Week 31 of 34

Week of July 20 — July 24, 2026

5 days on site. 34 photos. Earthwork, Electric, HVAC, Inspection, Paint, Plumbing, Site Concrete and Drainage.

July 20, 2026July 24, 20265 days34 photos
EarthworkElectricHVACInspectionPaintPlumbingSite Concrete and Drainage

Monday, July 20, 2026

Clear, 71°F

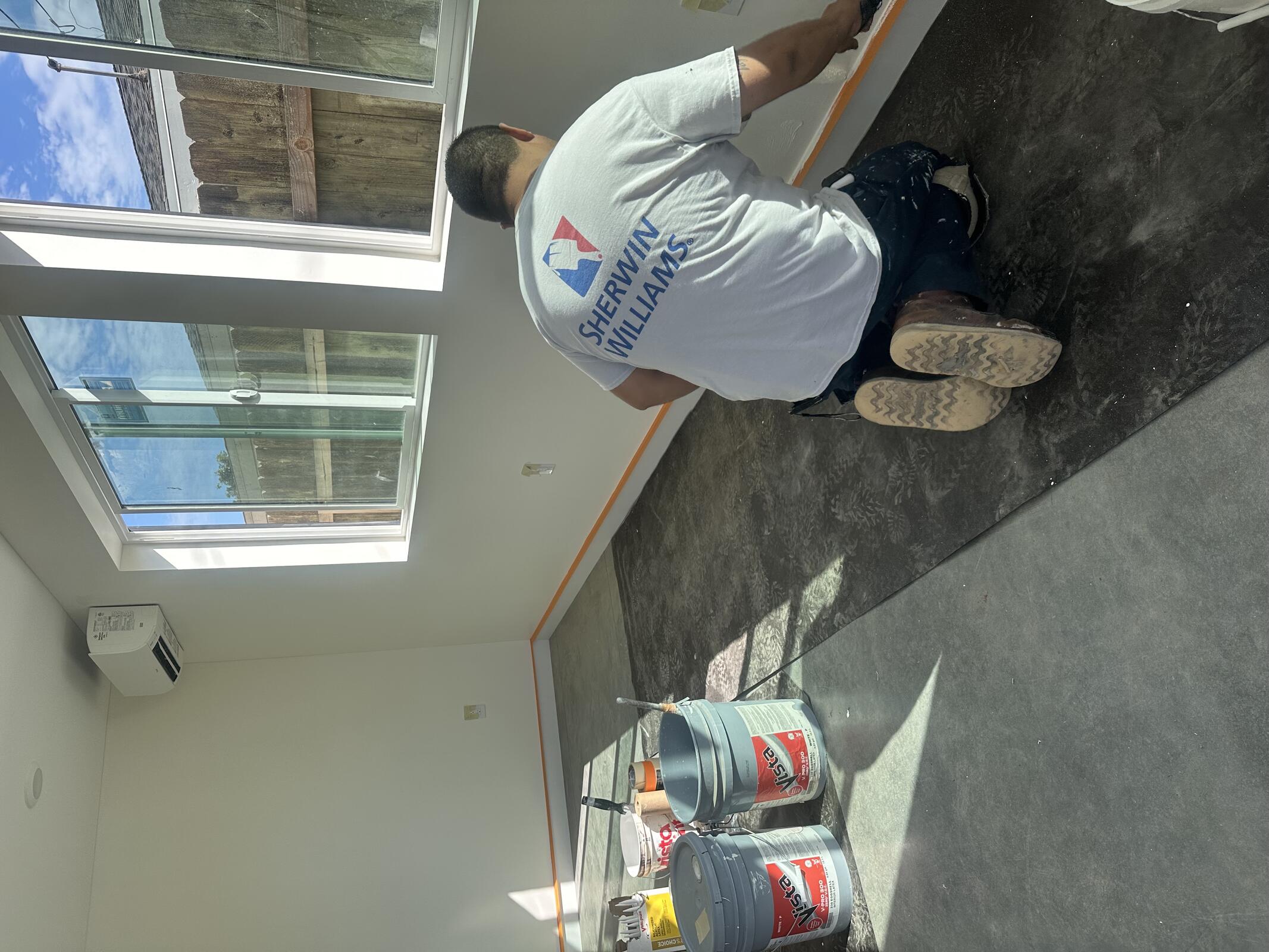

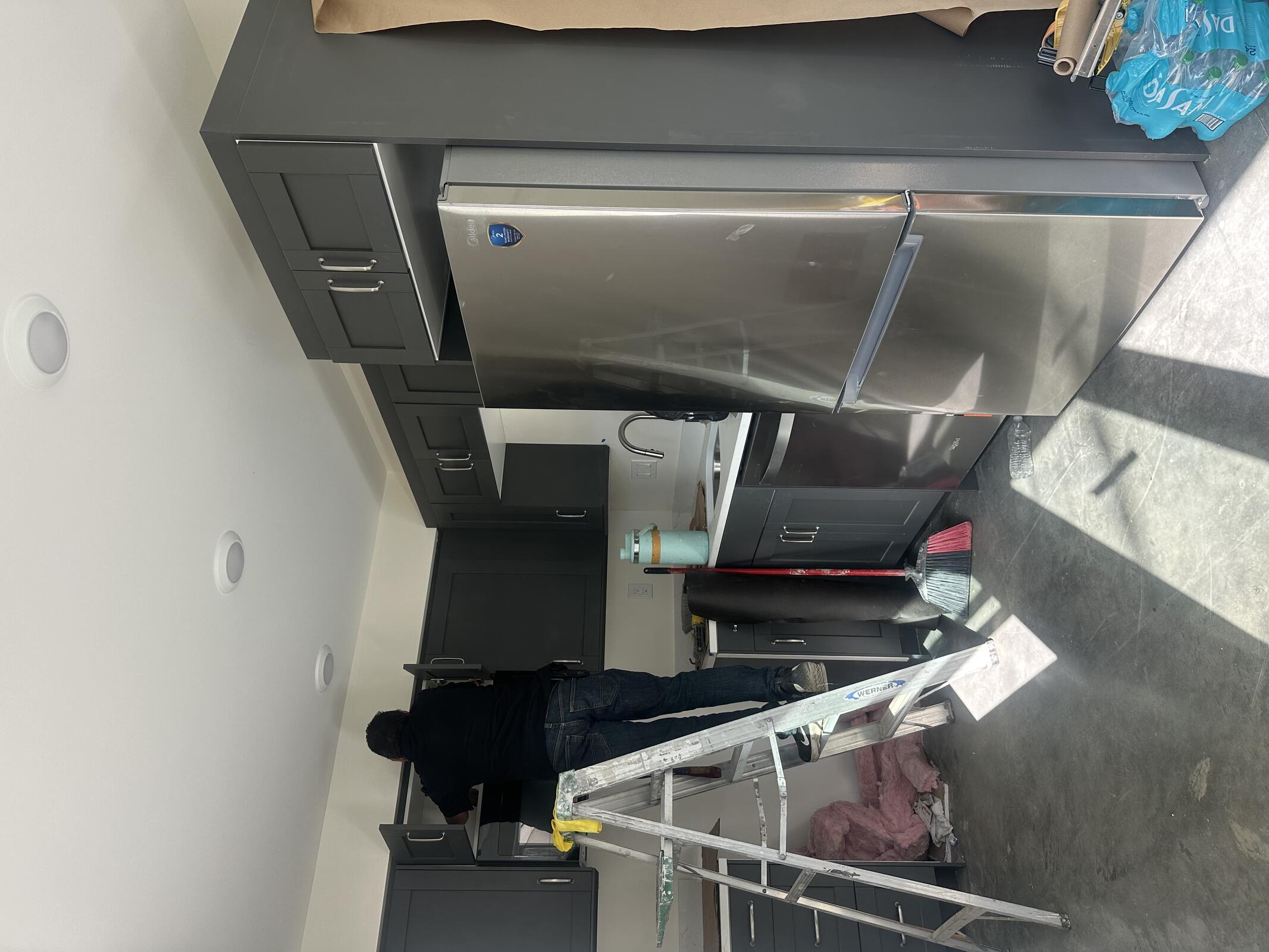

Painters Unlimited paintings walls and ceilings at Building B2.

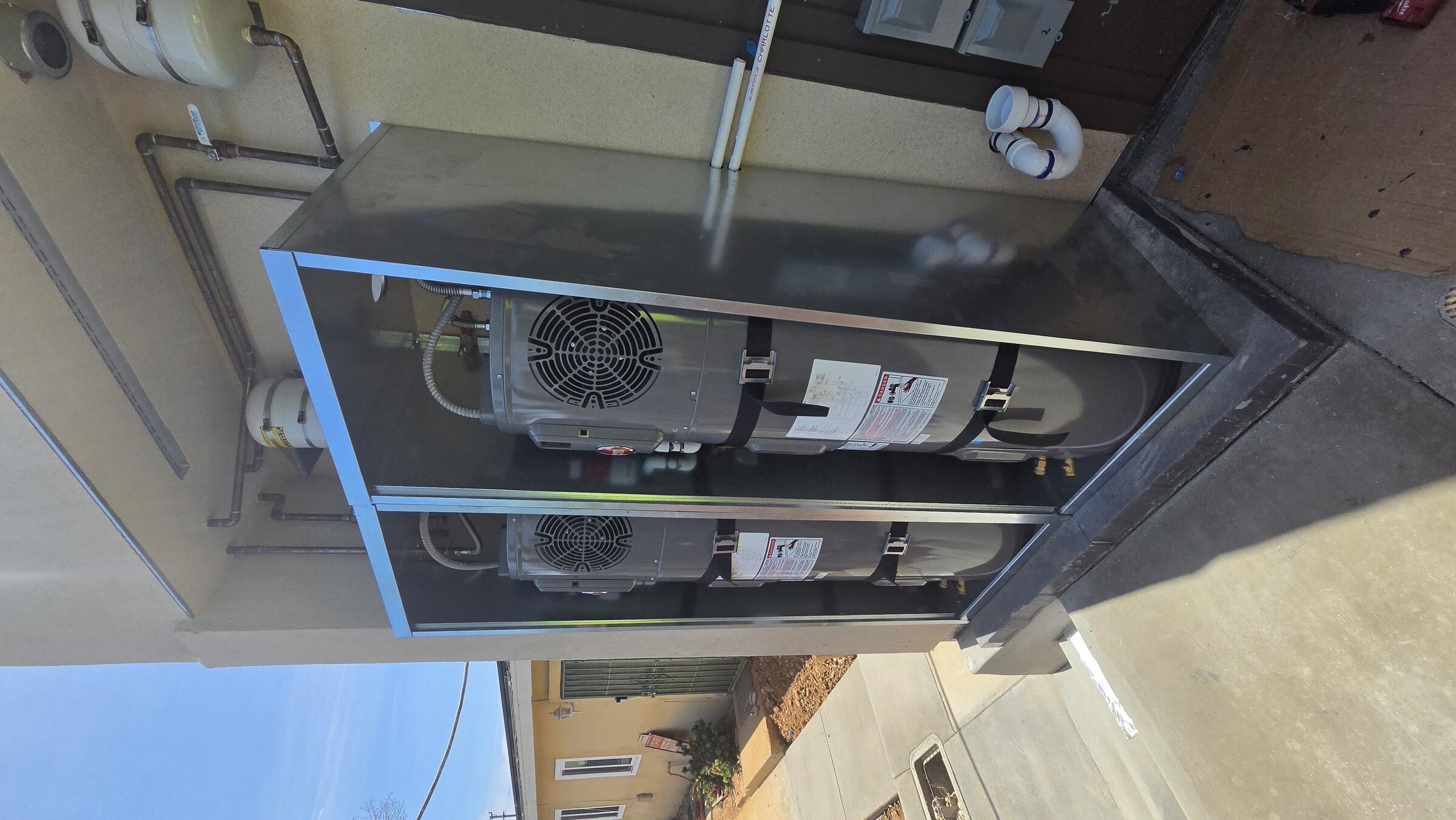

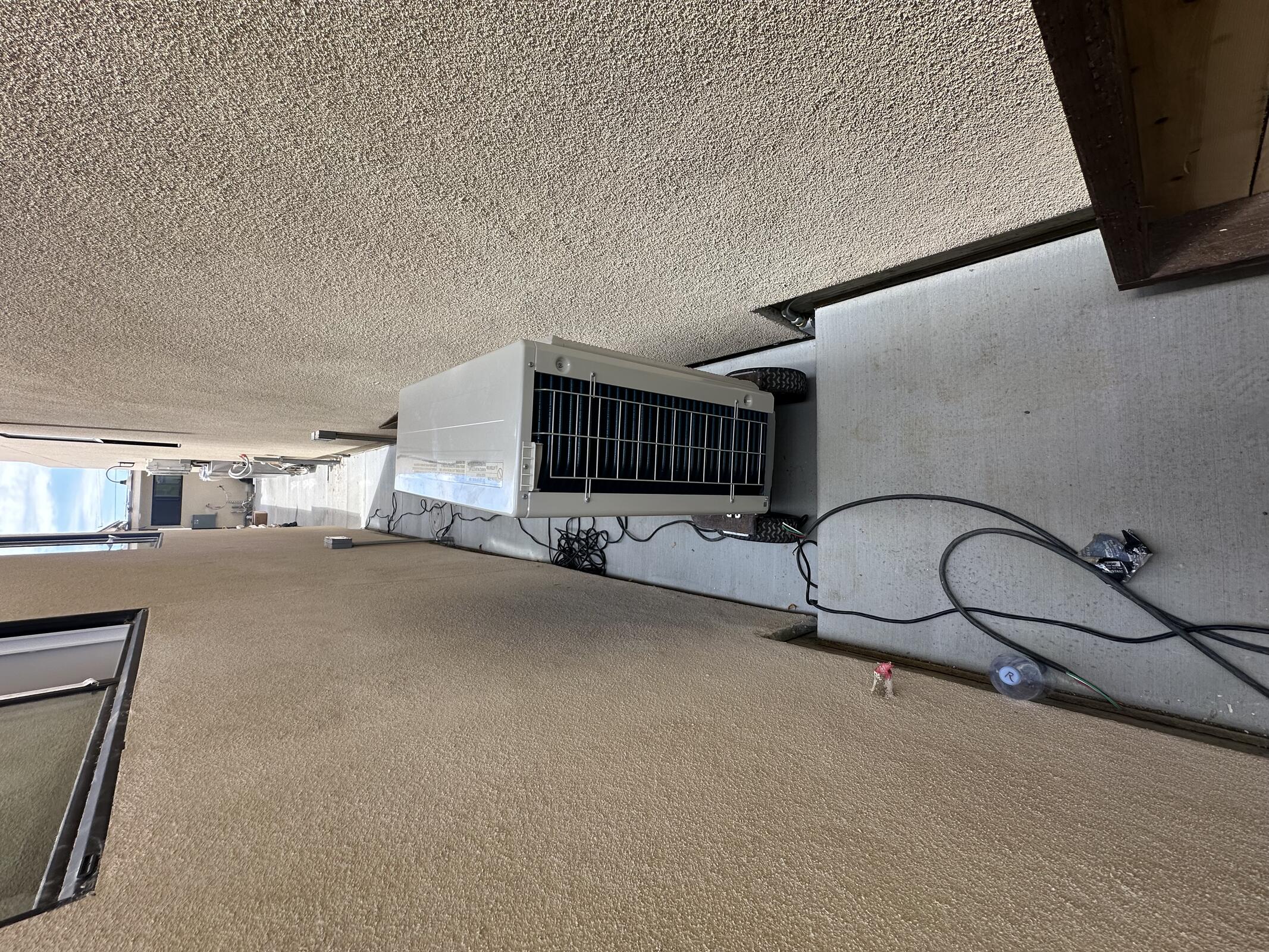

Clear HVAC getting outdoors units delivered and starting install.

ZSP continuing to test fixtures at all units and finish trim out.

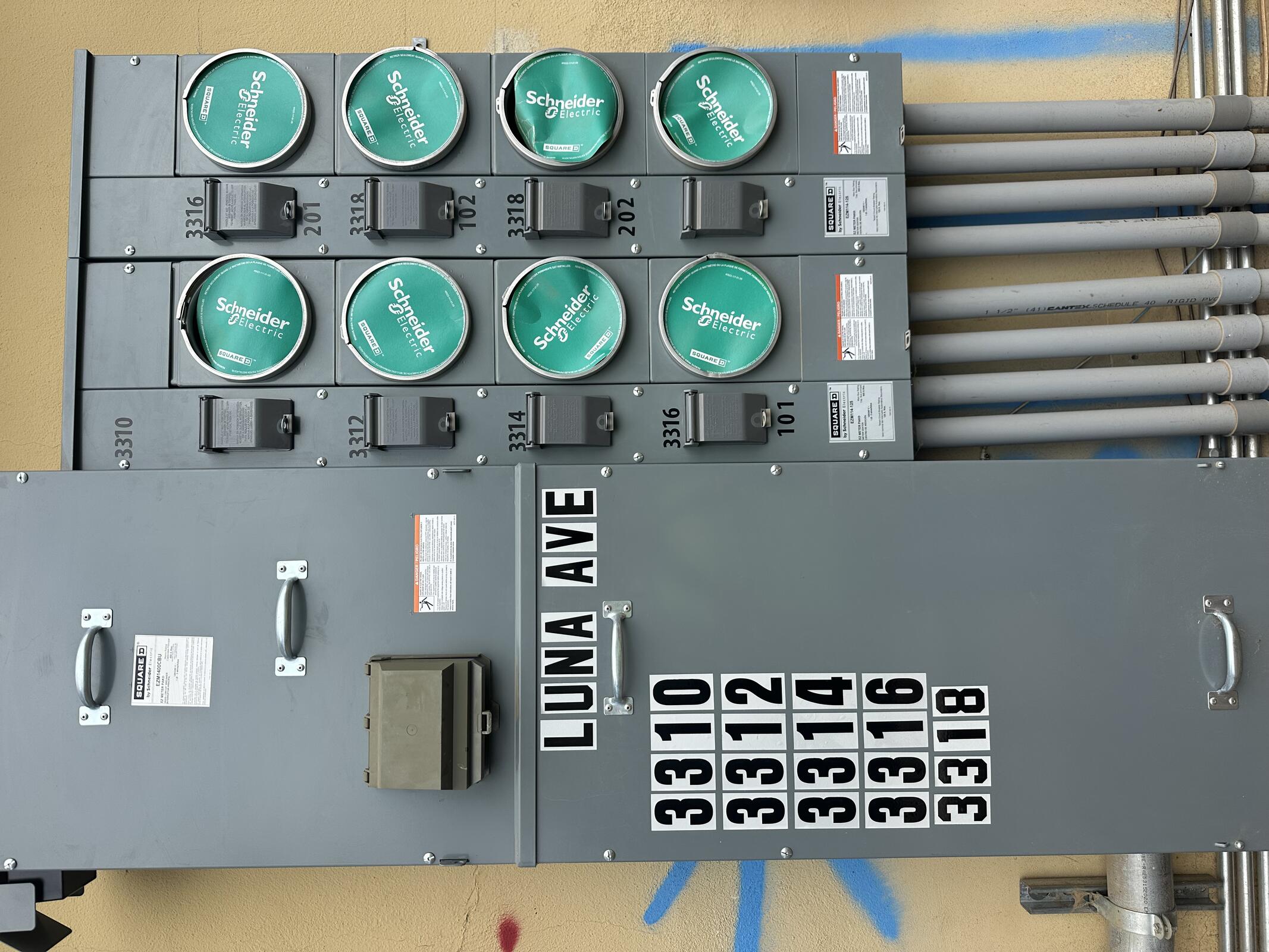

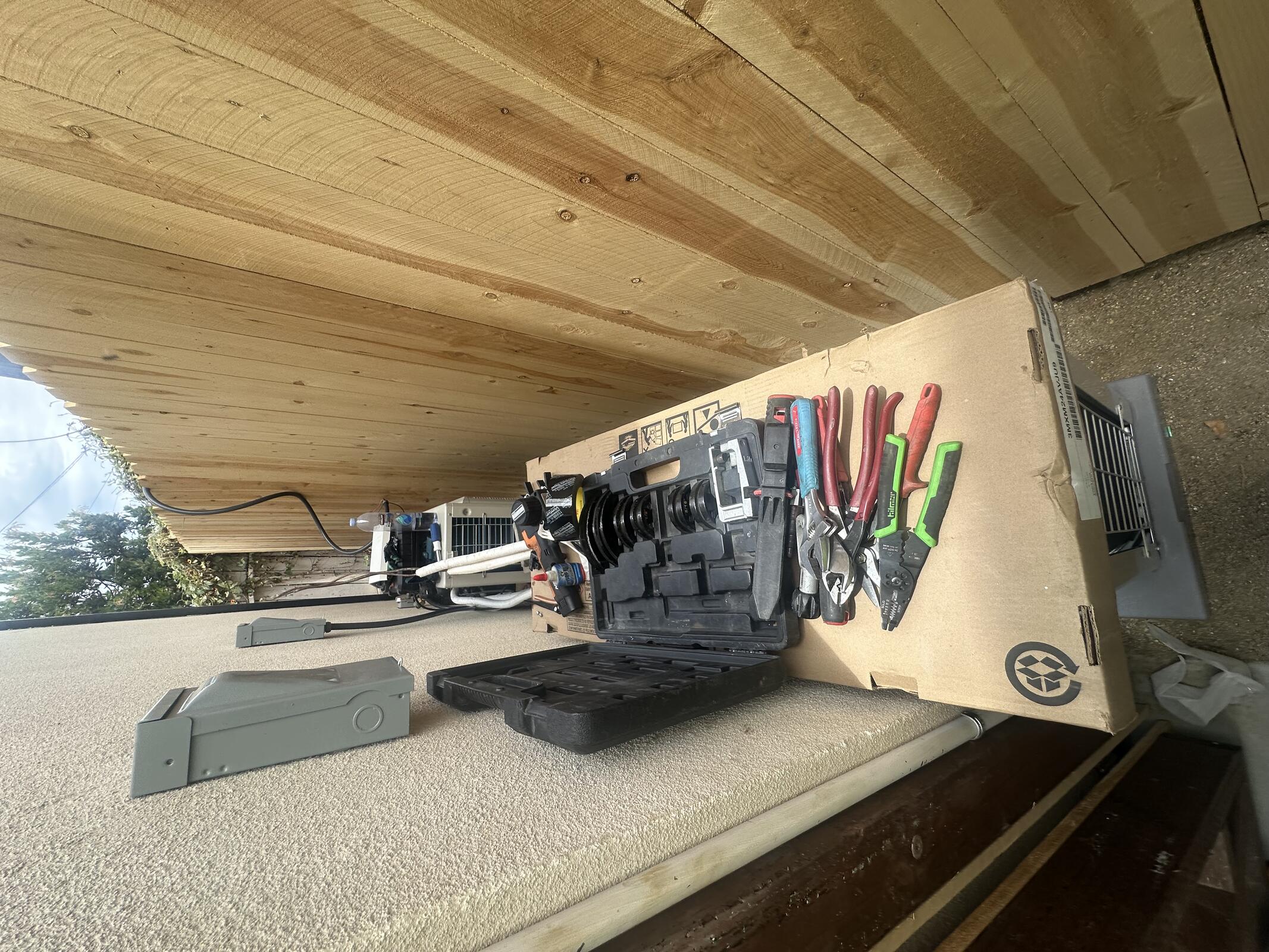

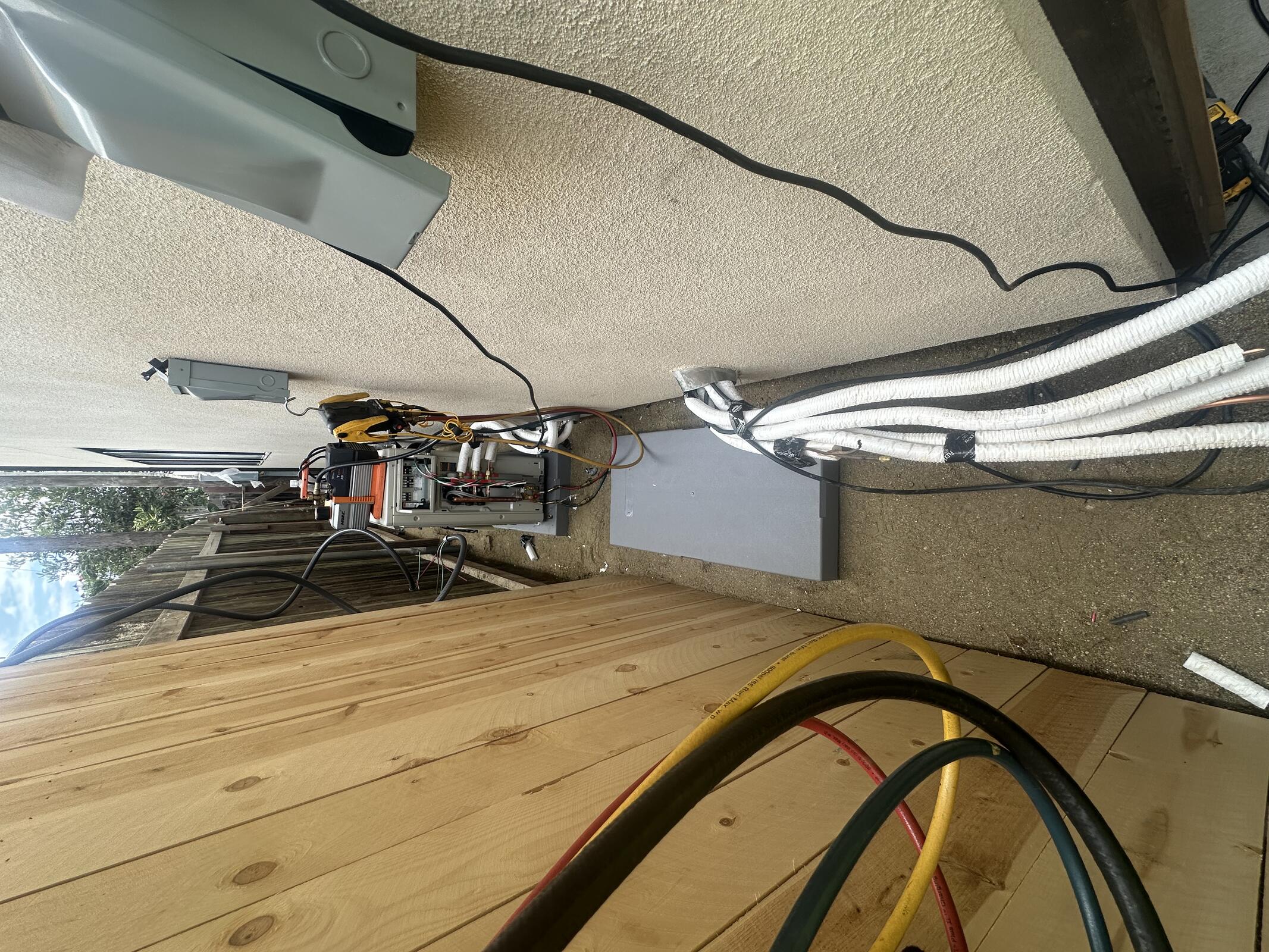

AC Electric finishing meter labeling and preparing for inspection today.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
Painters Unlimited2816
ZSP144
AC Electric122
Clear HVAC4832

Inspection: Danny S. on site at 11:40 AM. Signed off on meter at all units.

Tuesday, July 21, 2026

Clear, 81°F

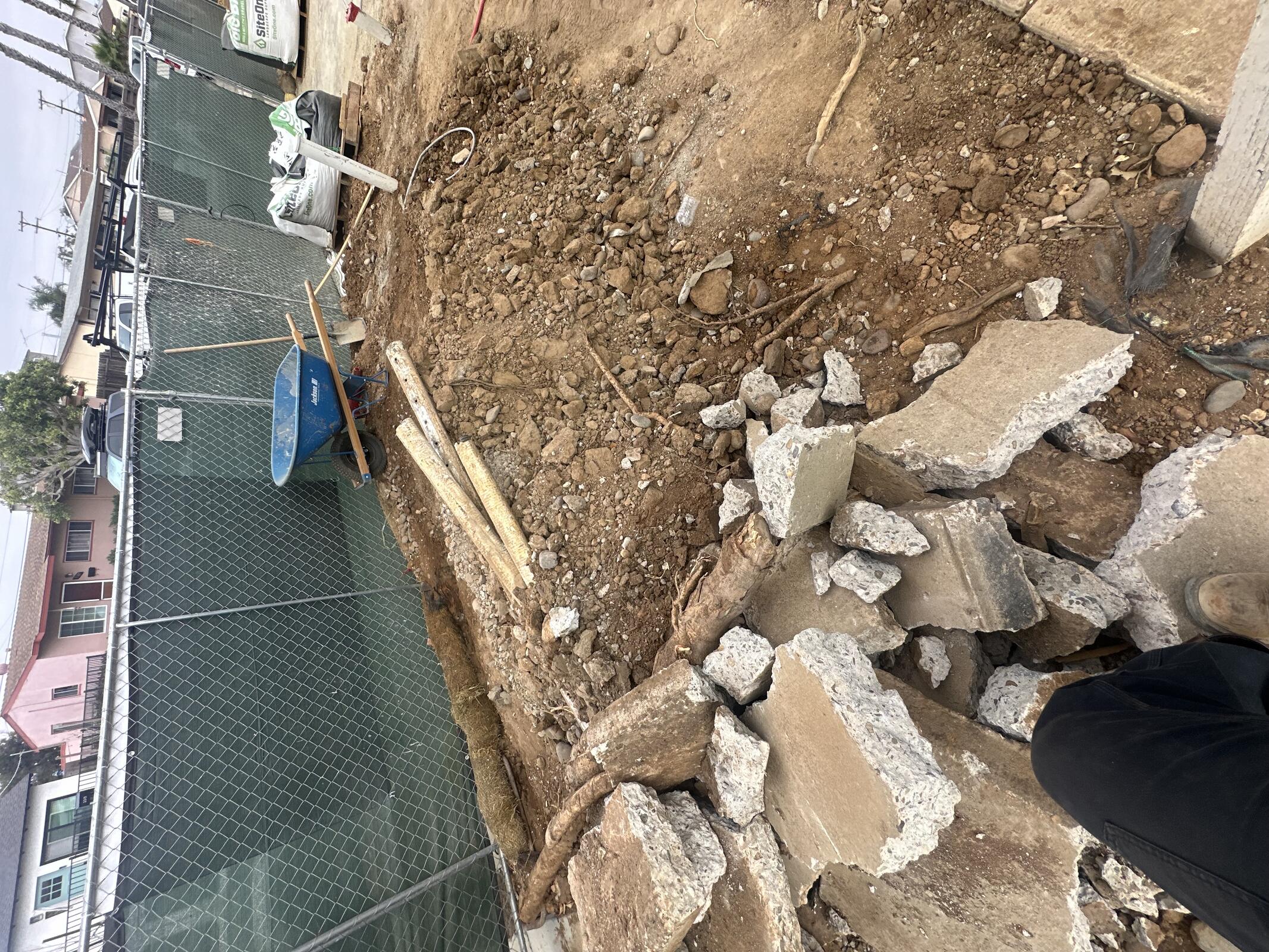

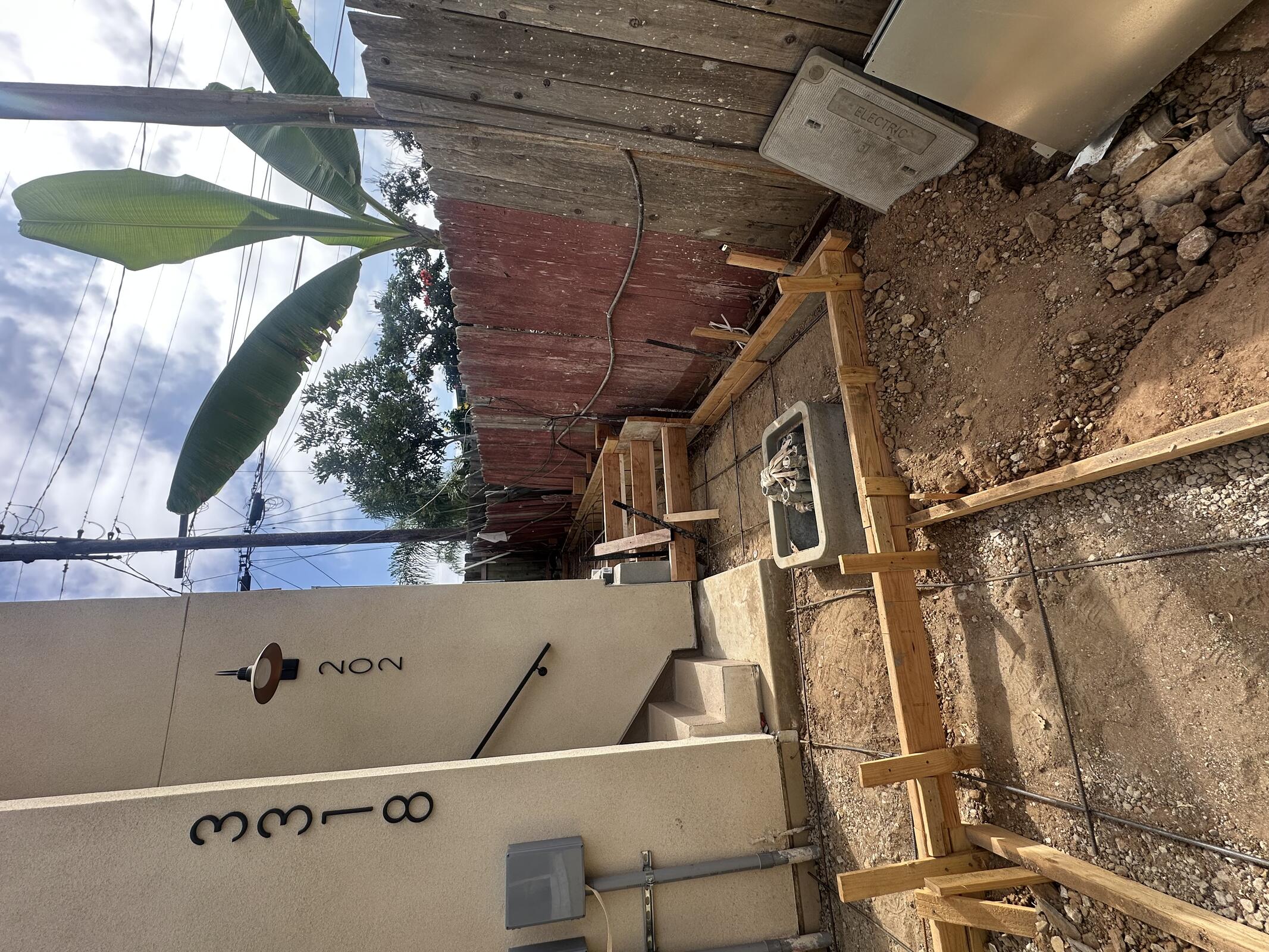

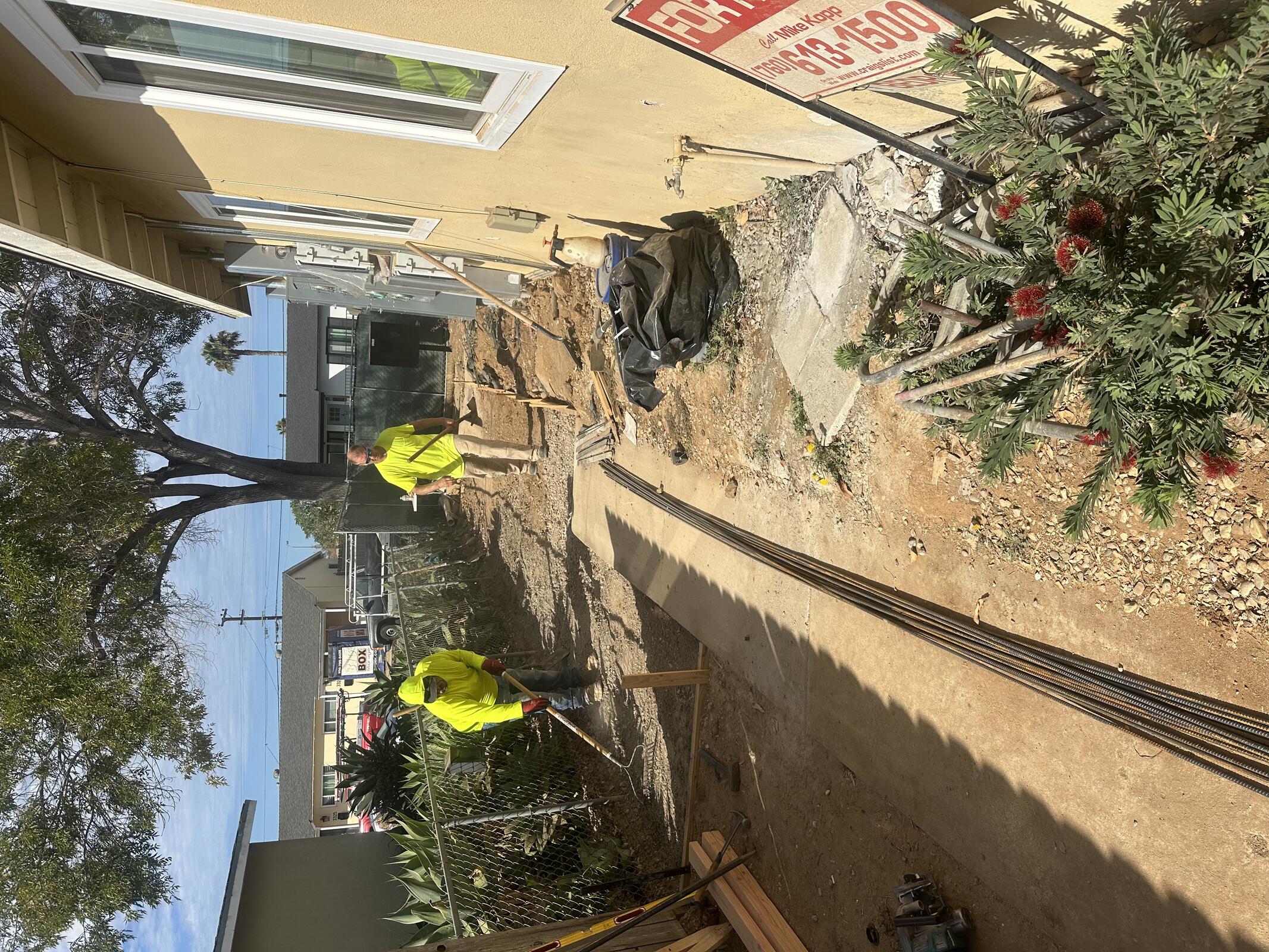

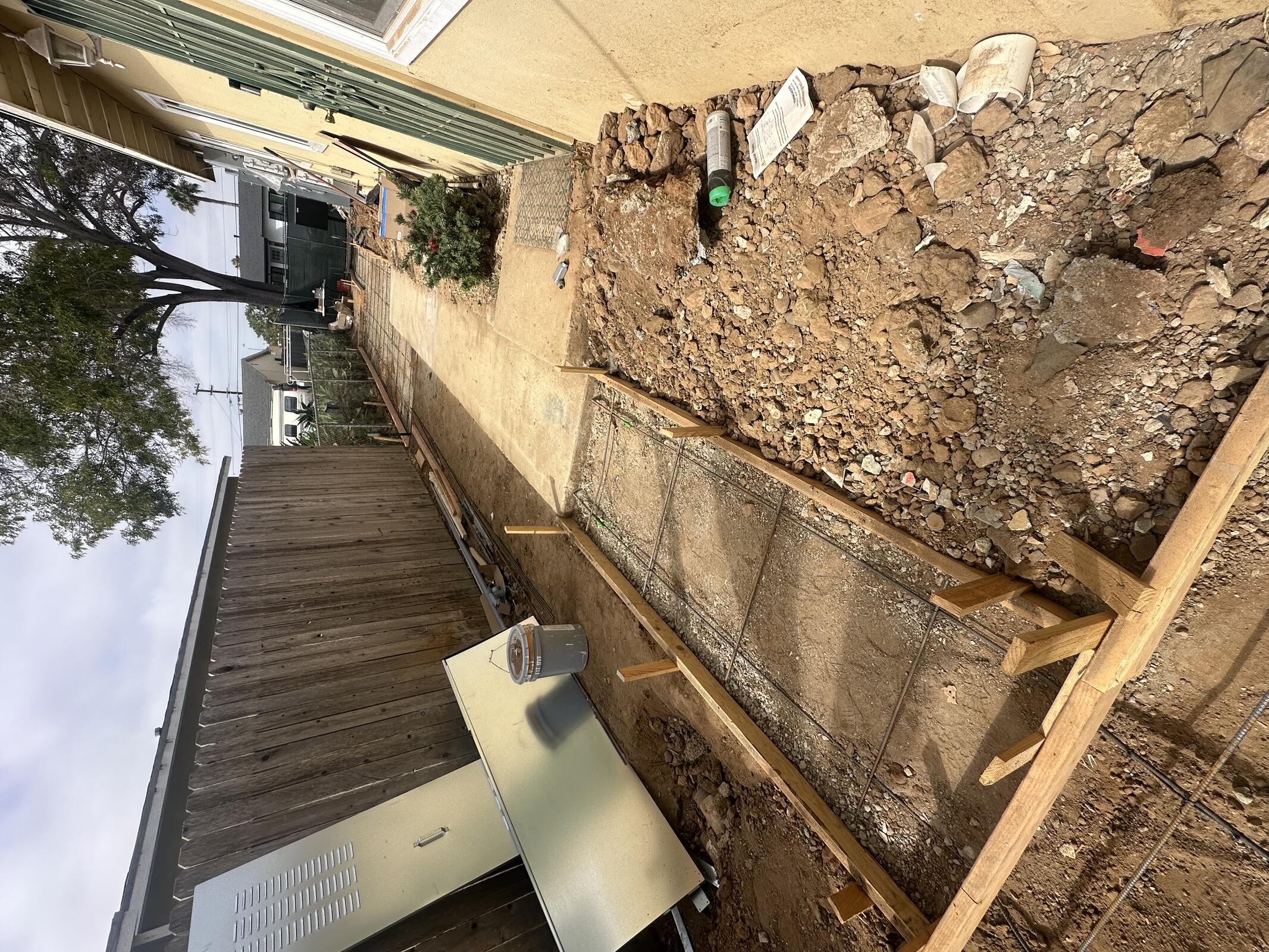

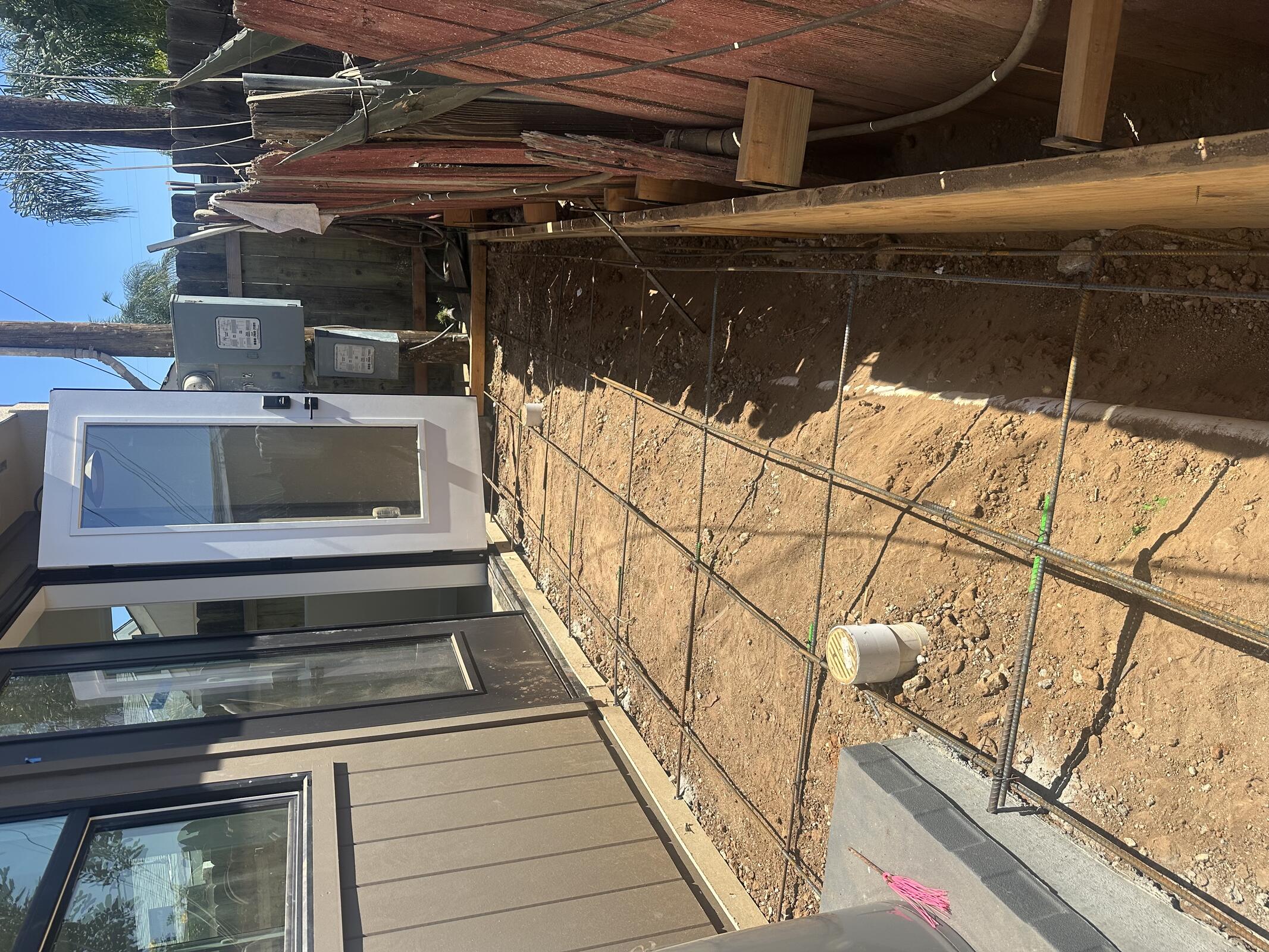

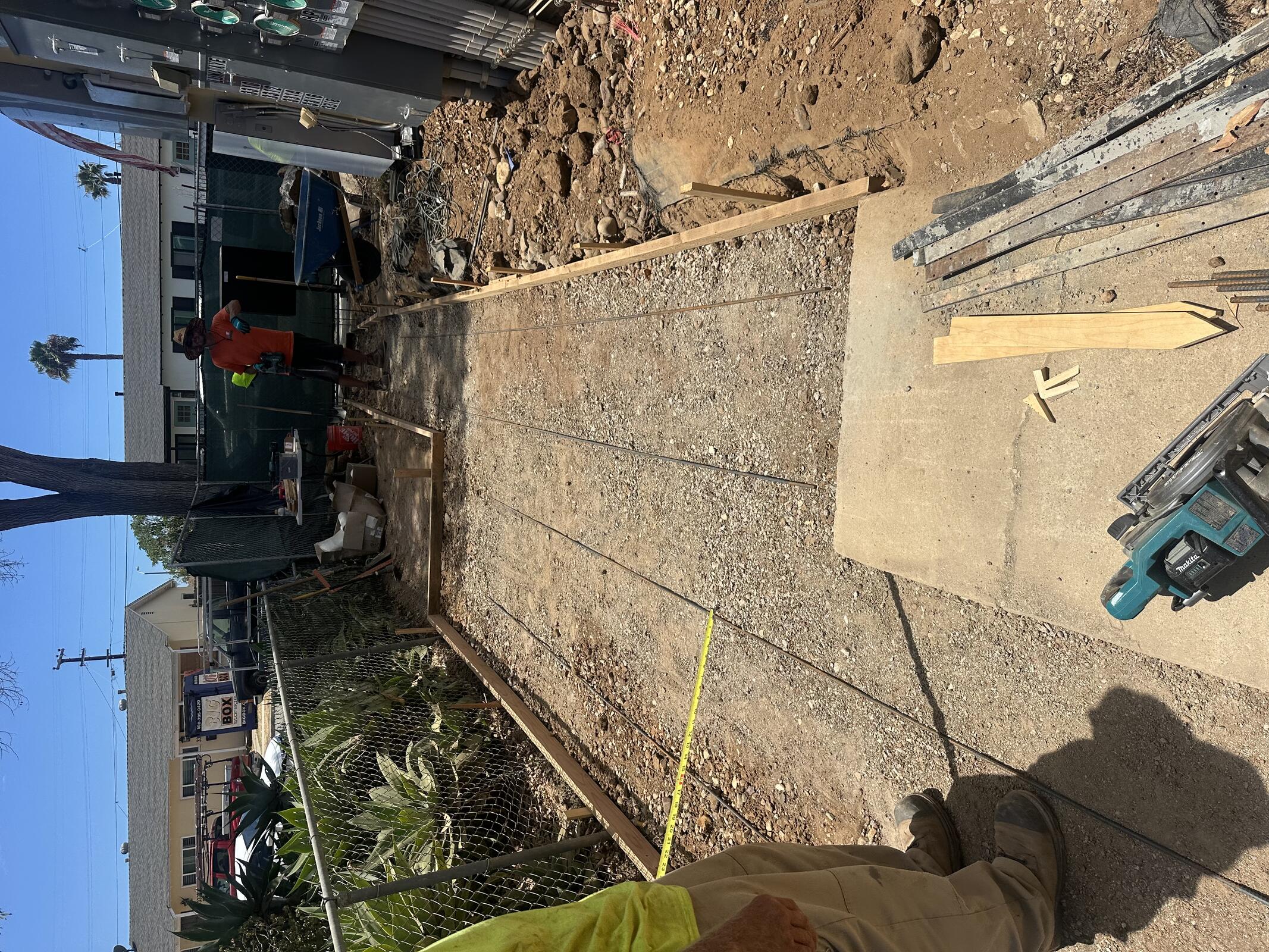

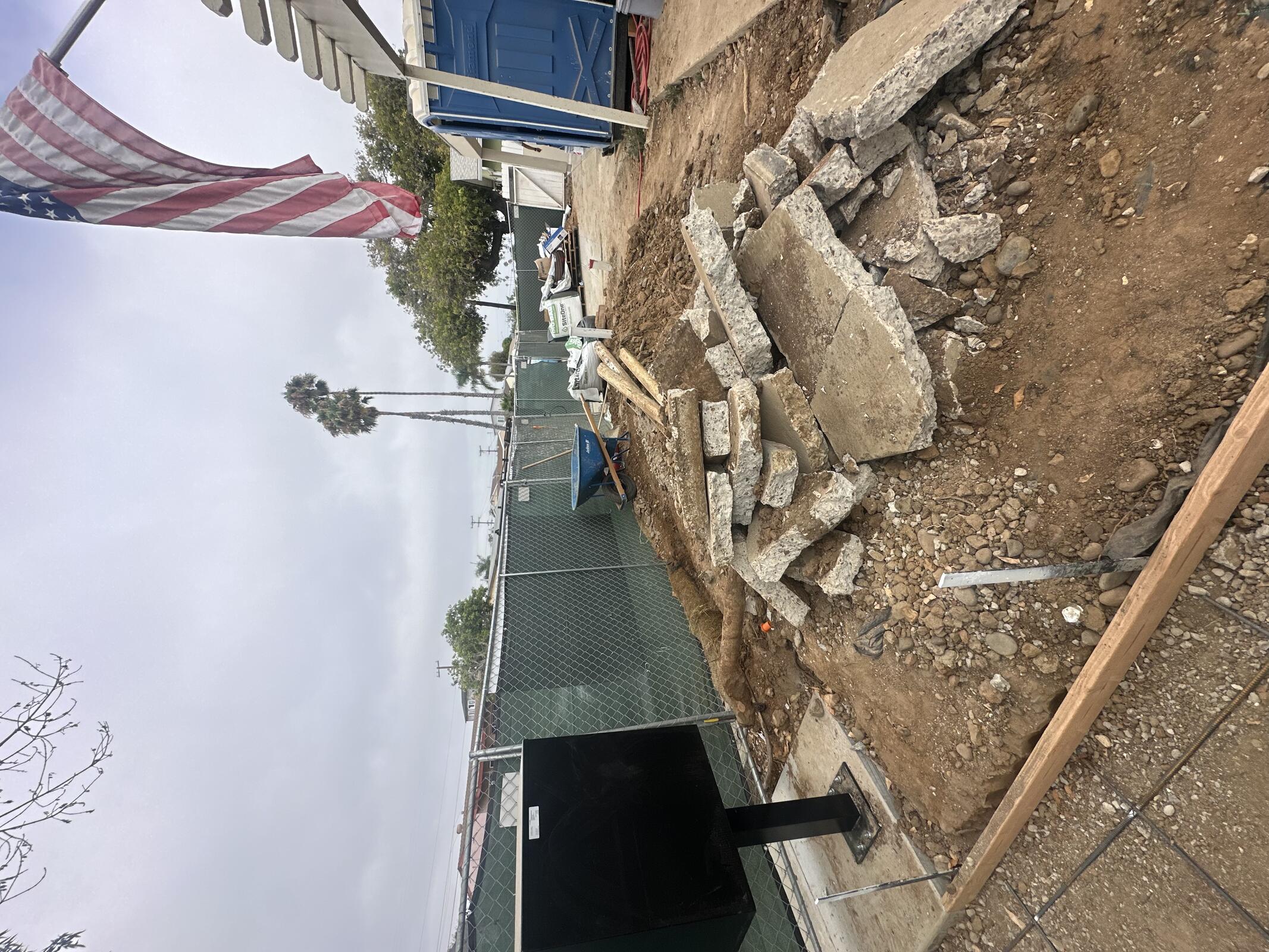

JBG installing rebar and forms for remaining site concrete.

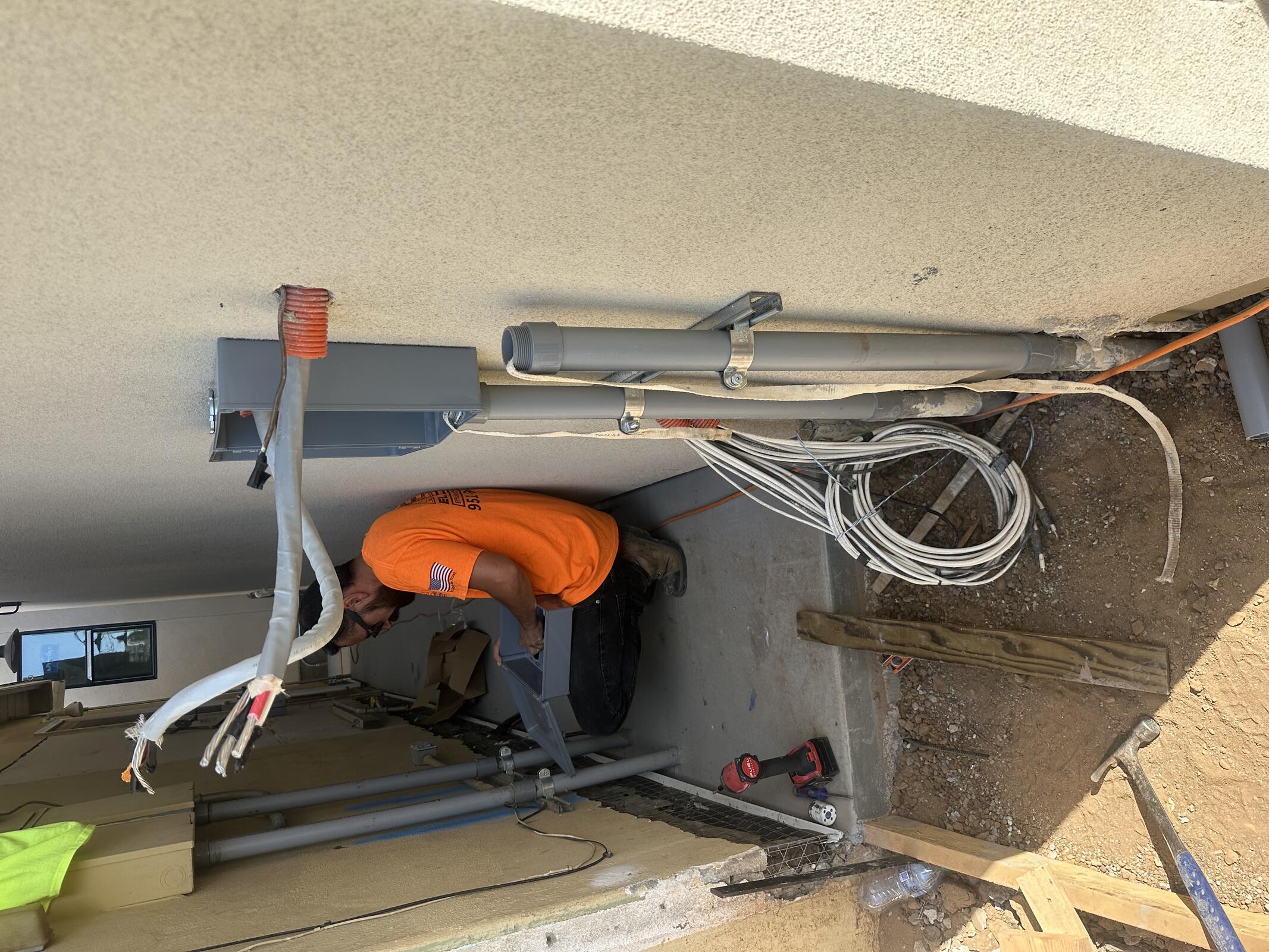

AC Electric installing exterior equipment.

Painters Unlimited working on Building B interiors.

Clear HVAC installing ducts and other pick-up items.

ML left voicemail with SDGE.

Guillermo from TT on site to look at cracked pocket door.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
JBG3824
AC Electric188
Clear HVAC2816
Painters Unlimited3824

Inspection: N/A

Wednesday, July 22, 2026

Partially cloudy, 76°F

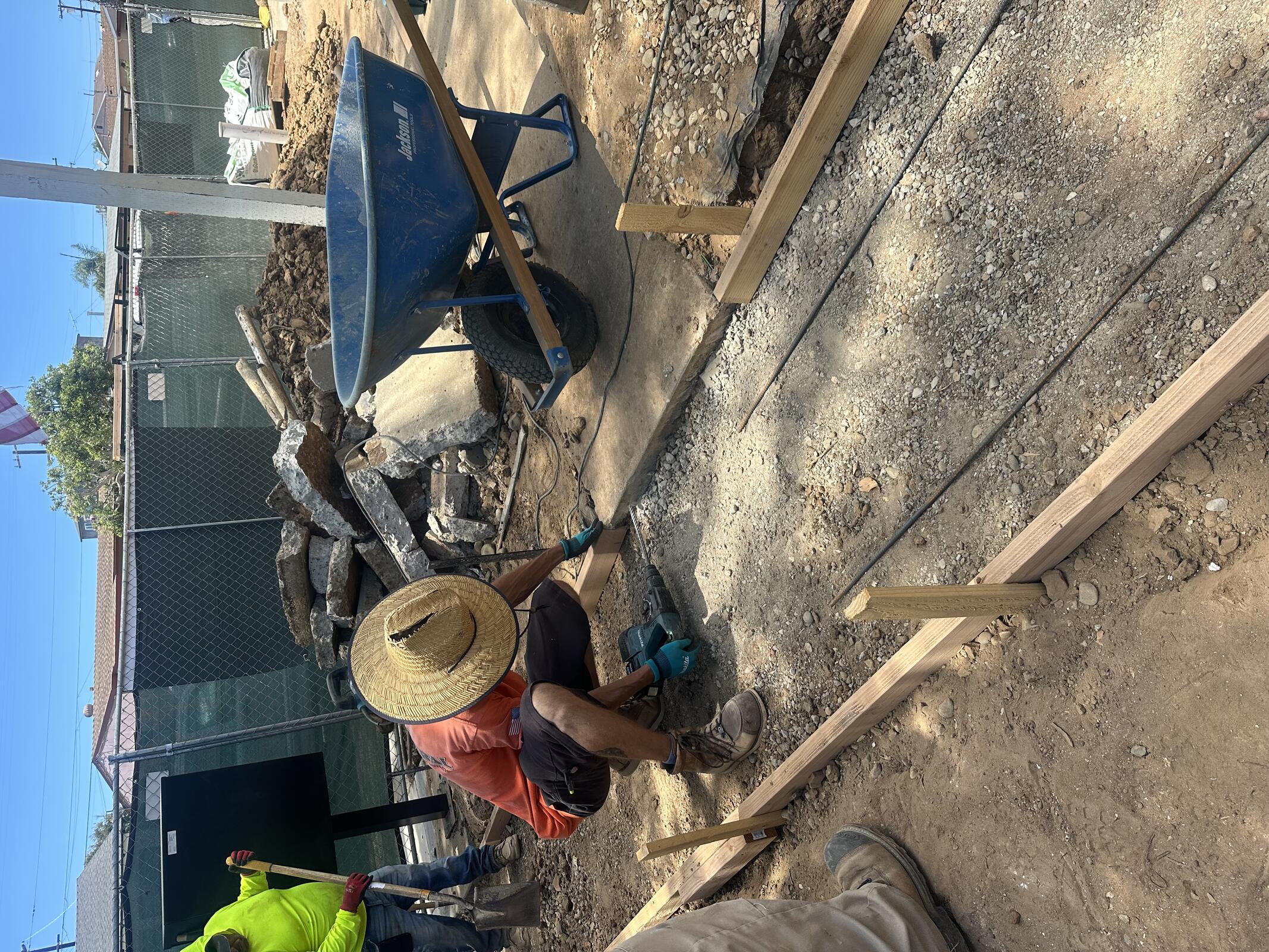

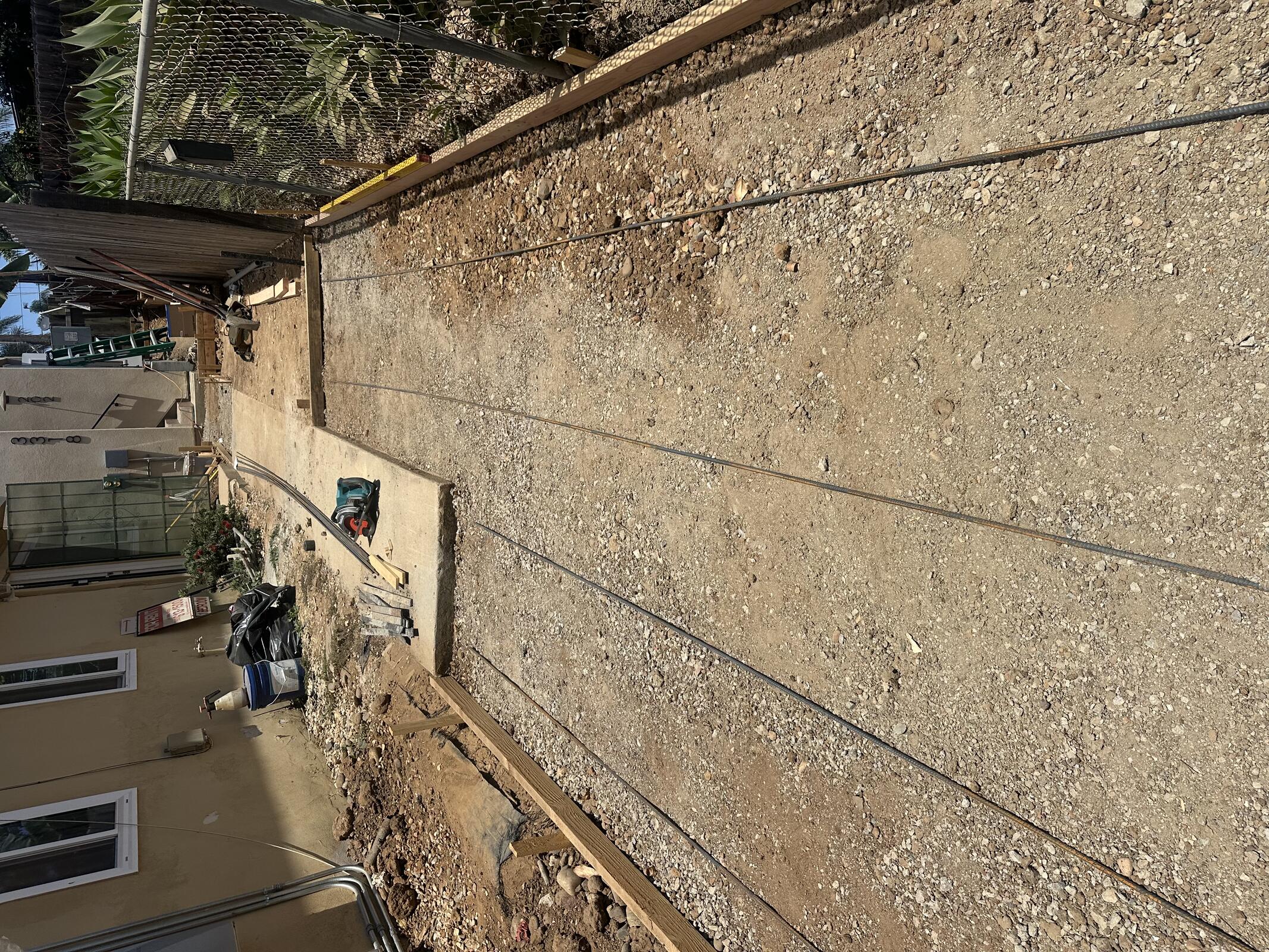

JBG on site this AM to finish rebar and formwork. Ready to pour tomorrow.

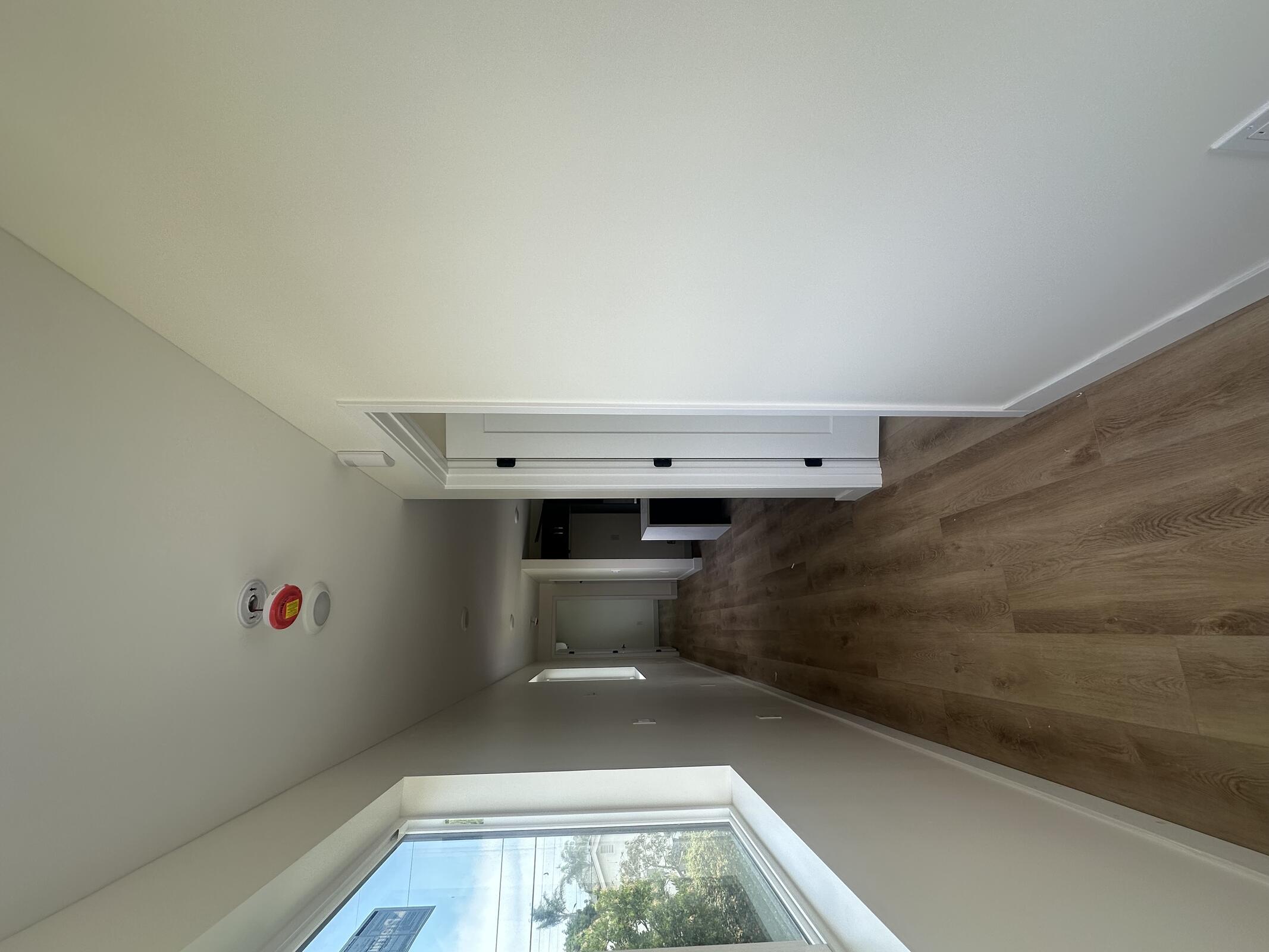

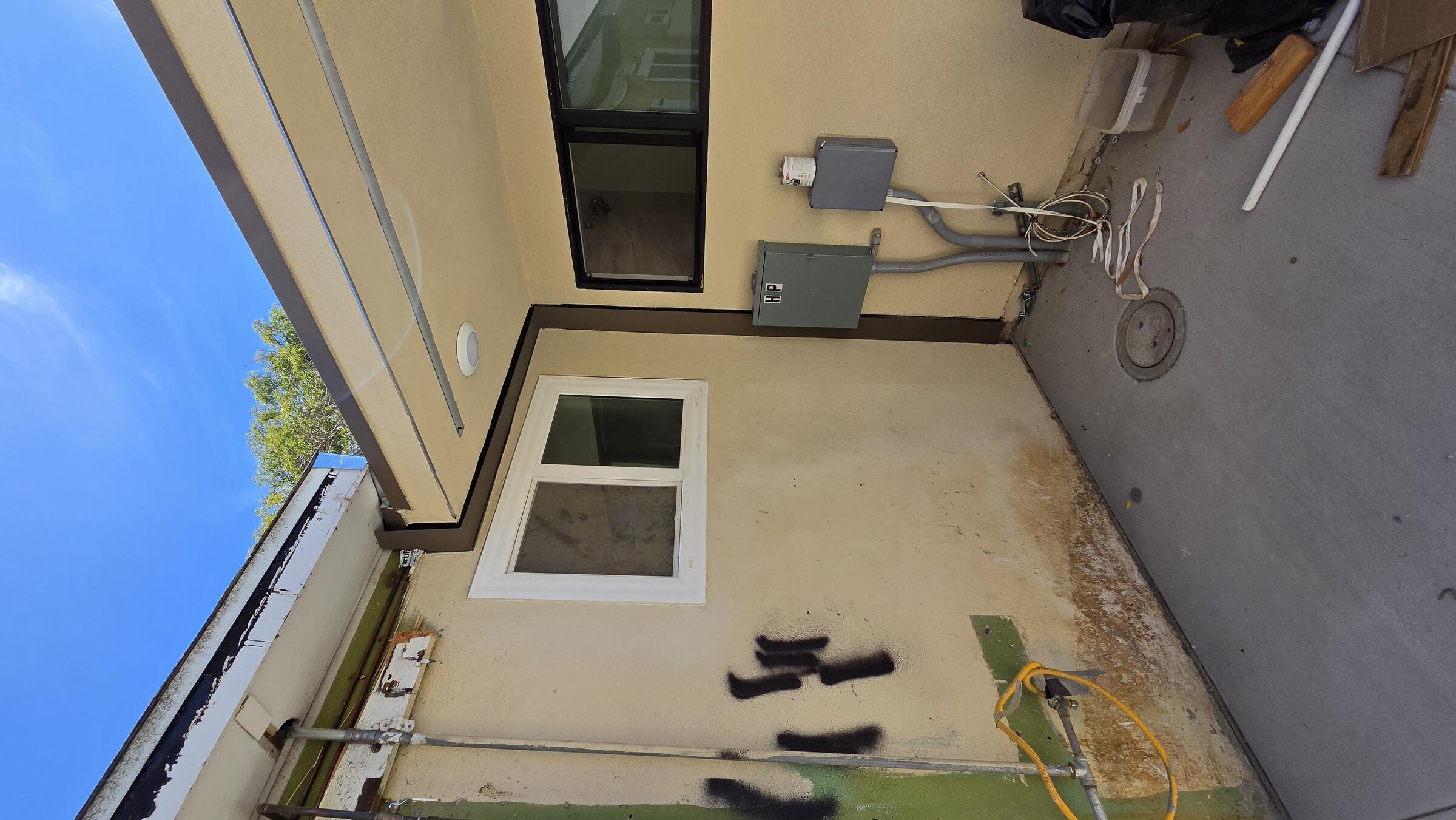

Painters Unlimited painting garage conversion wall and ceilings and then touching up baseboards and doors in all units.

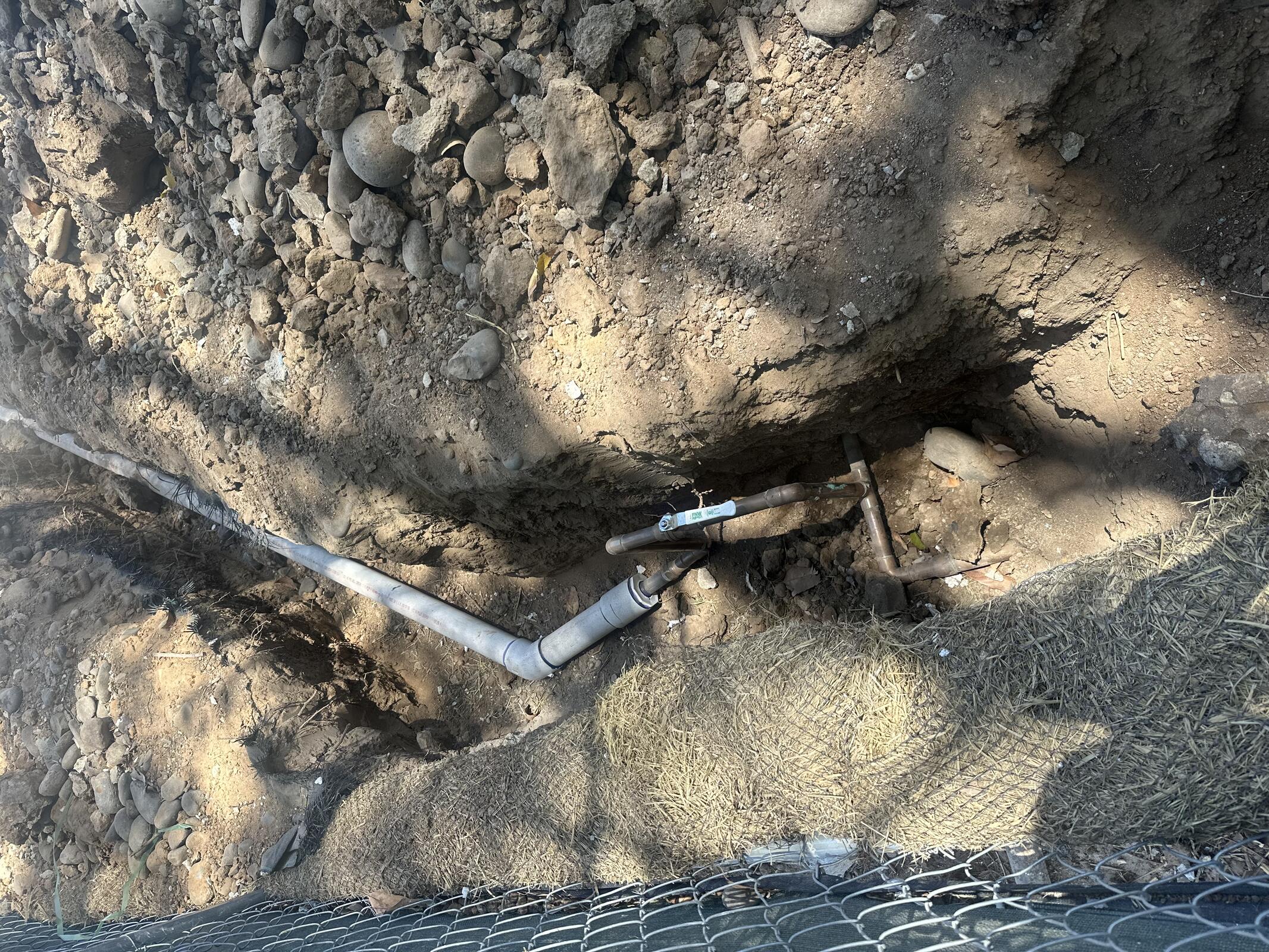

ZSP backfilling trench, installing tankless water heater and adjusting trim out.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
JBG3412
Painters Unlimited3824
ZSP188

Inspection: Ryan Bailey (Eco Green Energy) on site at 11:00 AM for HERs inspection. No issues. He will work on report.

Thursday, July 23, 2026

Clear, 81°F

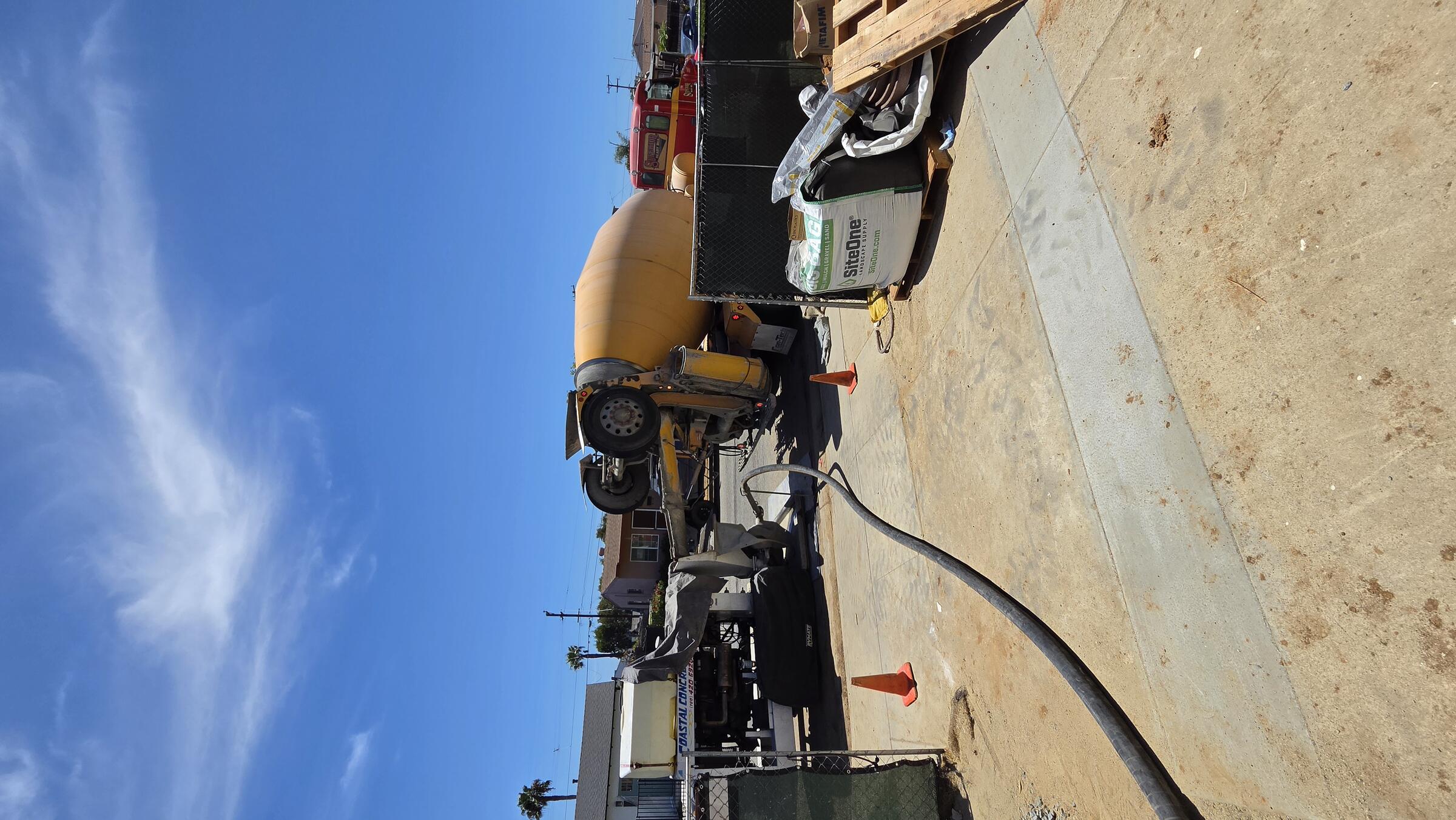

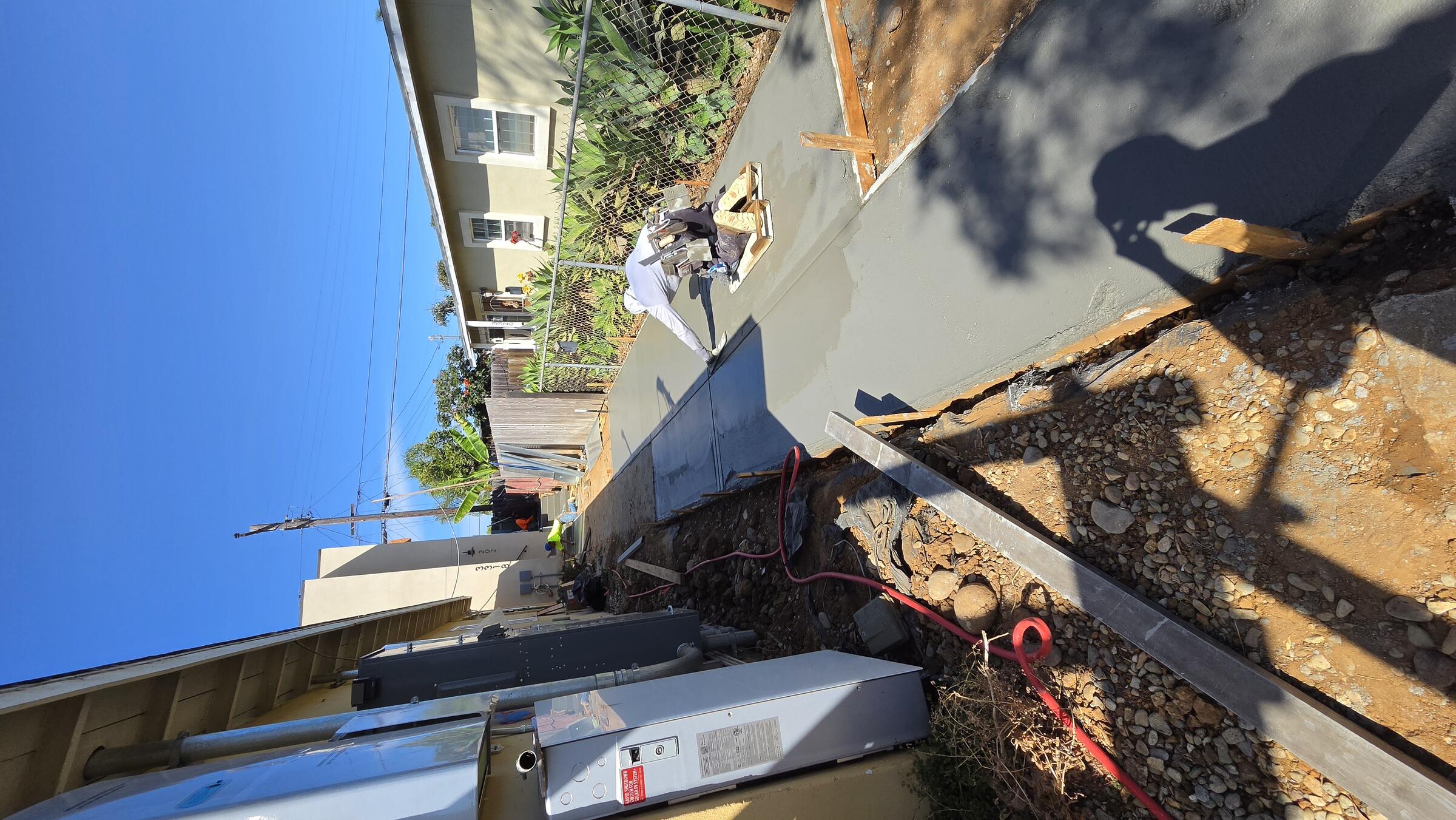

JBG pouring concrete for sidewalk and stairs today.

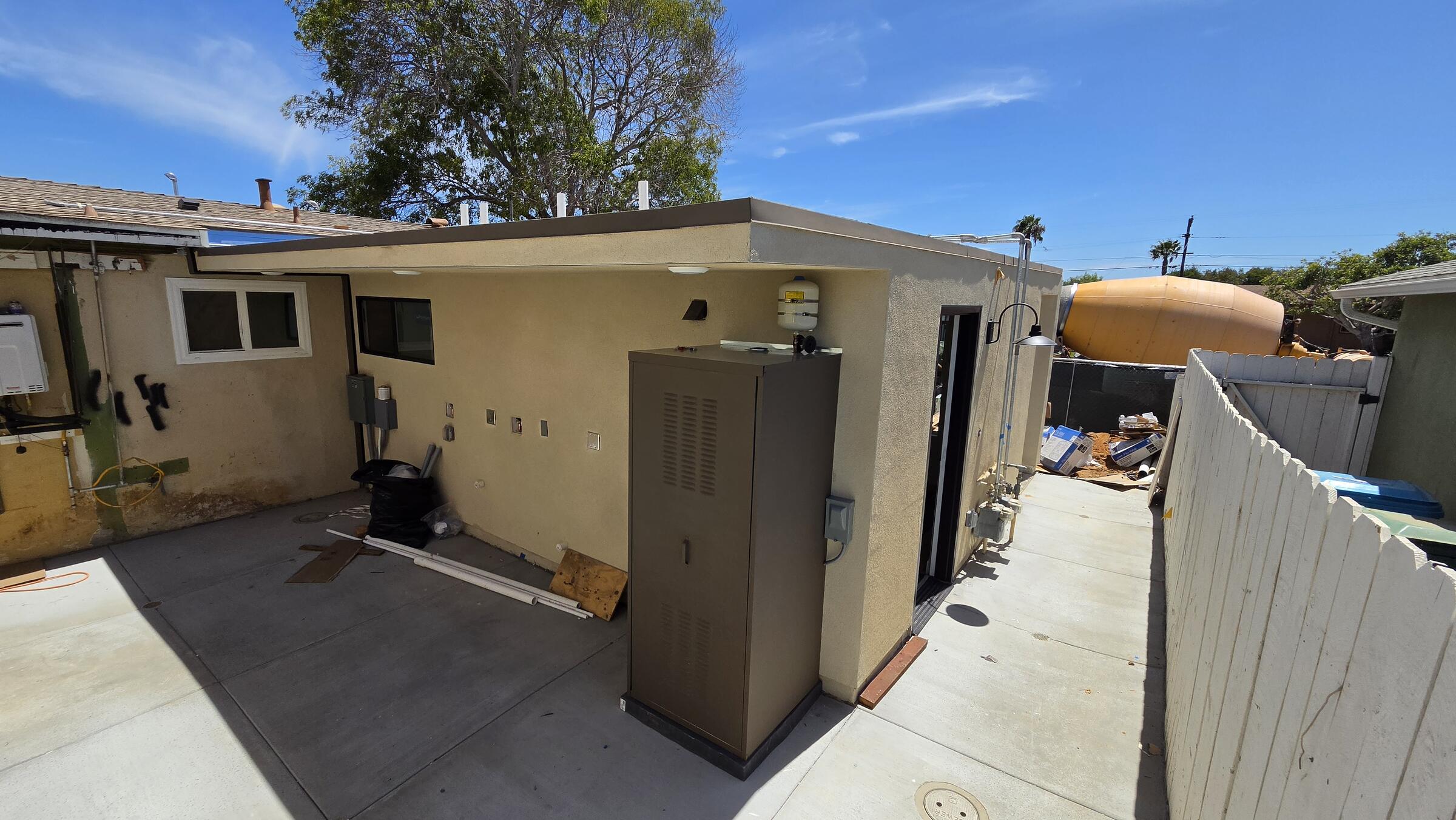

Painters unlimited painting water heater enclosures.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
JB General3515
Painters Unlimited2412

Inspection: ---

Friday, July 24, 2026

Clear, 80°F

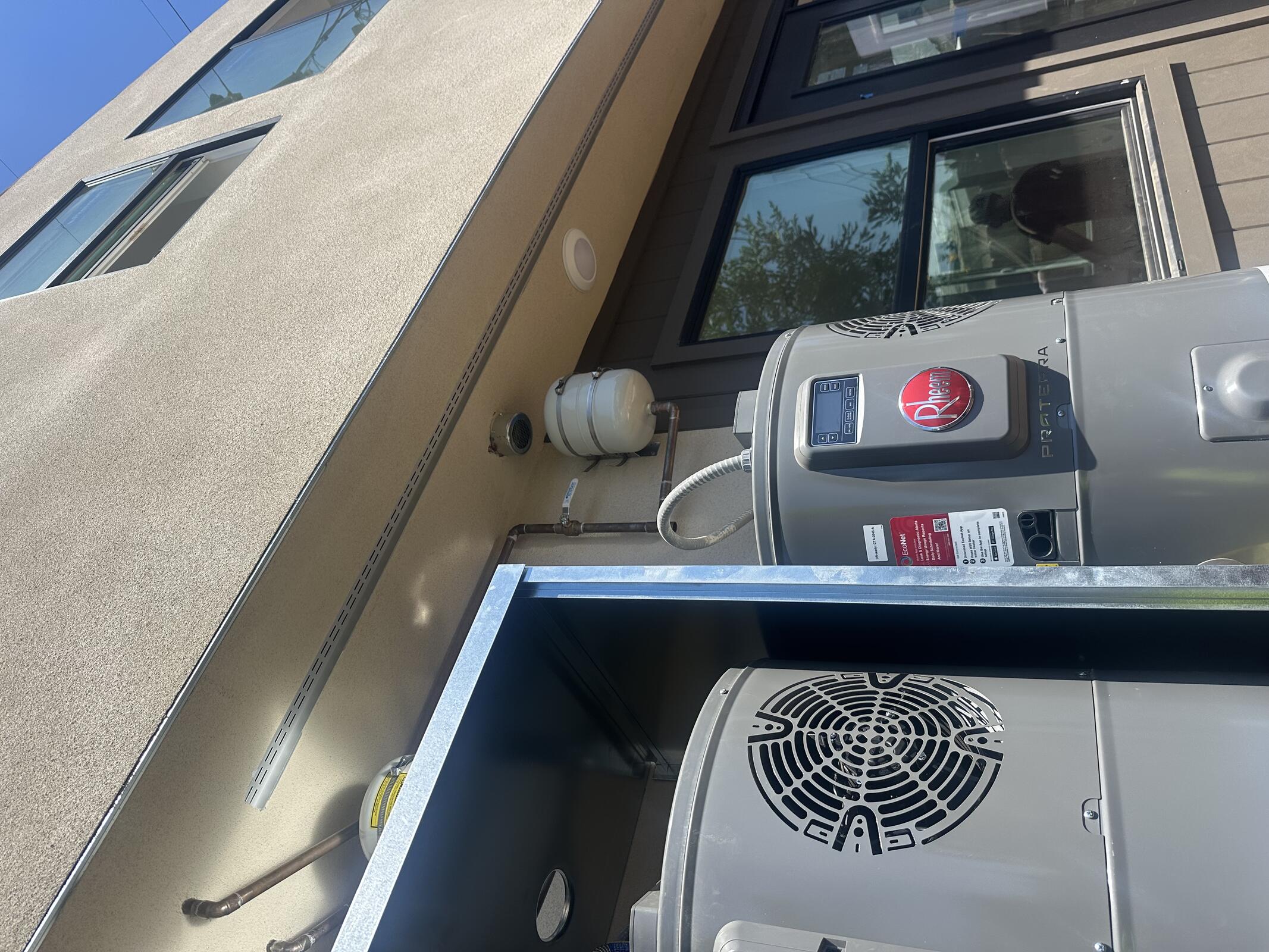

ZSP installing and testing water heater

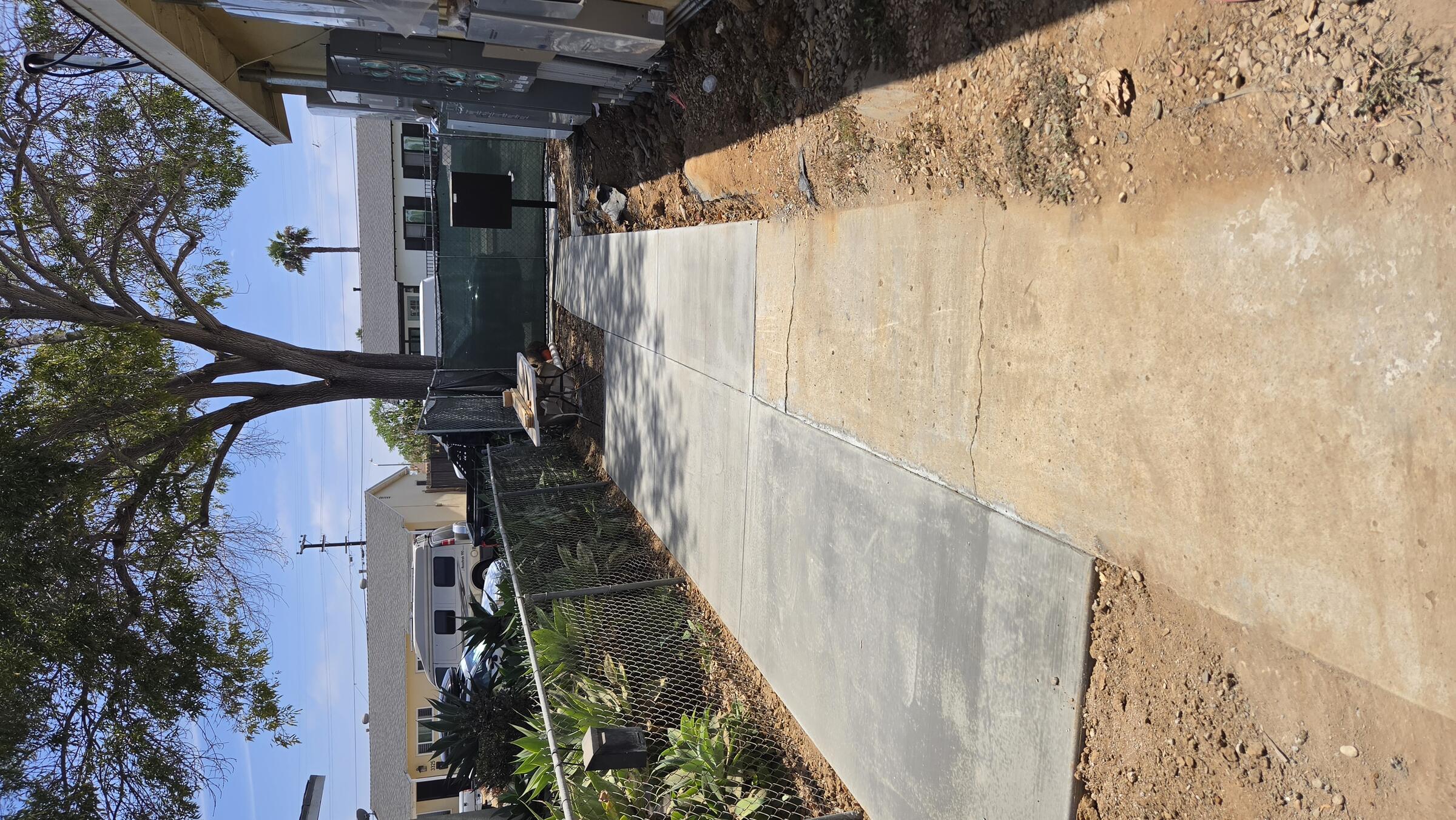

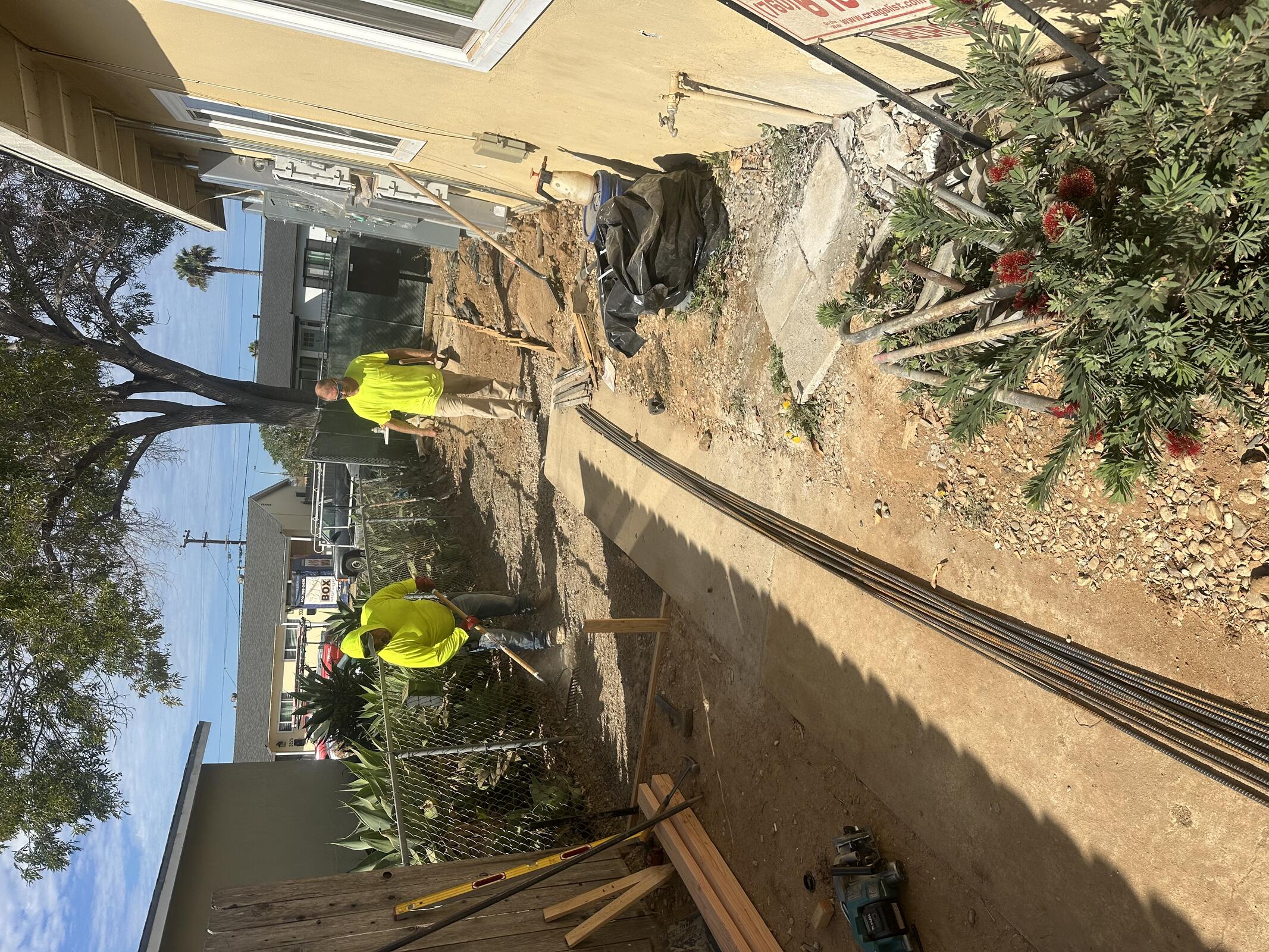

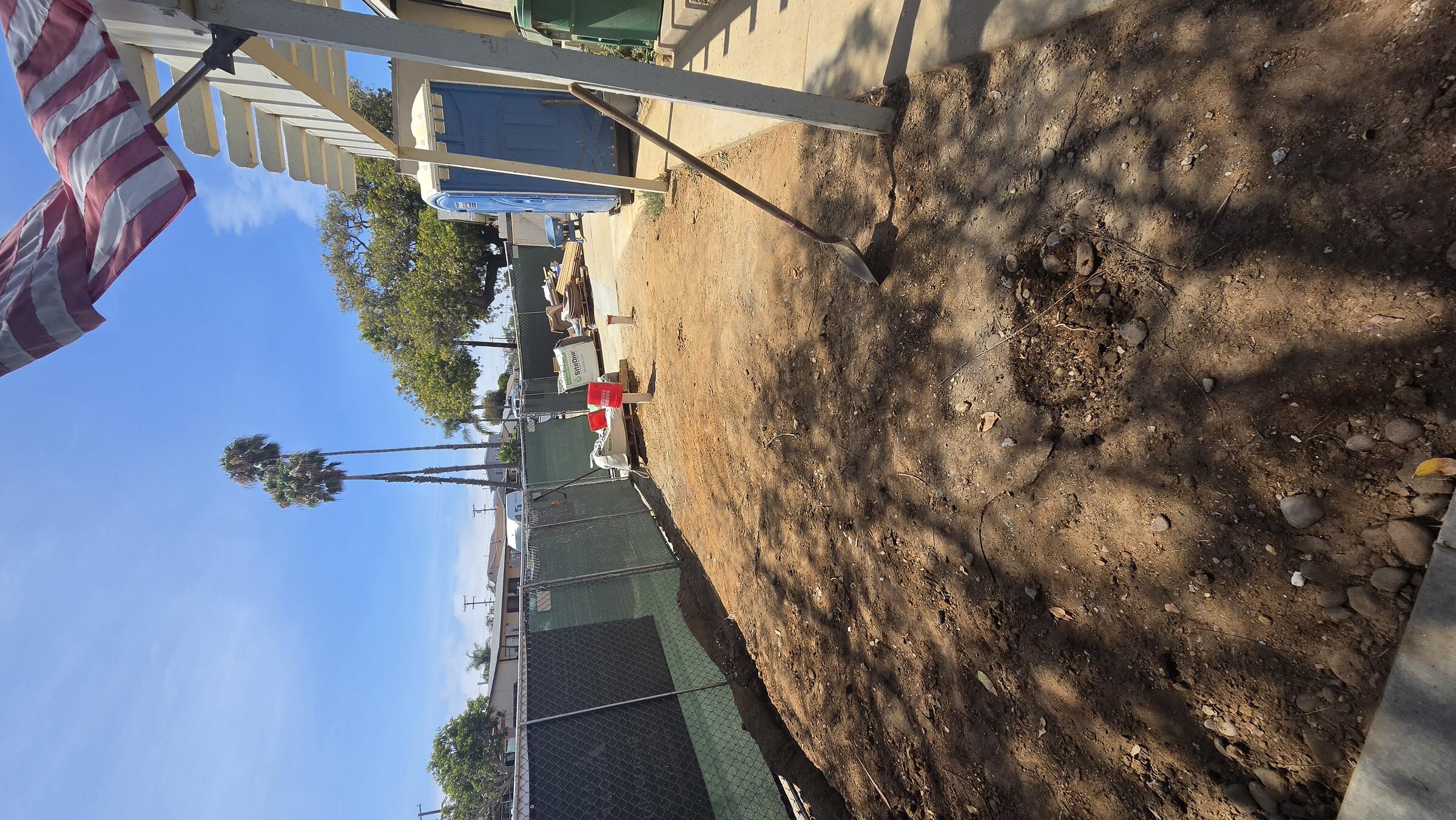

JBG hauling off excess dirt from front yard.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
JBG2612

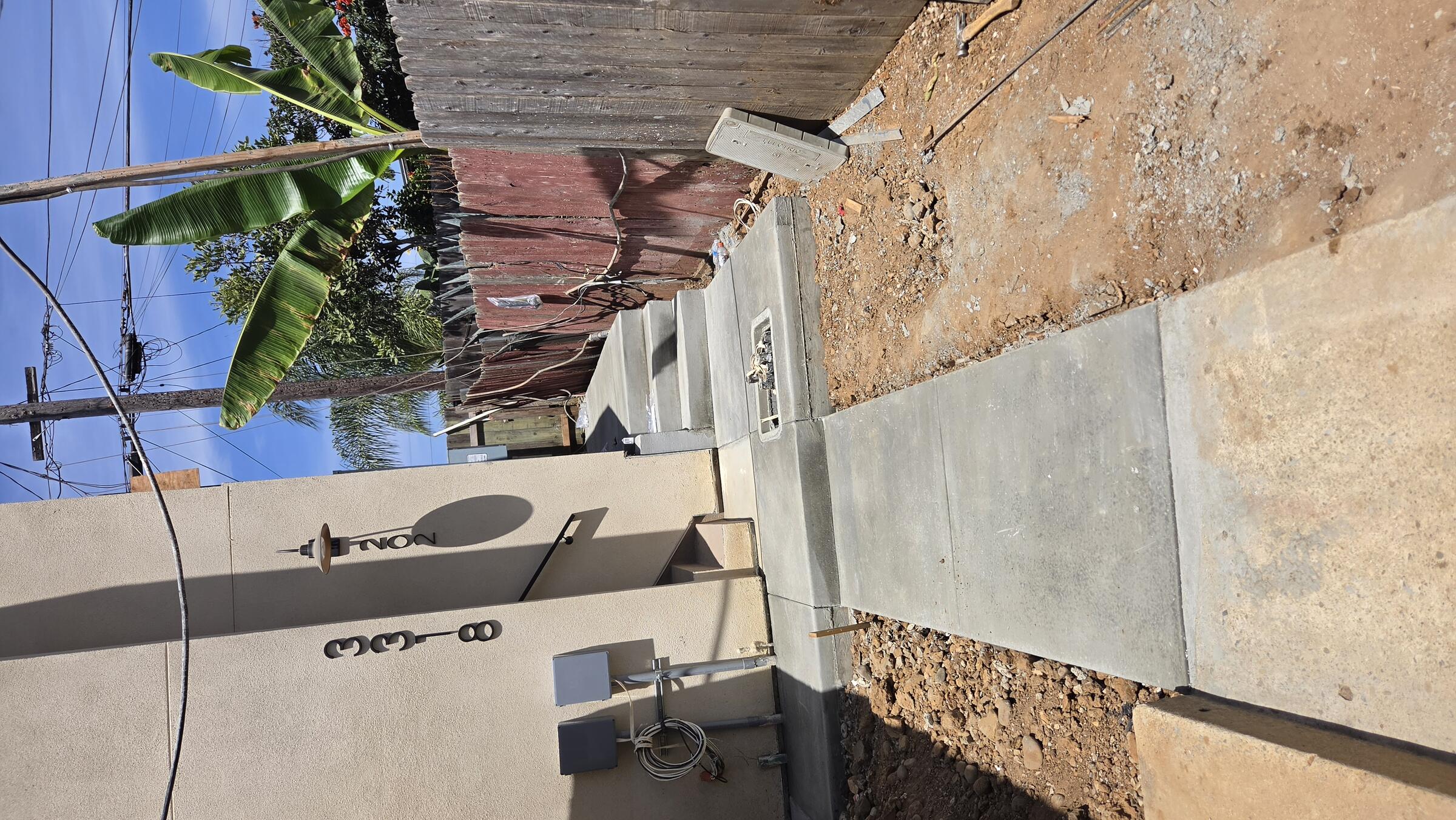

ZSP188

Inspection: ---
