Week of July 13 — July 17, 2026
5 days on site. 75 photos. Appliances, Cabinets, Countertops, DFH, Drywall, Electric, Flooring, Landscape, Paint, Plumbing, Site Concrete and Drainage, Stucco.
Monday, July 13, 2026
Partially cloudy, 78°F

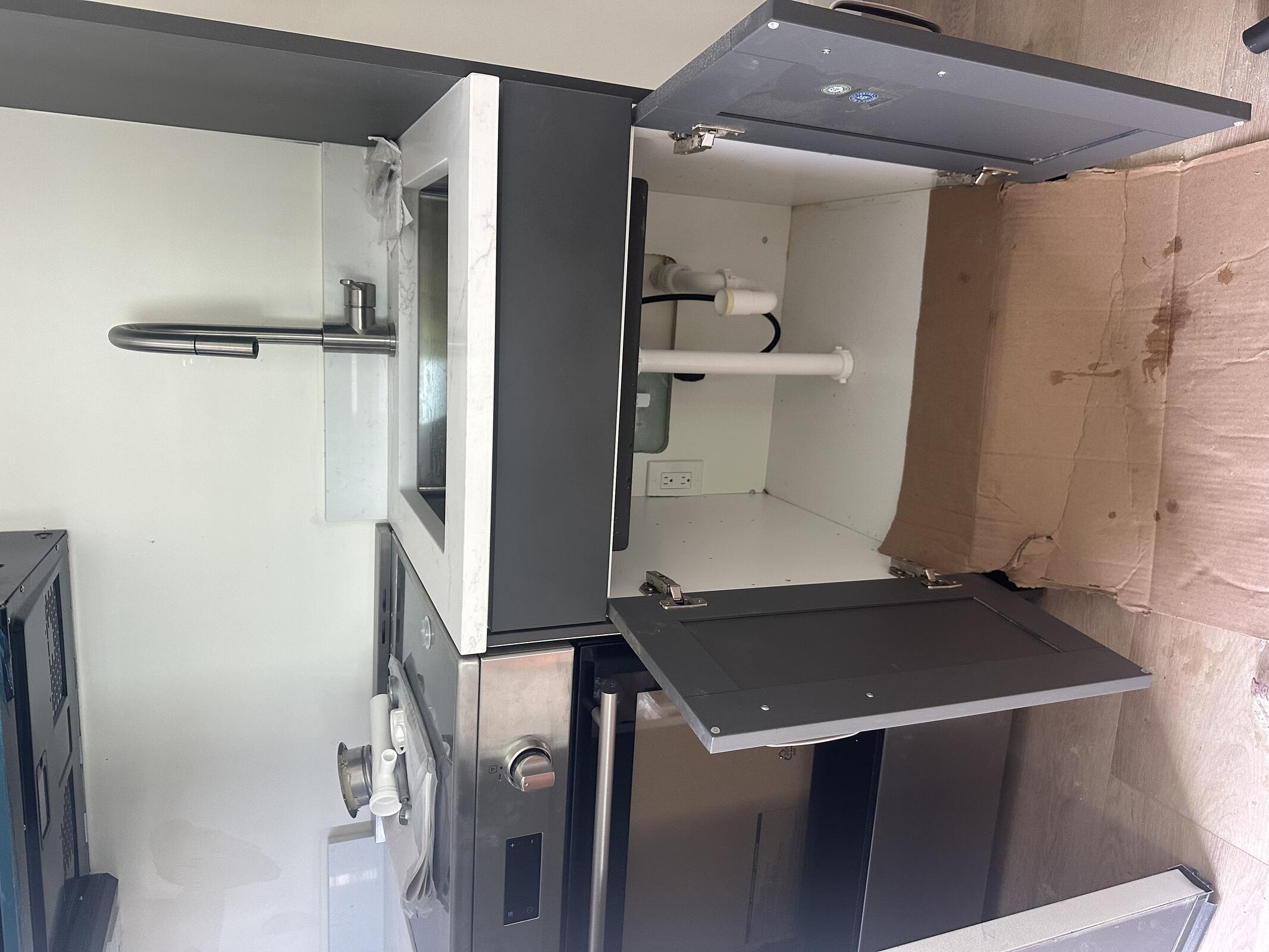

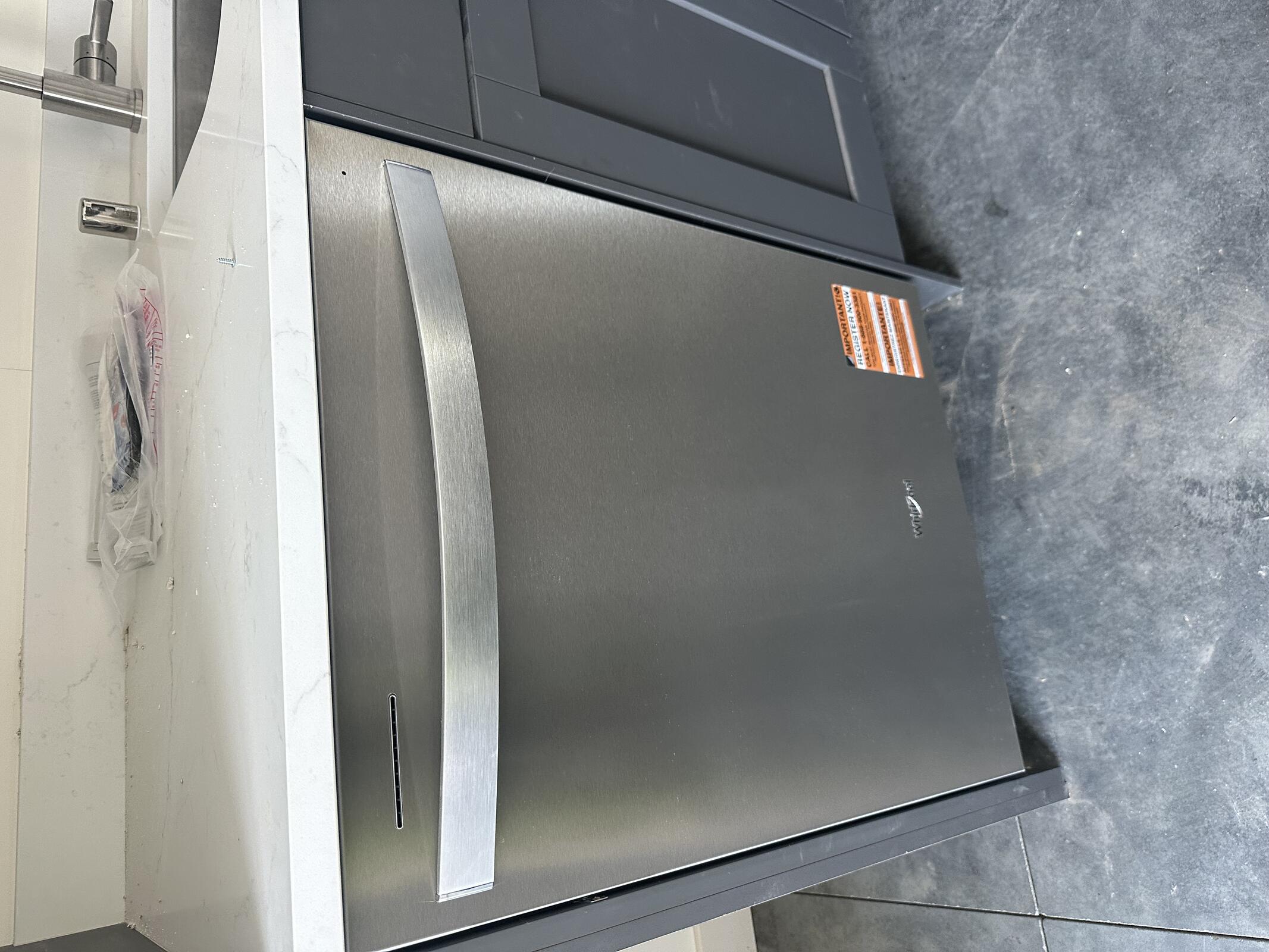

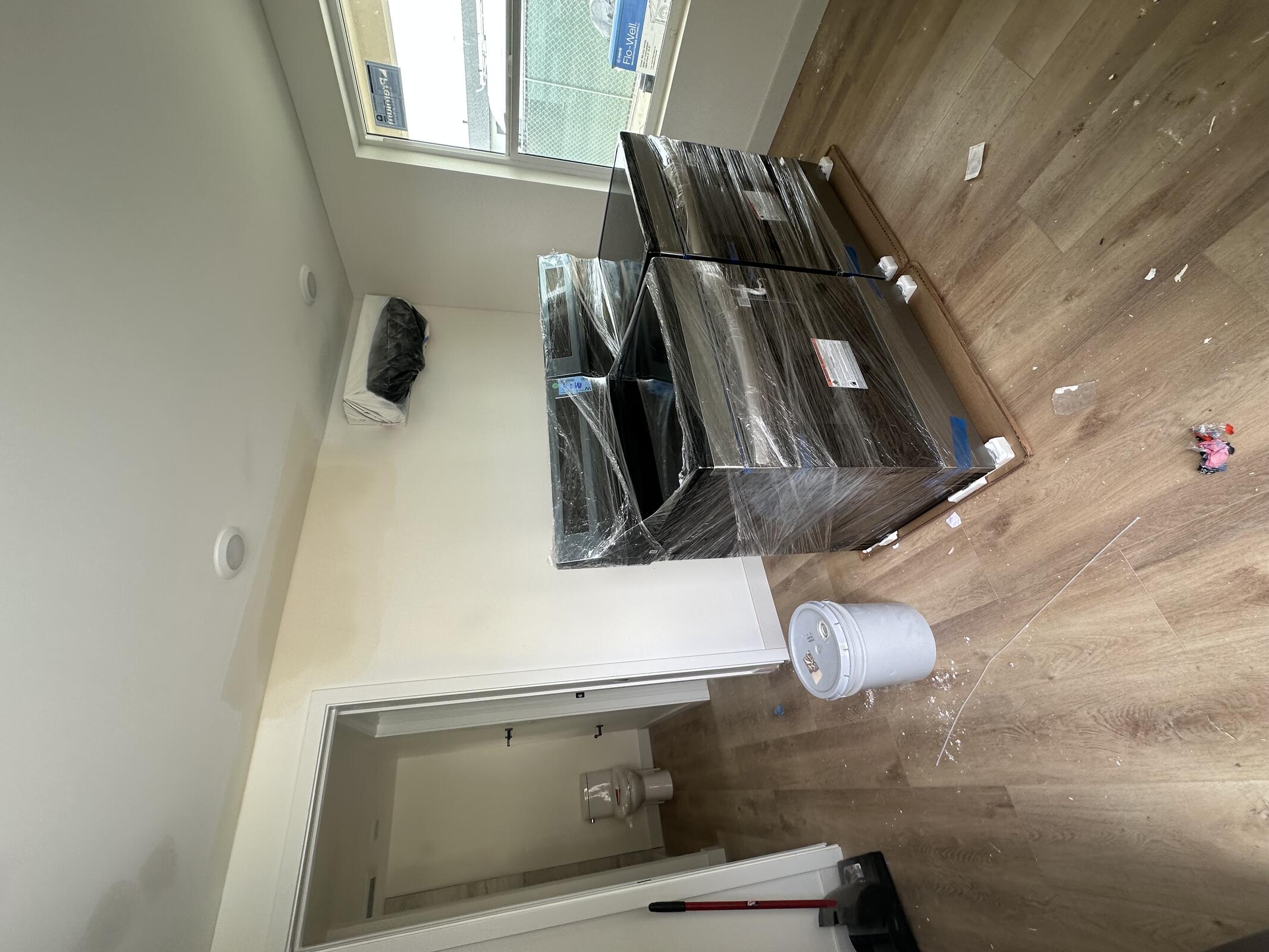

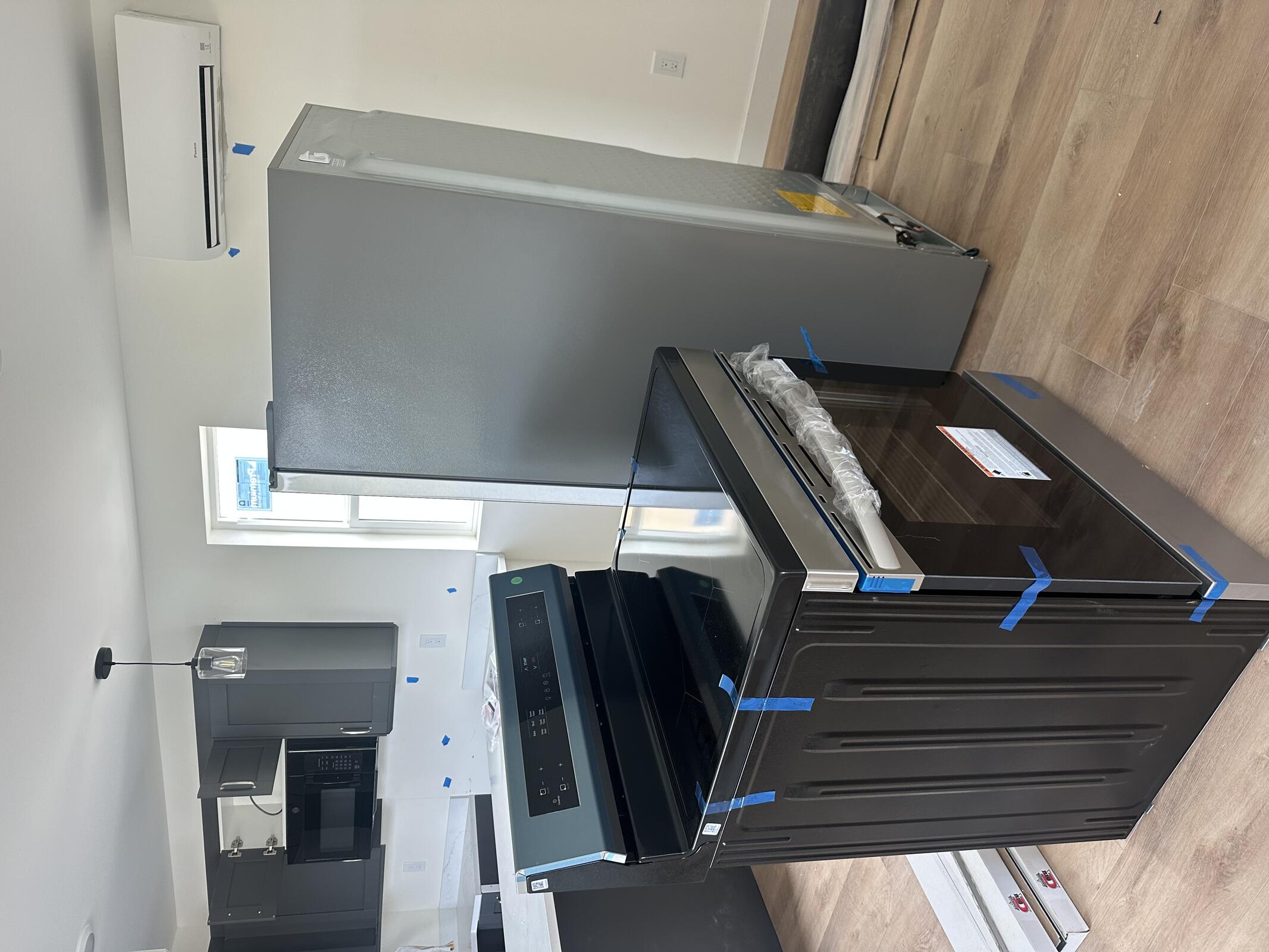

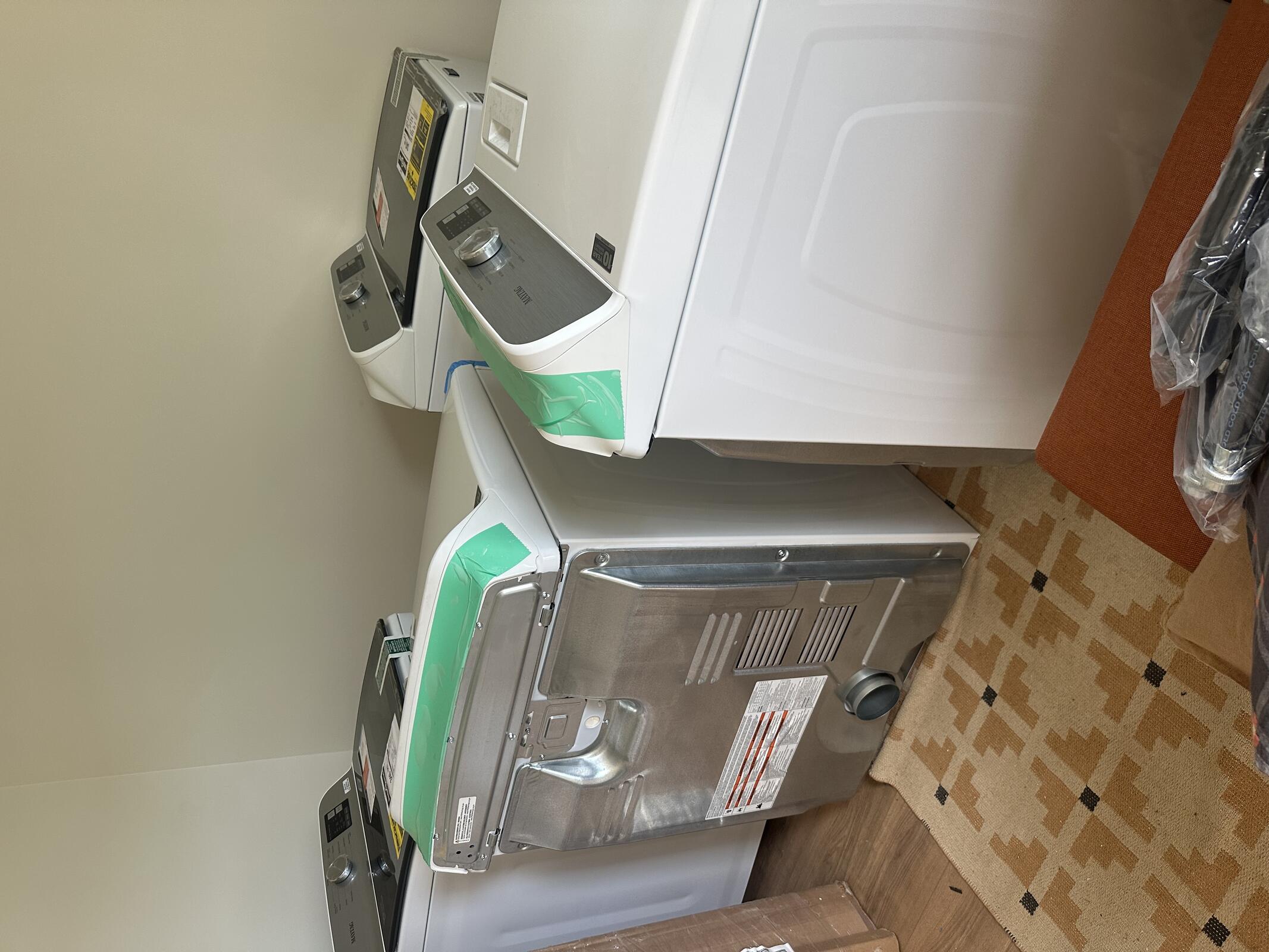

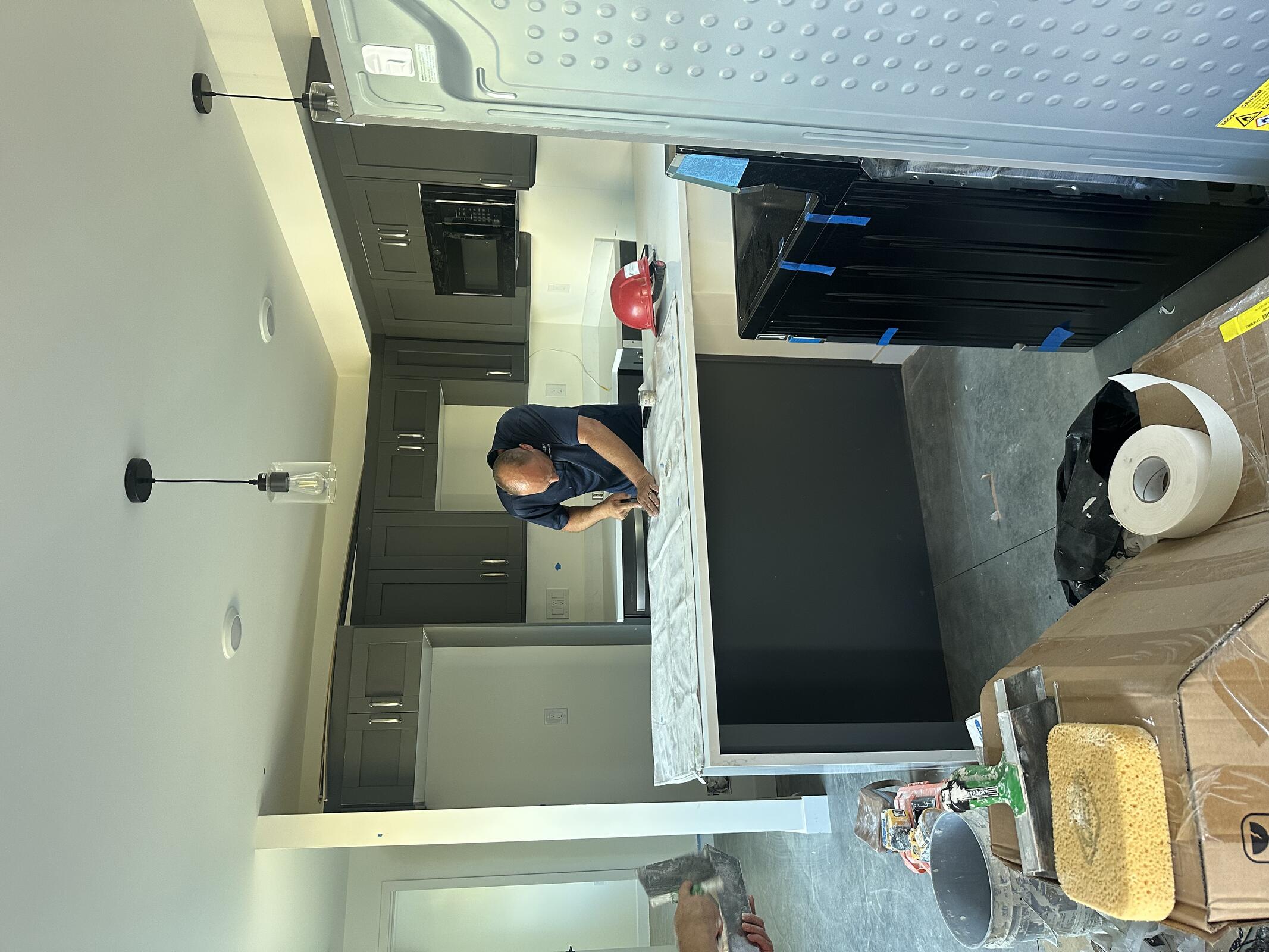

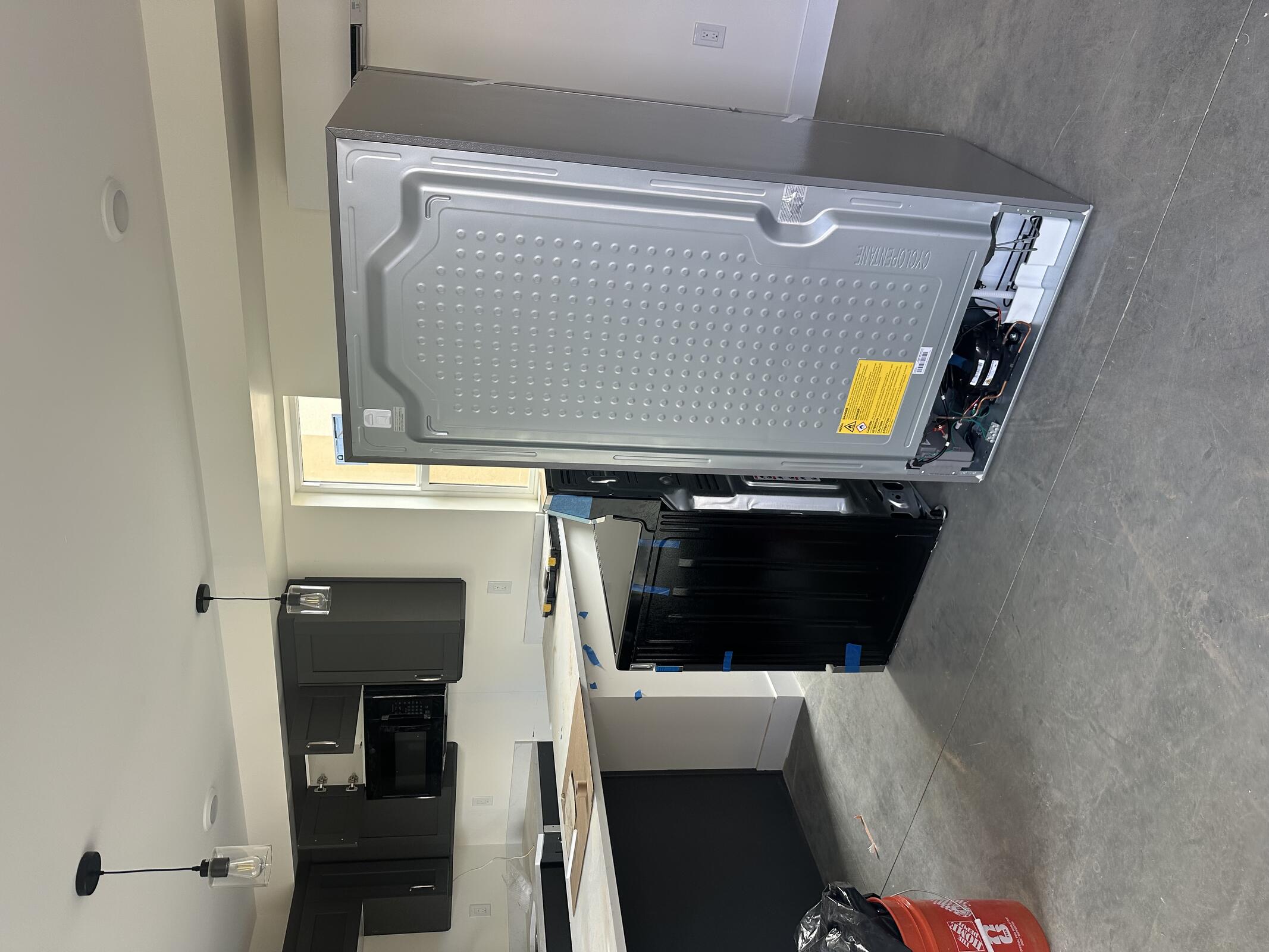

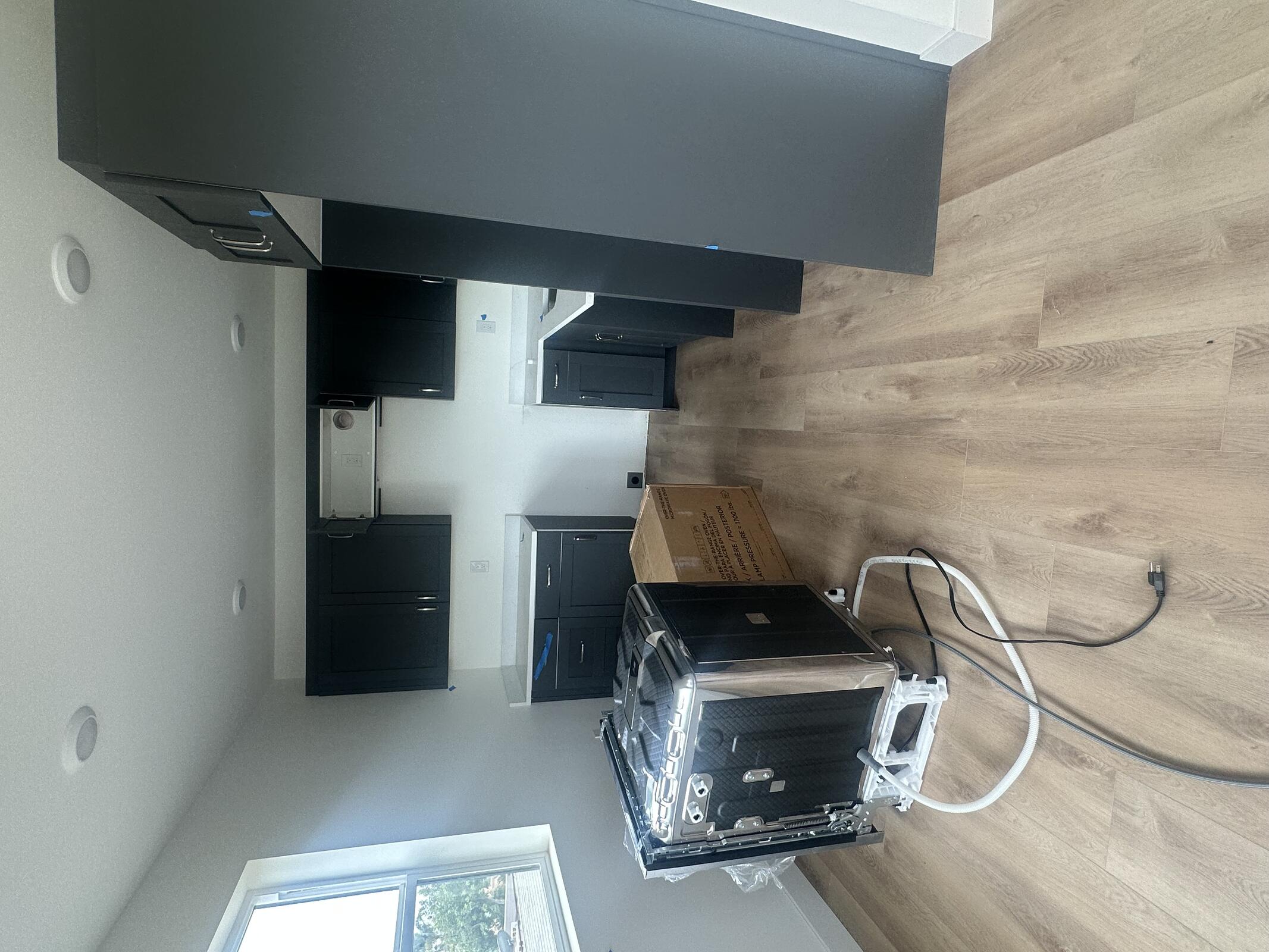

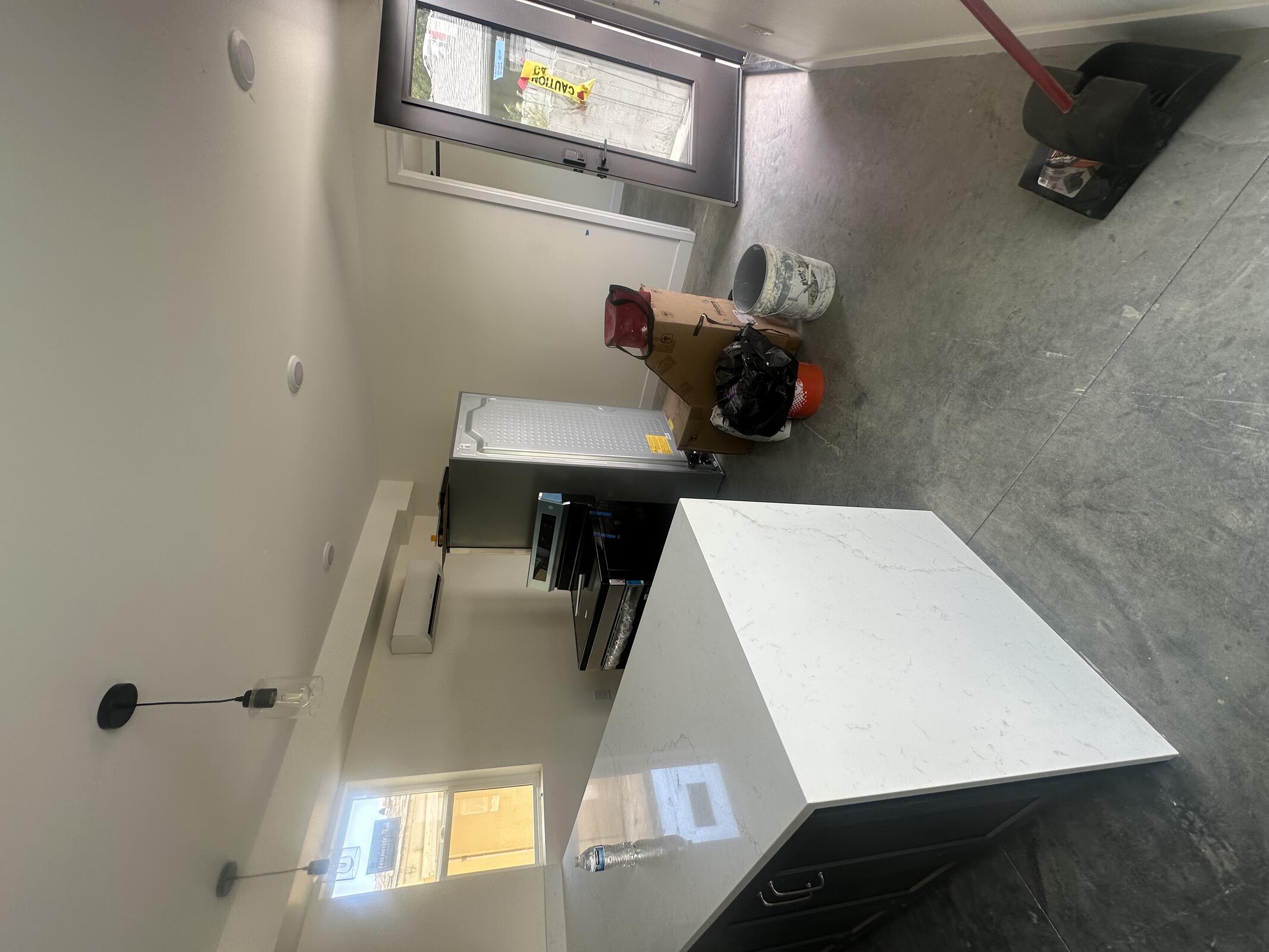

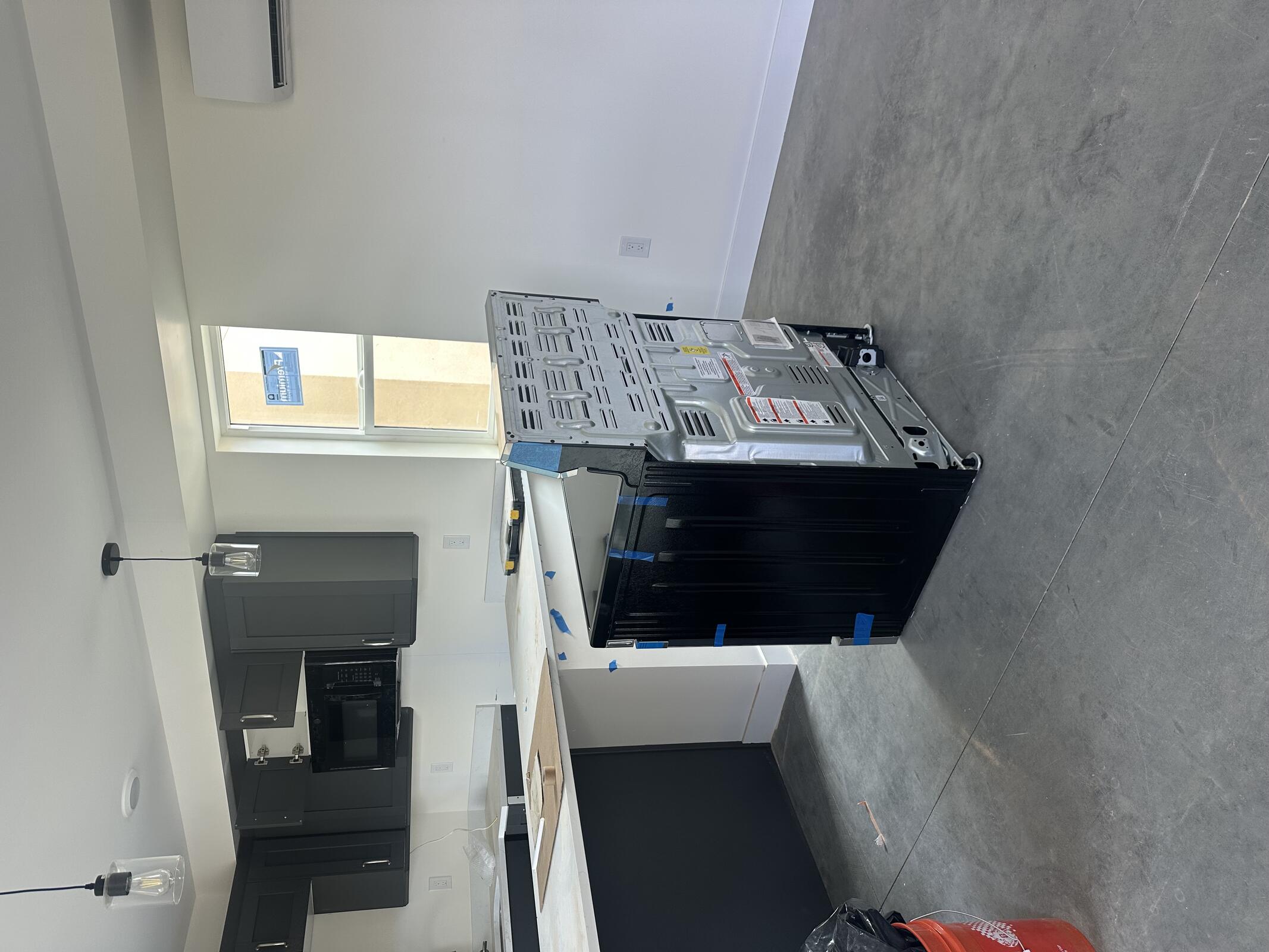

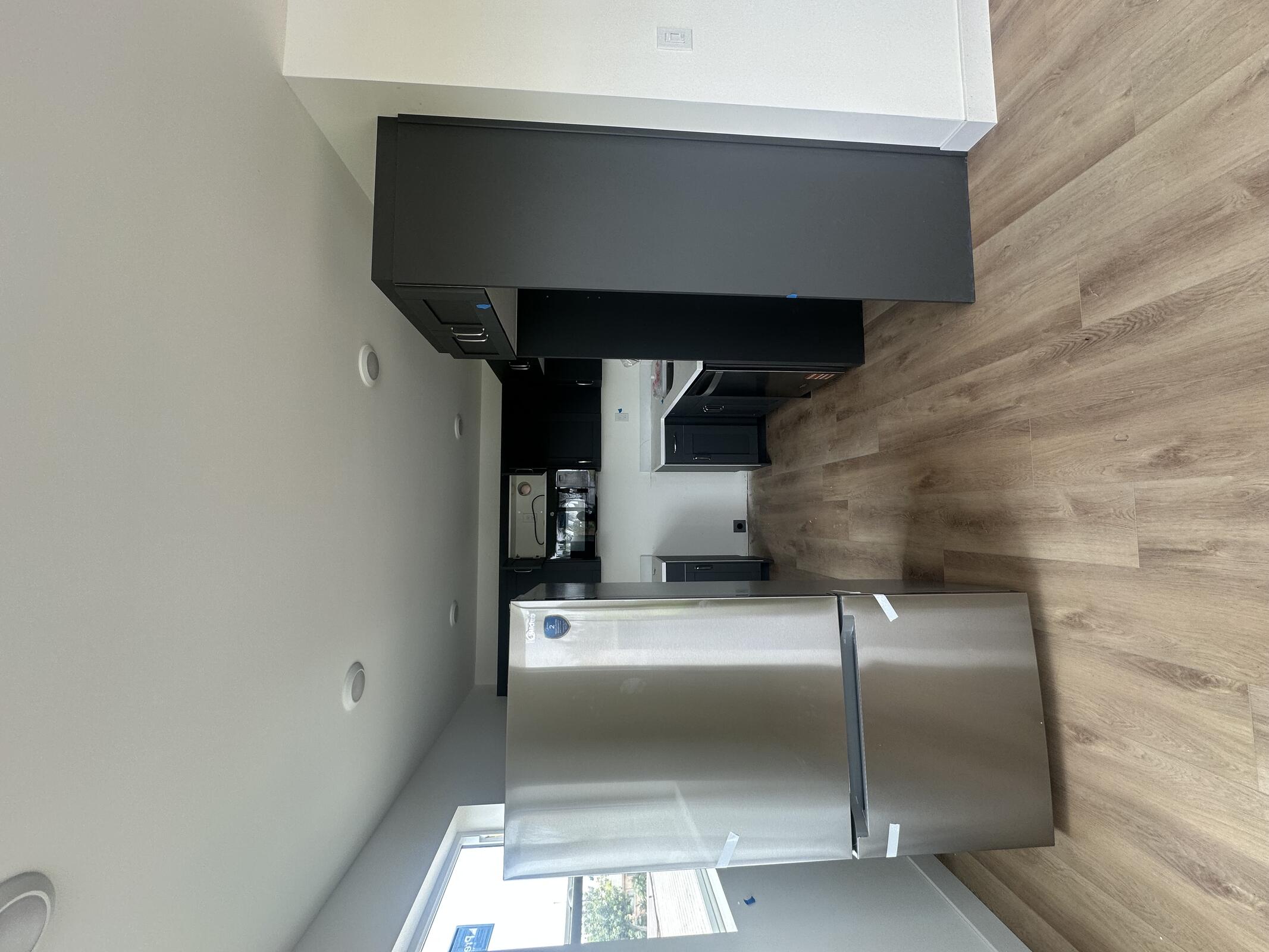

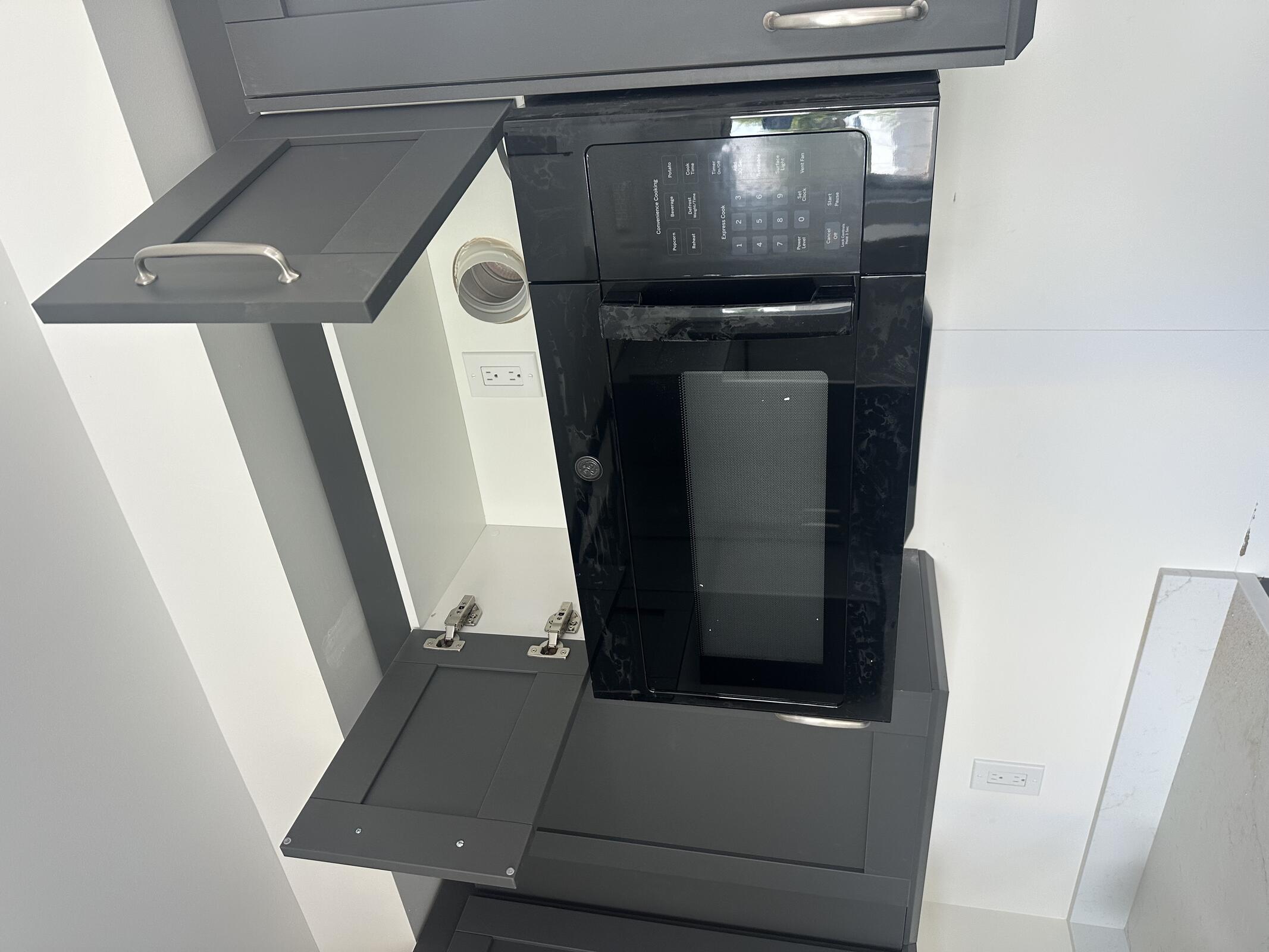

Costco and Lowe's on site to deliver washer/dryers and appliances for B and C. Washers and dryers put in front unit of existing duplex until electrical loads get sorted. Microwaves and Dishwashers installed at B1, B2, C1, C2. Refers dropped in all four units but not installed. Ranges only dropped off in Building C.

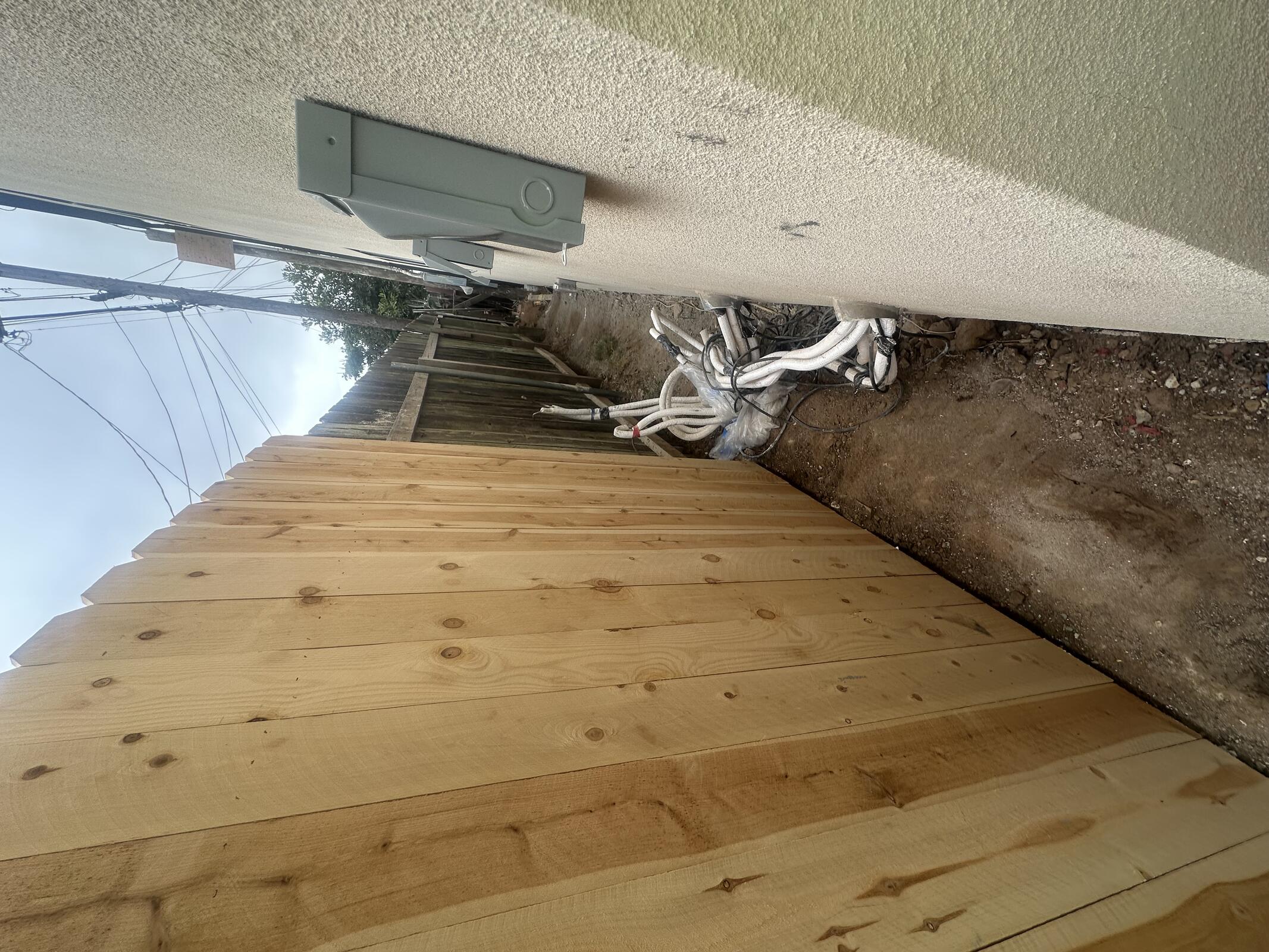

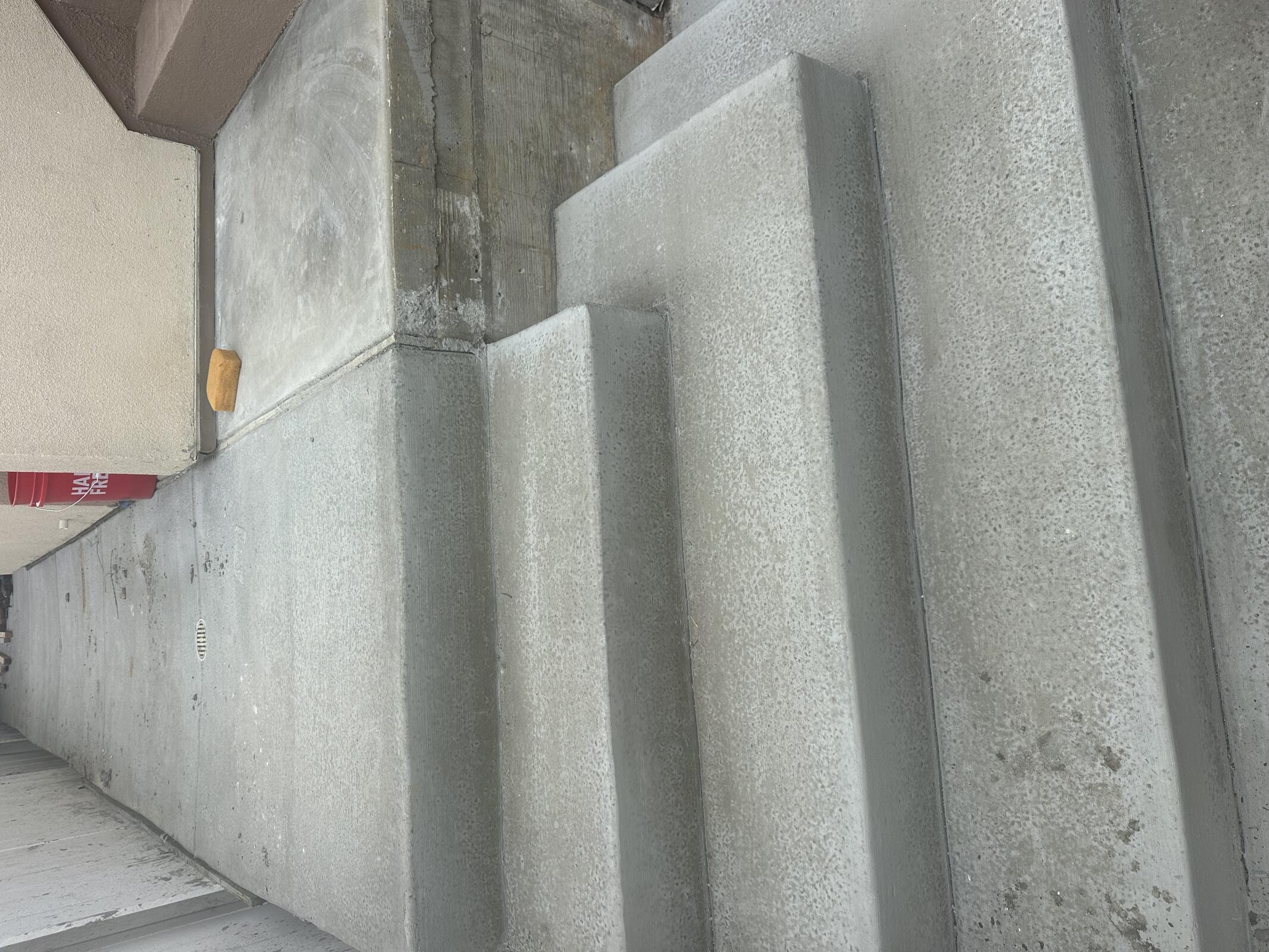

JBG continuing to work on fences and gates. Striping forms from Saturday's pour.

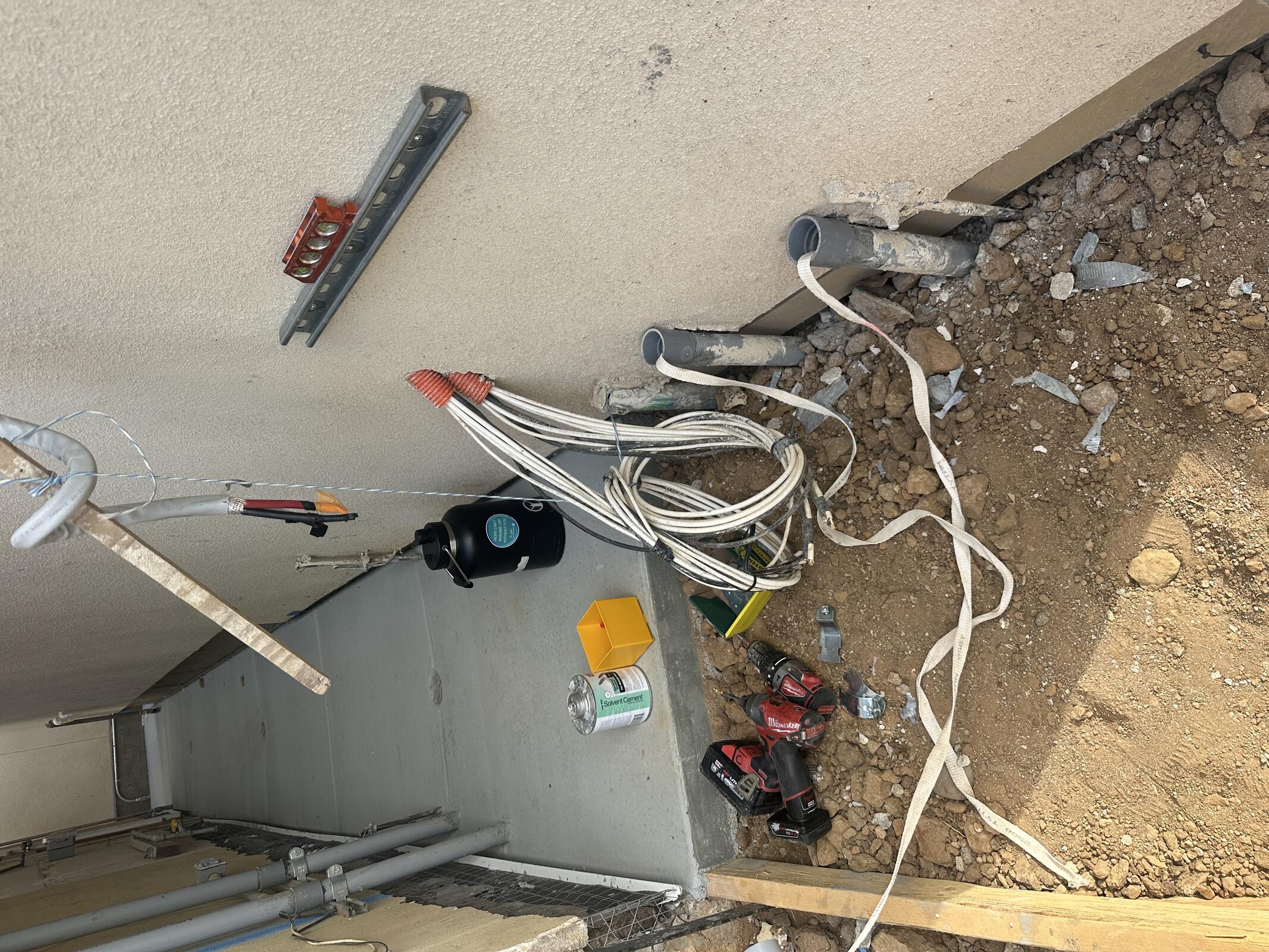

ZSP digging trench and connecting new units to water main.

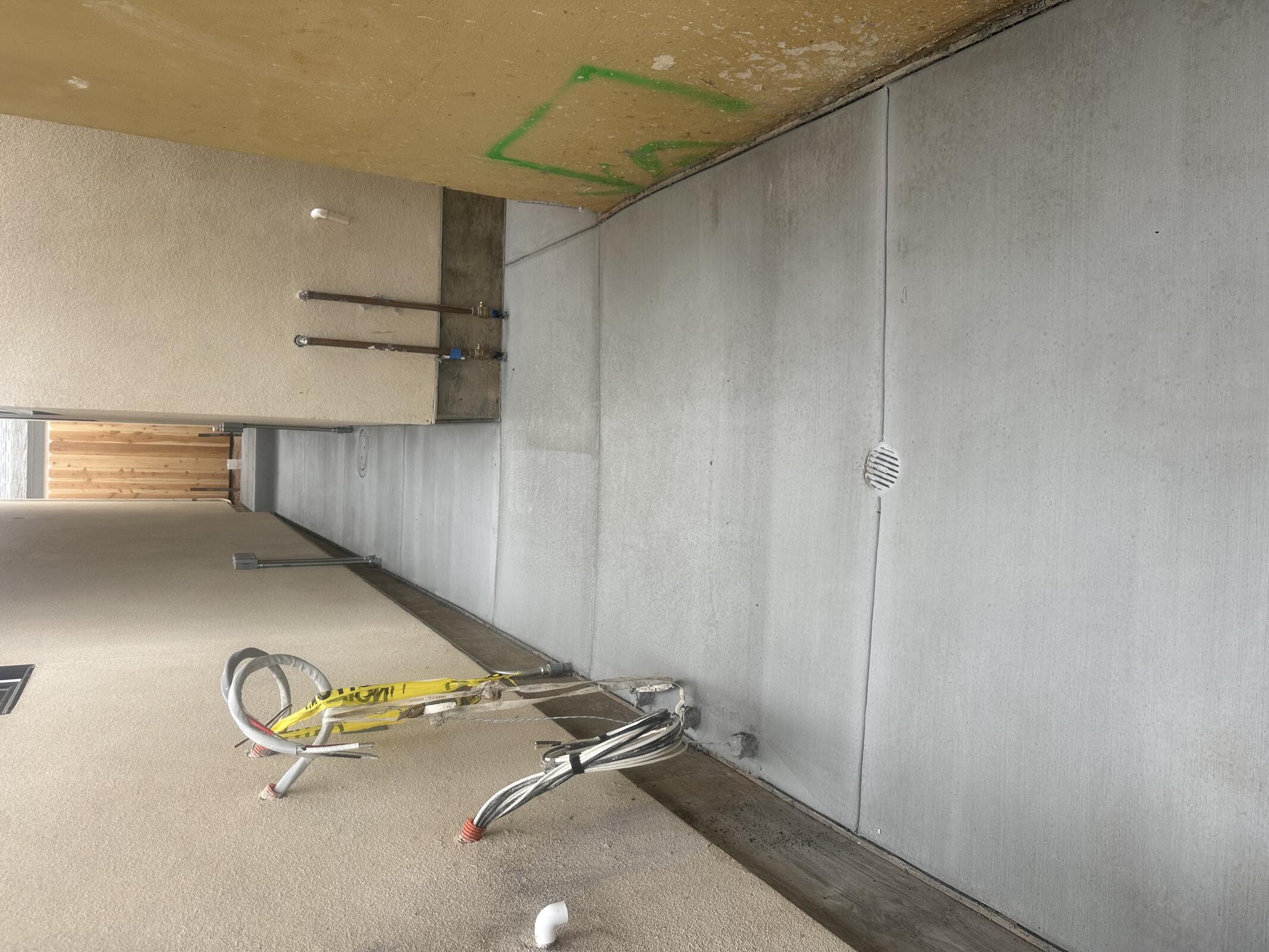

AC Electric completing more pick up items.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| JBG | 2 | 8 | 16 |
| AC Electric | 0.5 | 8 | 4 |
| ZSP | 1 | 8 | 8 |
Inspection: N/A
Delay: Pending electric coordination.

















Tuesday, July 14, 2026
Clear, 72°F

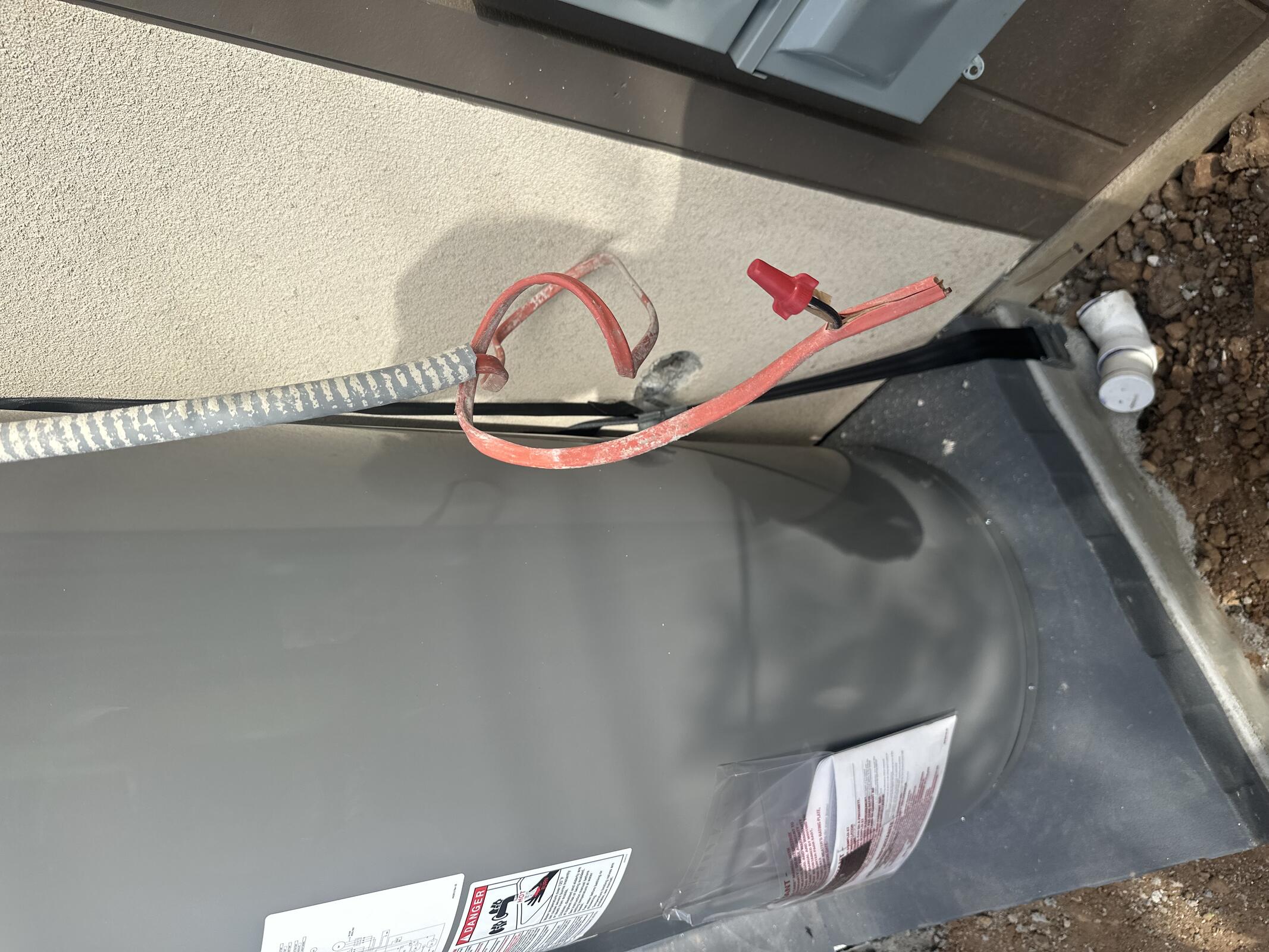

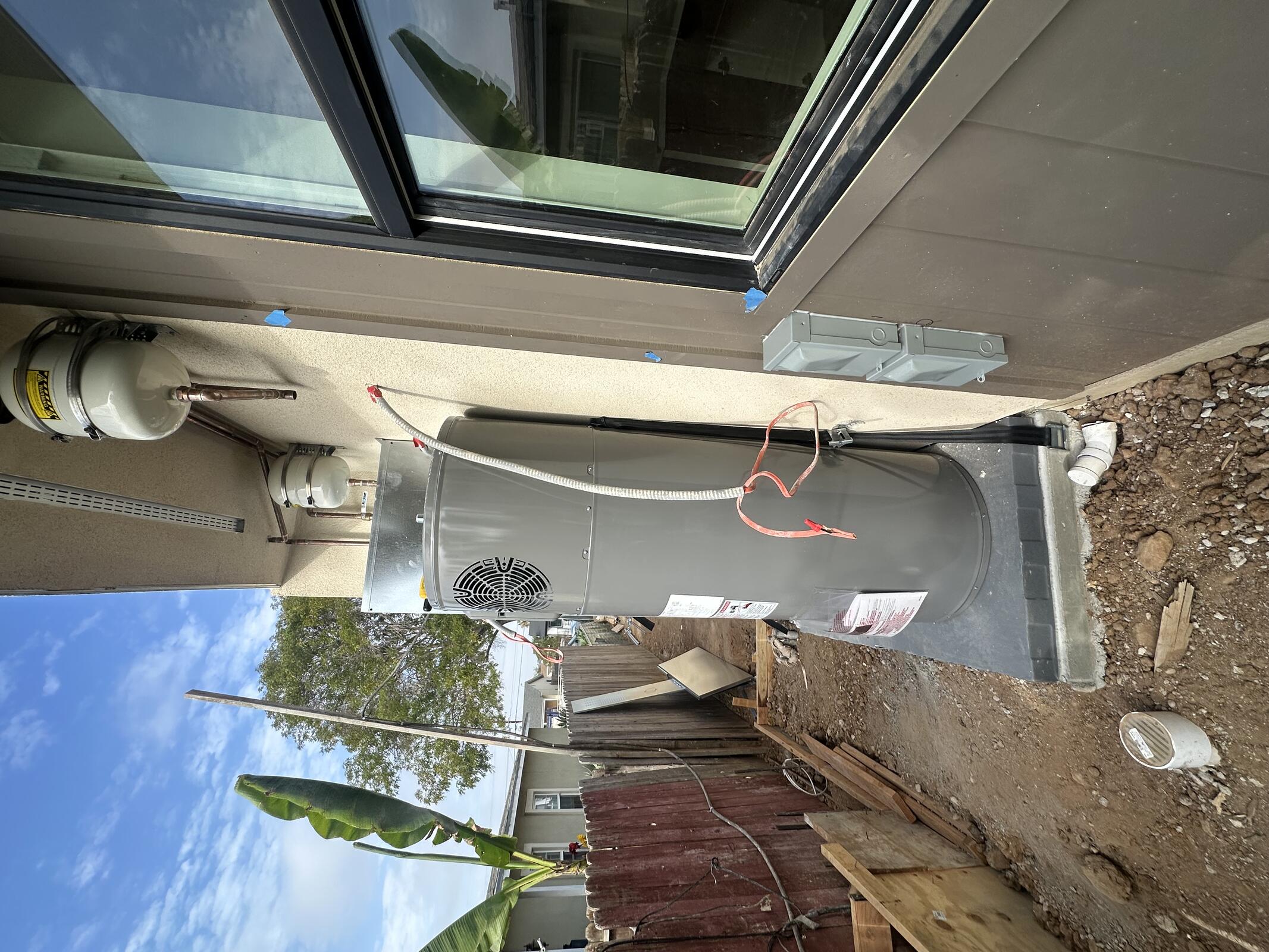

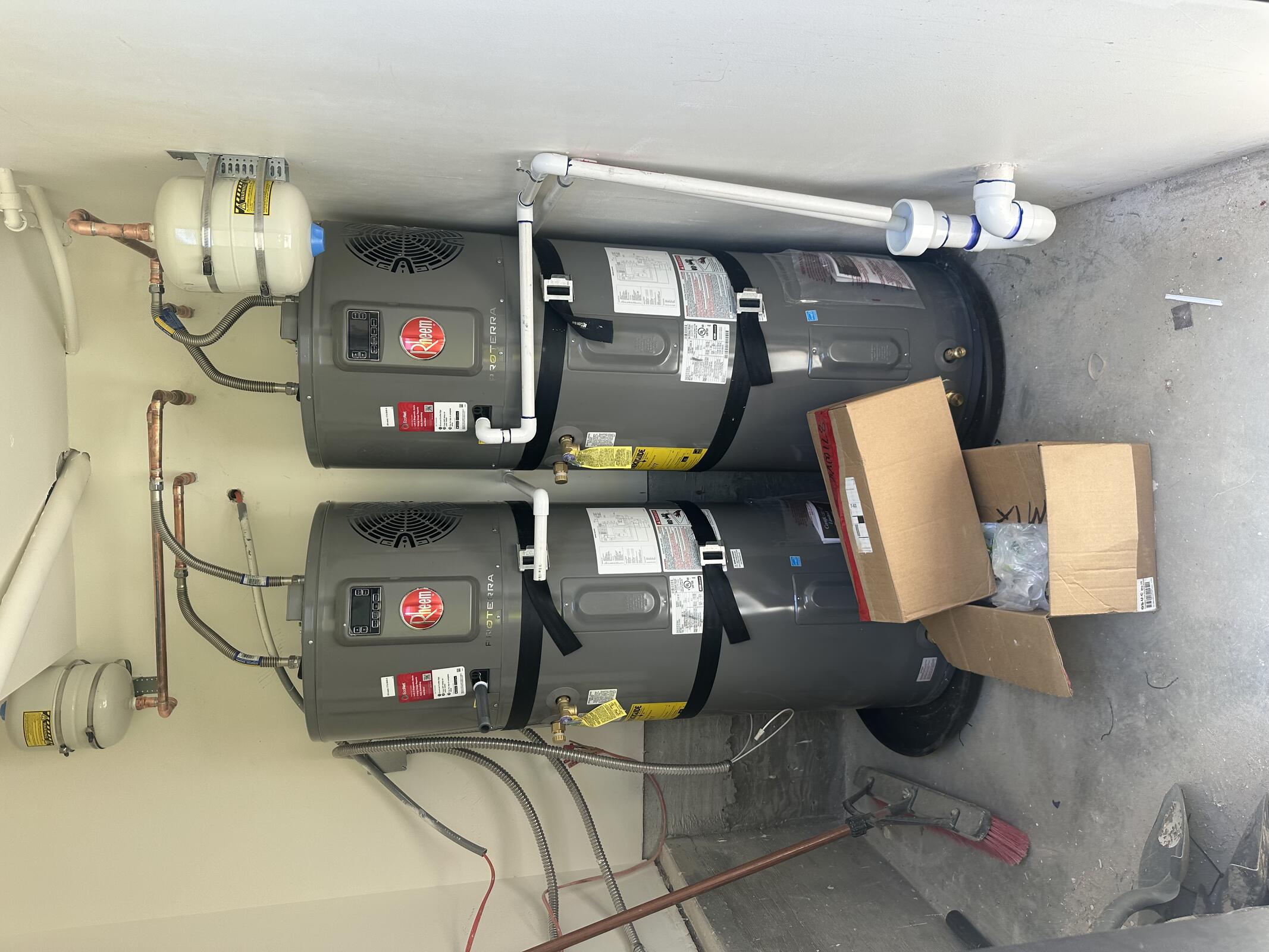

ZSP installing water heaters and continuing trim out.

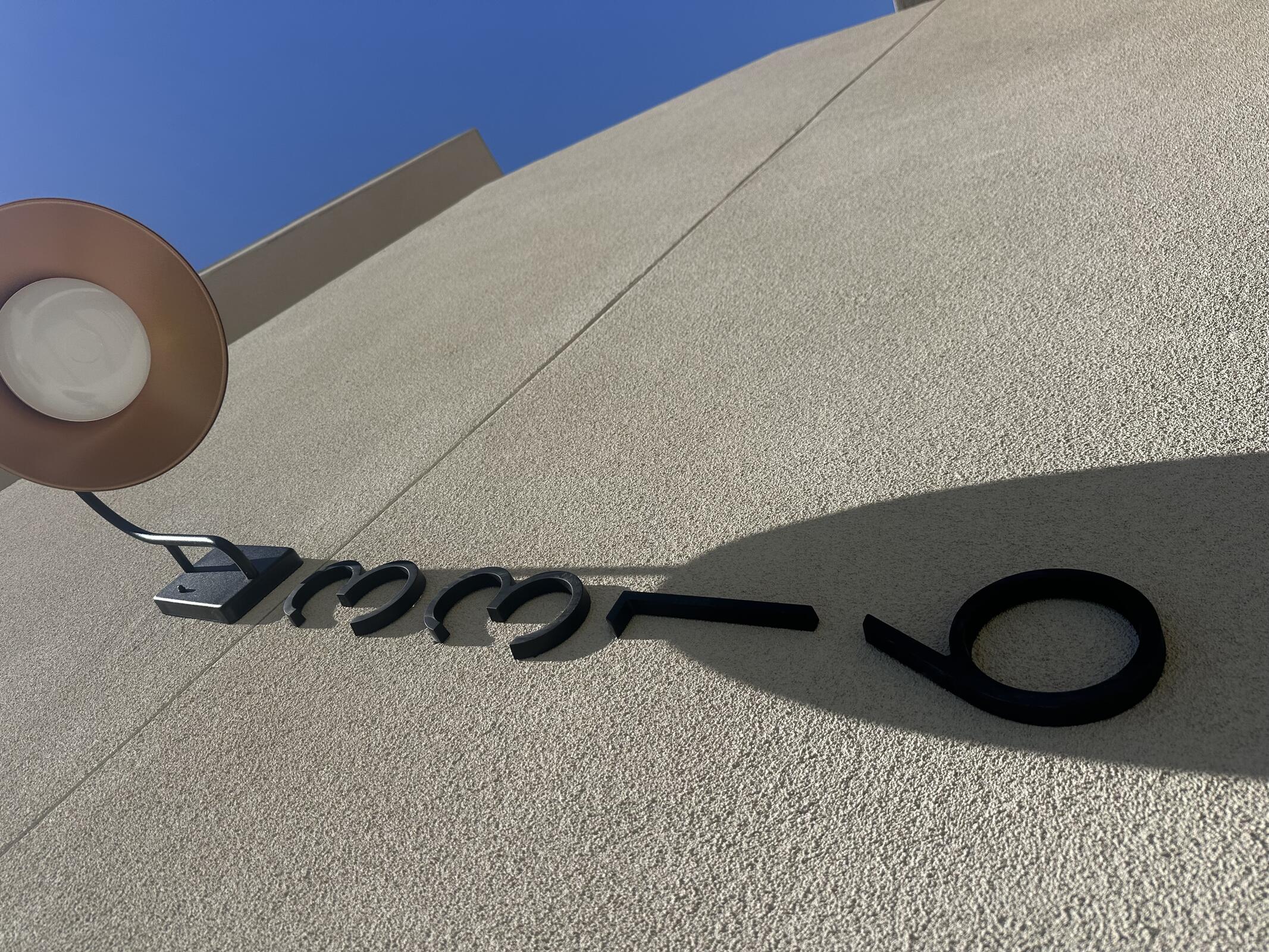

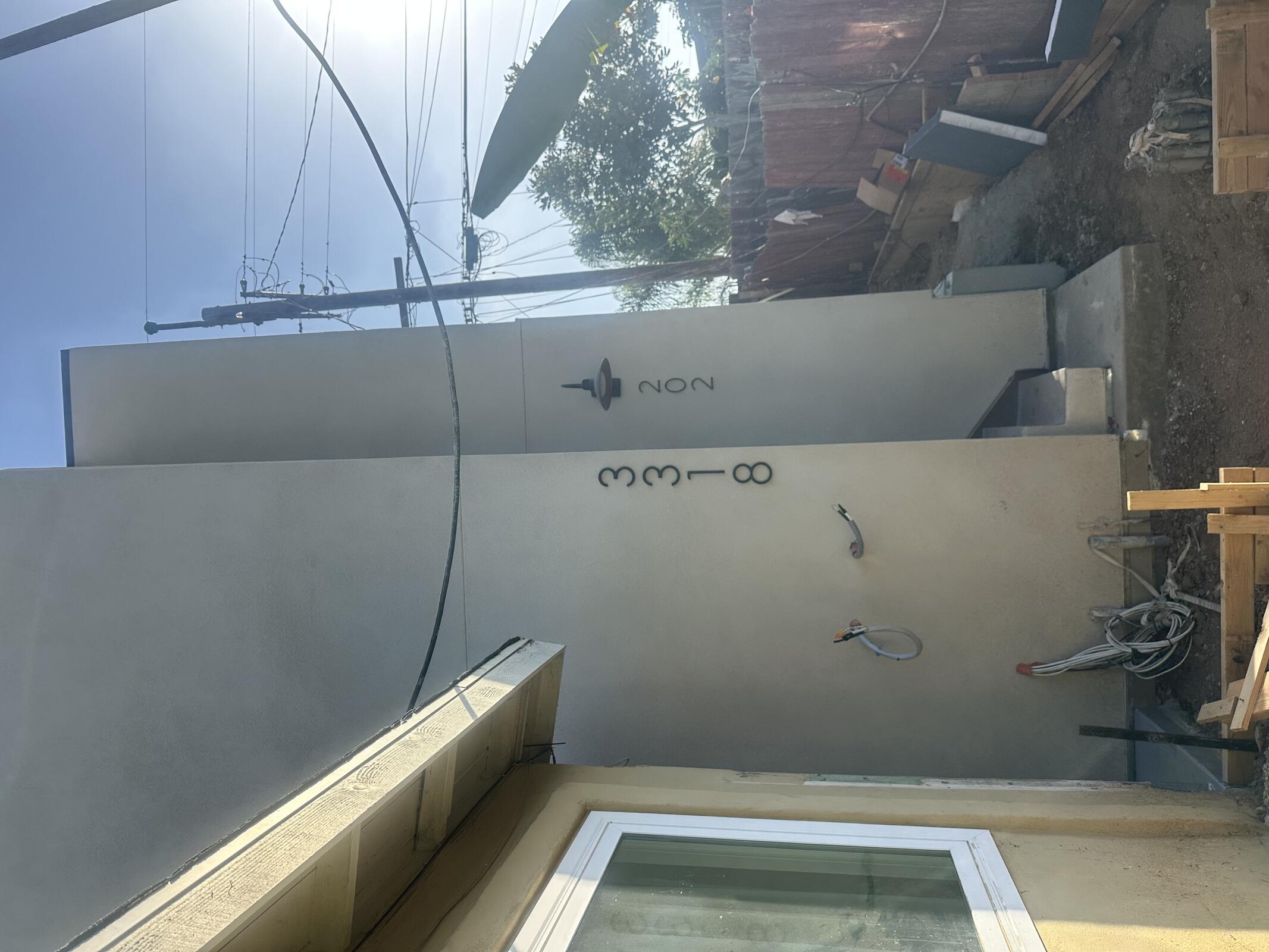

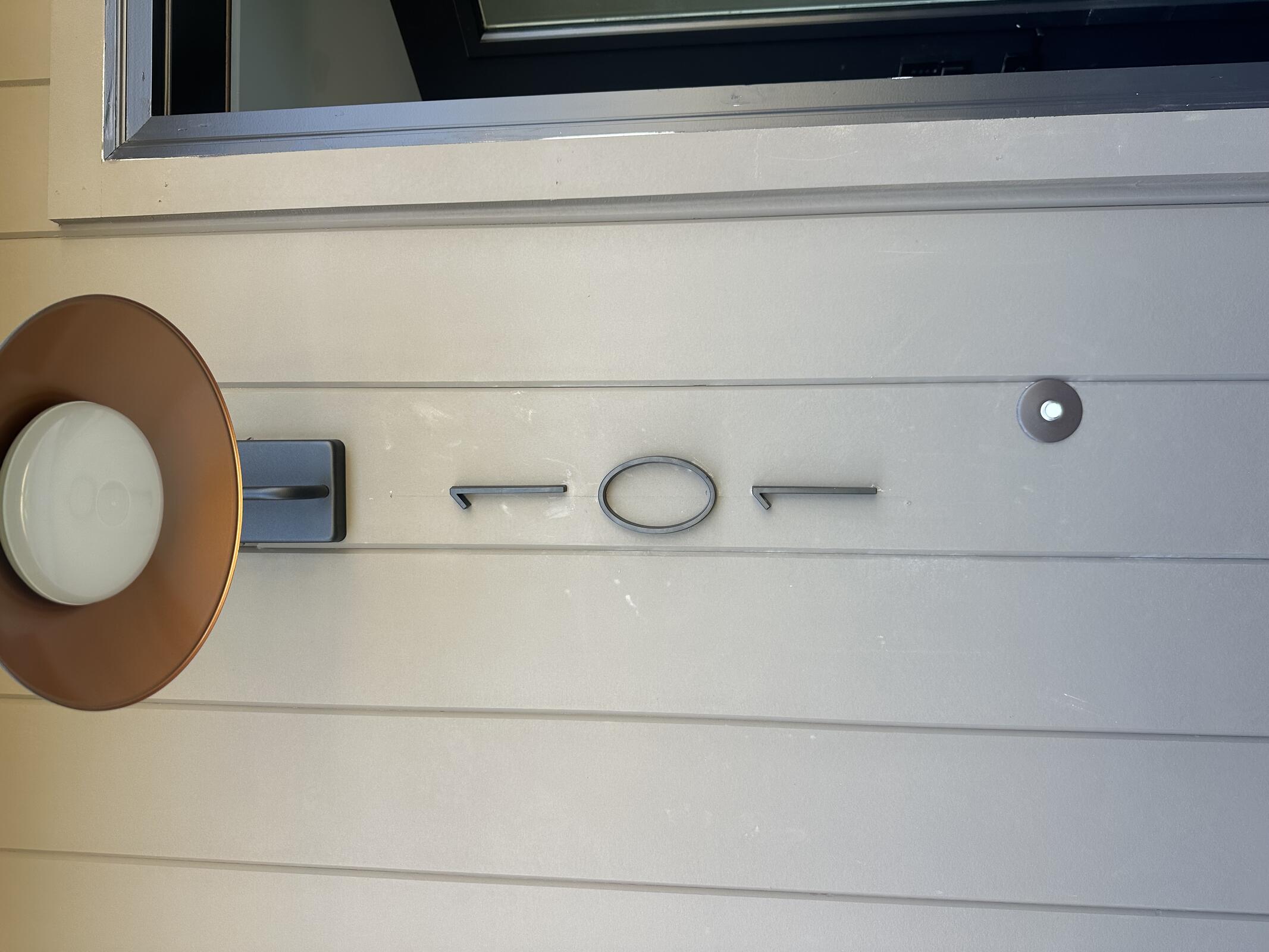

Taylor Trim installing remaining door hardware, threshold, weatherproofing, building and unit numbers.
Traditions working on punch list and repairing trade damage.

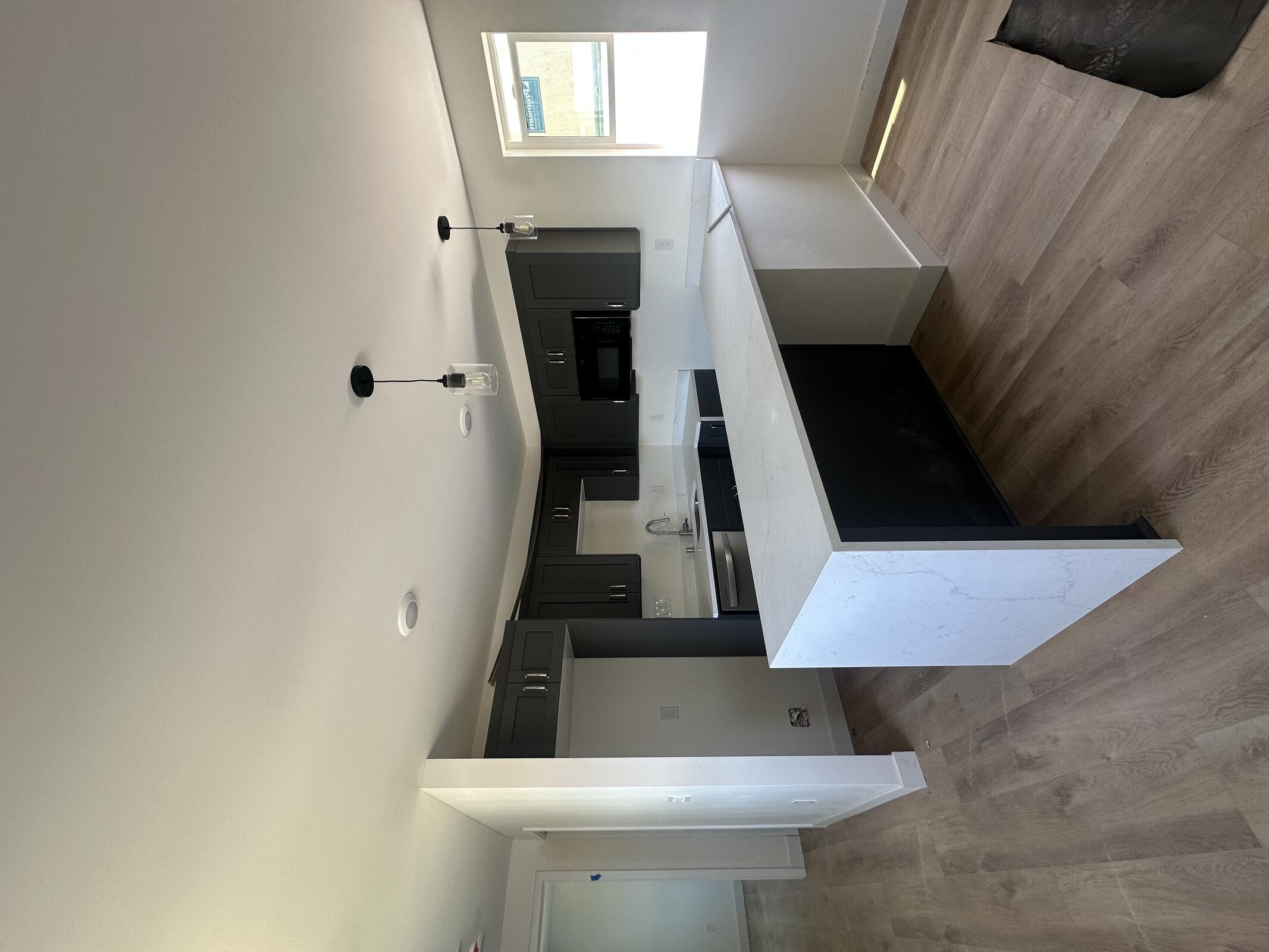

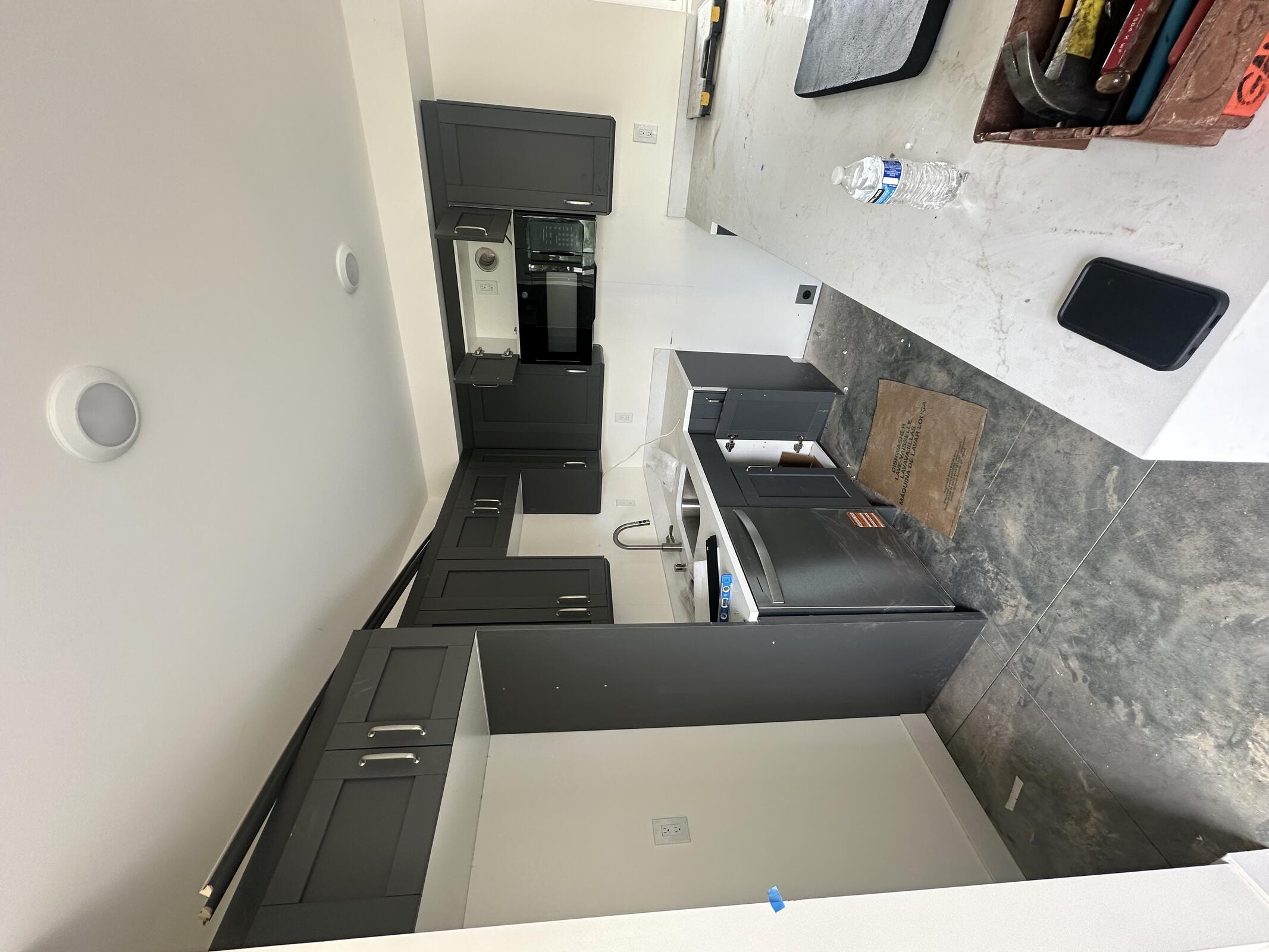

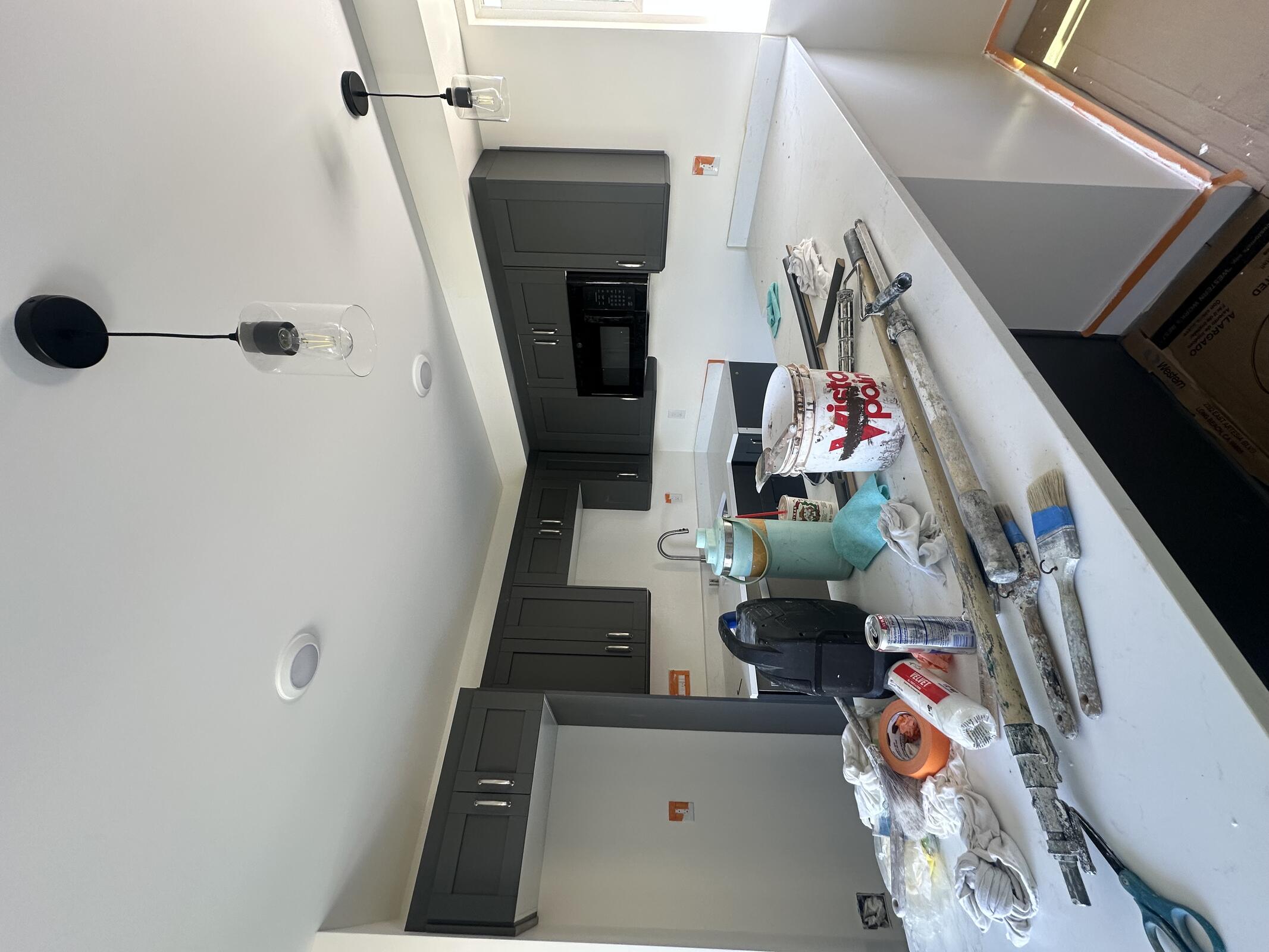

Marjan cleaning countertops and caulking.
Blue Tape walk with Paige around 11:30 AM.

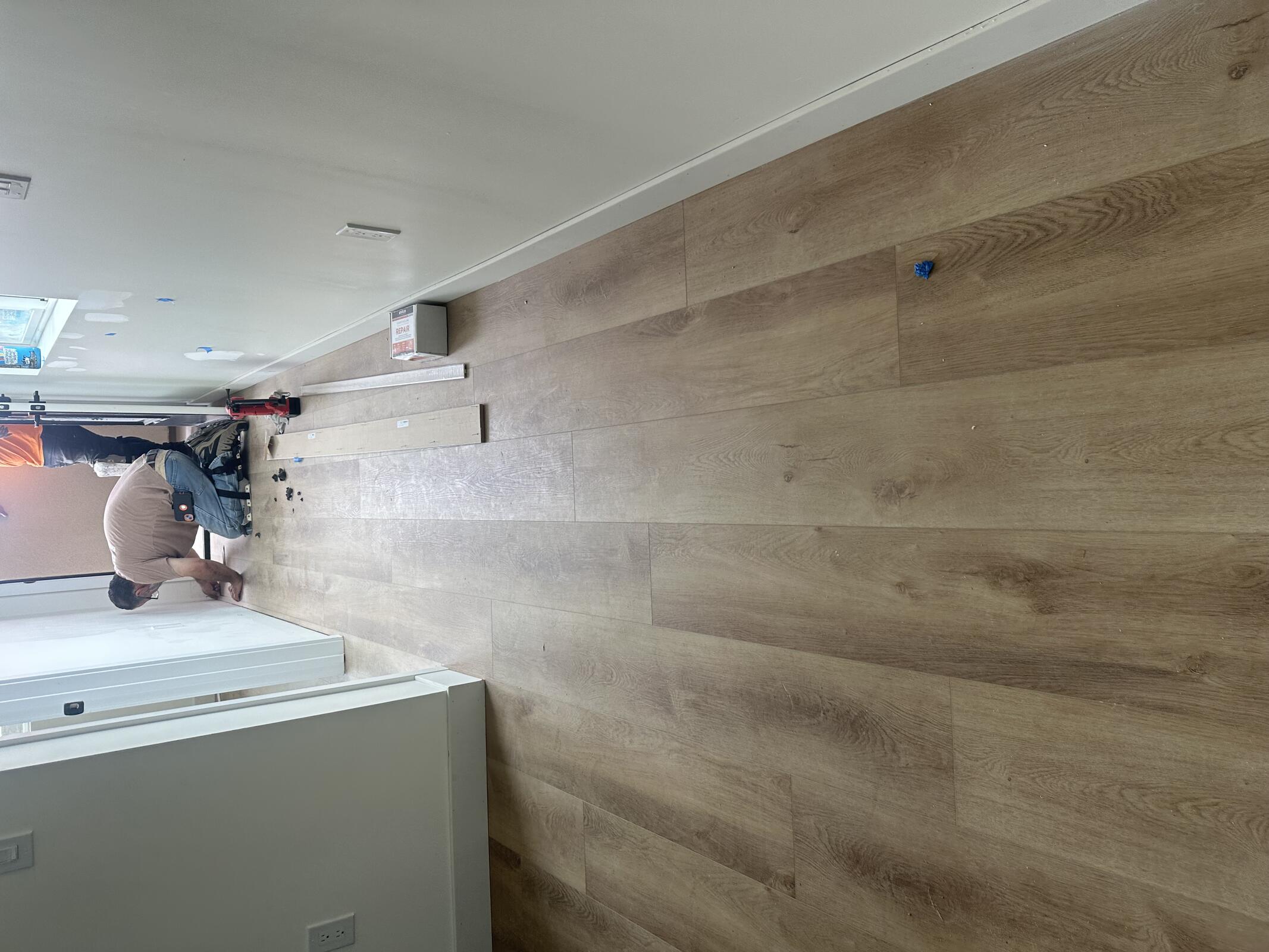

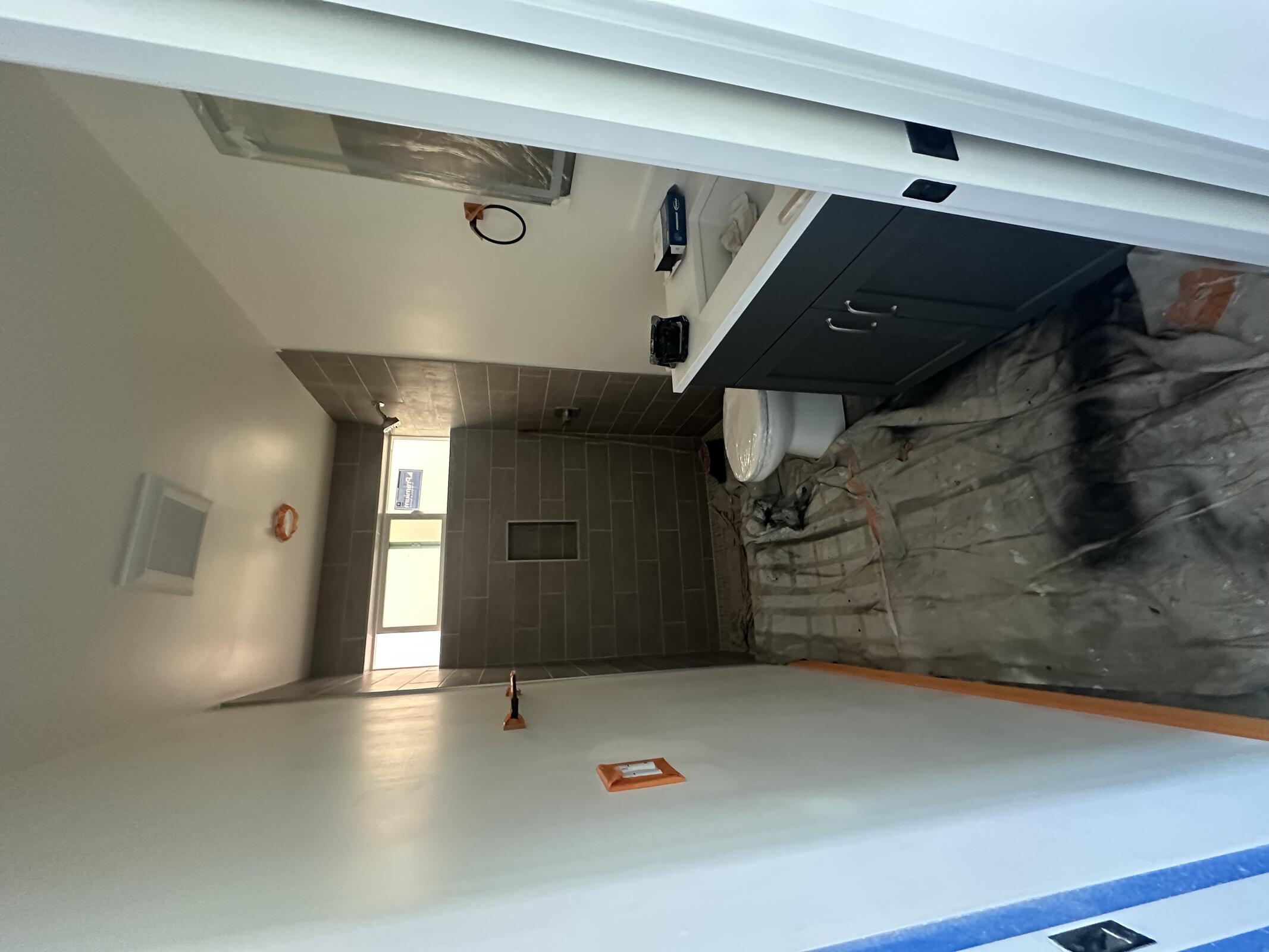

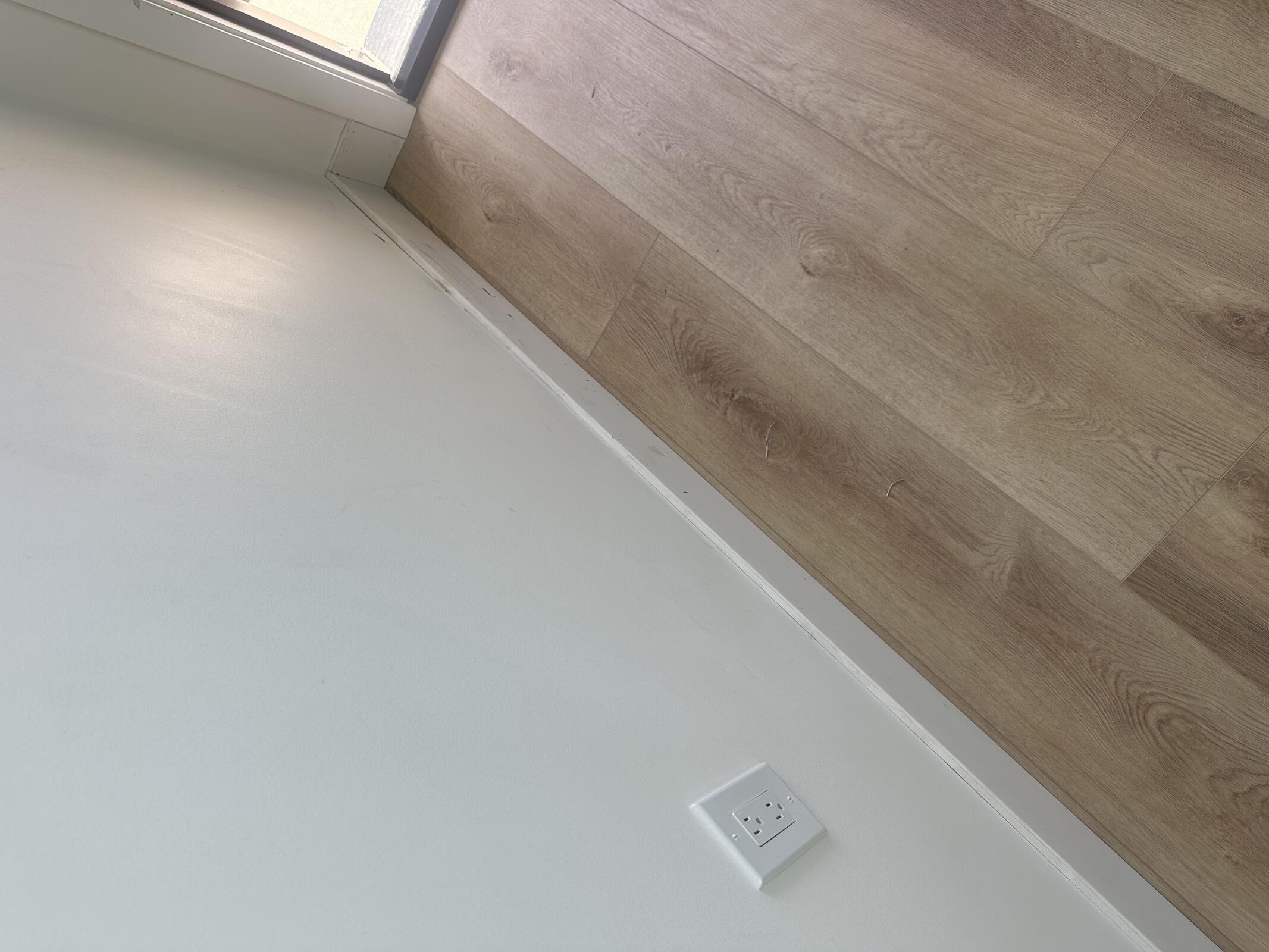

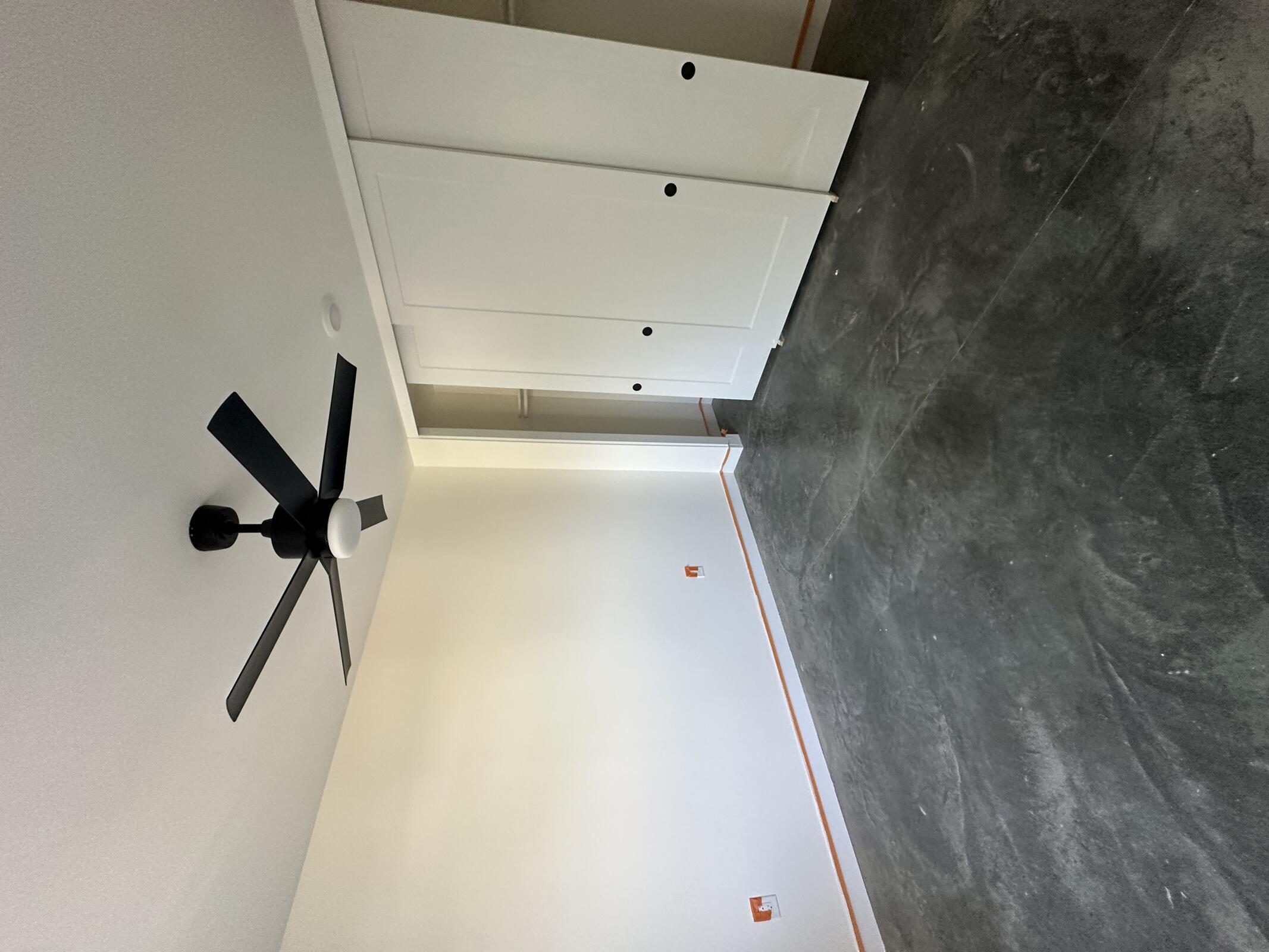

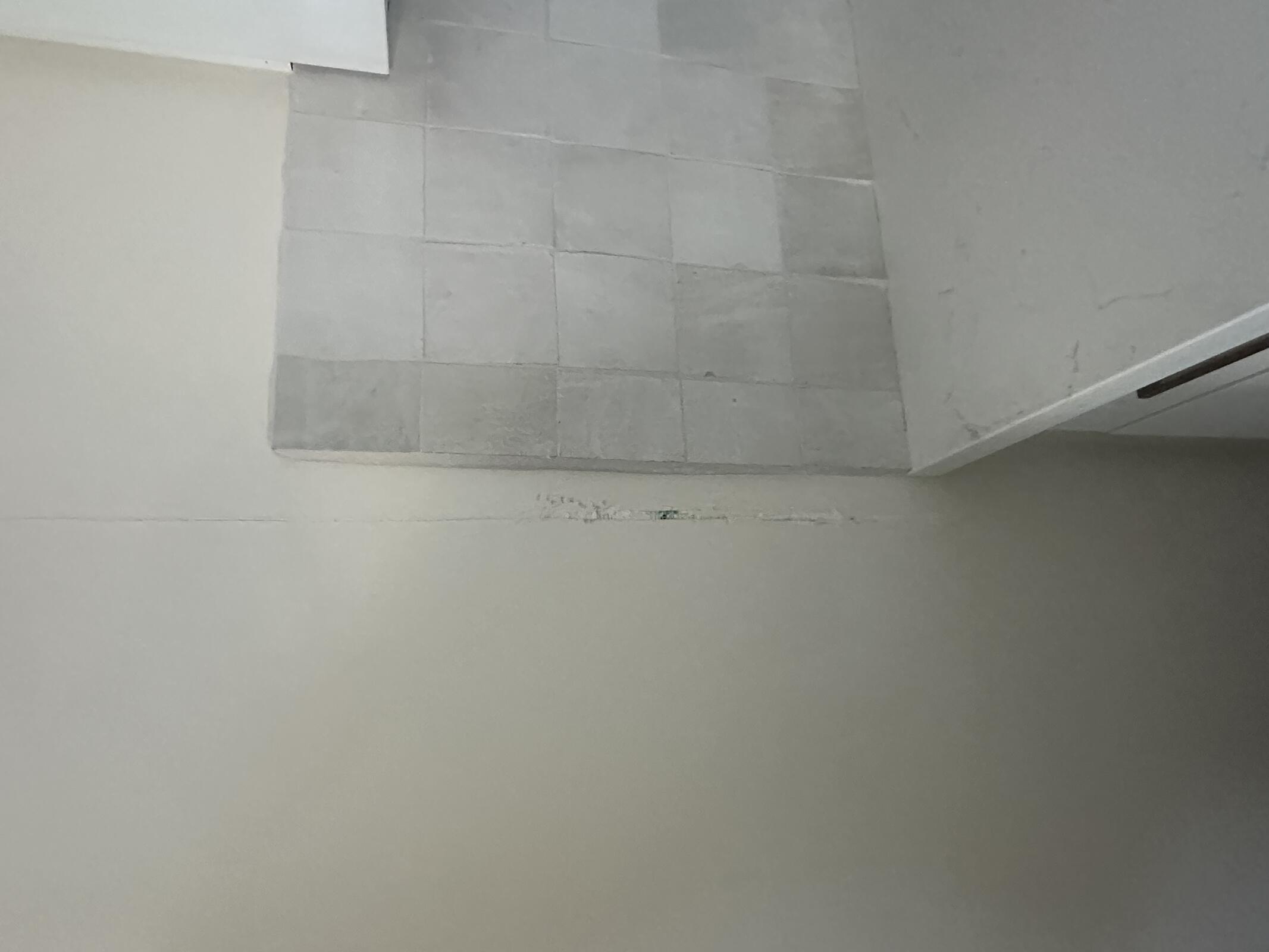

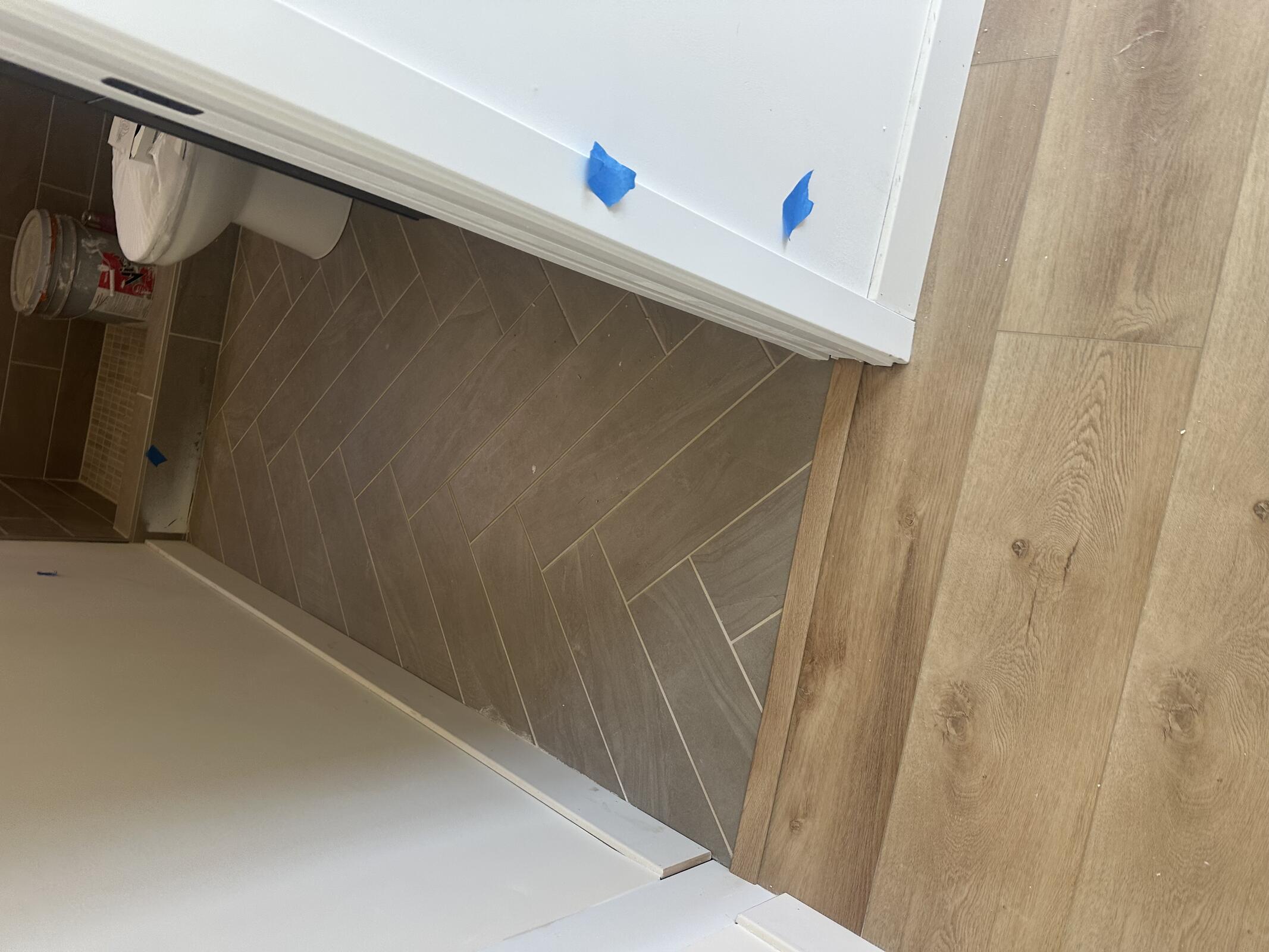

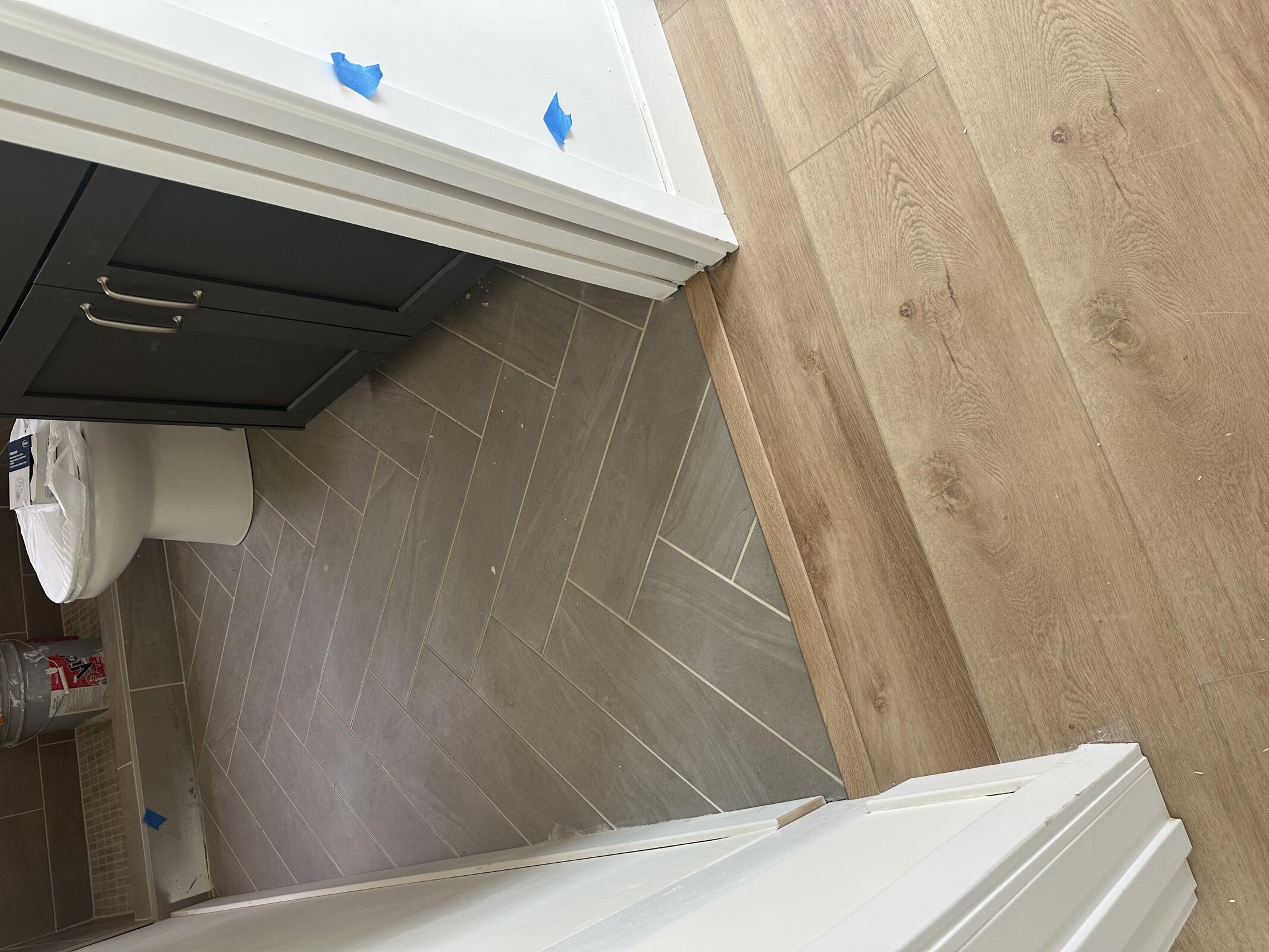

Coastal fixed LVP edge at C2 entrance and installed T-Mold at bathroom tile transition.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| ZSP | 1 | 8 | 8 |
| Traditions | 1 | 8 | 8 |
| Taylor Trim | 1 | 4 | 4 |
| Marjan Stone | 2 | 2 | 4 |
Inspection: N/A
Delay: Pending closure on electrical.











Wednesday, July 15, 2026
Clear, 80°F

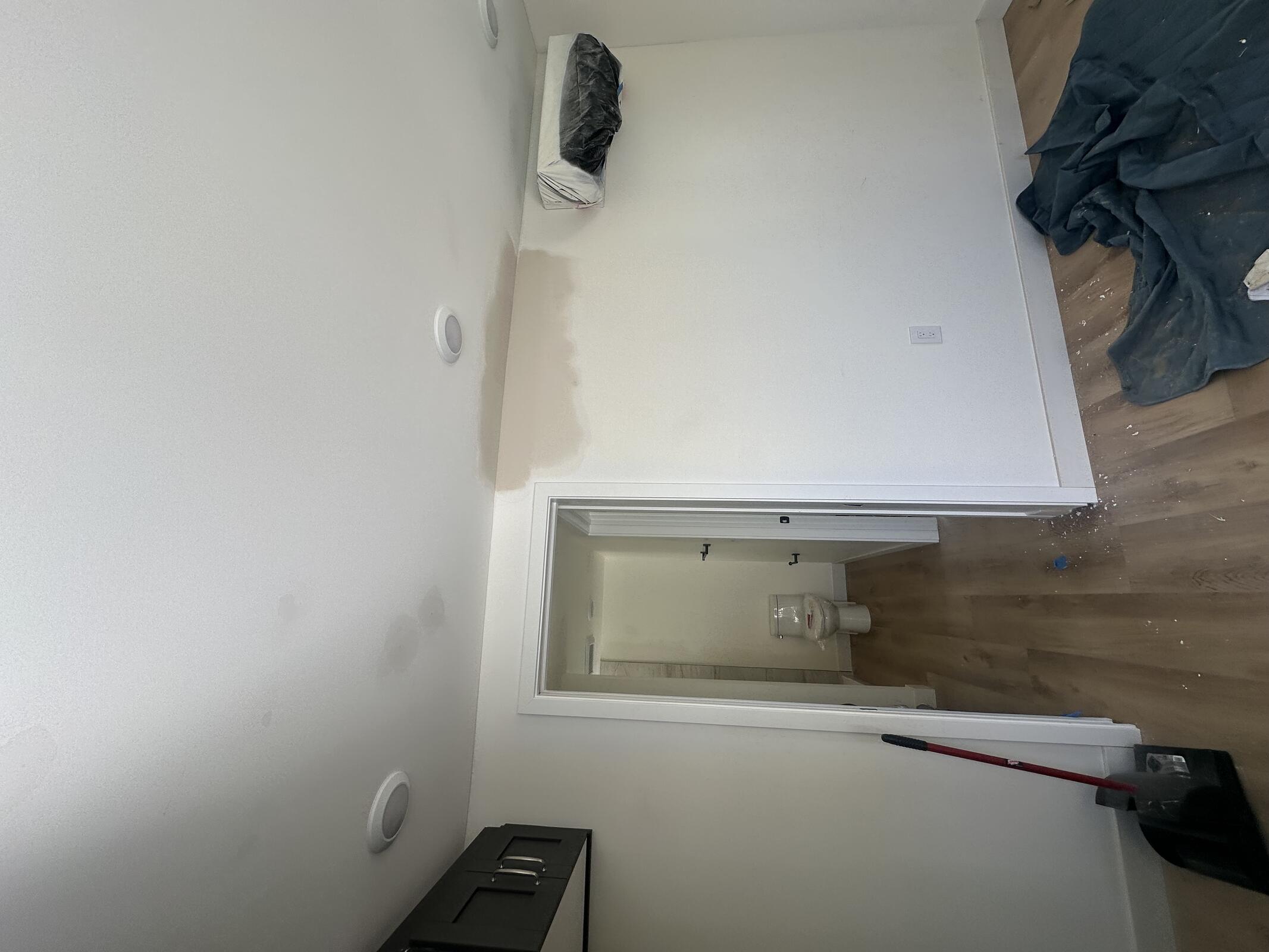

Taylor Trim installing remaining baseboards, shoe molding at Building C peninsulas, Unit Numbers, and door hardware.
AC Electric finishing punchlist items.

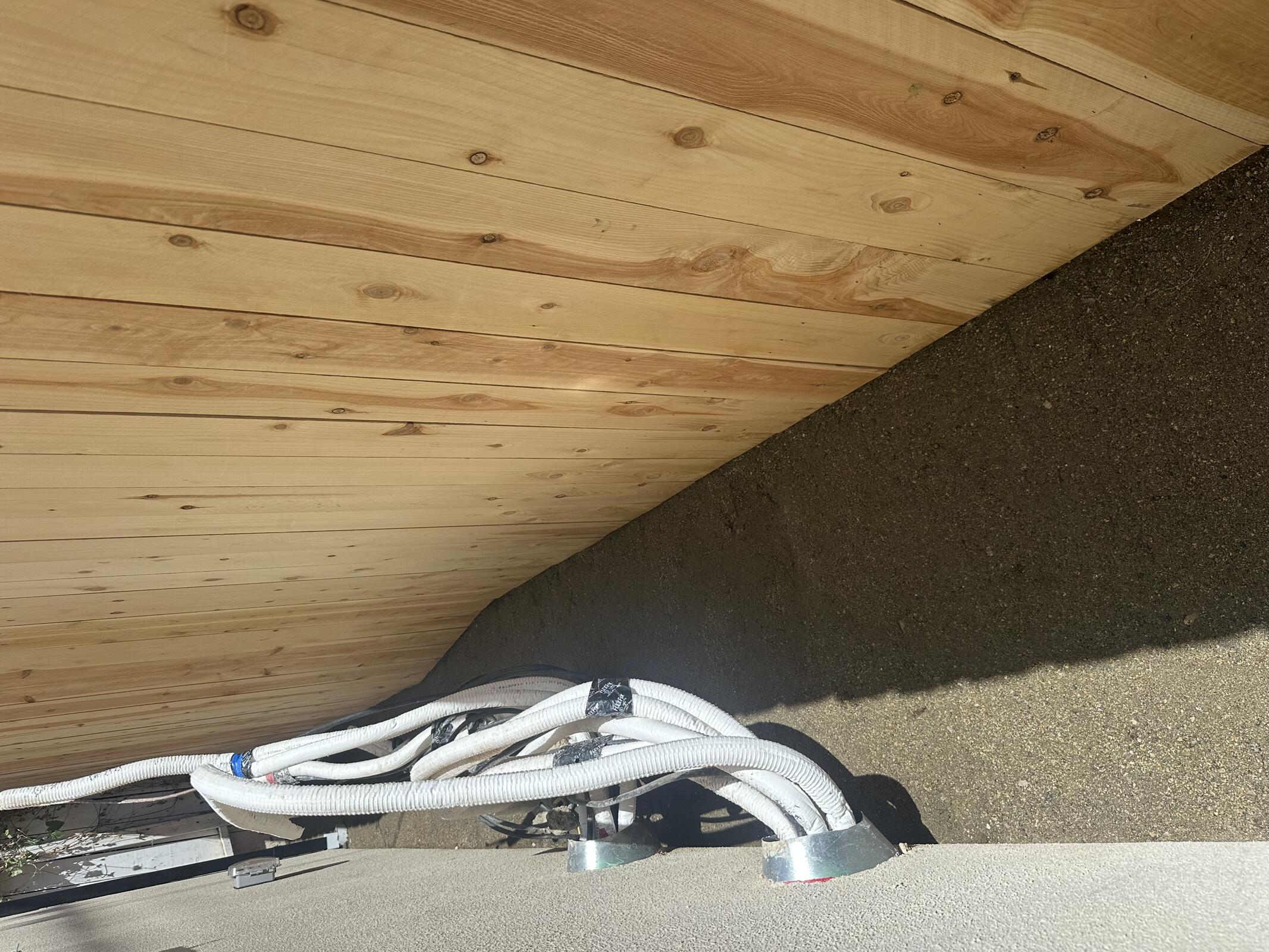

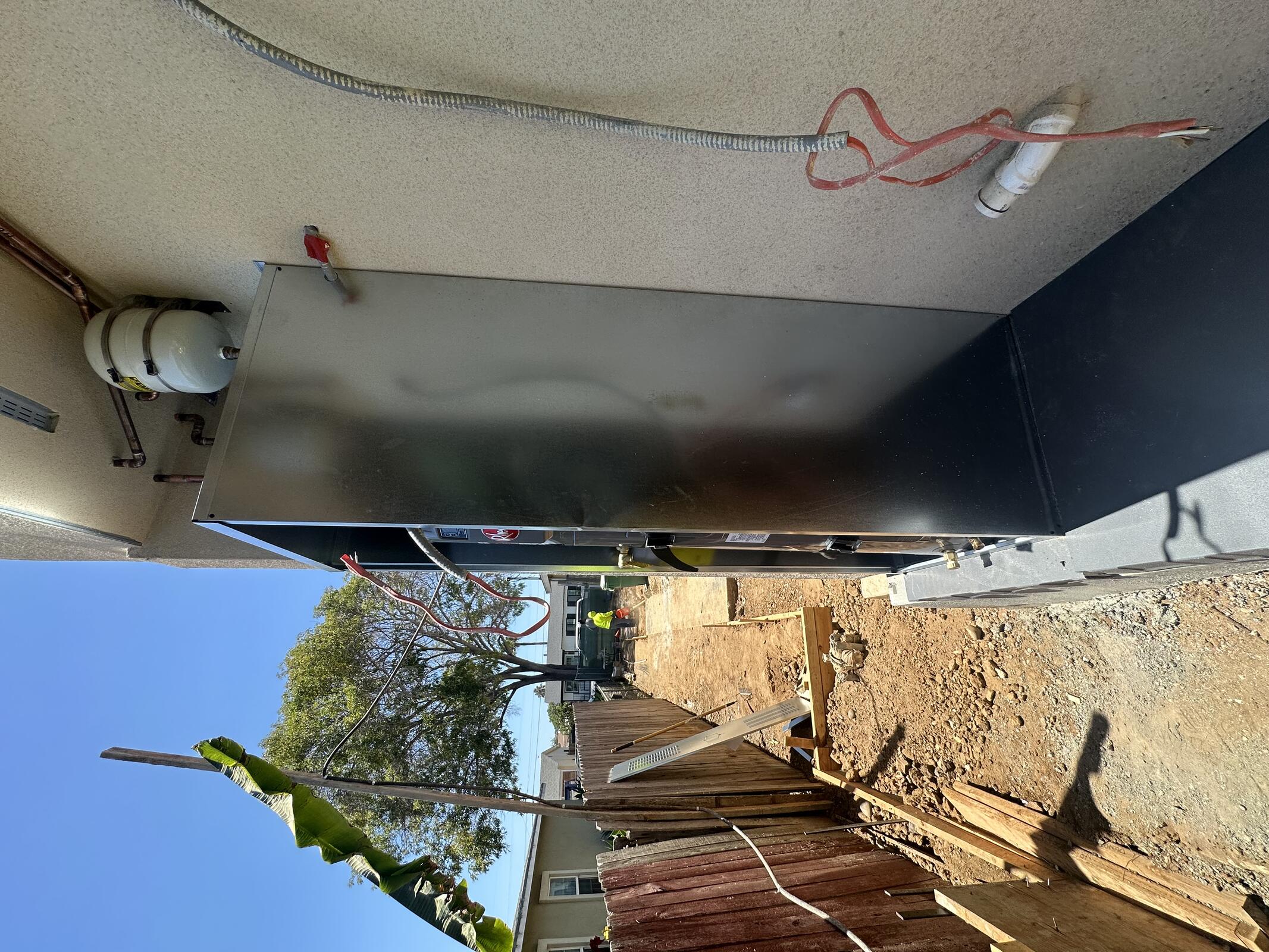

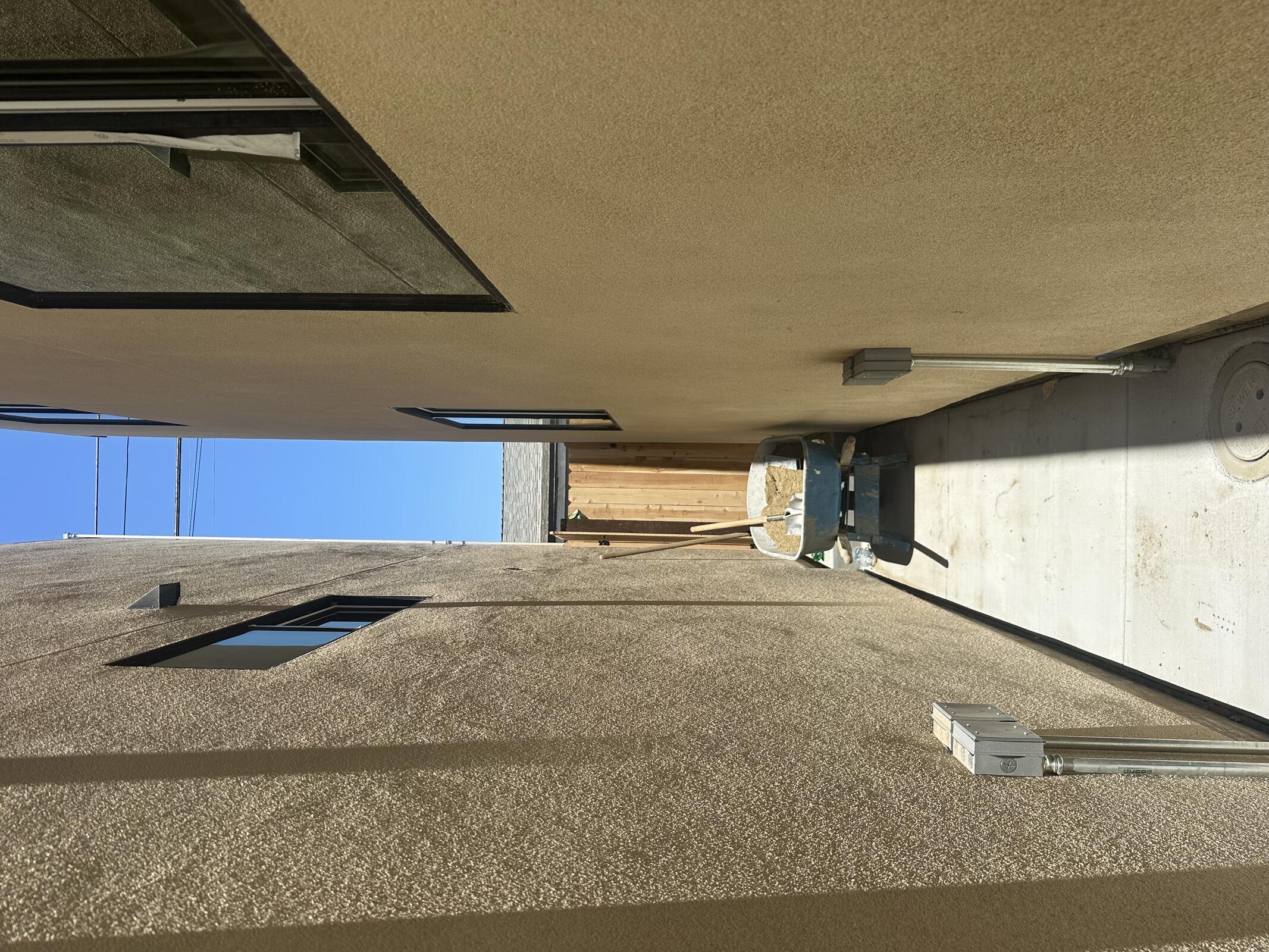

ZSP installing water heaters and enclosures at Building B.
Traditions sanding and finishing patching at all units and front house. Ken Huffman on site at 11:00 AM to perform QC.

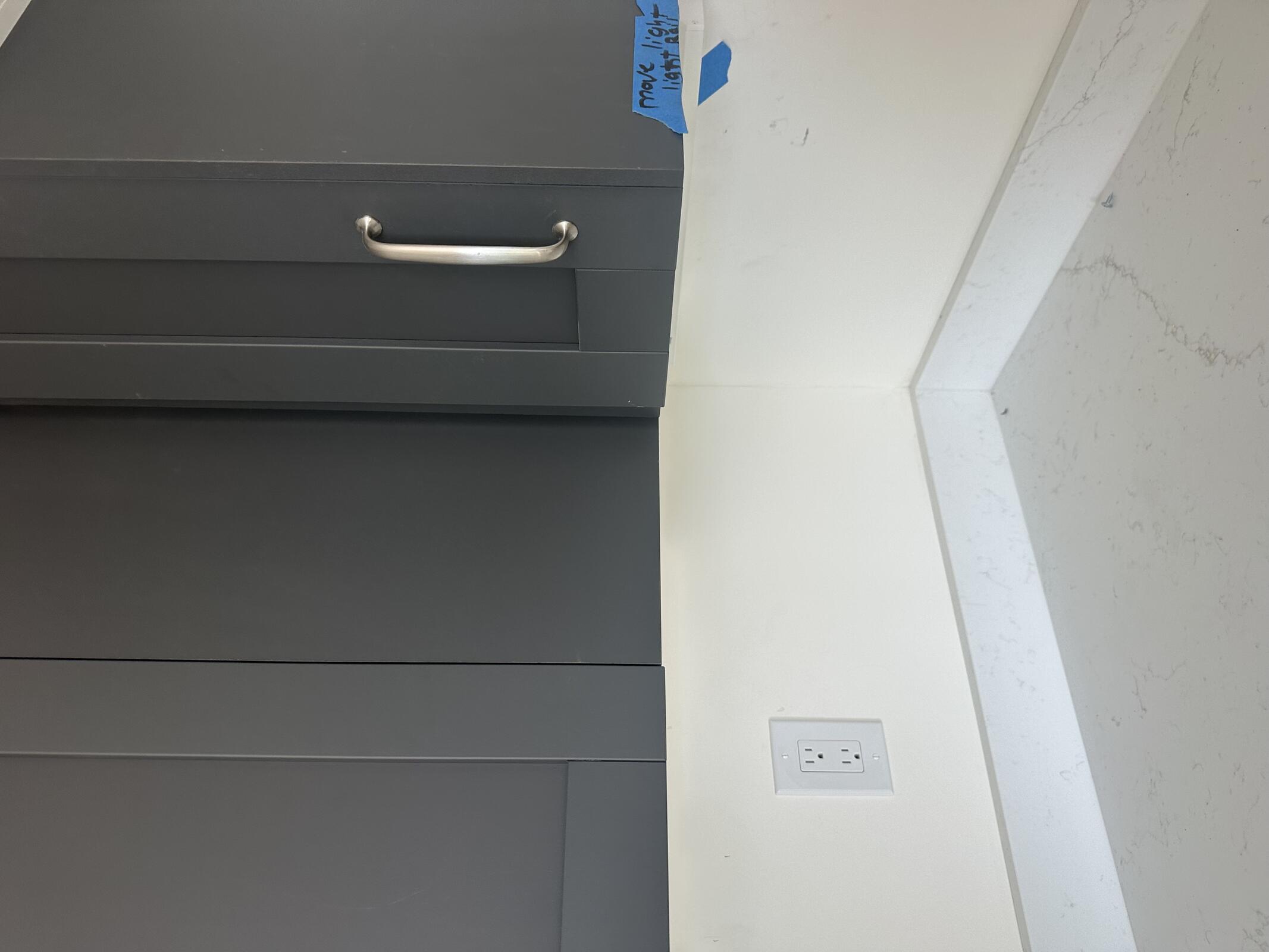

Primera doing final walk through, patching, and adjustments at cabinets.

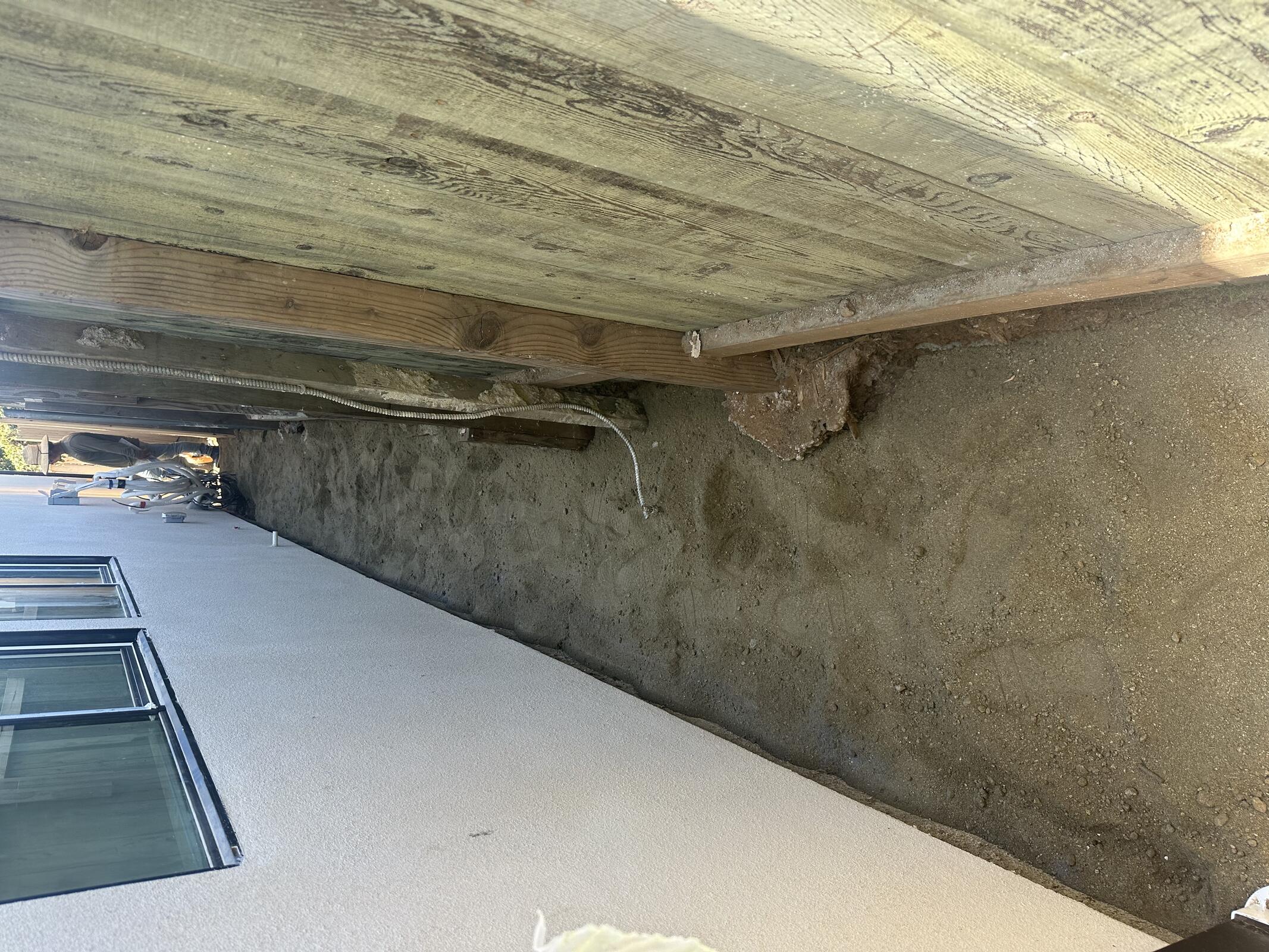

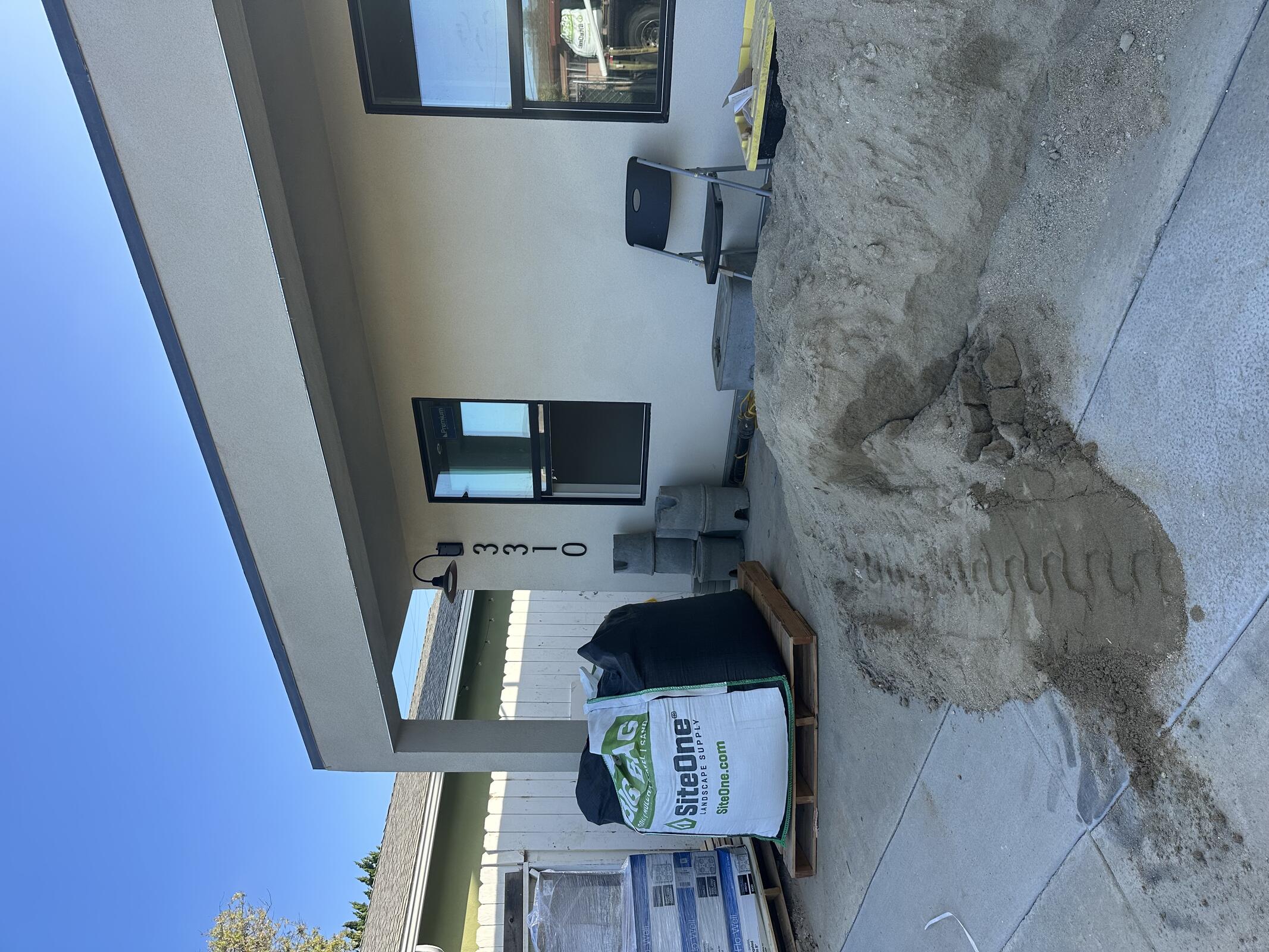

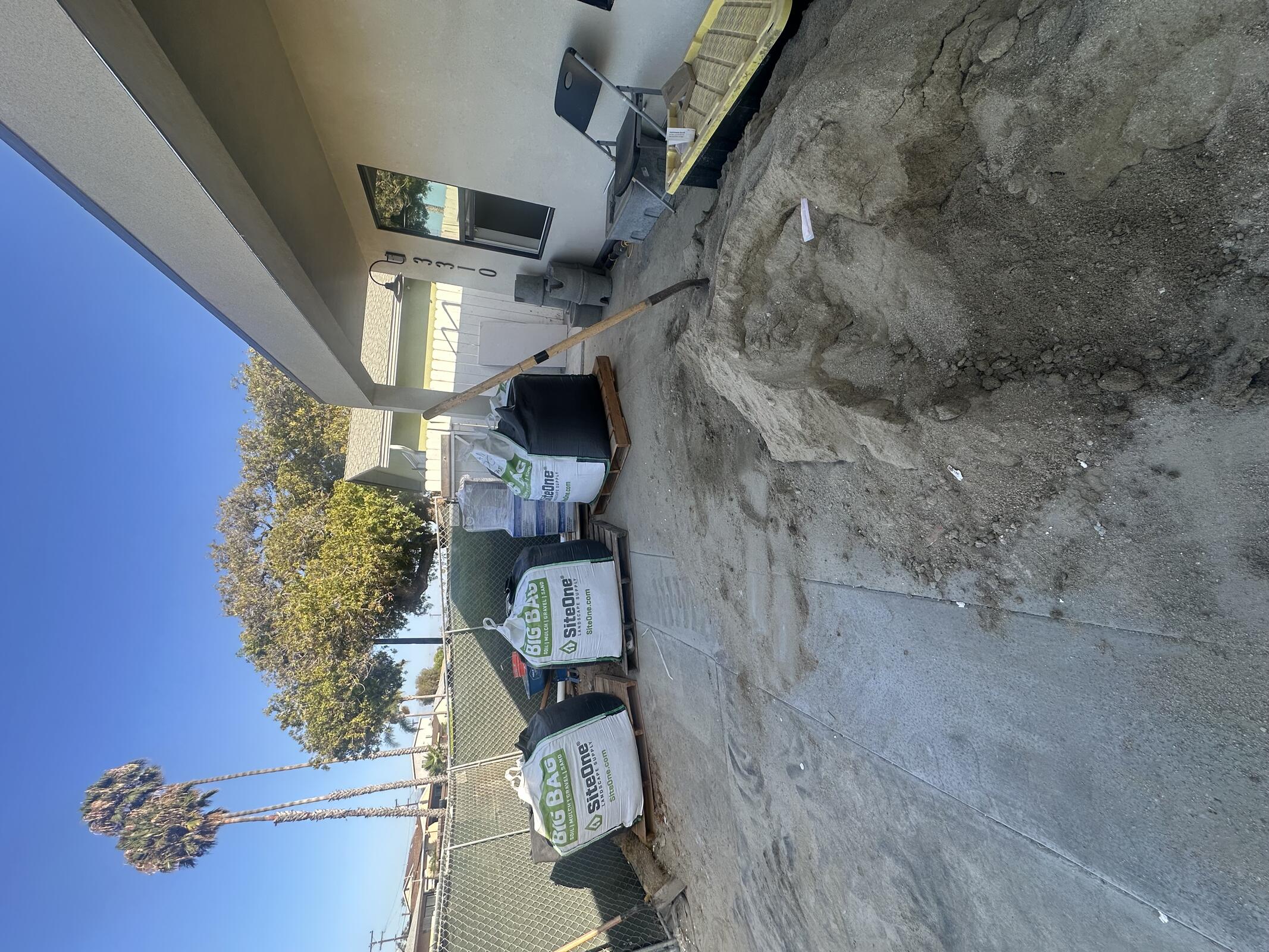

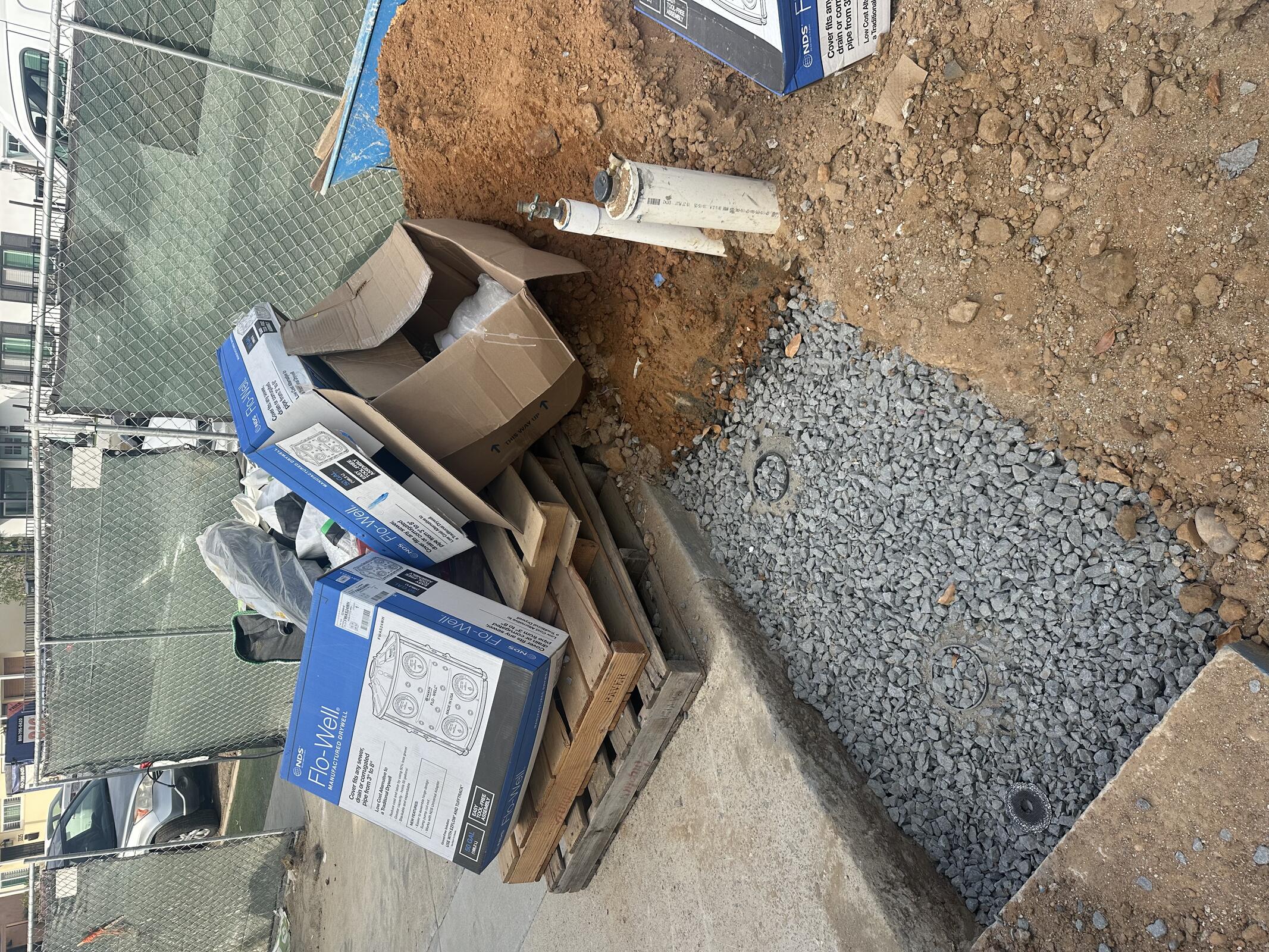

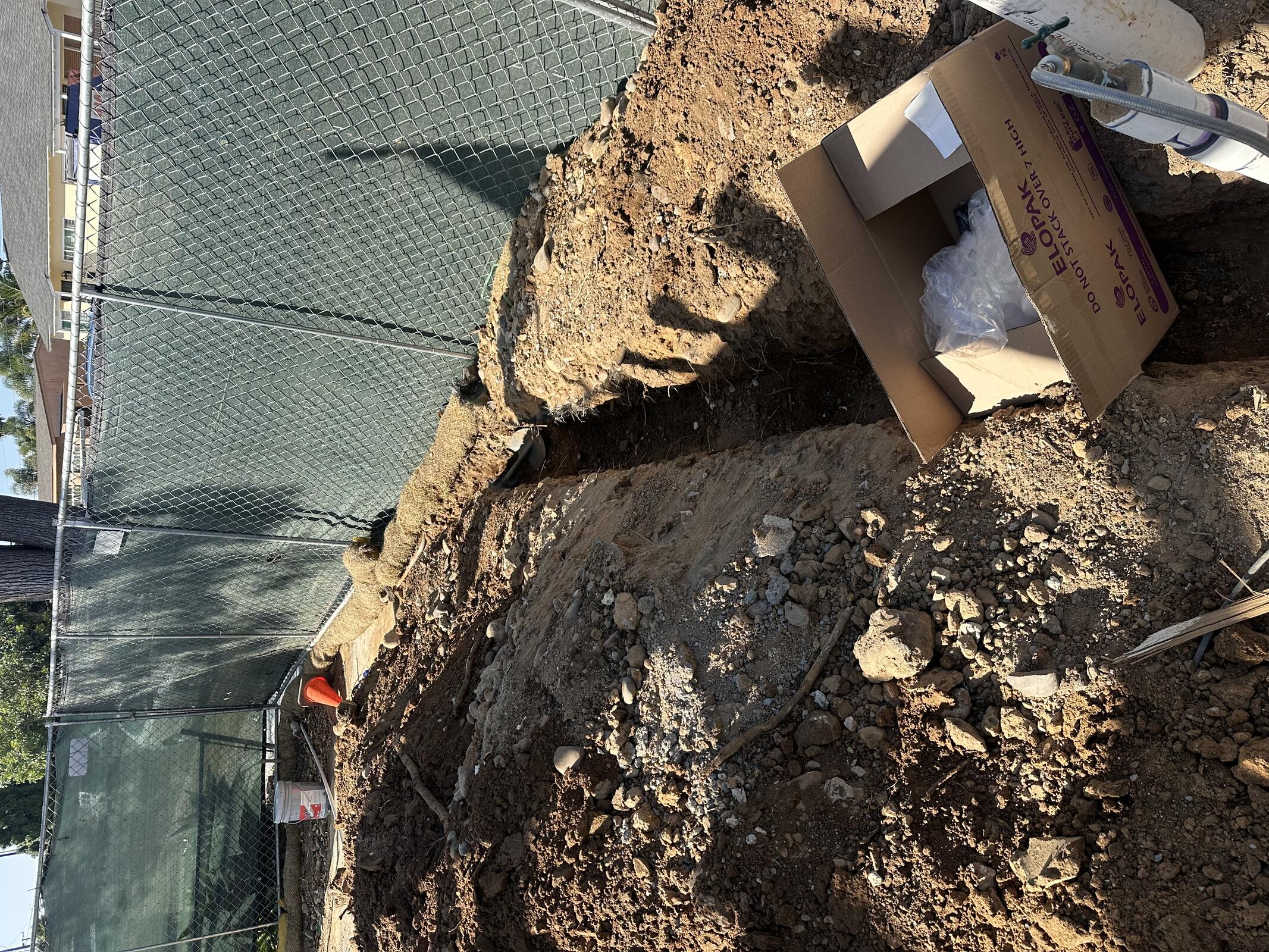

Golden Roots working on Stabalized DG at back area. DG, drywells, and 1 yard of gravel delivered to site.

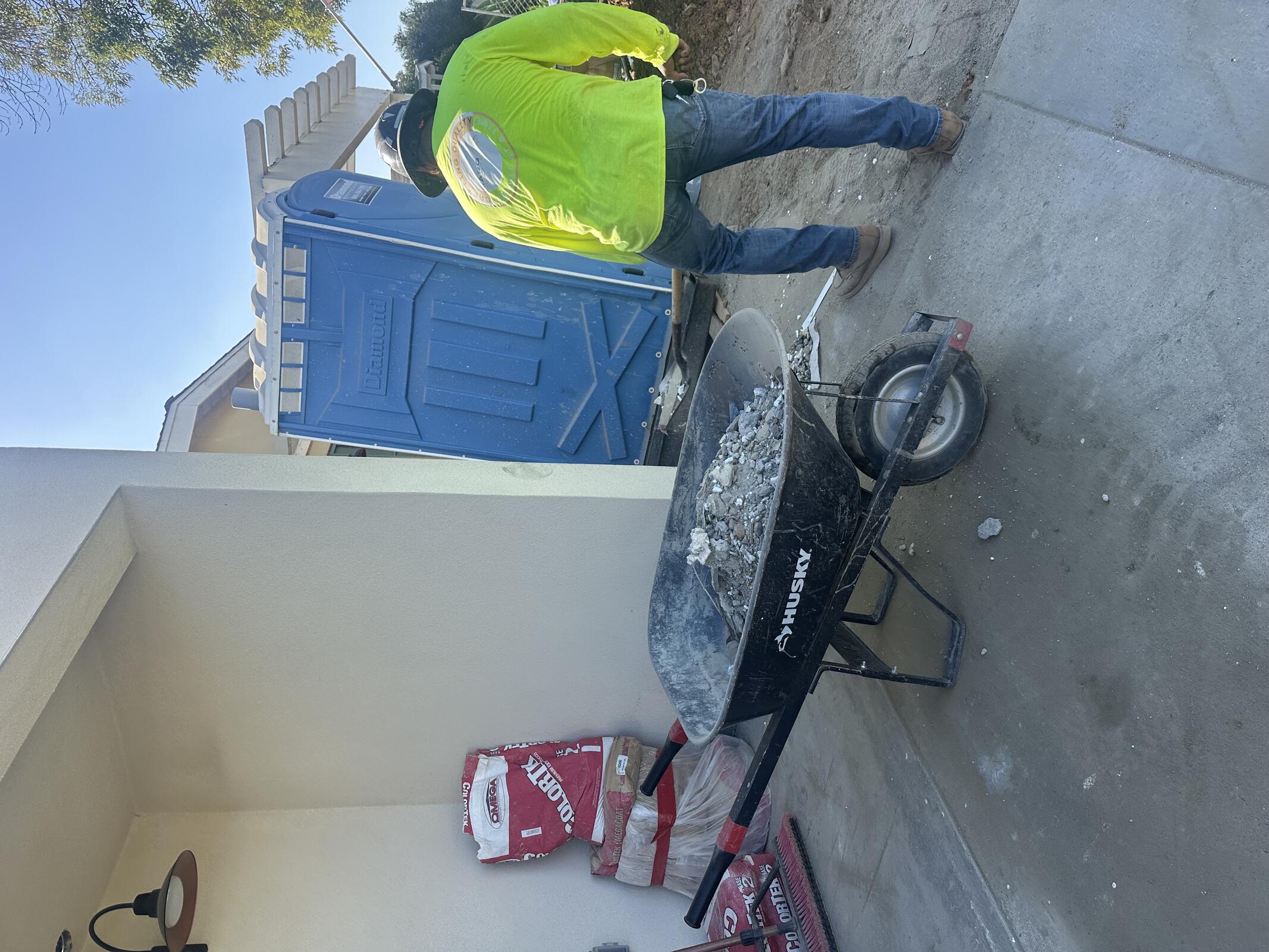

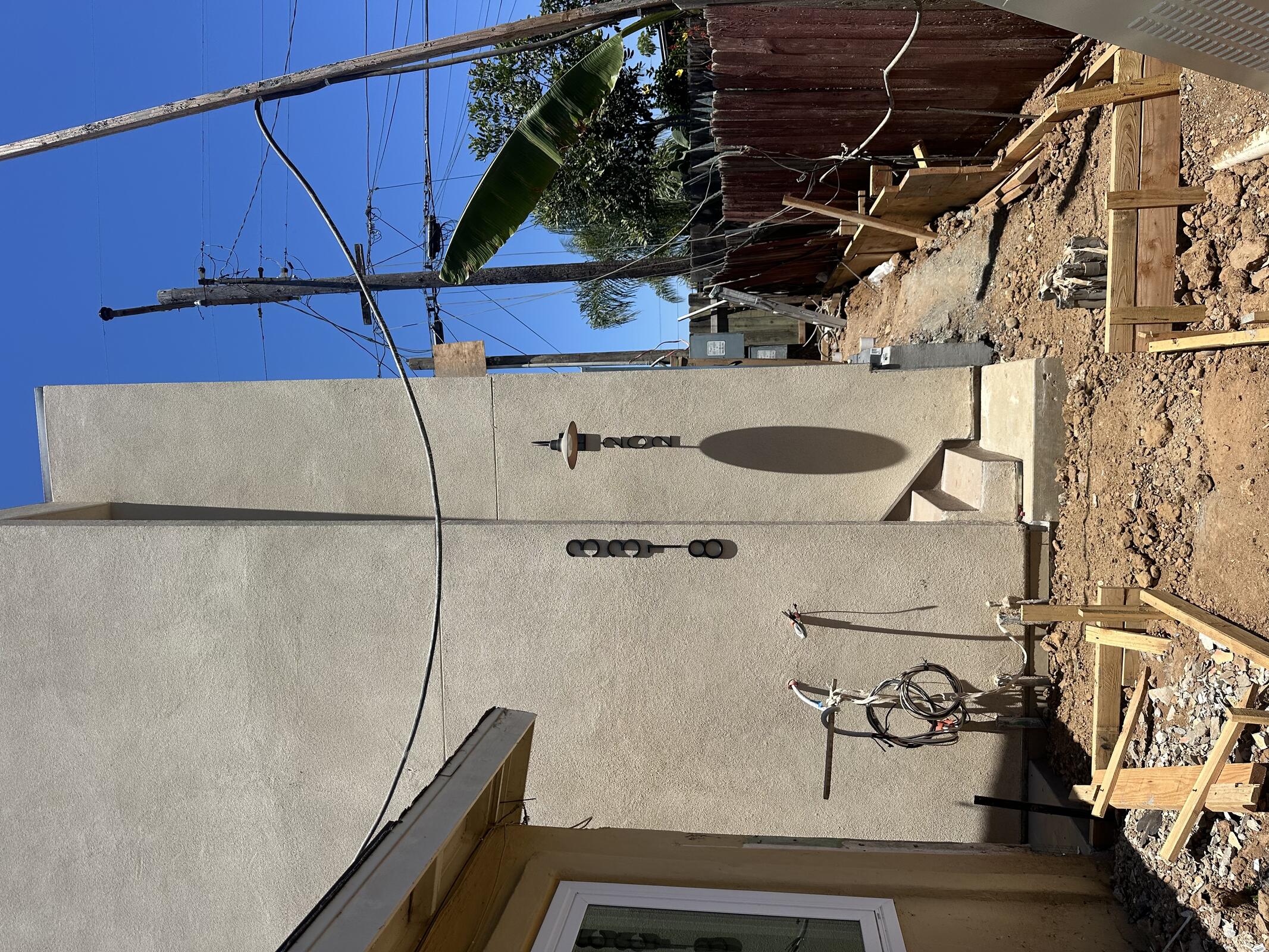

Marq removing all extra sand and stucco debris from site.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| Taylor Trim | 1.25 | 8 | 10 |
| AC Electric | 1 | 4 | 4 |
| Traditions | 2 | 8 | 16 |
| ZSP | 1 | 8 | 8 |
| Marq | 1 | 2 | 2 |
| Golden Roots | 3 | 8 | 24 |
| Primera | 1 | 8 | 8 |
Inspection: N/A
Delay: Electrical

















Thursday, July 16, 2026
Partially cloudy, 69°F

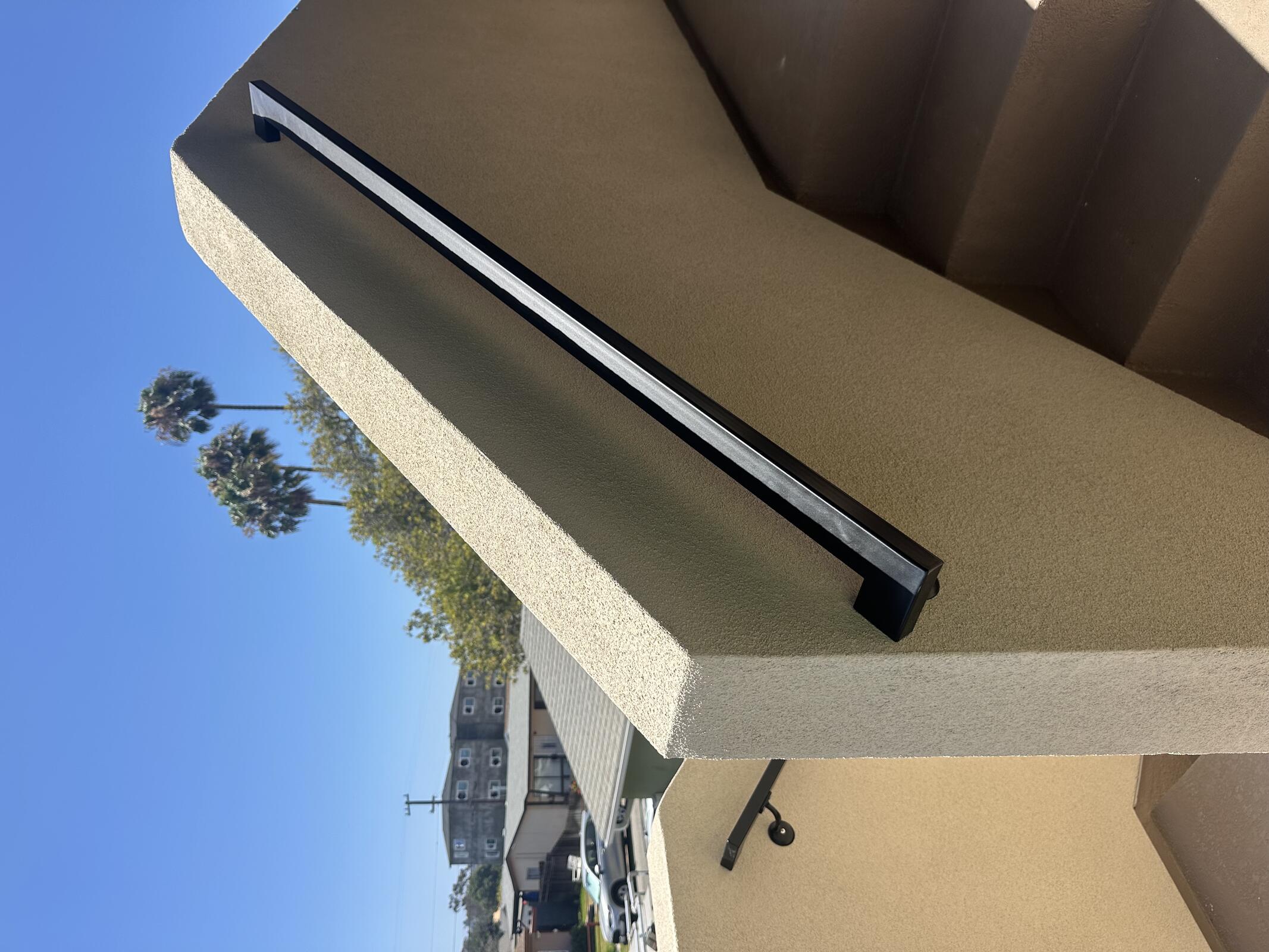

JBG installing range and microwave in garage unit. Hand rails installed.

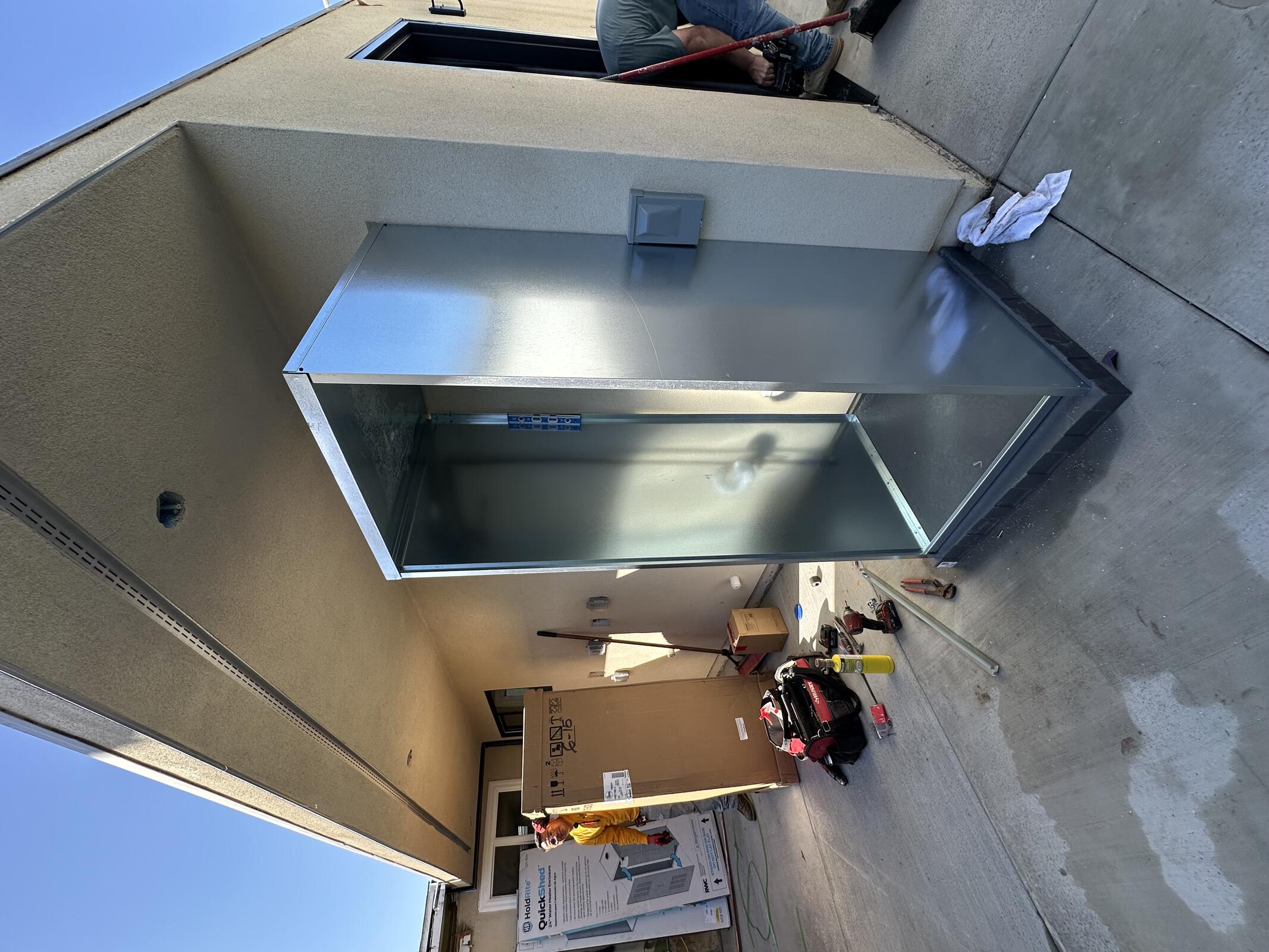

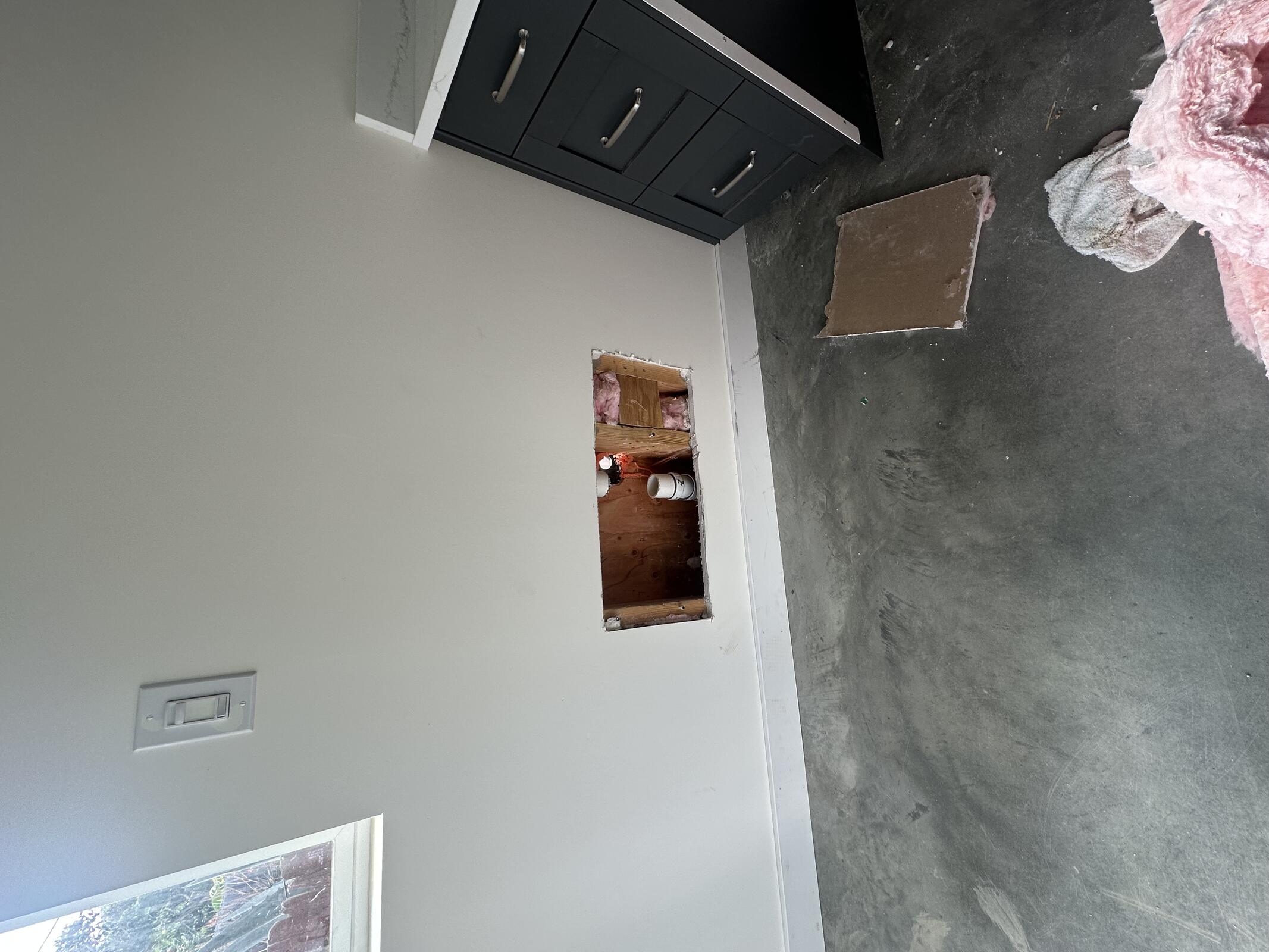

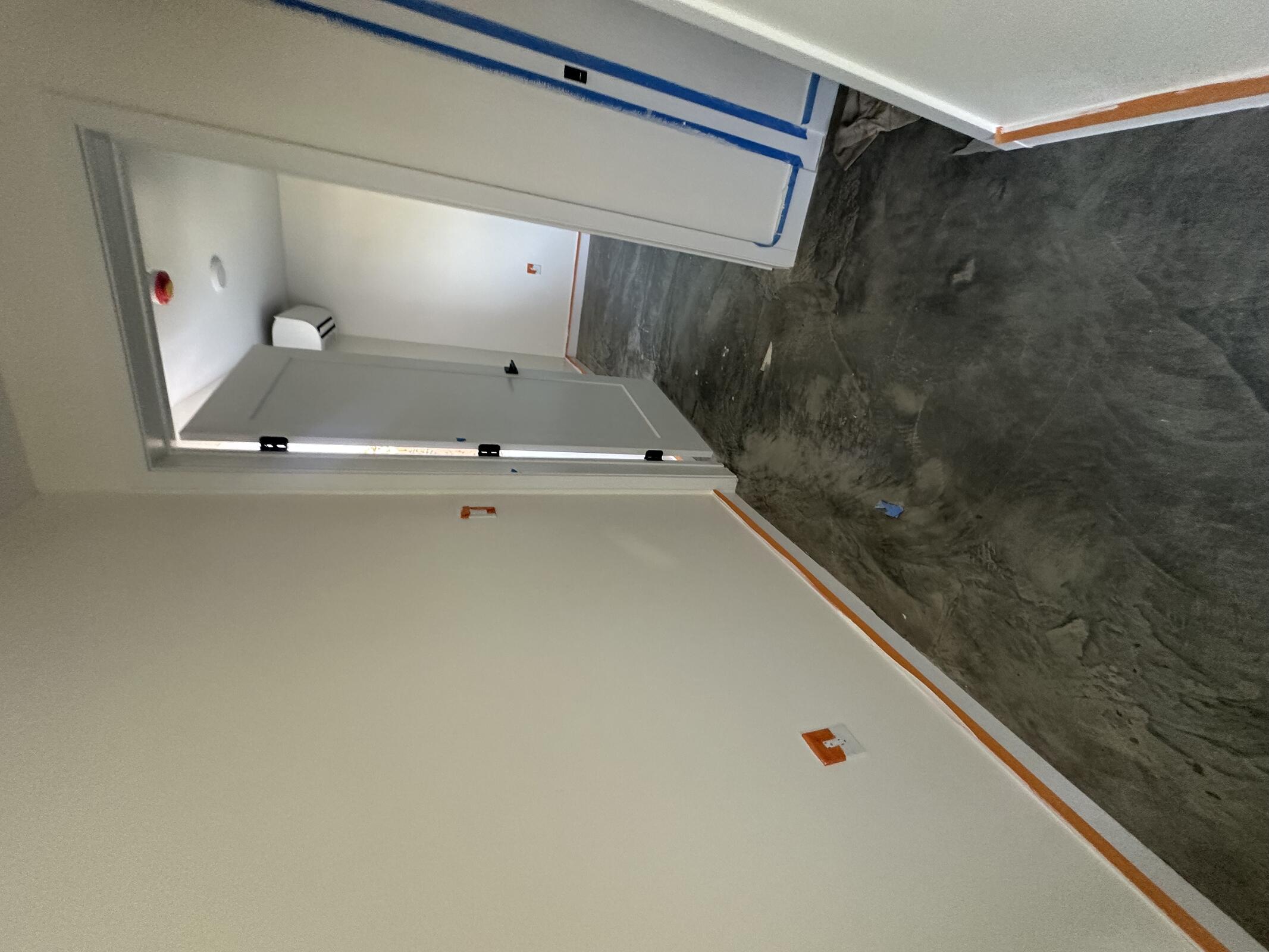

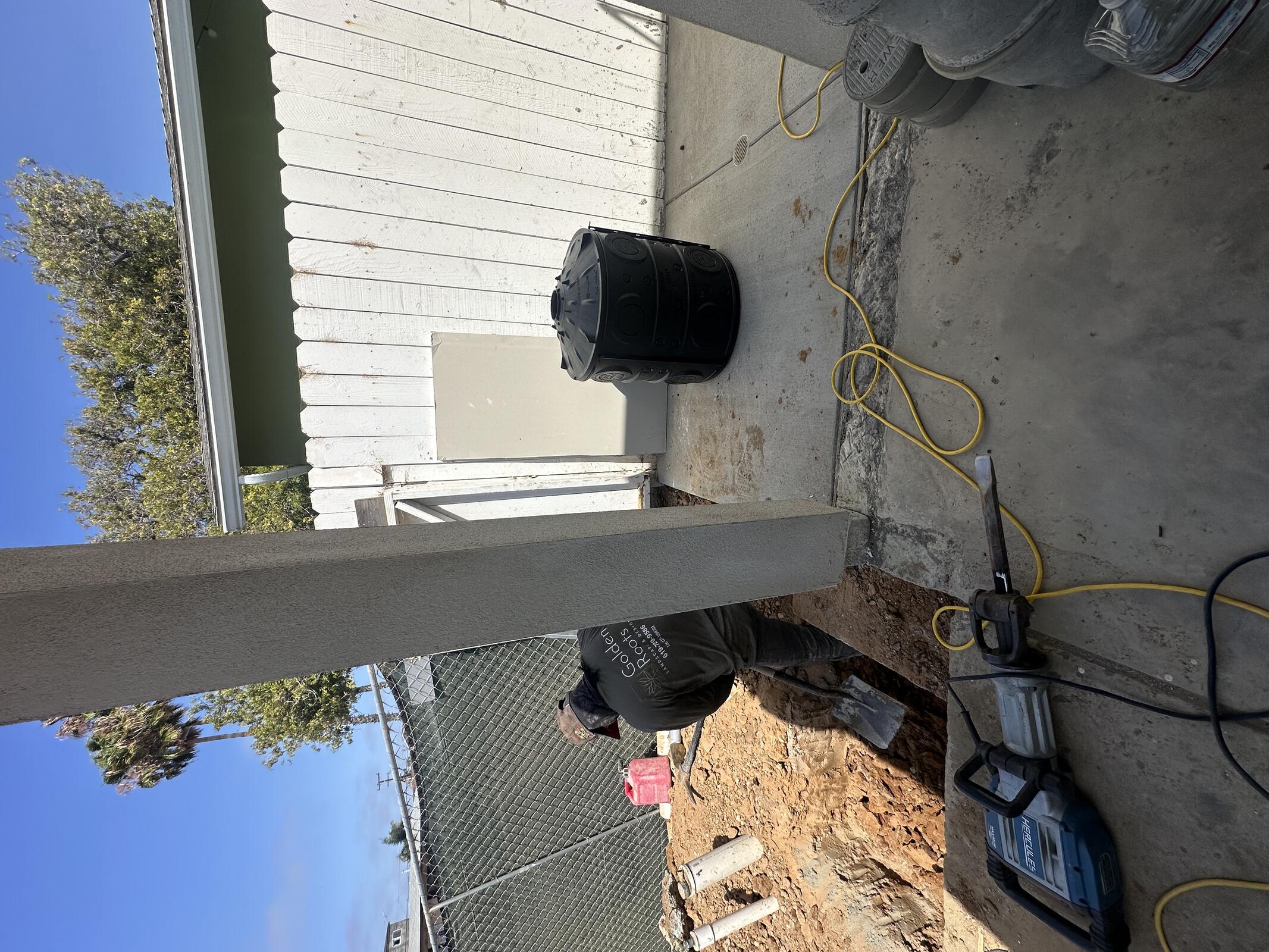

ZSP installing remaining toilets and building C water heaters. ZSP will need to cut drywall at Building B Unit 1 to move water heater drain.

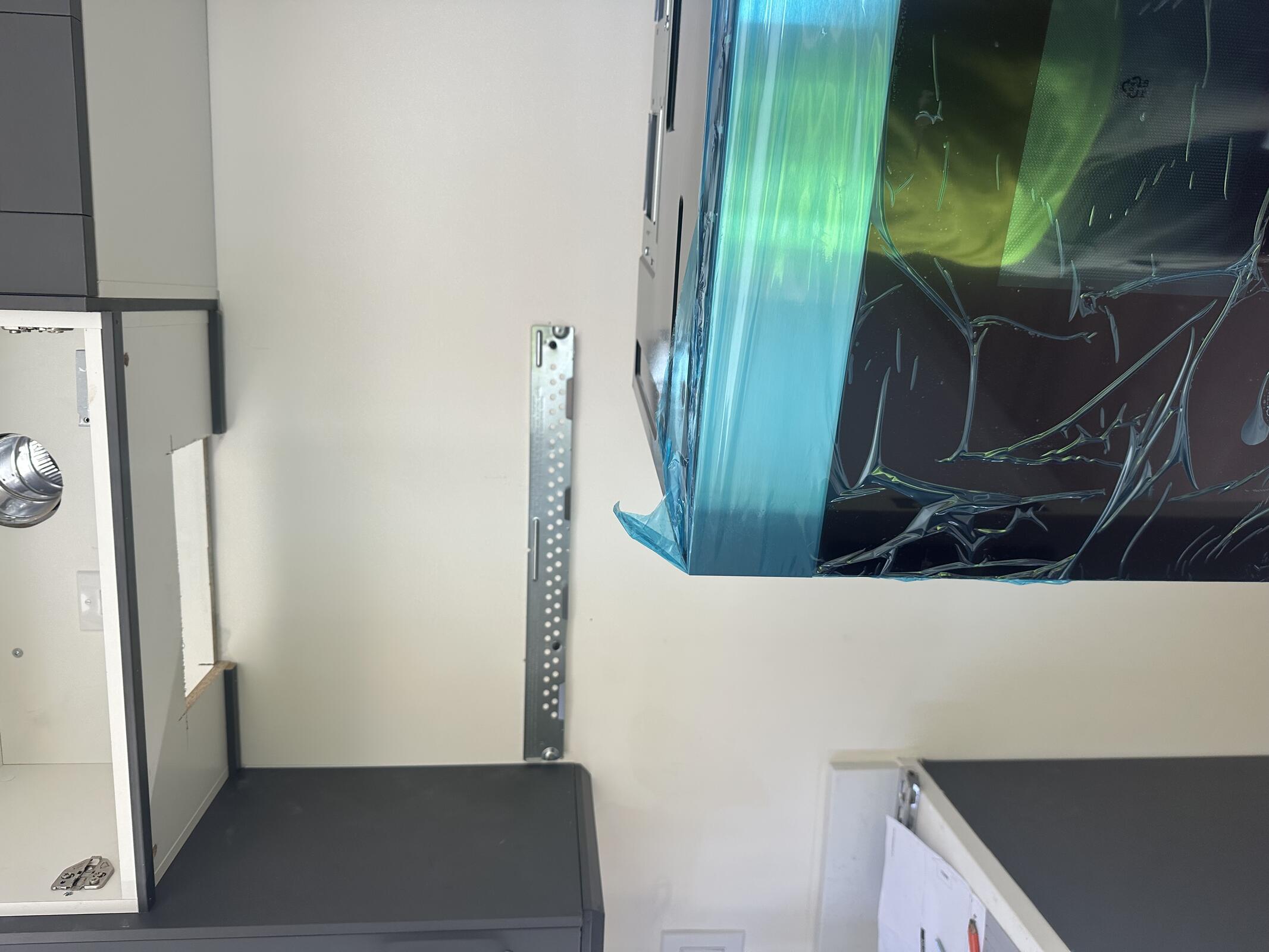

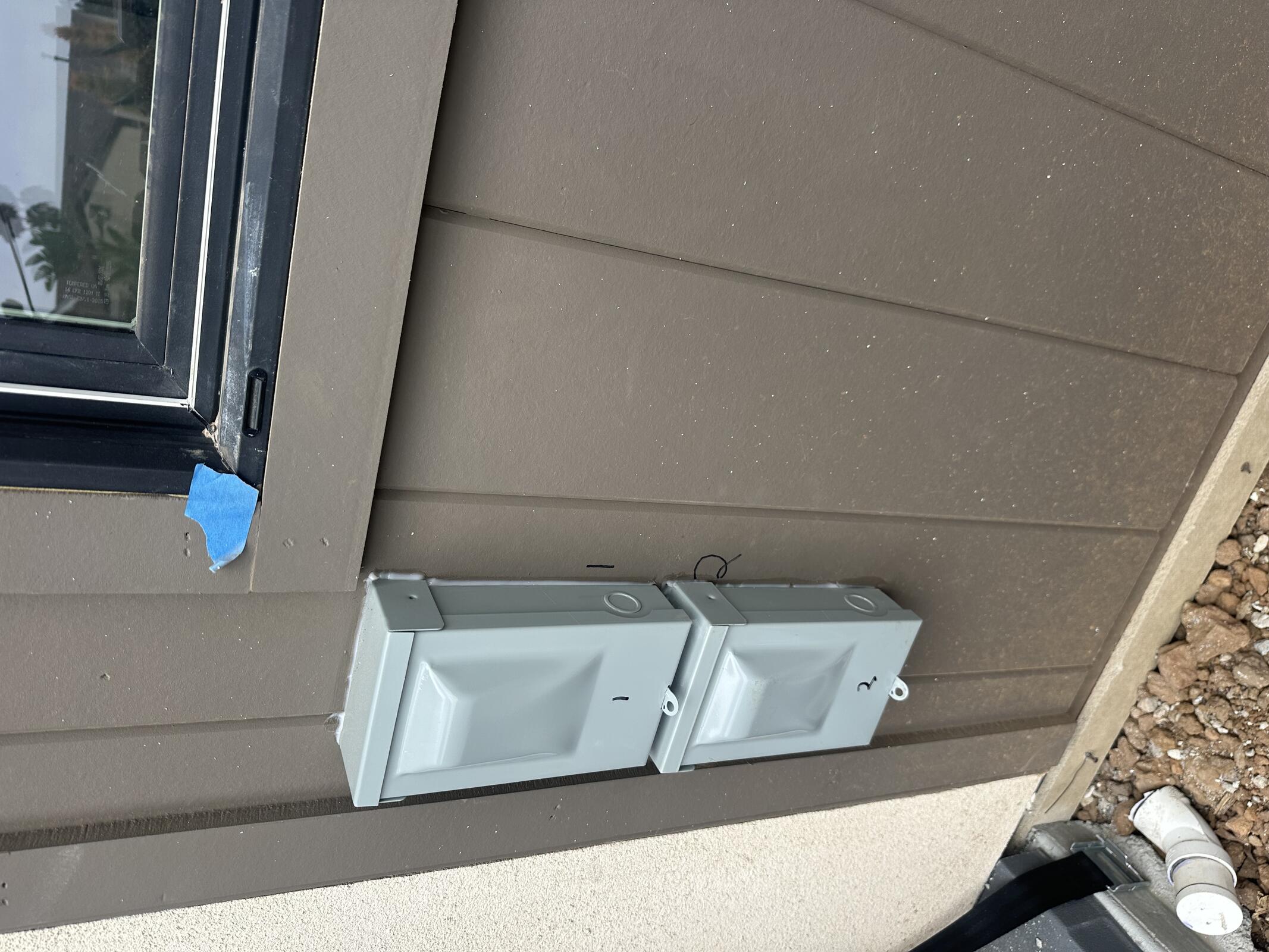

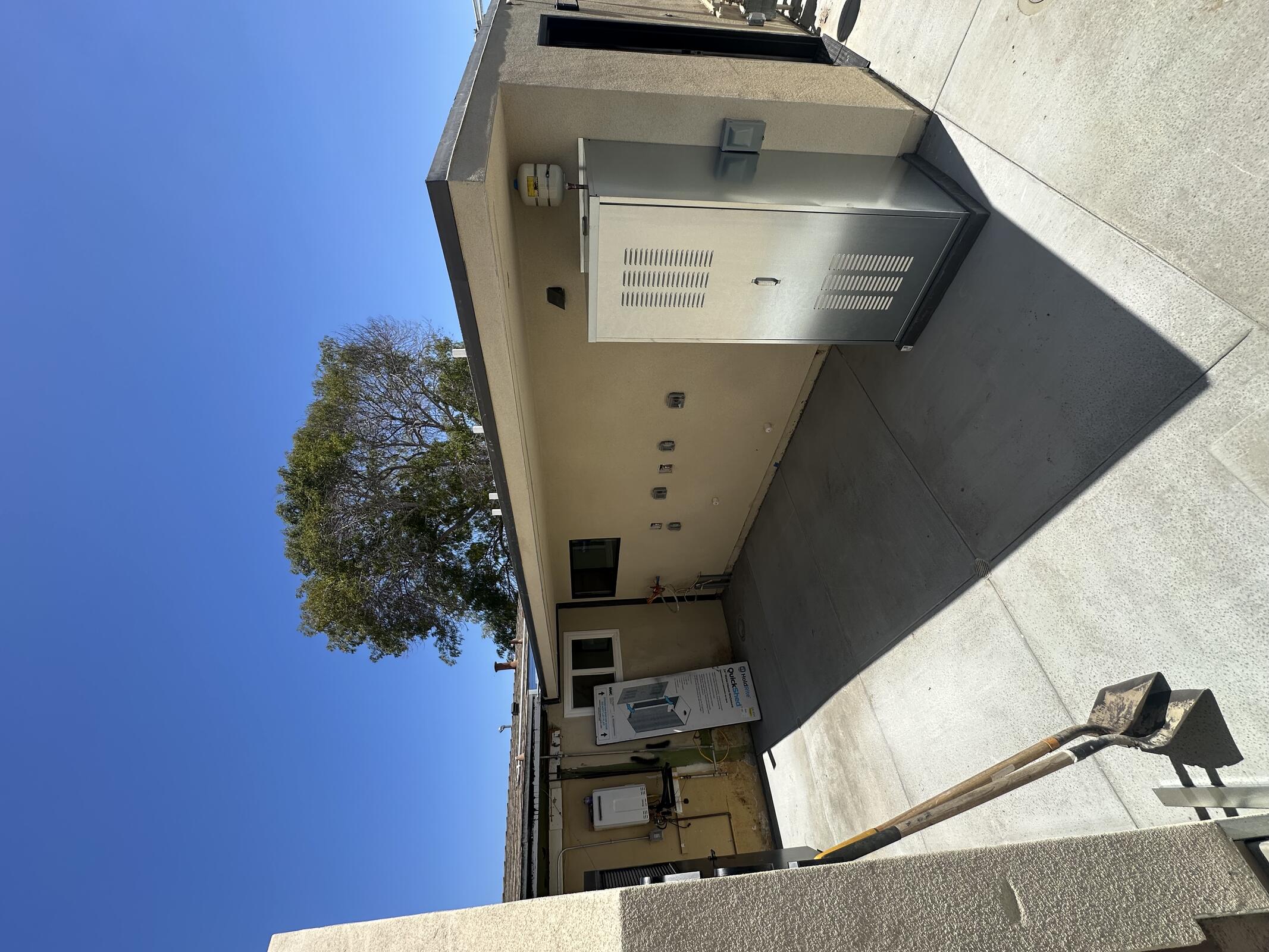

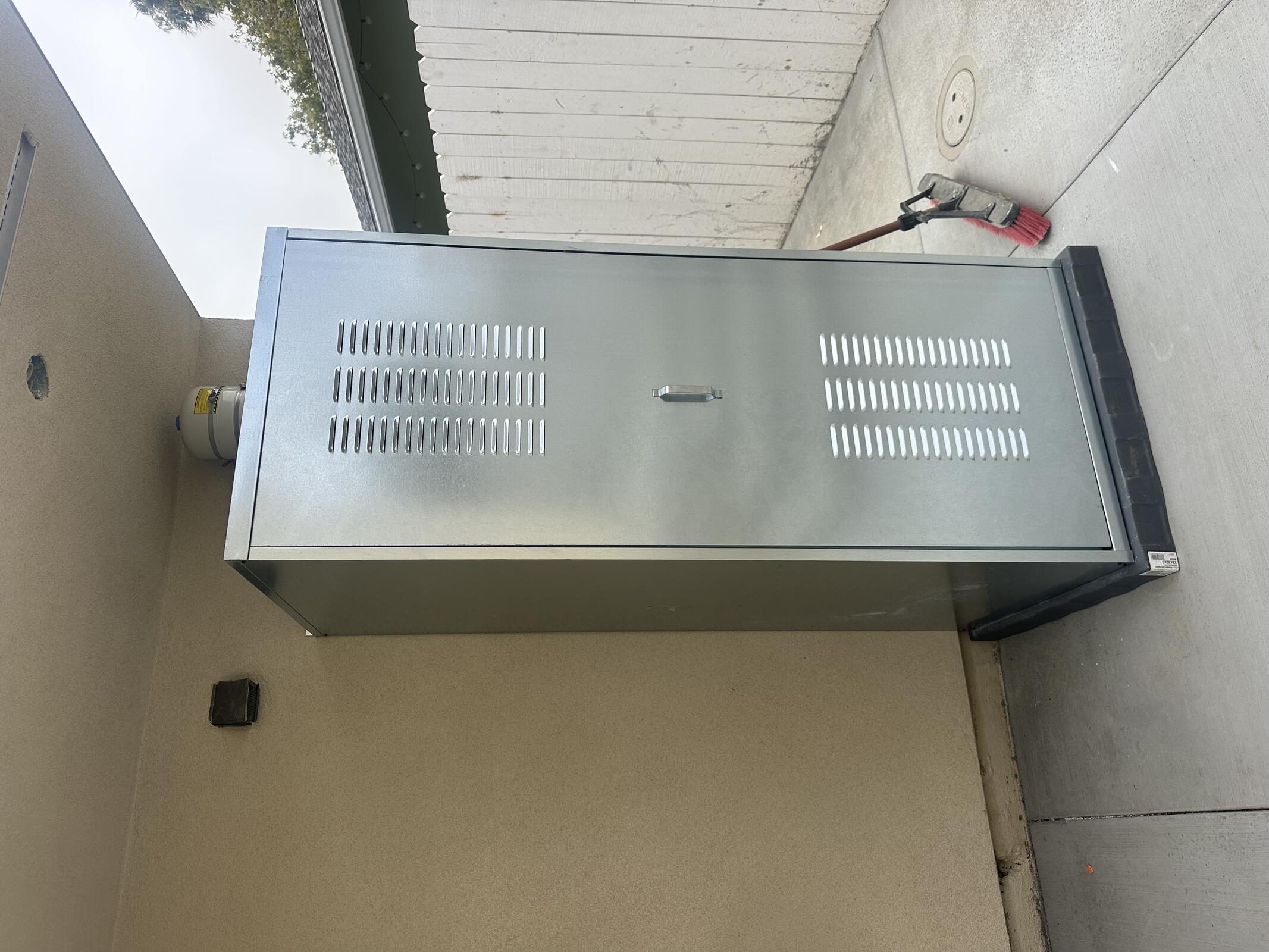

AC electric installing remaining under cabinet lights and disconnects. Meters labeled to prepare for inspection.

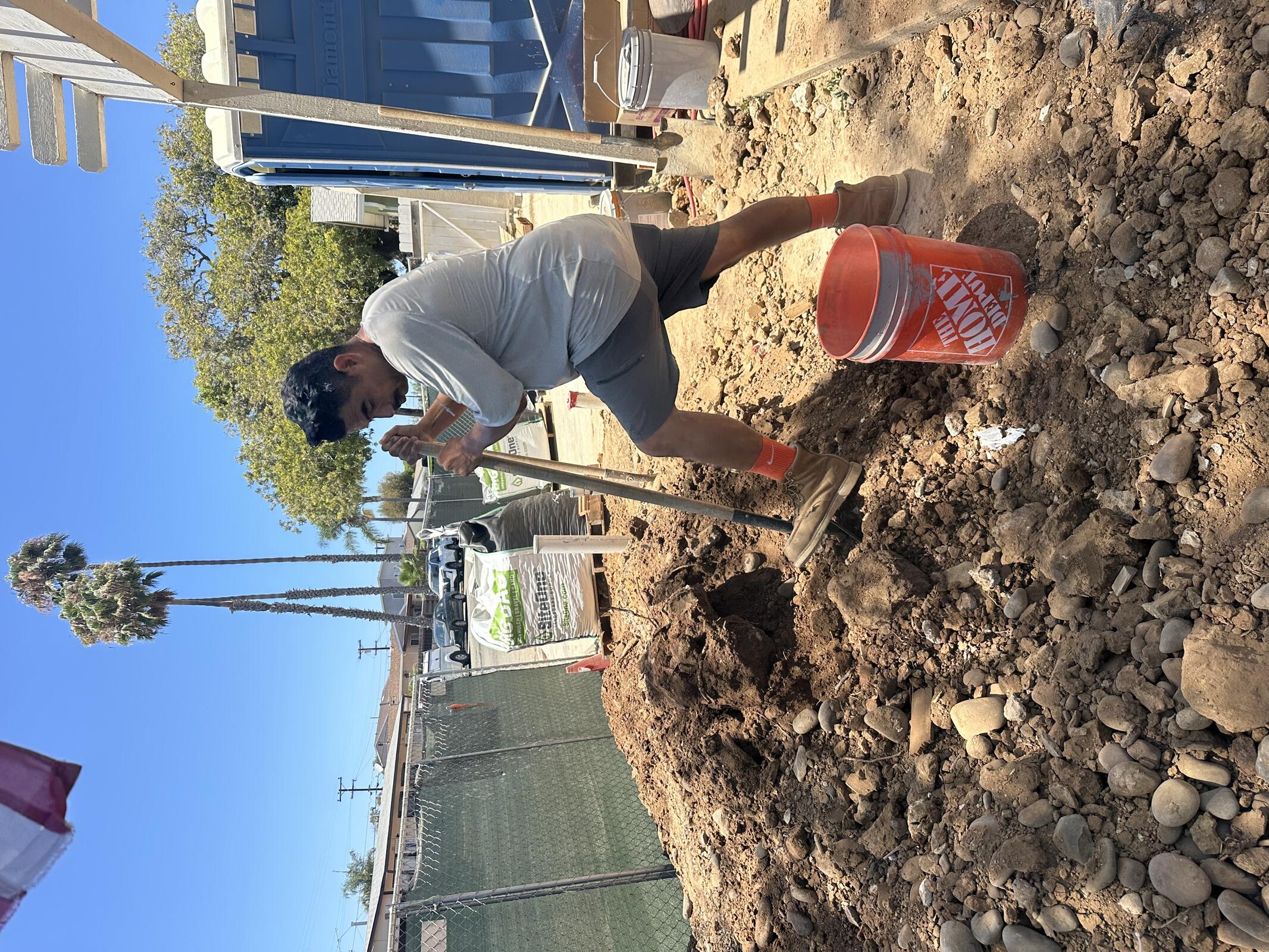

Golden Roots digging at front of property to install drywells.

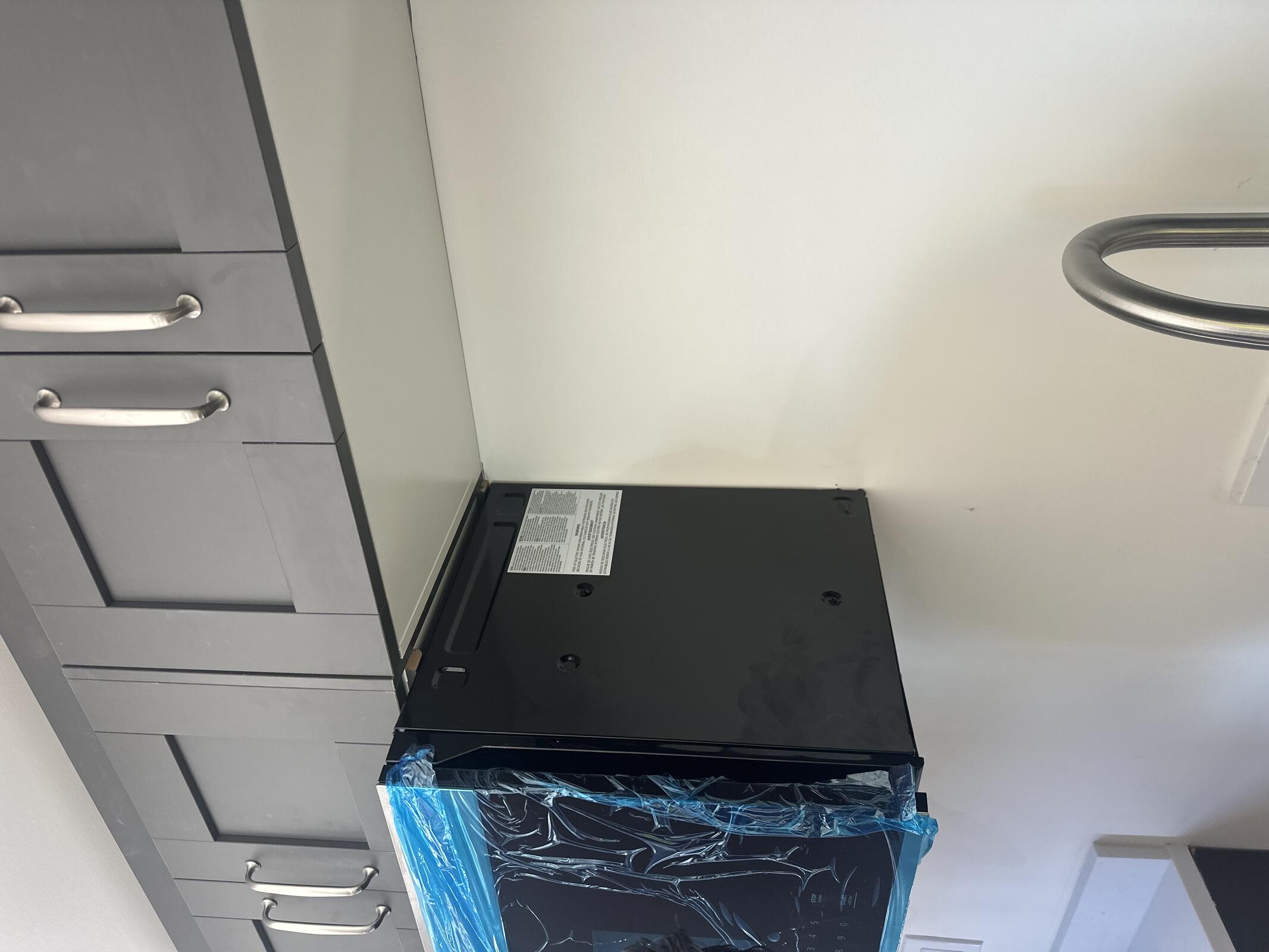

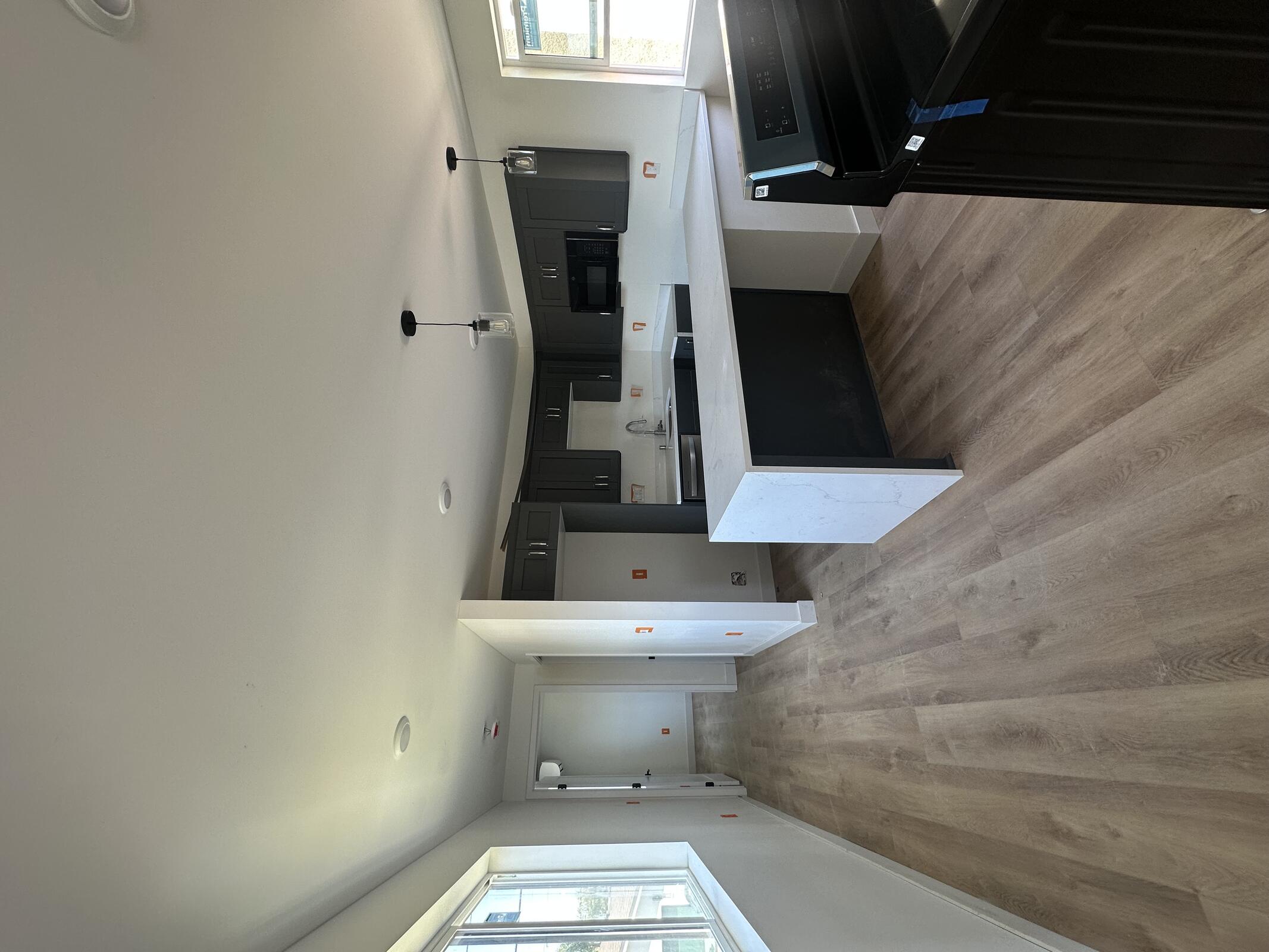

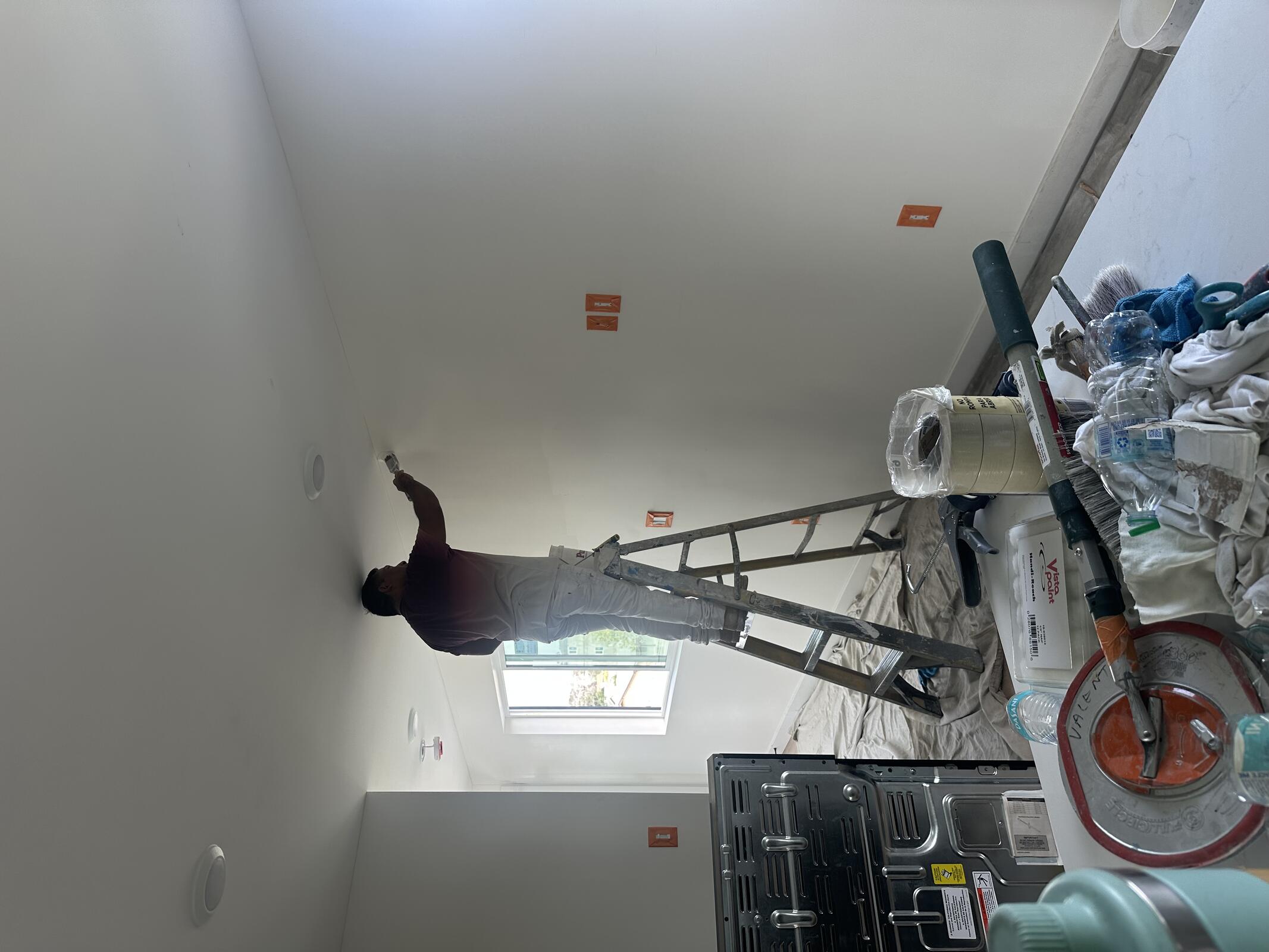

Painters Unlimited doing final paint at Building C.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| JBG | 3 | 4 | 12 |
| AC Electric | 2 | 8 | 16 |
| ZSP | 2 | 8 | 16 |
| Painters Unlimited | 3 | 8 | 24 |
| Golden Roots | 2 | 8 | 16 |
Inspection: N/A

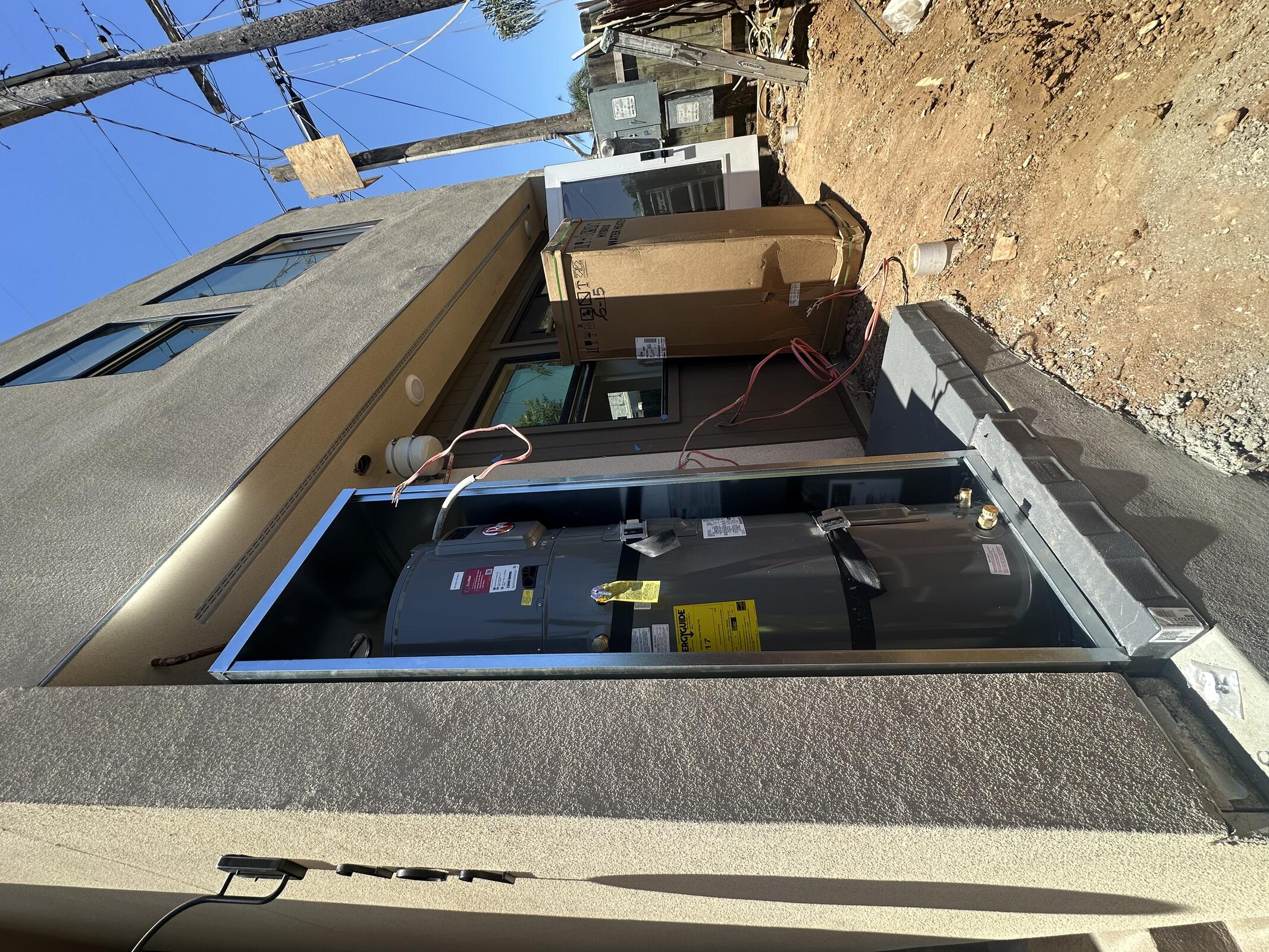

Delay: Letter accepted by Dan. Meter release scheduled for Monday.



















Friday, July 17, 2026
Overcast, 77°F

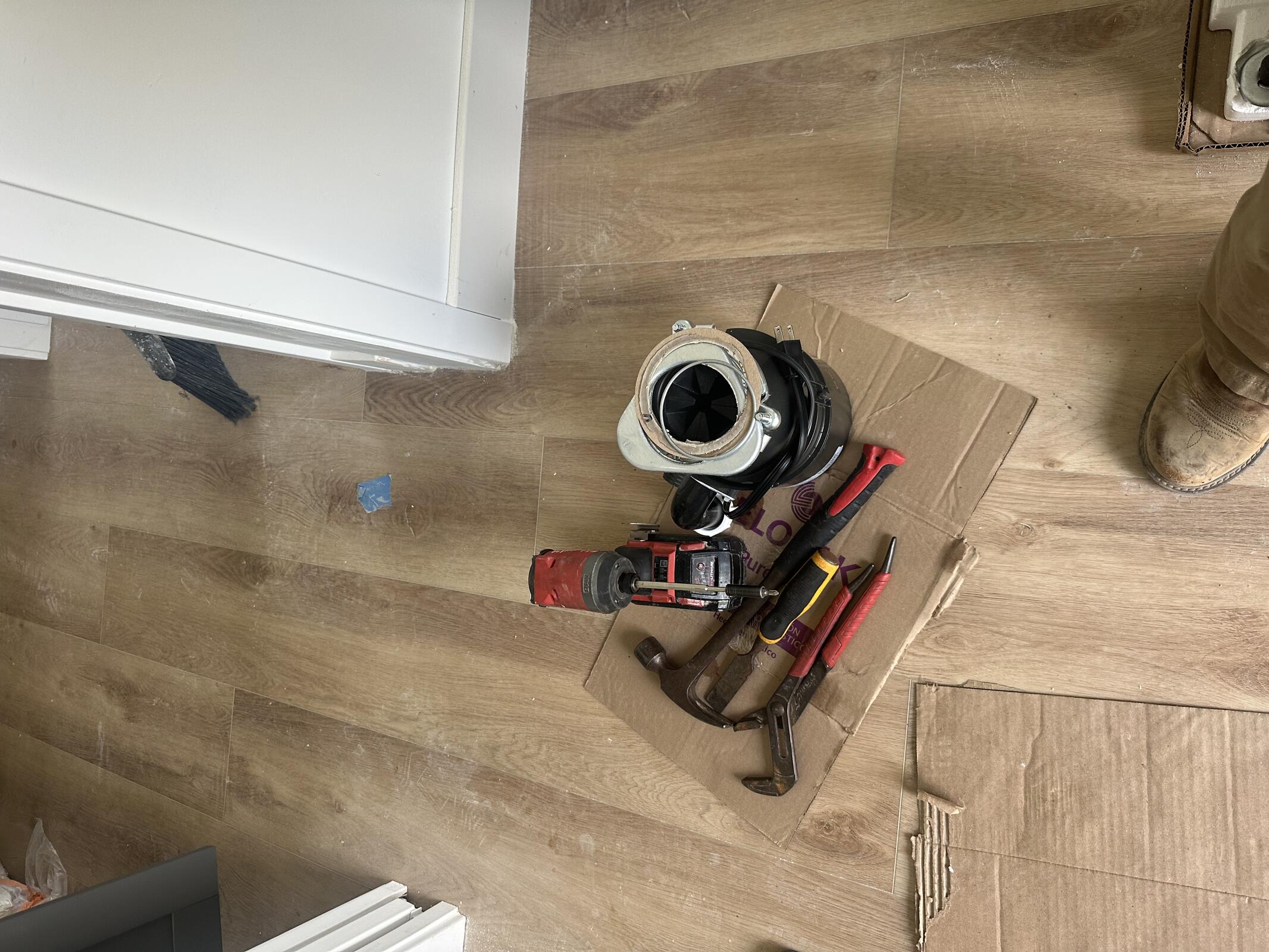

ZSP continuing to install water heaters, removing garbage disposals, and installing remaining toilets.

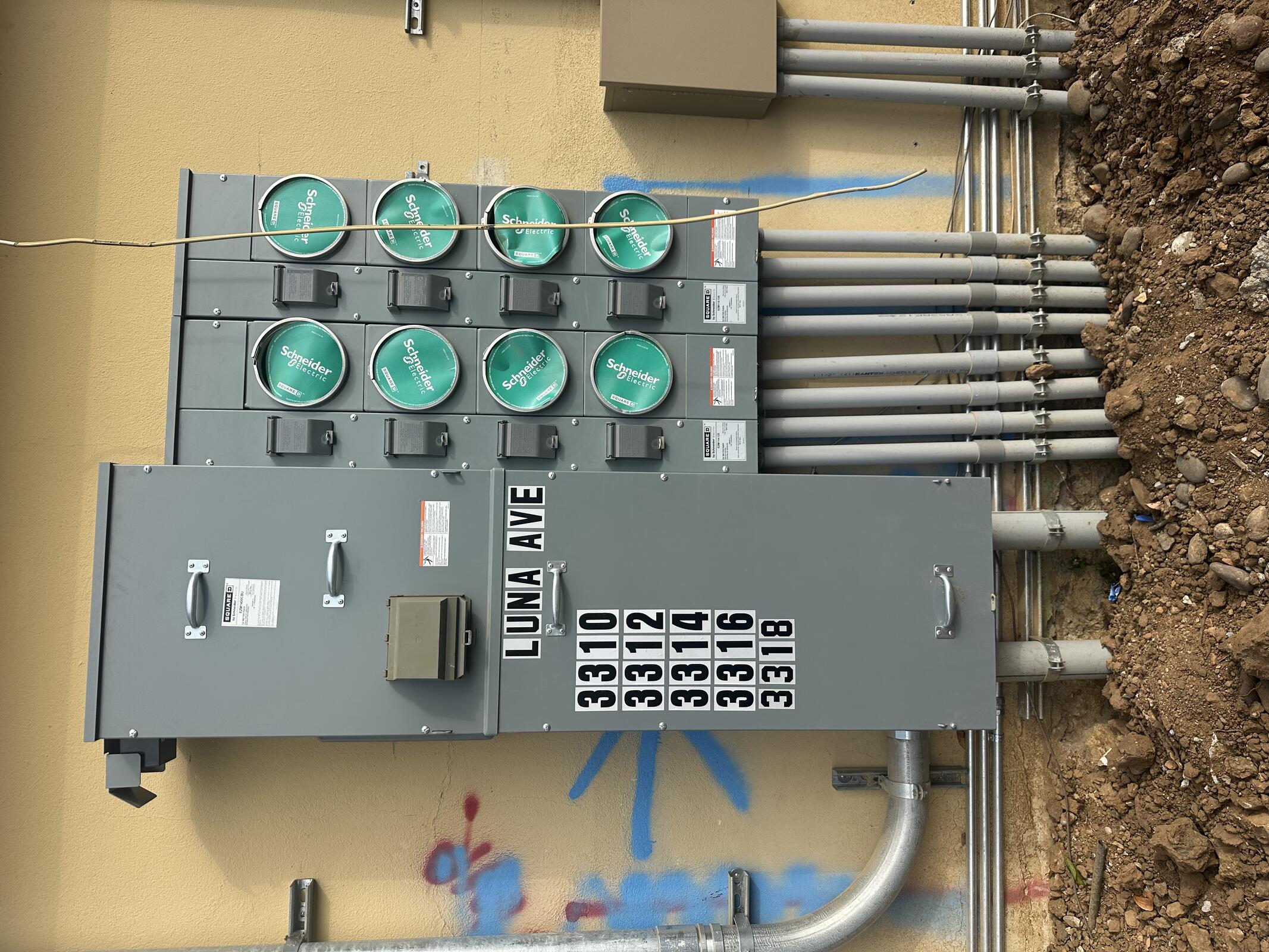

AC Electric installing house panel and preparing to pull wire.
Painters Unlimited continuing final coat.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| ZSP | 1 | 8 | 8 |
| Painters Unlimited | 3 | 8 | 24 |
| AC Electric | 1 | 4 | 4 |
Inspection: N/A
