Week 29 of 34

Week of July 06 — July 10, 2026

5 days on site. 55 photos. Cabinets, Electric, Paint, Plumbing, Site Concrete and Drainage, Stucco, Traffic Coating.

July 6, 2026July 10, 20265 days55 photos
CabinetsElectricPaintPlumbingSite Concrete and DrainageStuccoTraffic Coating

Monday, July 06, 2026

Clear, 74°F

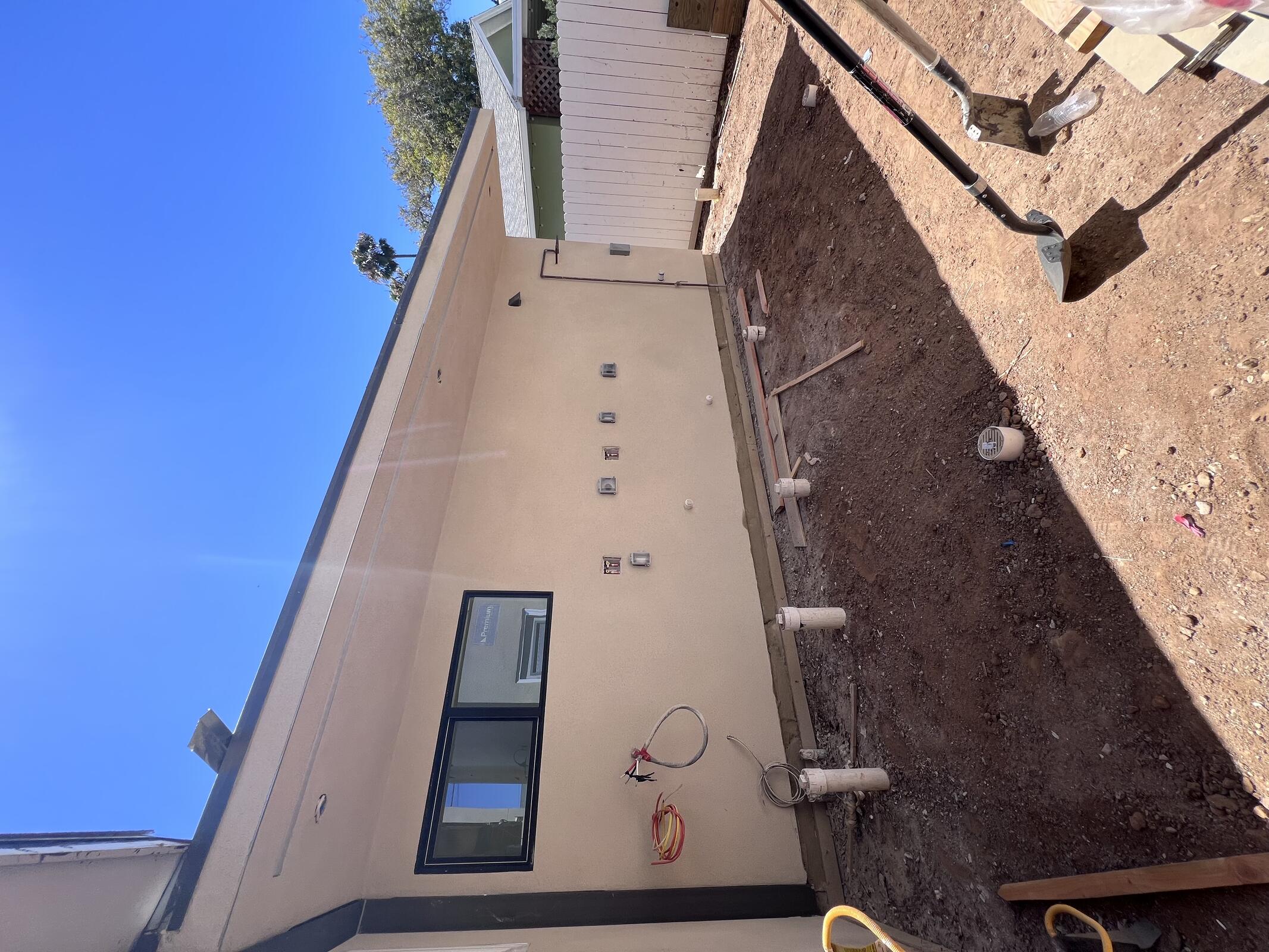

JBG continuing formwork for site concrete at Building C and between the buildings.

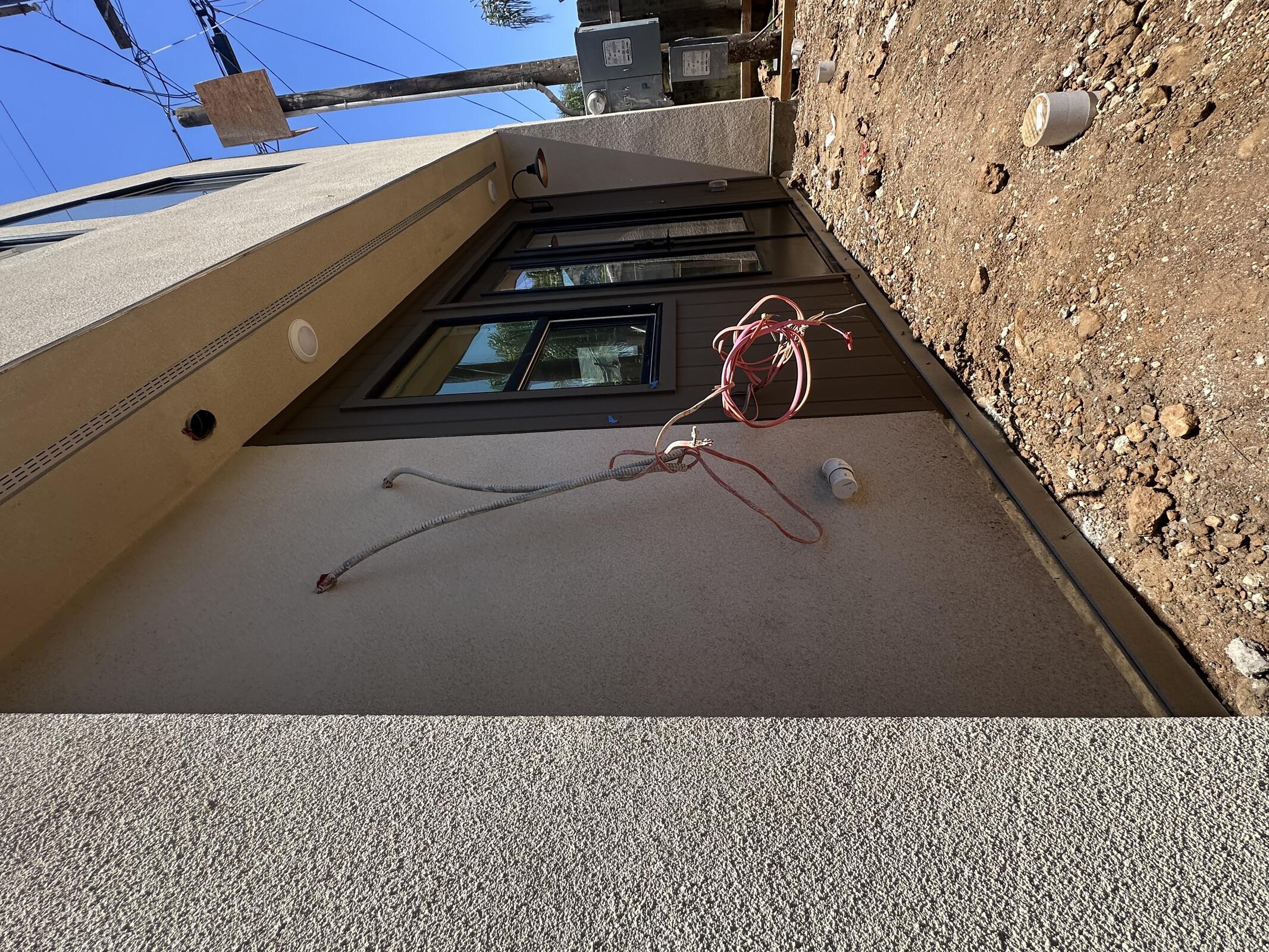

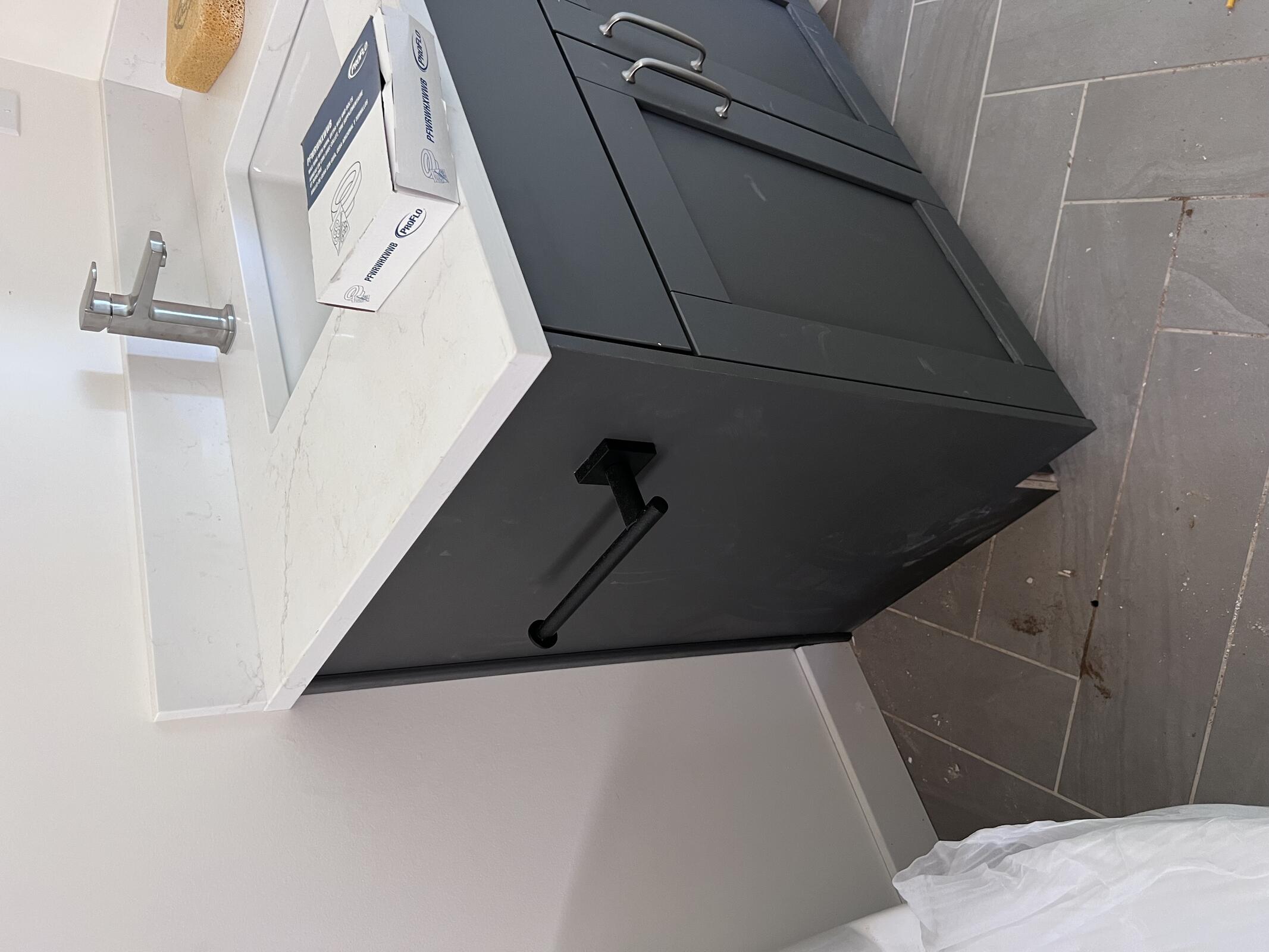

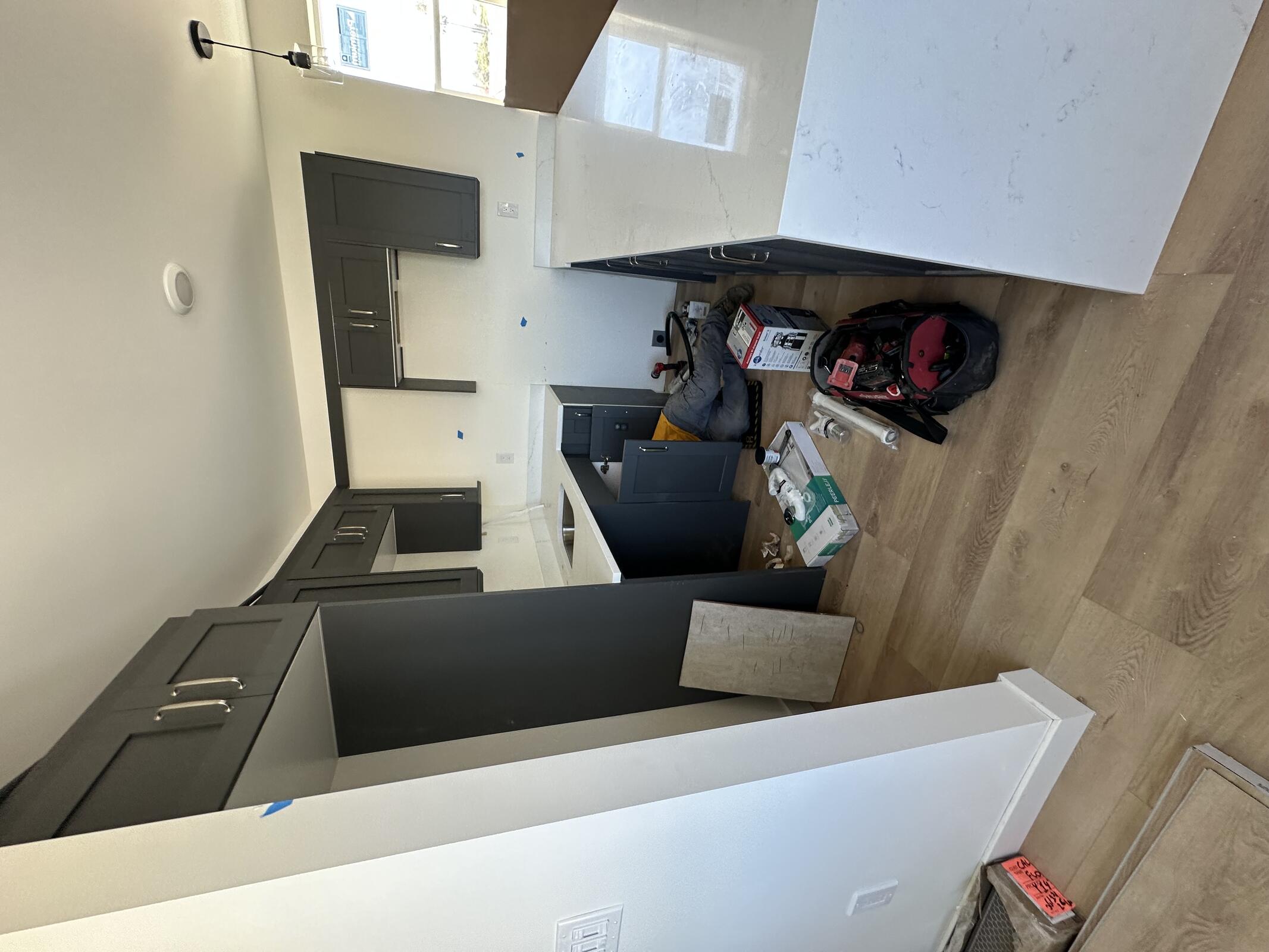

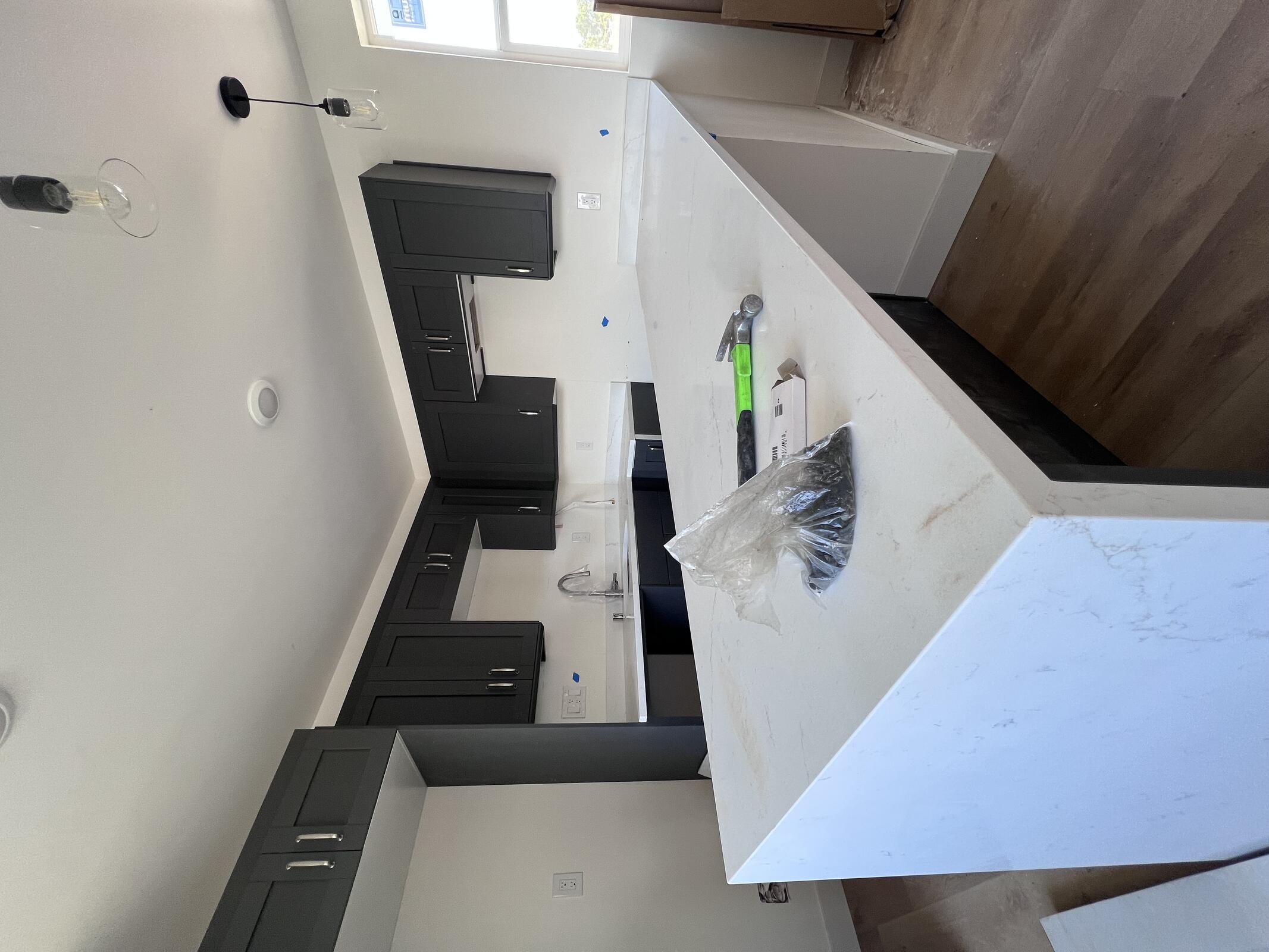

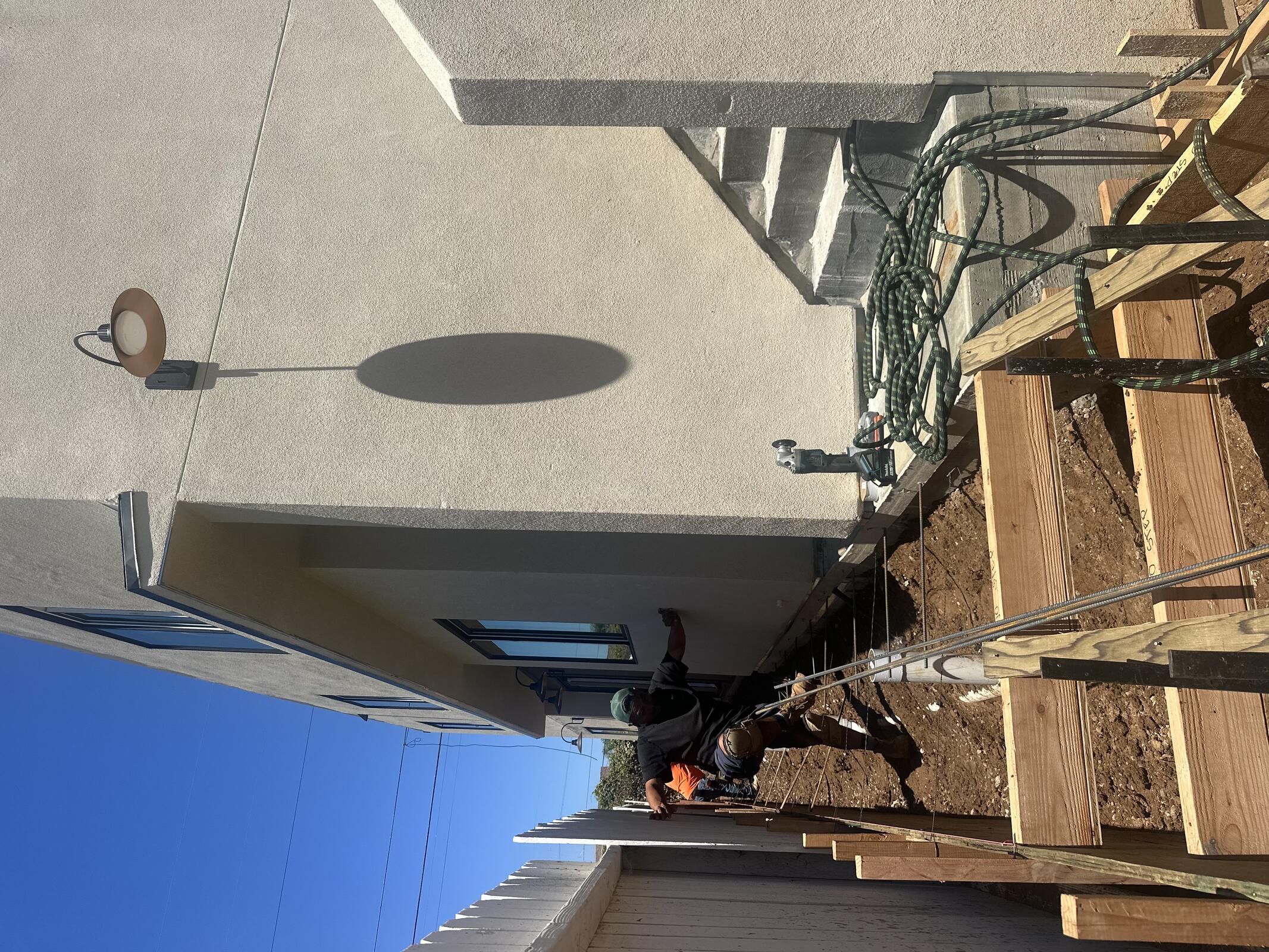

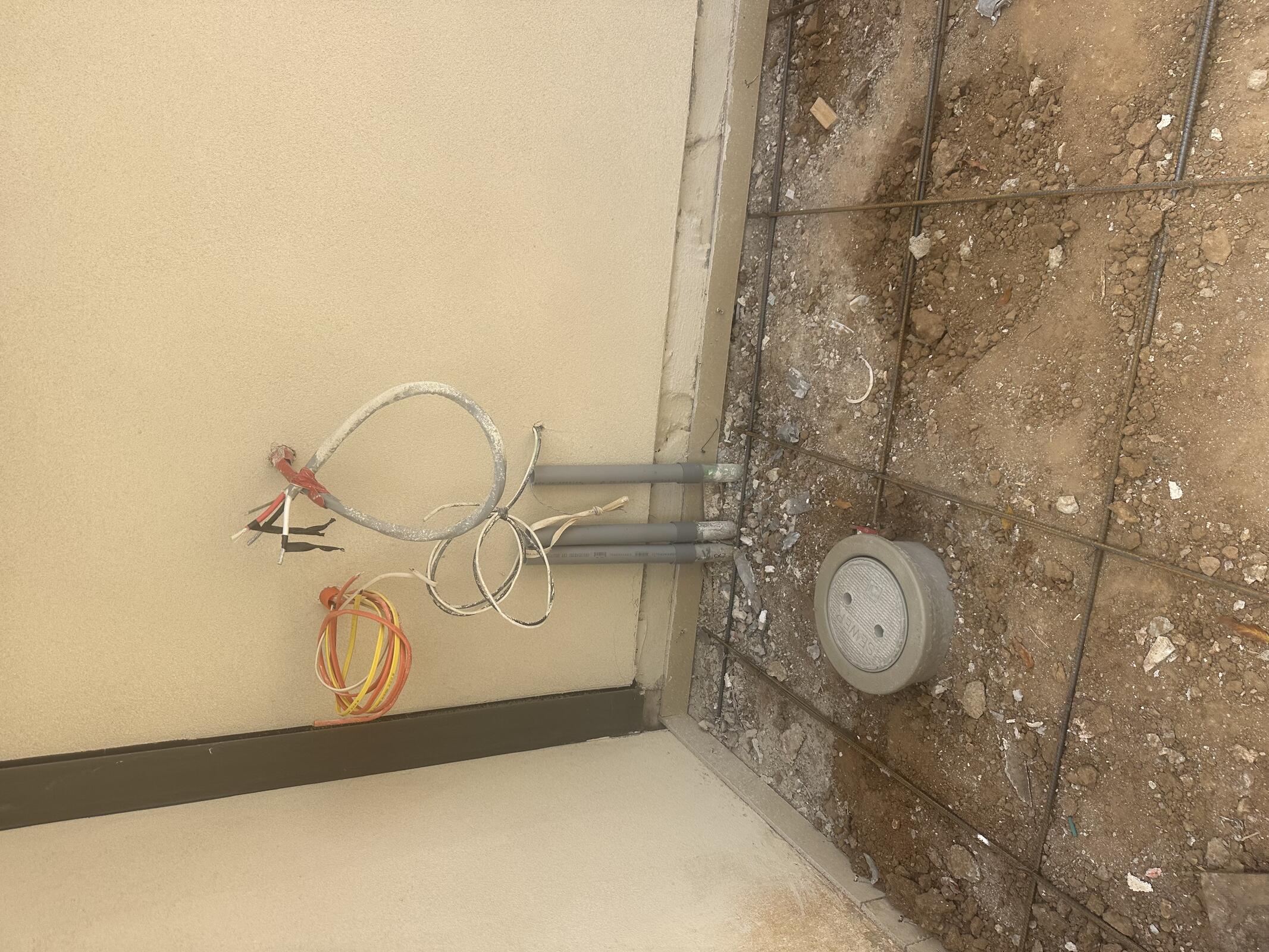

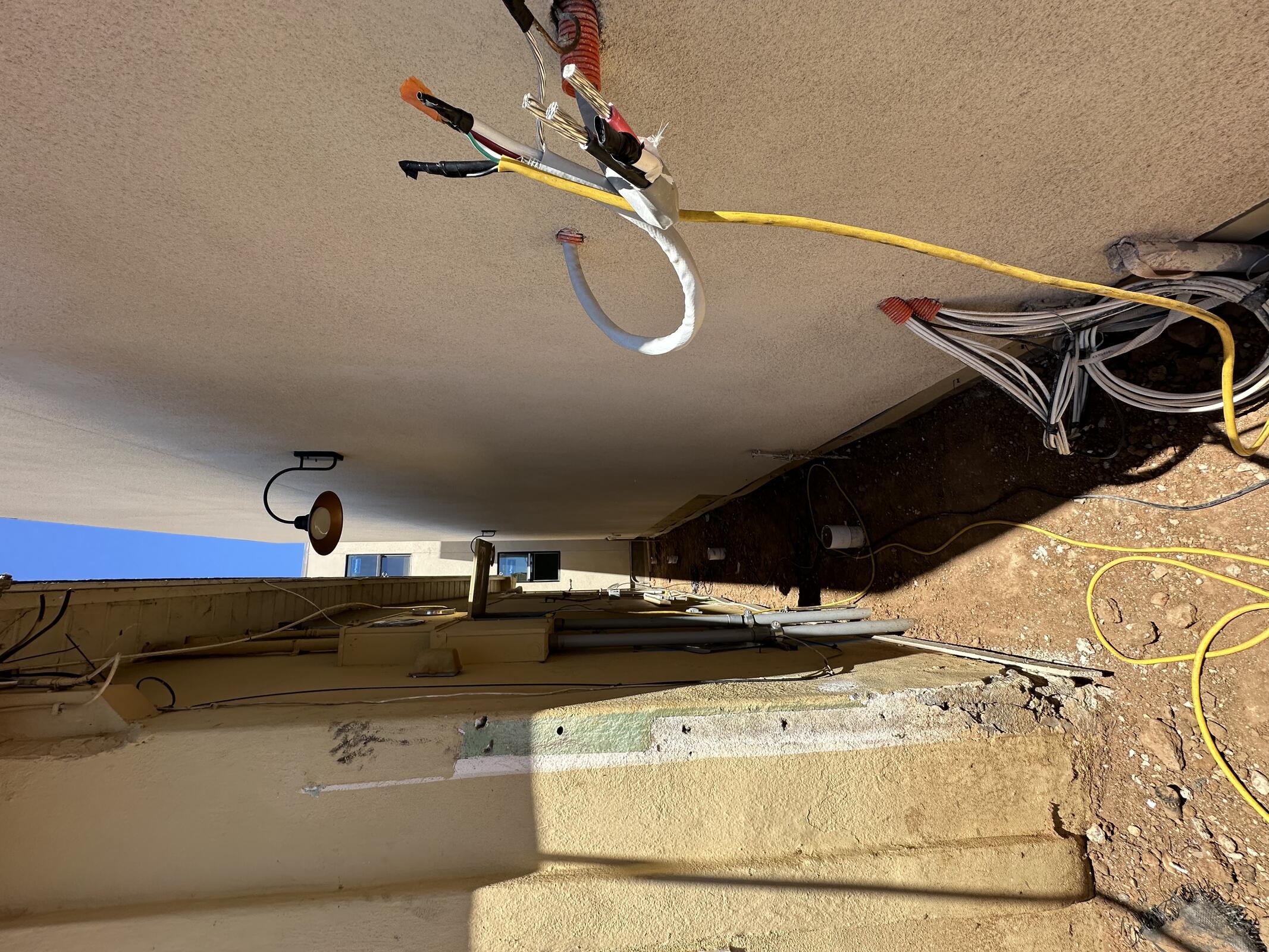

AC Electric continuing trim out and other pick up items.

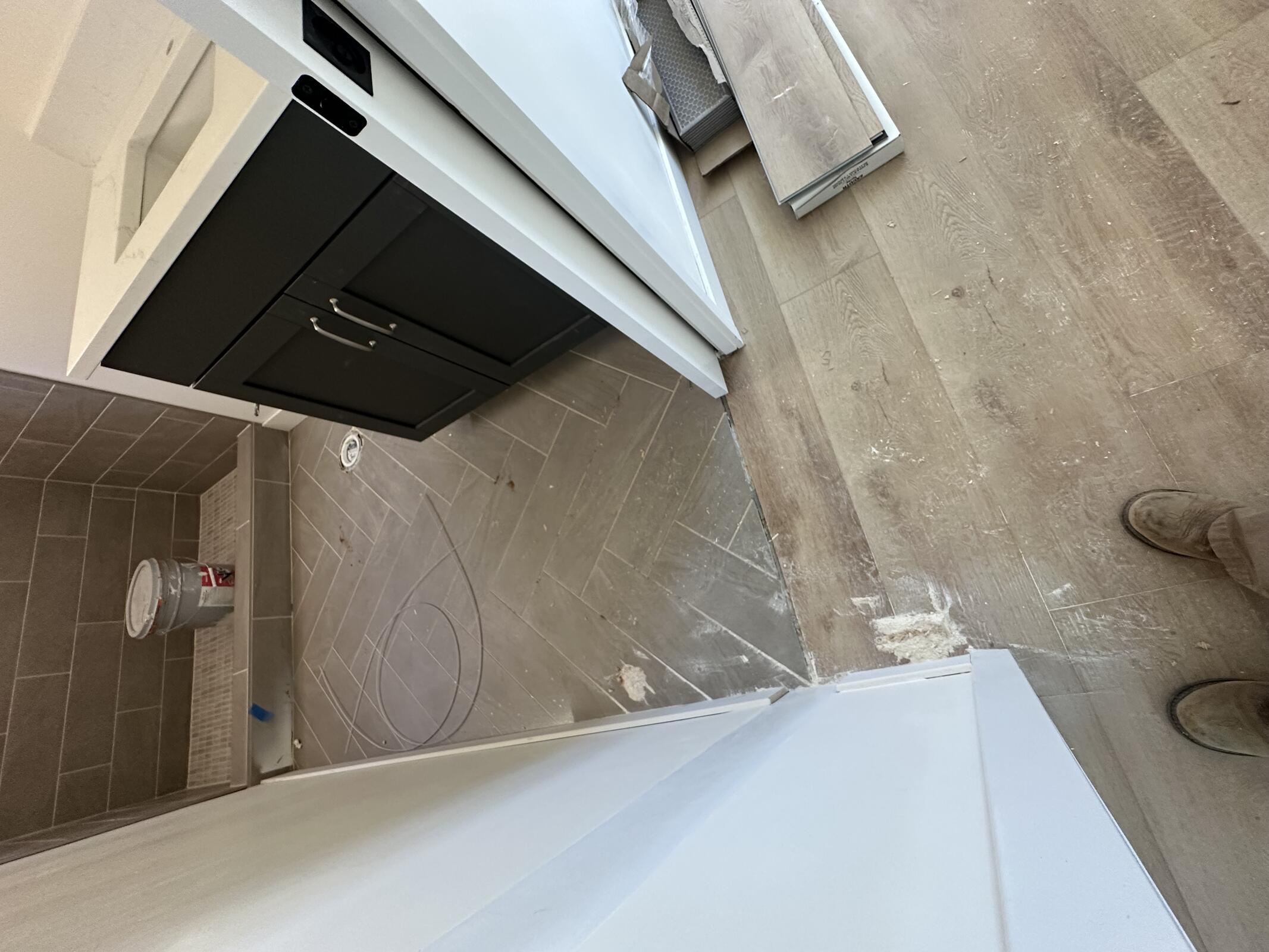

ZSP continuing trim out.

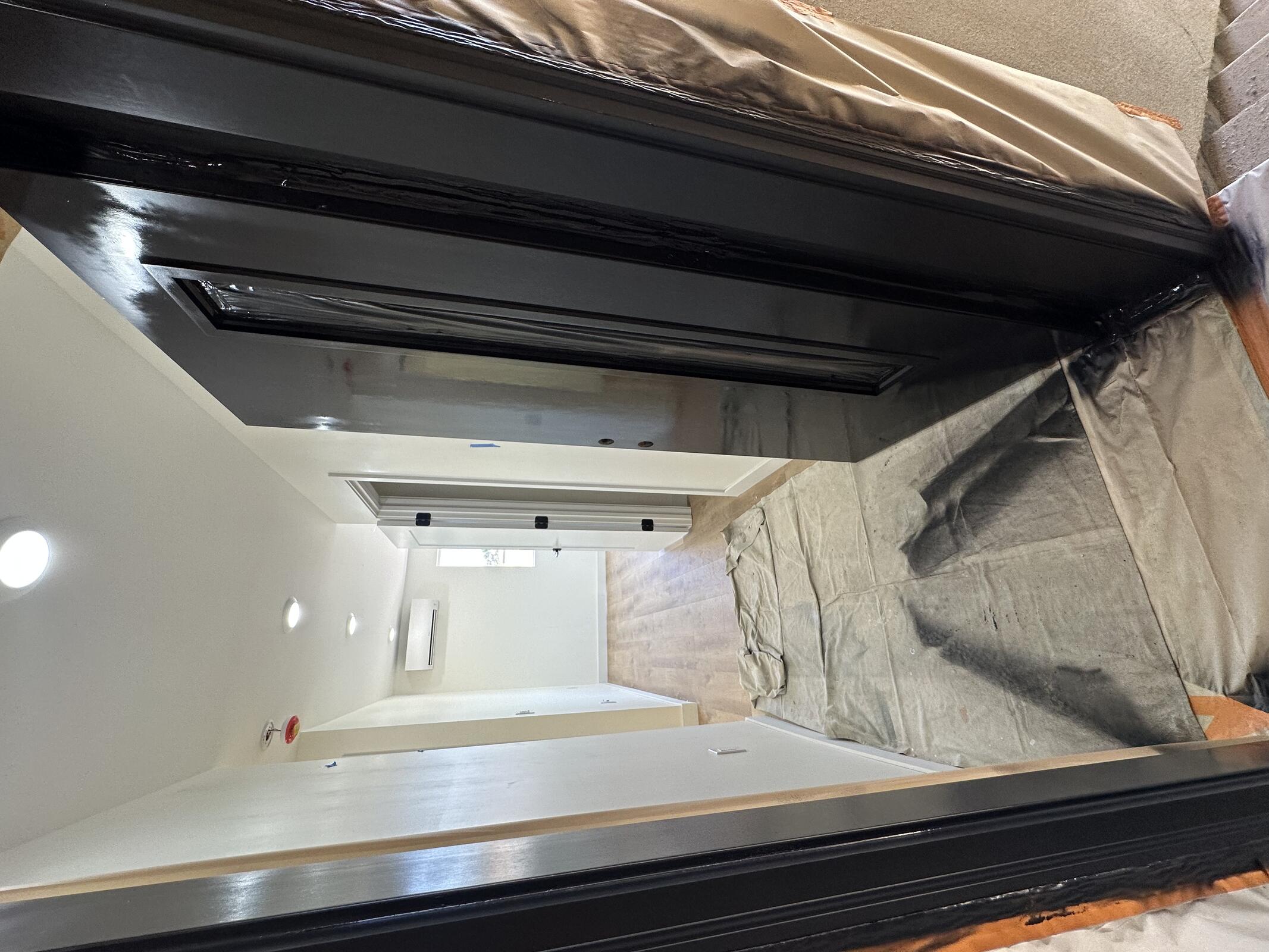

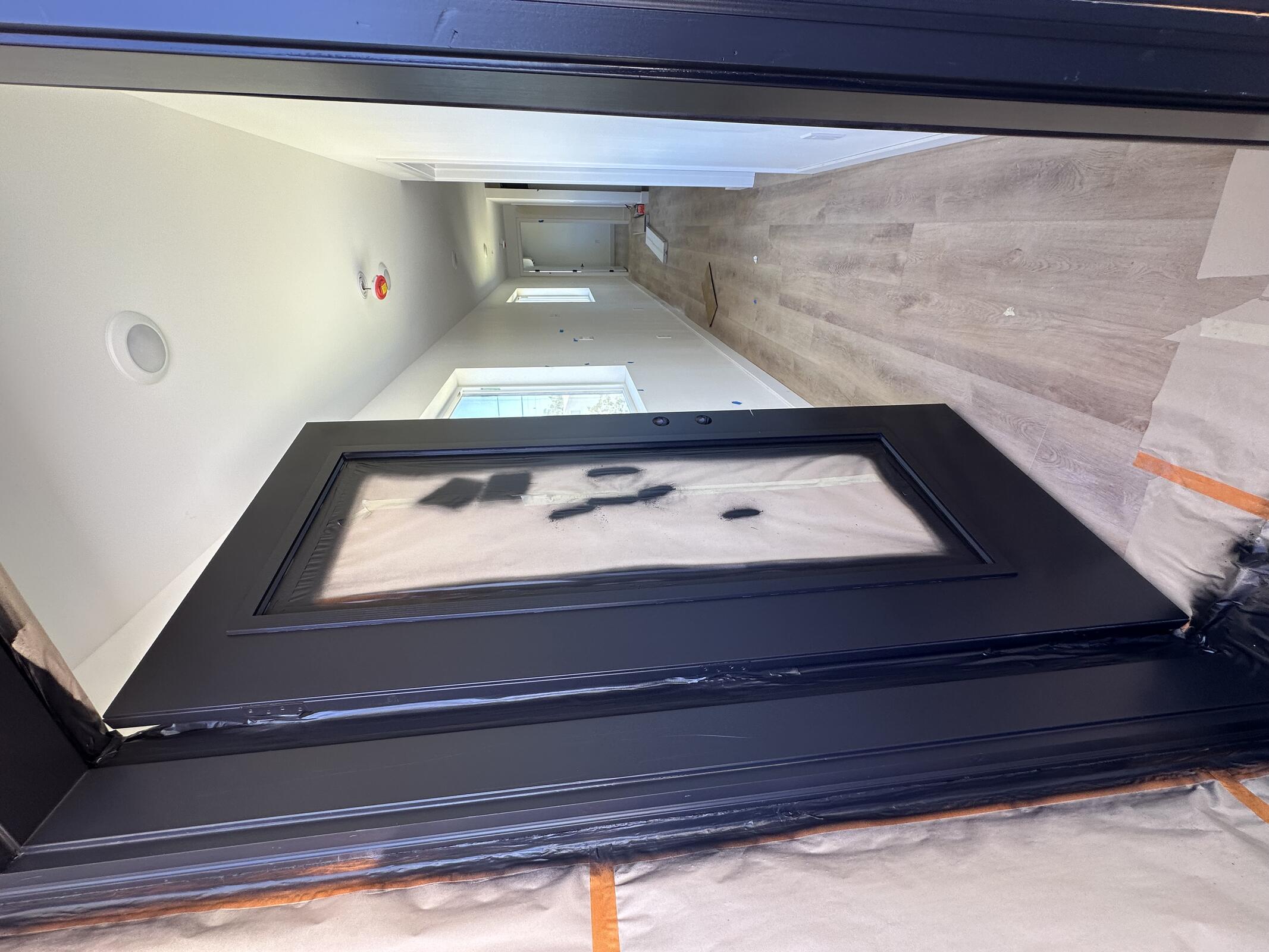

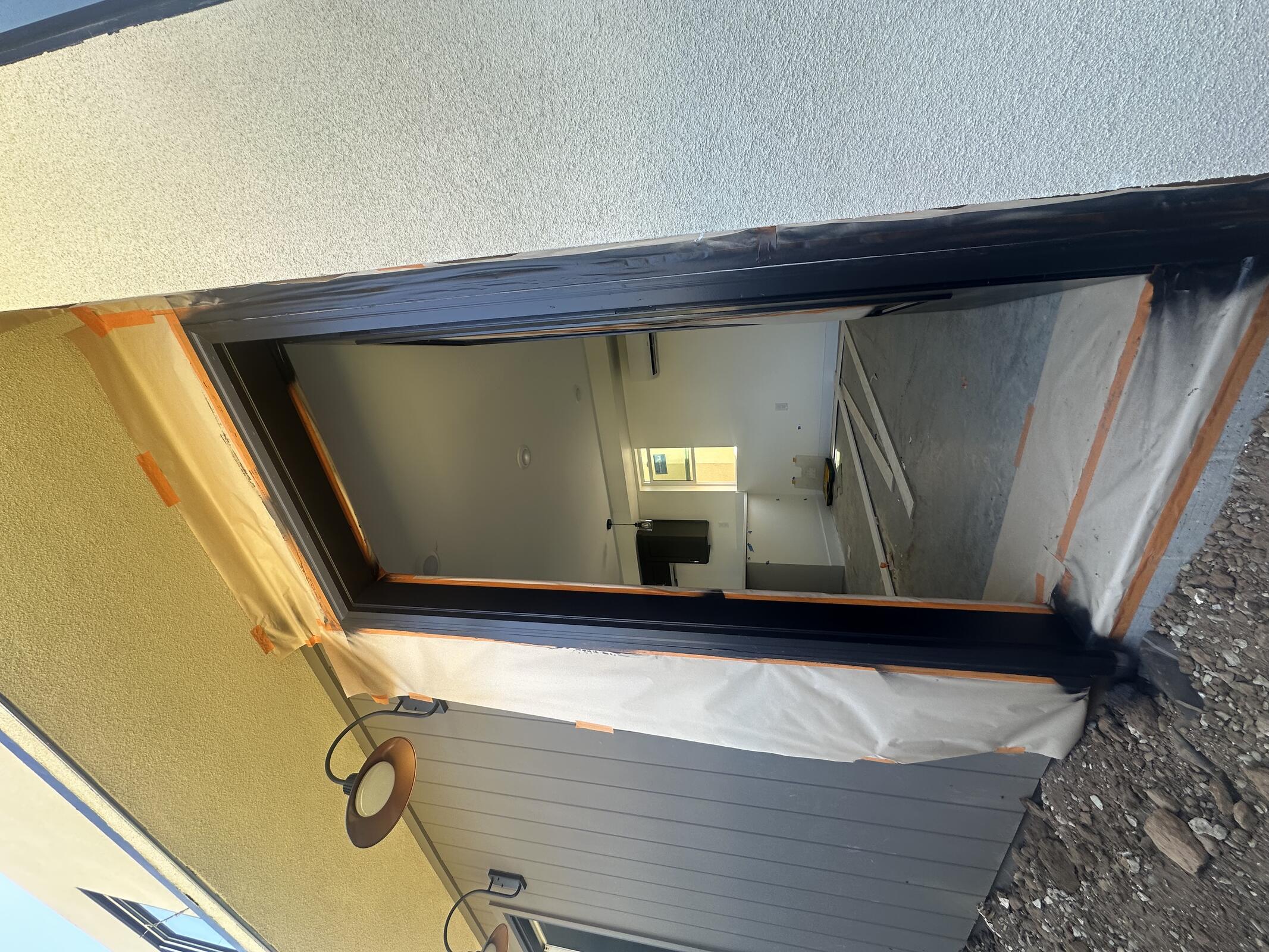

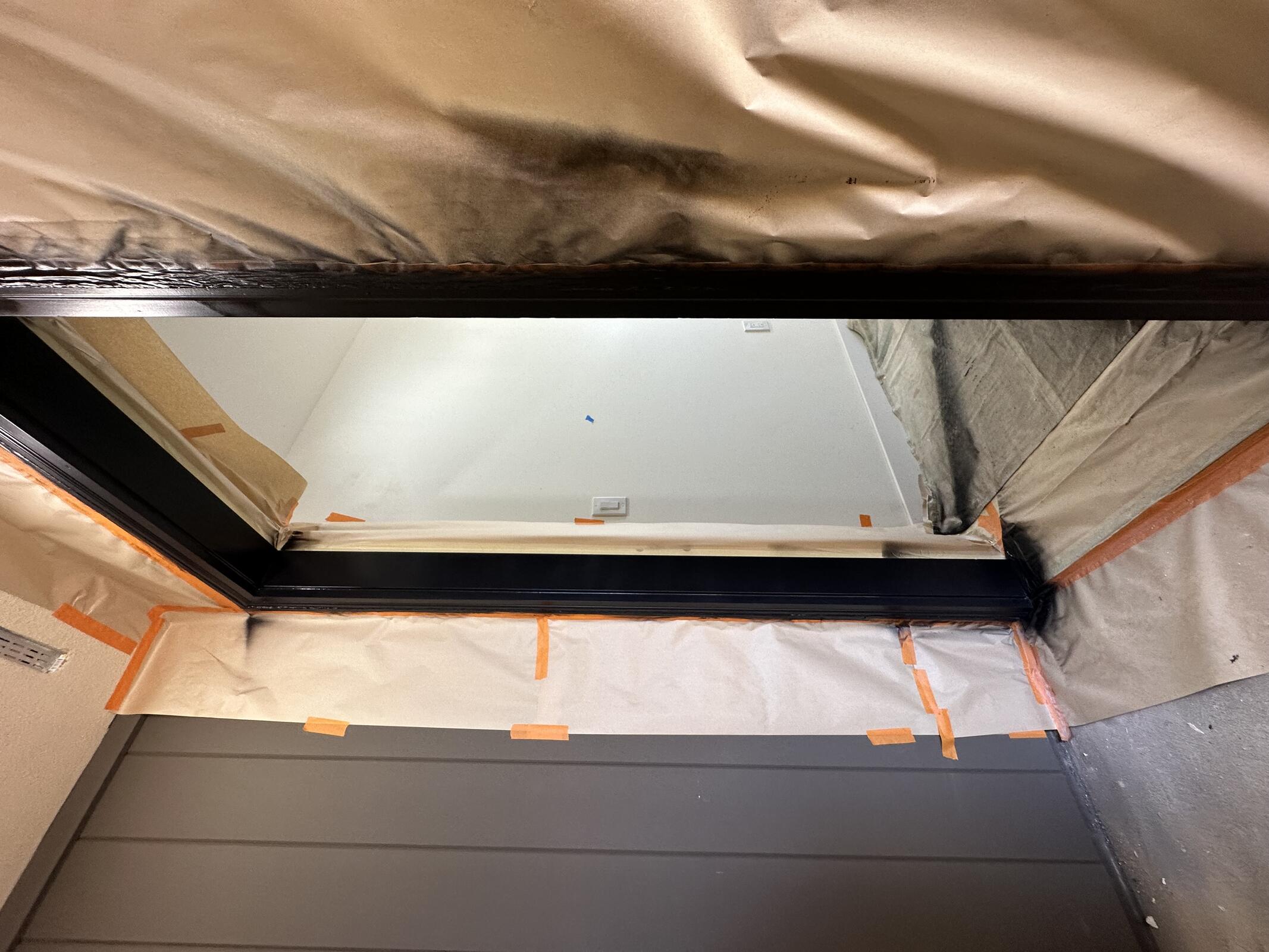

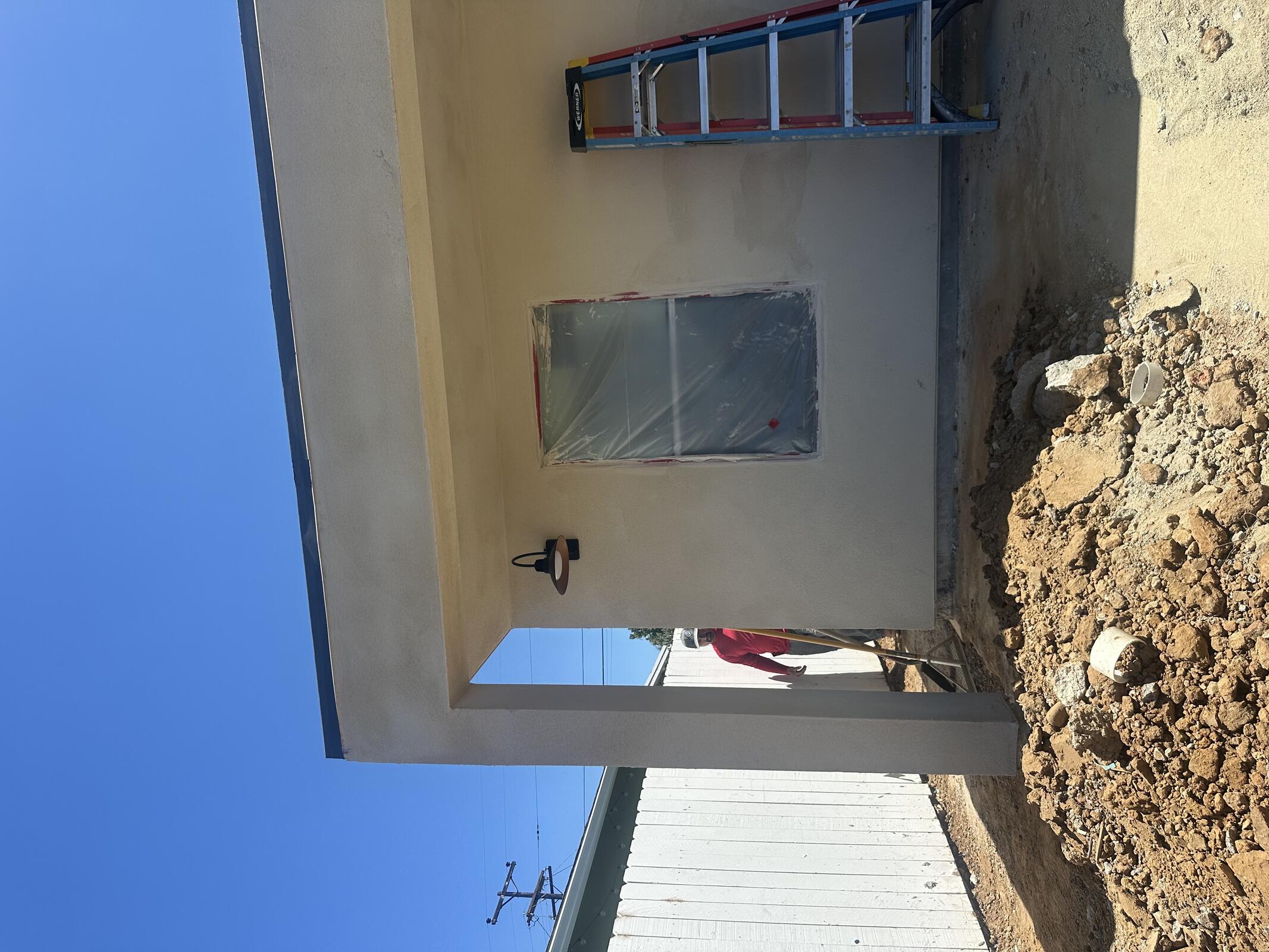

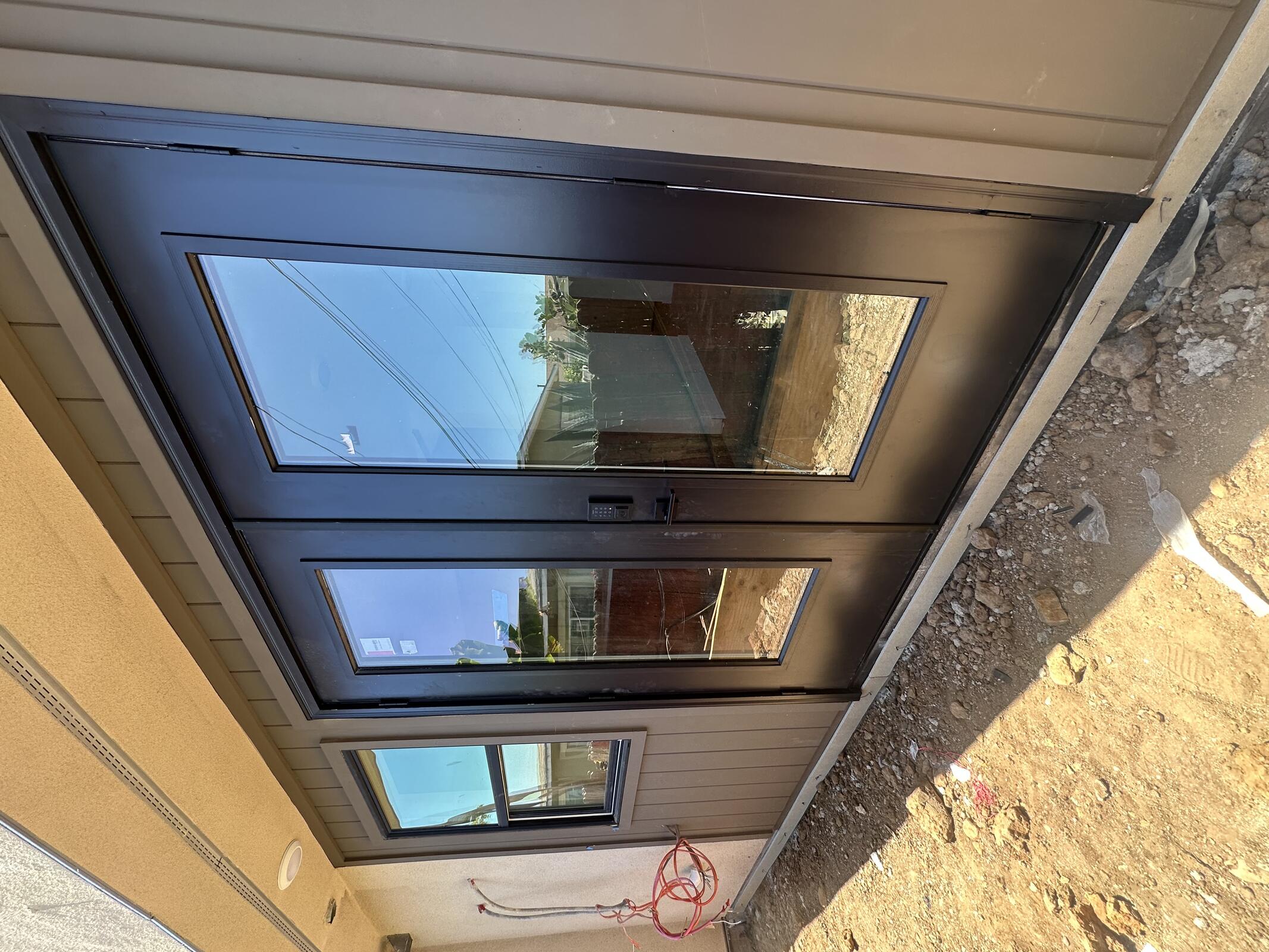

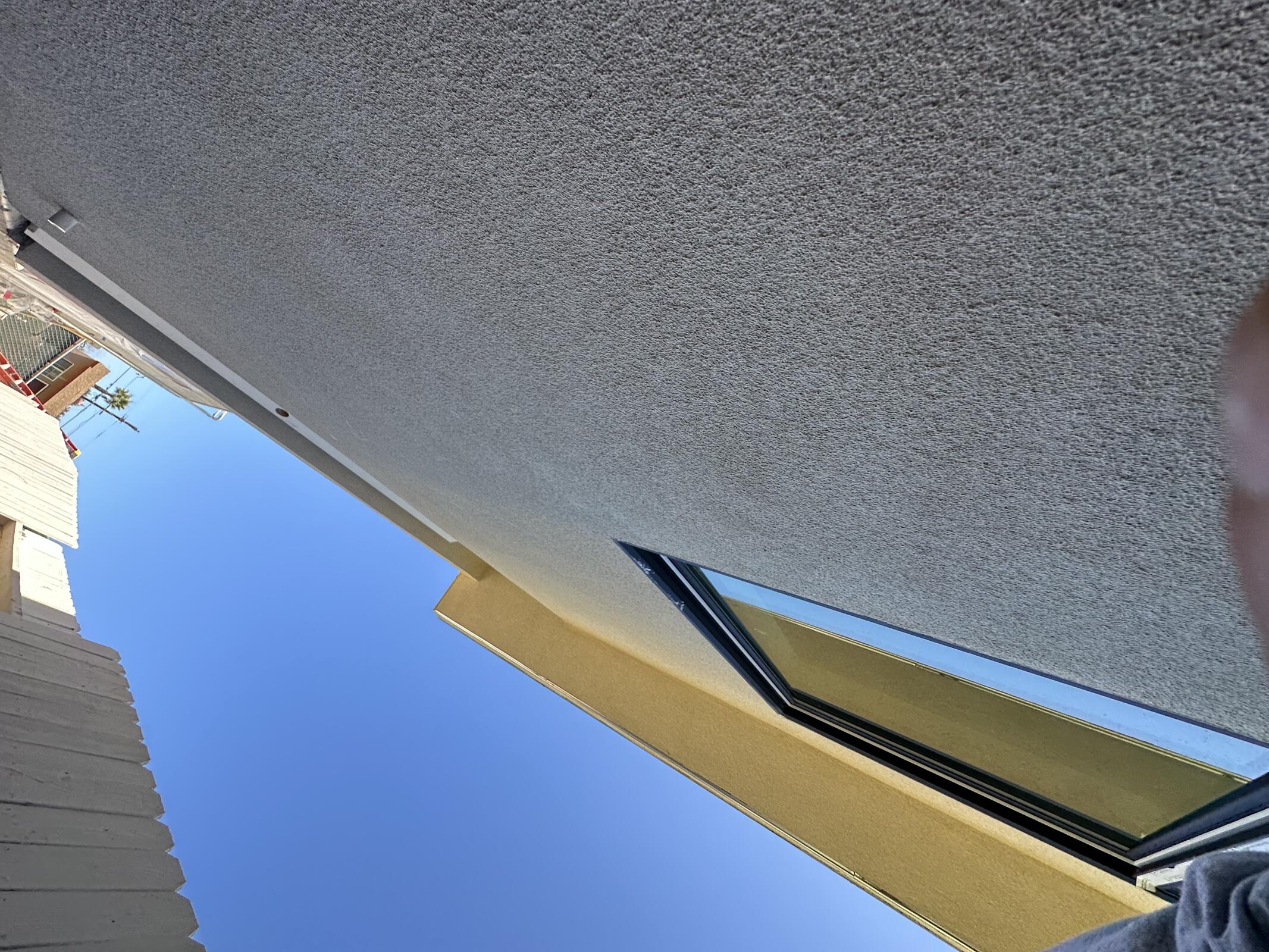

Painters Unlimited painting exterior doors.

ML walked site with Ken Huffman (Traditions Drywall) to discuss punchlist items.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
ZSP188
AC Electric1.5812
JBG5840
Painters Unlimited144

Inspection: N/A

Delay: Electrical issue (city/SDGE)

Tuesday, July 07, 2026

Clear, 73°F

Primera completing pick up items.

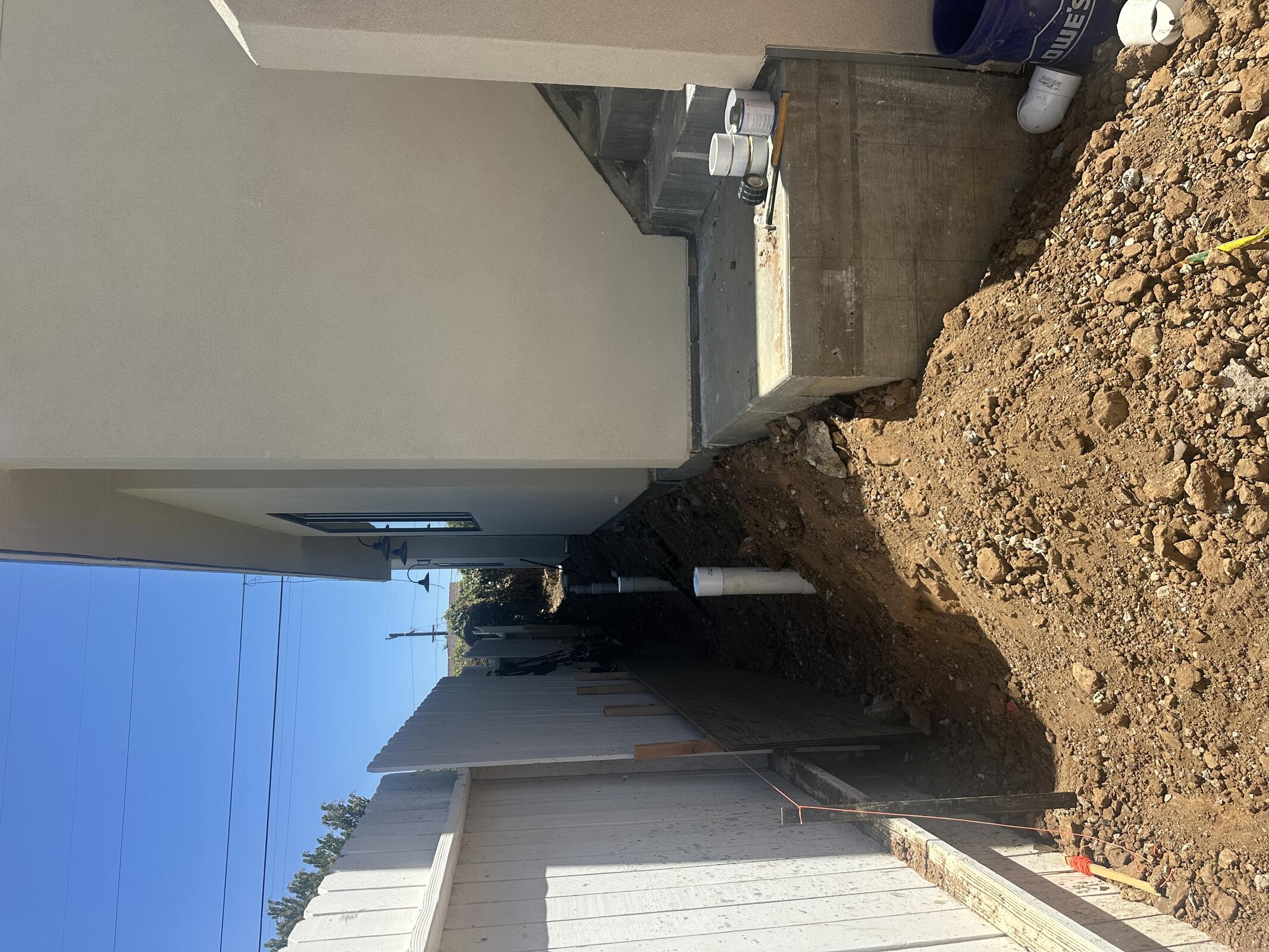

JBG continuing to form site concrete.

ZSP trimming out.

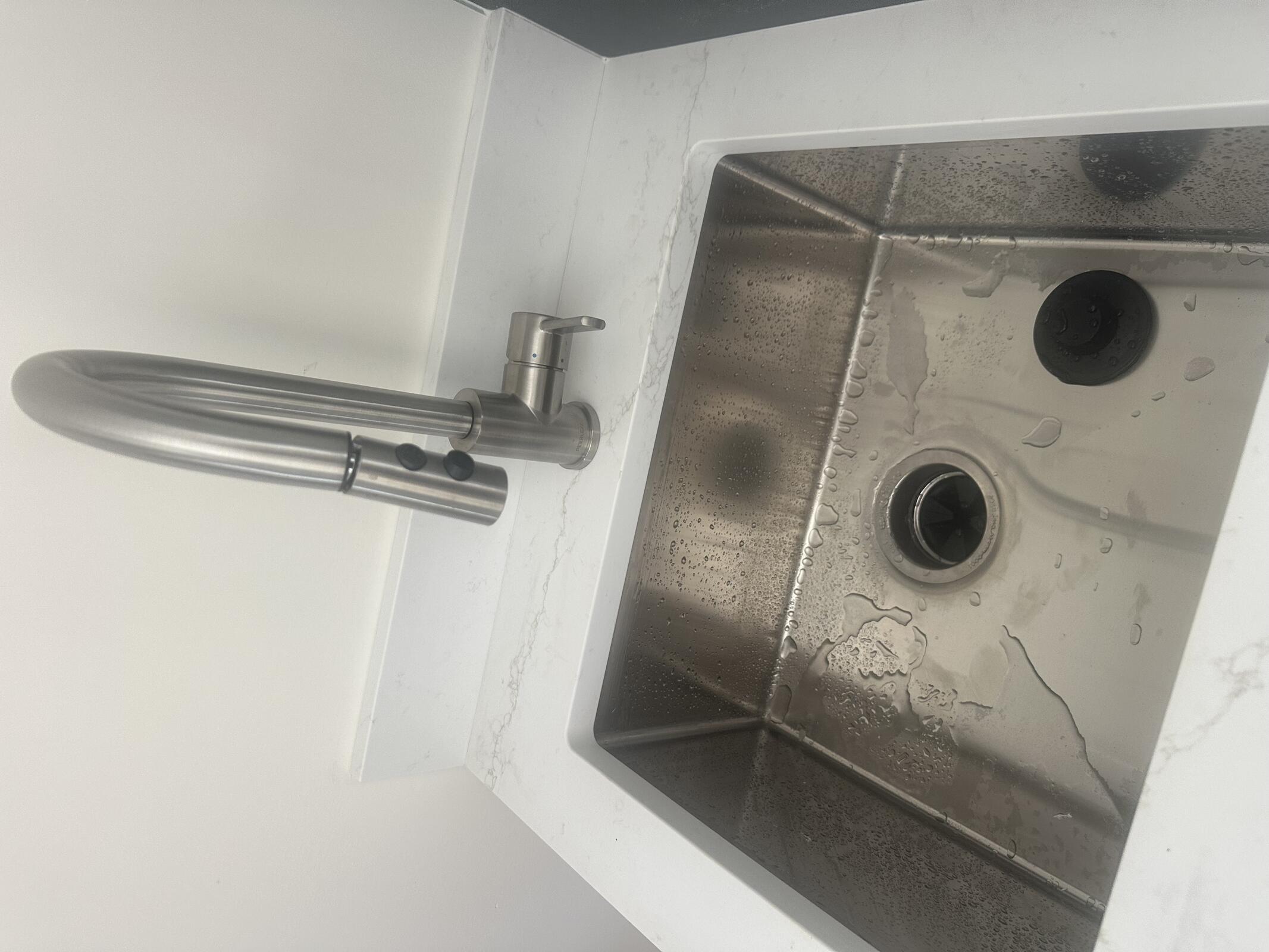

AC Electric trimming out.

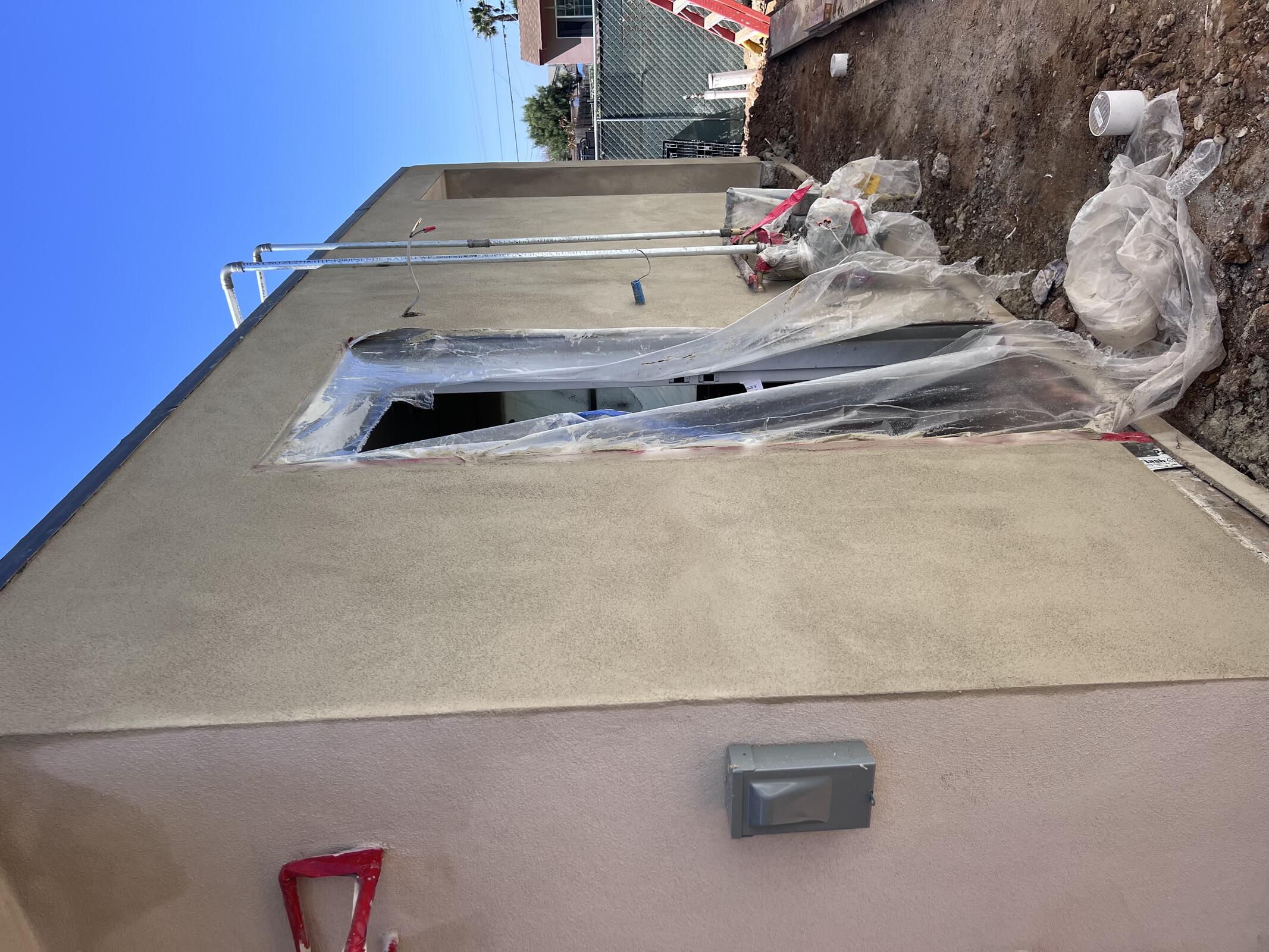

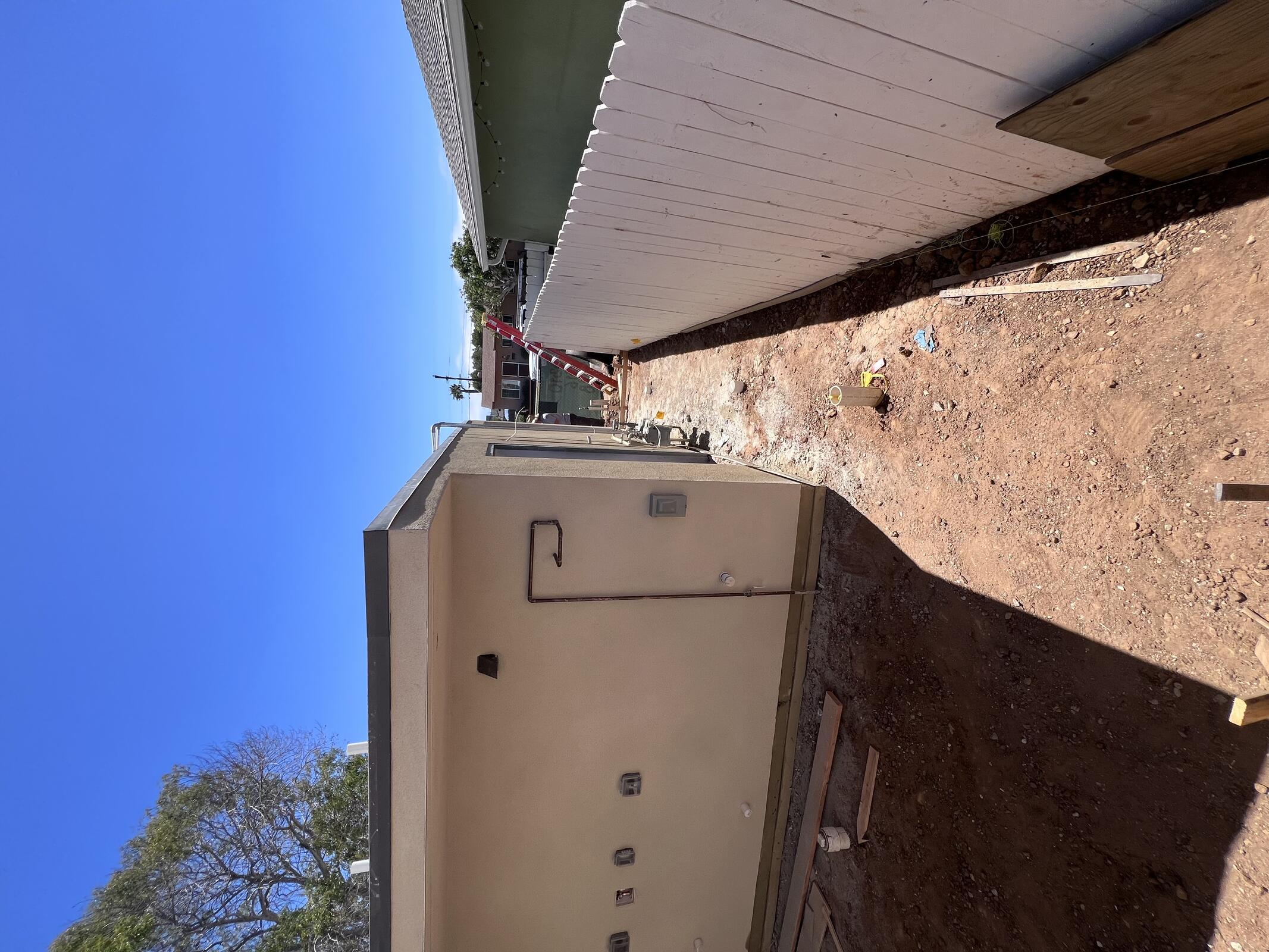

Marq finishing stucco at garage.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
Primera188
JBG6848
Marq2816
AC Electric0.584
ZSP188

Inspection: N/A

Delay: Pending City review and SDGE response

Wednesday, July 08, 2026

Clear, 74°F

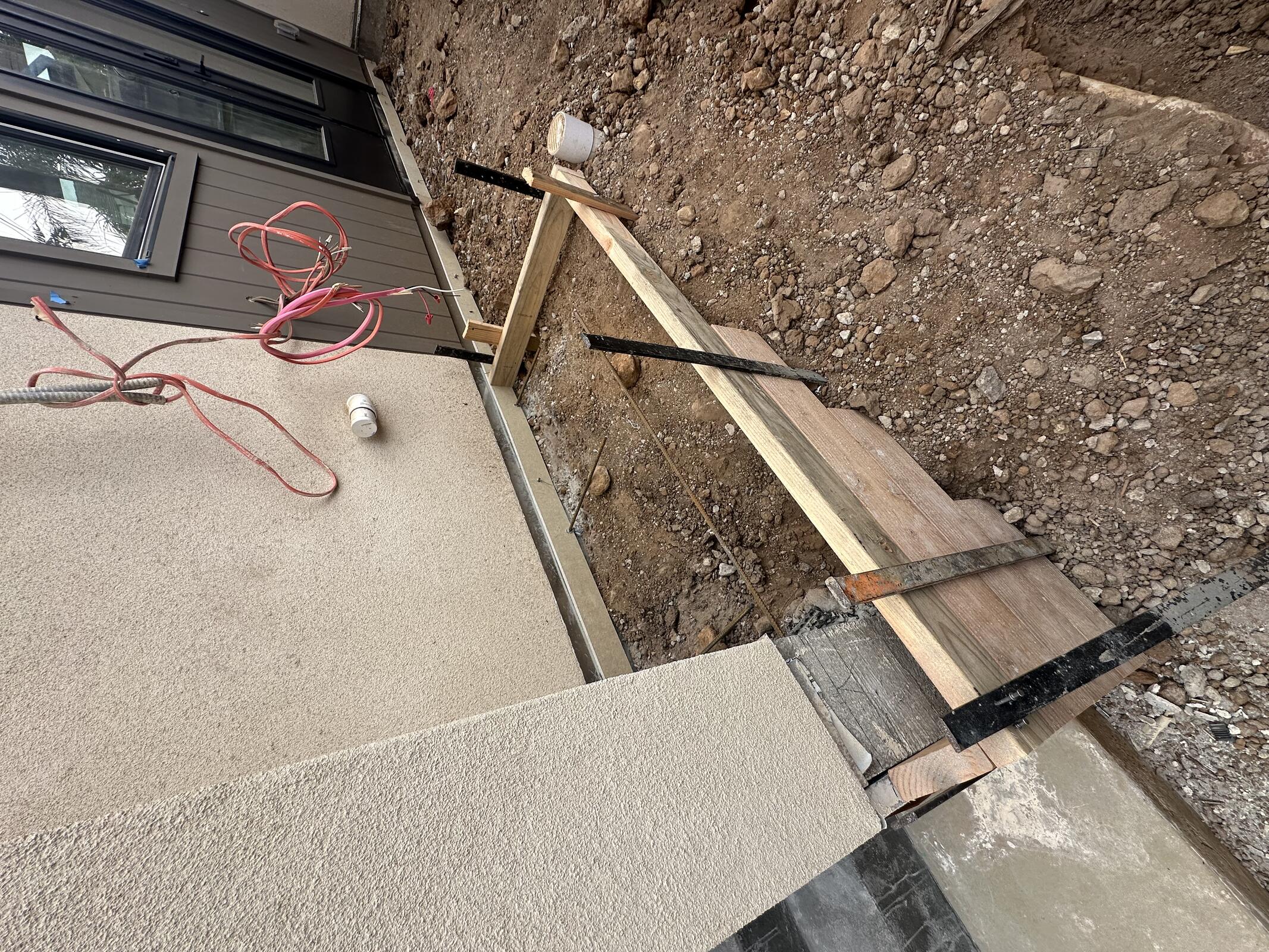

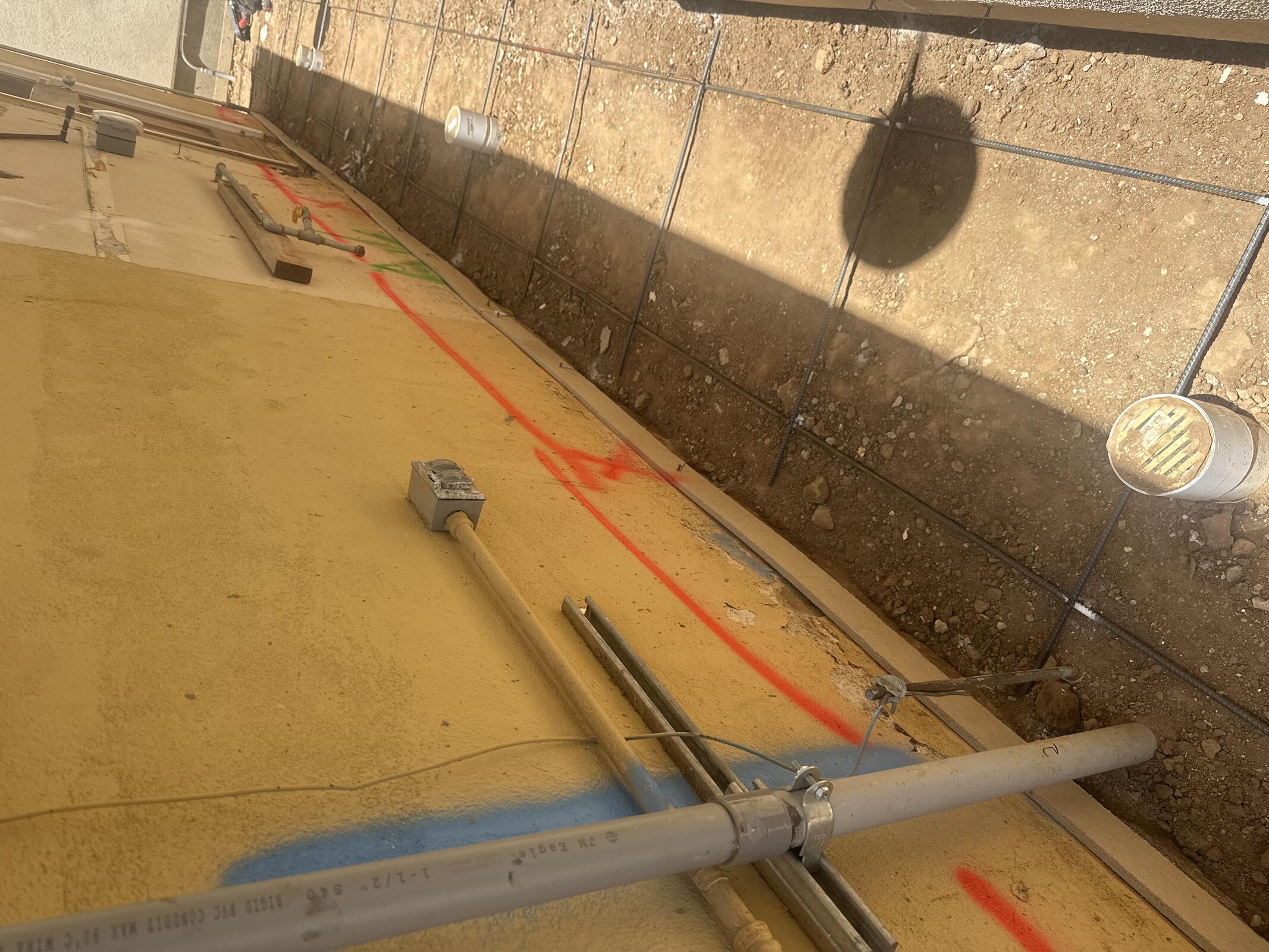

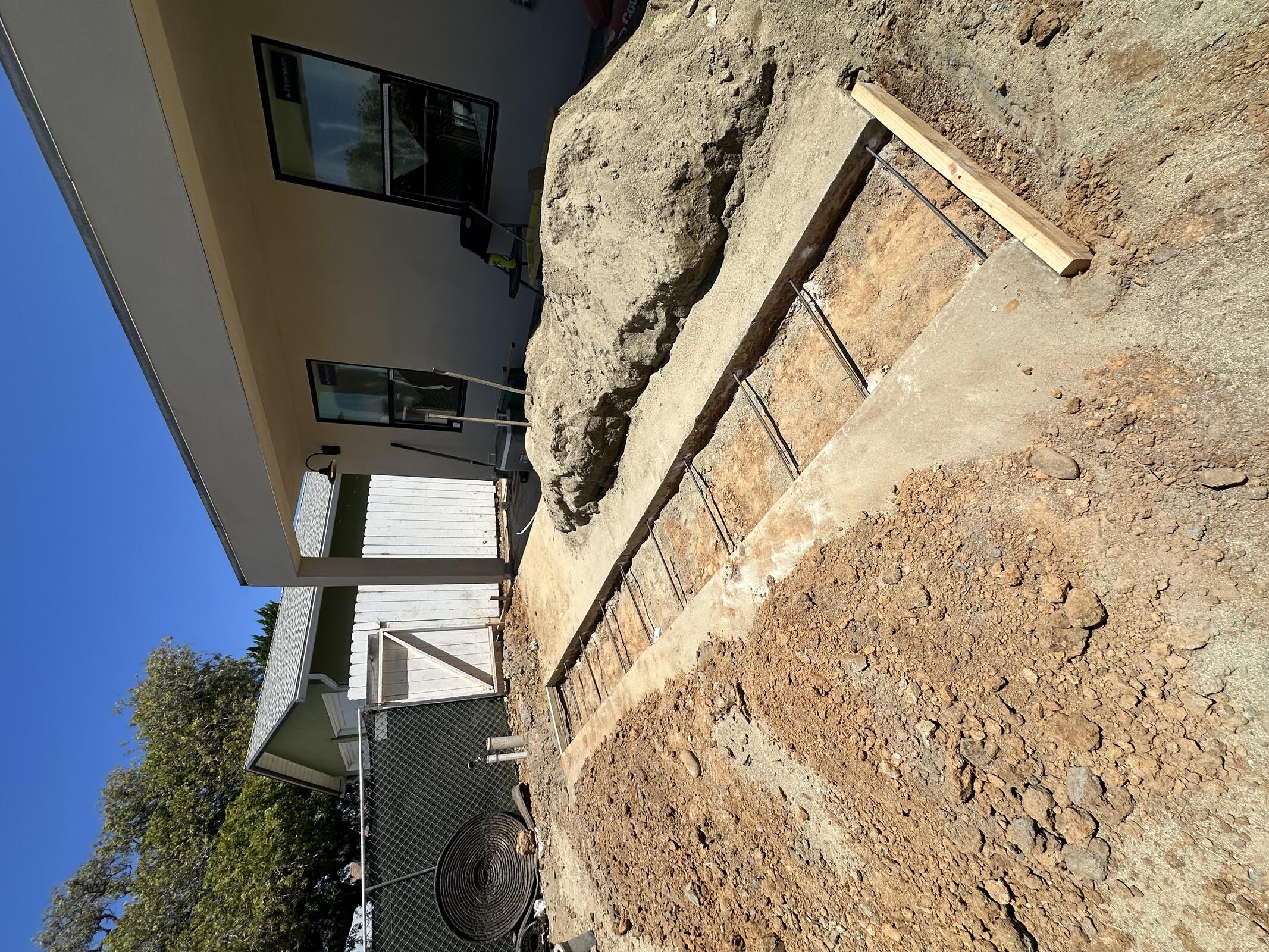

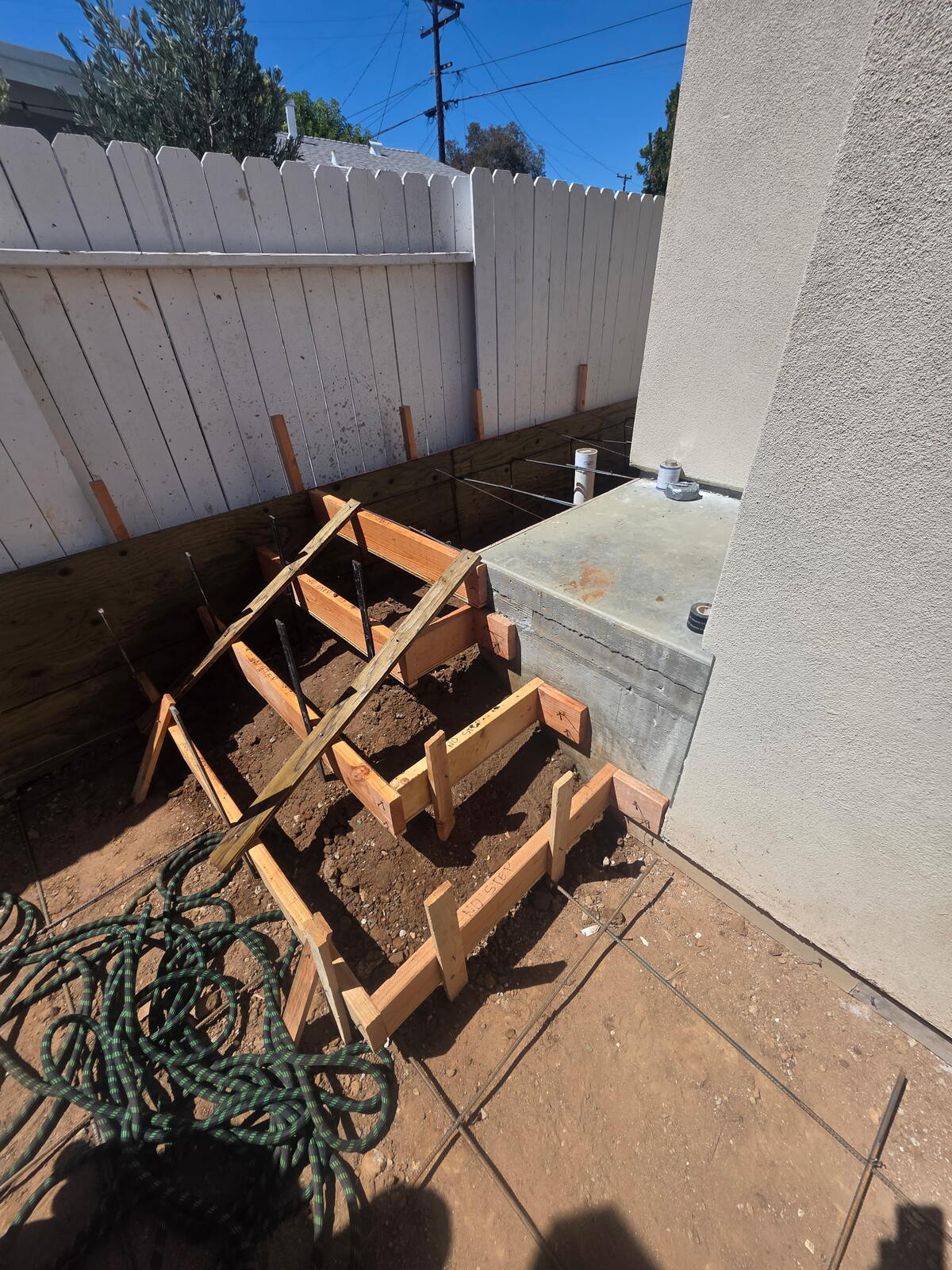

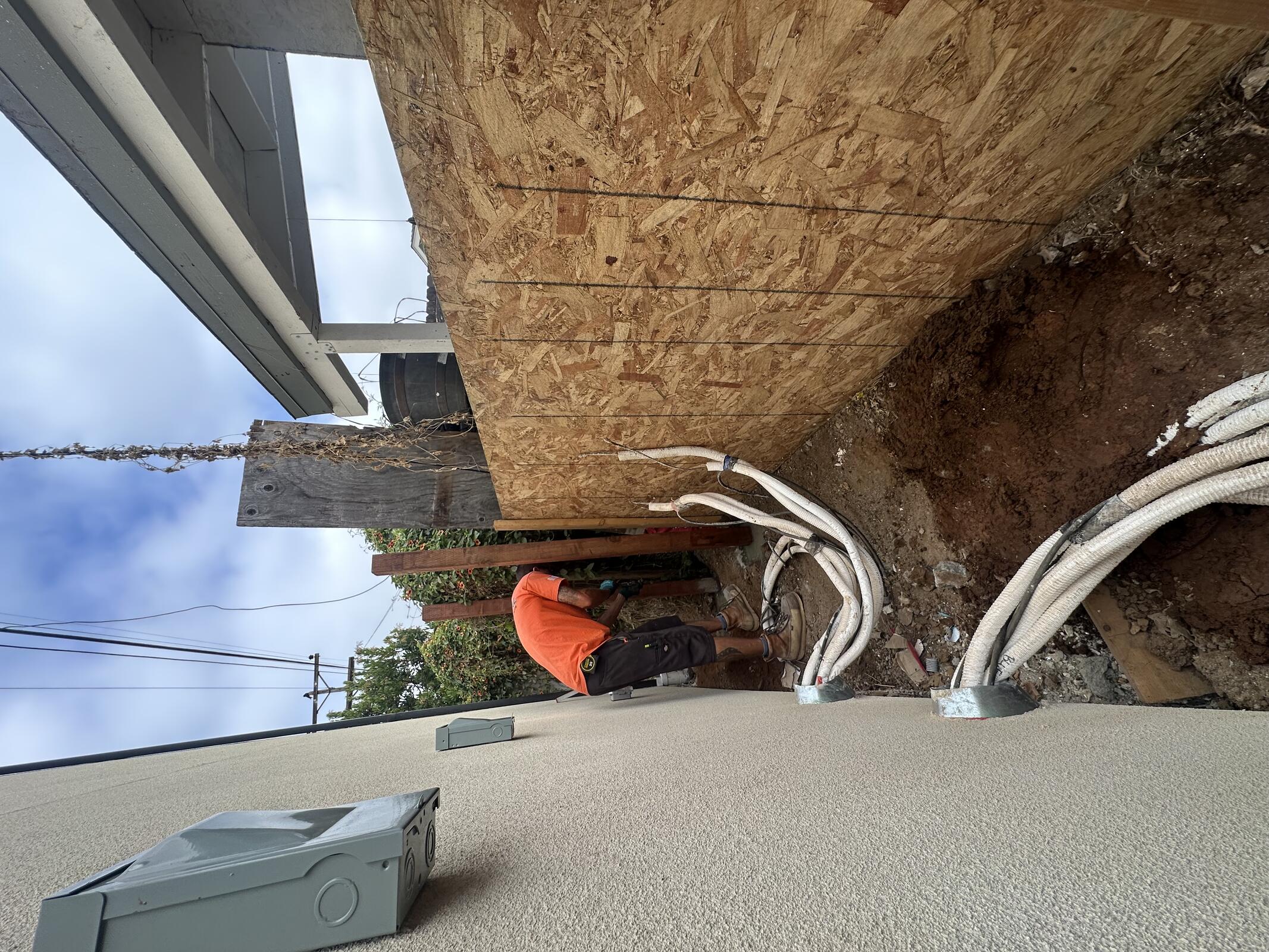

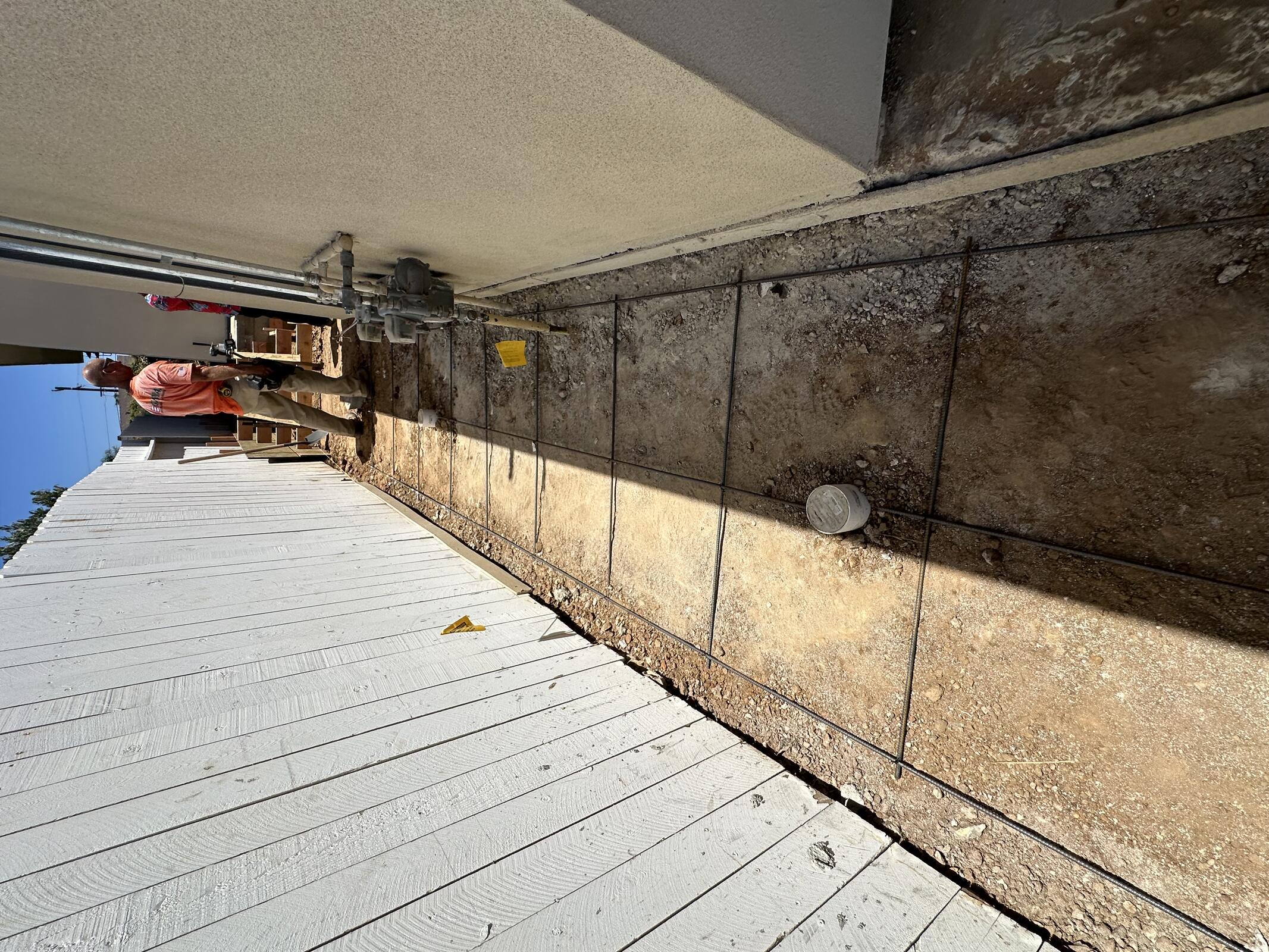

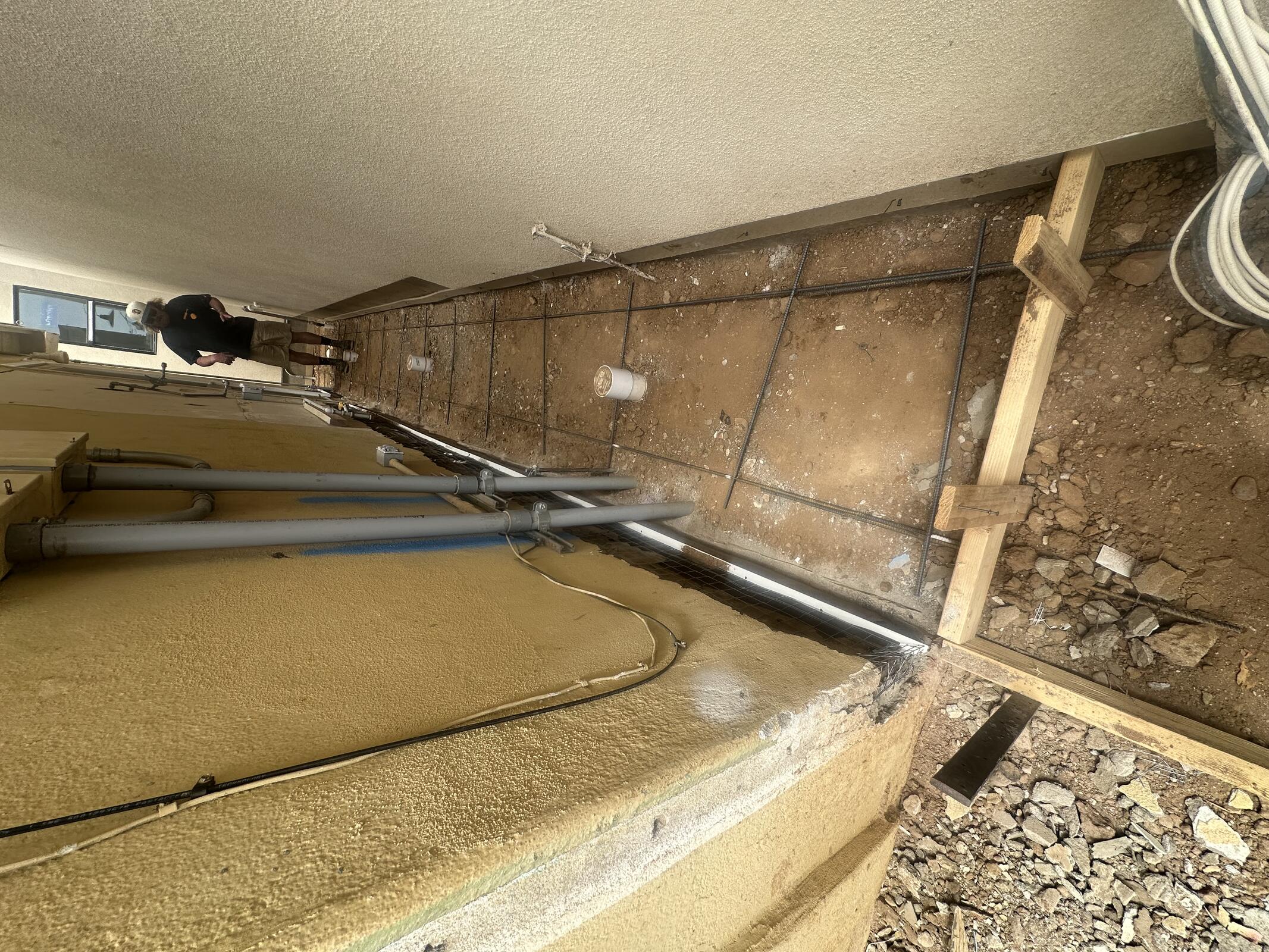

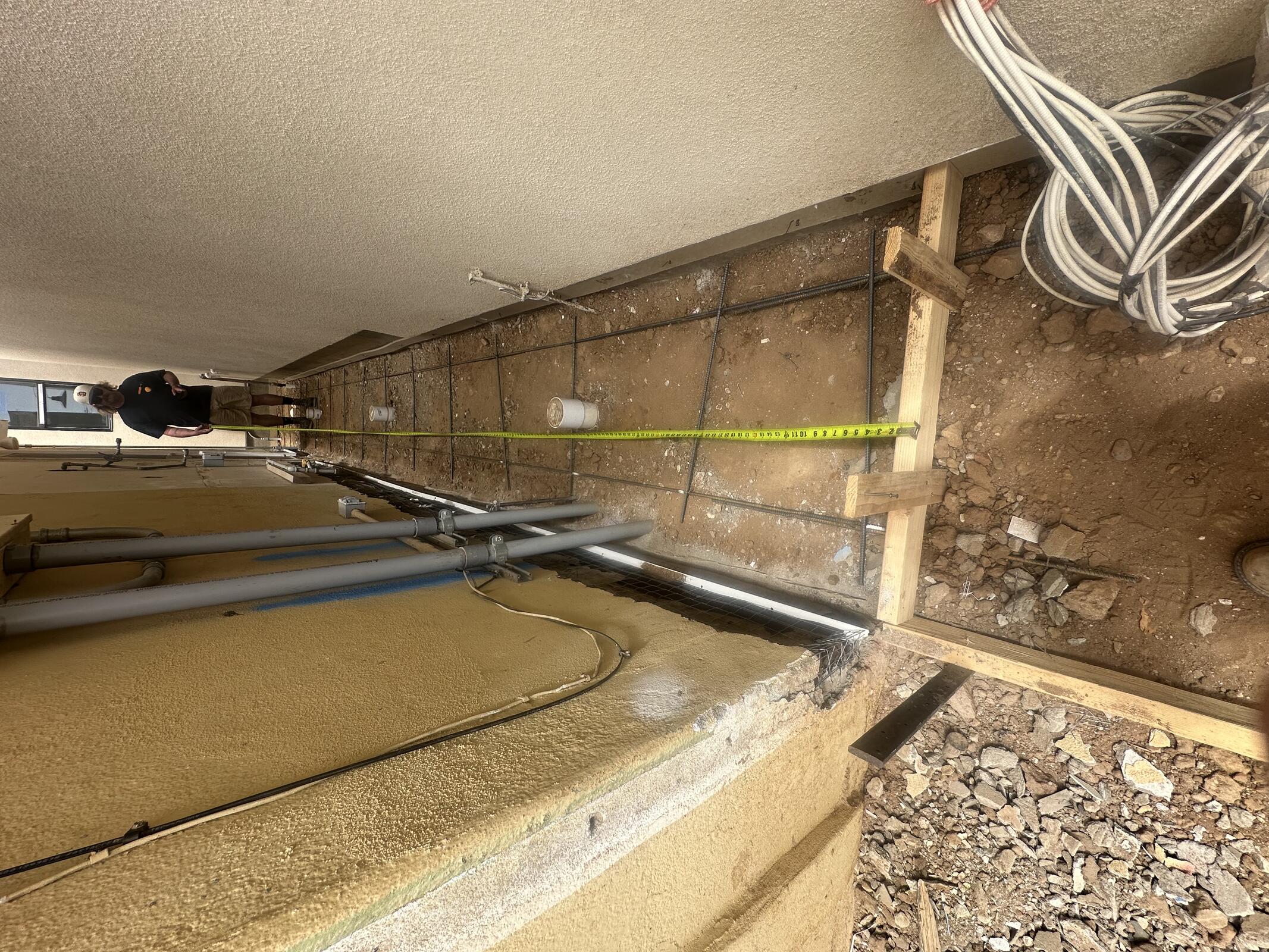

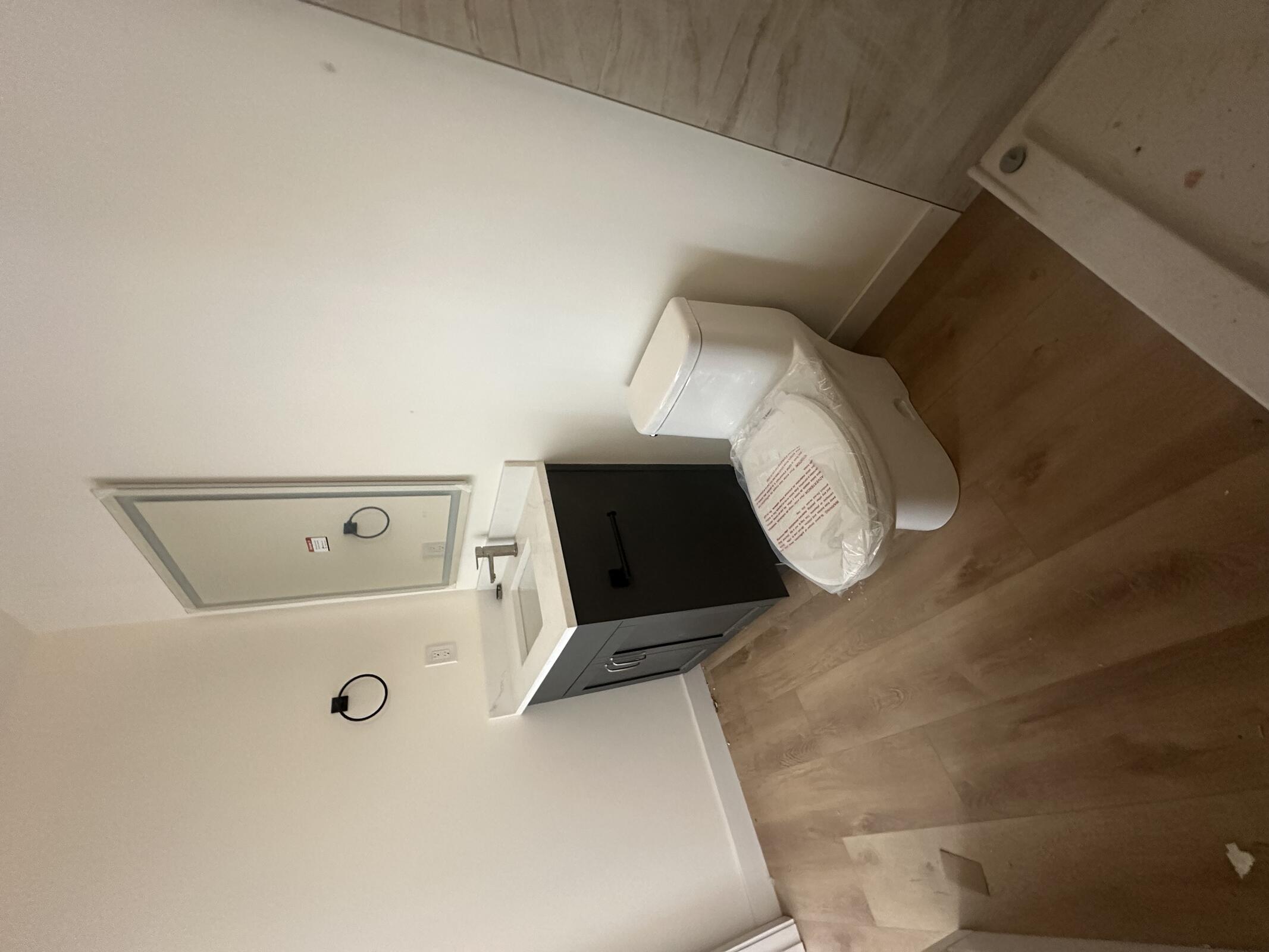

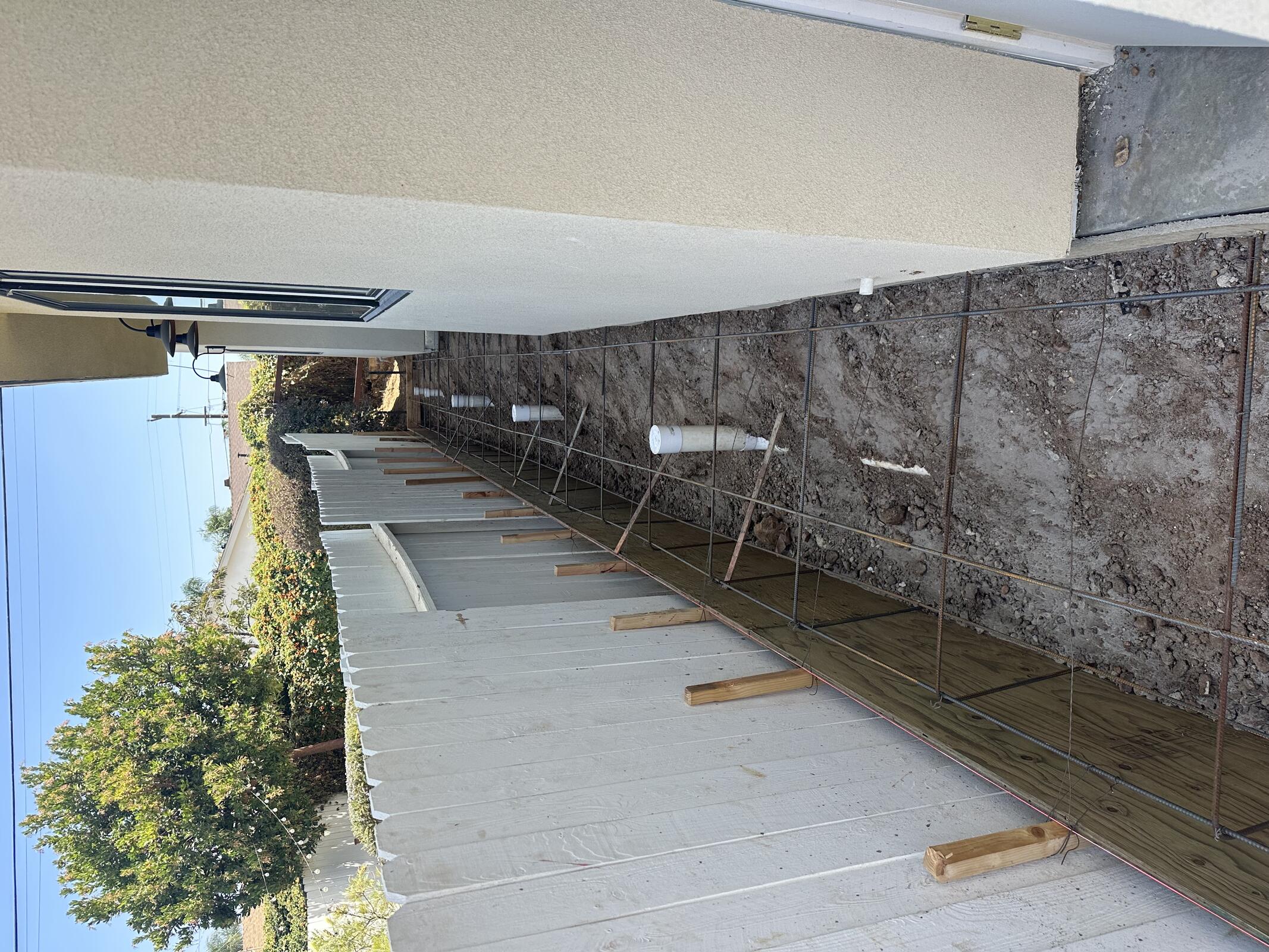

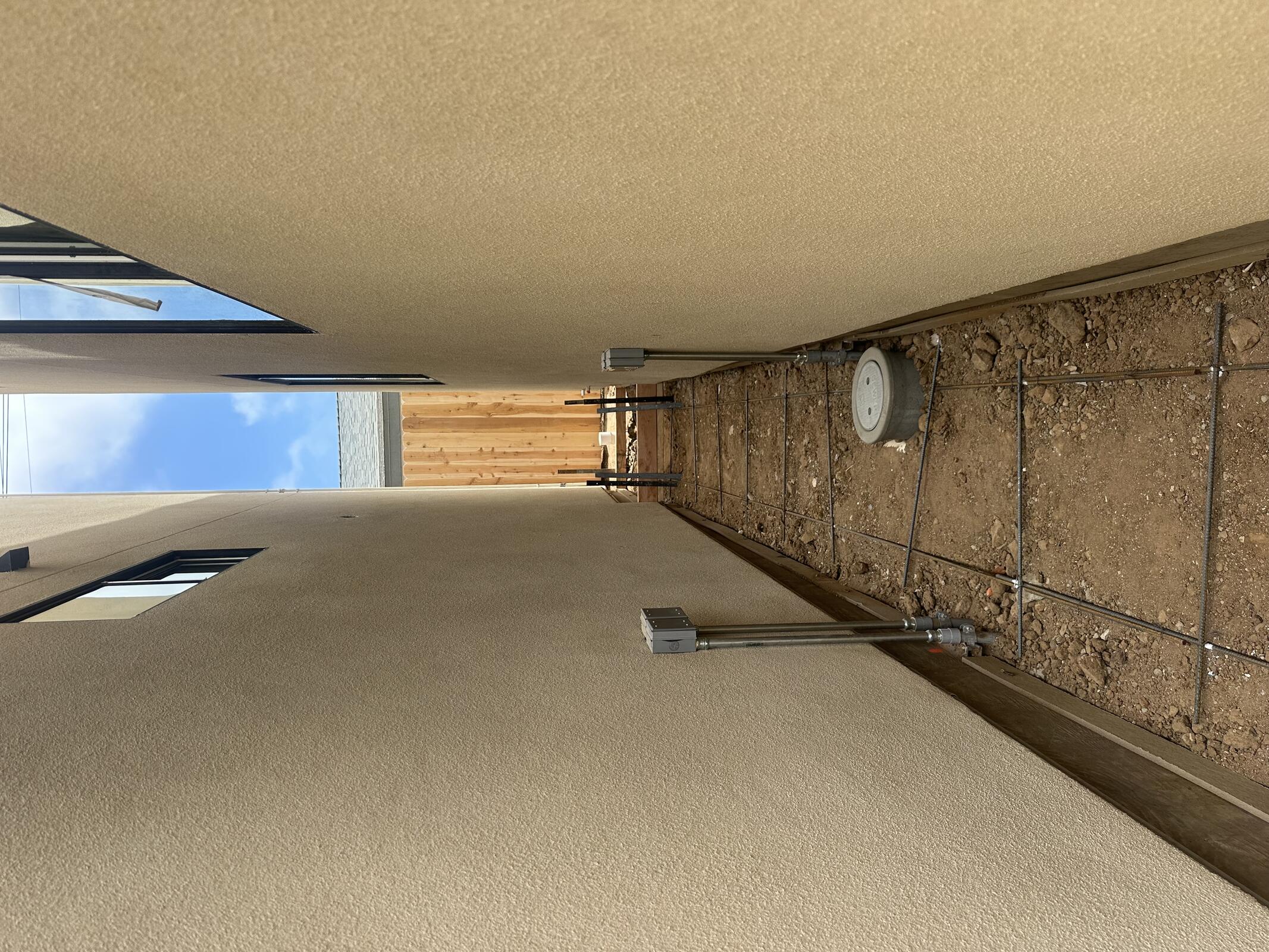

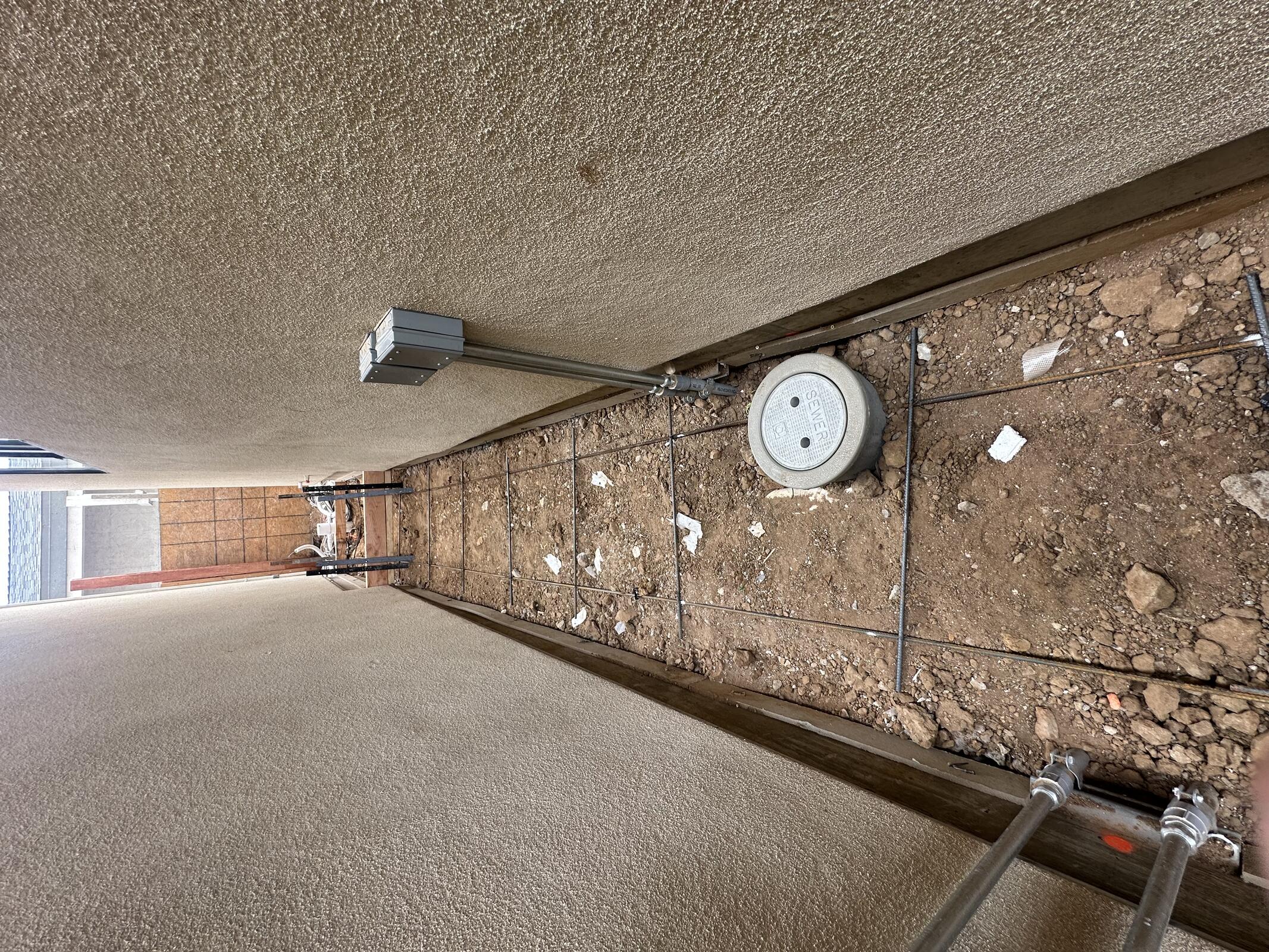

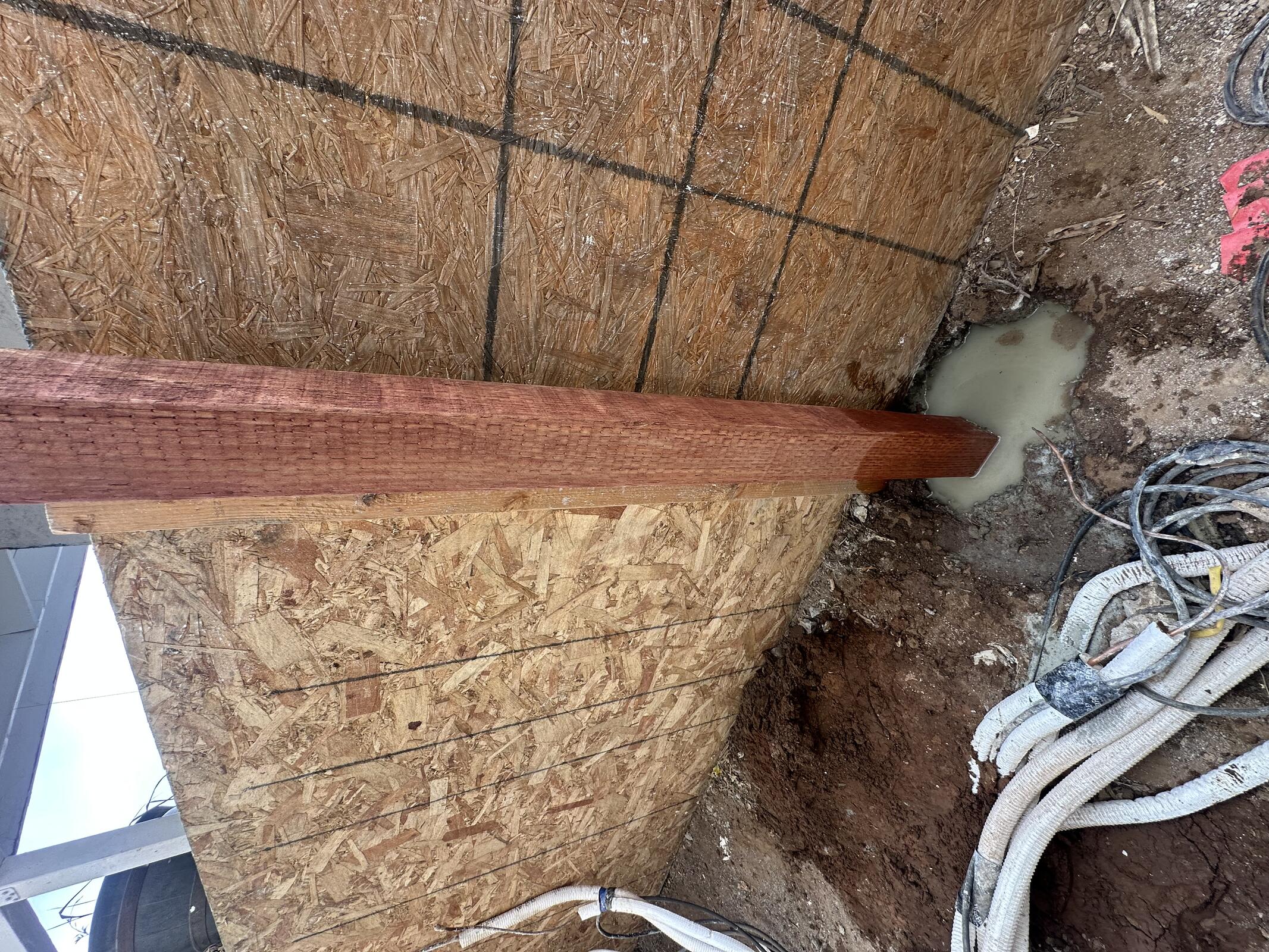

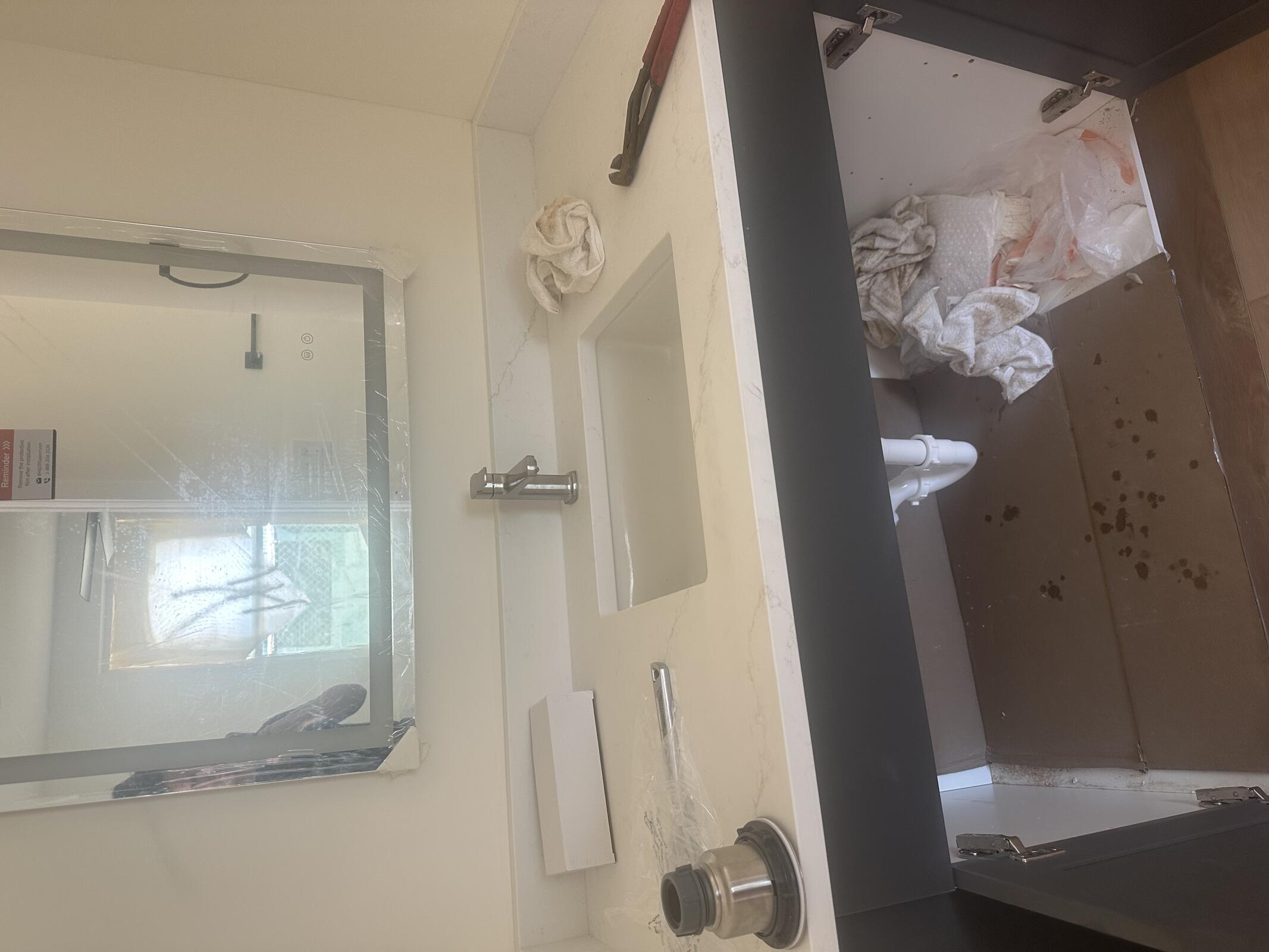

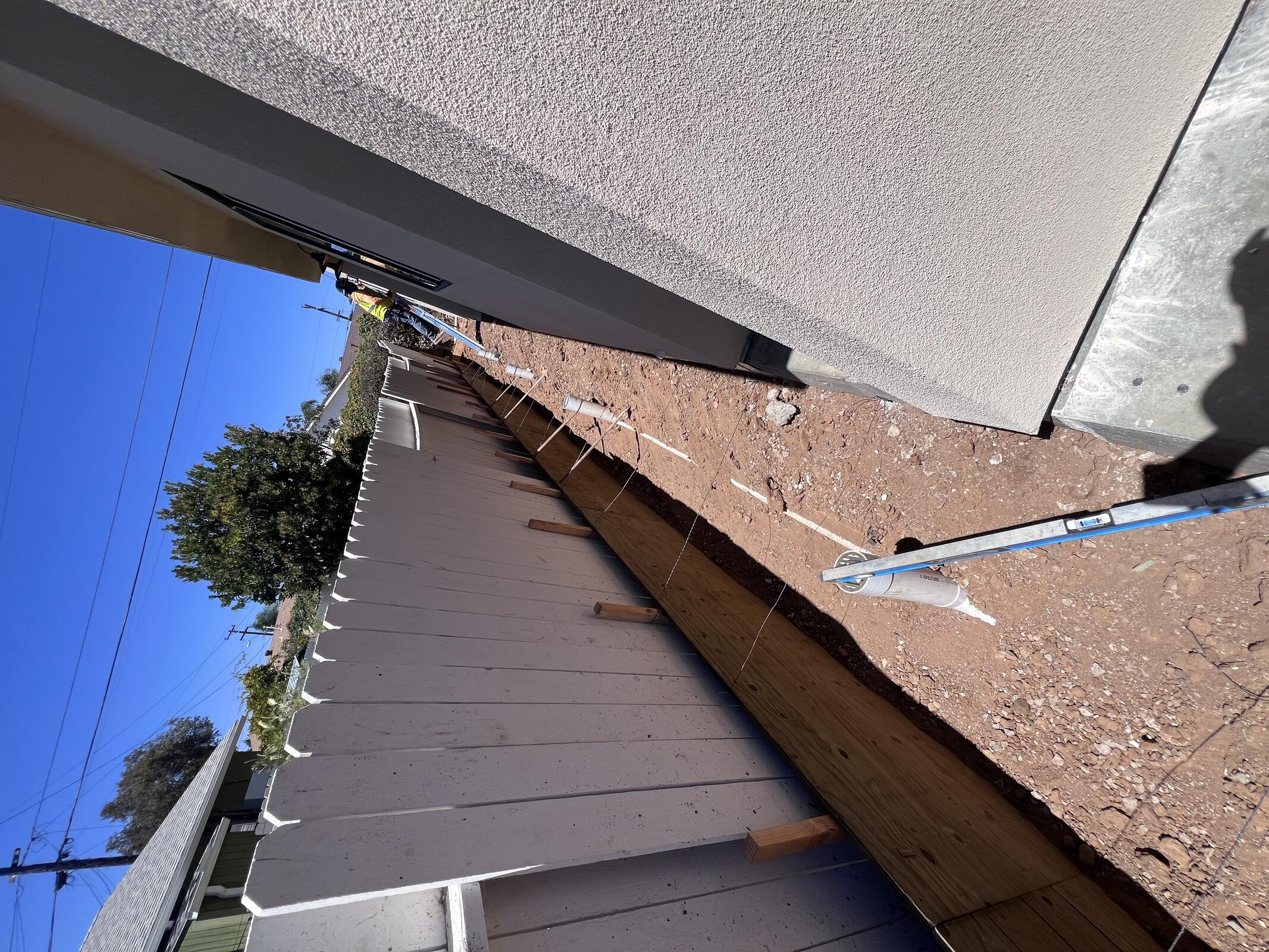

JBG installing rebar and preparing for concrete pour (pushed to Saturday). Laying out fence along back property line. Discussed how to get water heaters installed at Unit B without blocking off access for possible SDGE underground conduit. Wing wall to be eliminated and water heater enclosure to be be primed and painted to match color of siding. Pad for water heaters to be poured on Saturday, so plumbing can be finished.

ZSP continuing to trim out units.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
JBG4832
ZSP188

Inspection: N/A

Delay: Pending city comments, SDGE response, response from Gino to plea for accommodation.

Thursday, July 09, 2026

Partially cloudy, 72°F

ZSP roughing in and preparing for site concrete pour.

JBG installing back fence and finishing rebar/formwork.

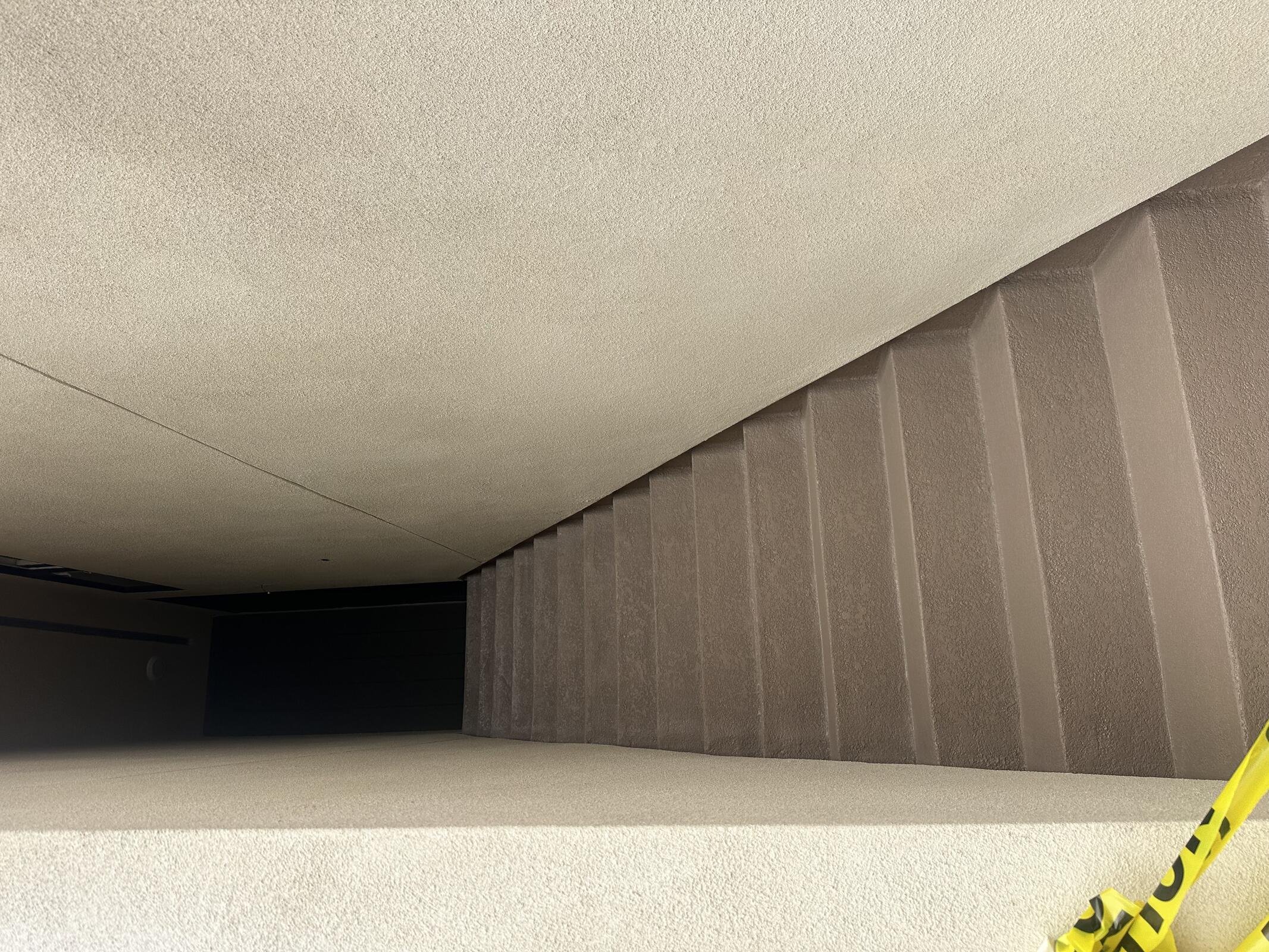

Rete's putting down first coat of final before color coat.

Marq plastering on site to look at existing stucco again. Demoing lower 18" of wall between existing duplex and Building B tomorrow. Creating plan to demo and patch as needed at existing duplex (after meter release).

ML cleaning up units.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
ZSP188
JBG3824
Rete's248

Inspection: N/A

Delay: Pending response from Gino.

Friday, July 10, 2026

Overcast, 68°F

Marq on site chipping stucco at existing duplex.

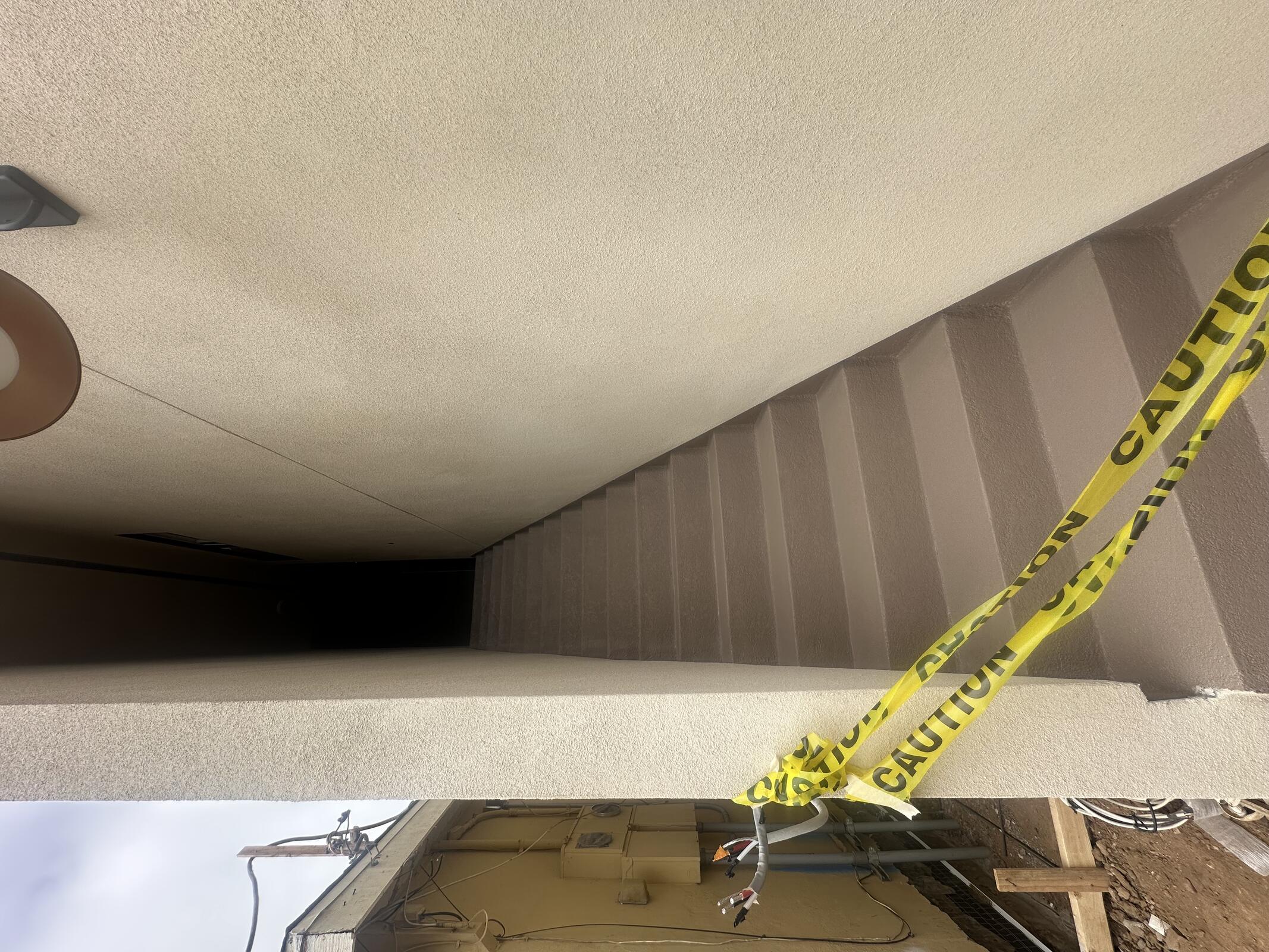

Rete's putting final coat on stairs at B and C.

Brent (JBG) on site to confirm everything is ready for tomorrow’s pour.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
Marq144
Rete’s224

Inspection: N/A

Delay: Sam is doing calcs. Pending response from SDGE re 420 A calc.
