All updates
Week 28 of 34

Week of June 29 — July 02, 2026

4 days on site. 69 photos. Countertops, DFH, Drywall, Electric, Inspection, Plumbing, Site Concrete and Drainage, Stucco.

June 29, 2026July 2, 20264 days69 photos
CountertopsDFHDrywallElectricInspectionPlumbingSite Concrete and DrainageStucco

Monday, June 29, 2026

Partially cloudy, 70°F

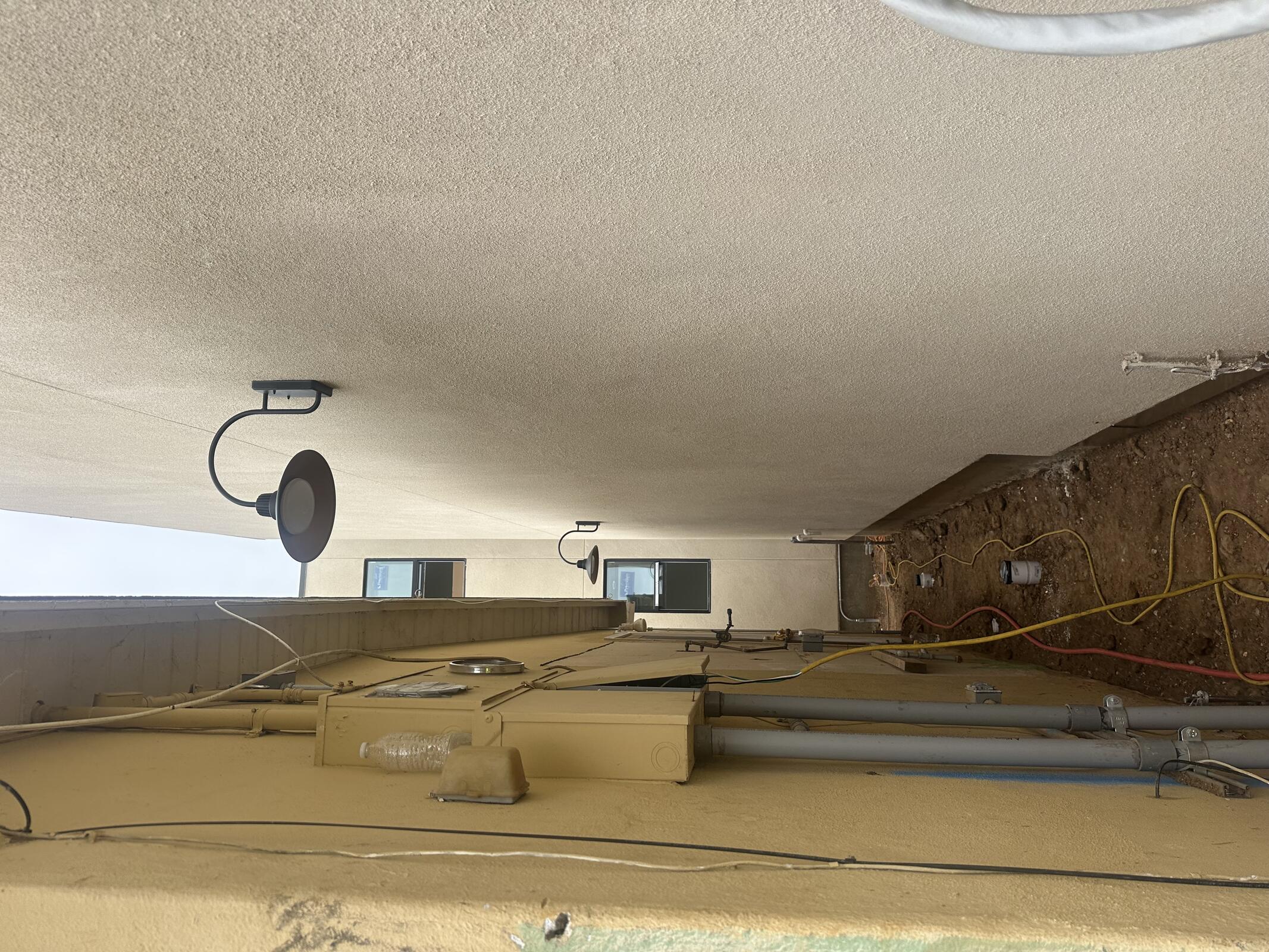

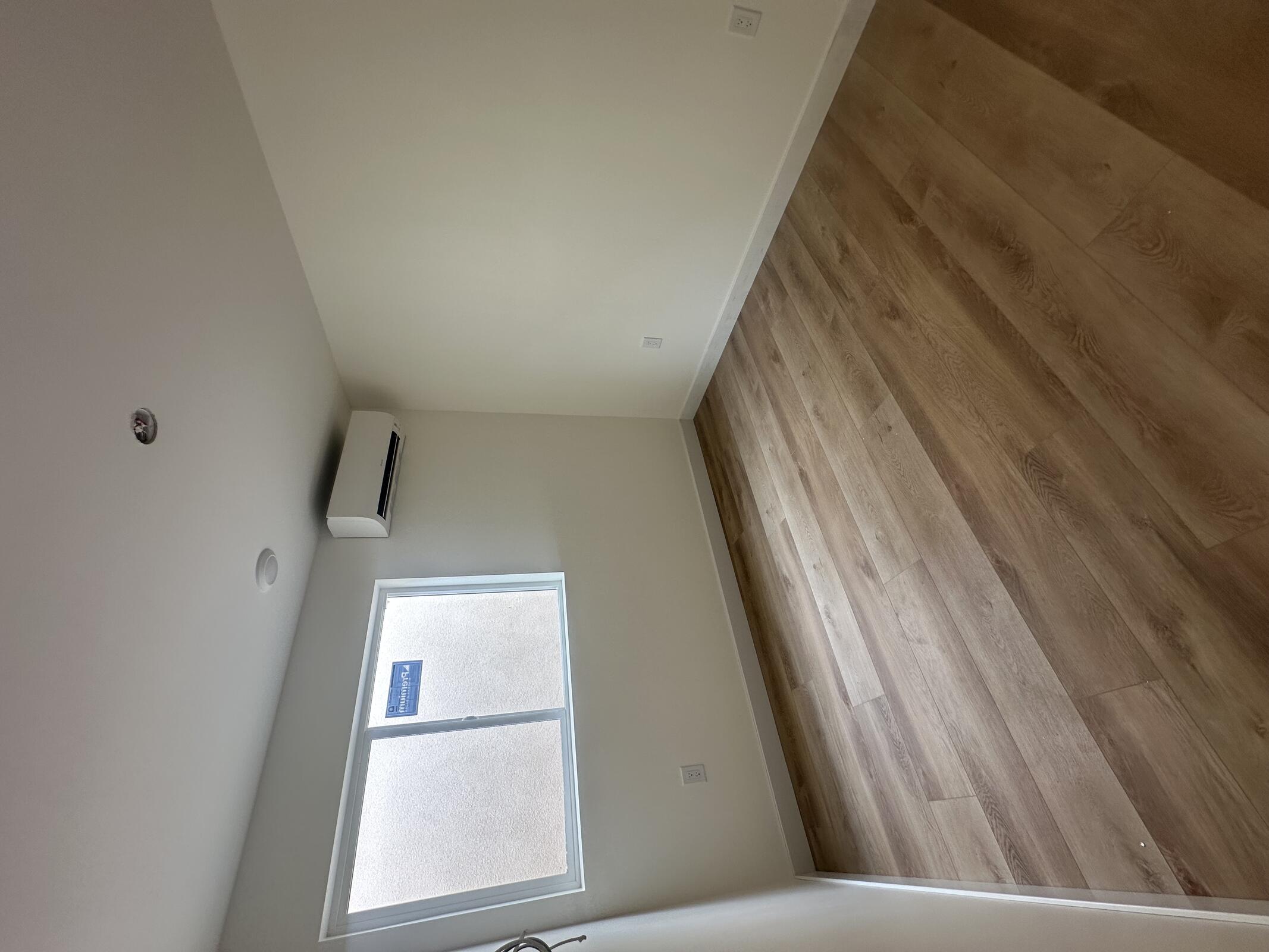

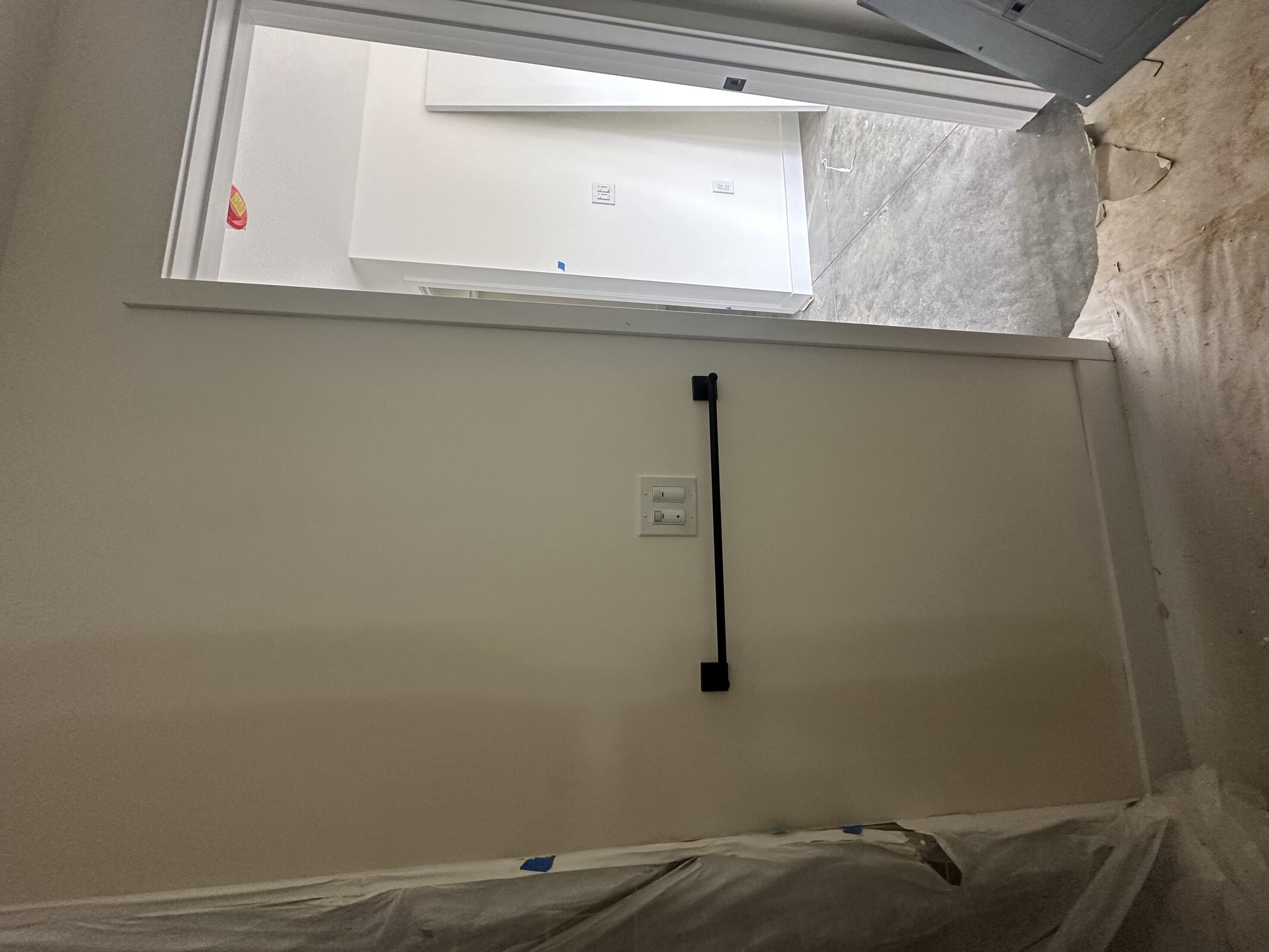

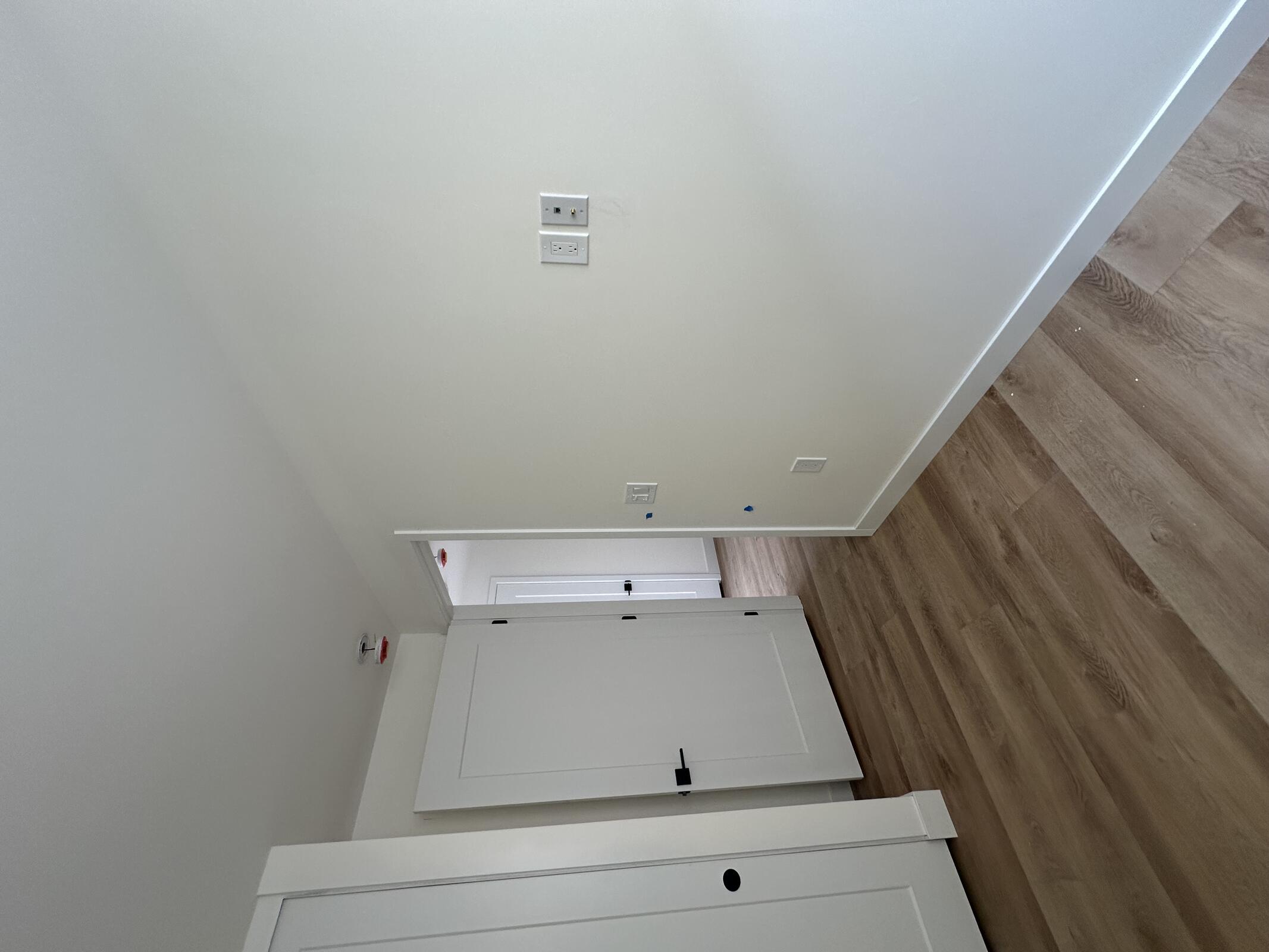

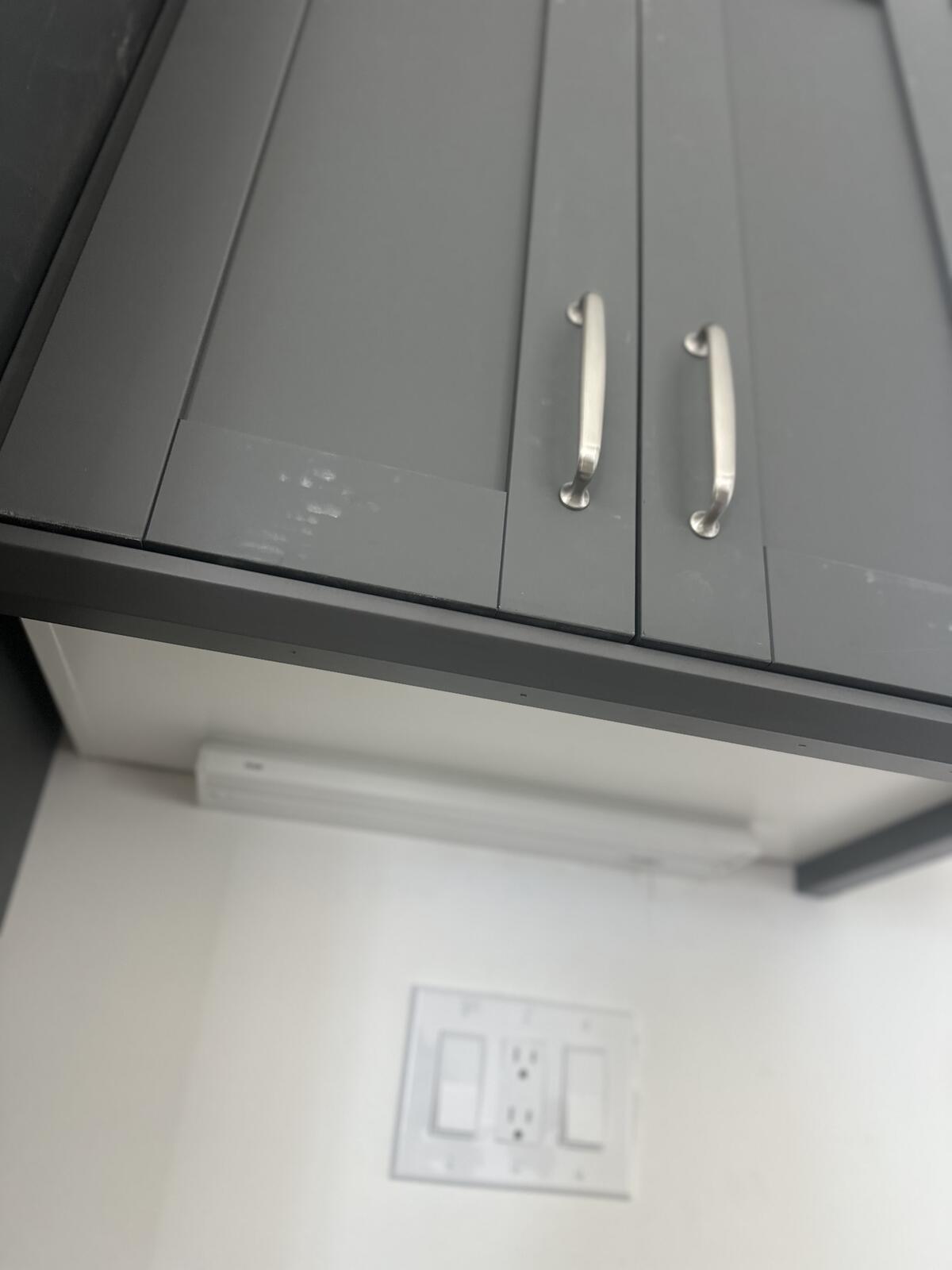

AC Electric trimming garage unit.

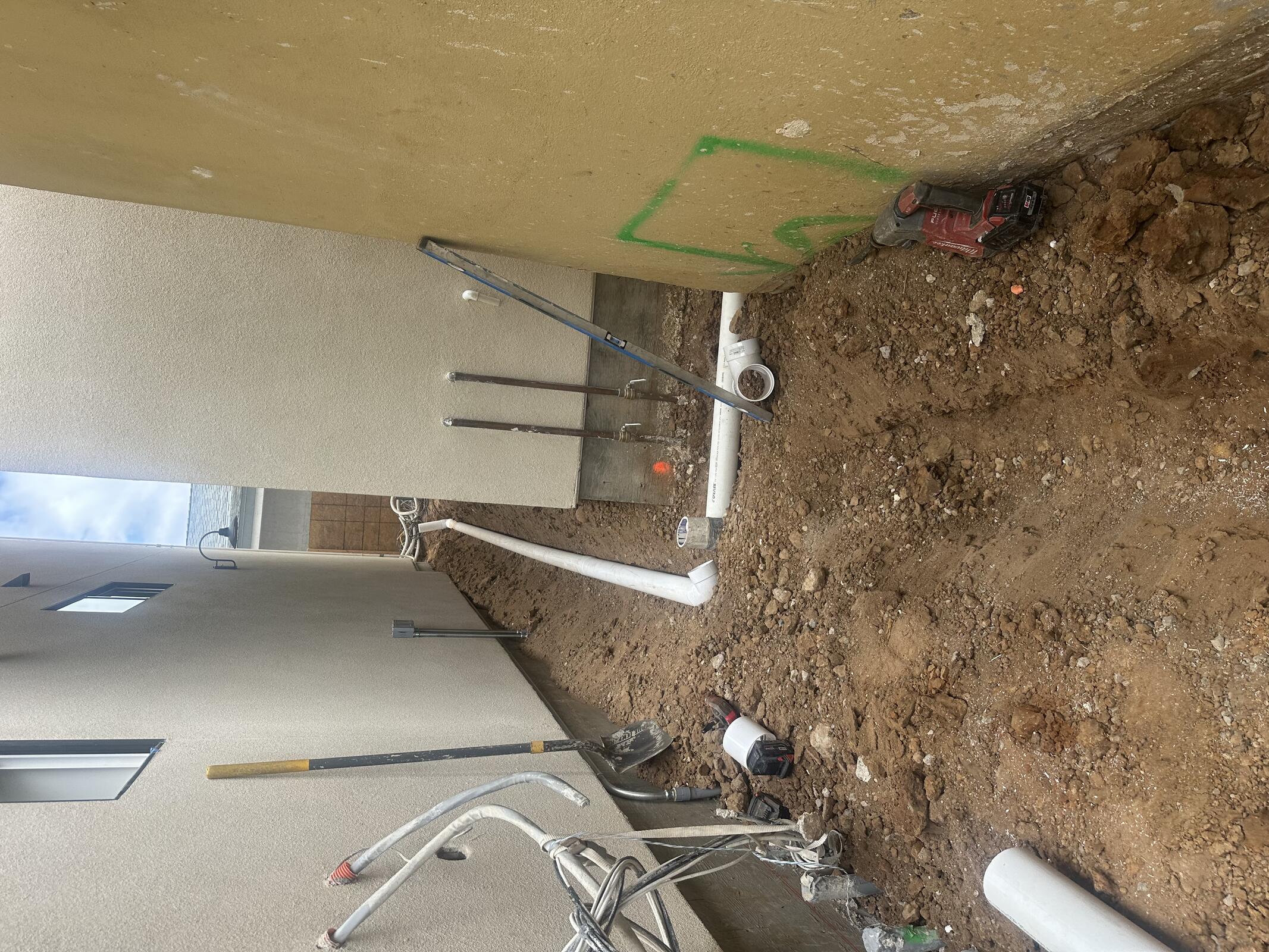

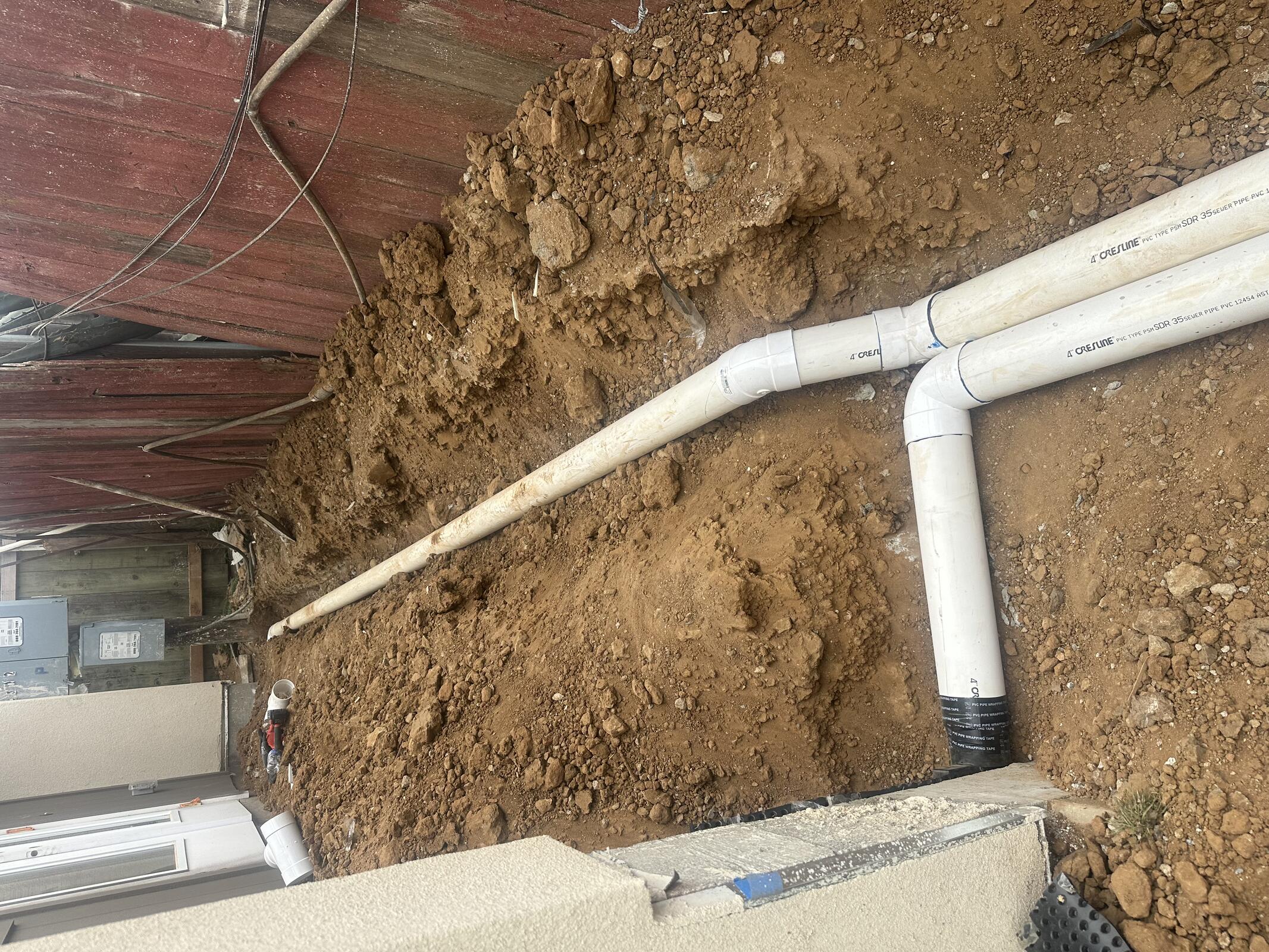

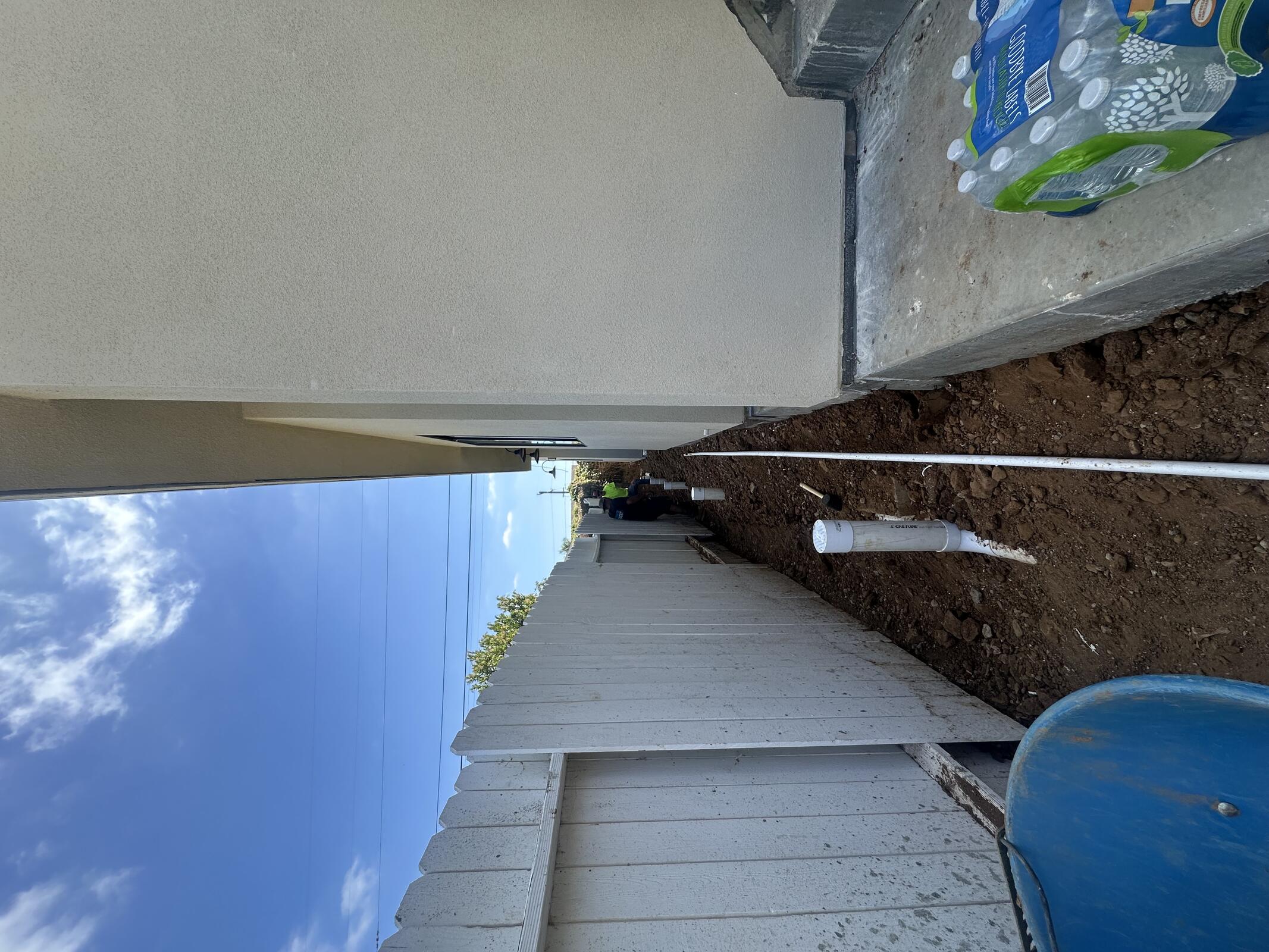

JBG installing drains.

Taylor Trim installing baseboard at C2 and B2.

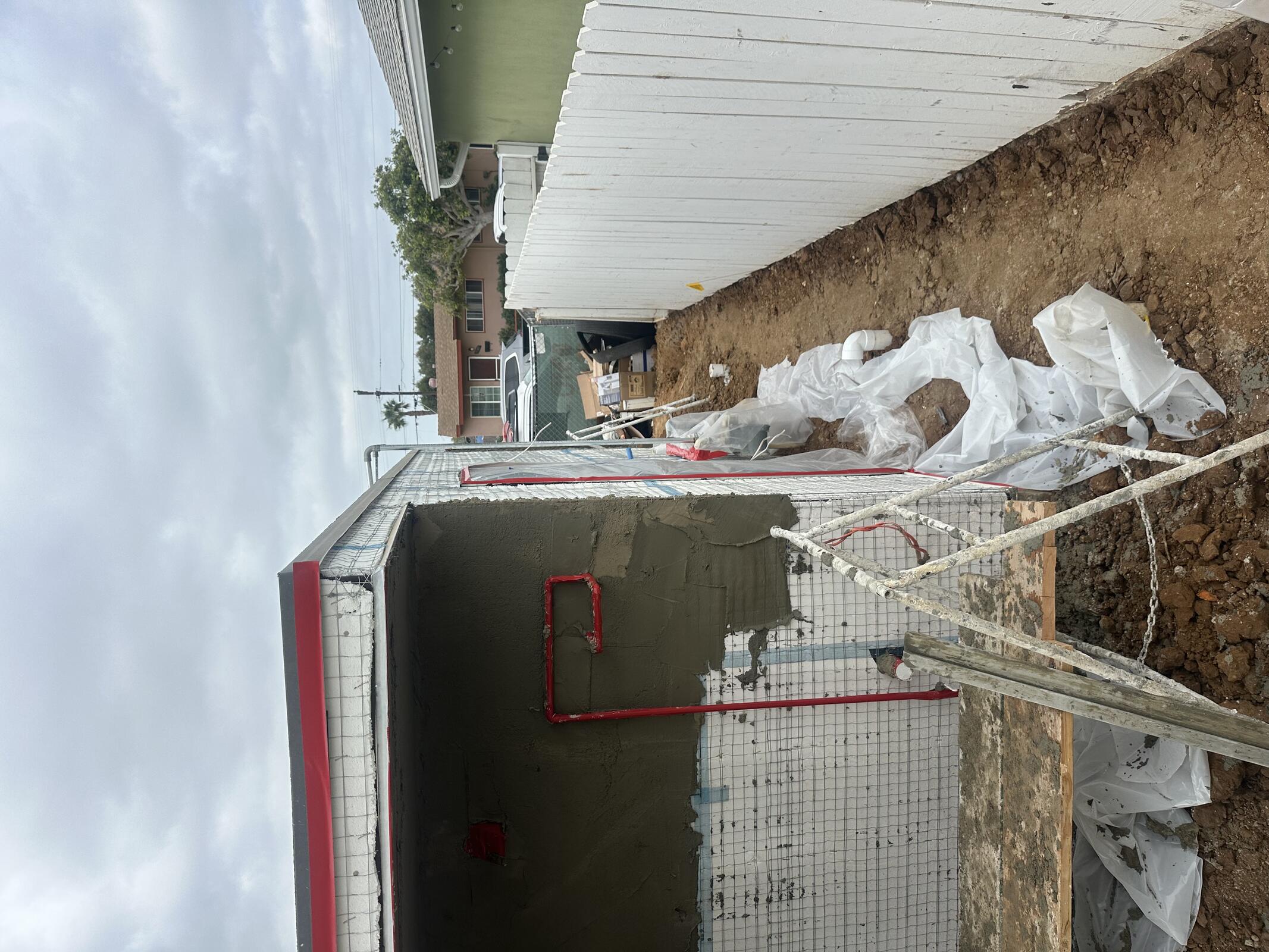

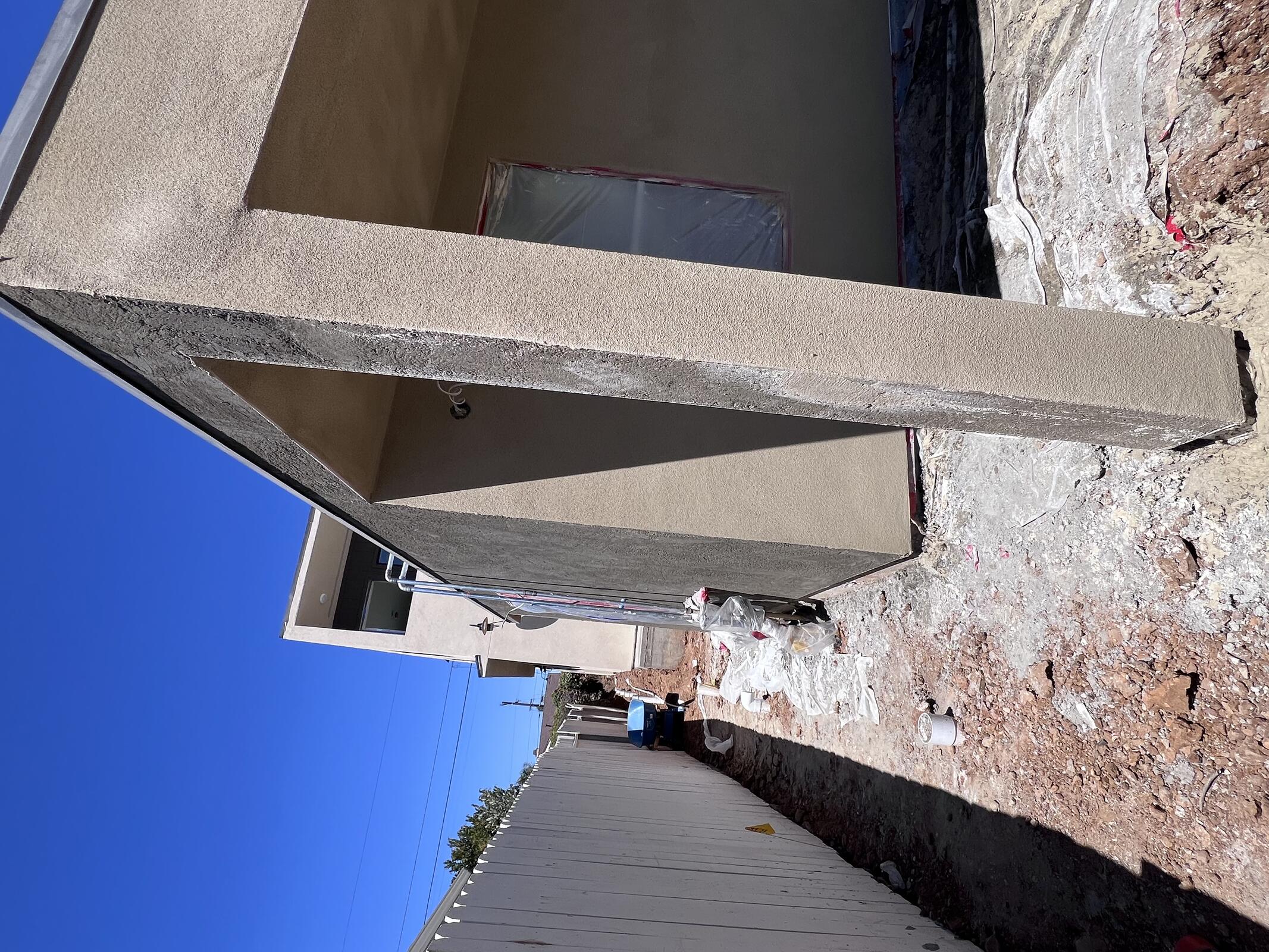

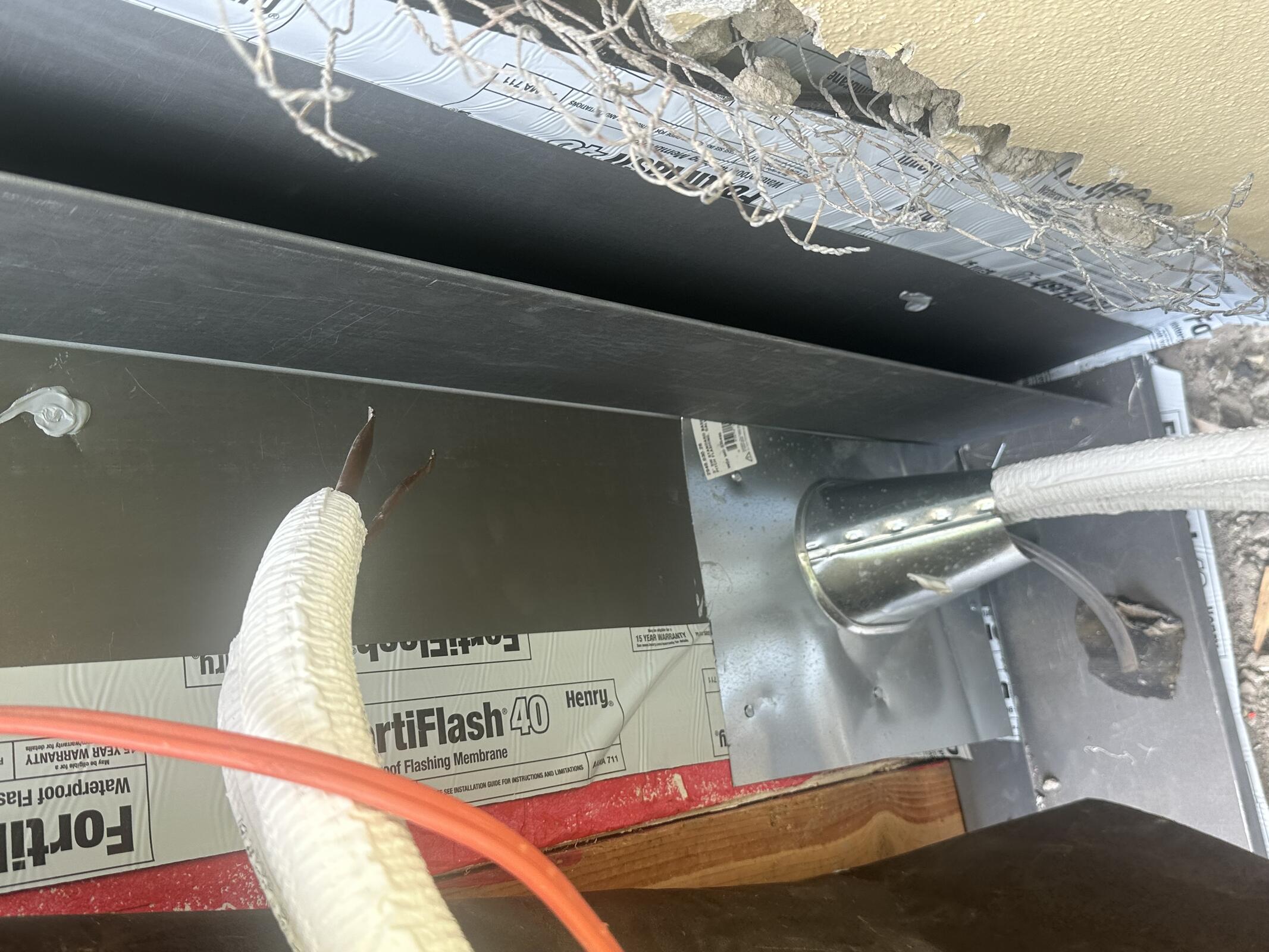

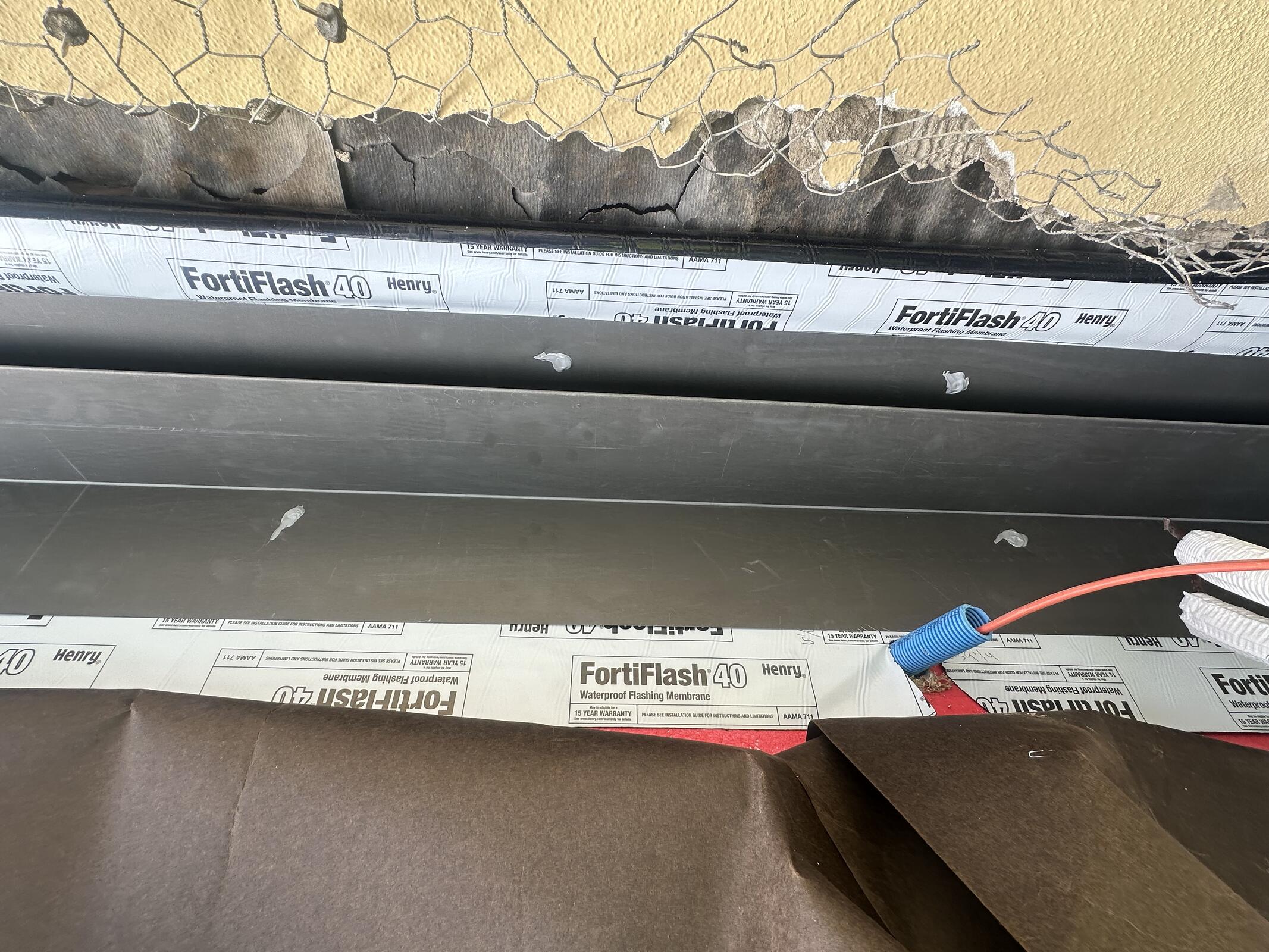

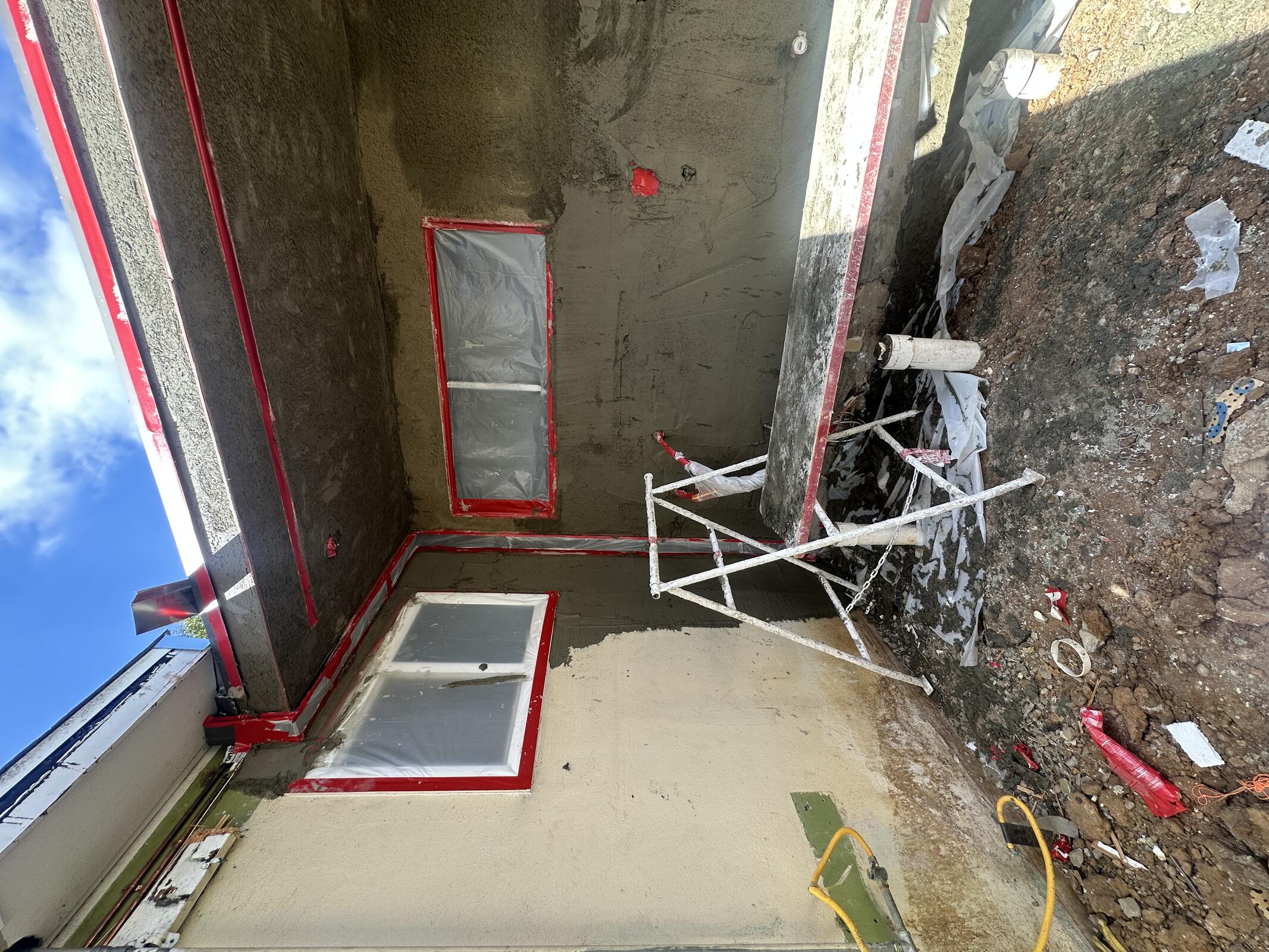

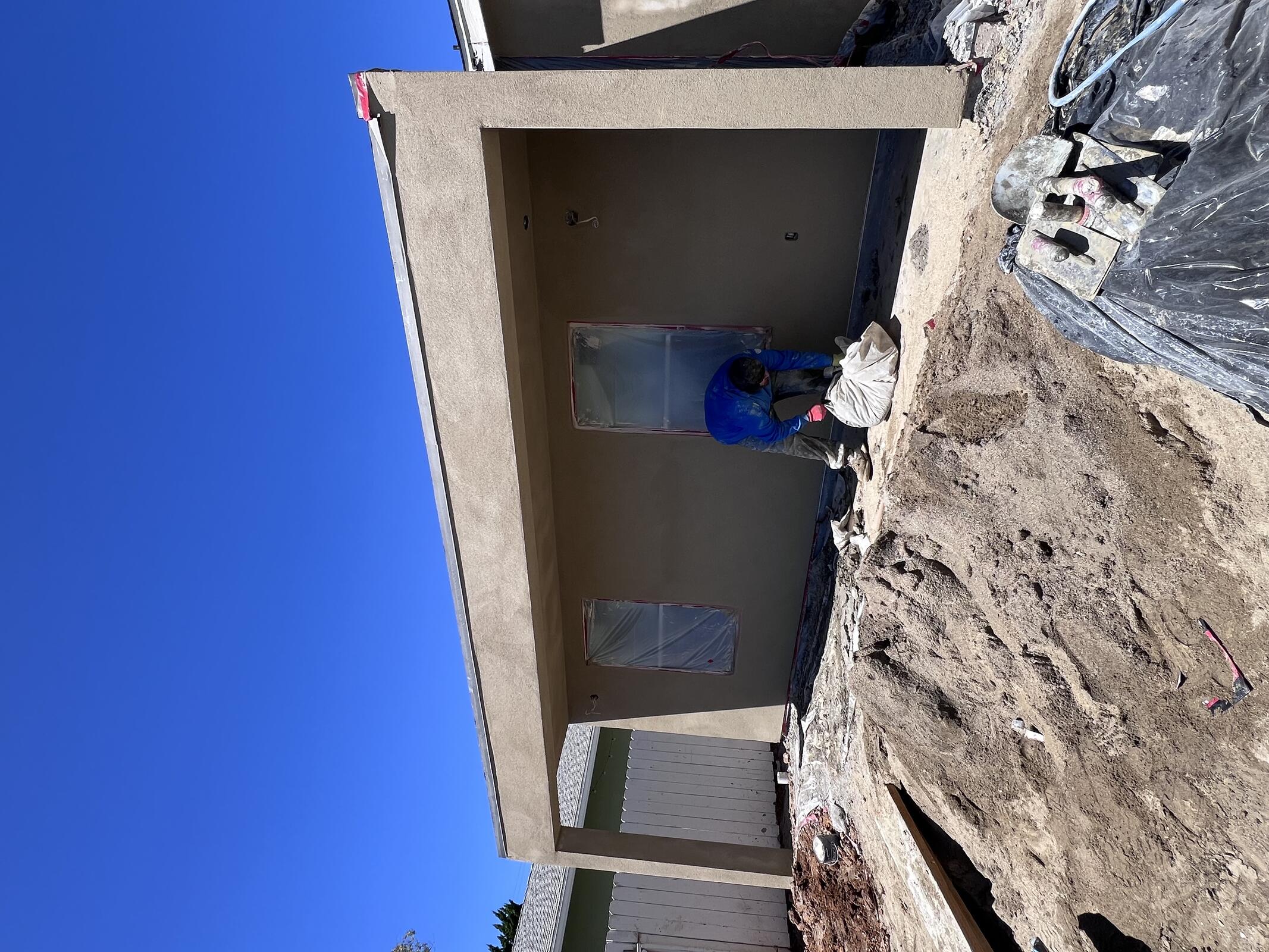

Marq Plastering installing seismic joint at front site between garage and duplex.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
AC Electric1.5812
JBG4832
Taylor Trim188
Marq144

Inspection: N/A

Tuesday, June 30, 2026

Partially cloudy, 62°F

AC Electric continuing trim out.

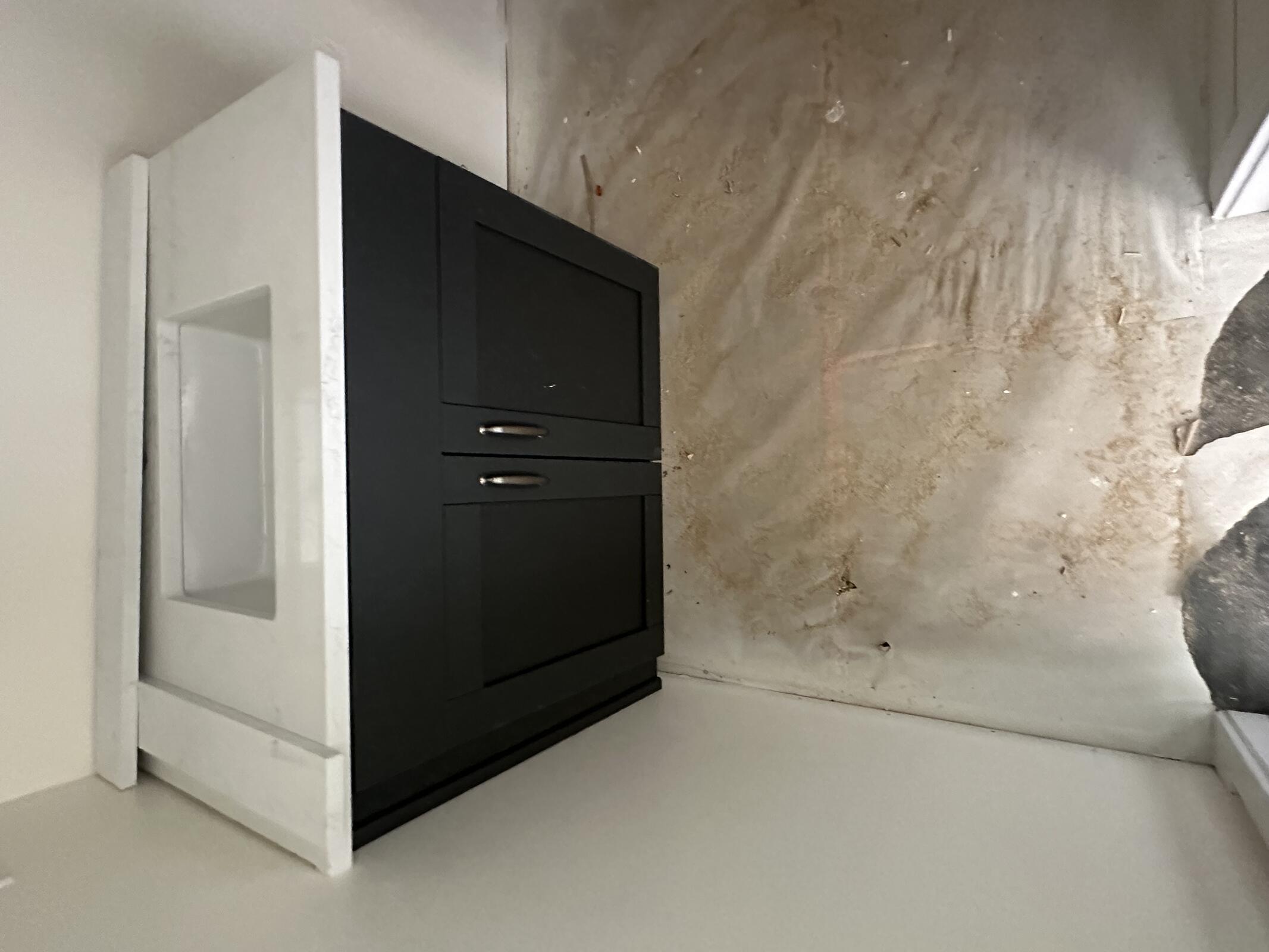

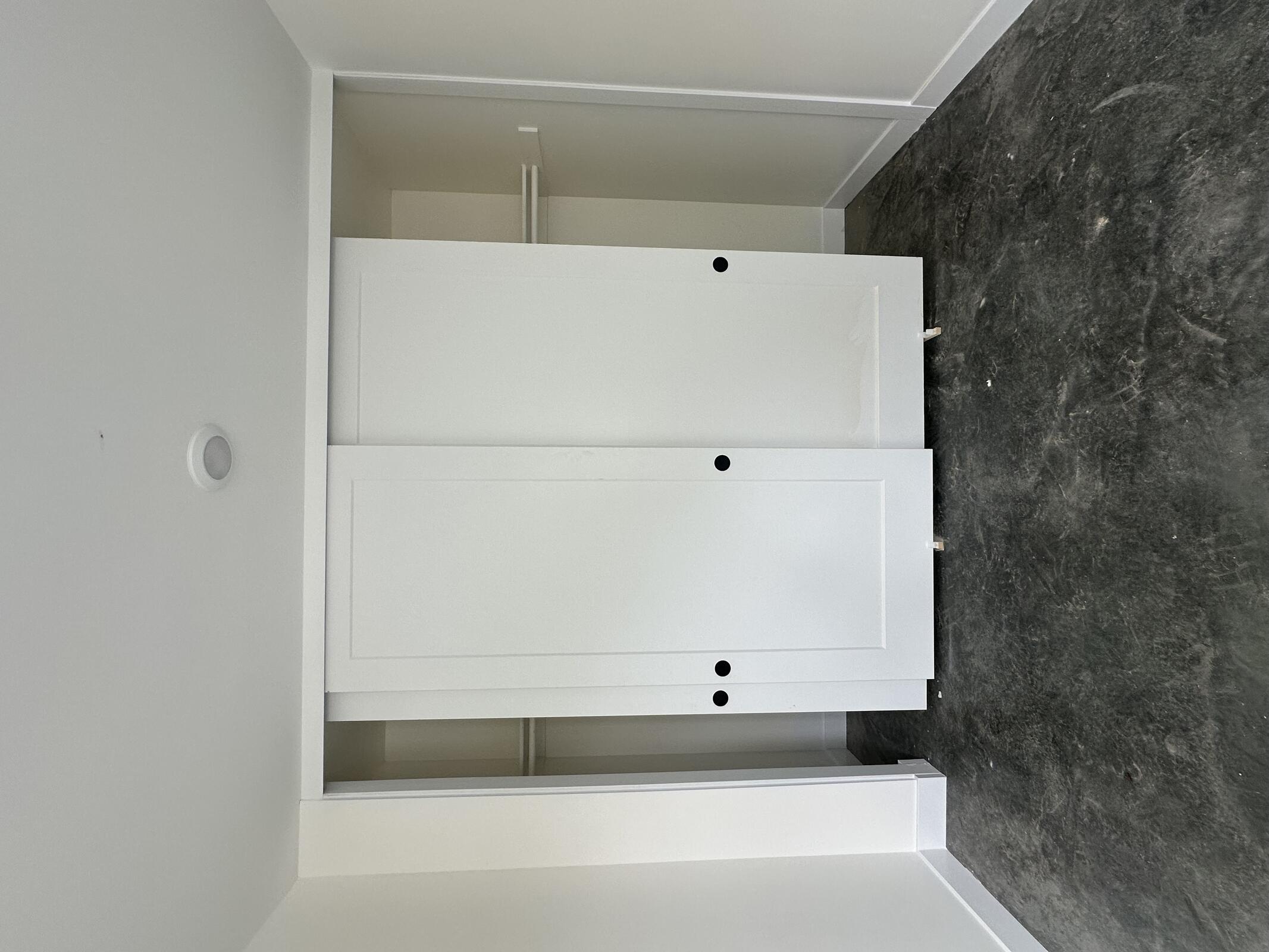

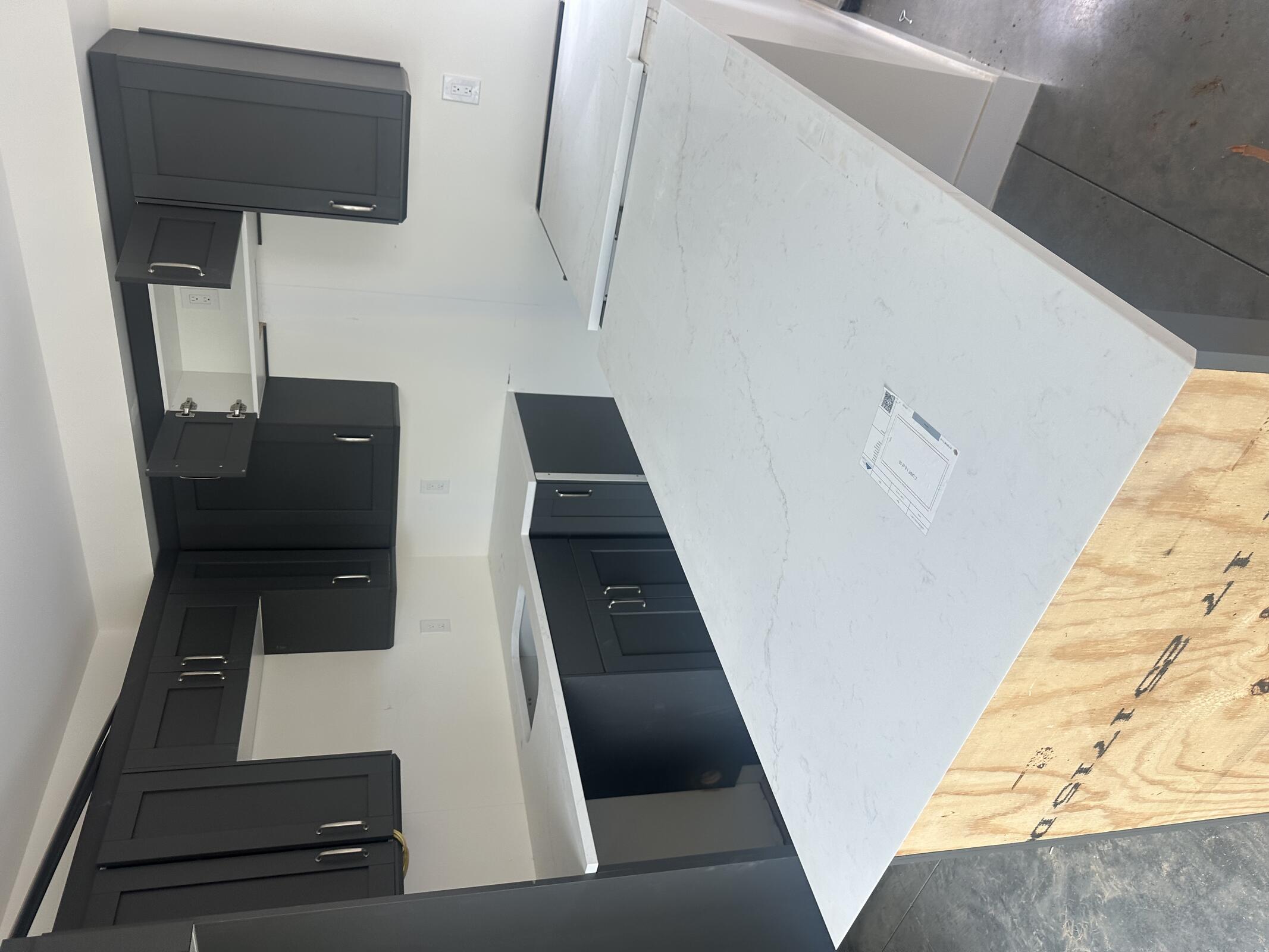

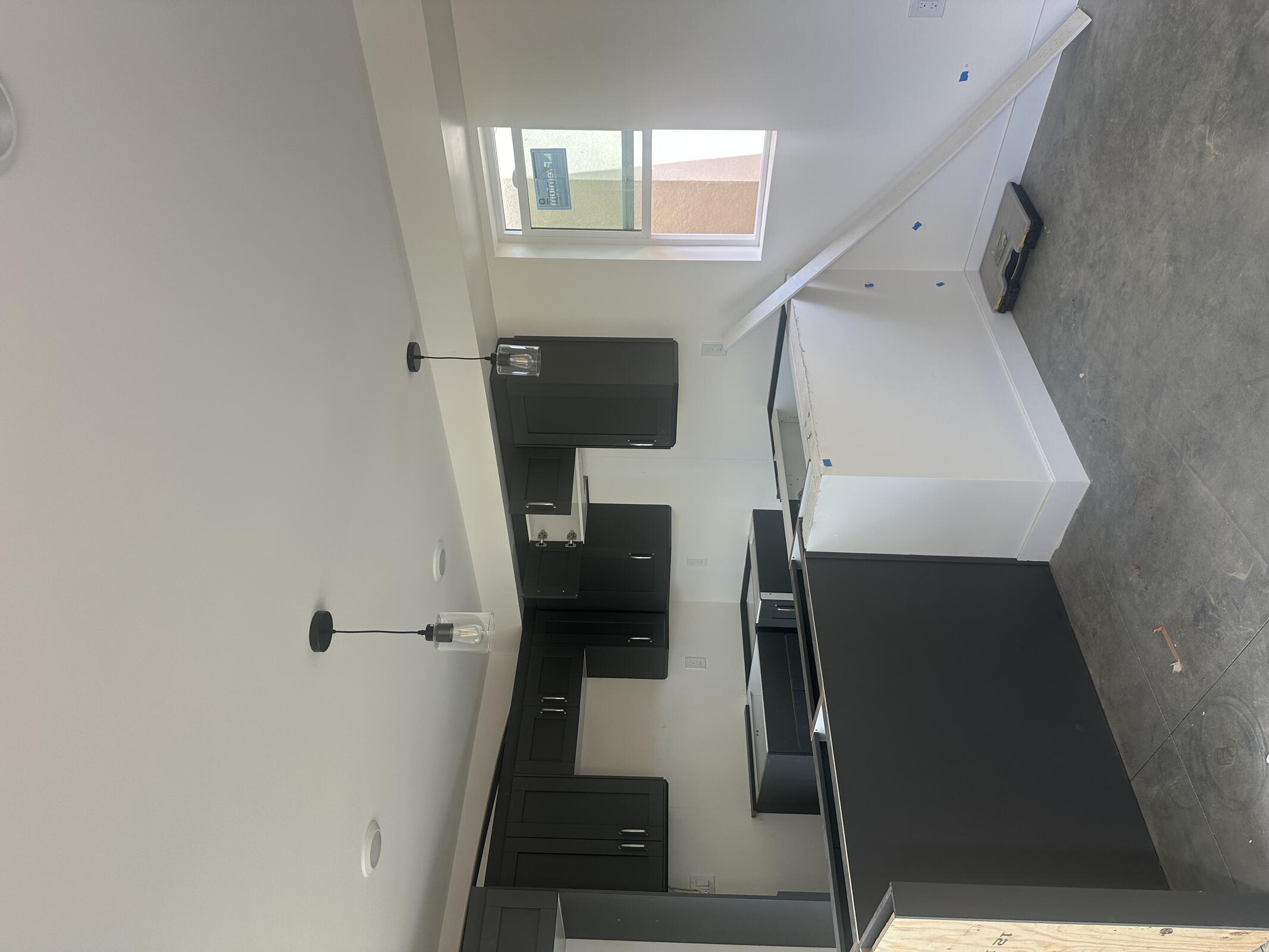

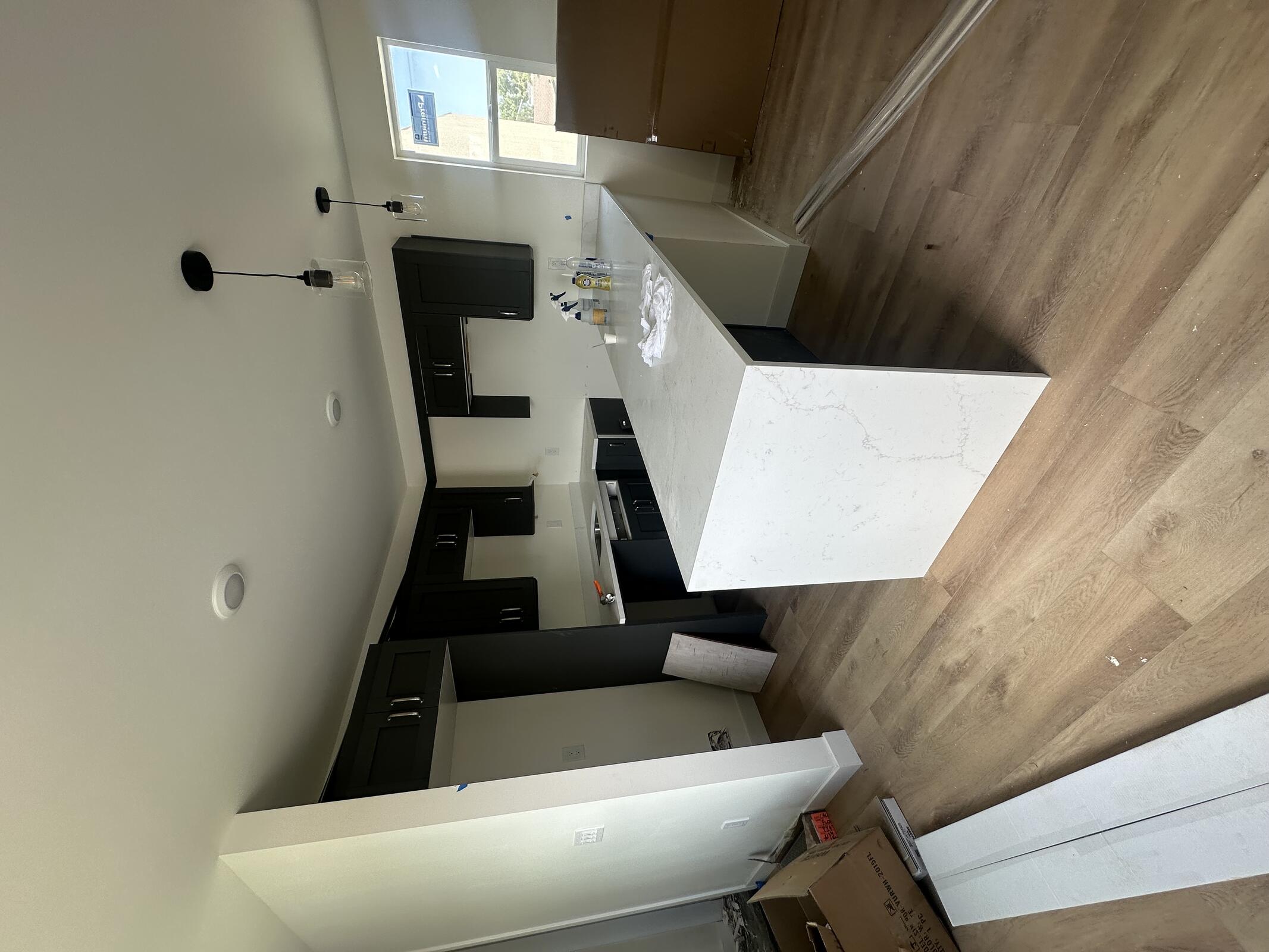

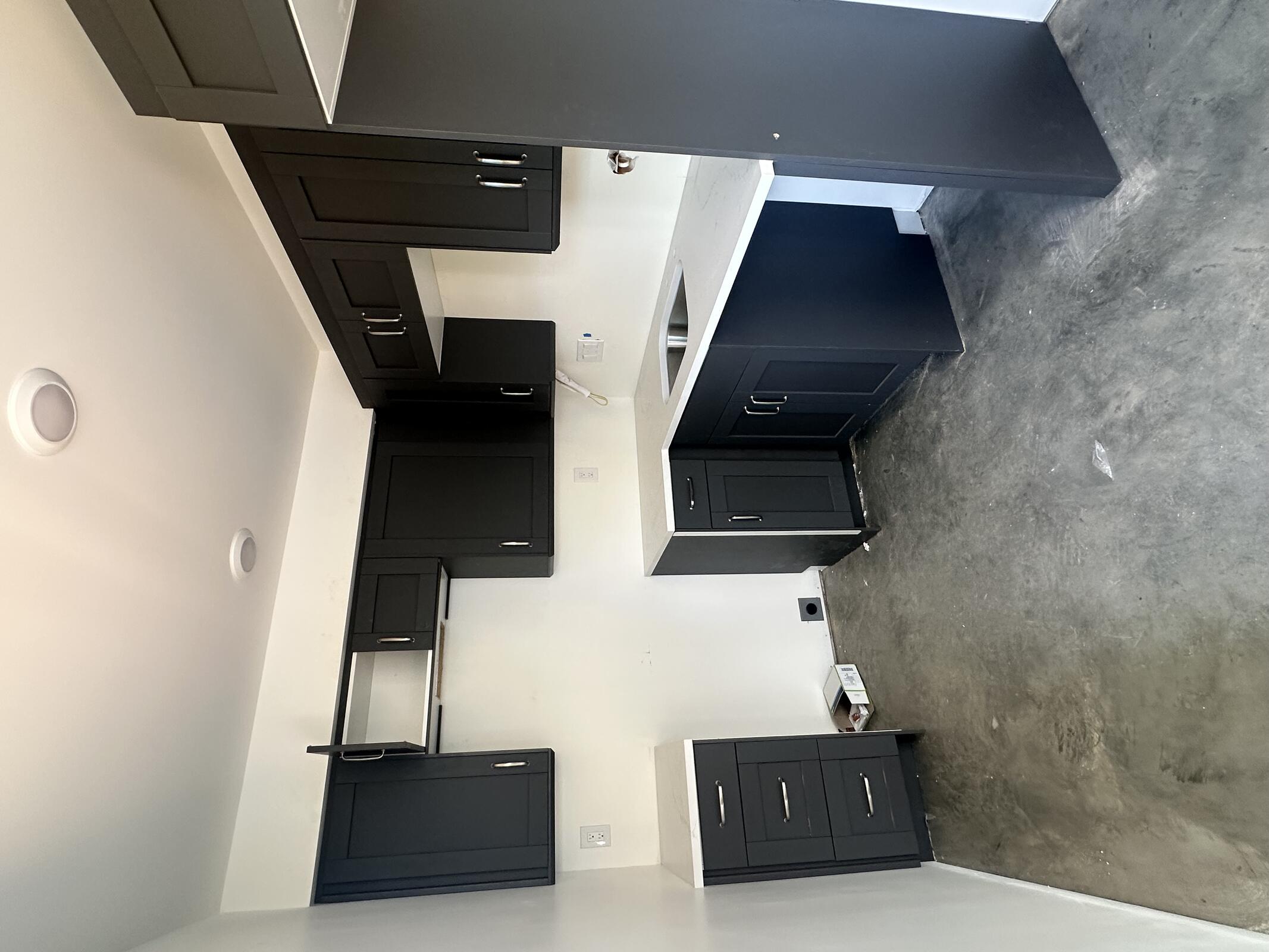

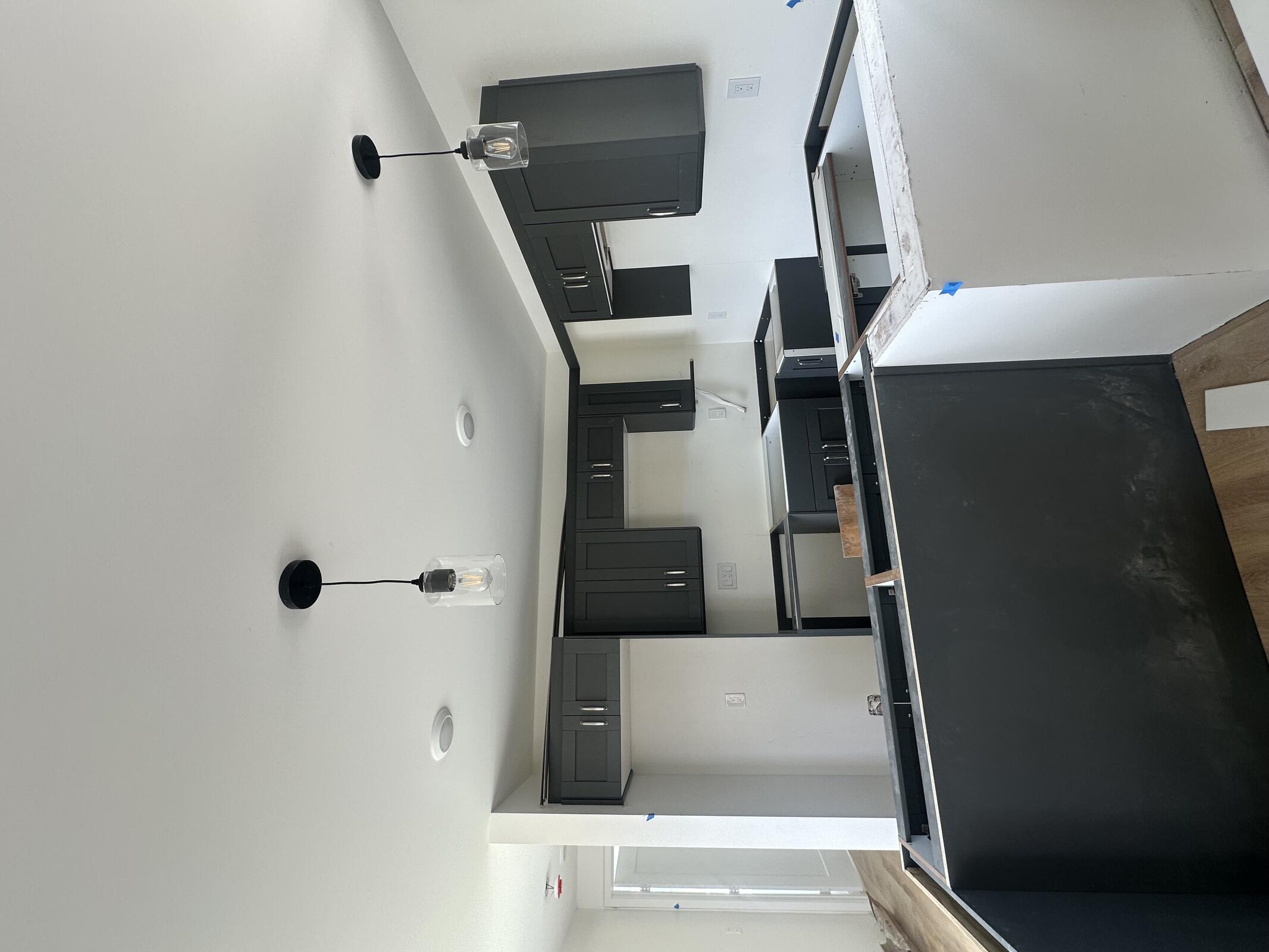

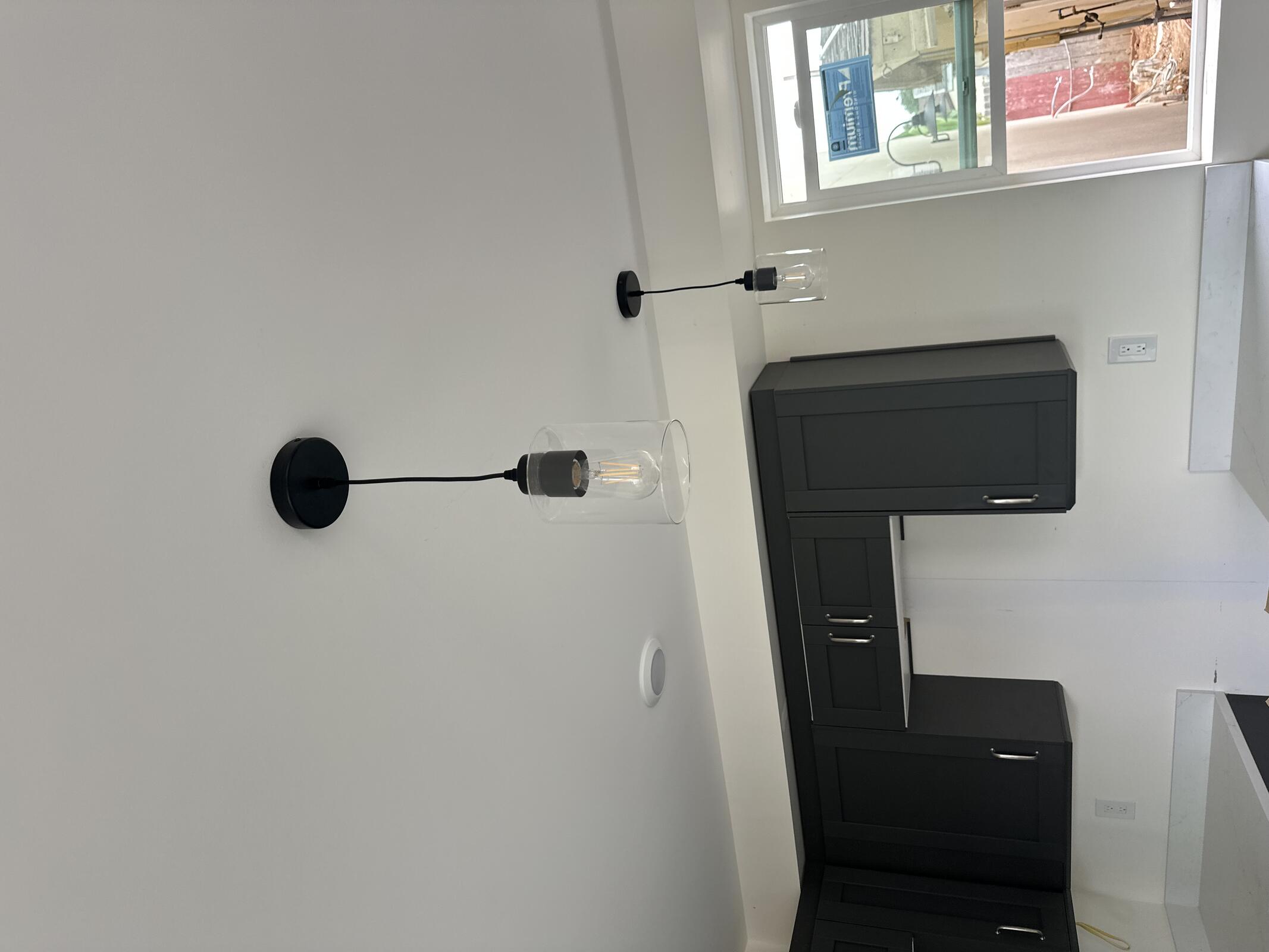

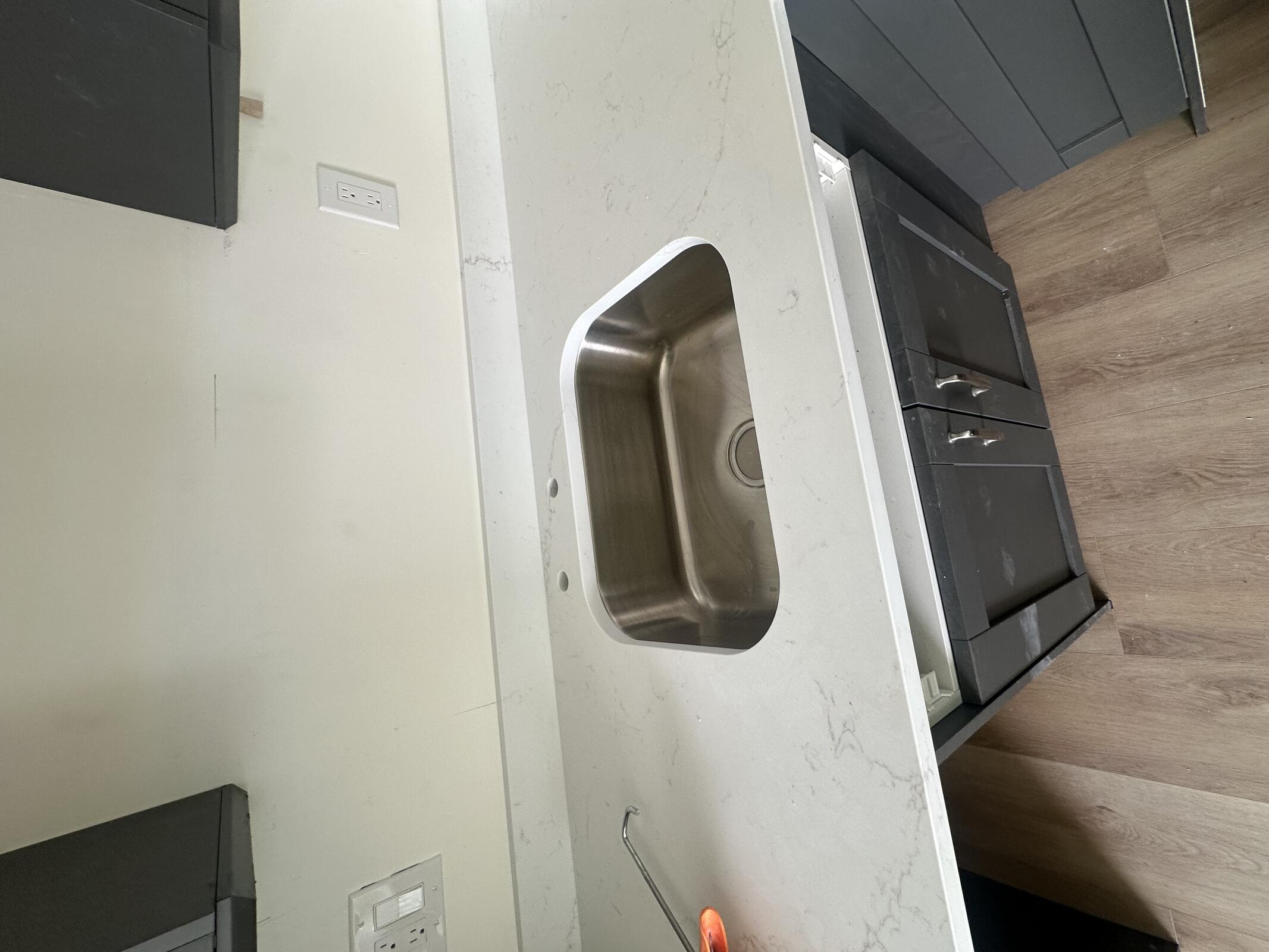

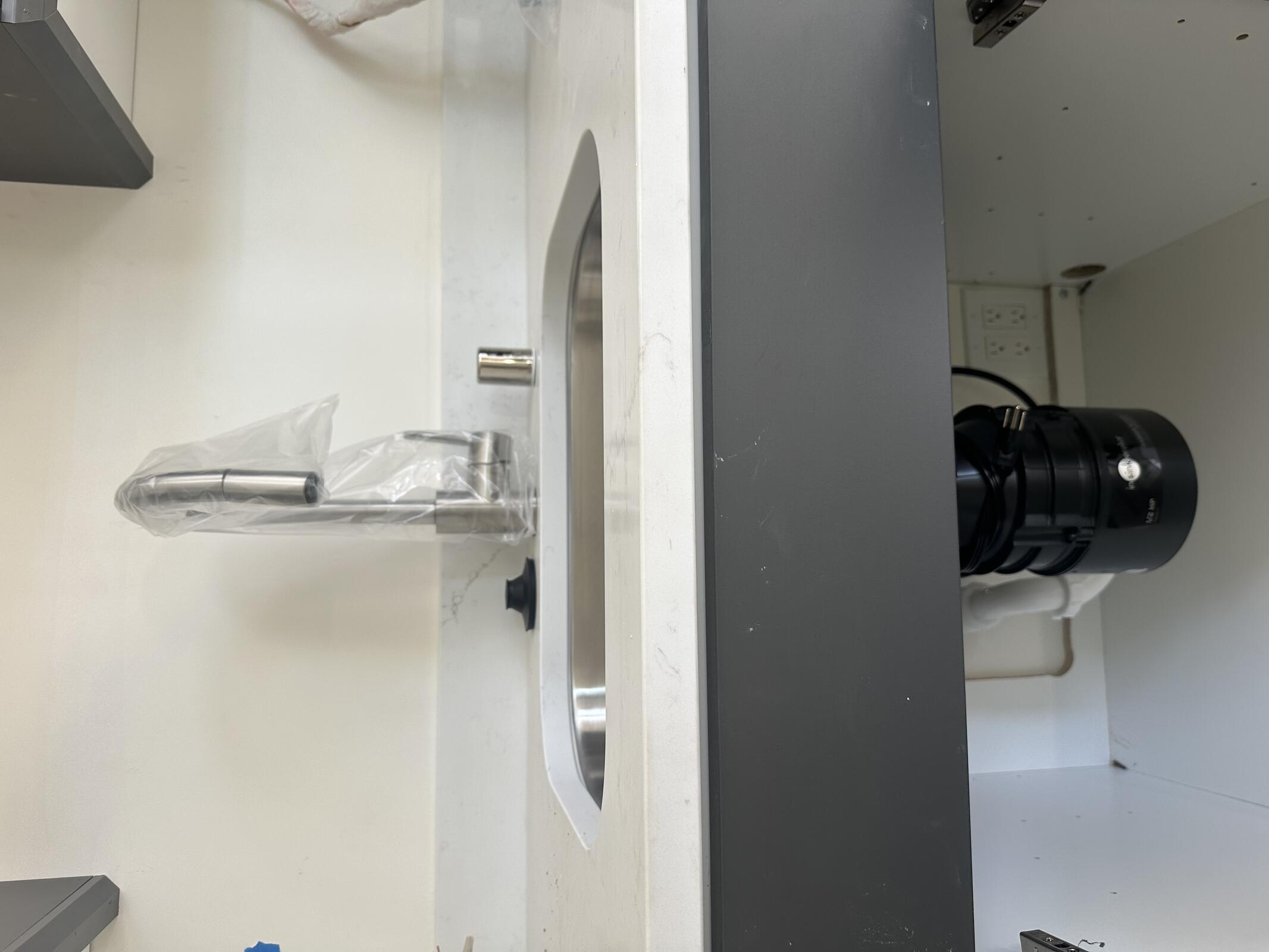

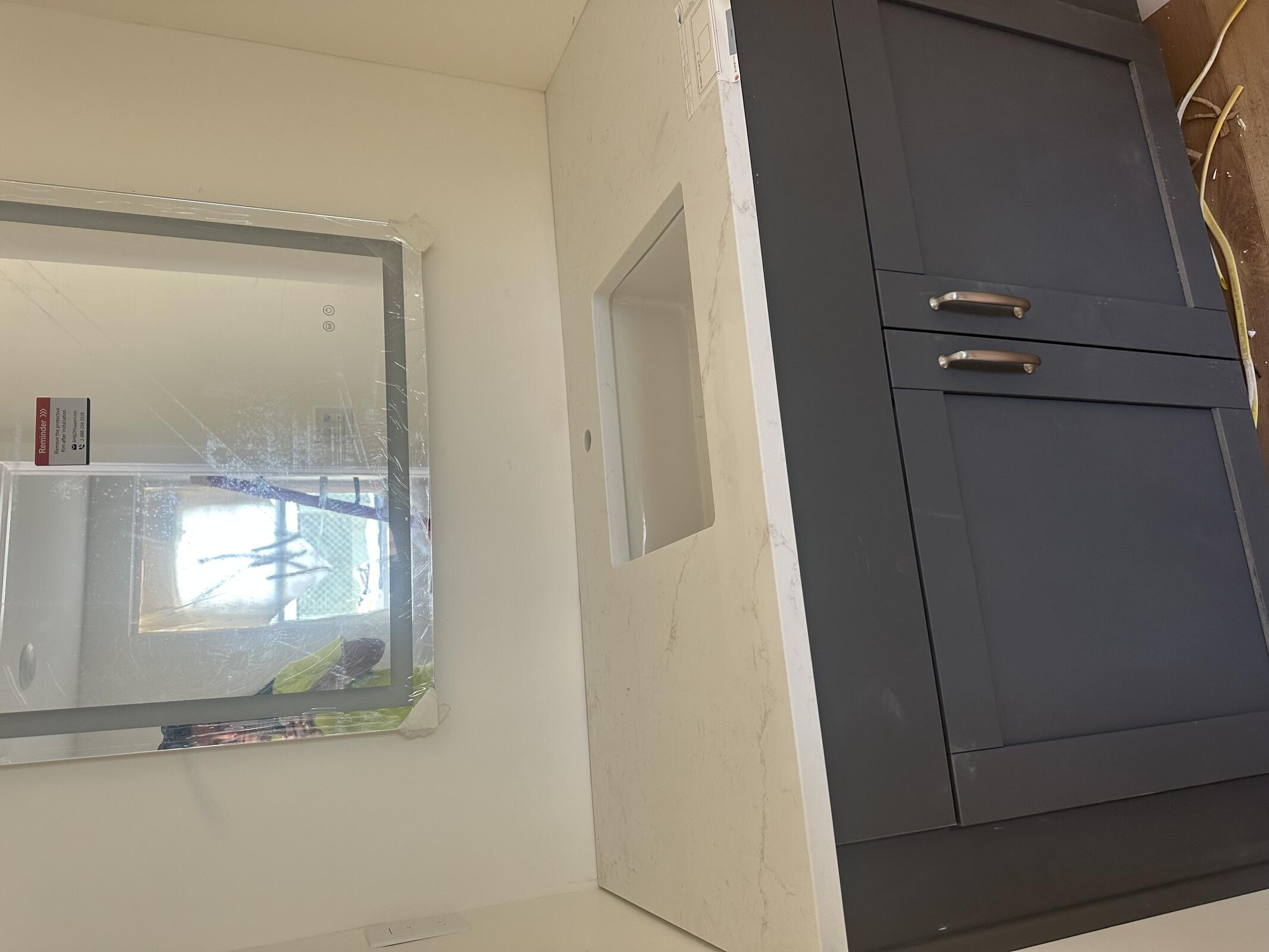

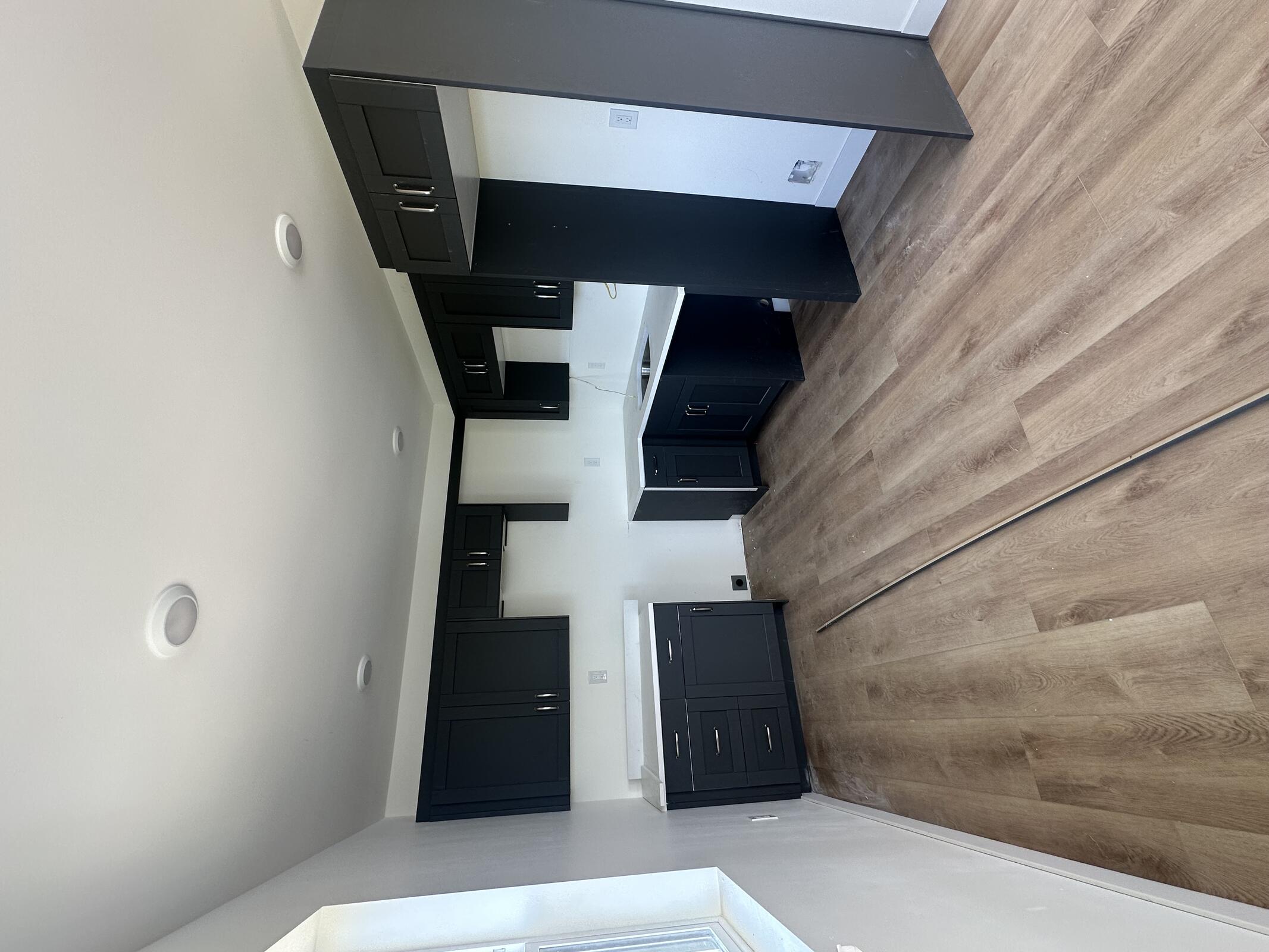

Marjan installing countertops. Garage kitchen countertops pending sink.

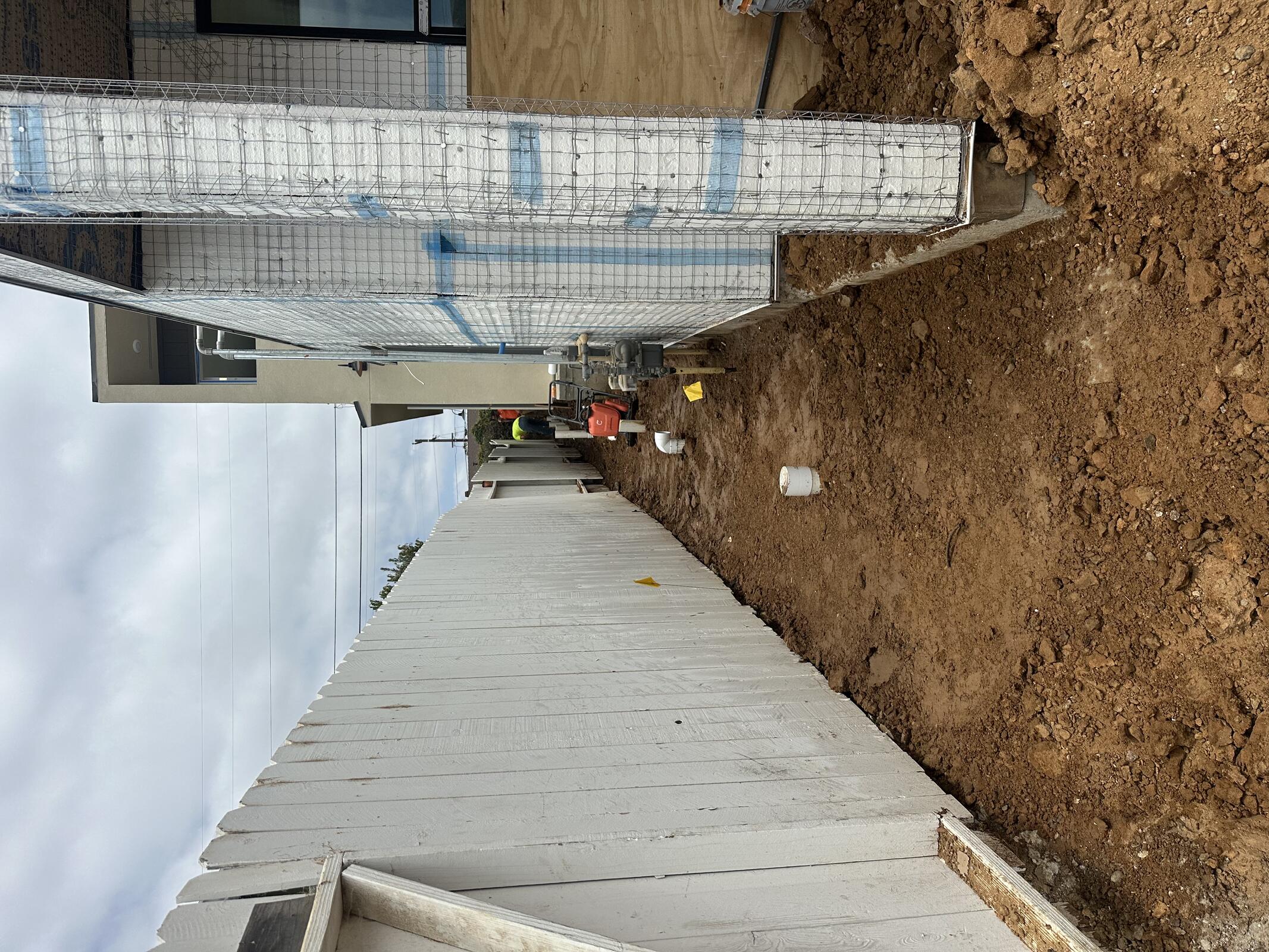

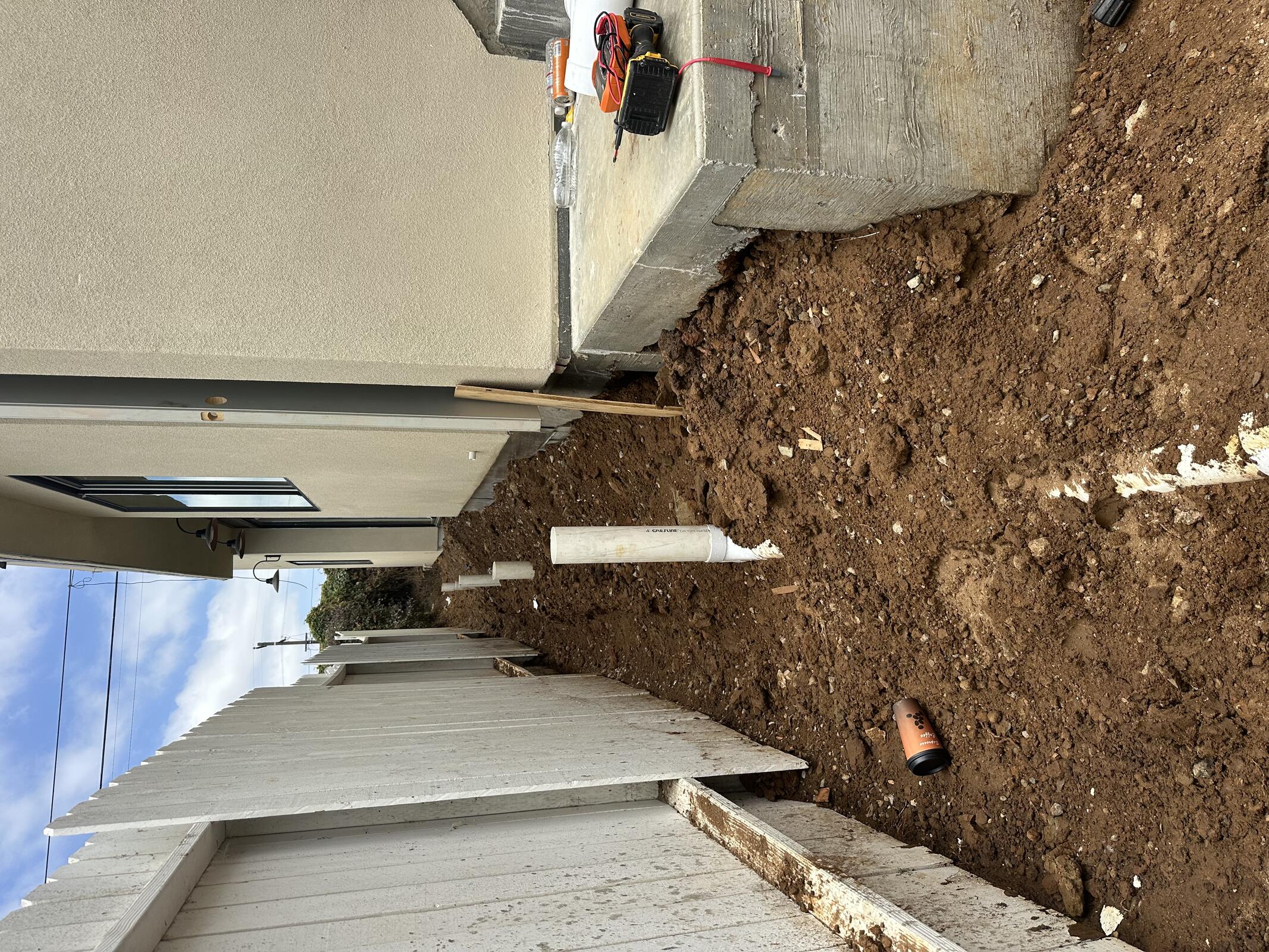

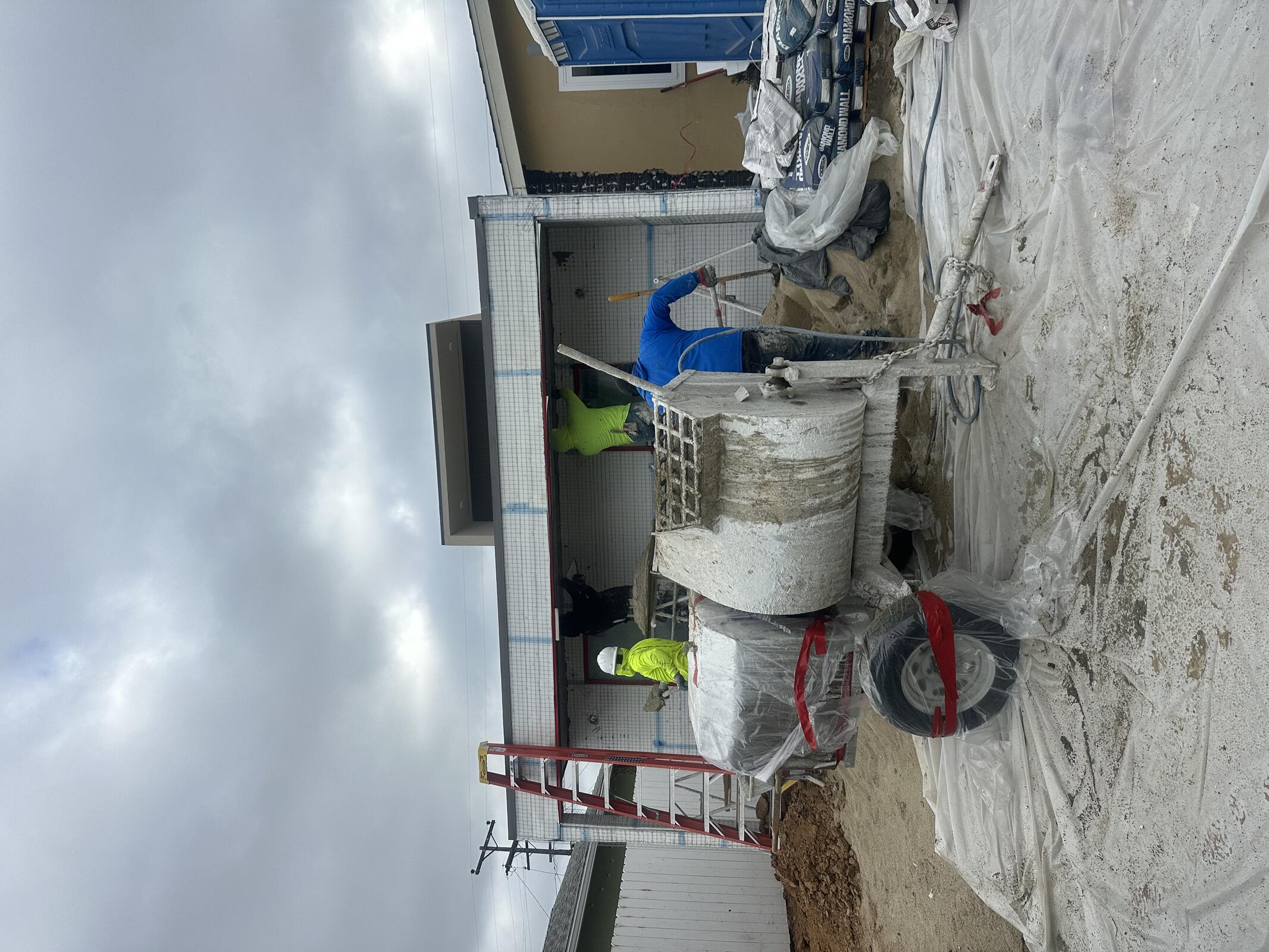

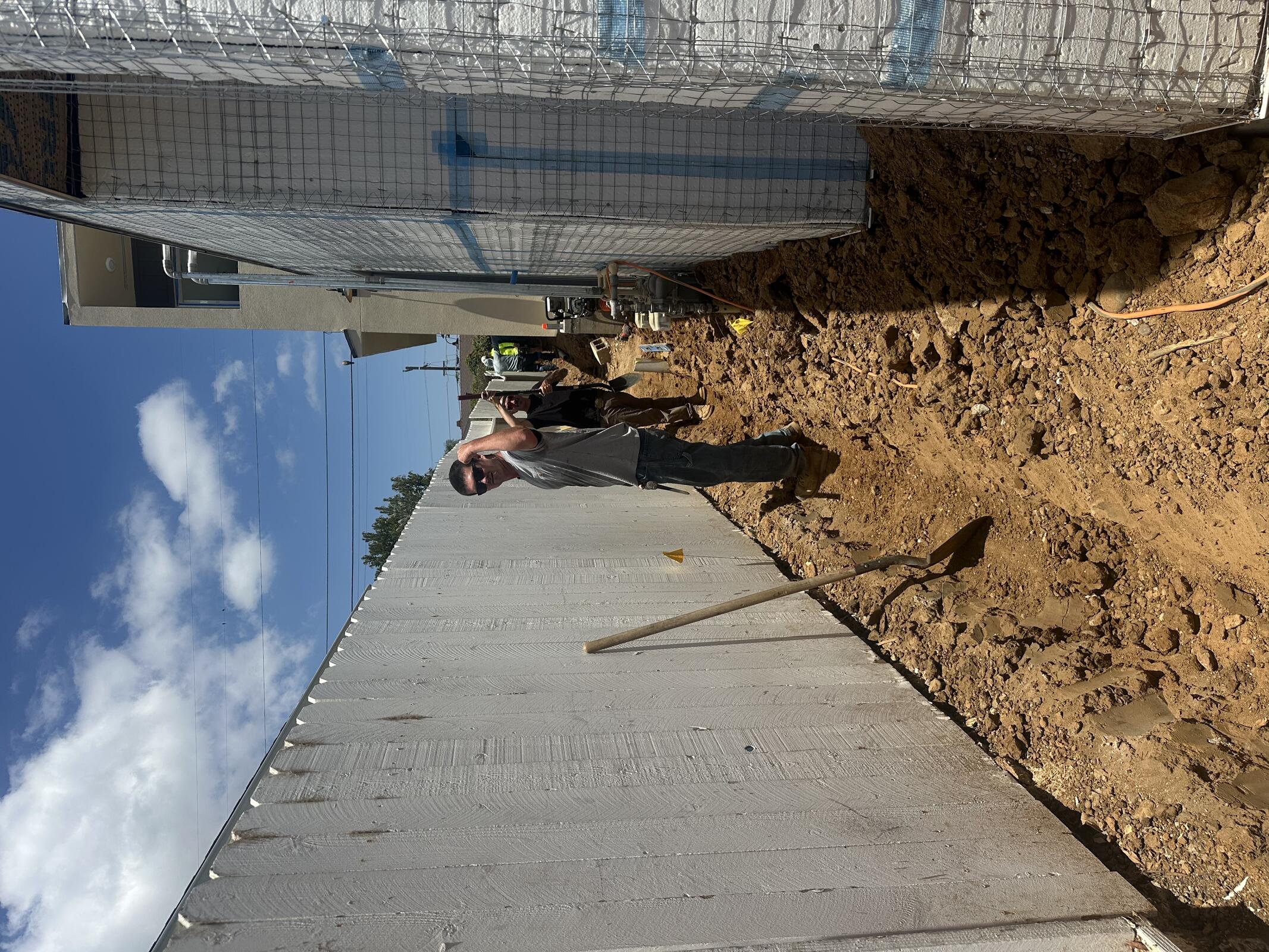

JBG installing drains, backfilling and starting formwork.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
AC Electric188
JBG4832
Marjan Stone4832

Inspection: N/A

Delay: Electric saga with the city continues…

Wednesday, July 01, 2026

Partially cloudy, 68°F

AC Electric continuing trim.

ZSP continuing trim.

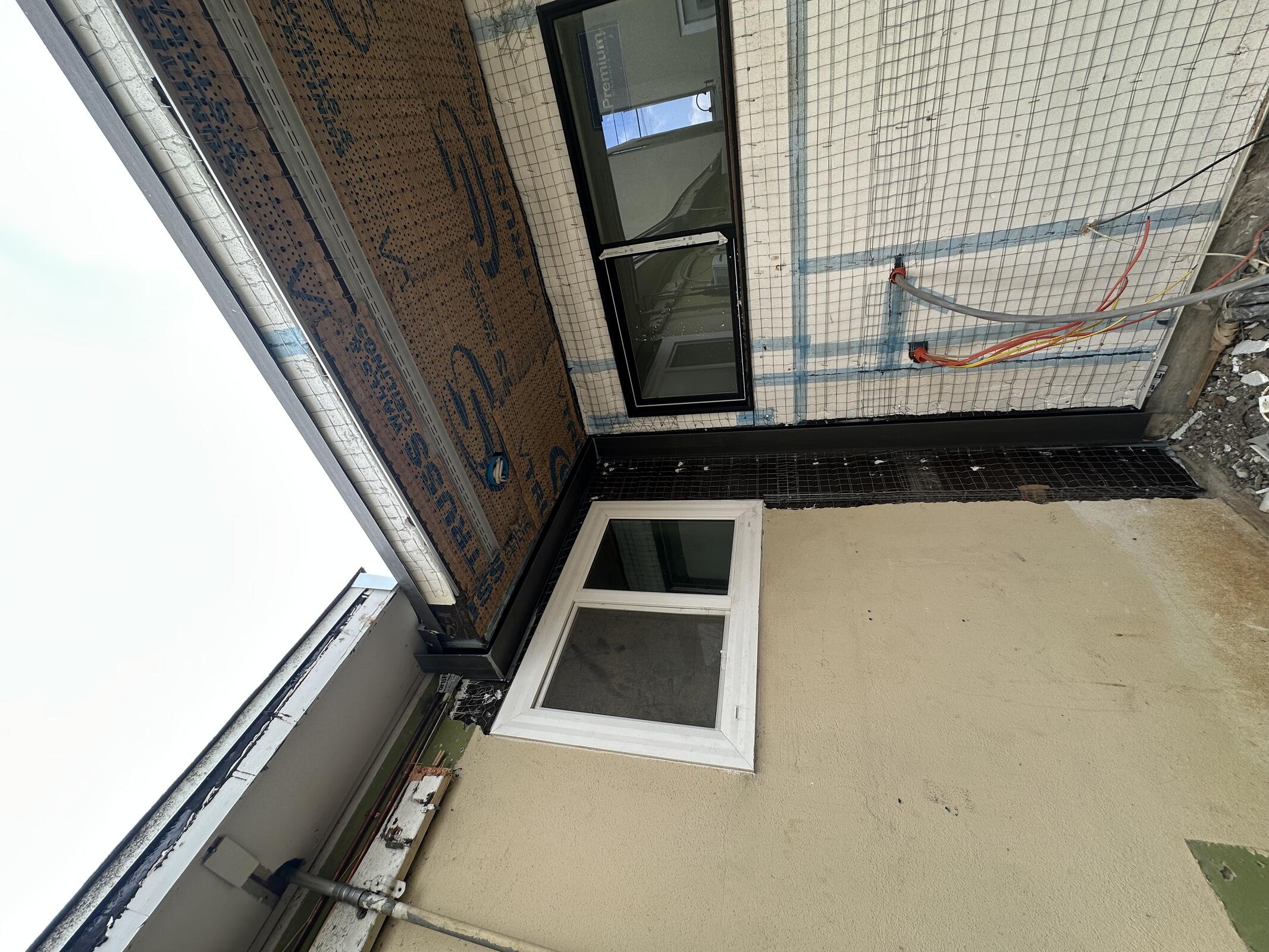

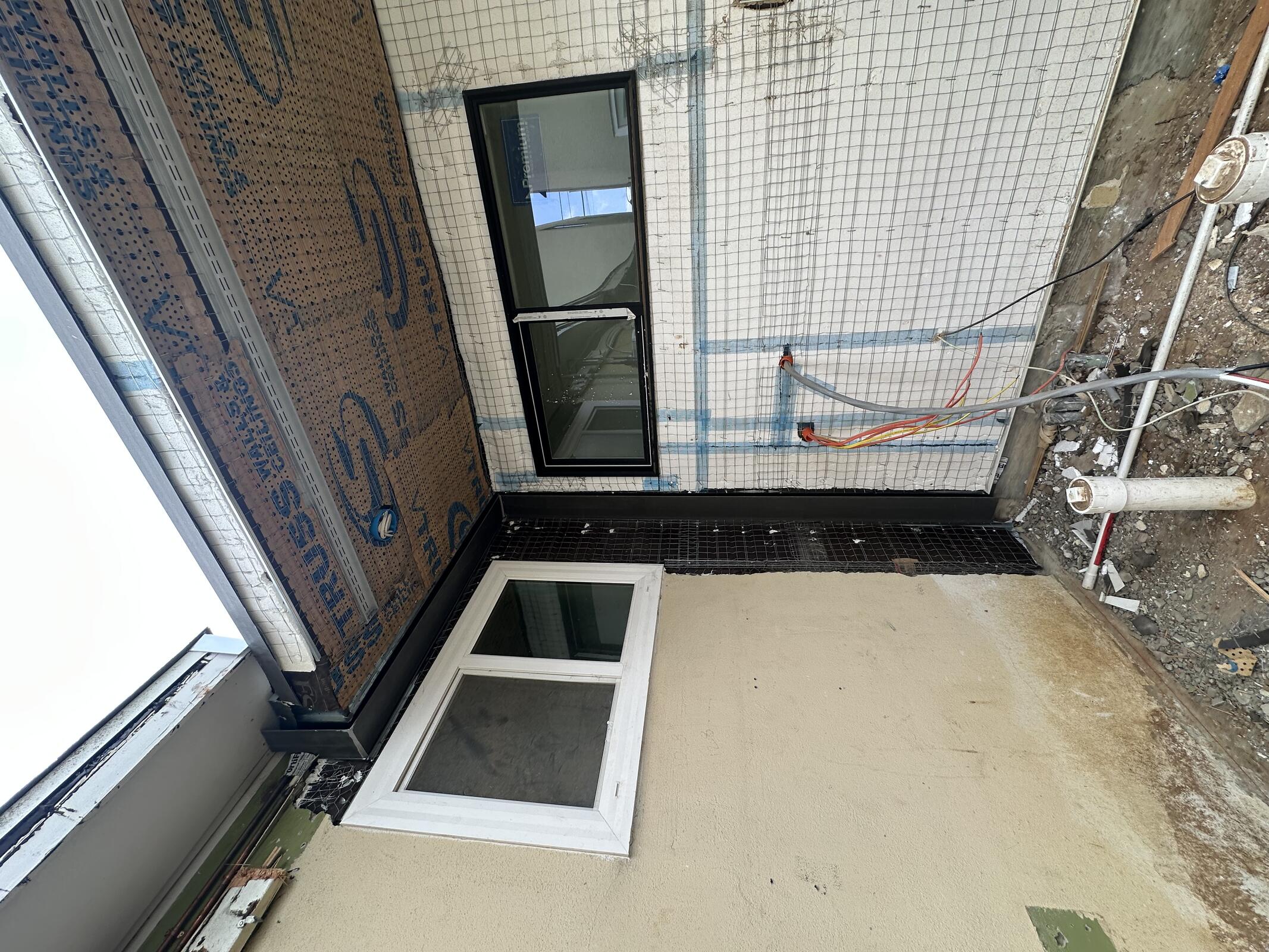

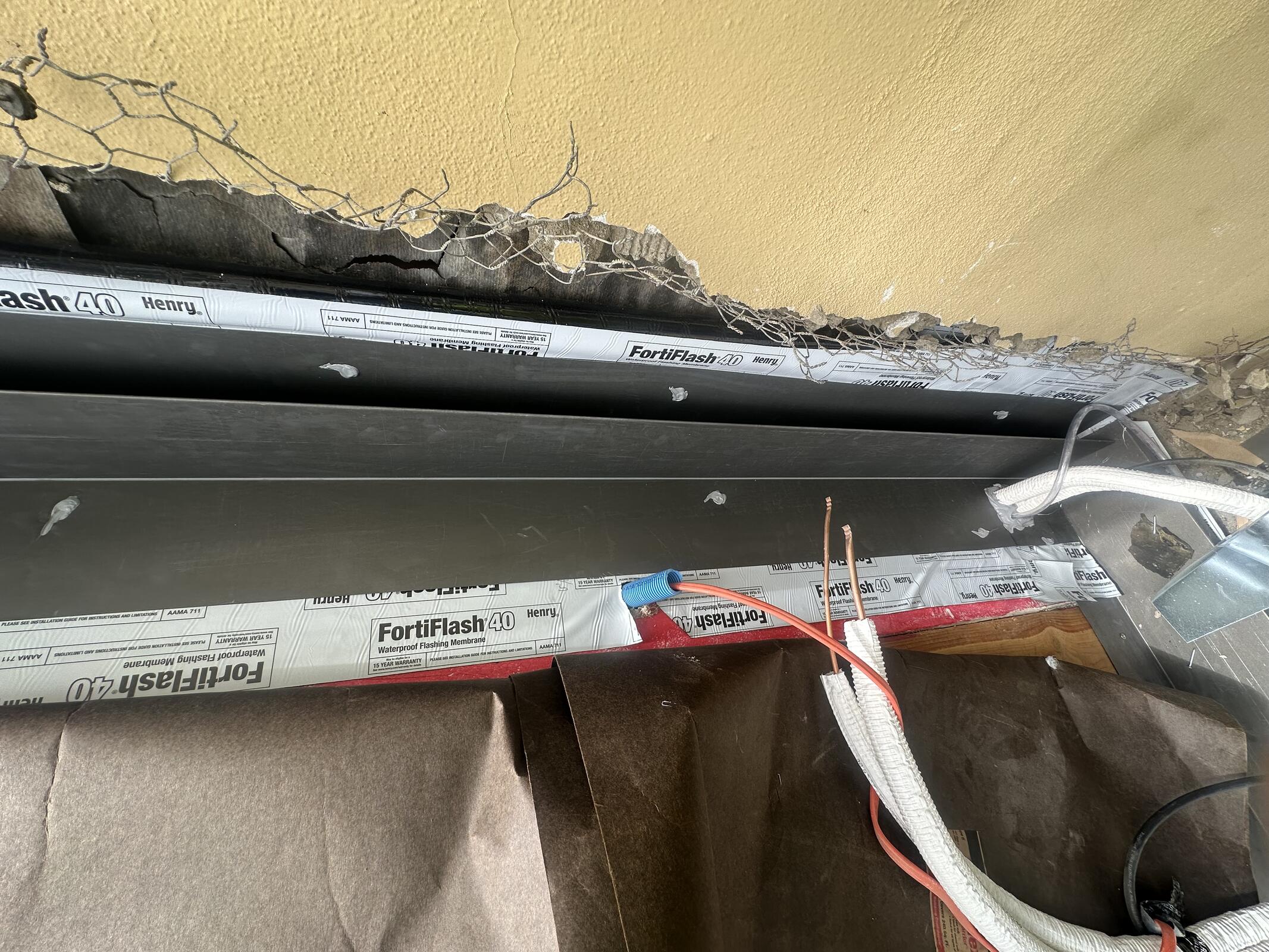

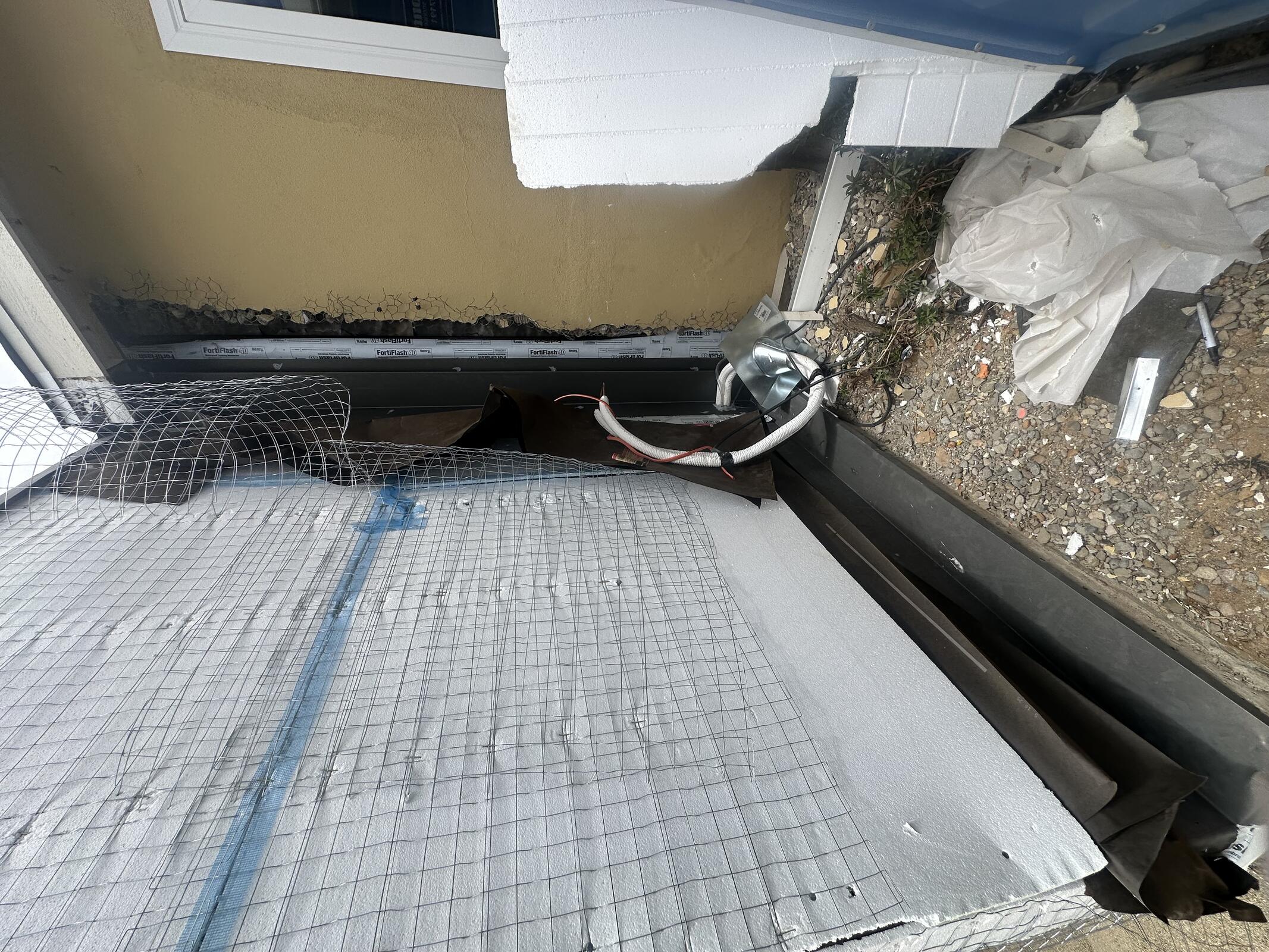

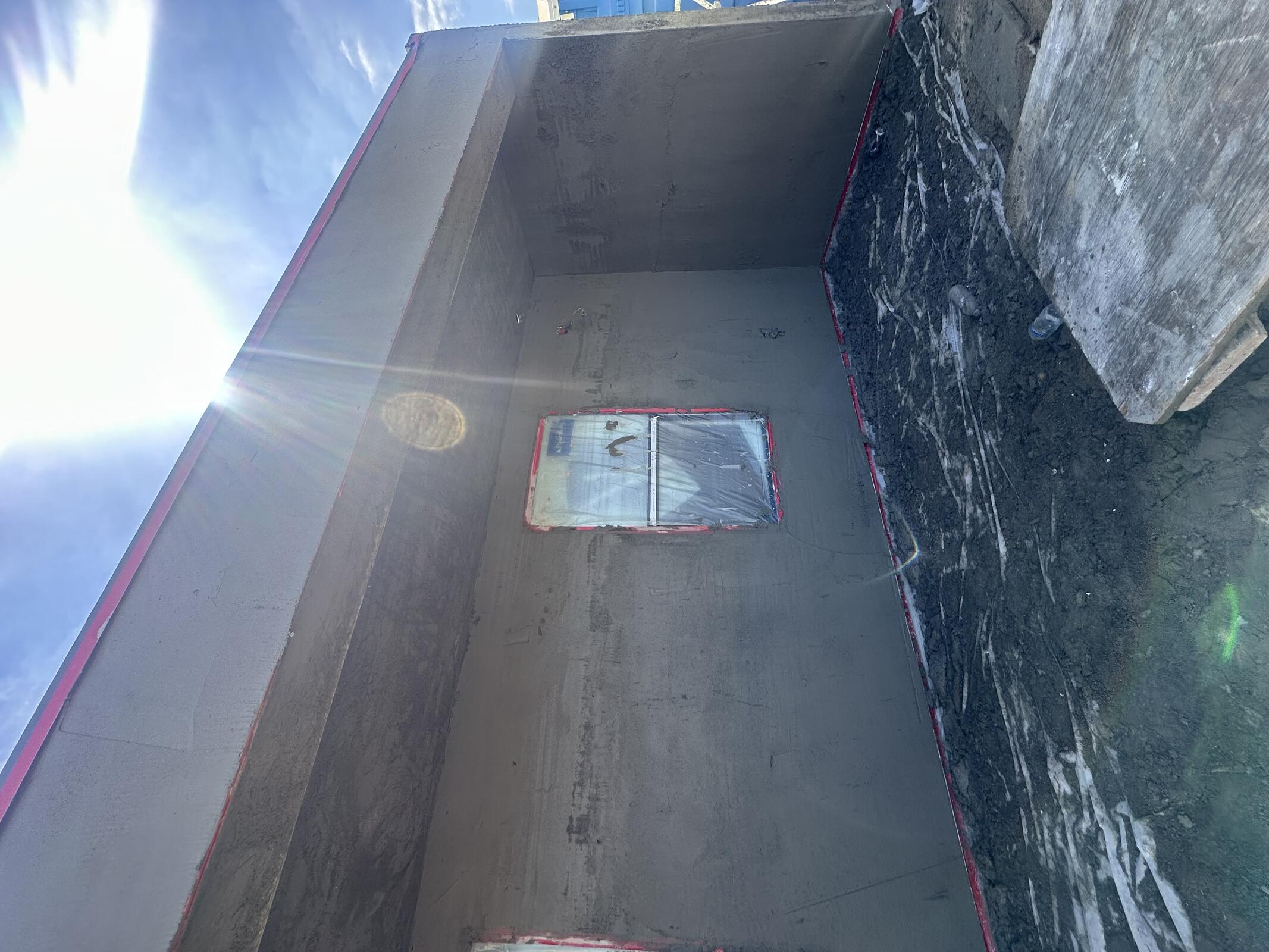

JBG finishing up drainage and working on formwork for raised entrance at building C.

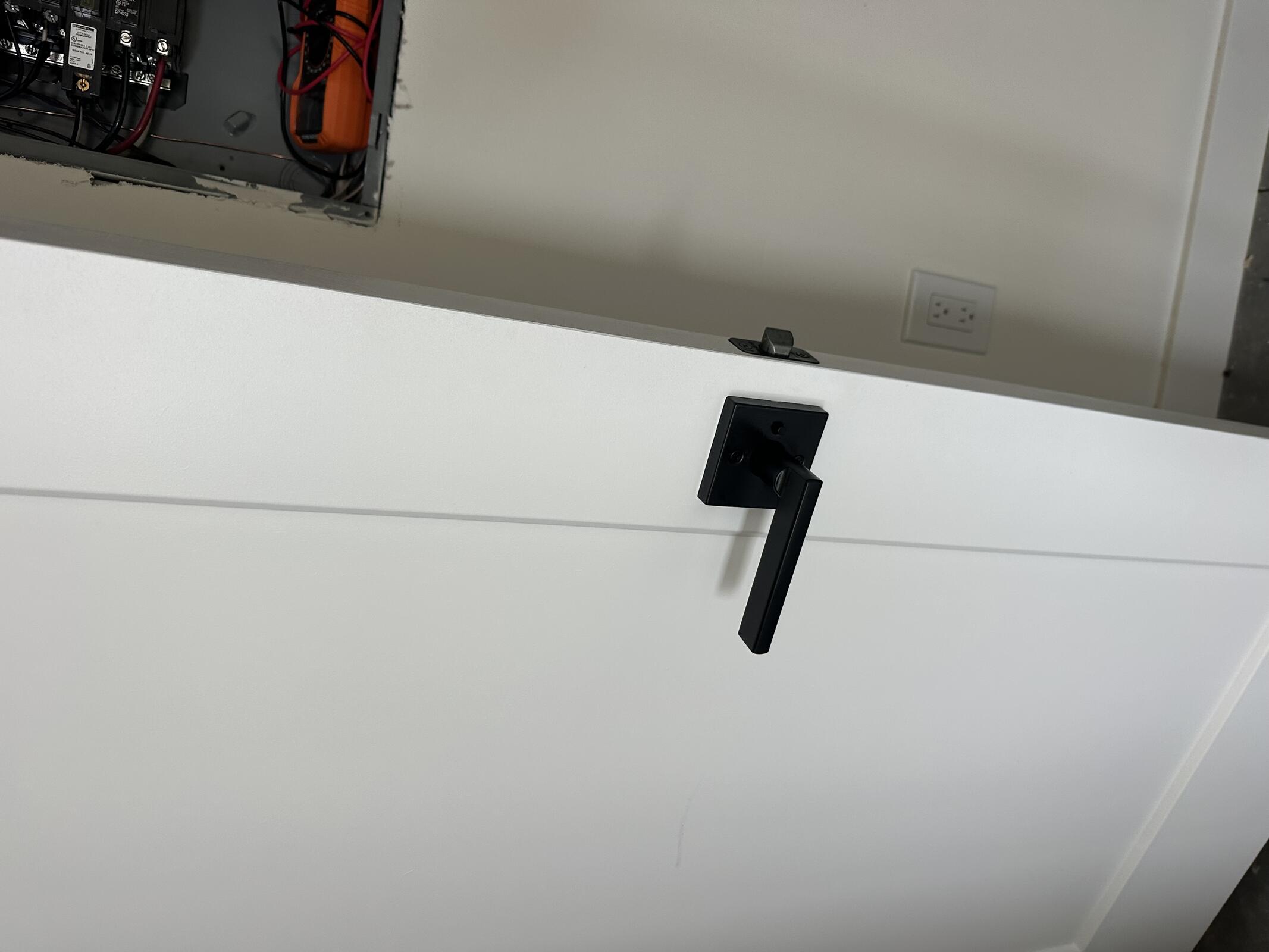

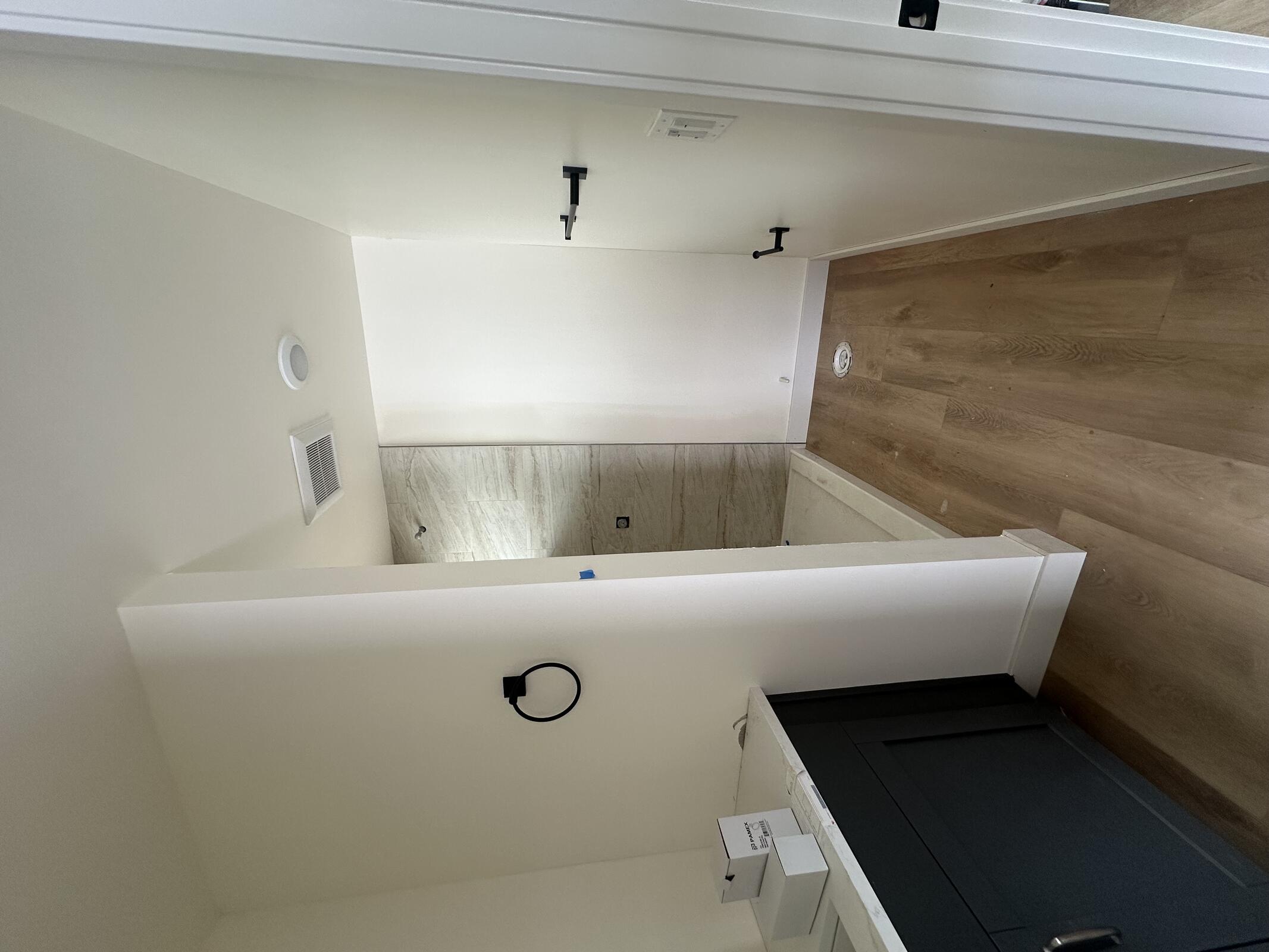

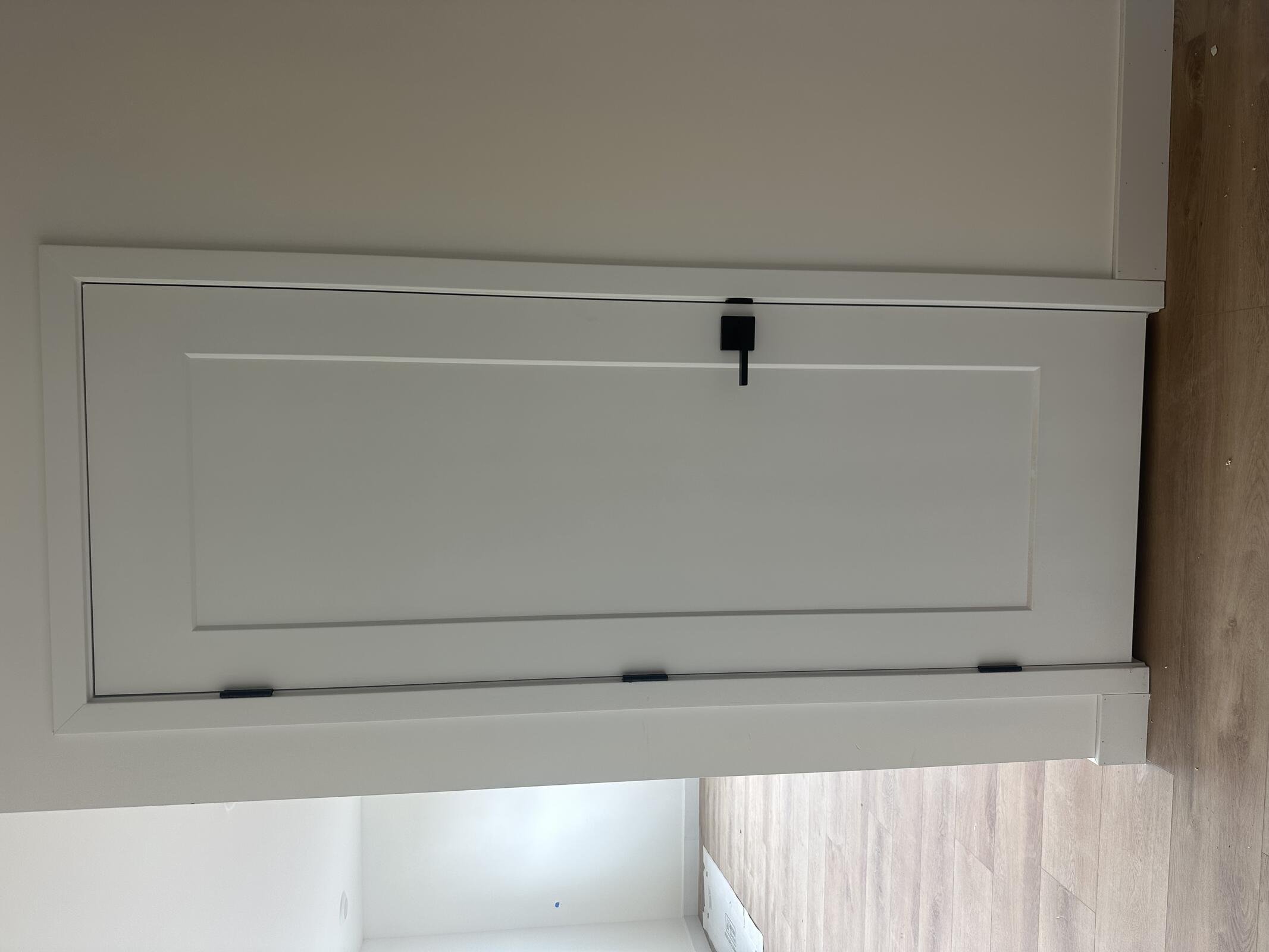

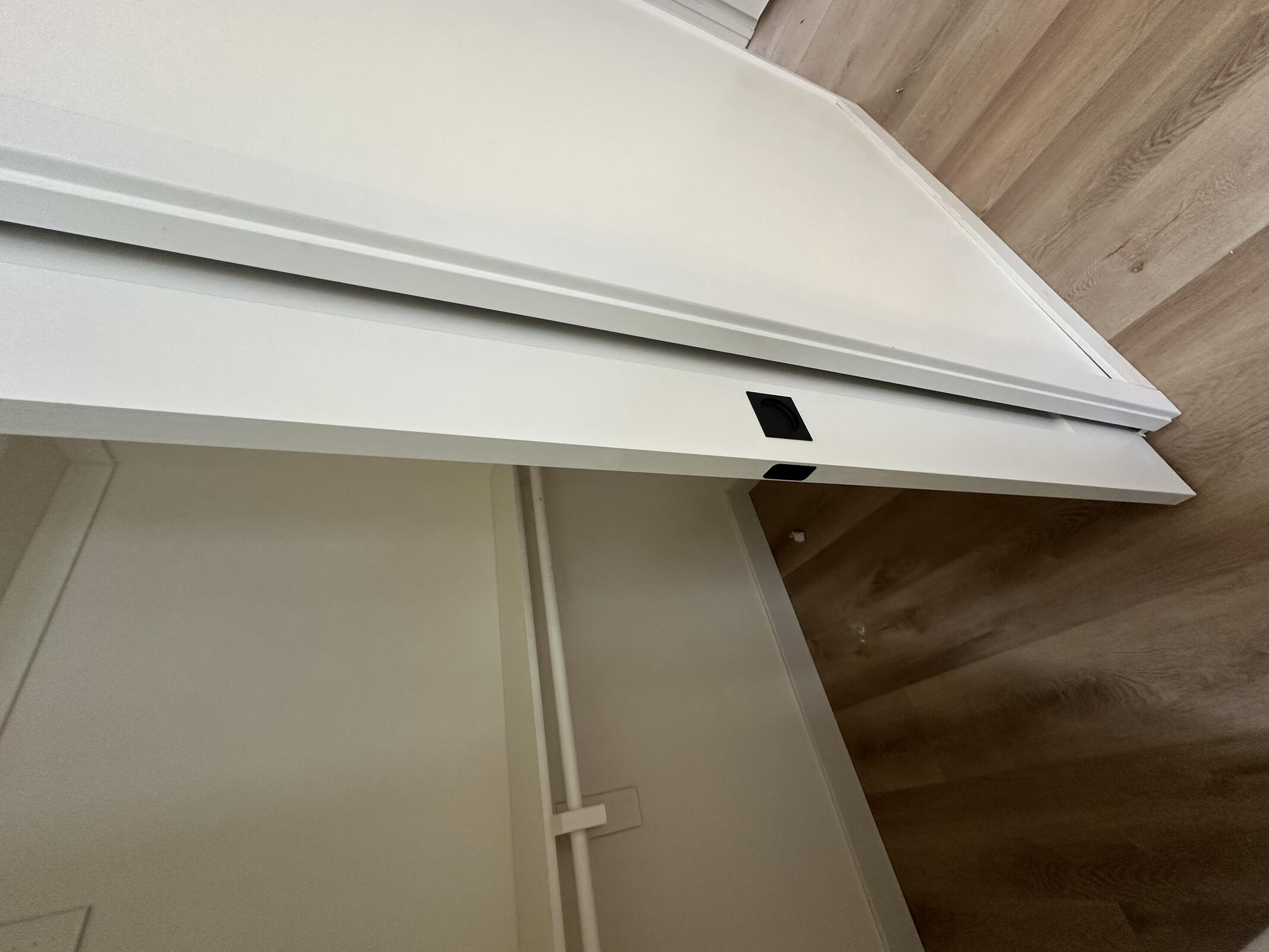

Taylor Trim installing bathroom hardware and interior door hardware.

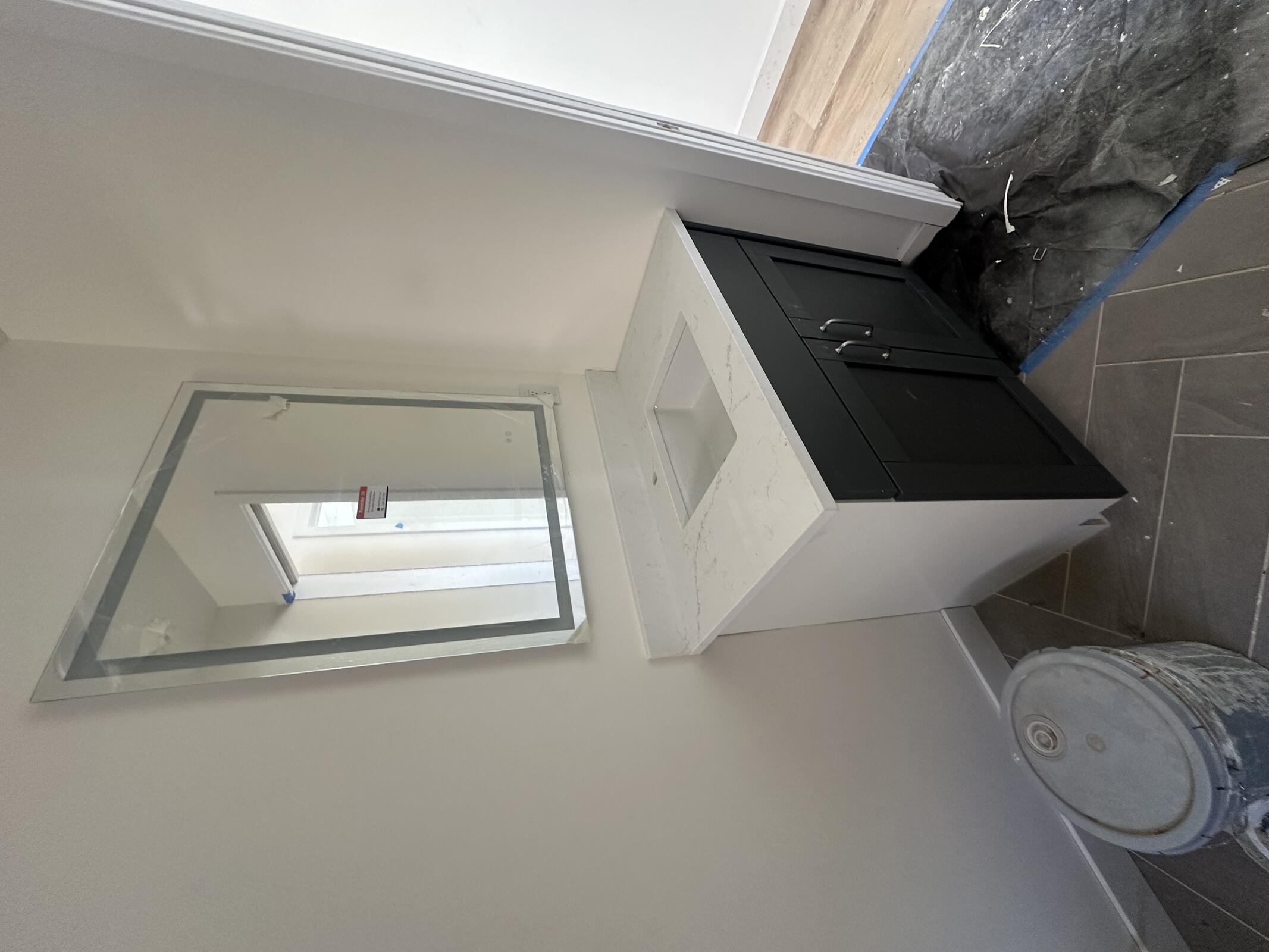

Marjan on site at 2:30 pm to do garage countertops.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
JBG6848
AC Electric4832
ZSP181
Taylor Trim2816

Inspection: Dave Finney on site at 2:30 pm. Passed lath and plaster at garage.

Delay: Electrical submittal

Thursday, July 02, 2026

Overcast, 66°F

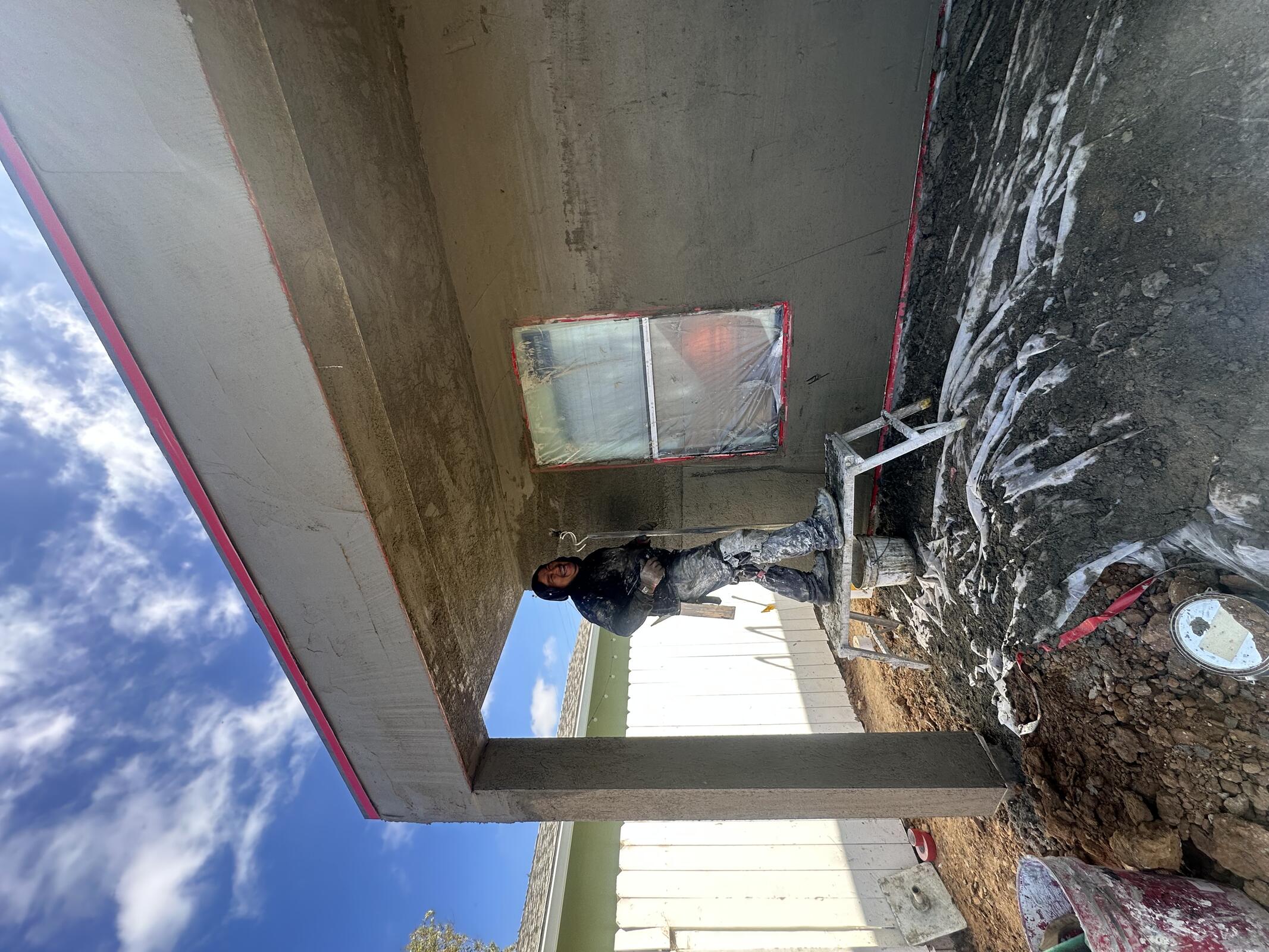

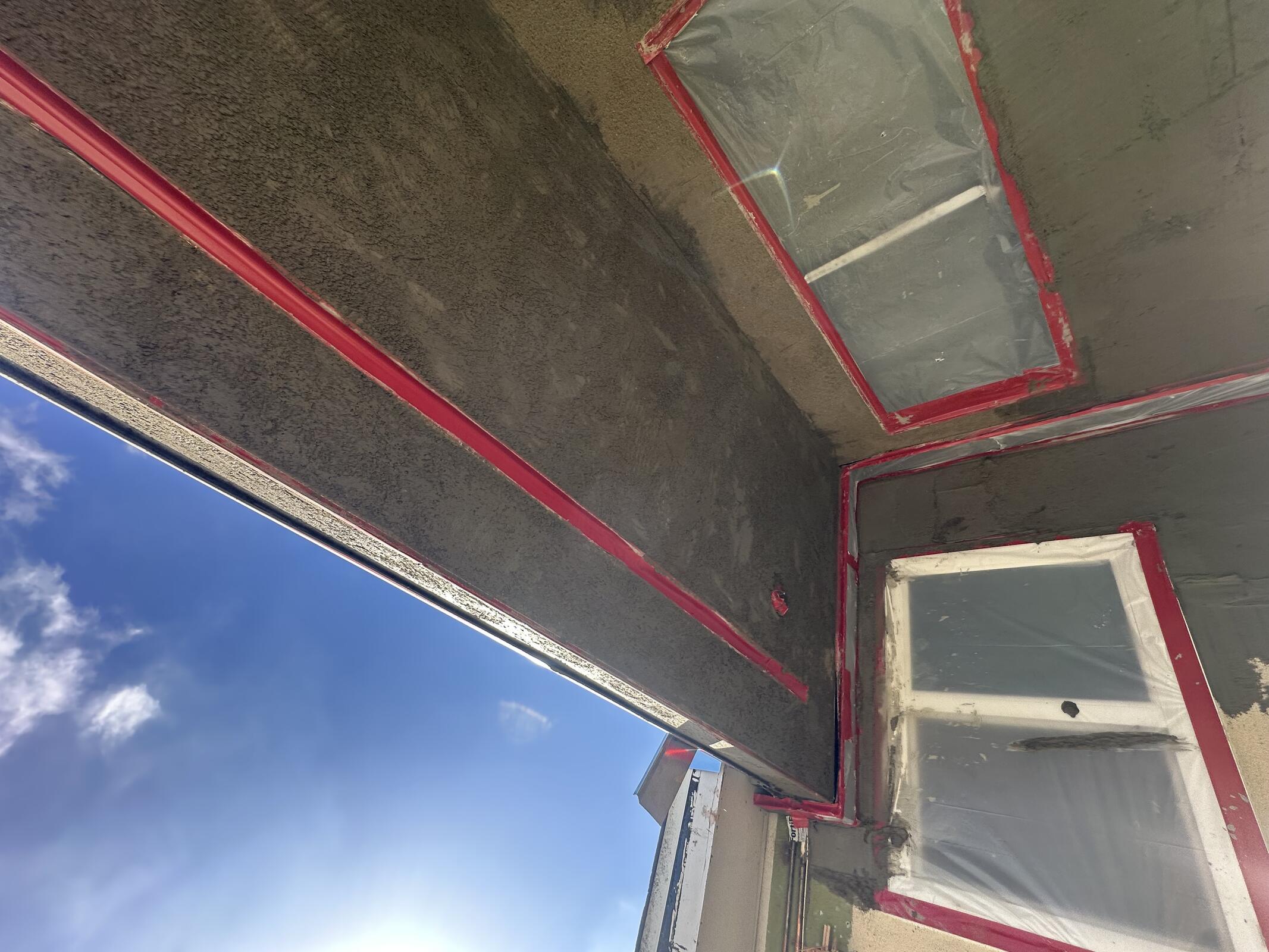

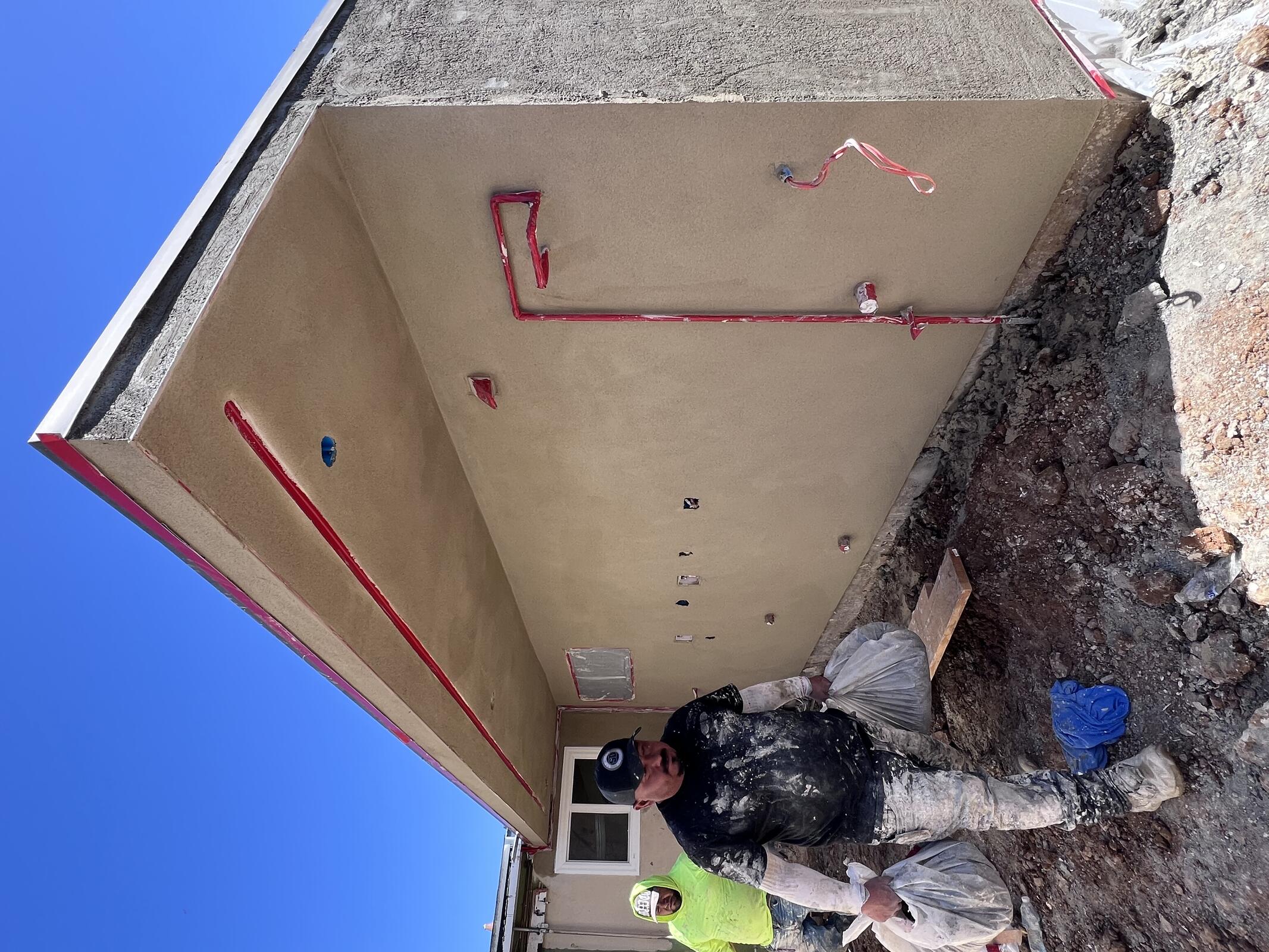

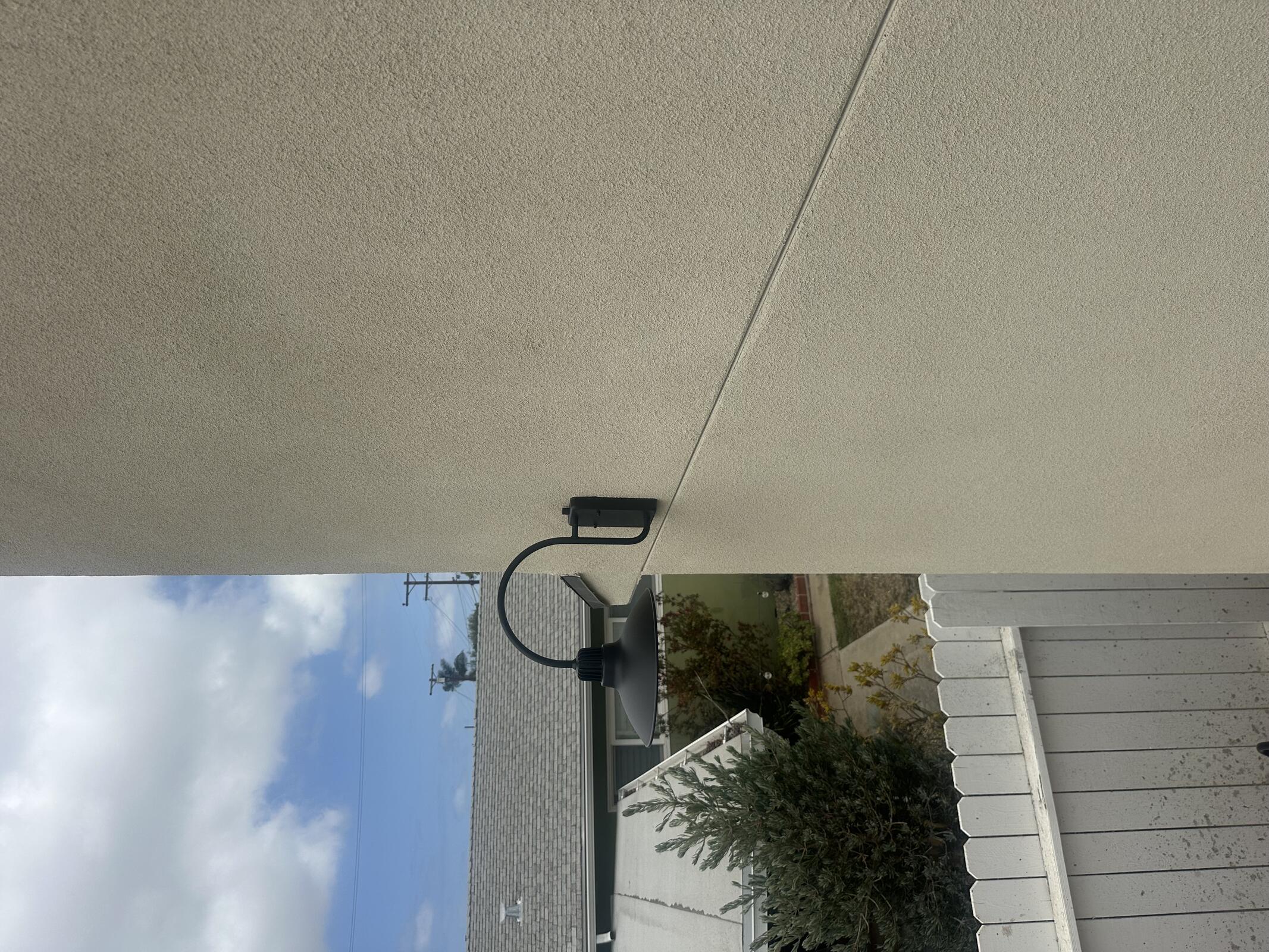

Marq stuccoing garage.

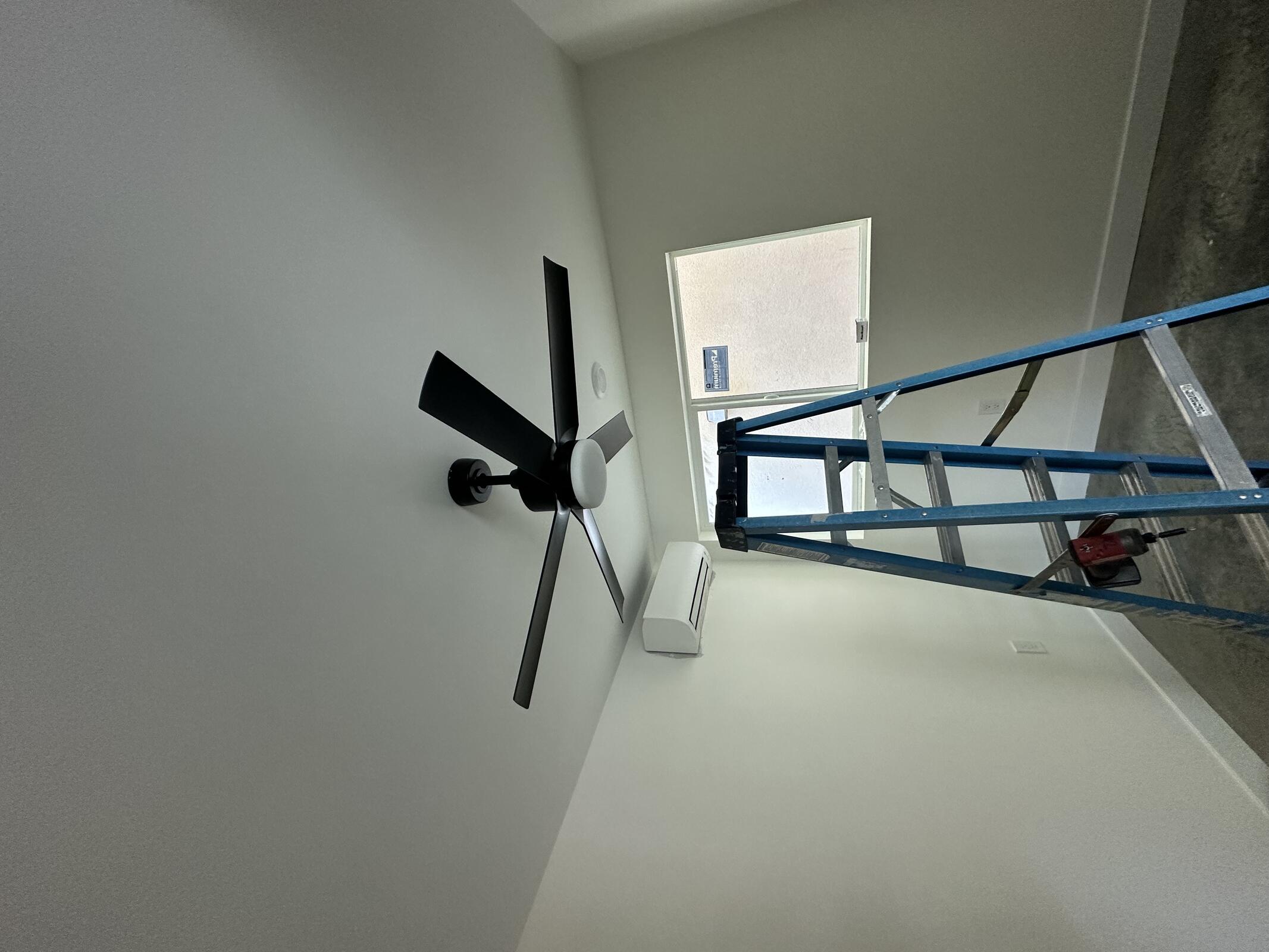

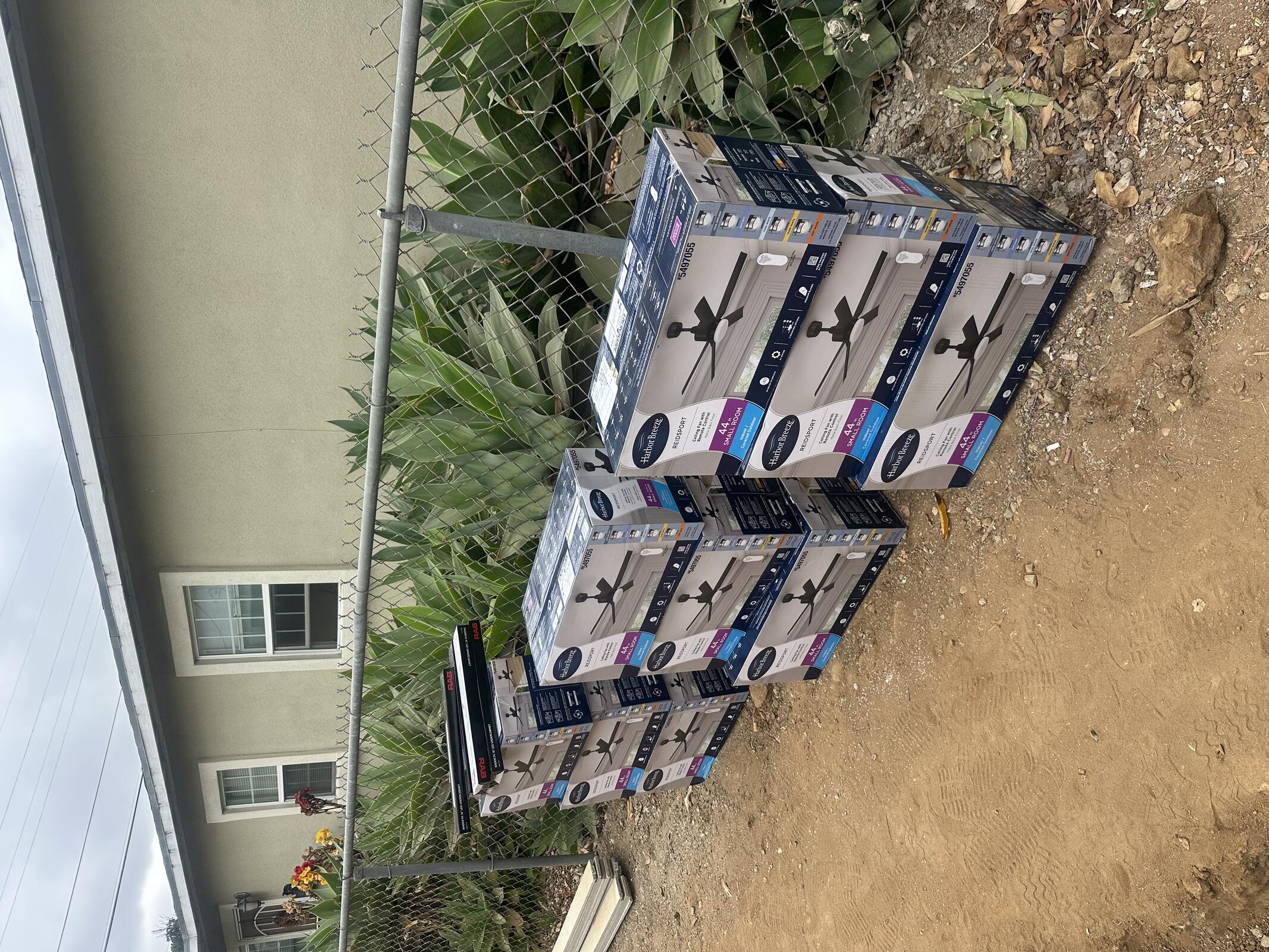

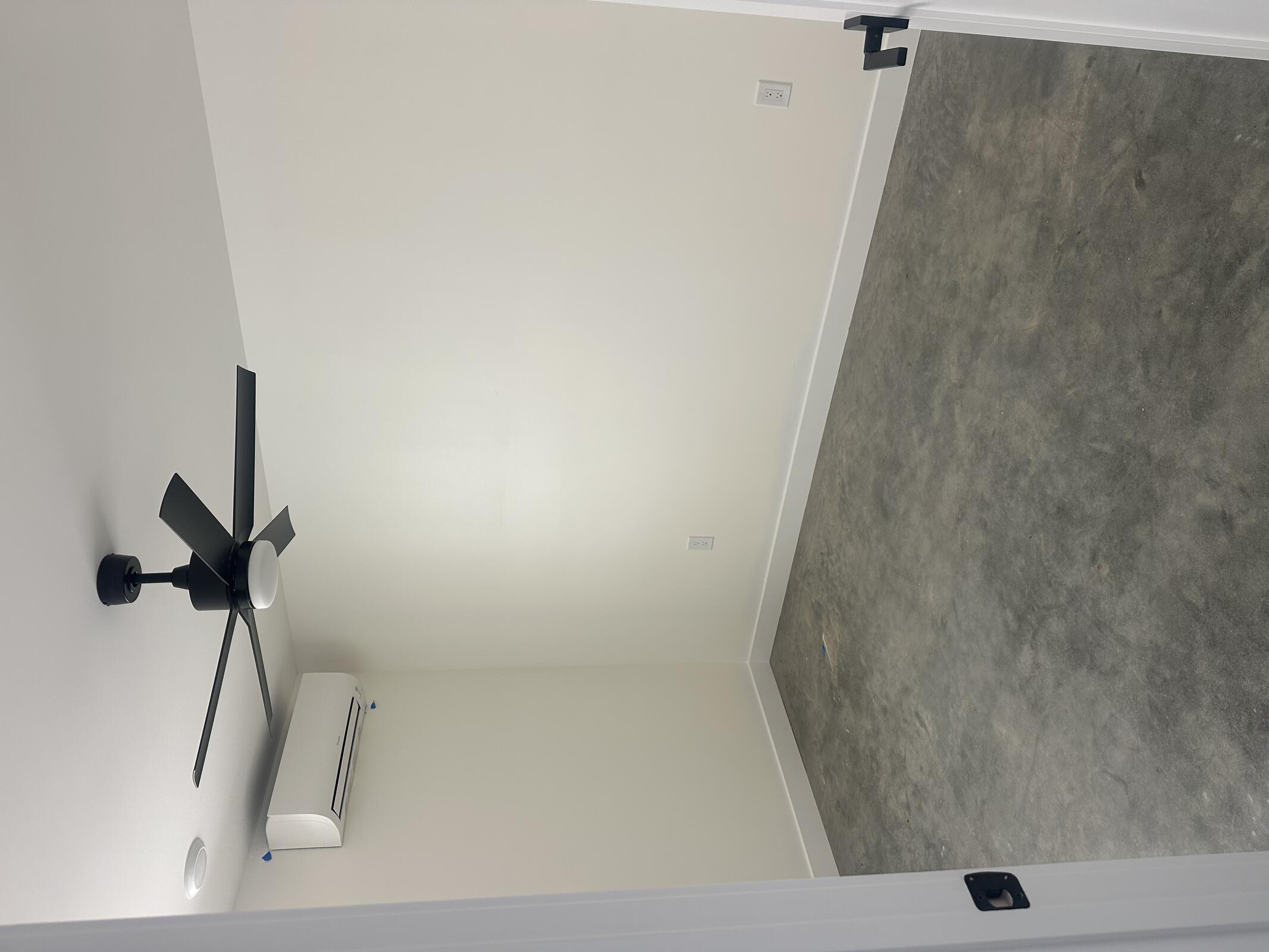

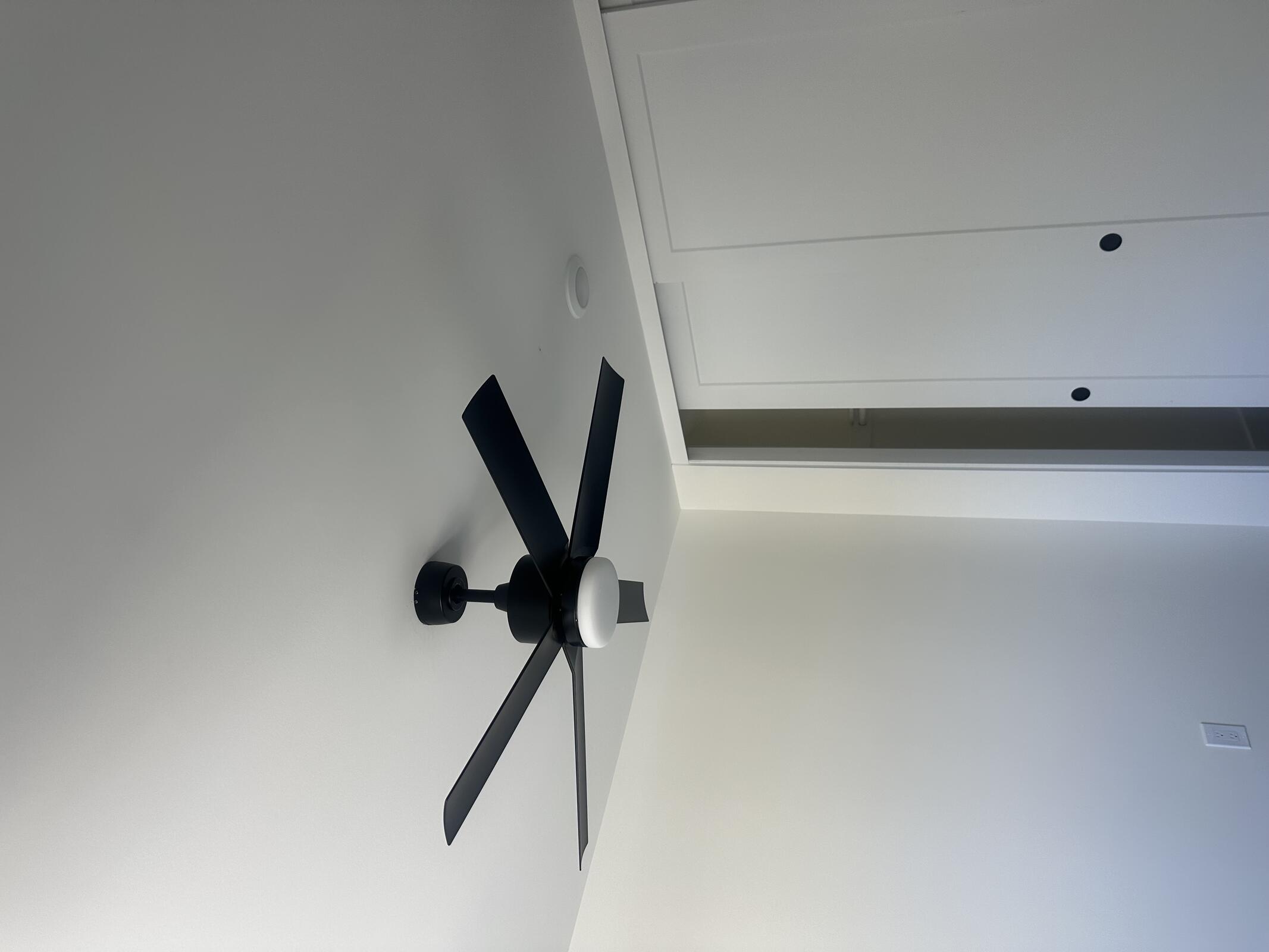

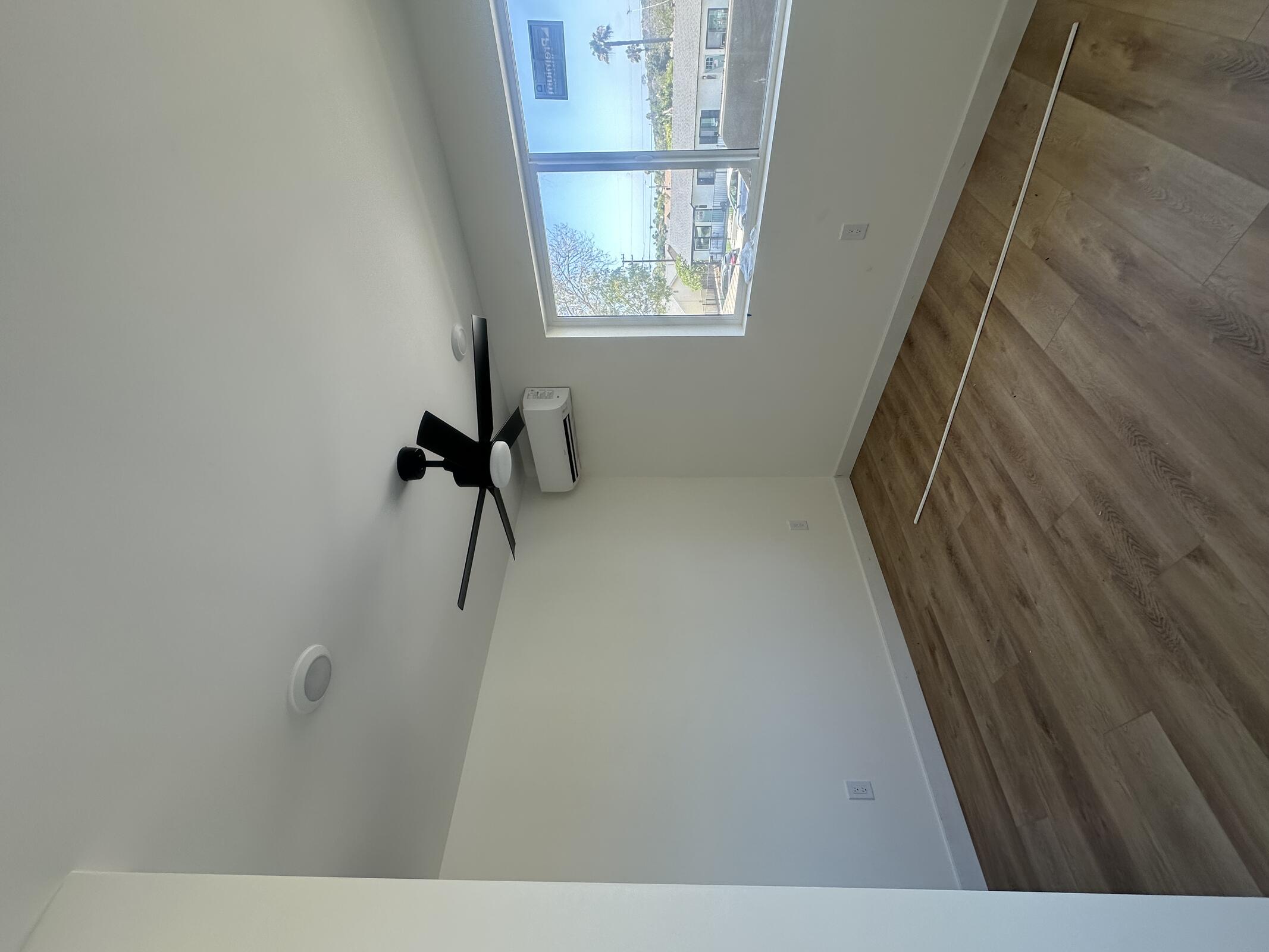

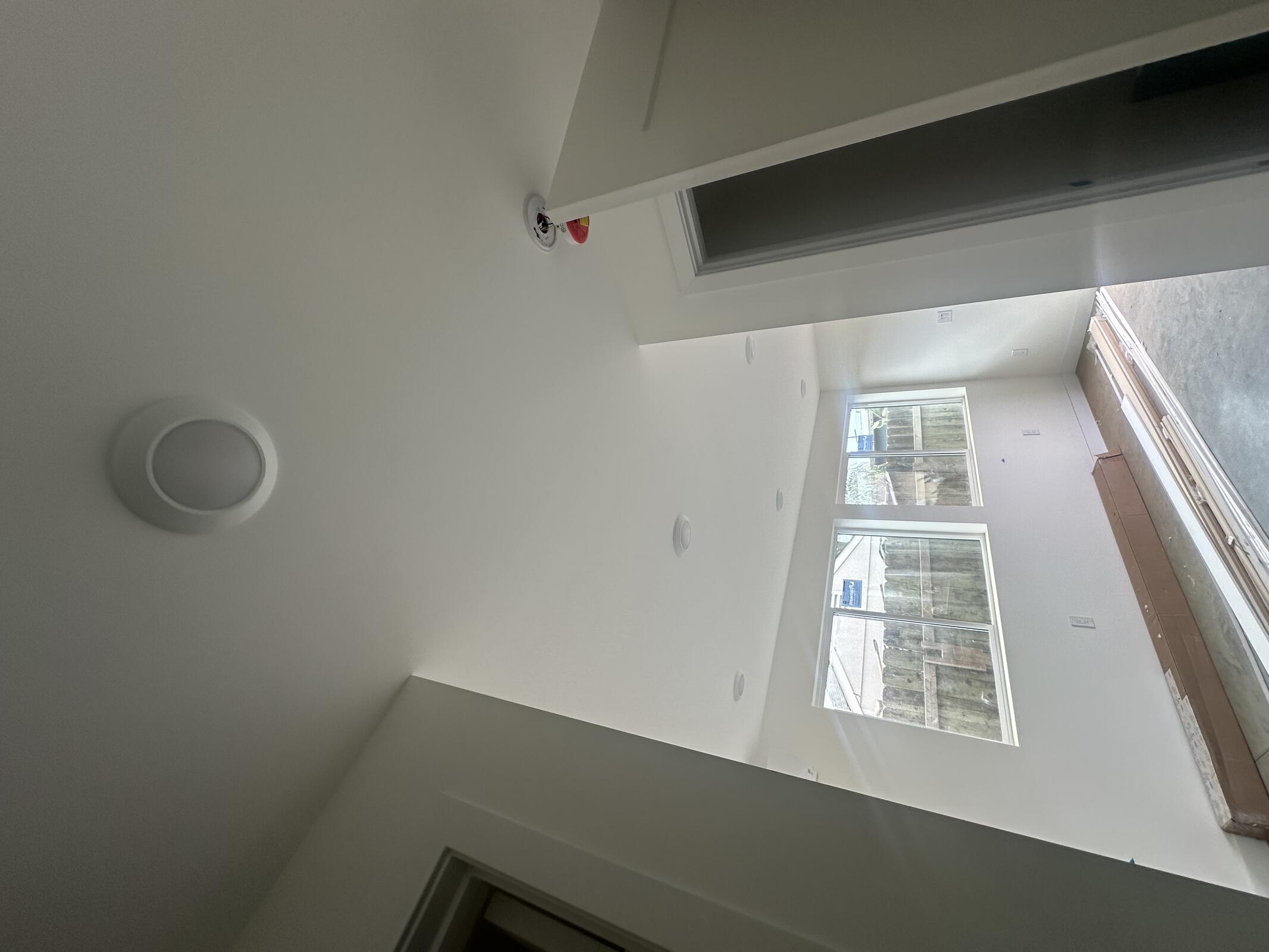

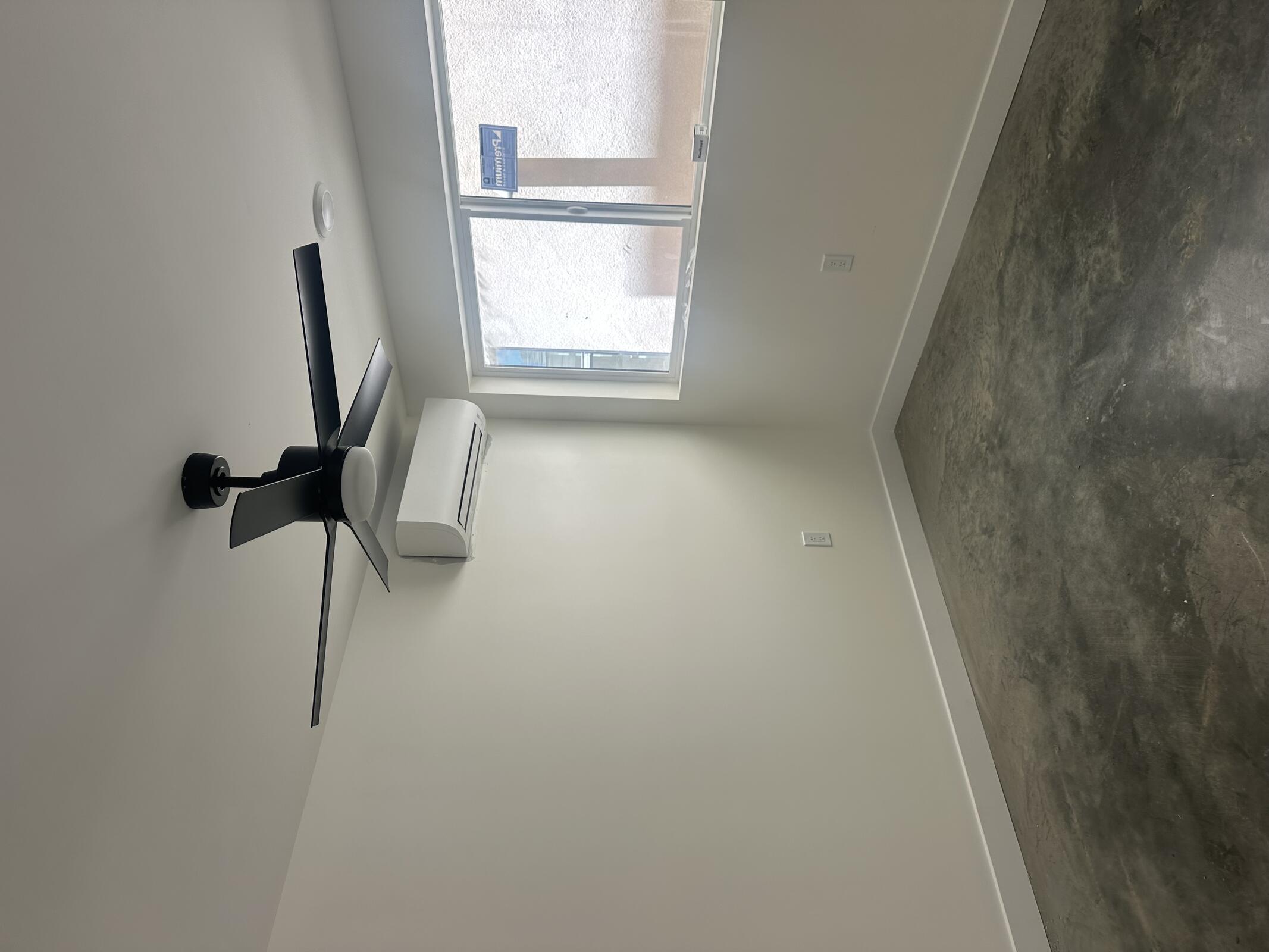

AC Electric installing ceiling fans and doorbells.

ZSP installing garbage disposals and faucets.

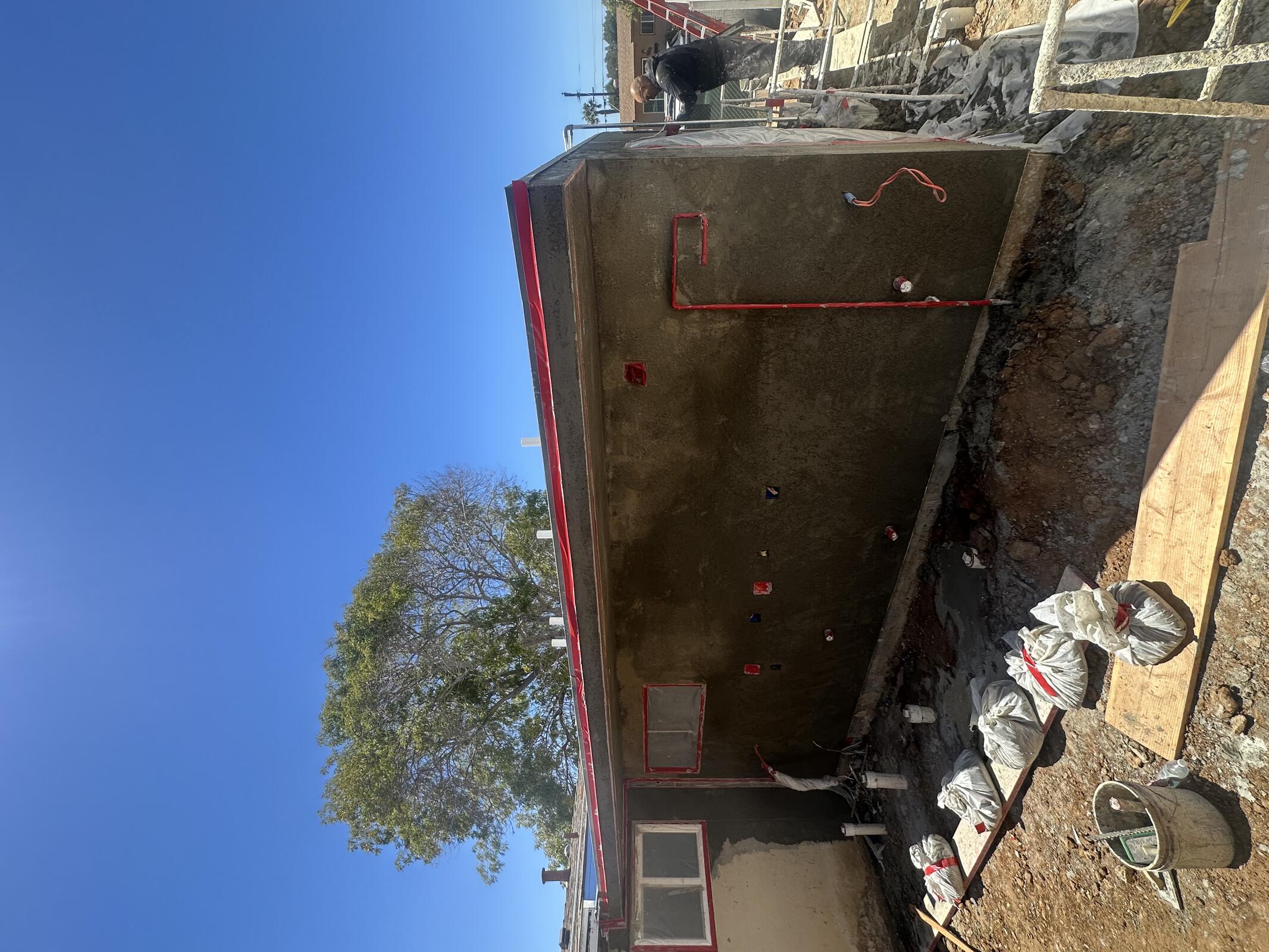

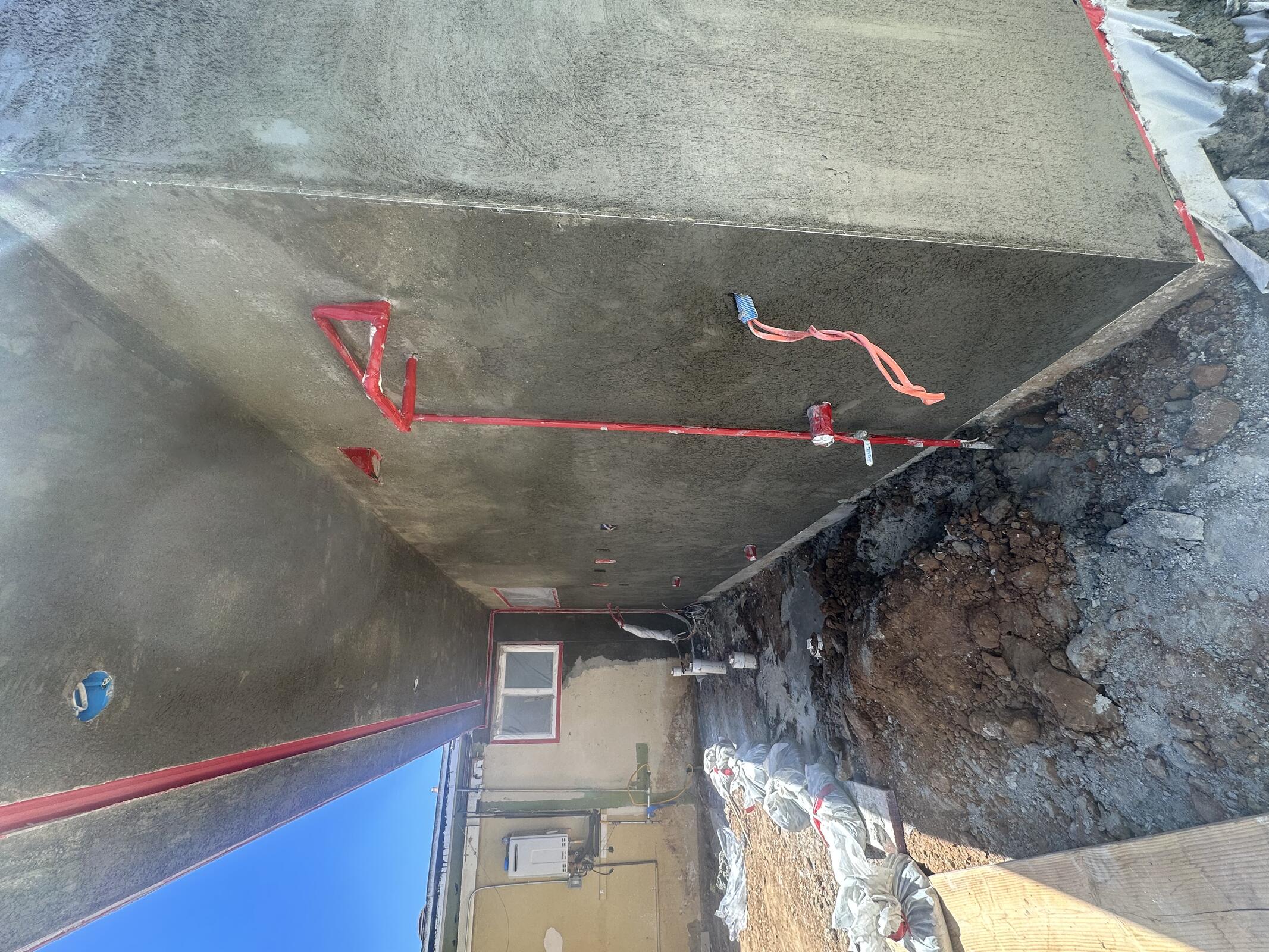

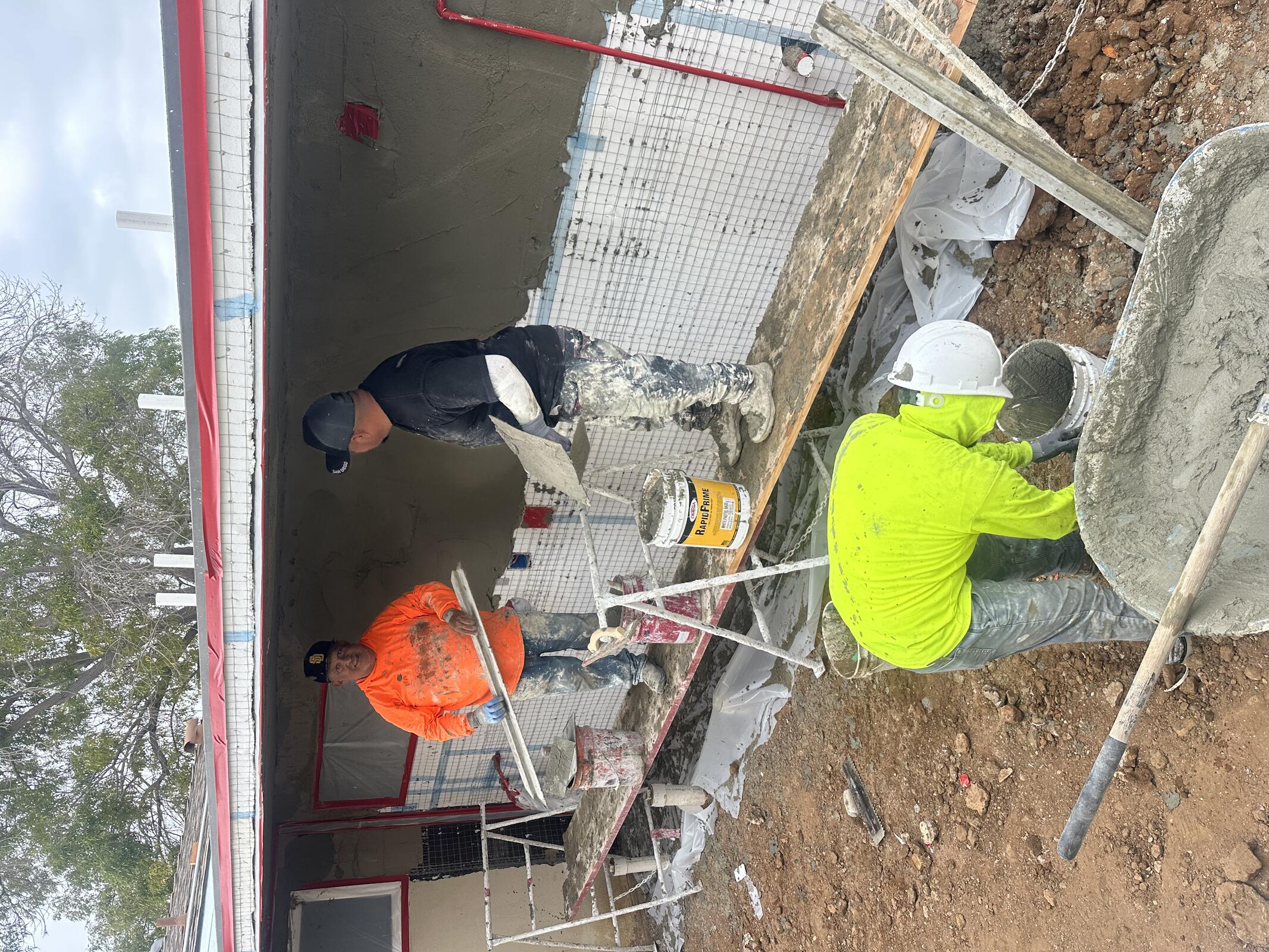

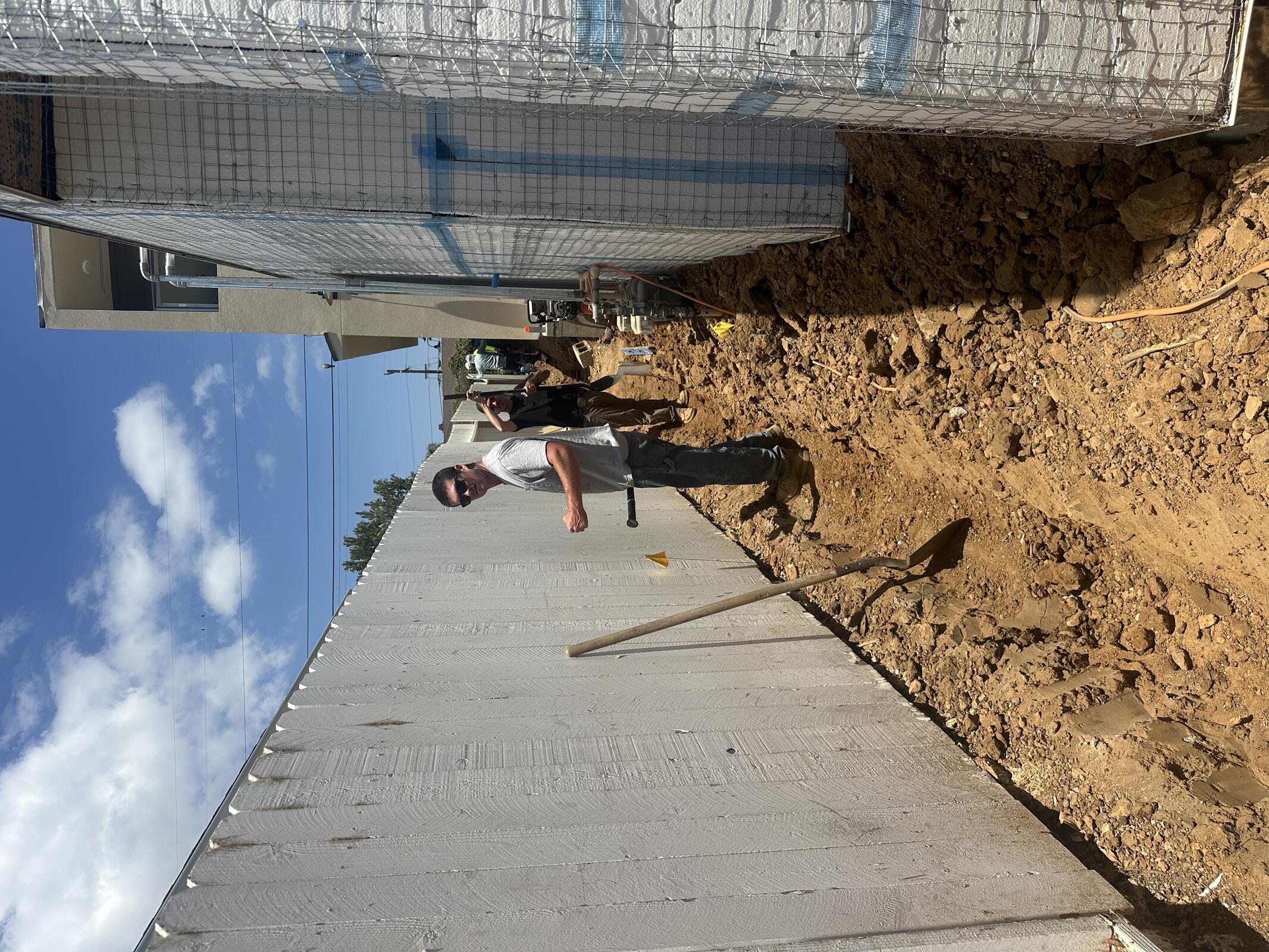

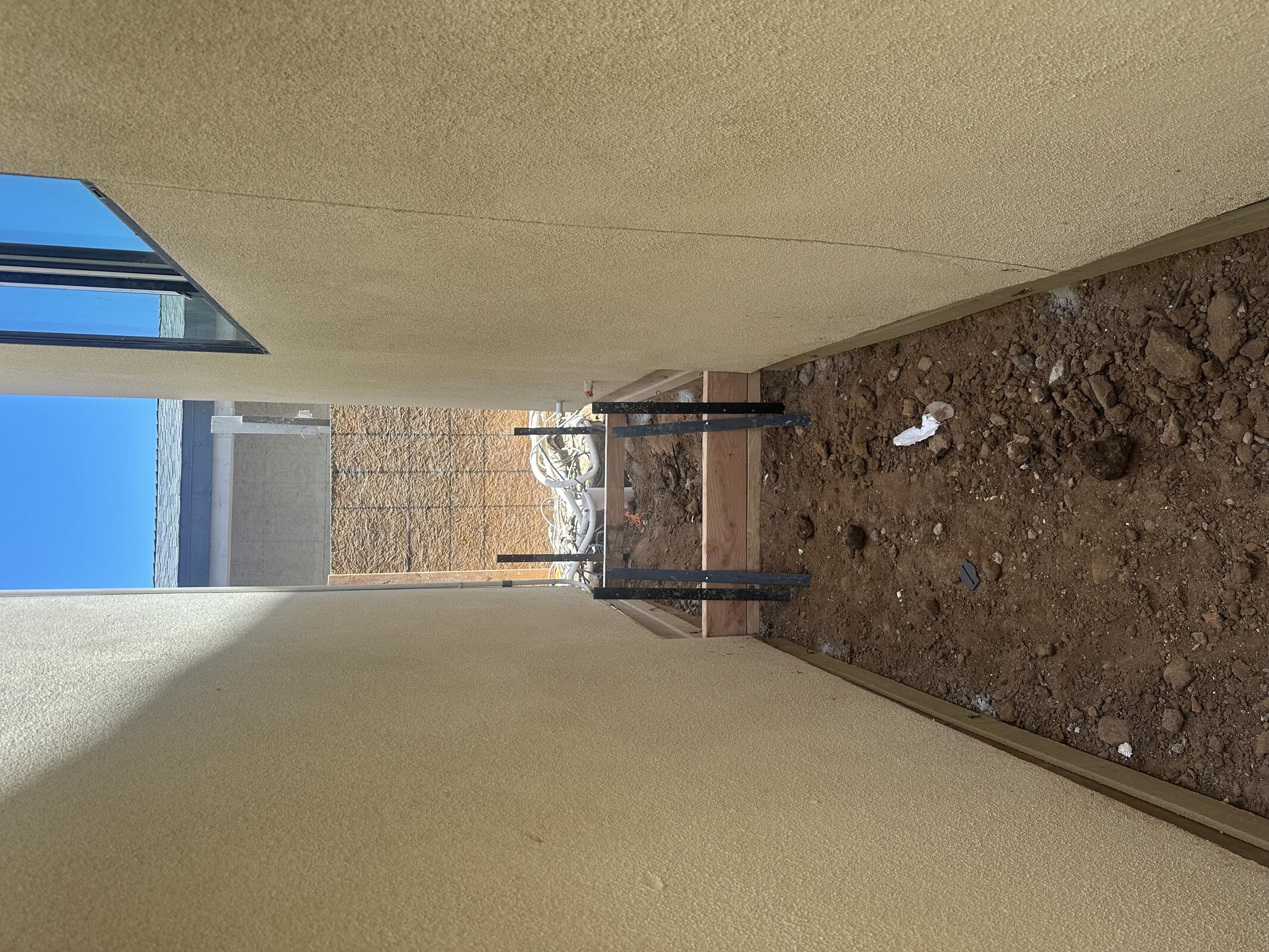

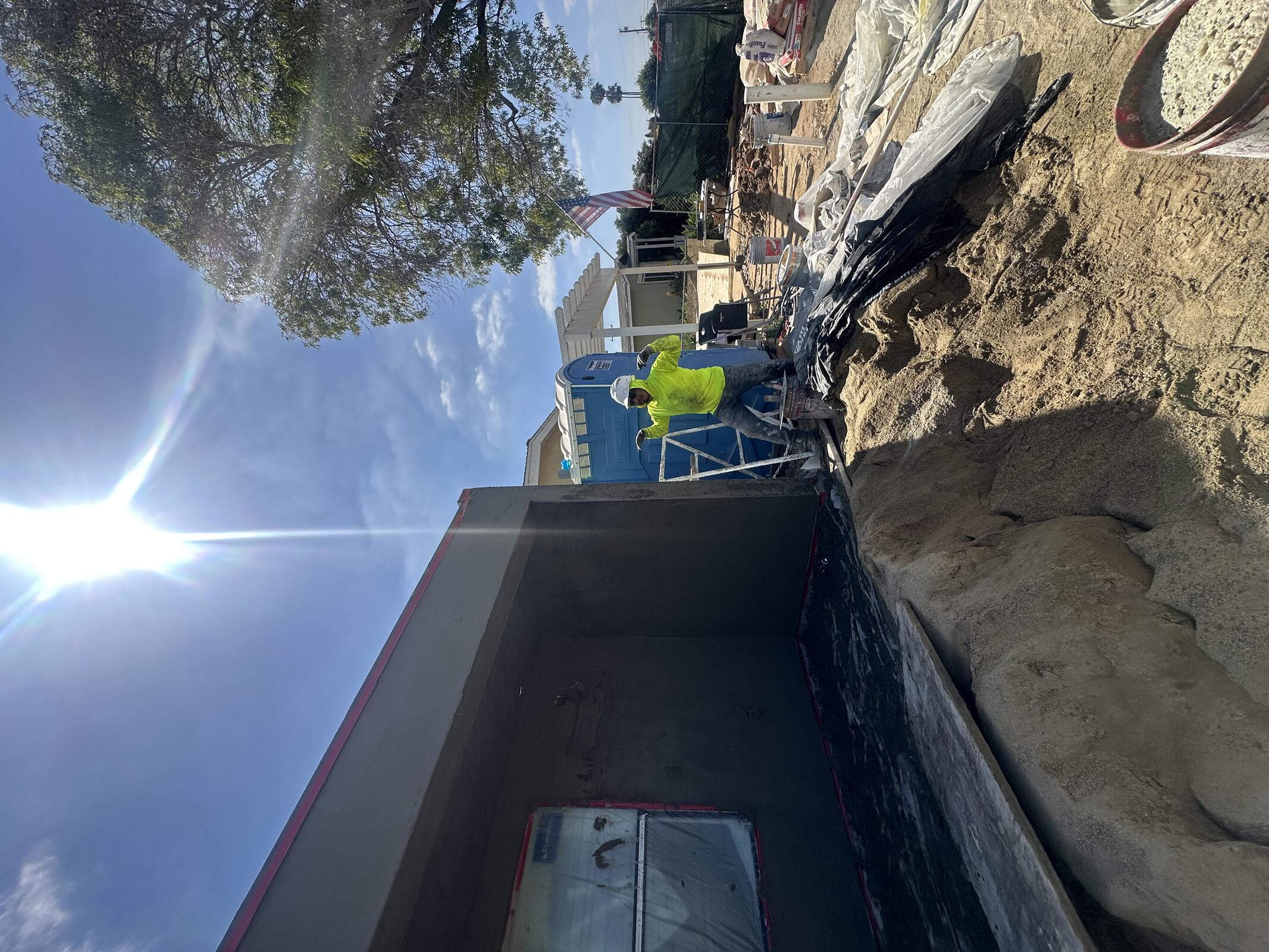

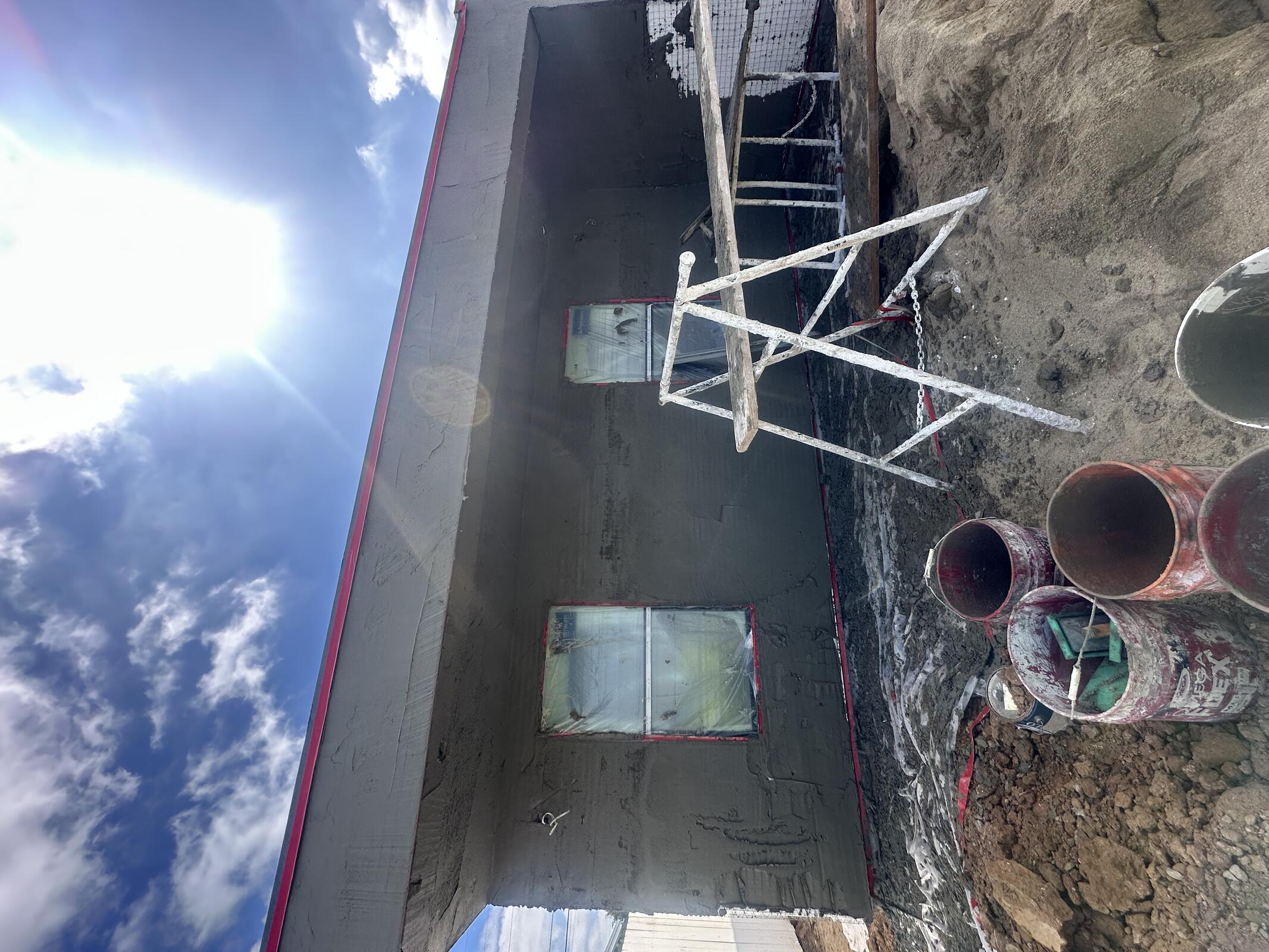

JBG forming site concrete on building C side.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
Marq6848
JBG4832
AC Electric2816
ZSP188

Inspection: N/A

Delay: Pending informal review of electrical plans and SDGE estimated cost / schedule impacts for transformer.
