Week of June 22 — June 26, 2026
5 days on site. 50 photos. Cabinets, Countertops, Electric, Flooring, Paint, Plumbing, Roofing, Site Concrete and Drainage, Solar, Tile.
Monday, June 22, 2026
Clear, 72°F
JBG continuing to move dirt and clean up the jobsite.

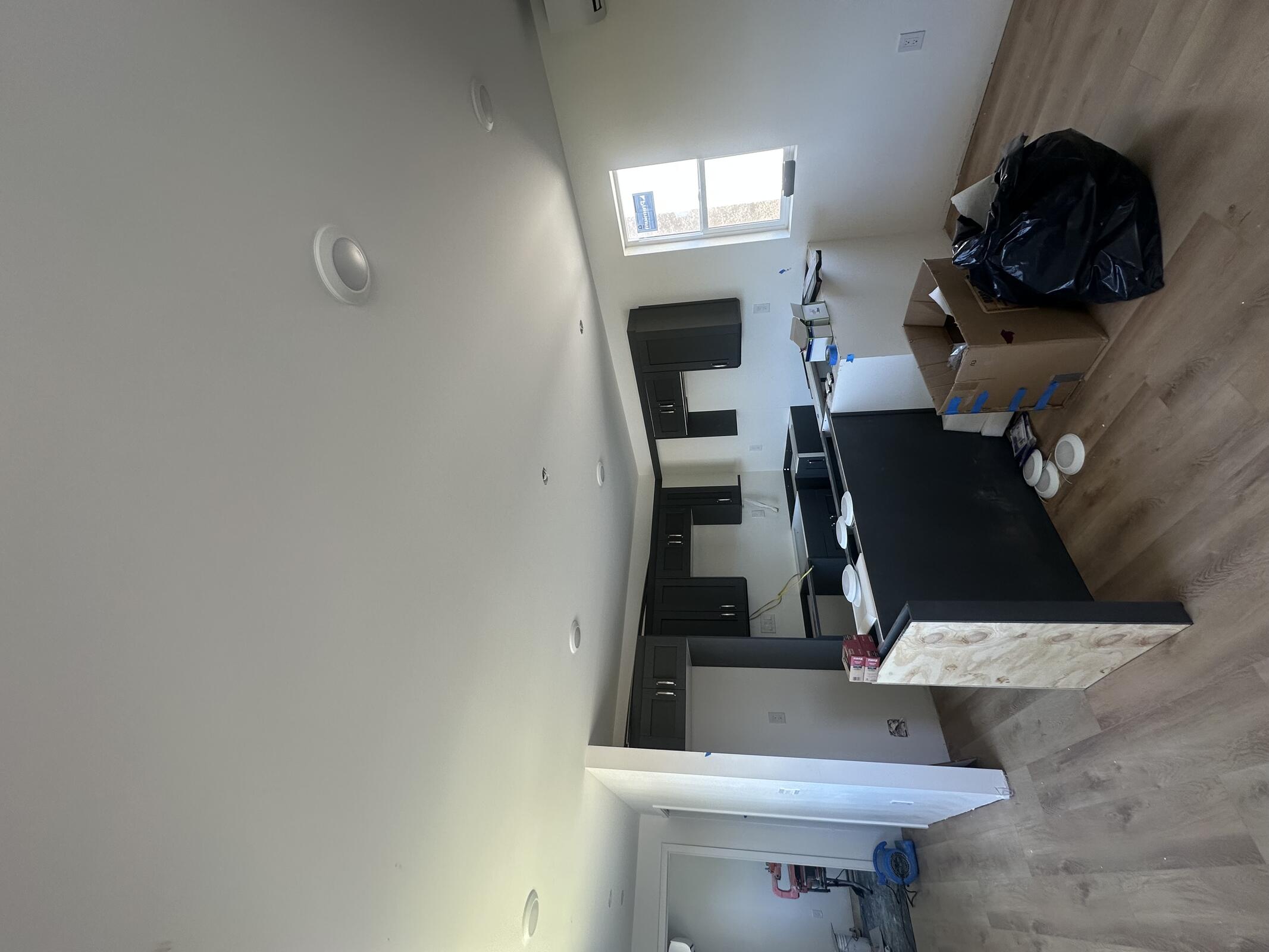

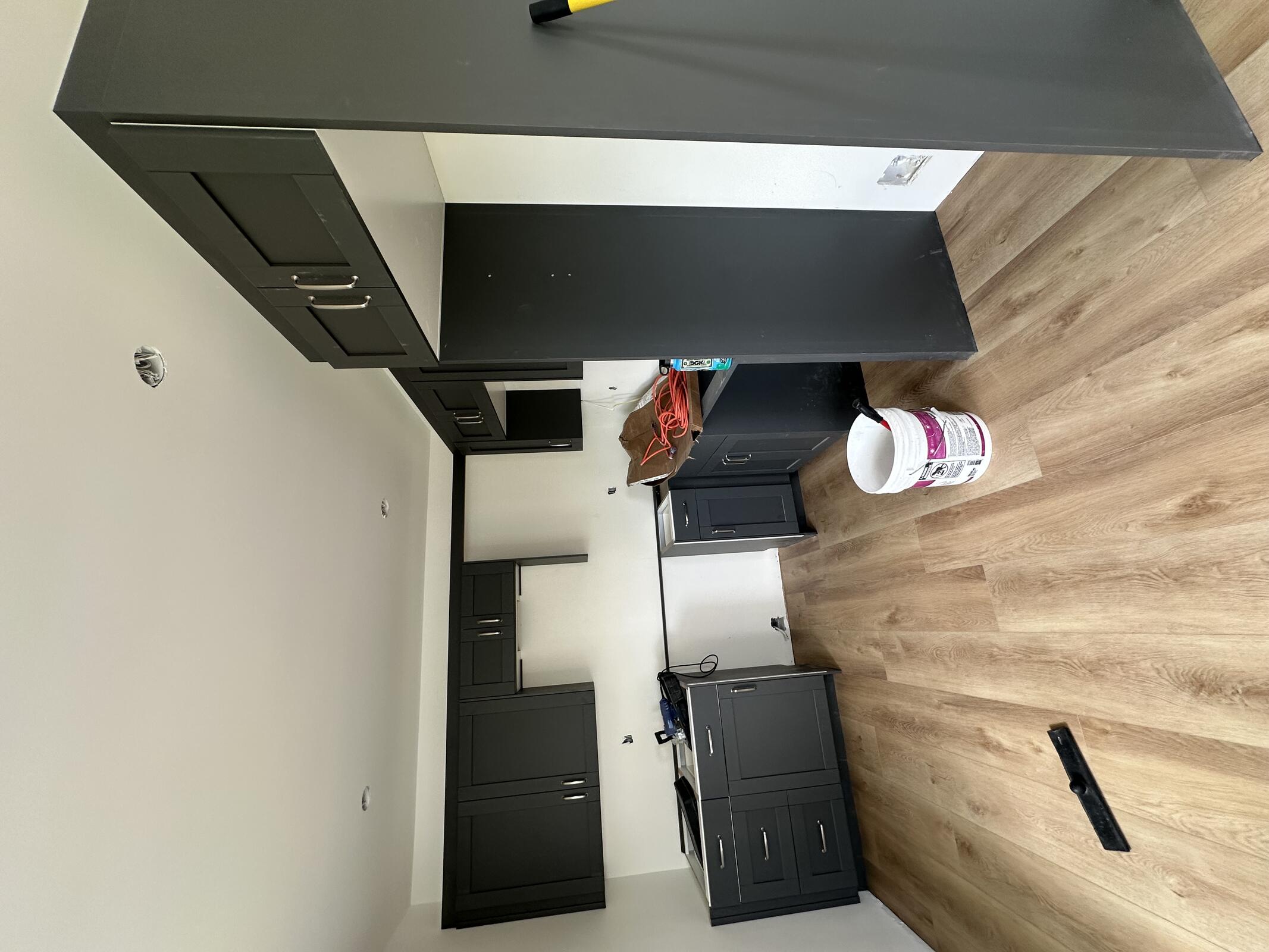

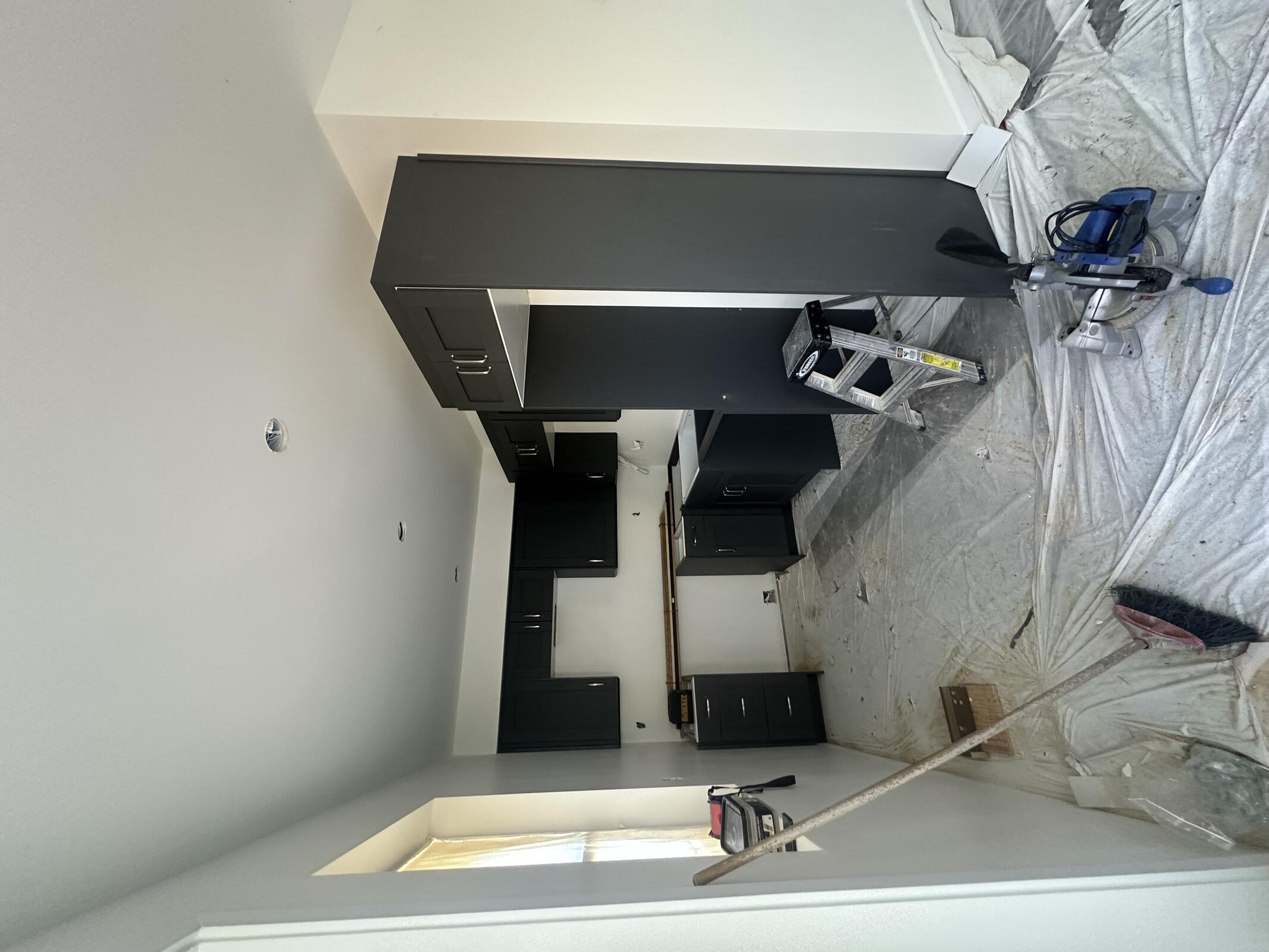

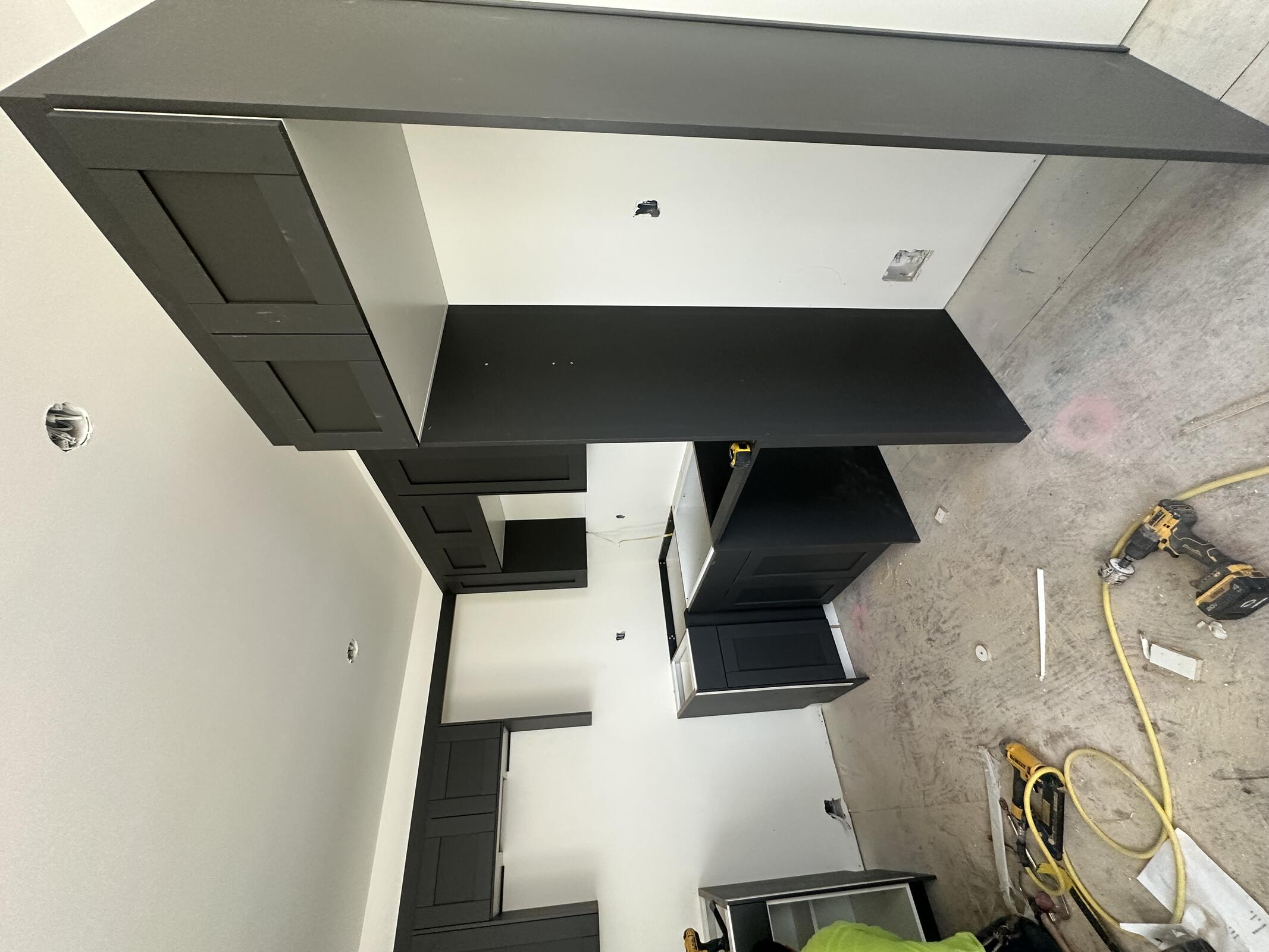

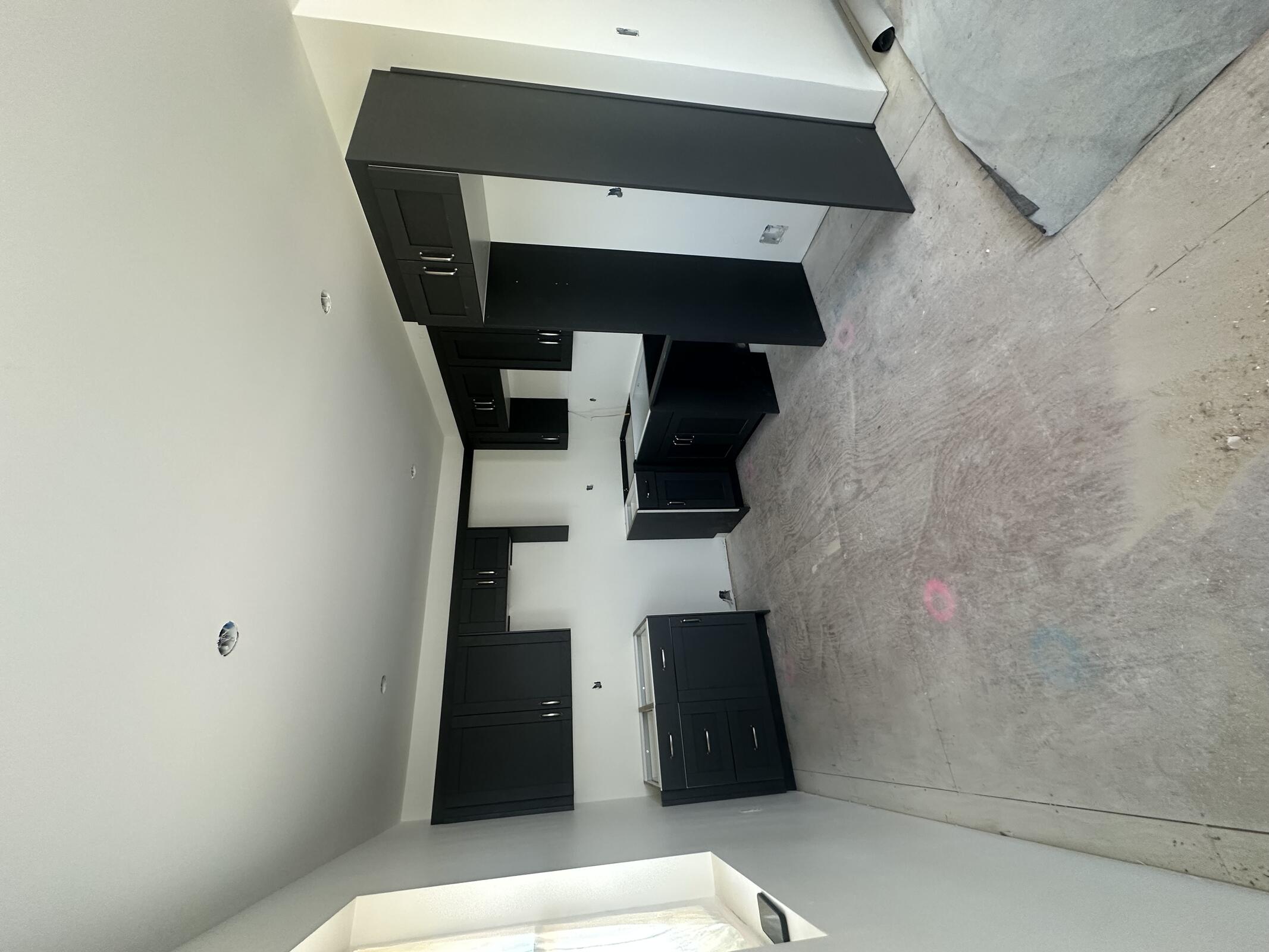

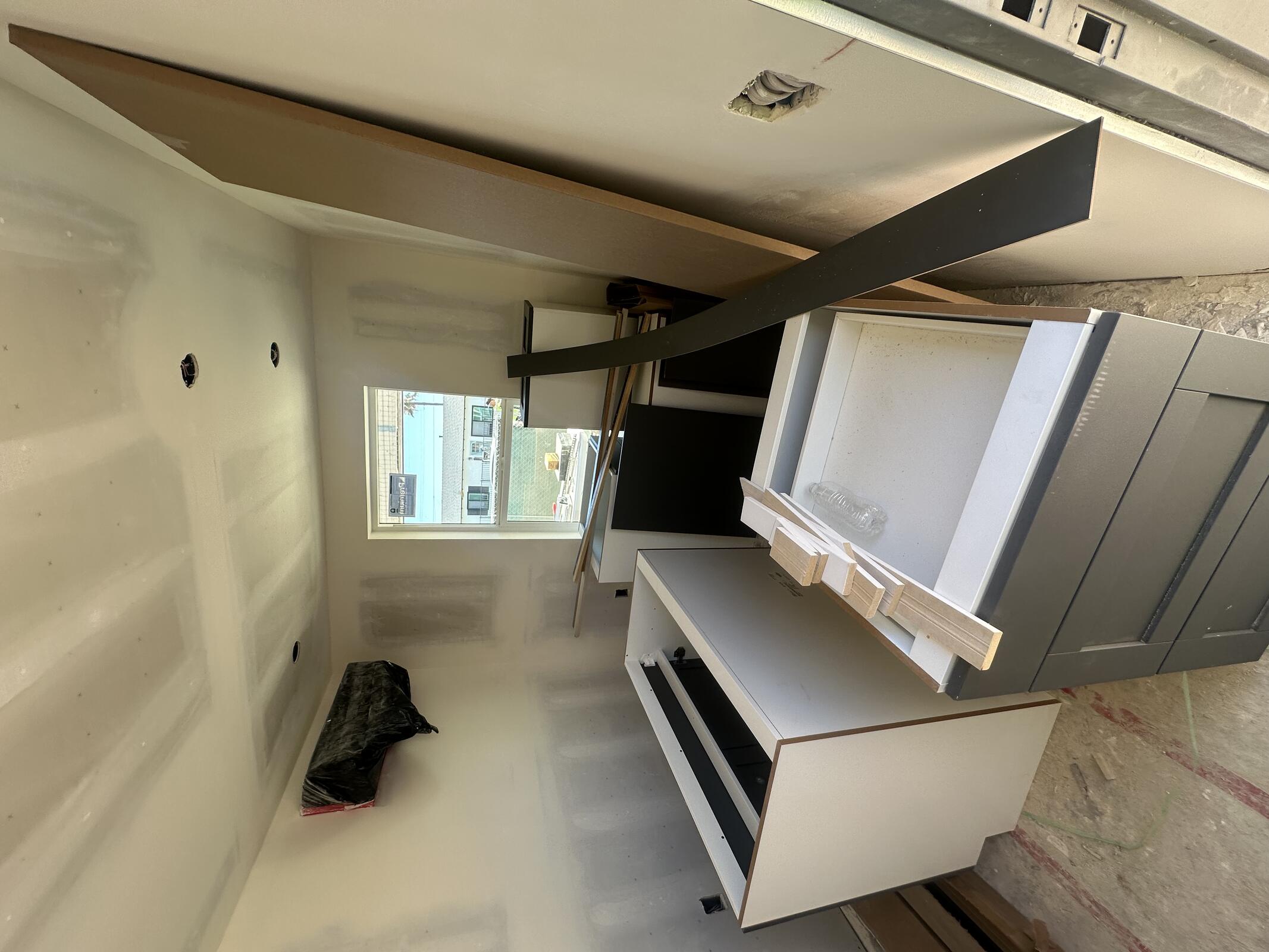

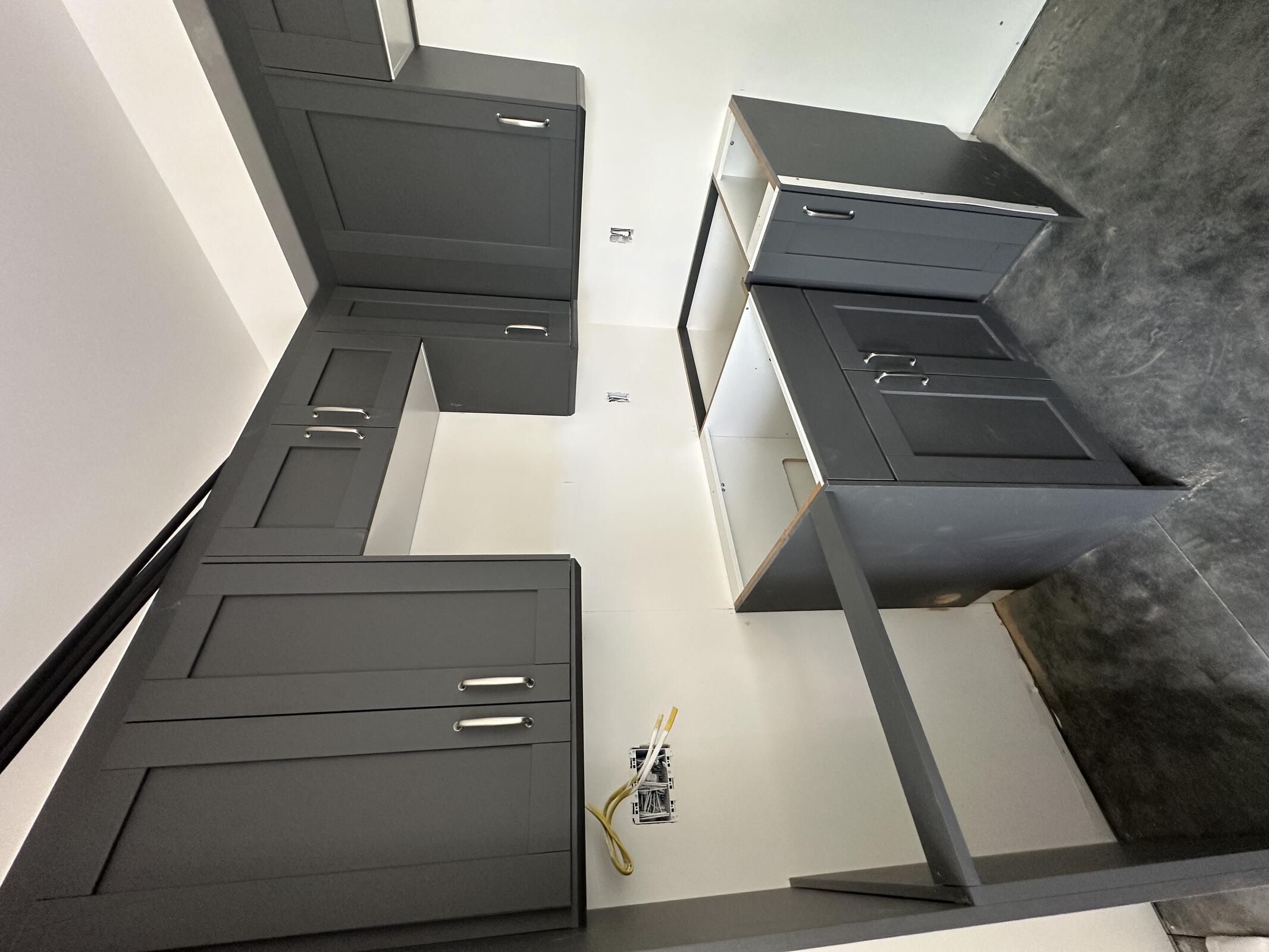

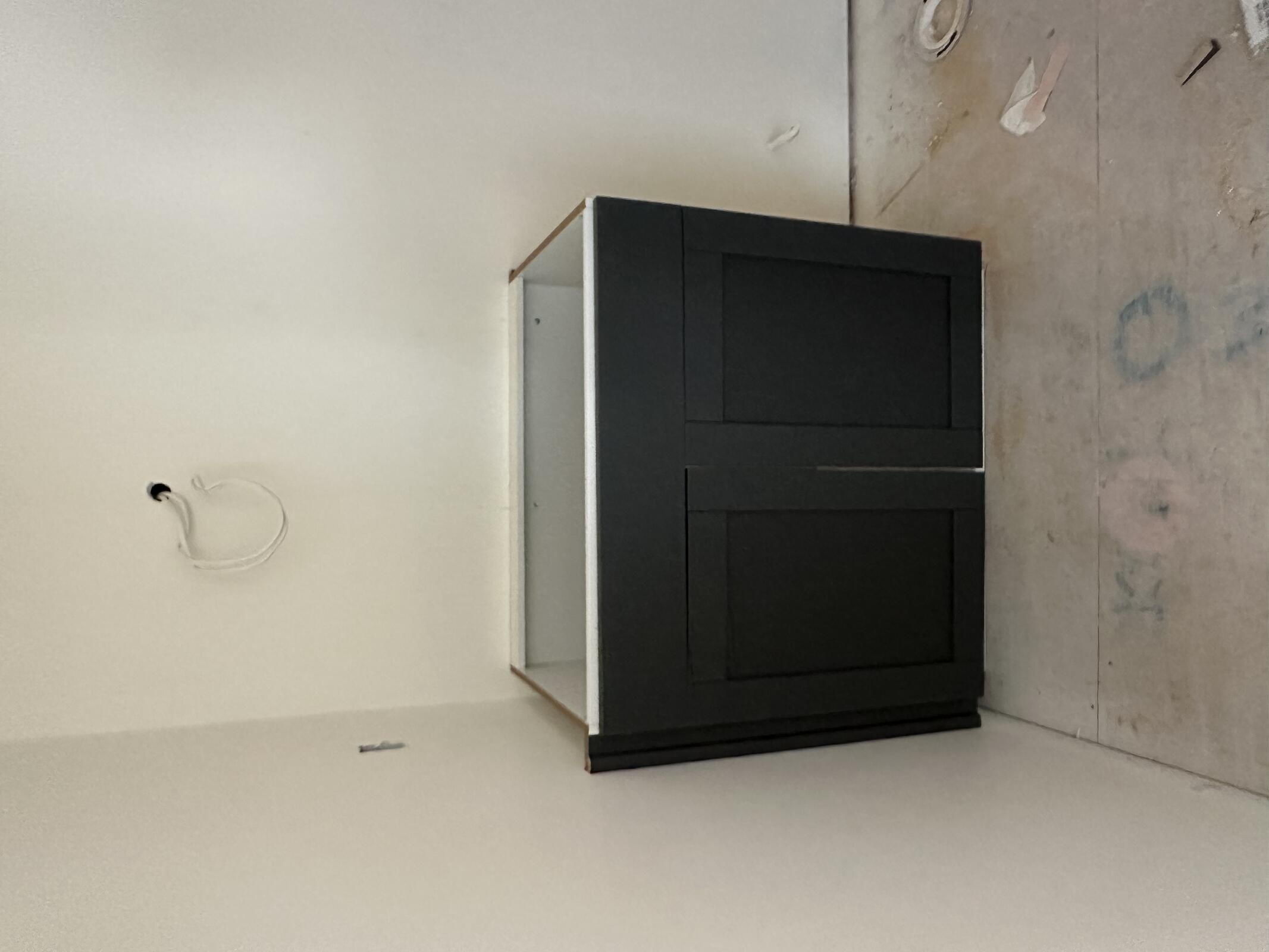

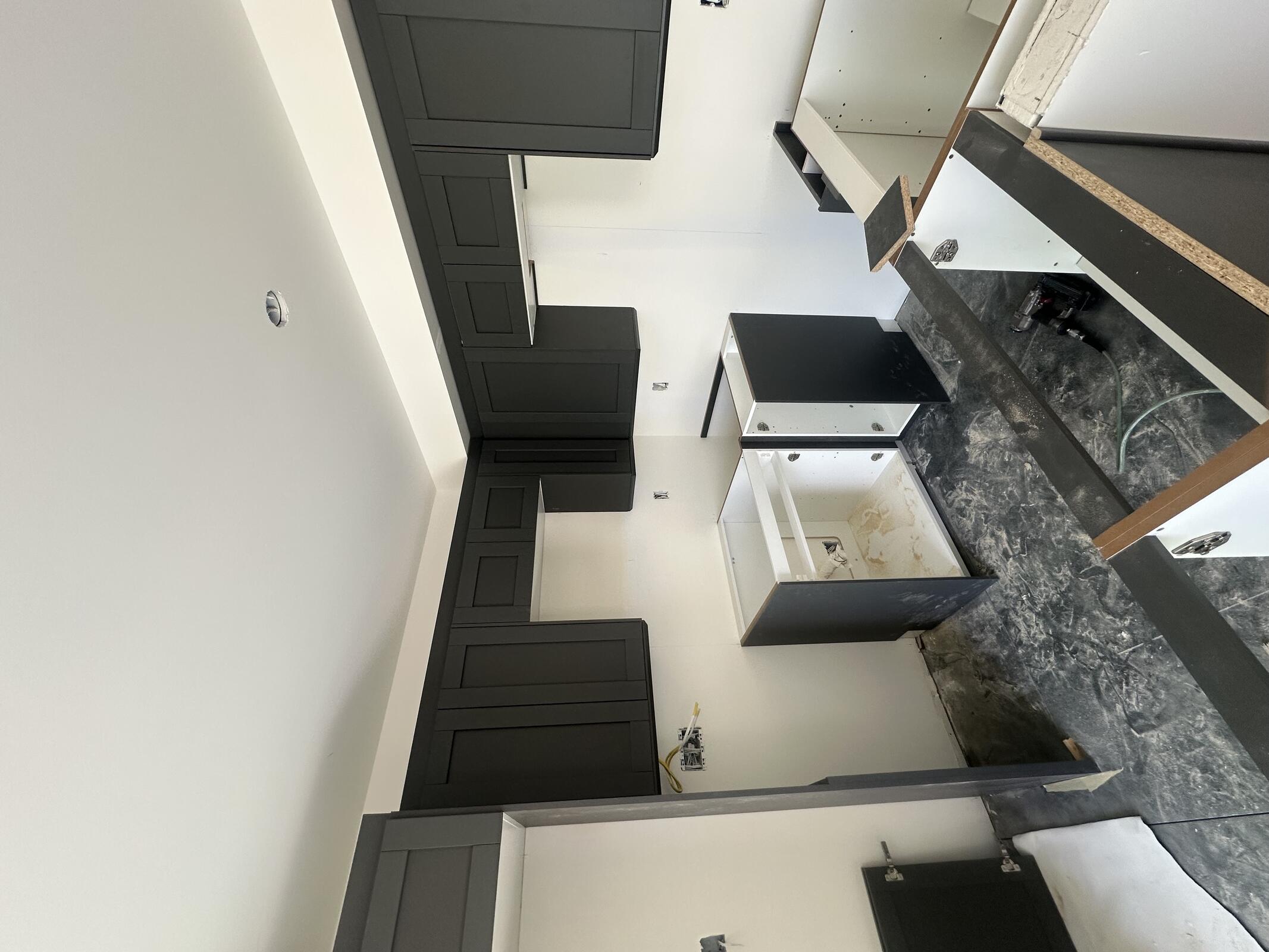

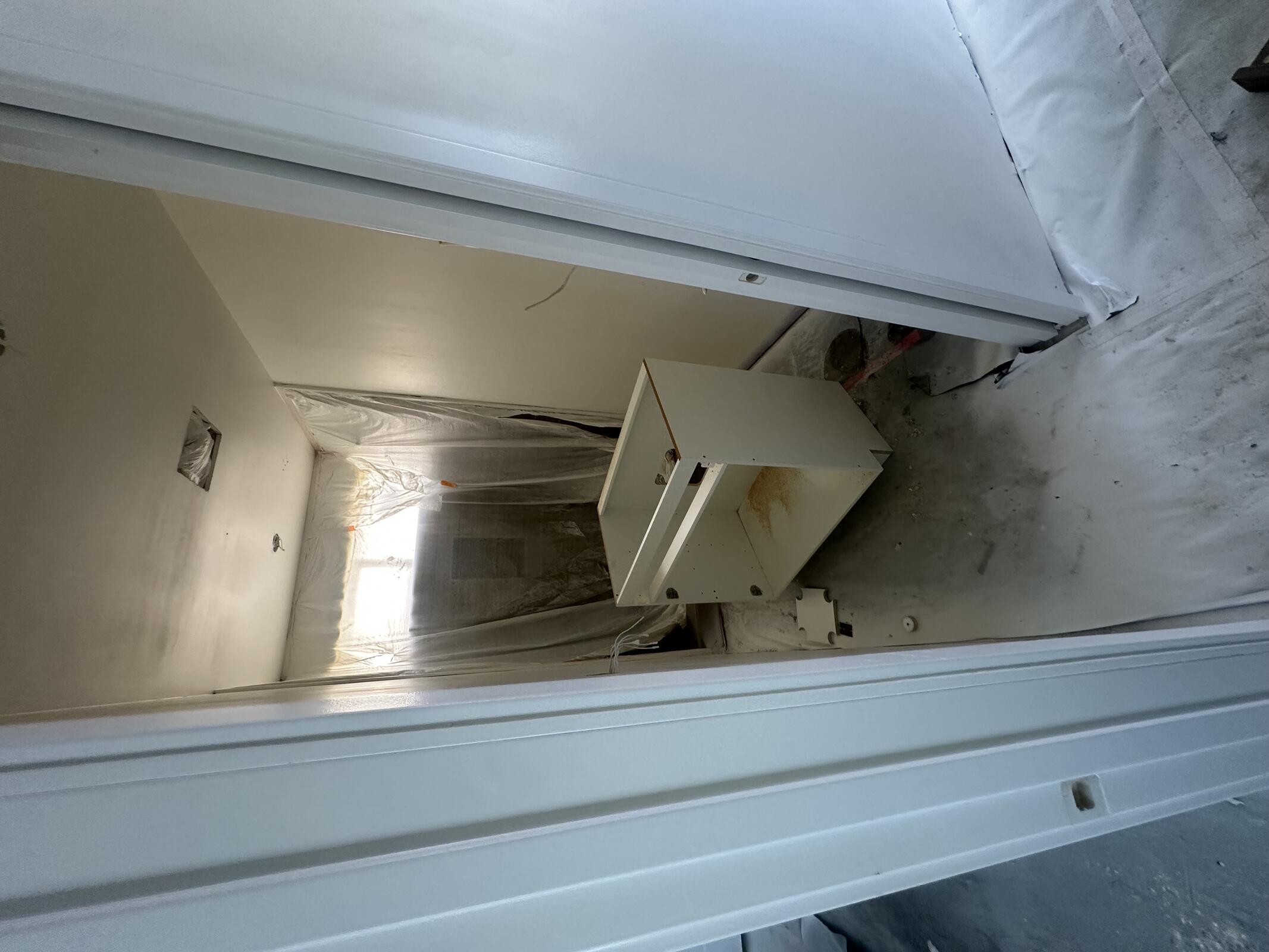

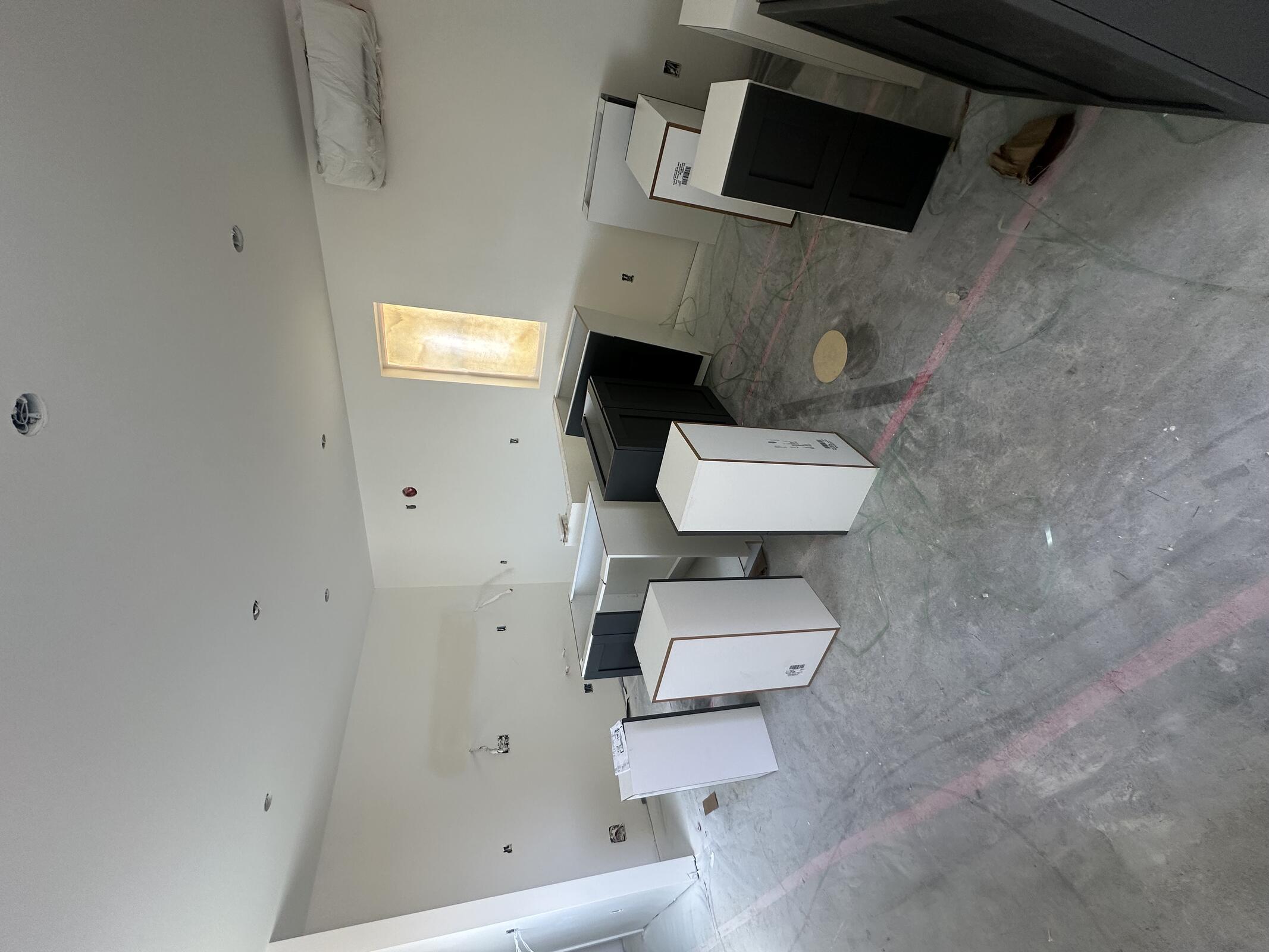

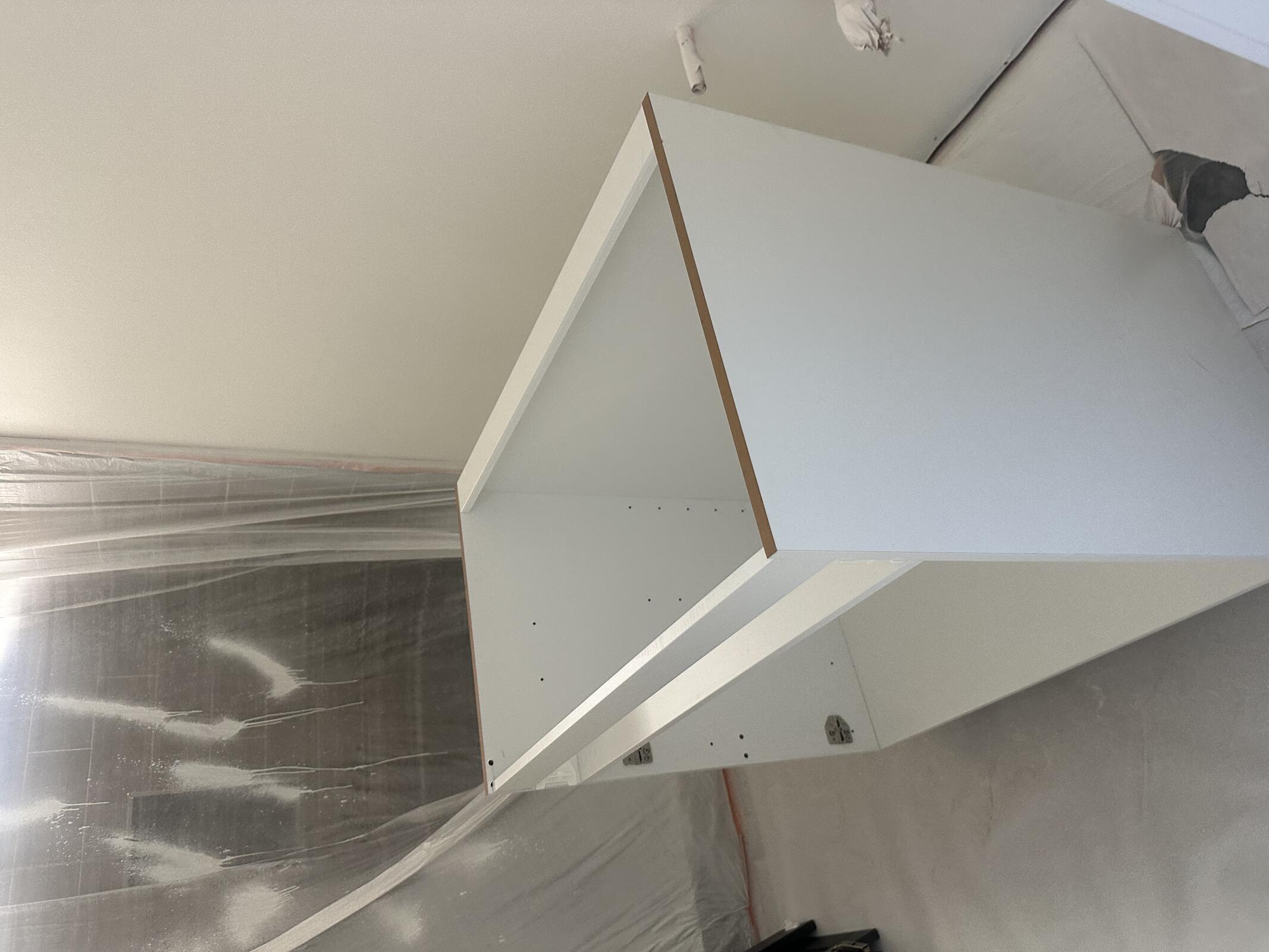

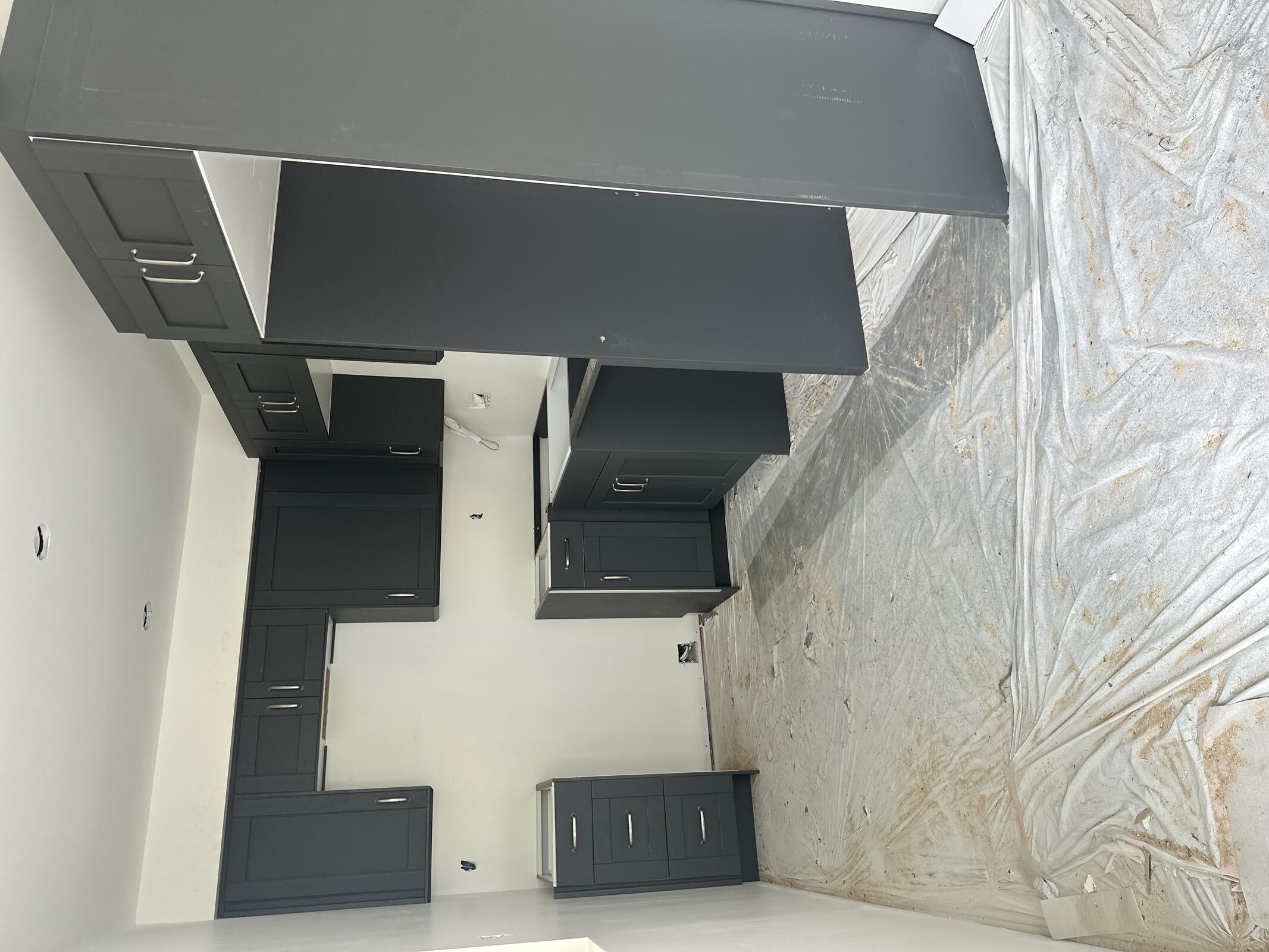

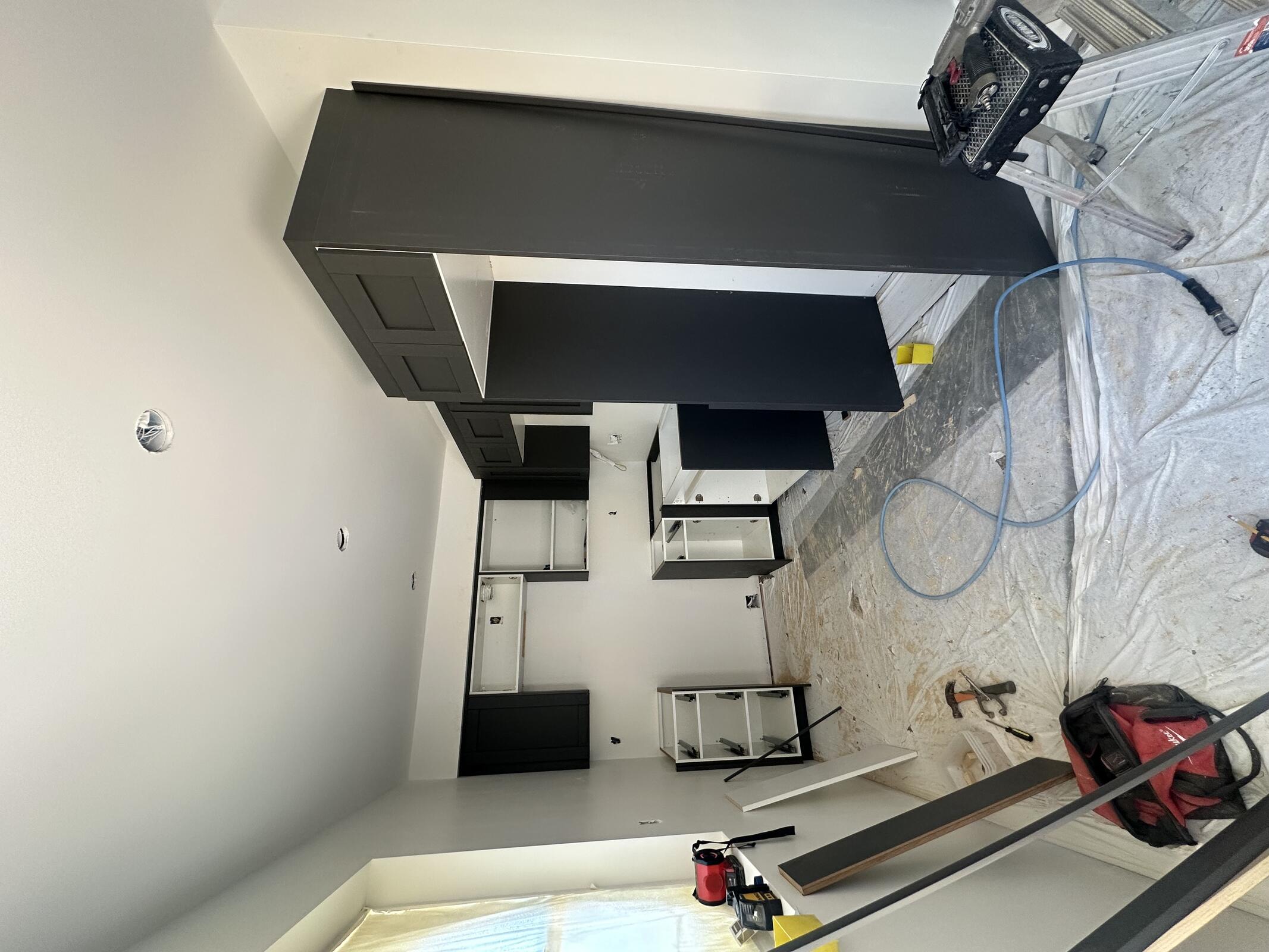

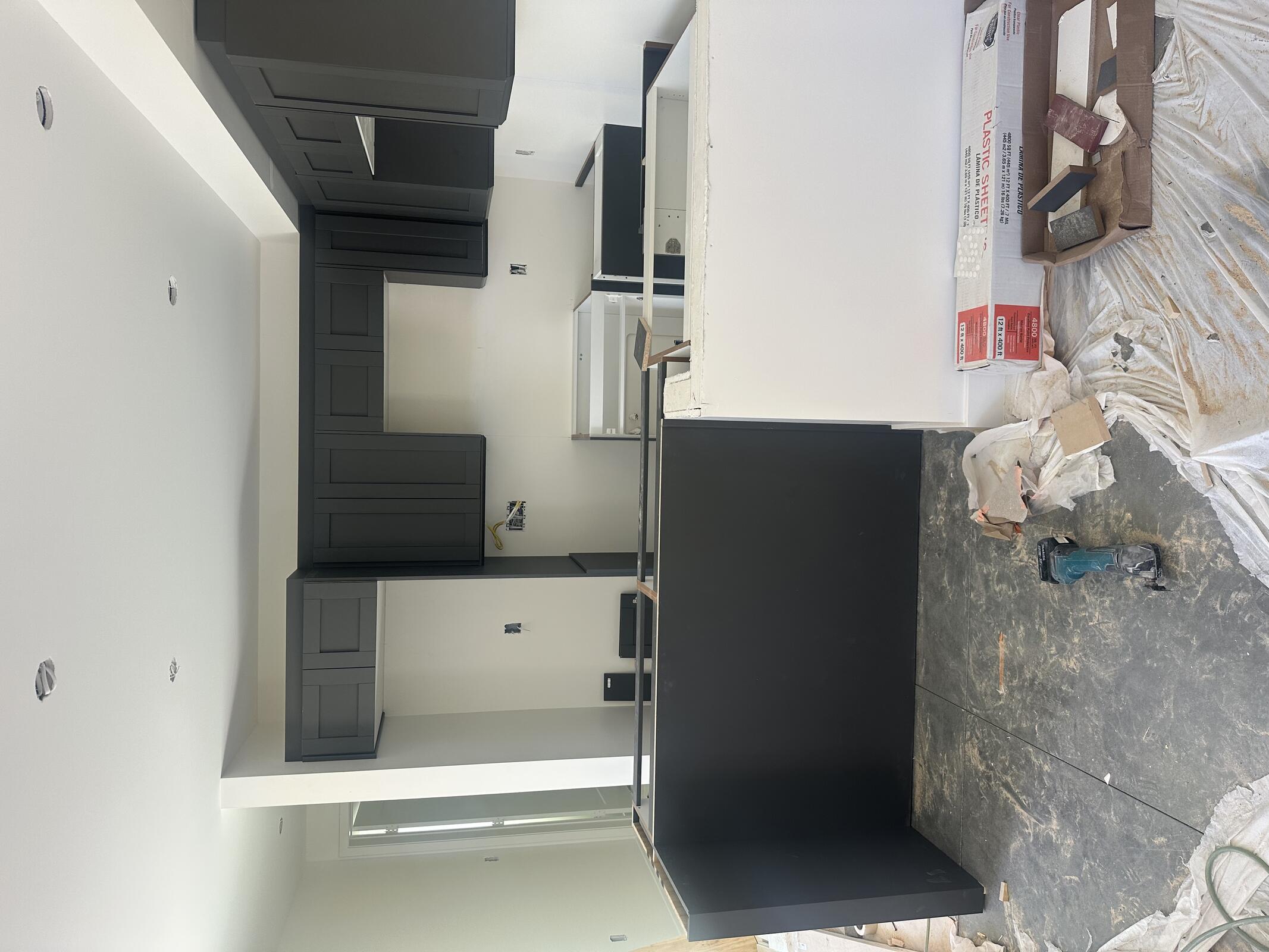

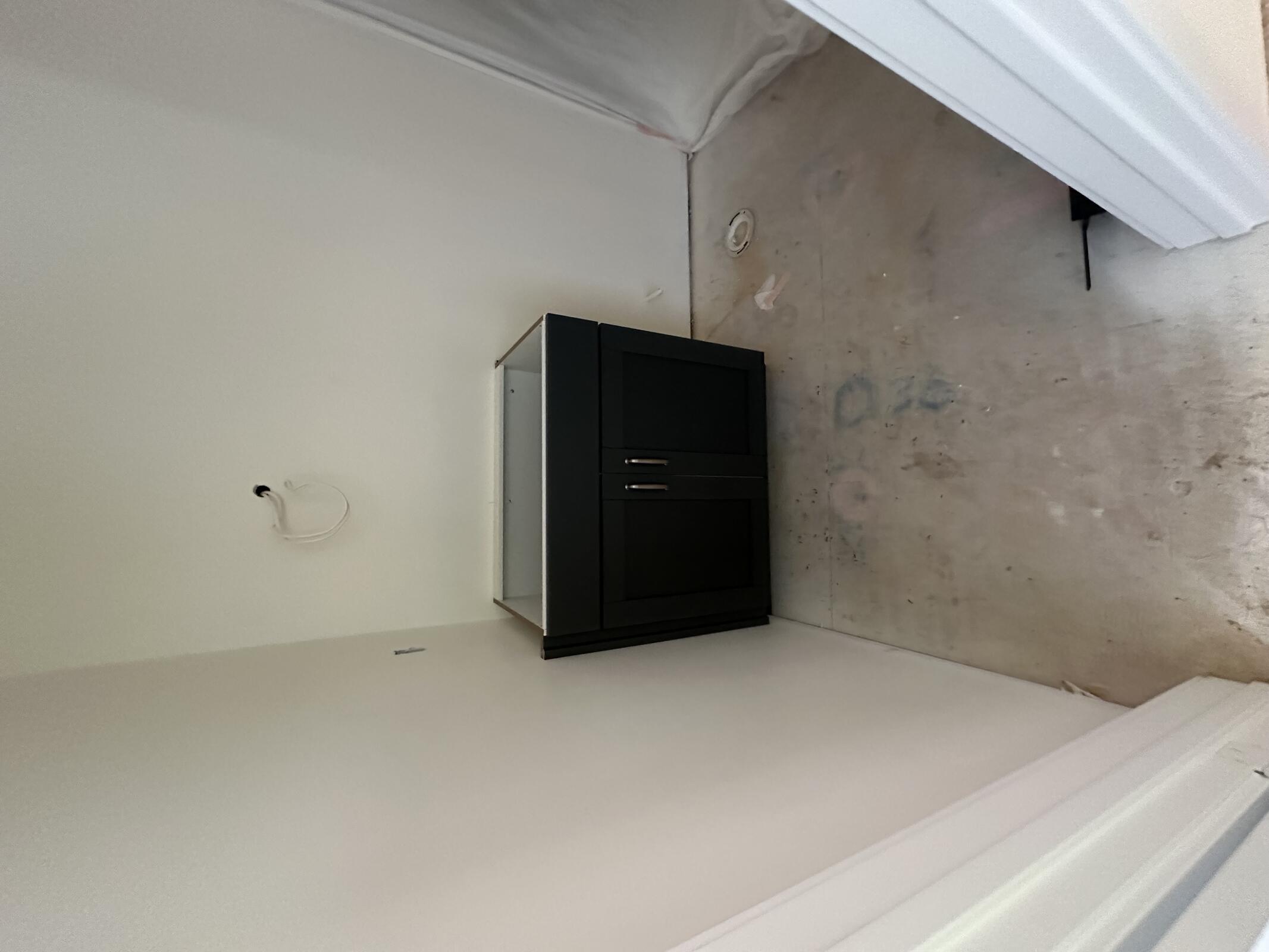

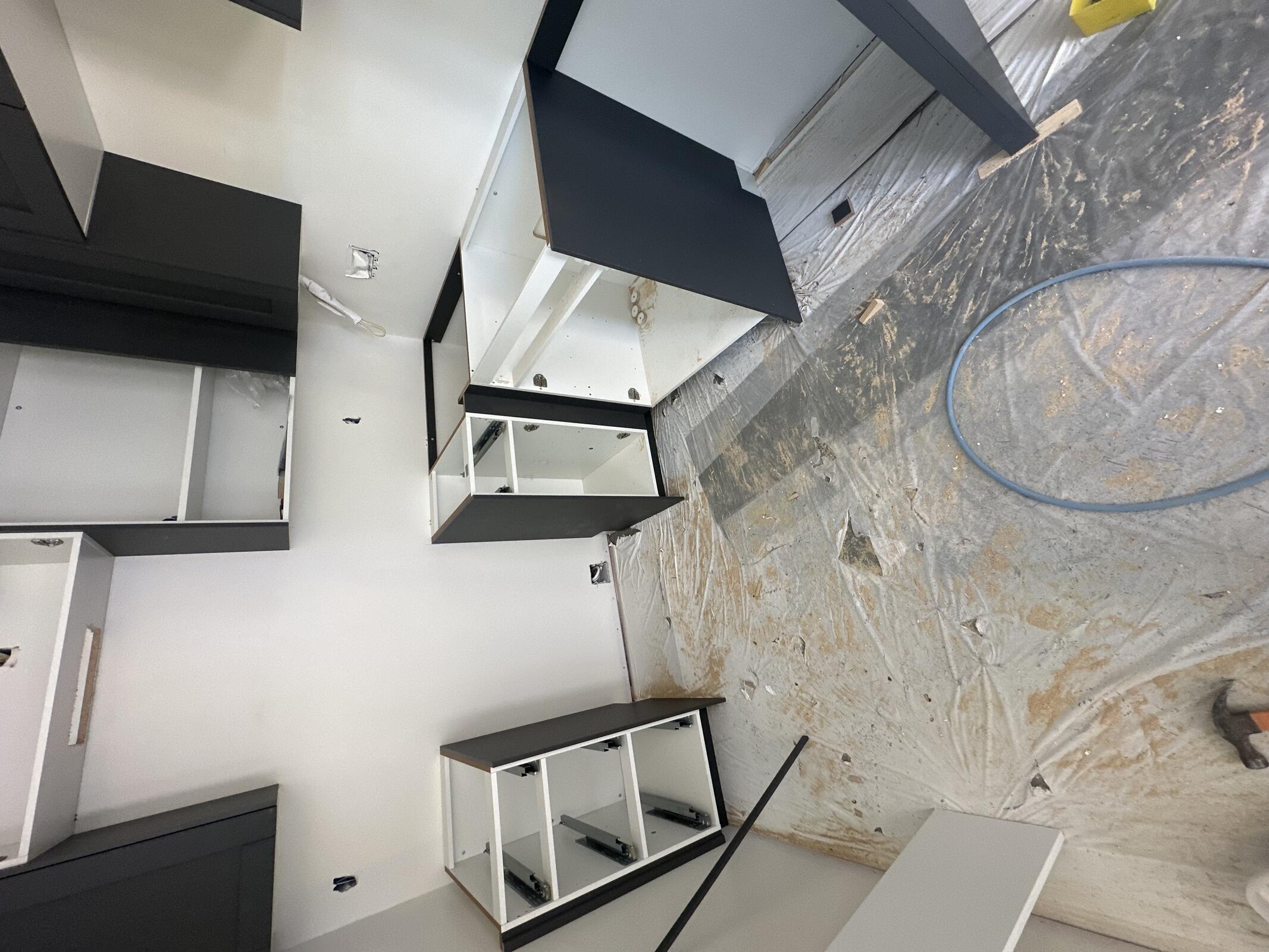

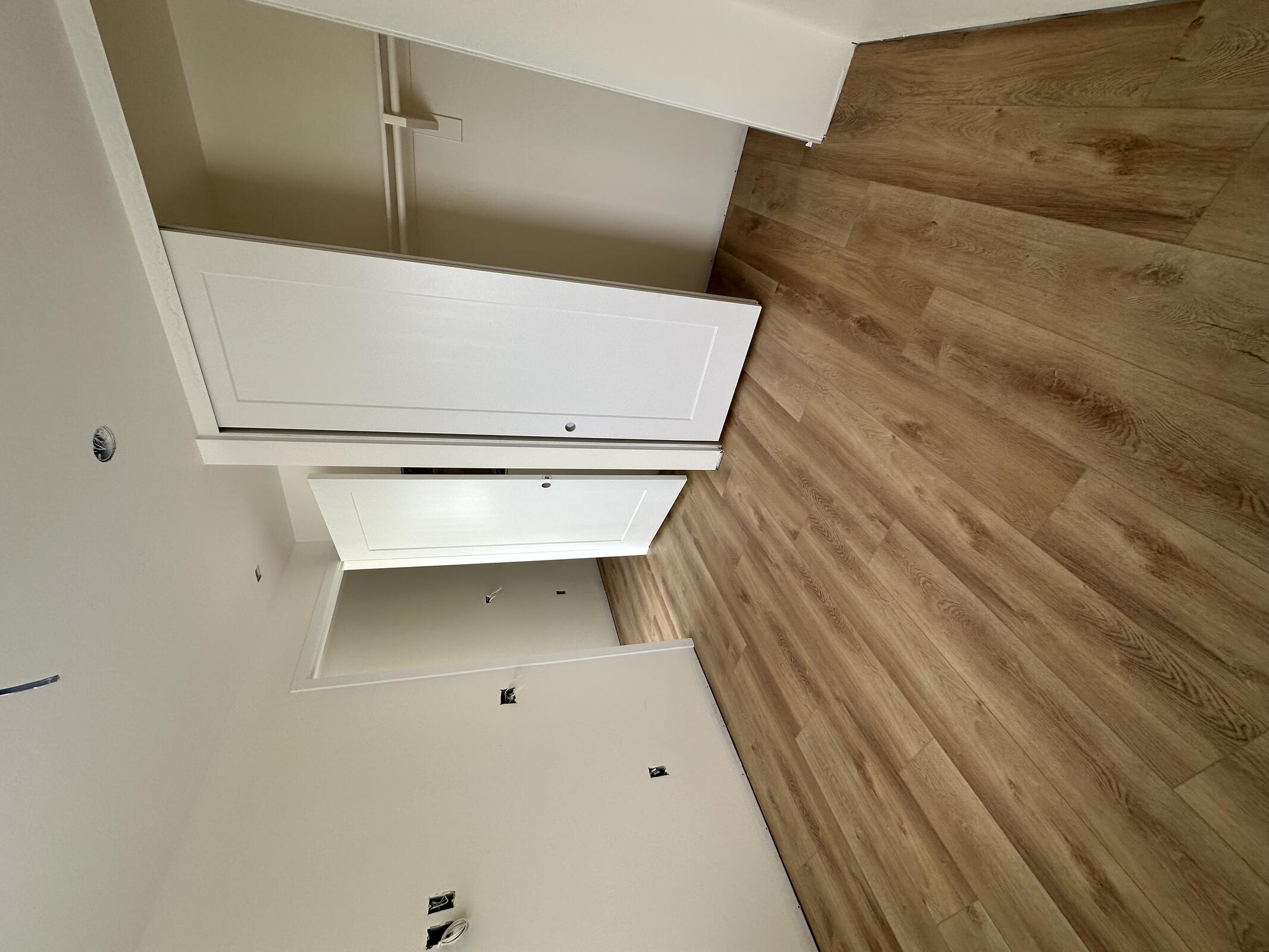

Primera installing cabinets.

Coastal finishing Niche and installing schluter metal at Garage bathroom. Grout tomorrow.
Taylor Trim installing doors at garage and bifolds at Unit B.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| Coastal | 1 | 8 | 8 |
| JBG | 3 | 8 | 24 |
| Primera | 3 | 8 | 24 |
| Taylor Trim | 1 | 4 | 4 |
Inspection: N/A
Delay: Pending response form Gino ( DSD)

Tuesday, June 23, 2026
Partially cloudy, 72°F

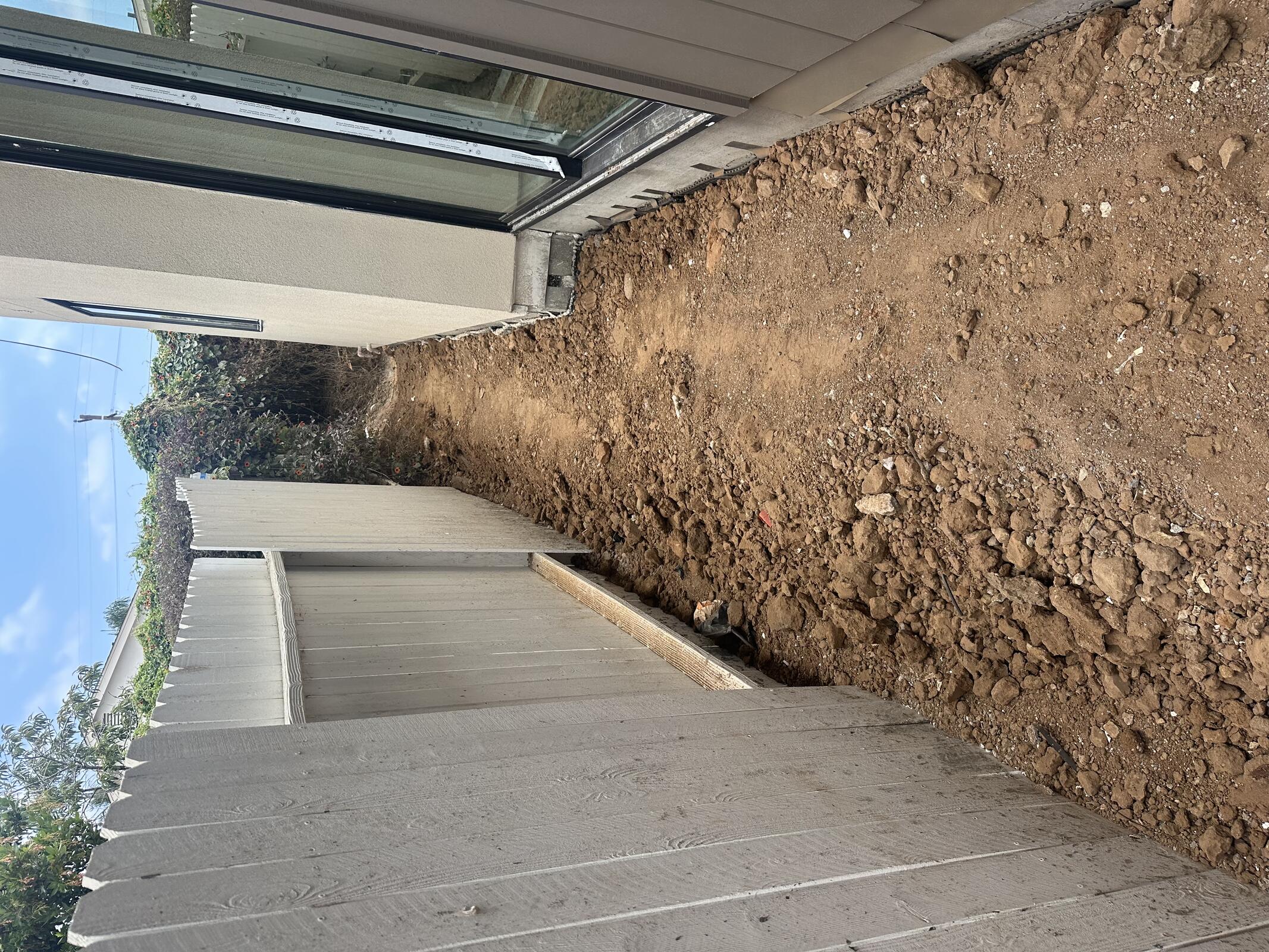

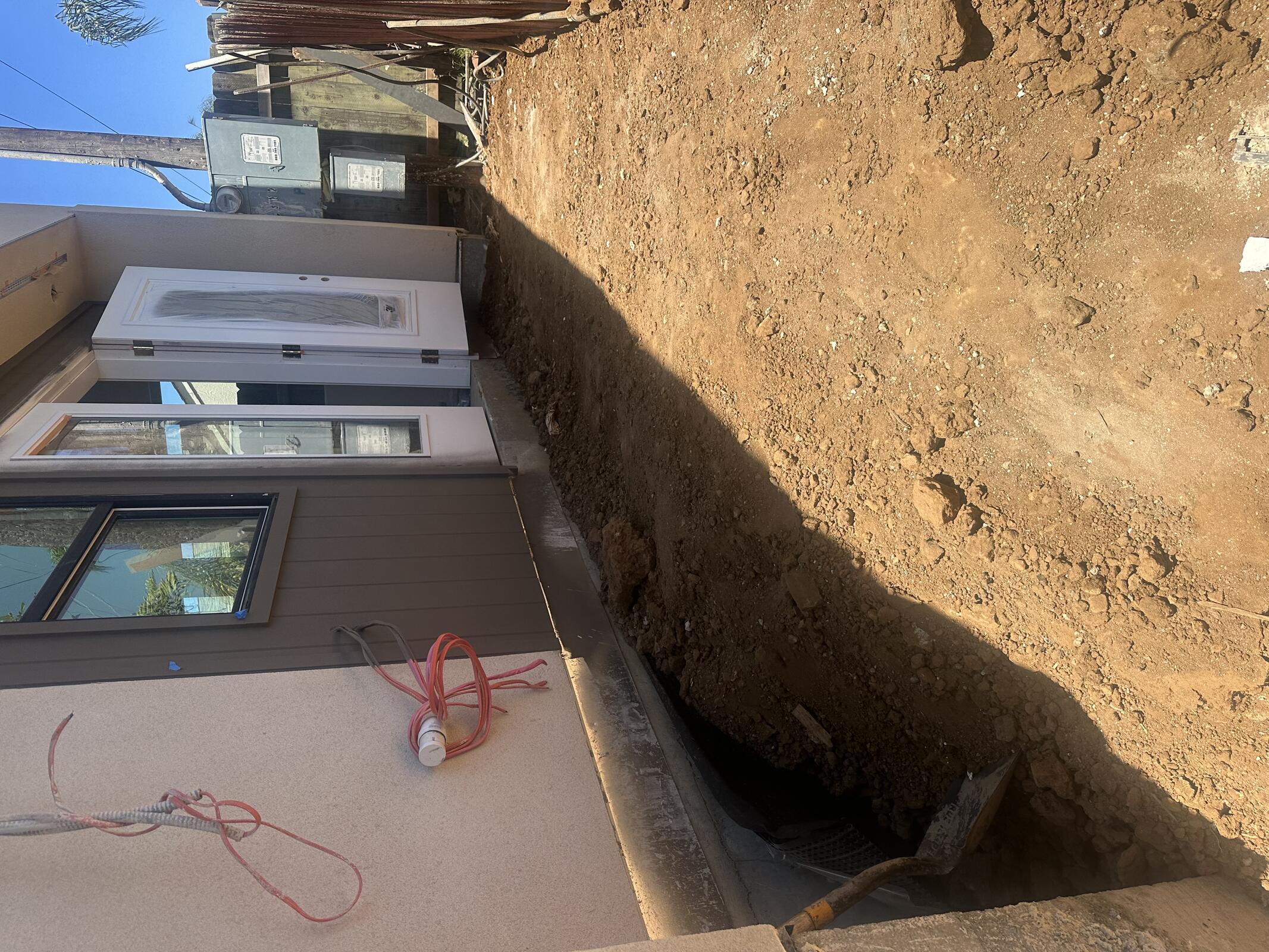

JBG moving dirt and prepping drainage elevations.
ZSP adjusting gas line for roofers.

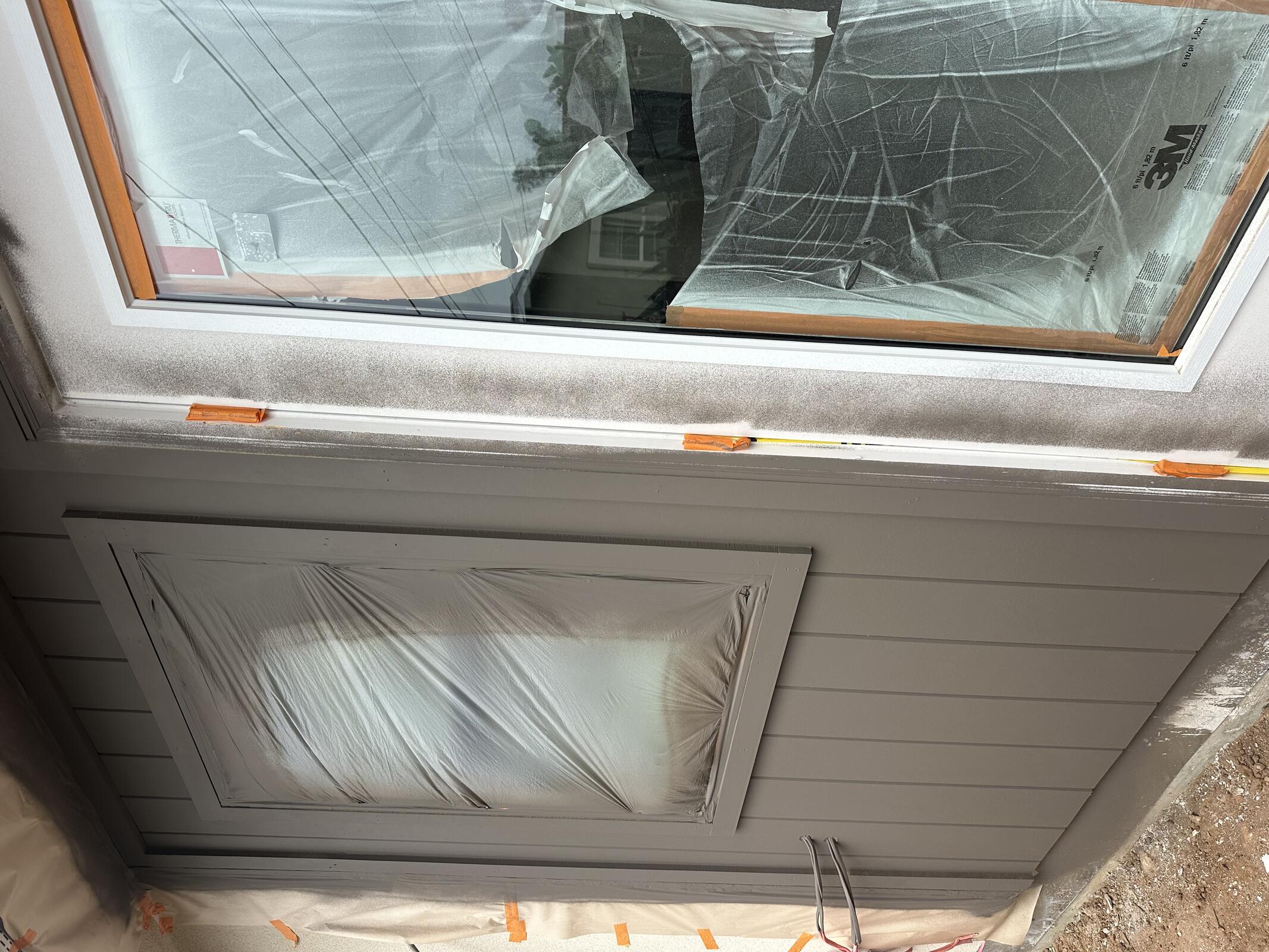

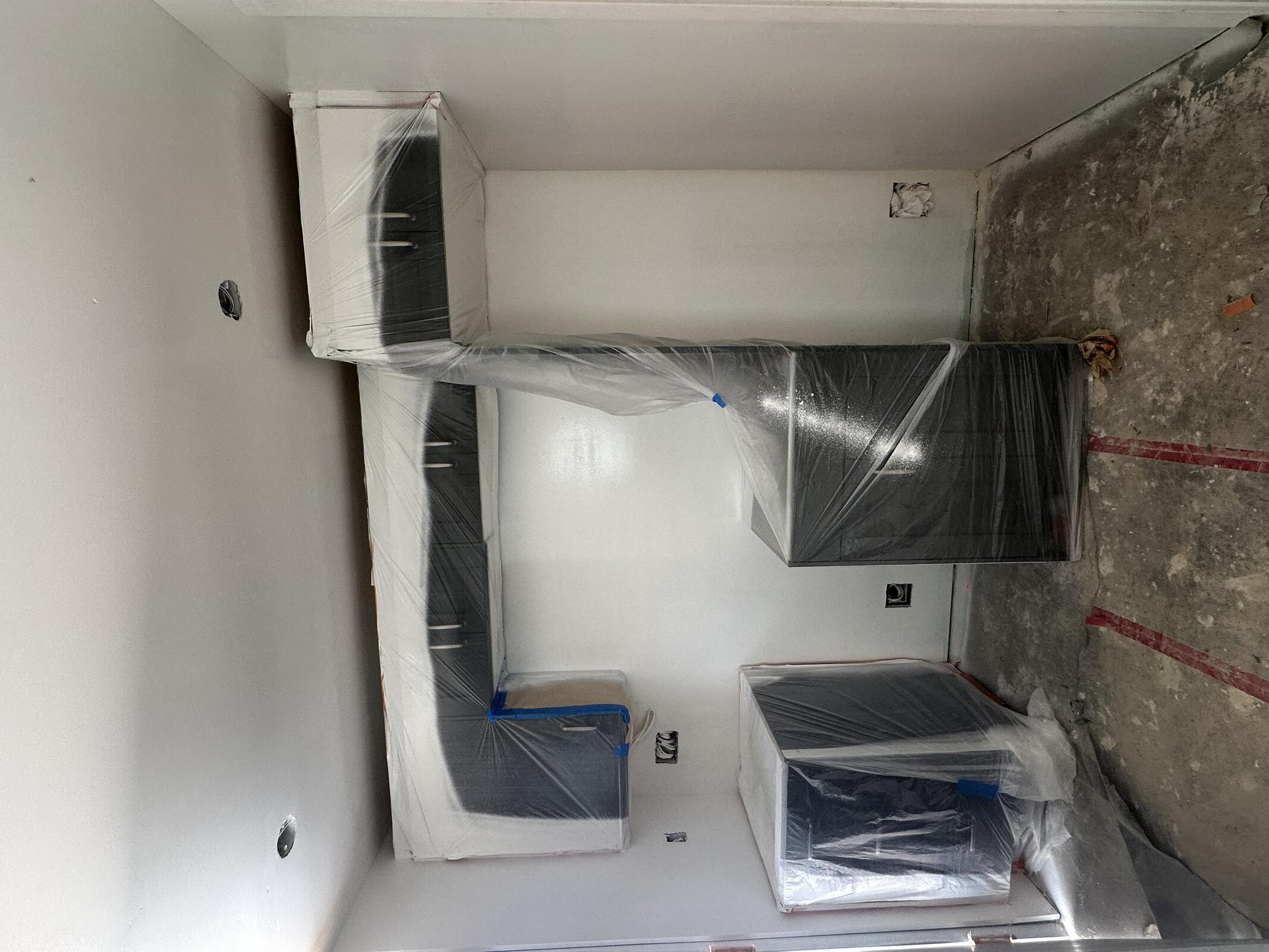

Painters Unlimited painting siding and garage interior.

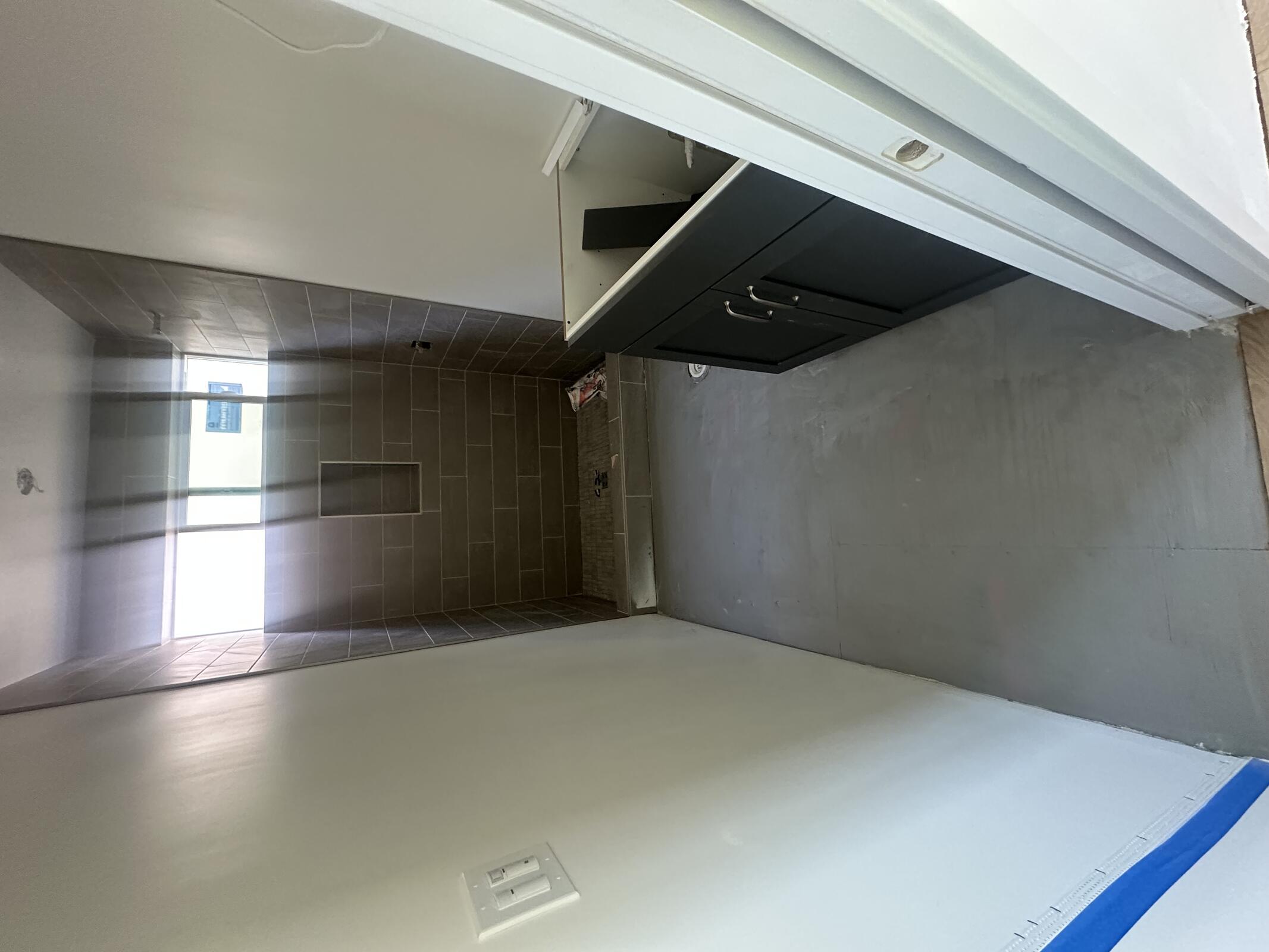

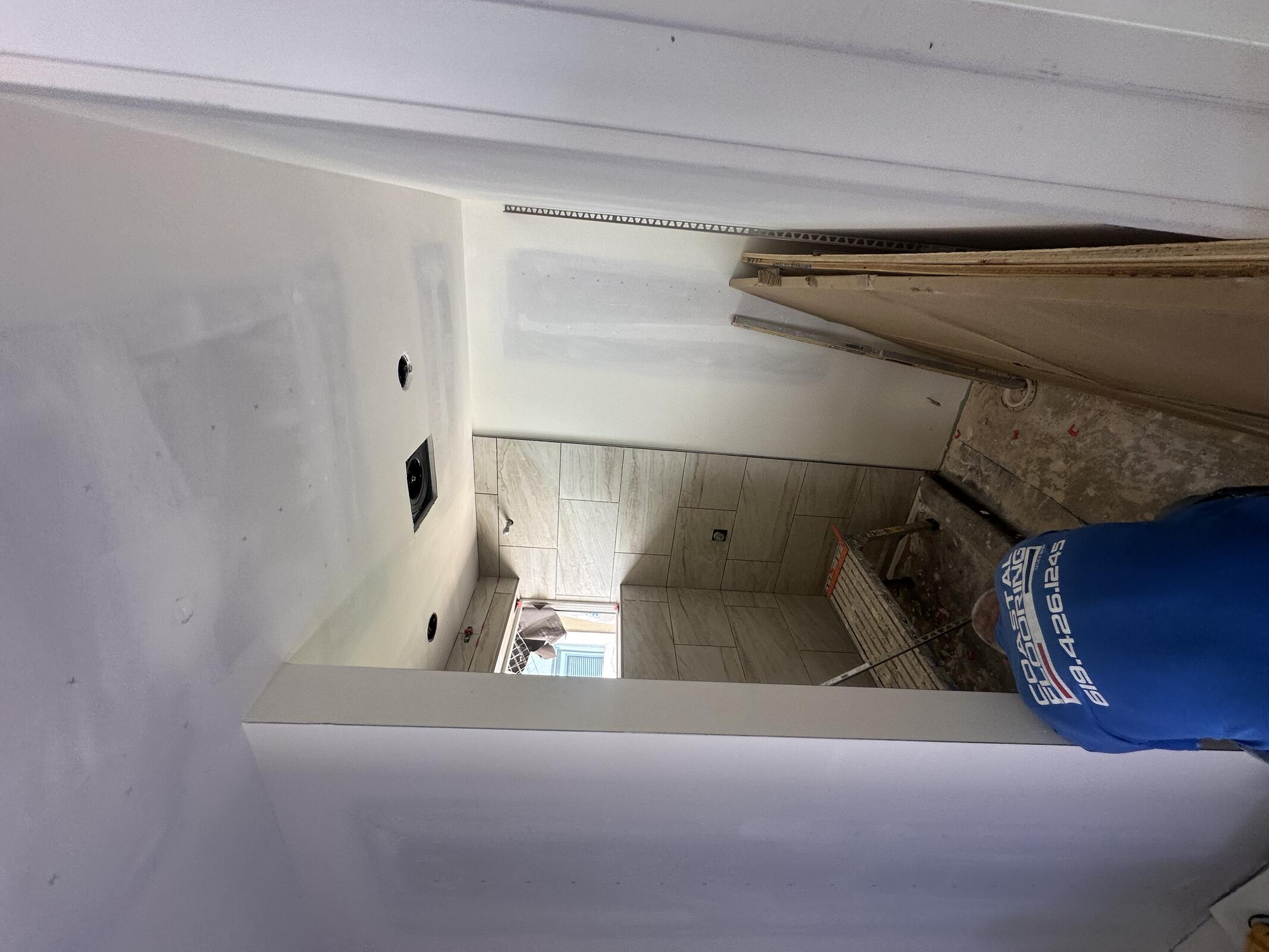

Coastal installing LVP at B2, C2, and D. Grouting garage shower.
Primera on site doing QC checks.
Sunline installing wall equipment on Building C. Solar panels delivered at 11:05 AM.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| JBG | 5 | 8 | 40 |
| ZSP | 2 | 8 | 16 |
| Painters Unlimited | 4 | 8 | 32 |
| Coastal - Flooring Crew | 7 | 4 | 28 |
| Coastal - Tiler | 1 | 6 | 6 |
| Primera | 2 | 4 | 8 |
Inspection: N/A

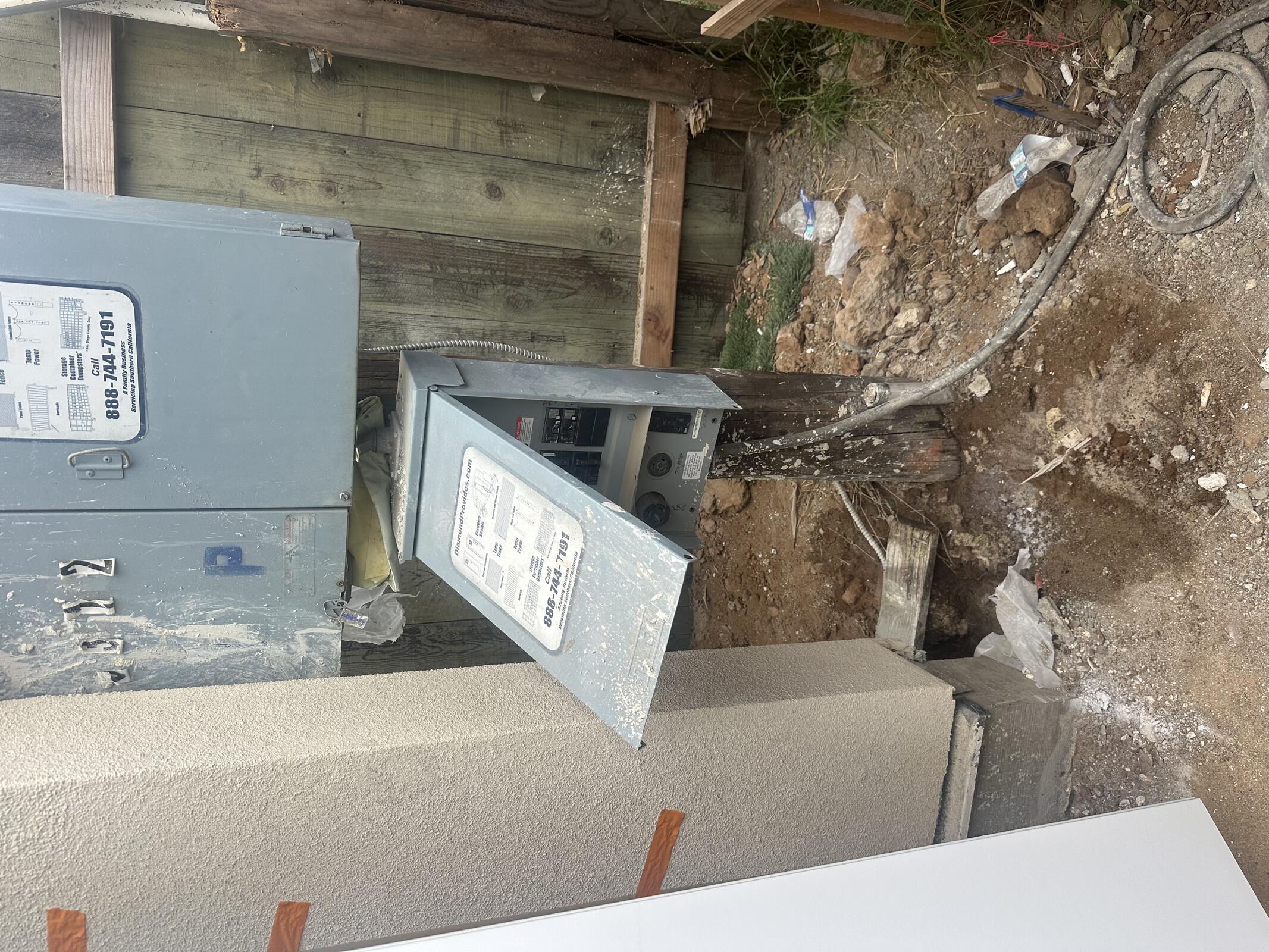

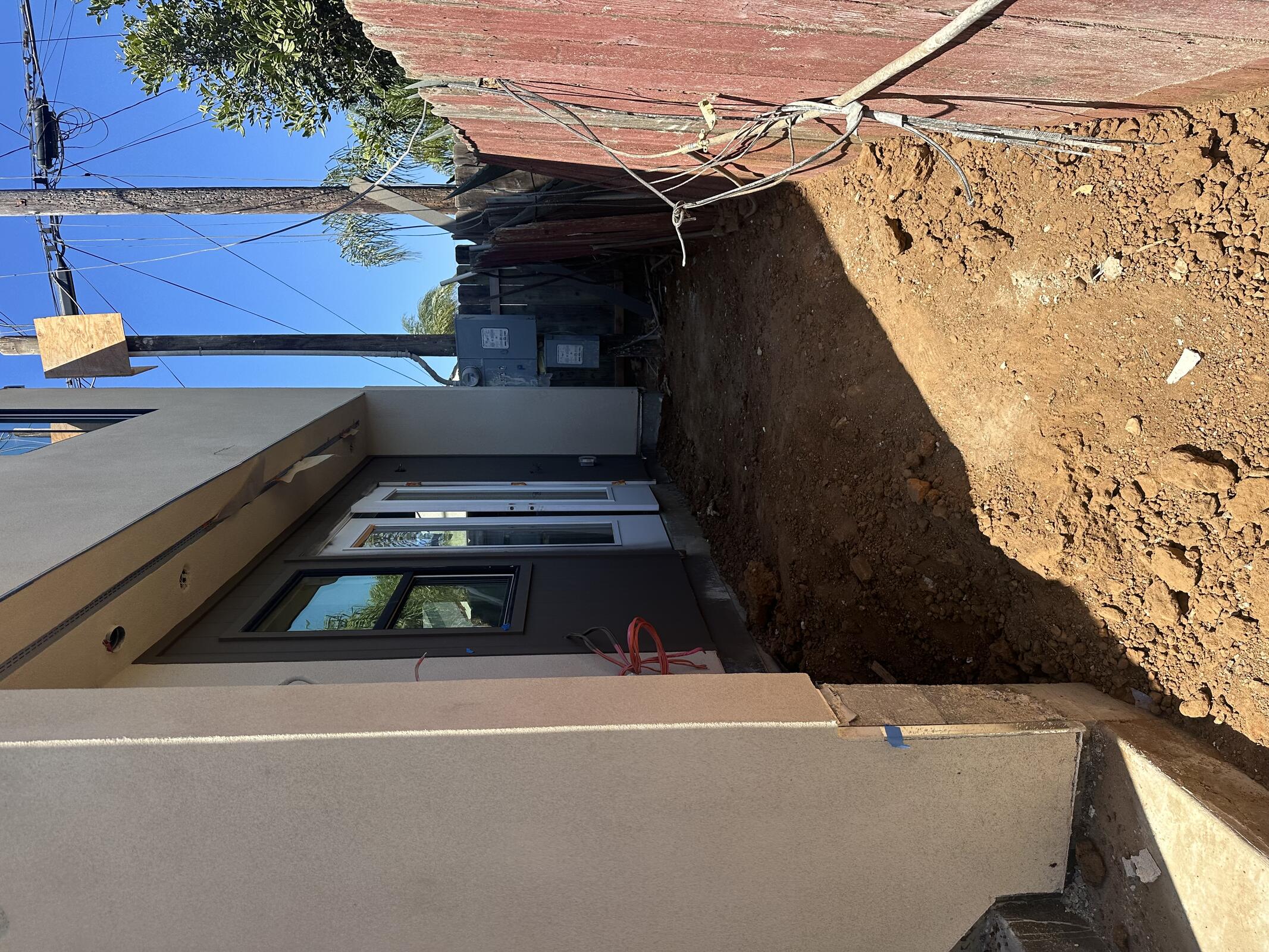

Delay: Pending calculations from Flores and path forward. Temp power pole in way of site concrete near Building B. Waiting on Building B site concrete in case we need to underground to transformer.

Wednesday, June 24, 2026
Partially cloudy, 72°F
JBG on site continuing to prep for drainage install.

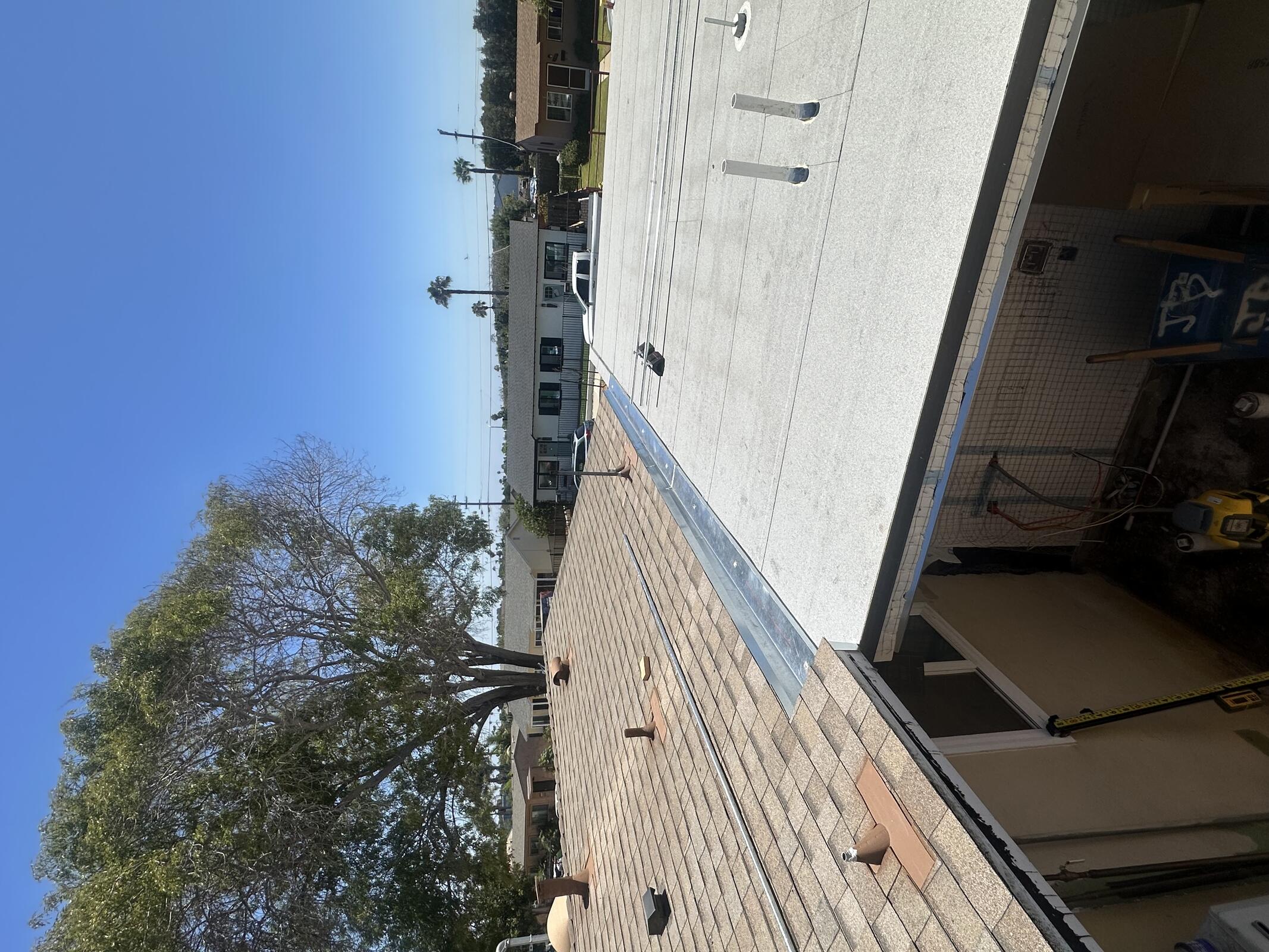

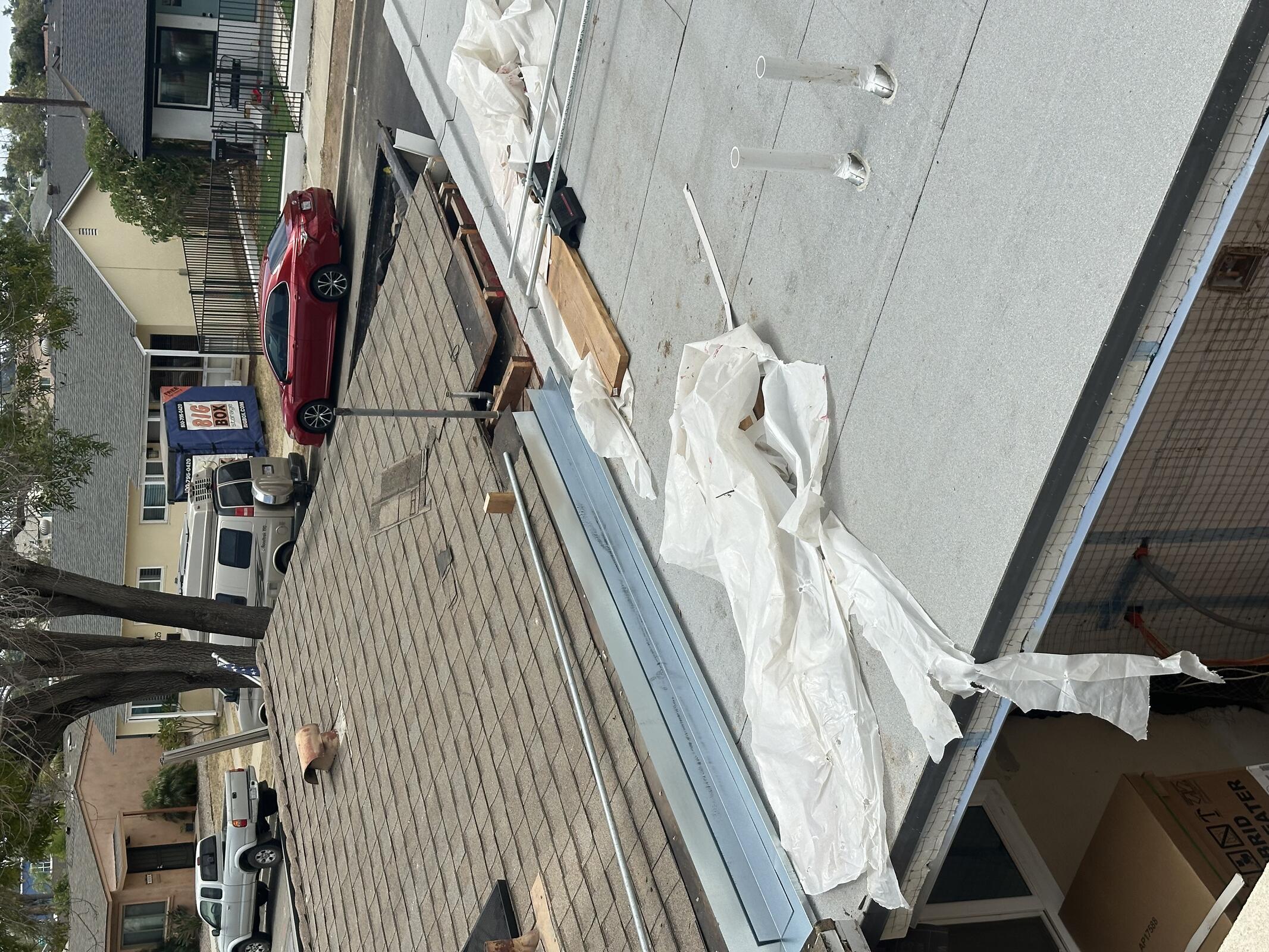

Roofers installing flashing over seismic gap between existing duplex and garage.

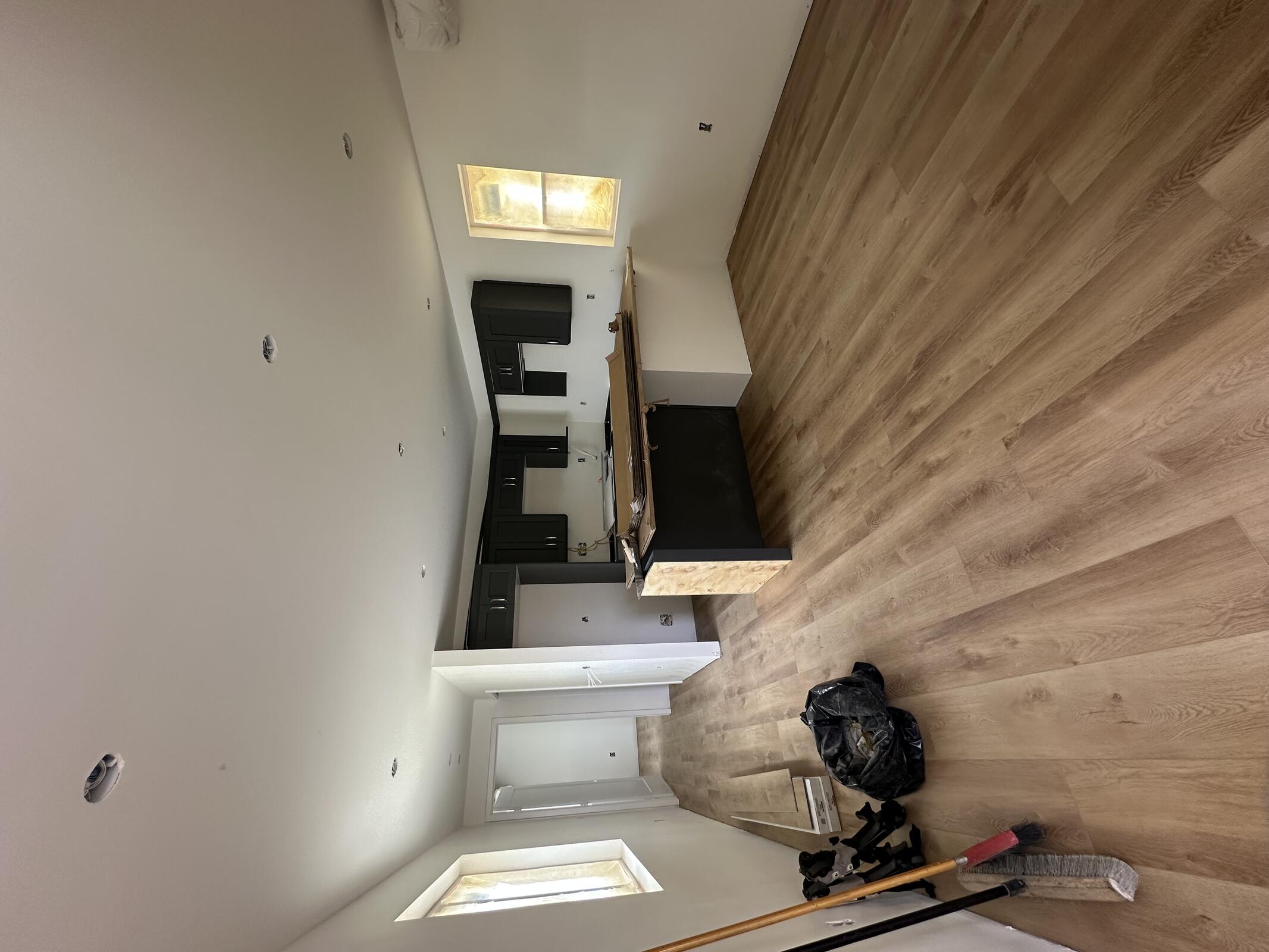

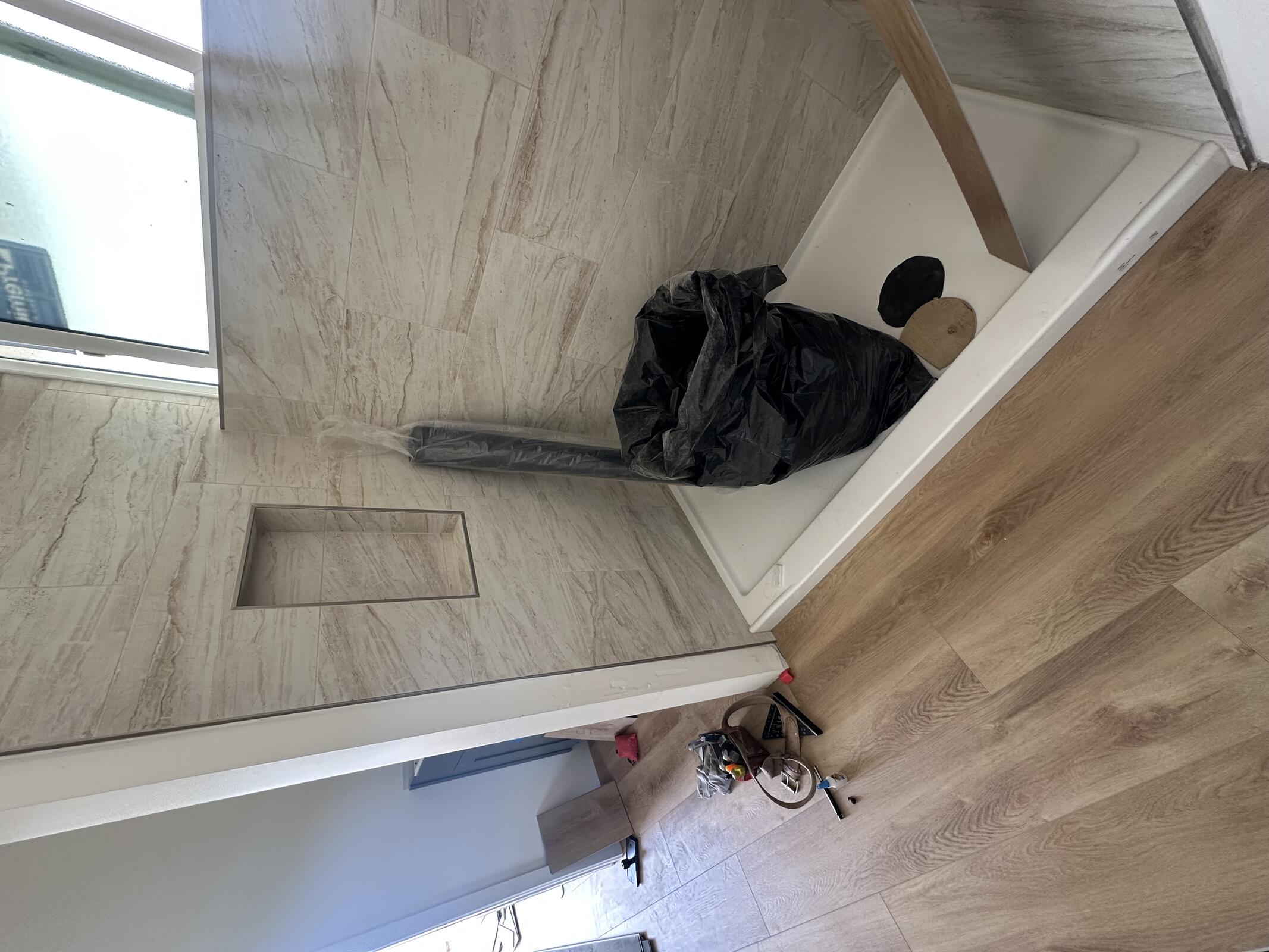

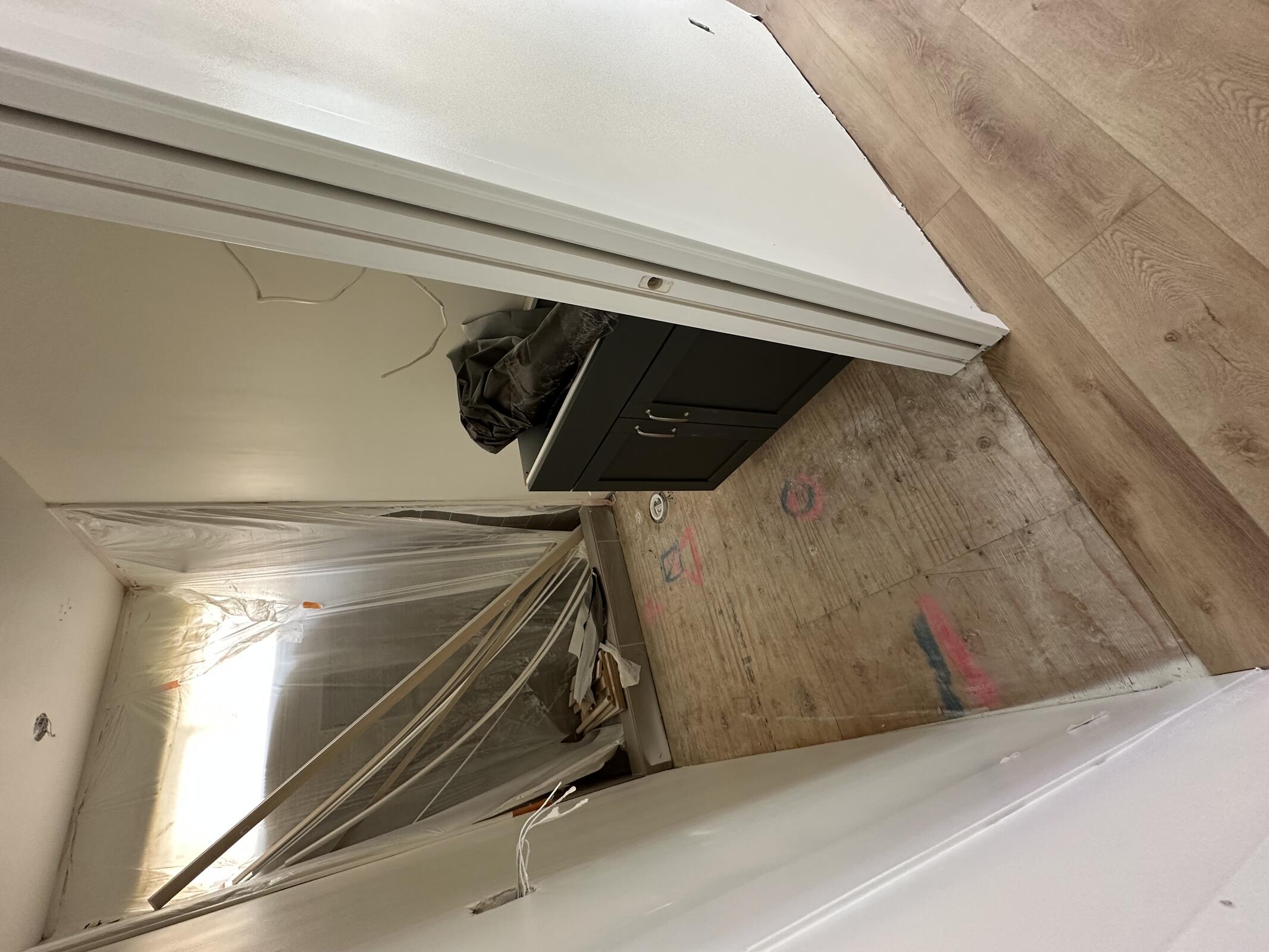

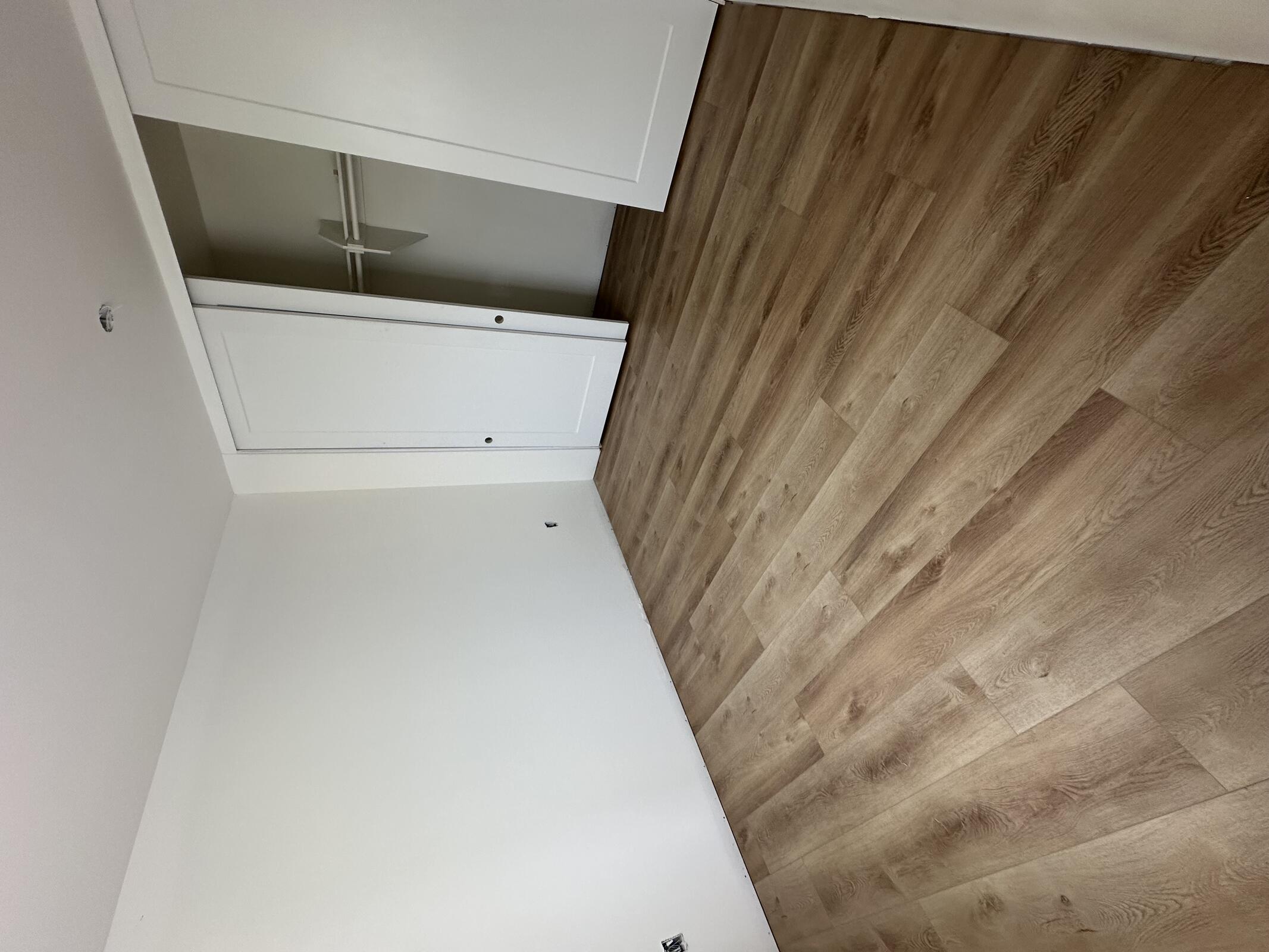

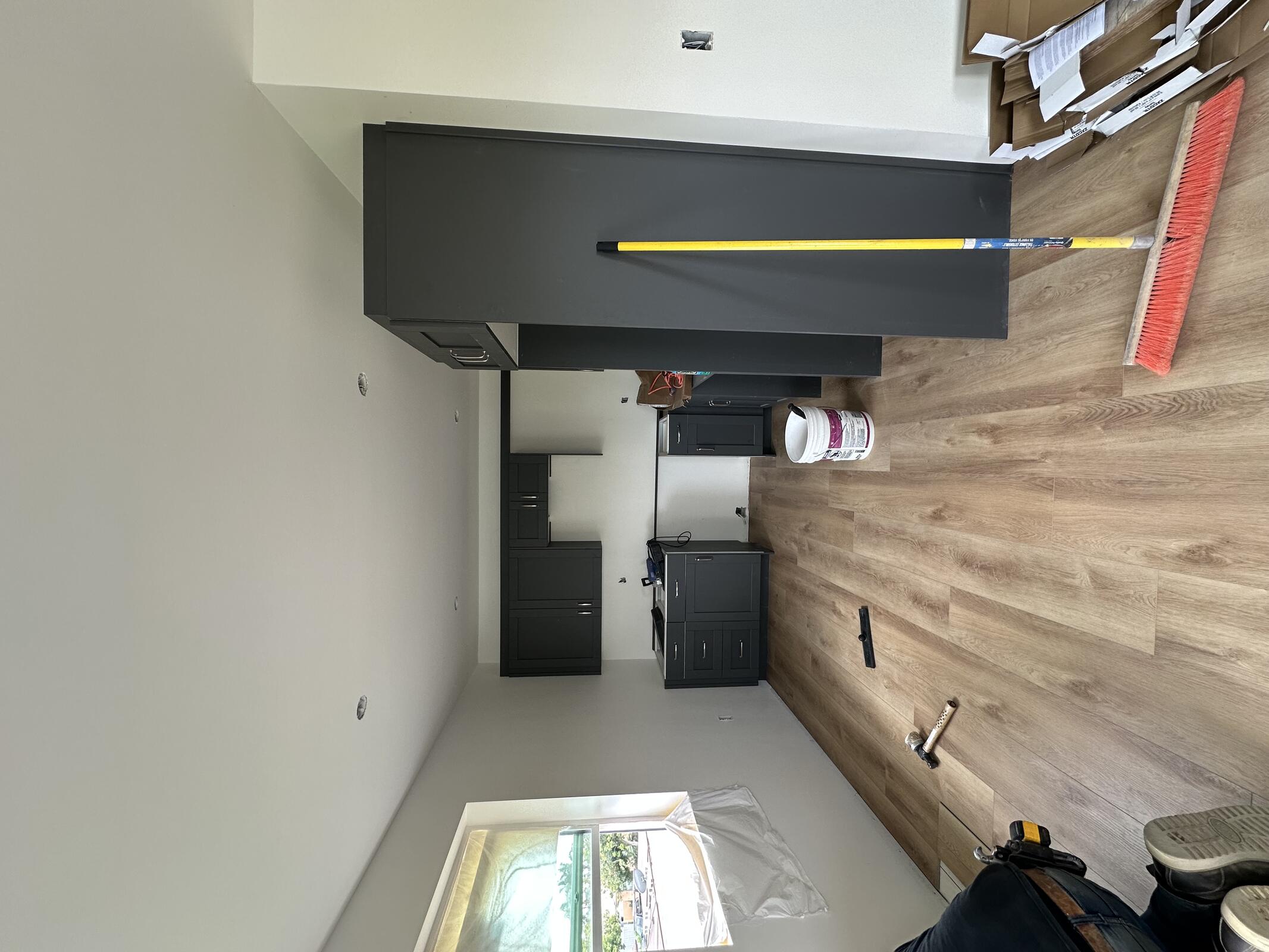

Coastal installing LVP at garage.

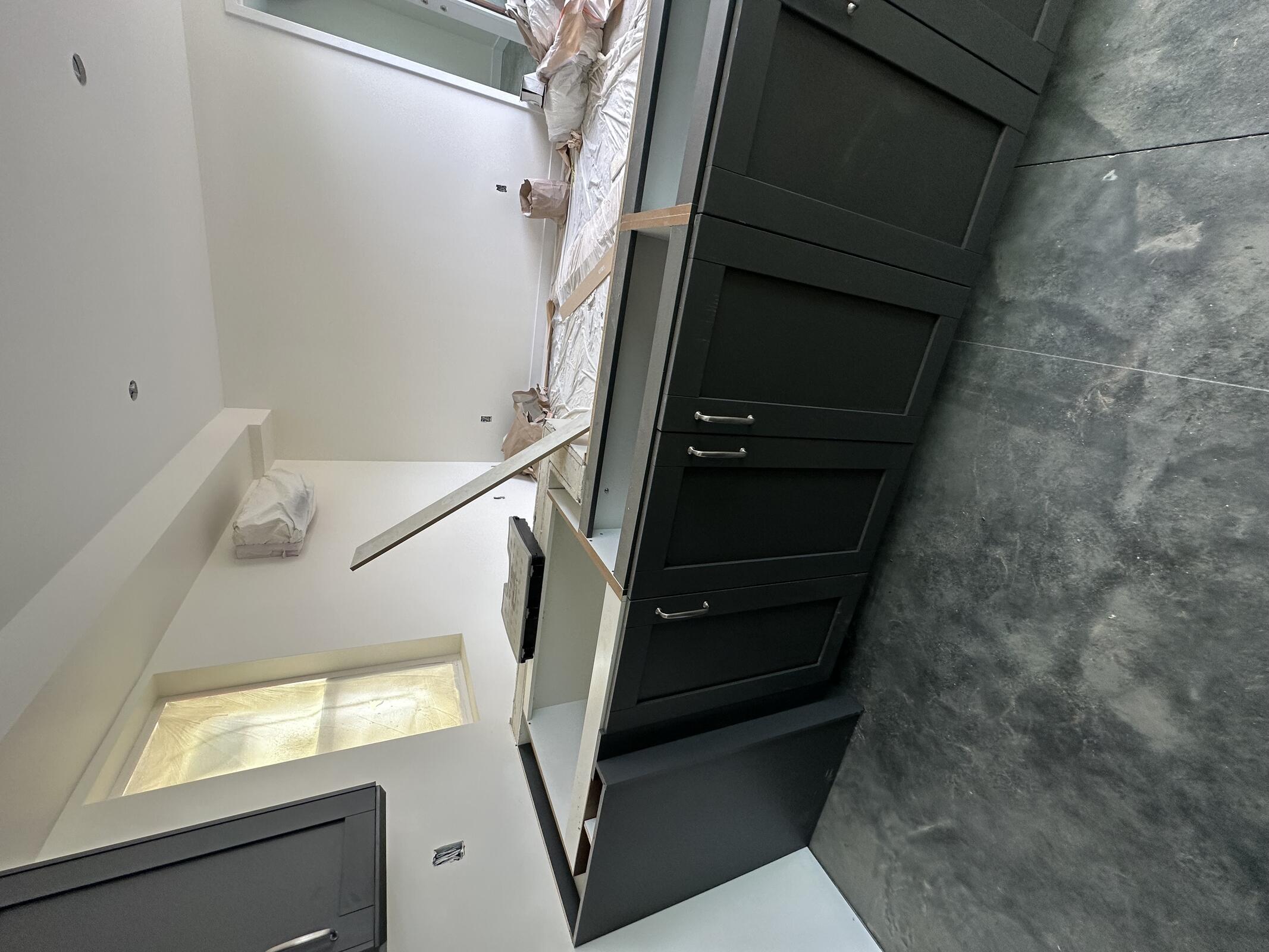

Marjan Stone templating countertops for fabrication.
Sunline installing panels on Buildings B and C.

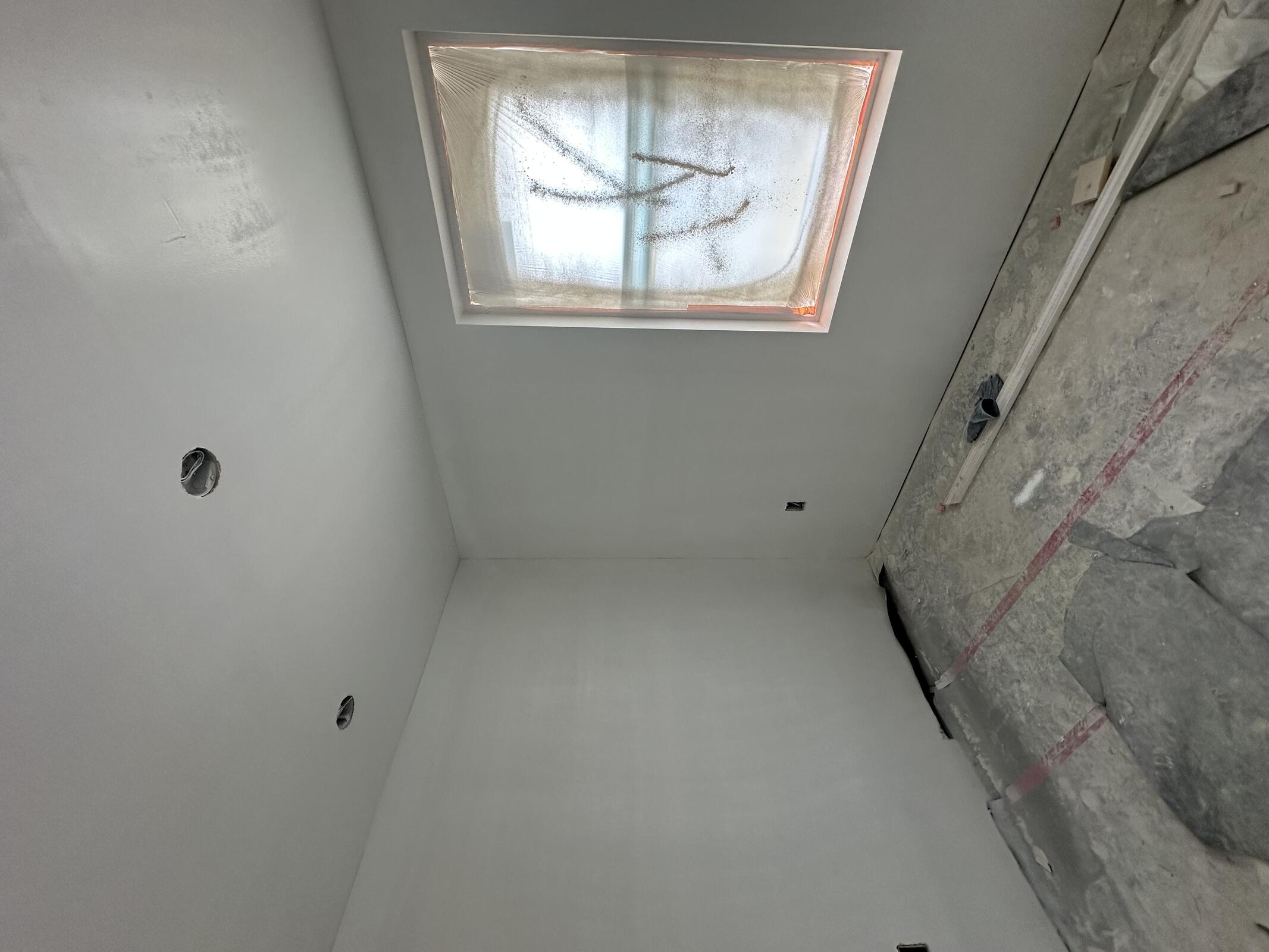

ML completed preliminary blue tape walk and alerted drywallers, cabinets, and DFH of corrections needed.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| Coastal | 2 | 5 | 10 |
| JBG | 4 | 8 | 40 |
| ACCI | 3 | 4 | 12 |
Inspection: N/A
Delay: Meter saga continuines....

Thursday, June 25, 2026
Clear, 71°F
AC Electric installing LED lights and finish.

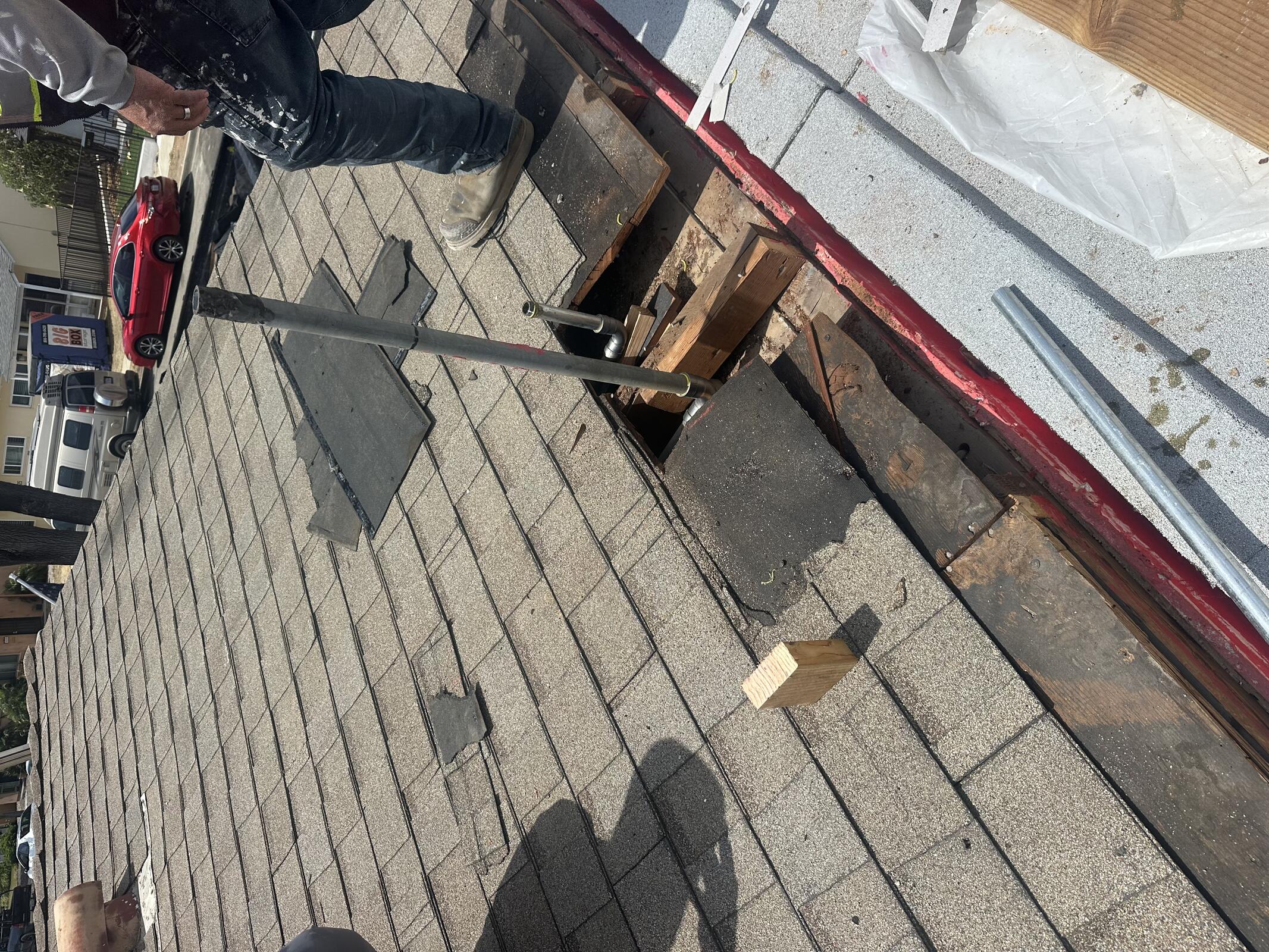

ACCI finishing roof repair at existing duplex.
JBG finalizing rough grade and drainage mat at Building B.
Sunline on site.

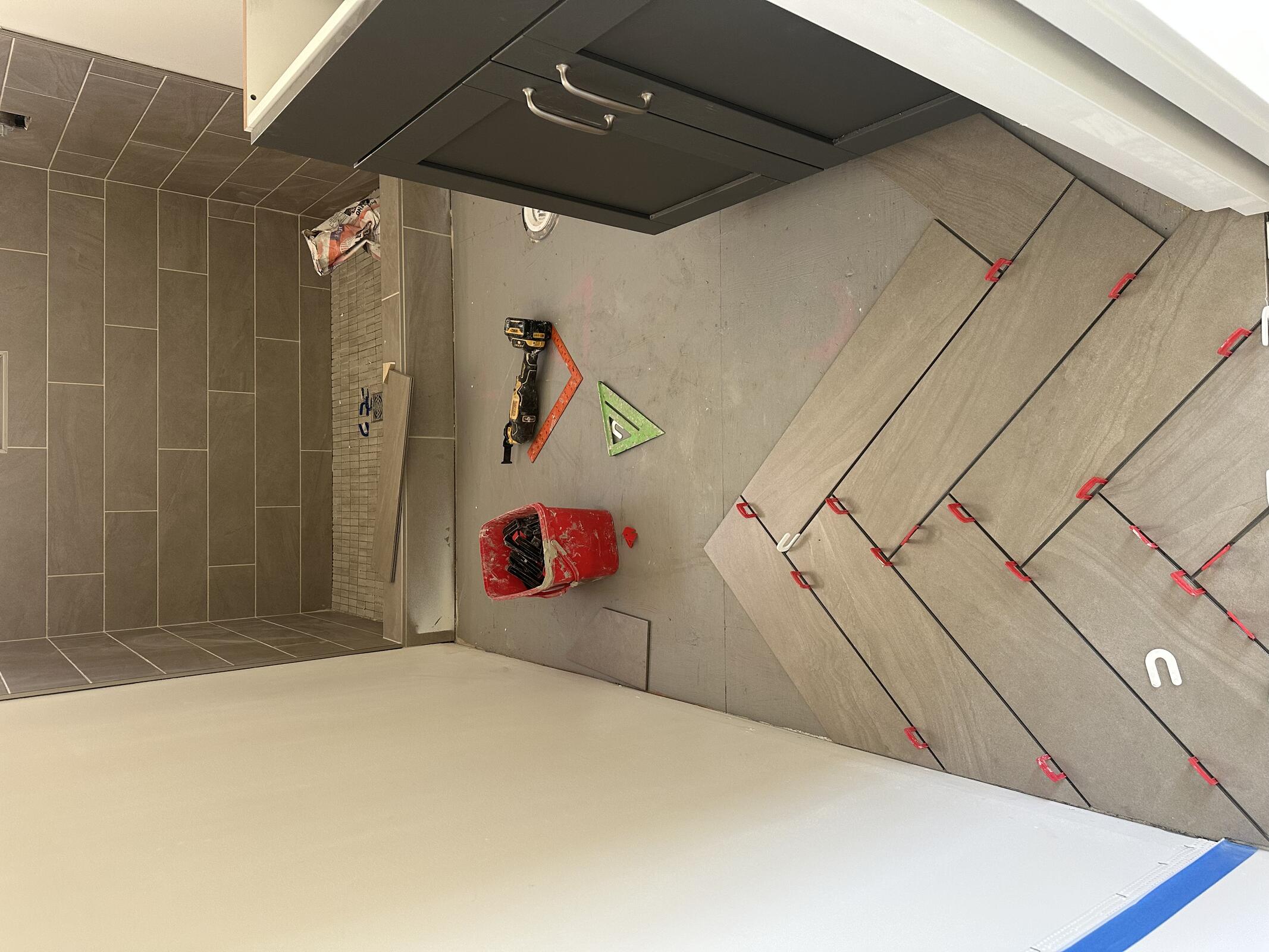

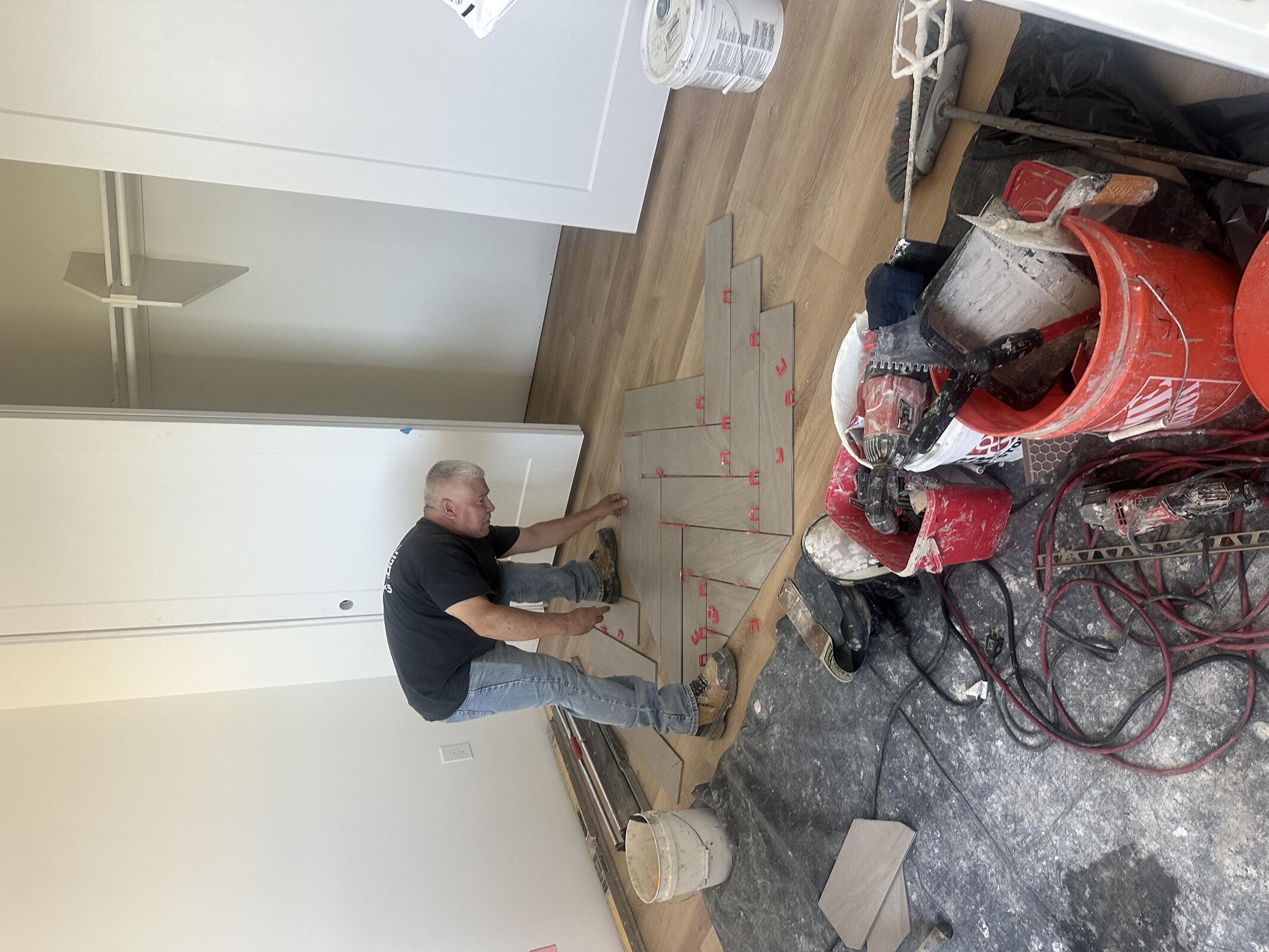

Coastal laying out C2 bathroom floor tile.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| JBG | 2 | 8 | 16 |
| ACCI | 3 | 5 | 15 |
| AC Electric | 3 | 8 | 24 |
Coastal - 1 - 8 - 8
Inspection: N/A
Delay: Pending final calcs from Sam (Flores)

Friday, June 26, 2026
Clear, 72°F

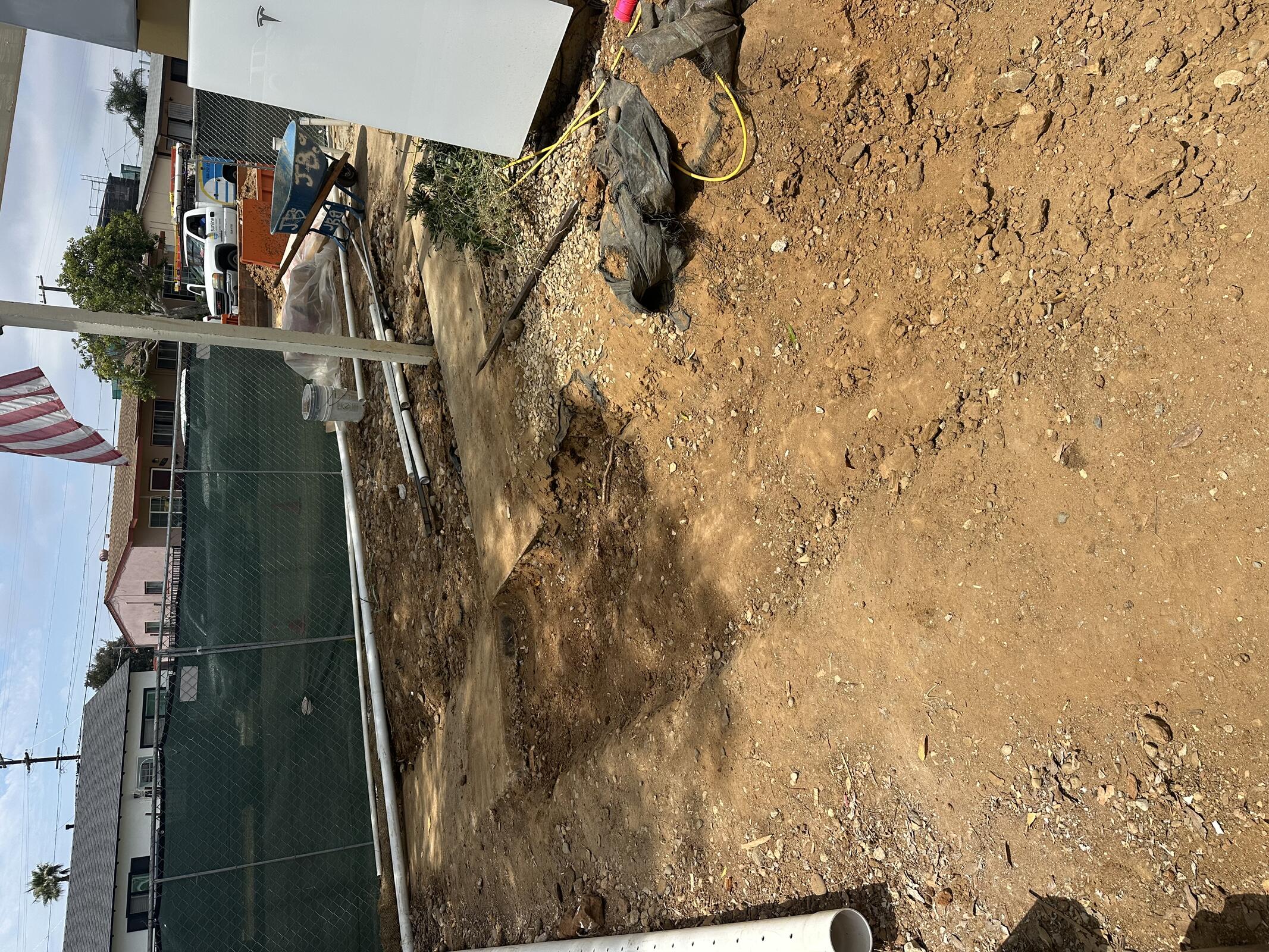

JBG General digging trenches for solid drains.
Coastal finishing C2 bathroom floor layout.
TDI on site to walk through items that need correcting.
AC Electric roughing in units and exterior lighting.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| AC Electric | 3 | 8 | 24 |
| JBG | 2.5 | 8 | 20 |
Inspection: N/A
