Week of June 15 — June 20, 2026
6 days on site. 59 photos. Cabinets, DFH, Drywall, Gutters, Paint, Plumbing, Scaffolding, Siding, Site Concrete and Drainage, Solar, Stucco, Tile.
Monday, June 15, 2026
Clear, 73°F

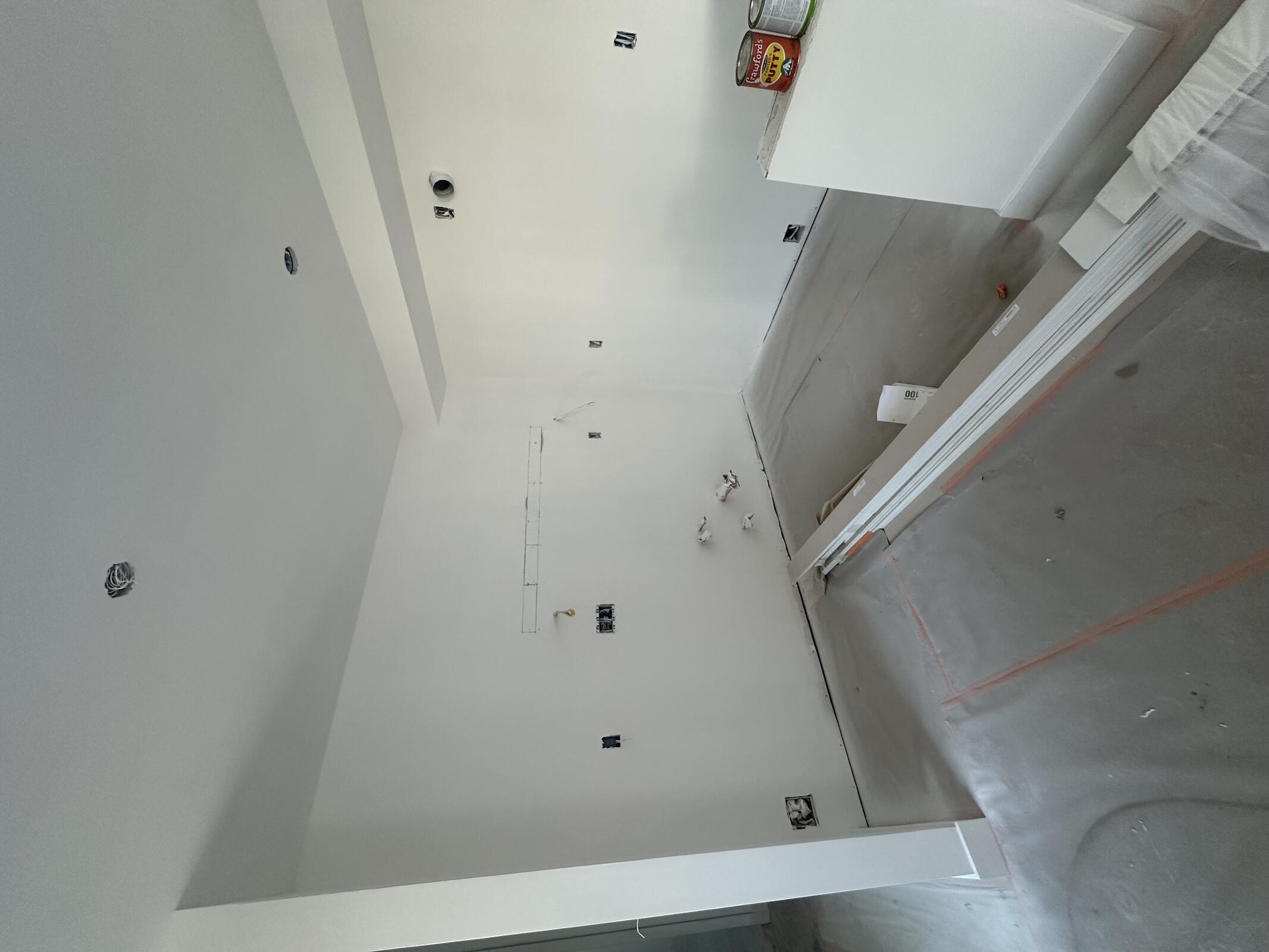

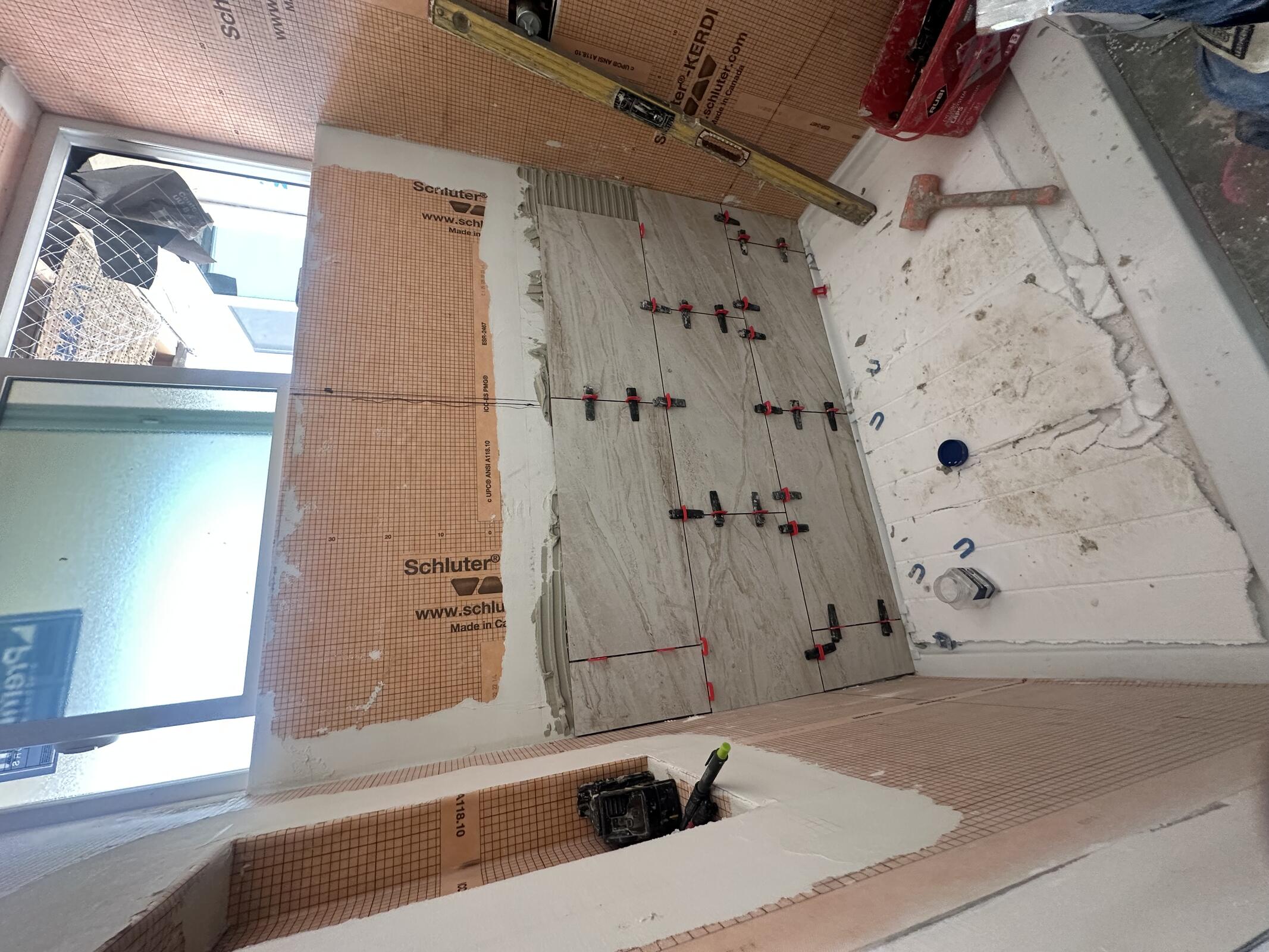

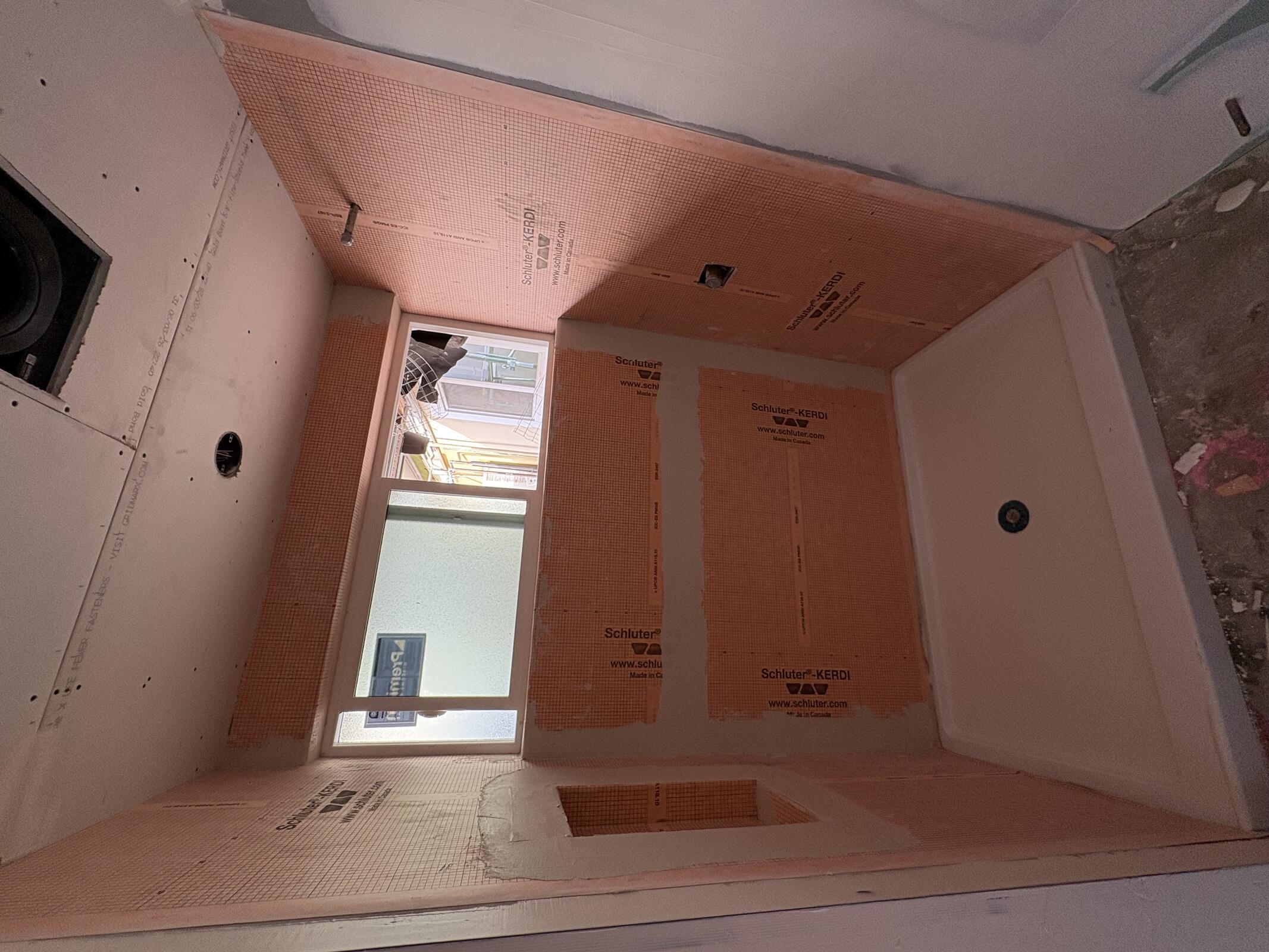

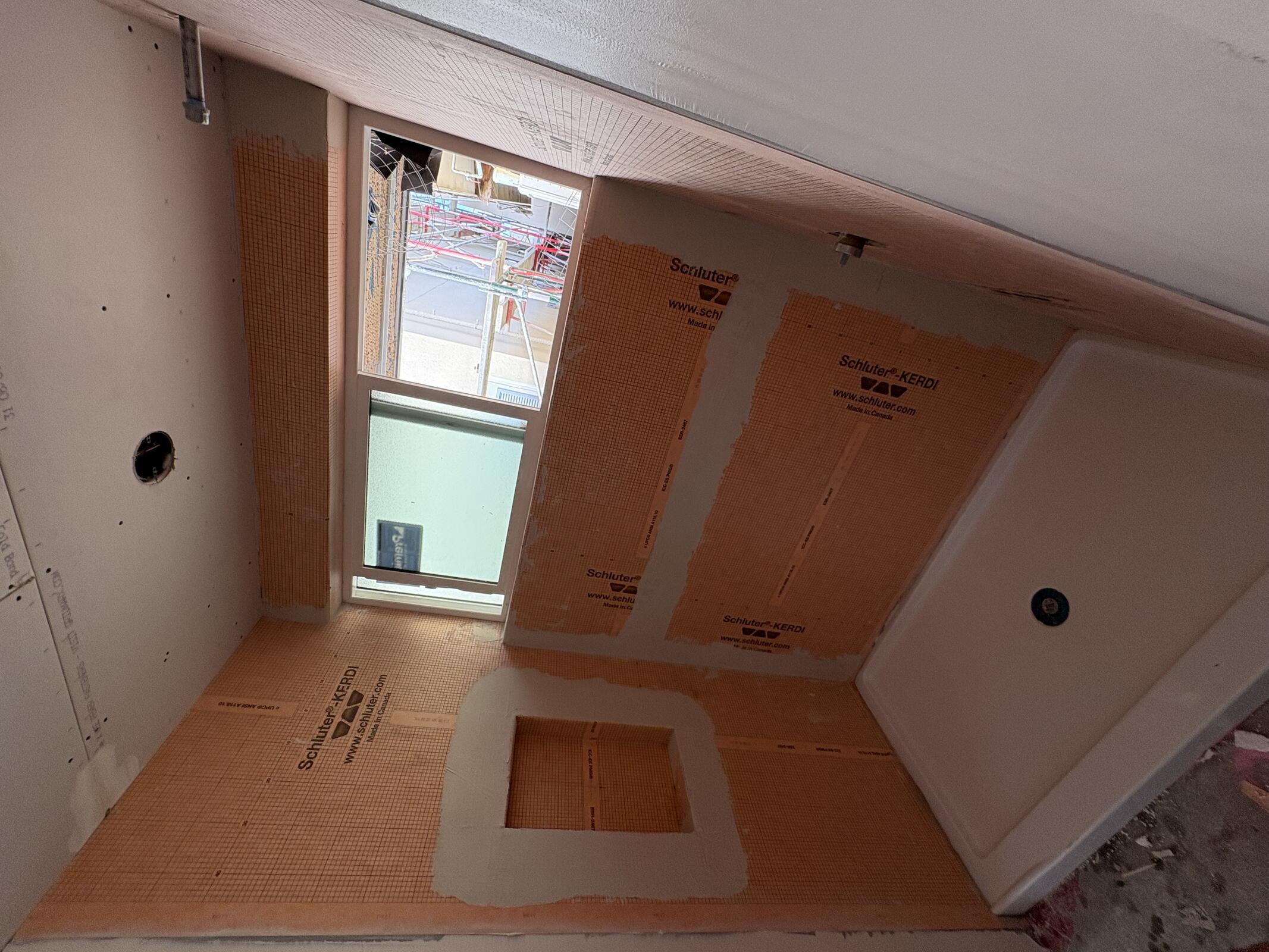

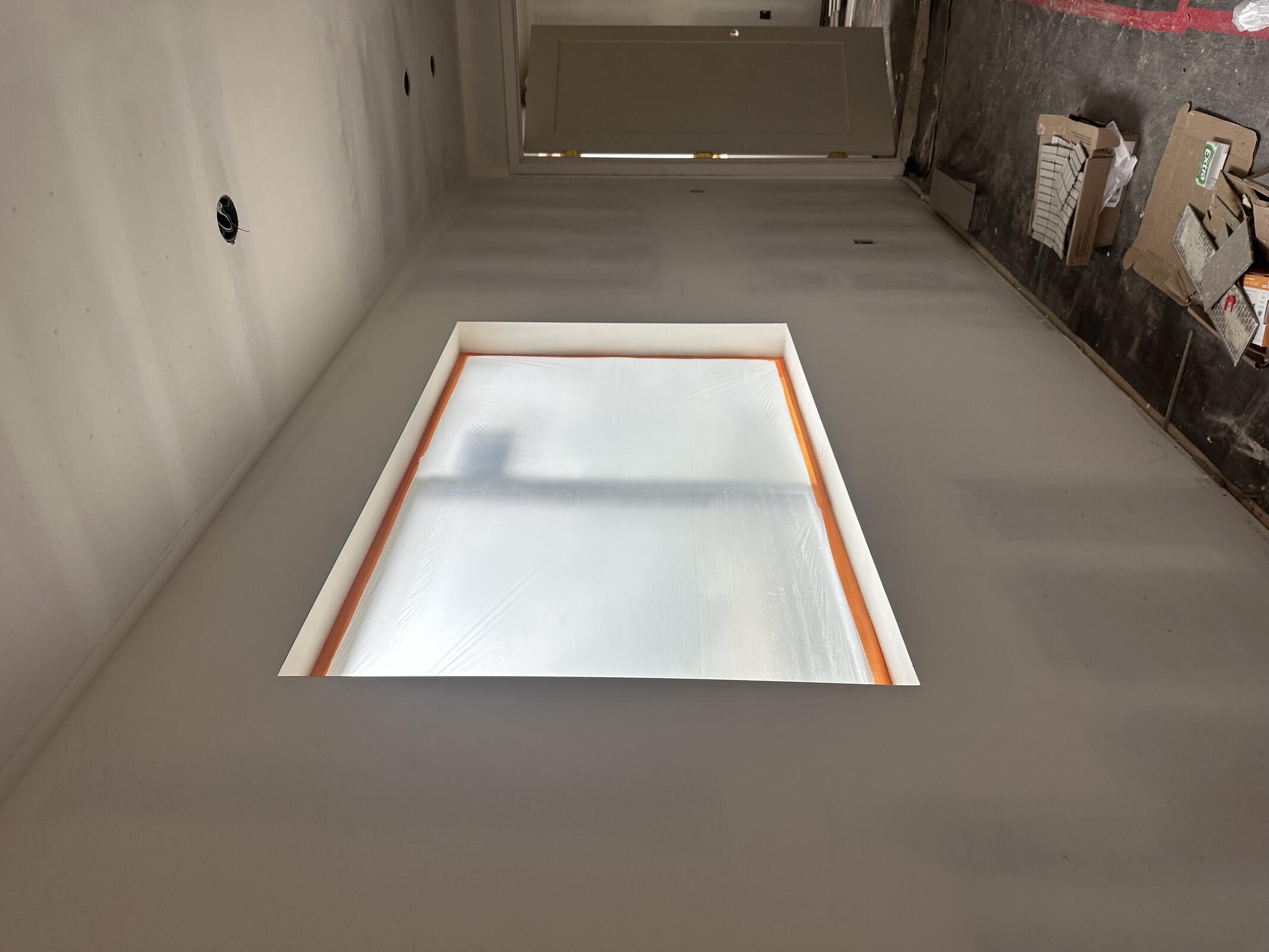

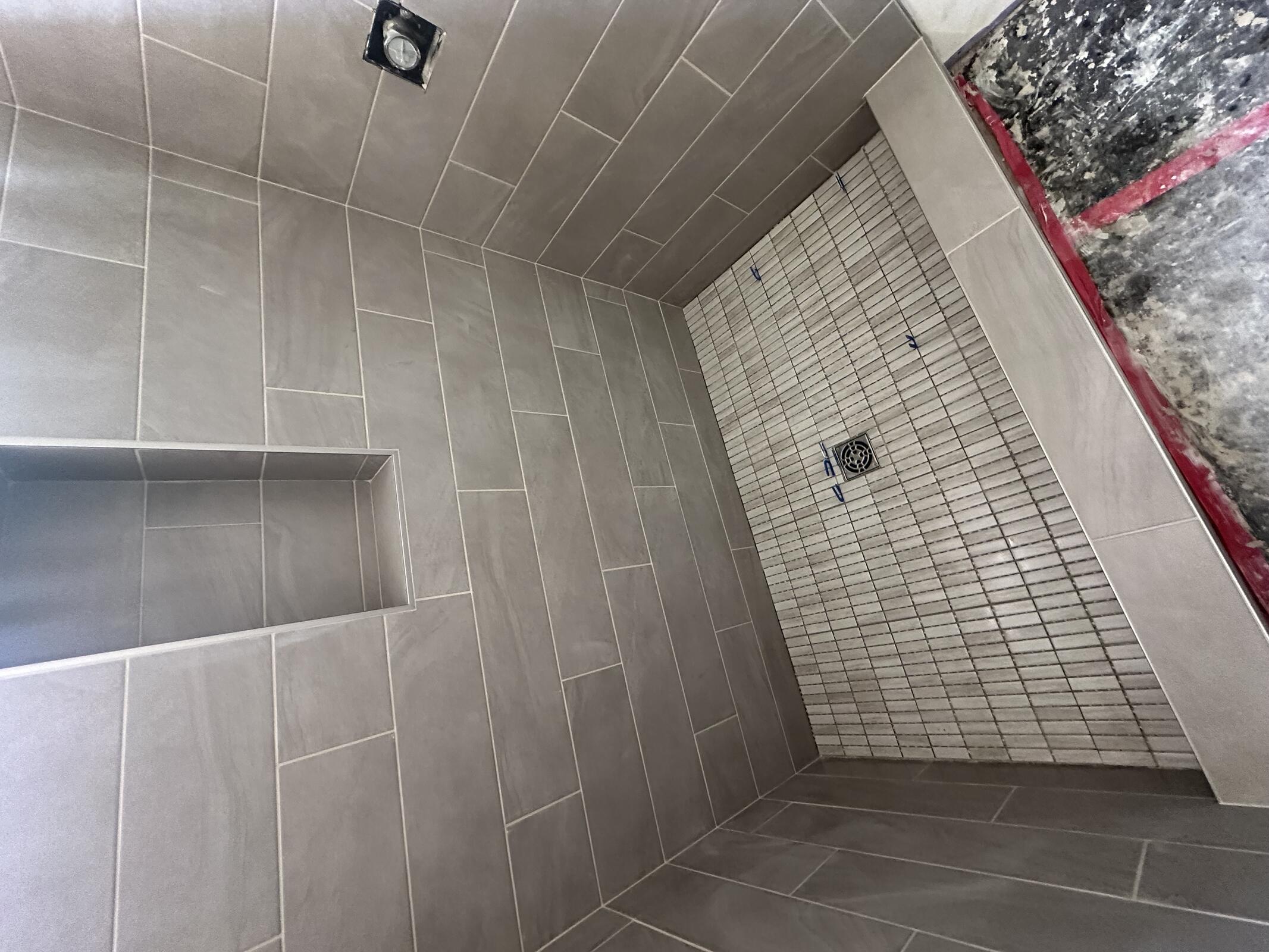

Coastal grouting shower walls at C2 and laying out shower floor tile.

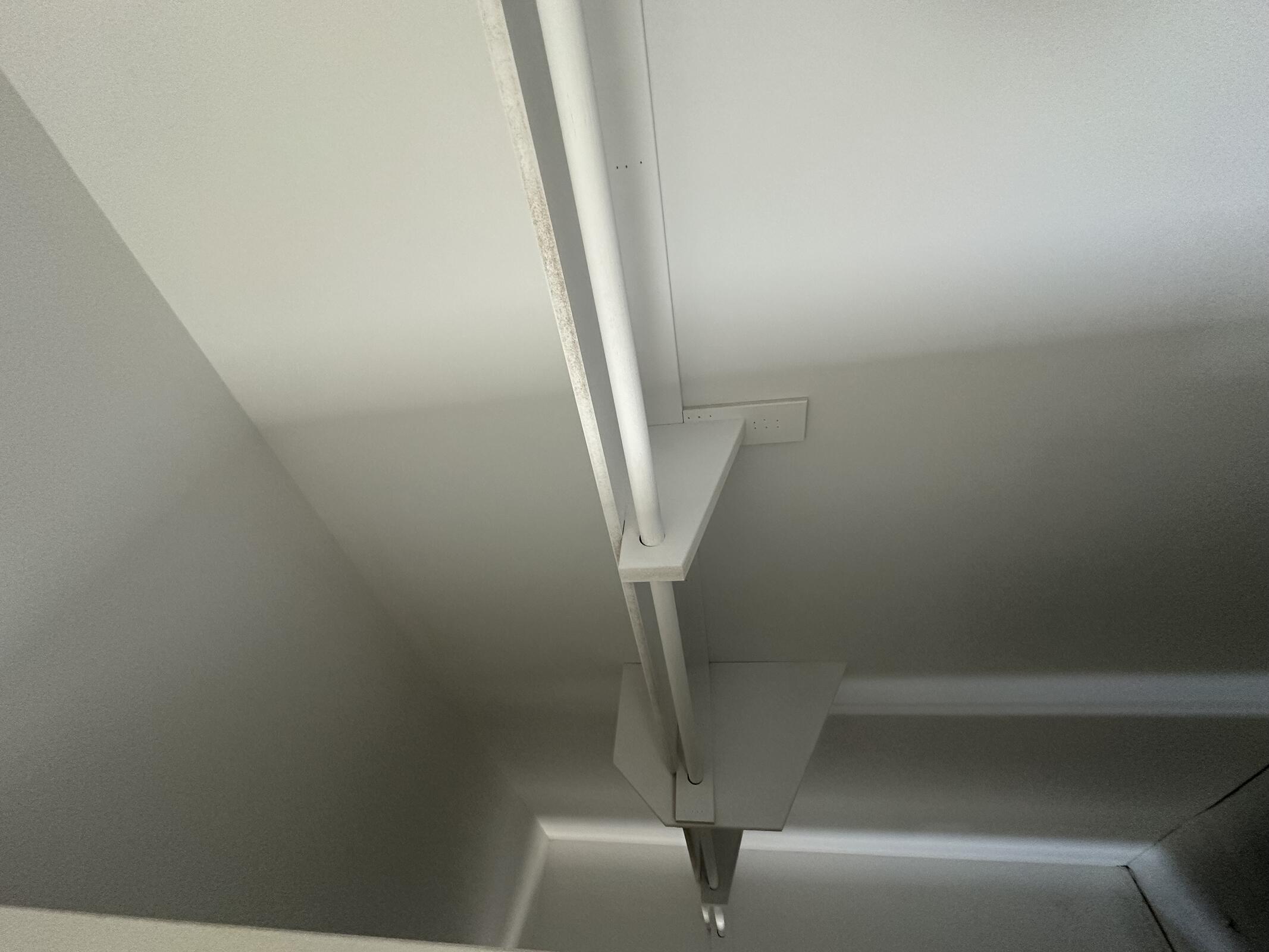

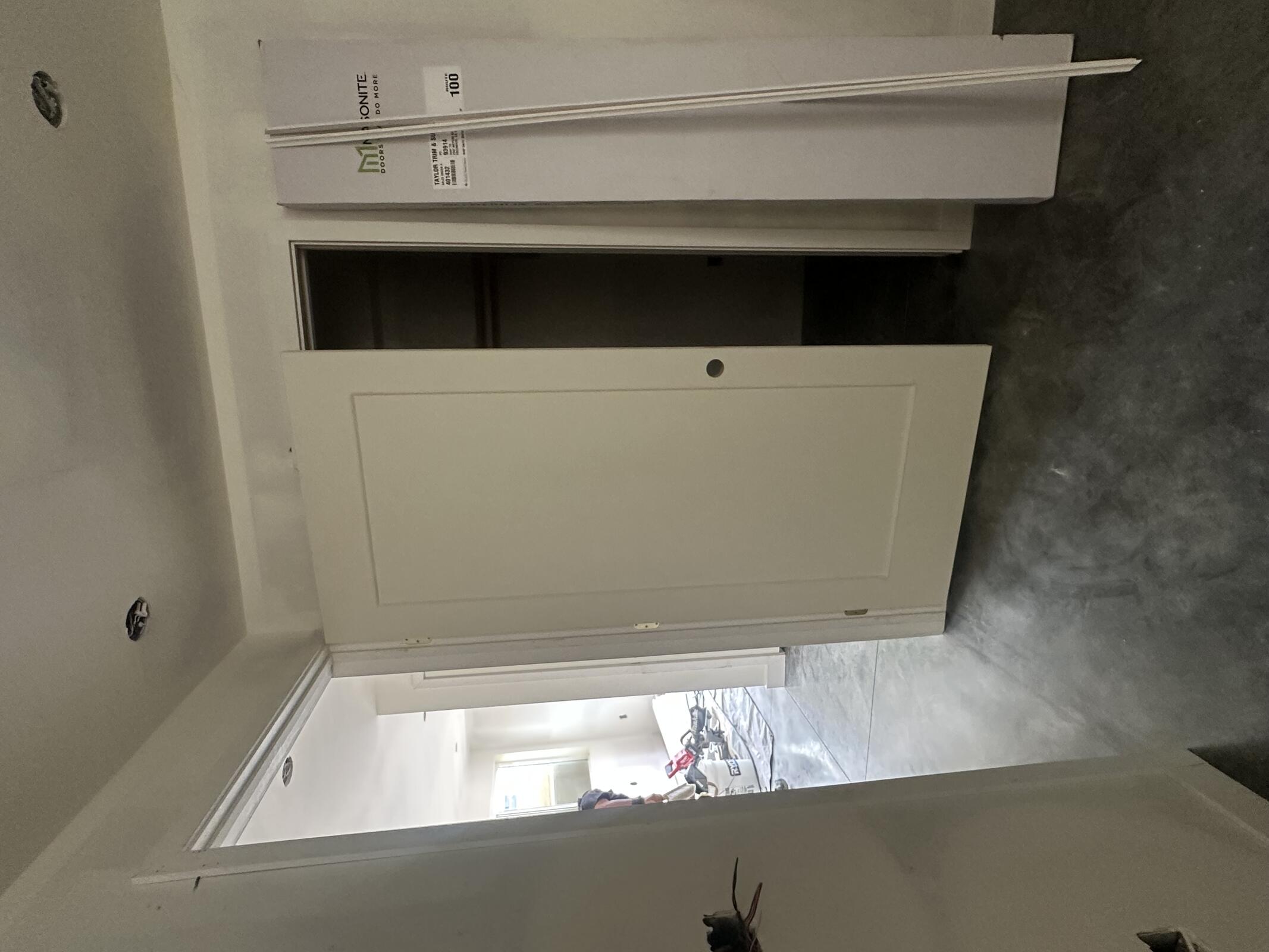

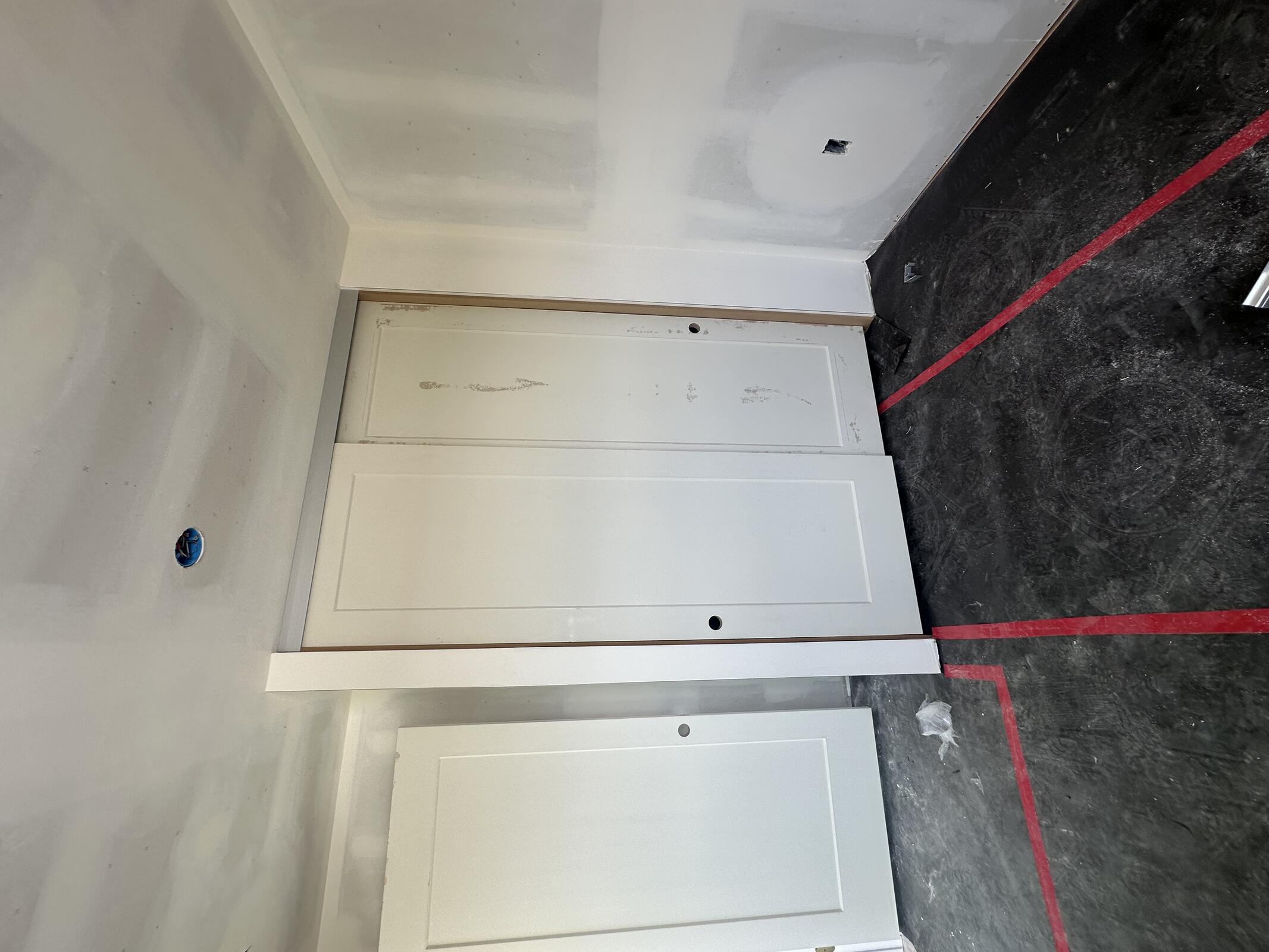

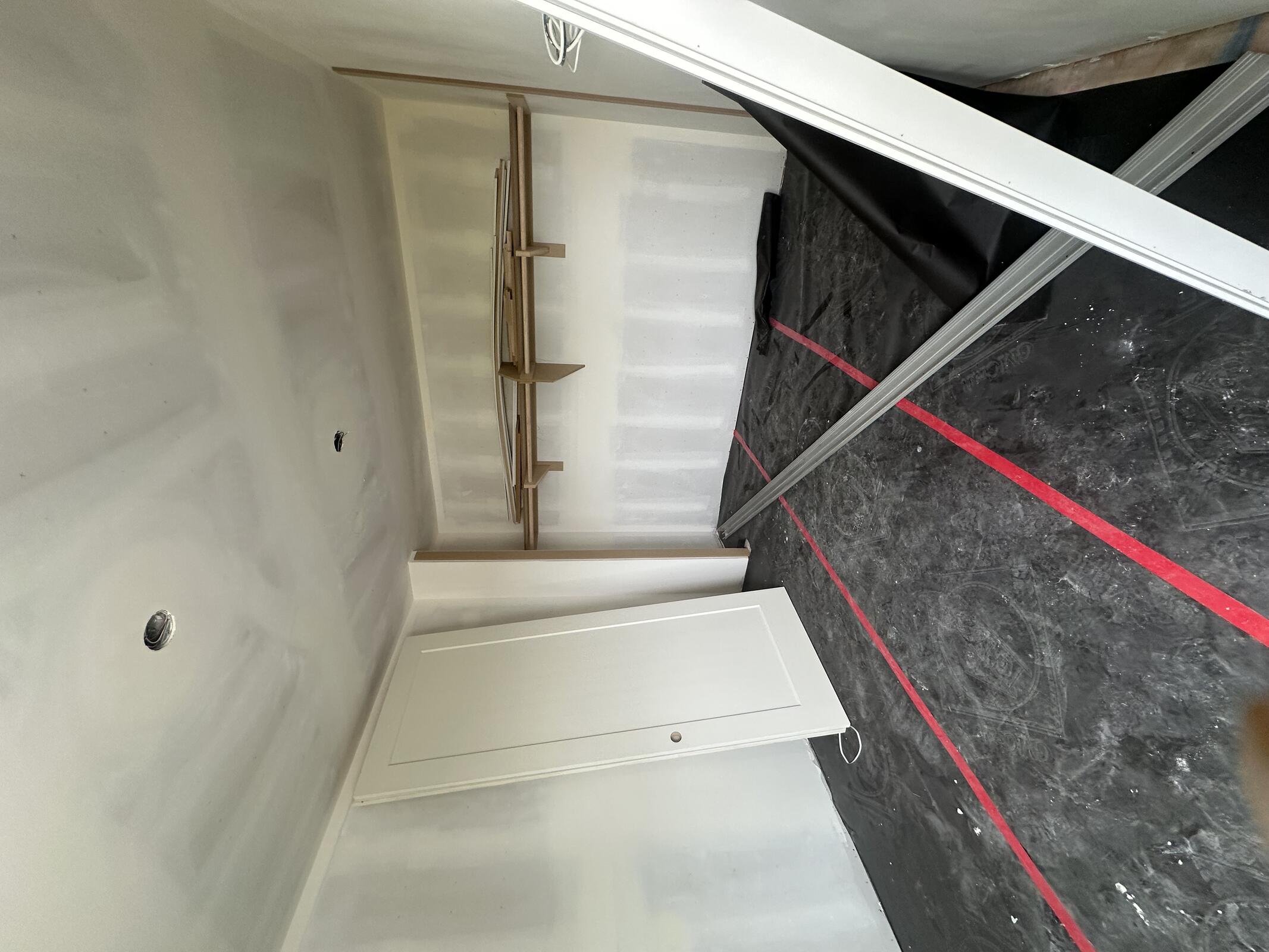

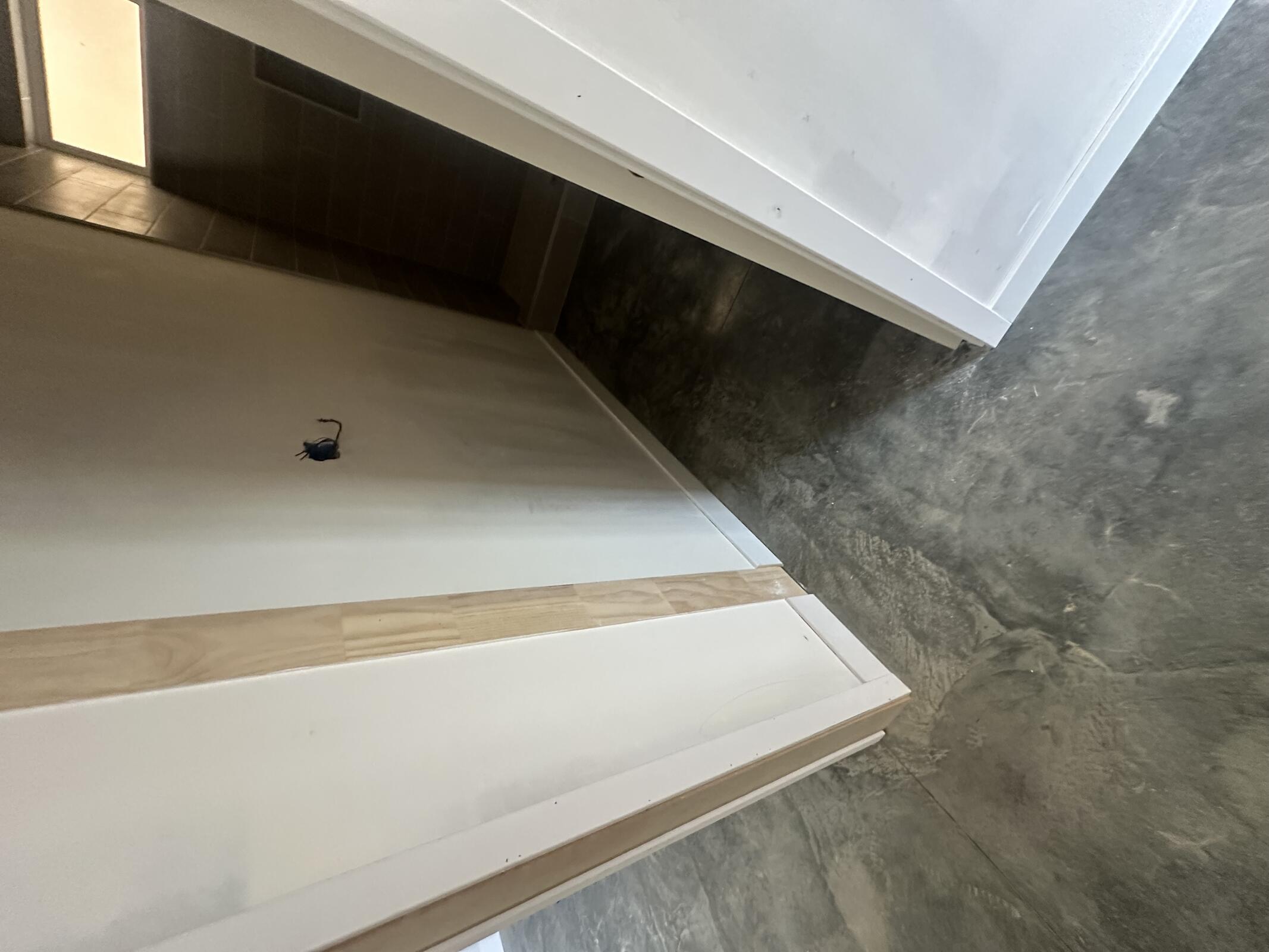

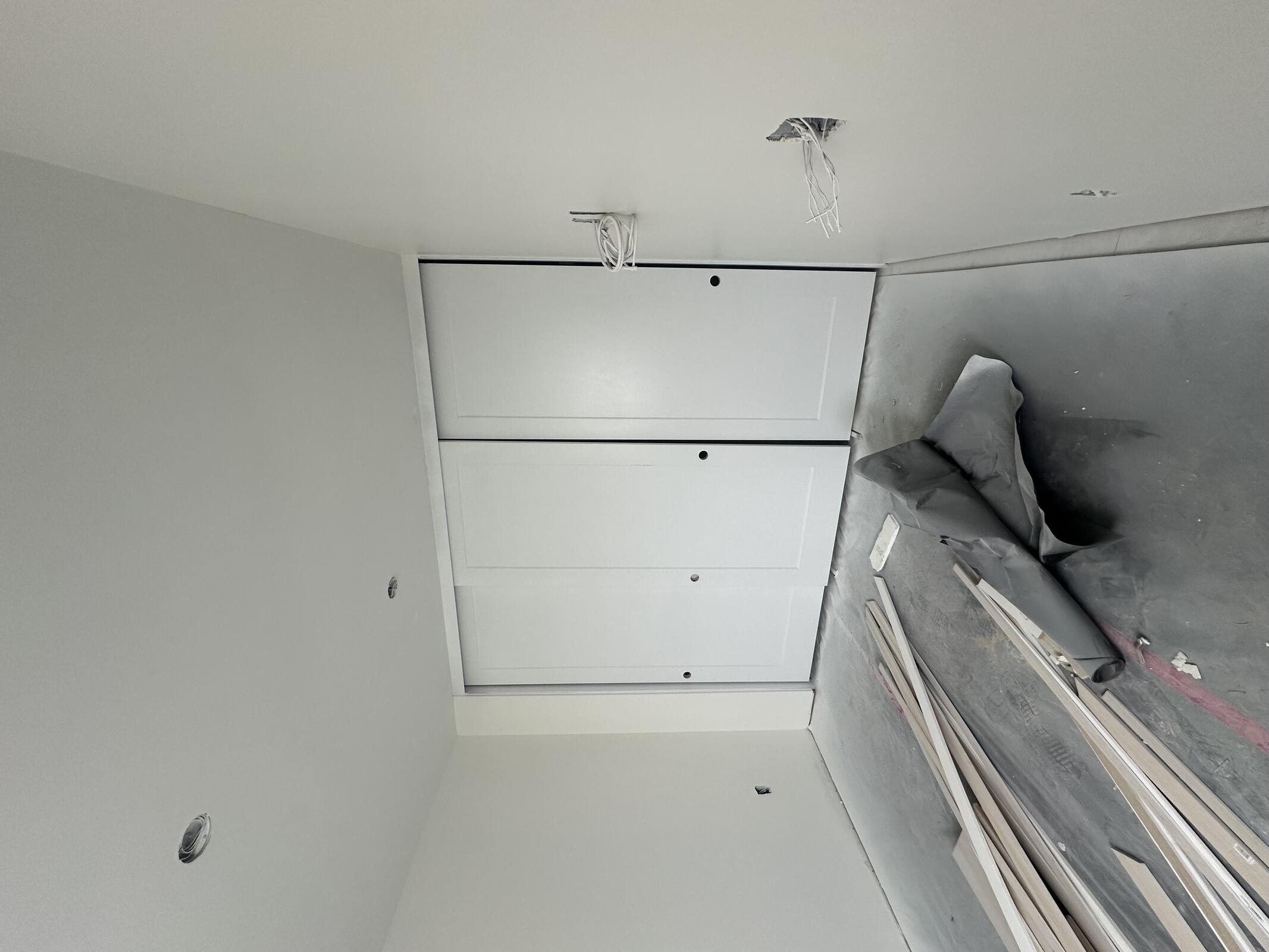

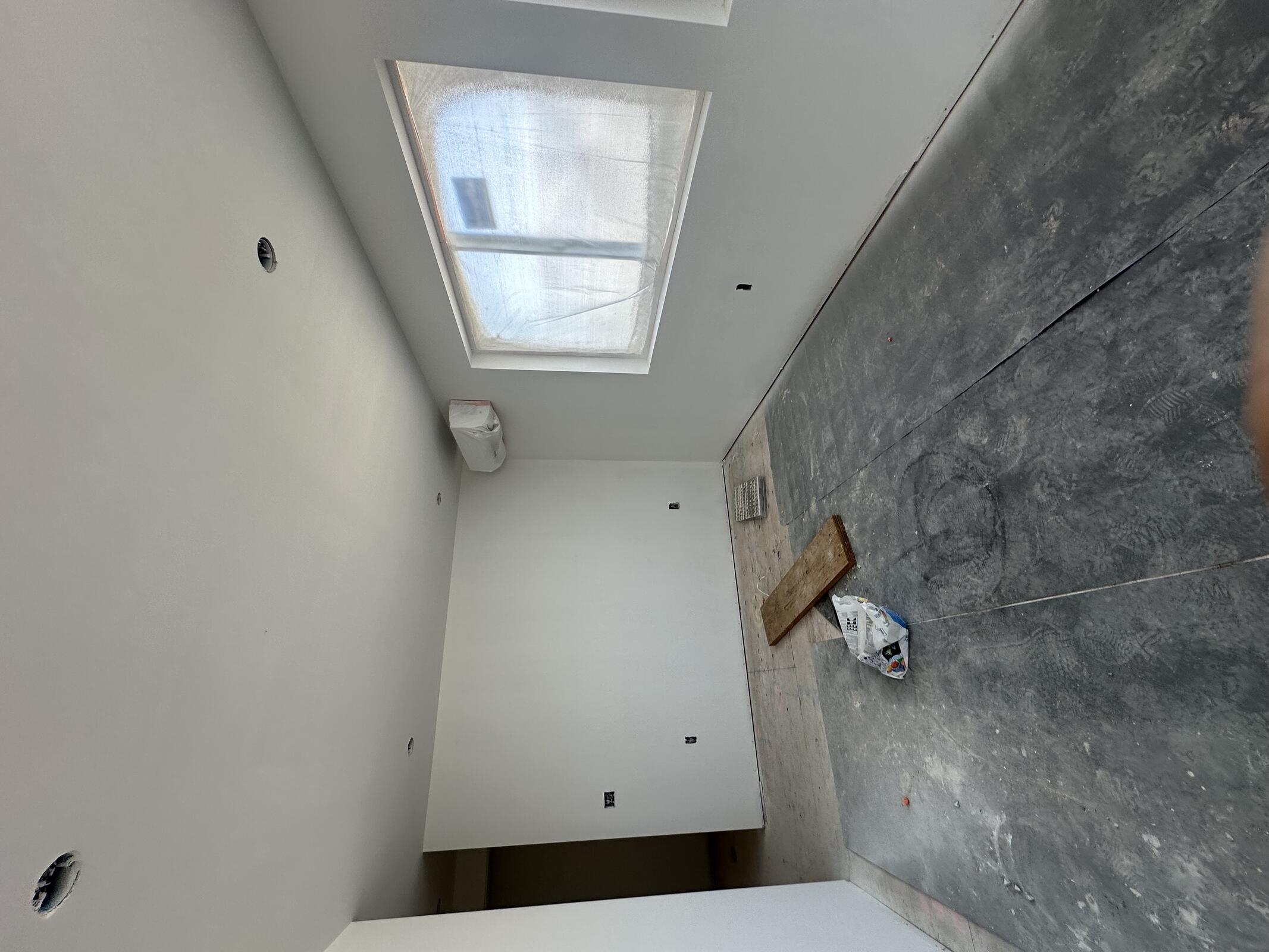

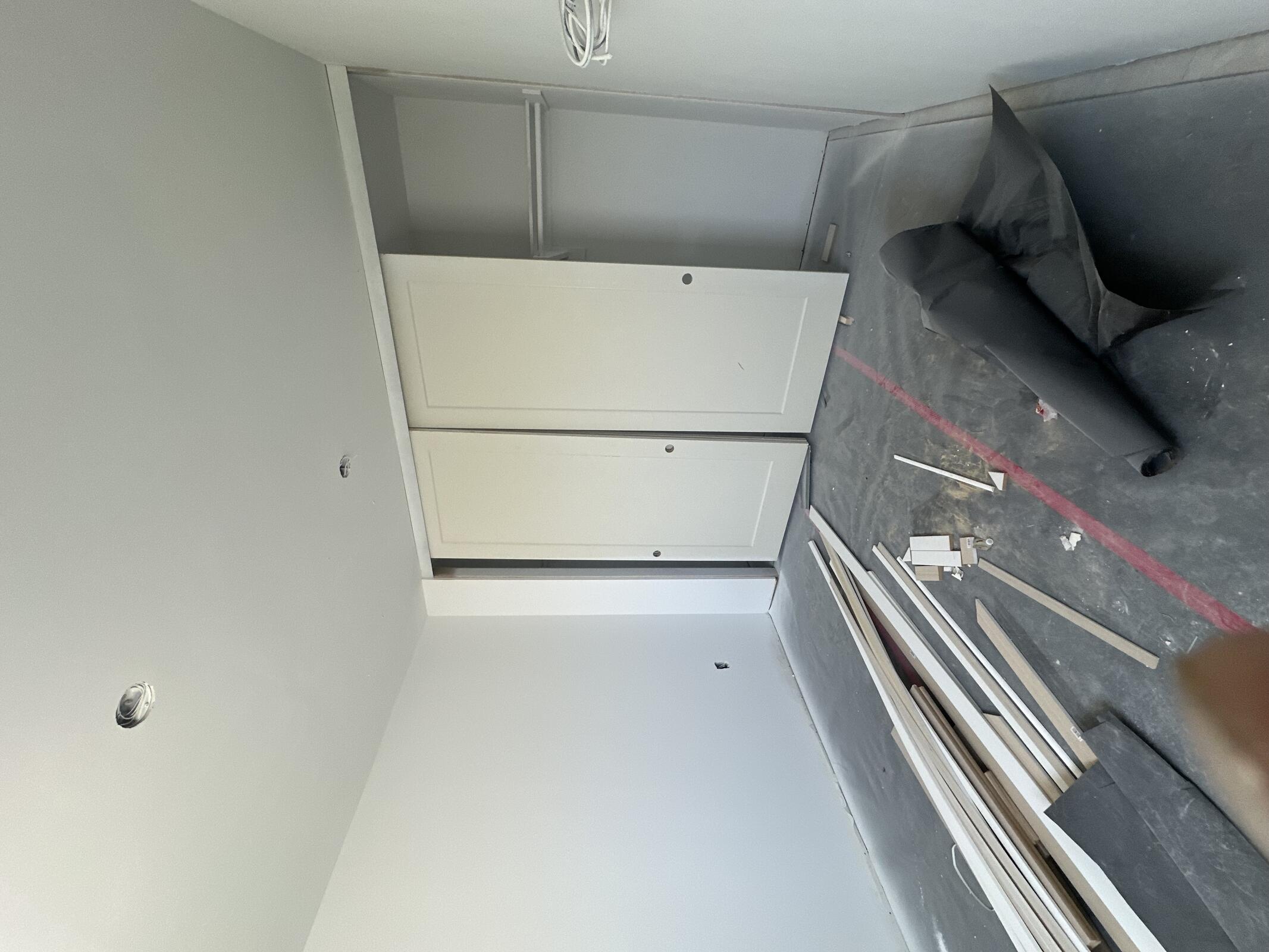

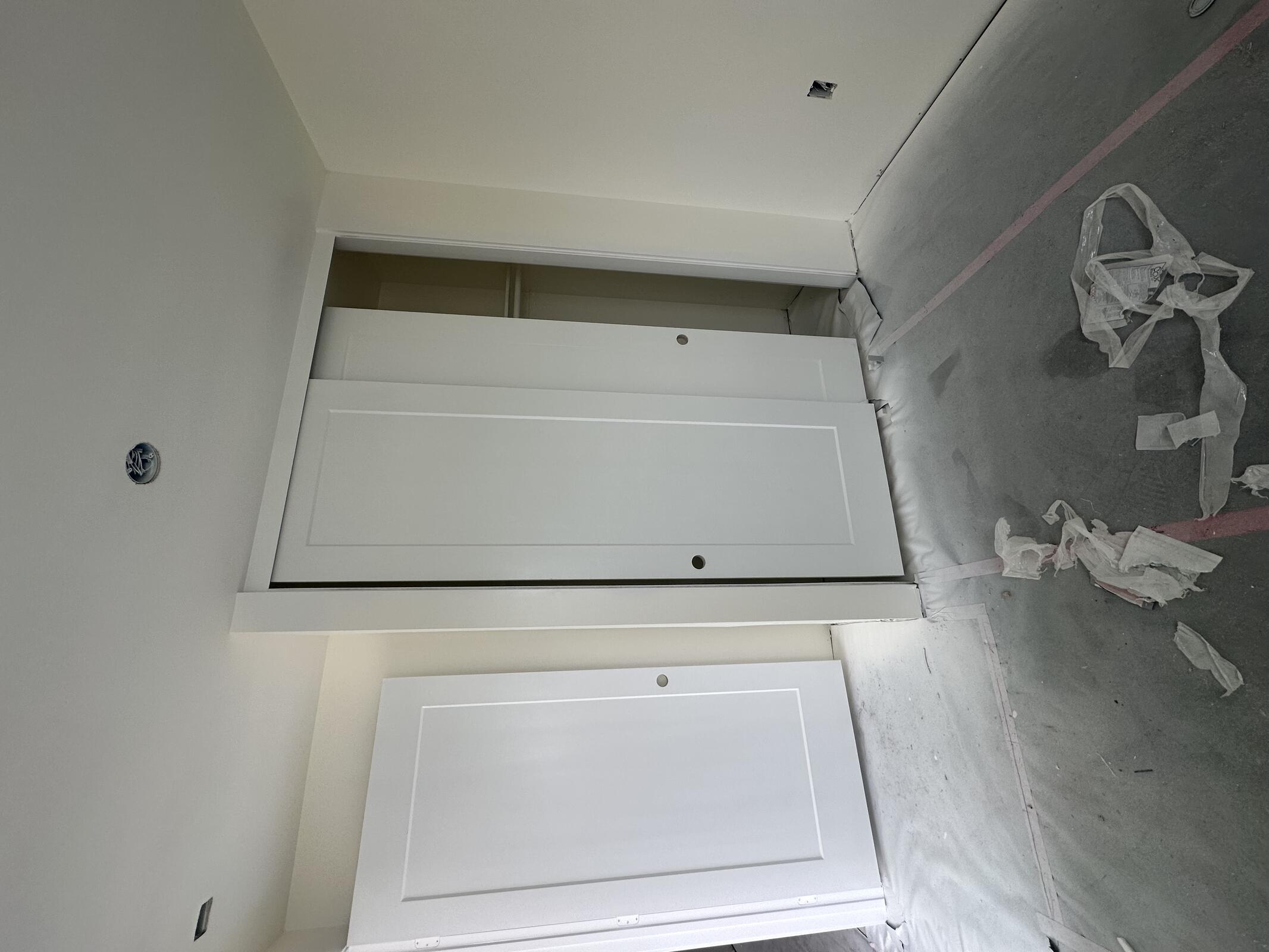

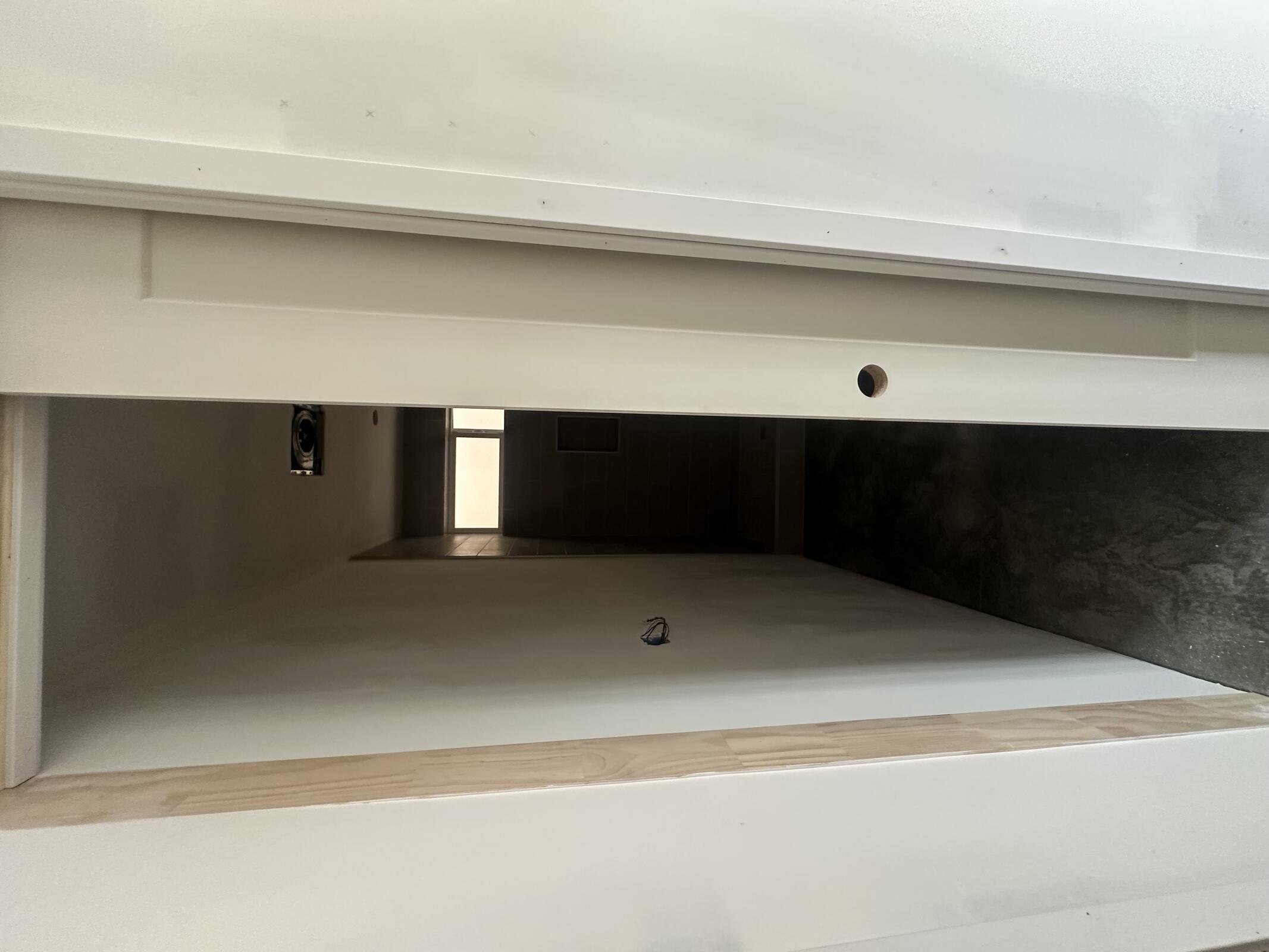

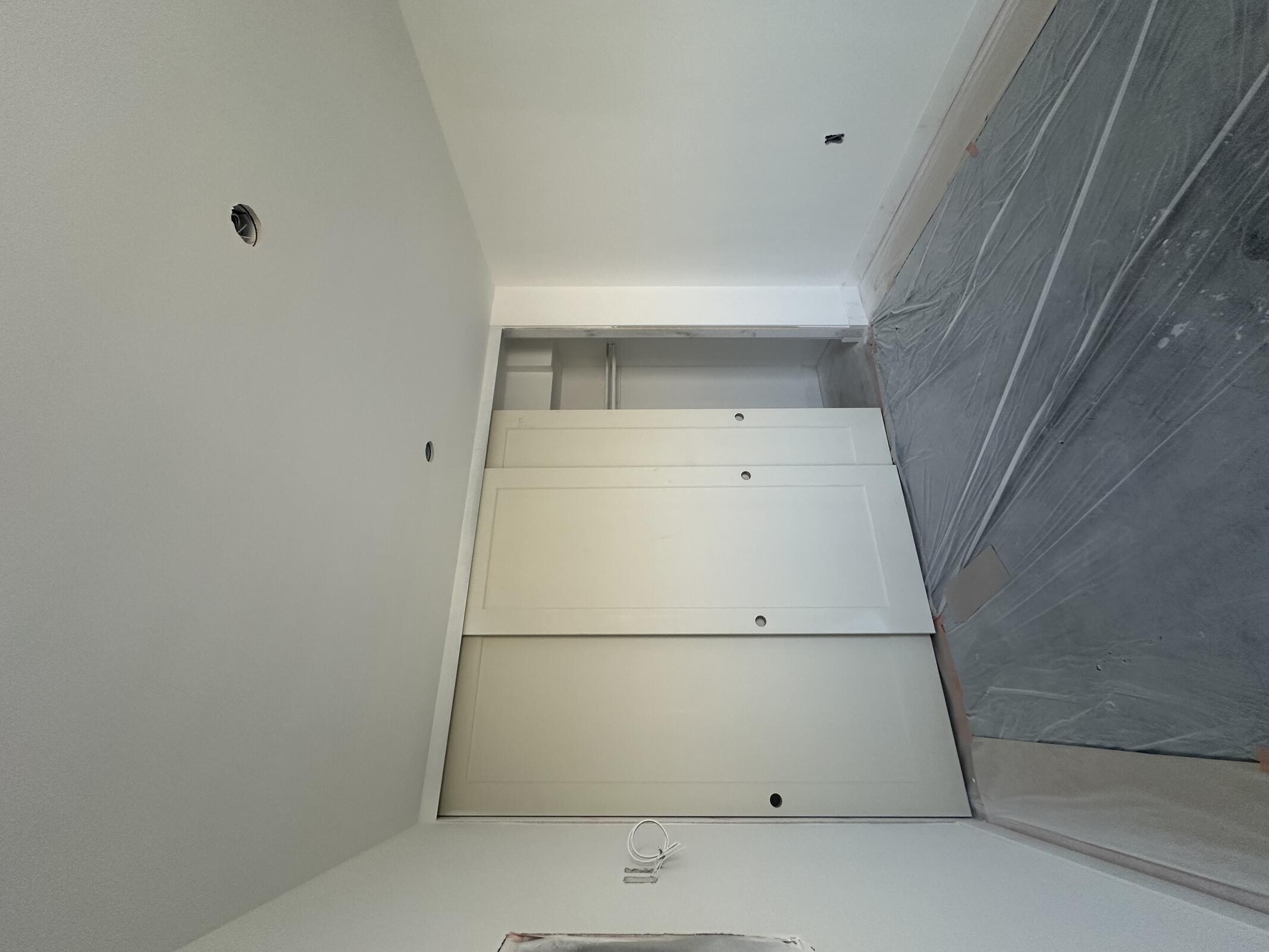

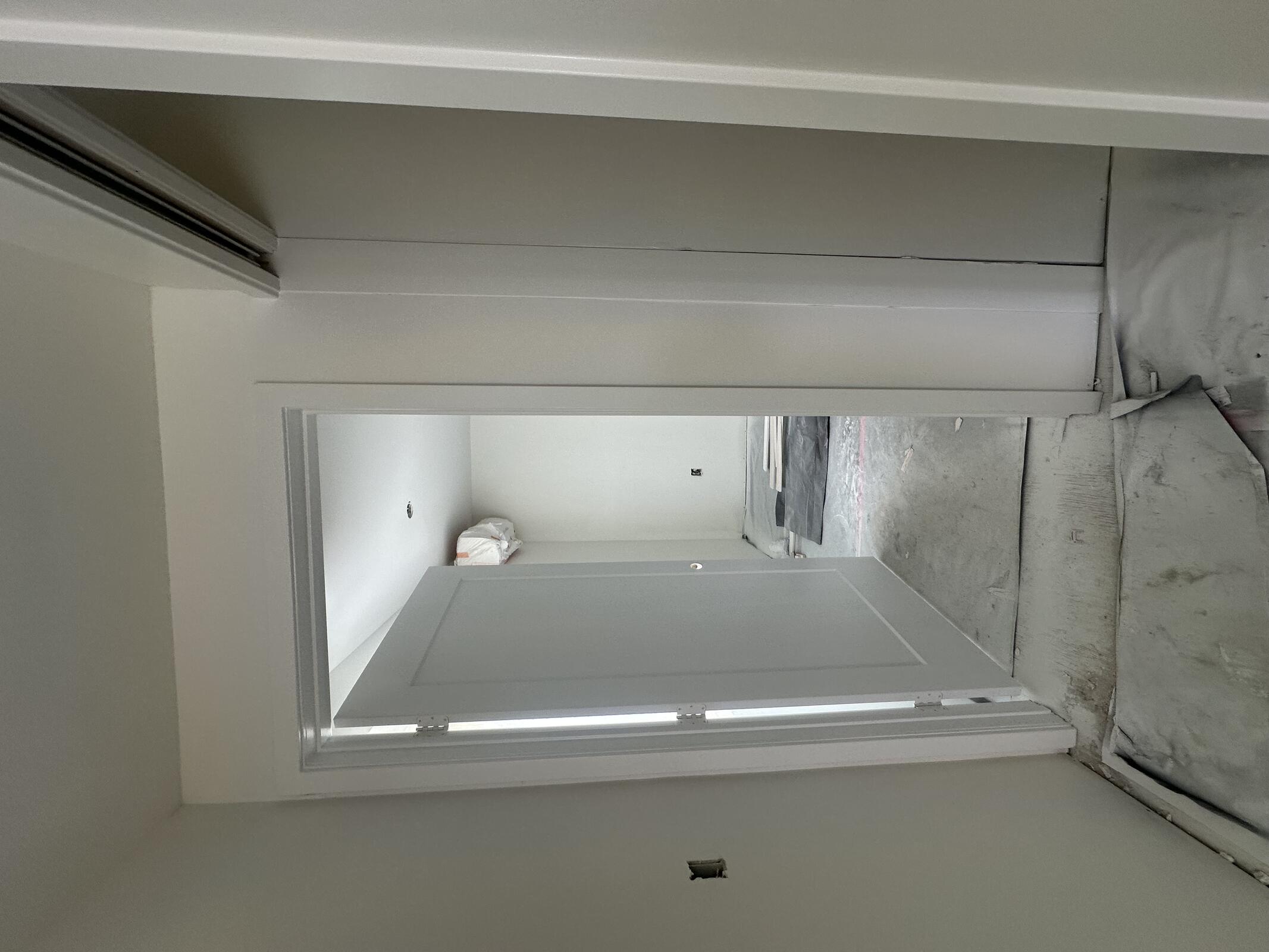

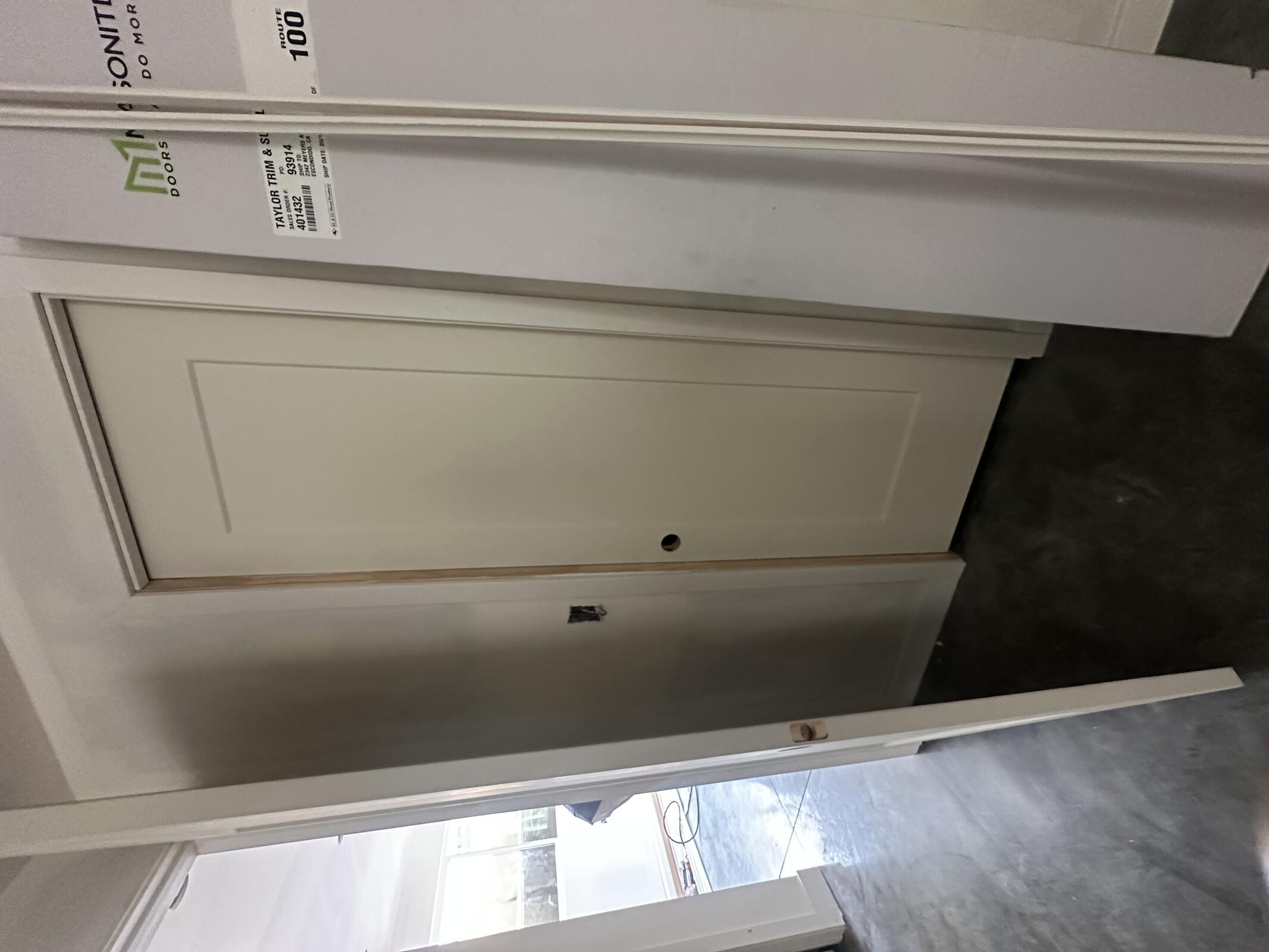

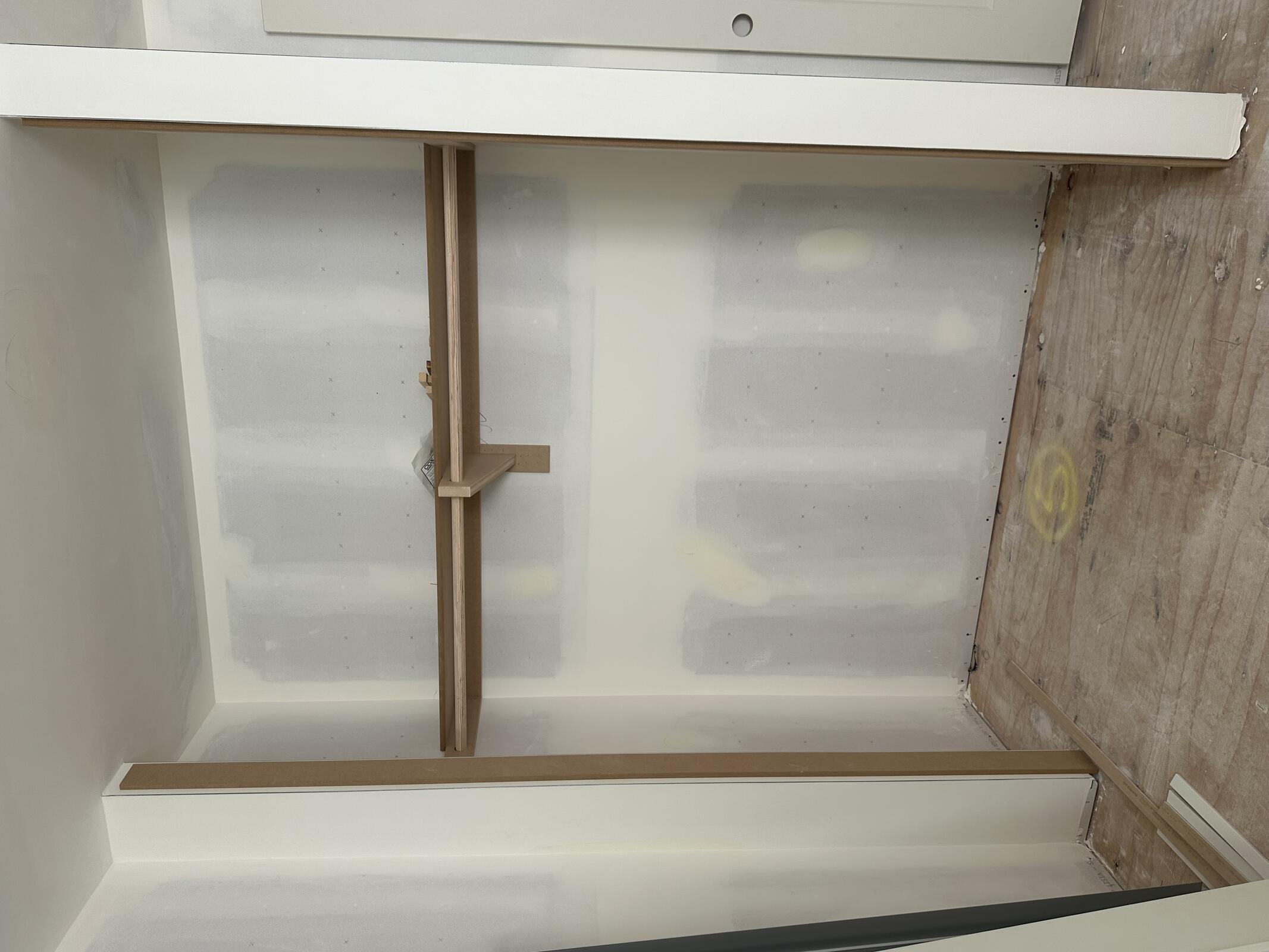

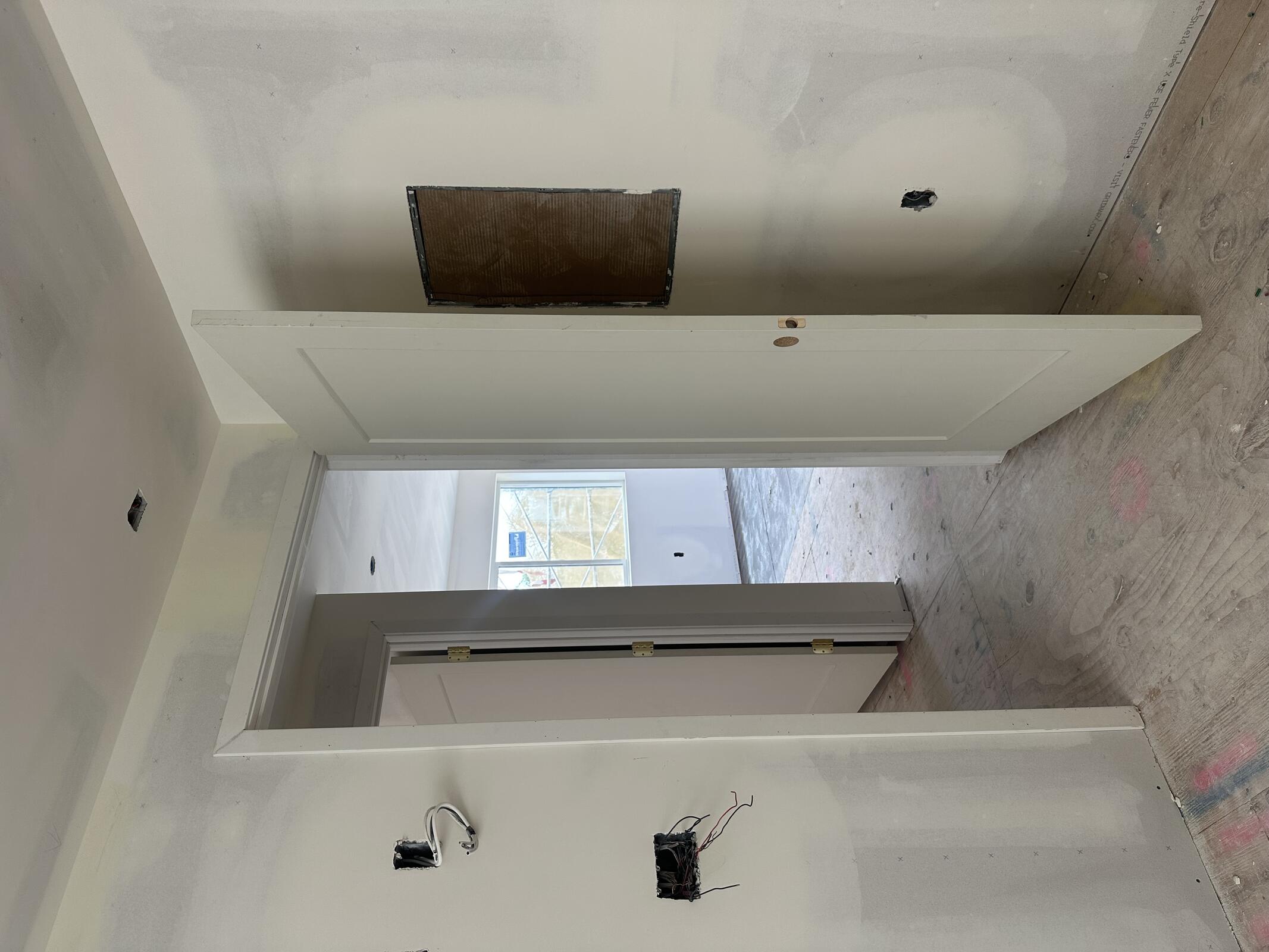

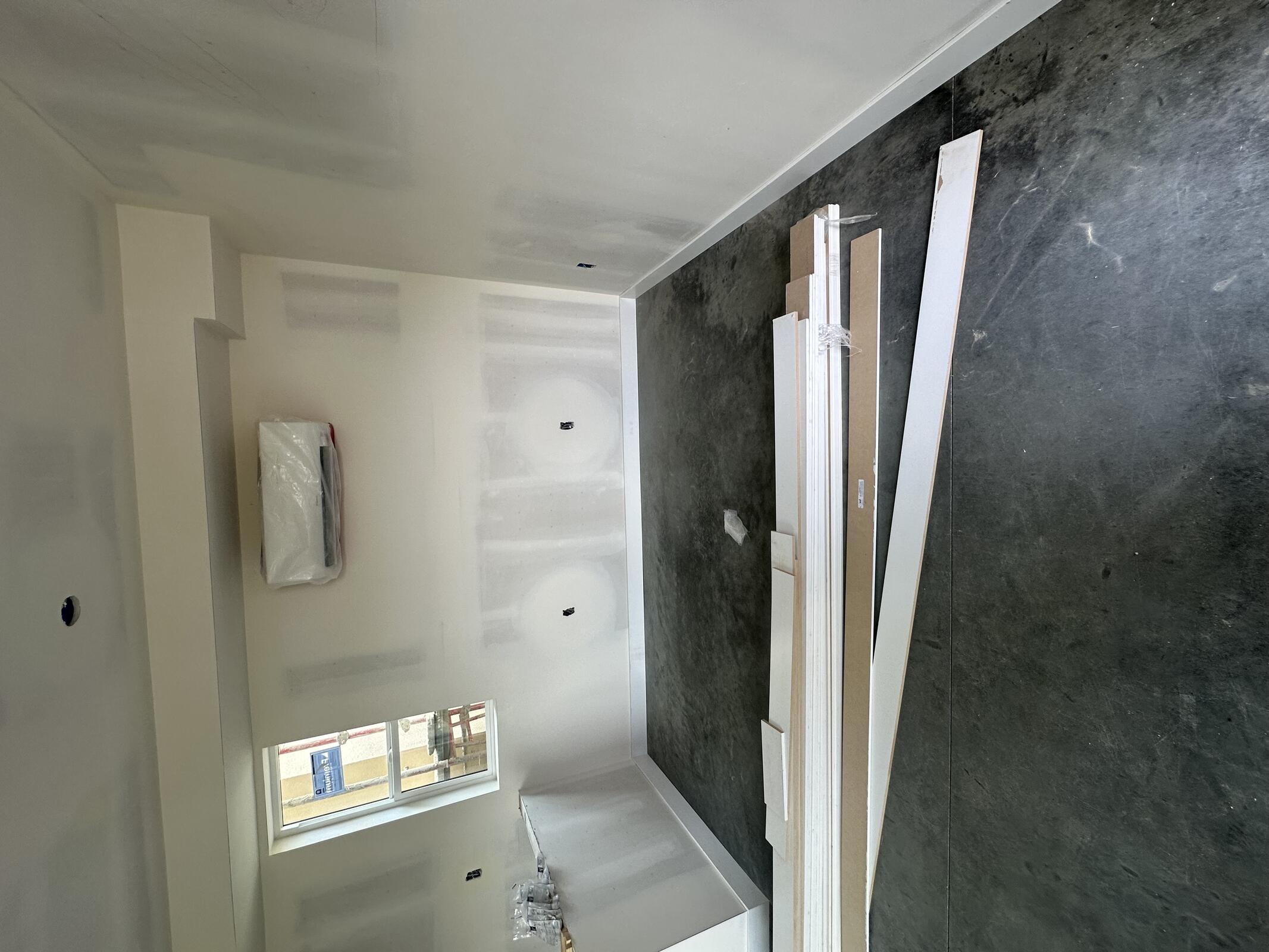

TT installing remaining interior doors. Bi-folds to be installed after paint. Baseboards installed at B1 and C1, in areas with no cabinets.
Marq papering areas for siding.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| Marq | 1 | 8 | 8 |
| Coastal | 1 | 8 | 8 |
| Taylor Trim | 2 | 8 | 16 |

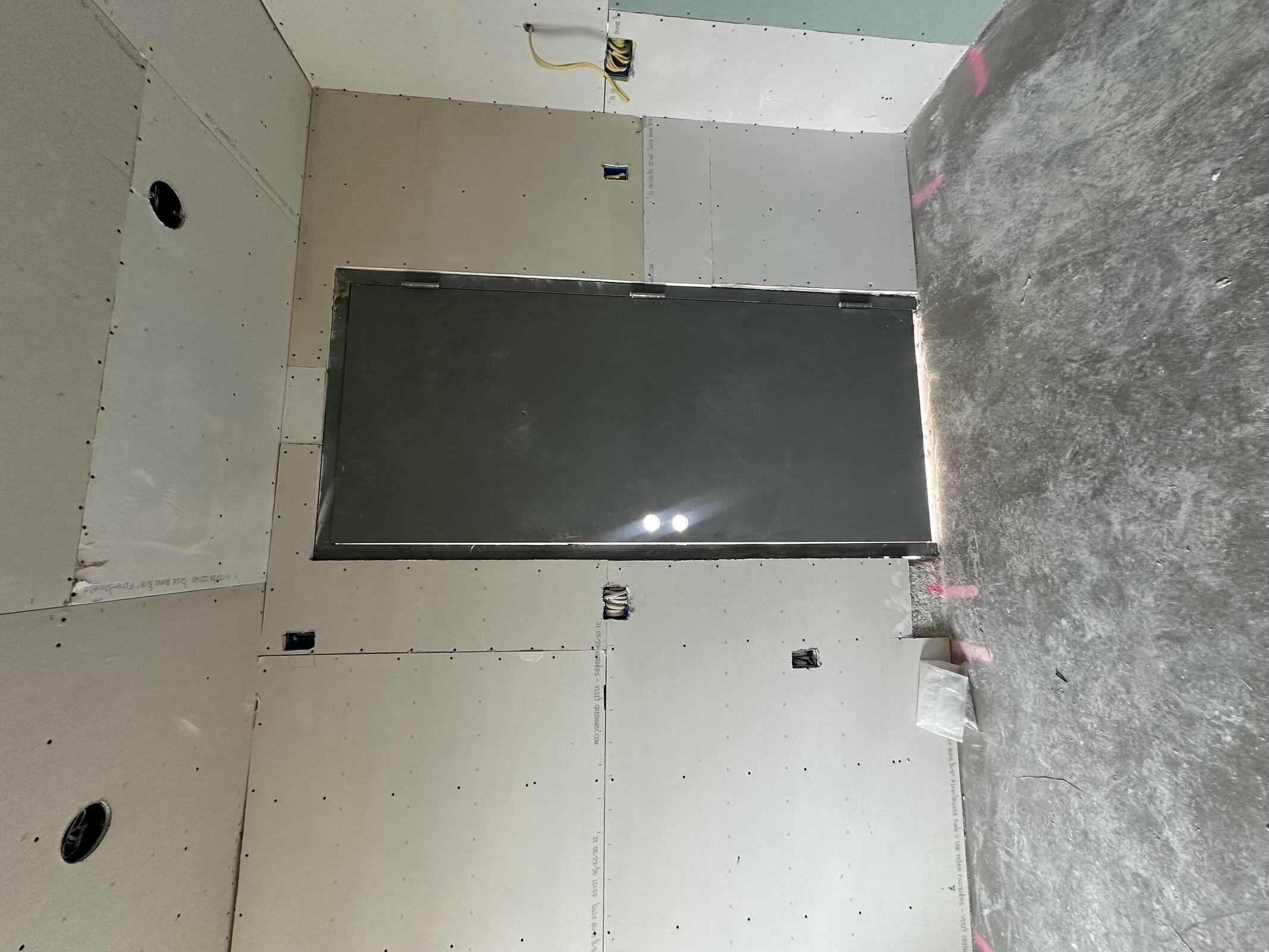

Inspection: Dave Finney on site at 10:50 for drywall screw inspection at Garage Conversion. Passed!
Delay: Electrical load issue has not been resolved with the city. 1070 still working on it. We will be ready to schedule SDGE electrification on Wednesday, when scaffolding comes down.

Tuesday, June 16, 2026
Clear, 74°F
Aquasoltech installing gutters and downspouts on B and C.
Marq fogcoating and cleaning at B&C and installing paper, foam and lath at the garage.

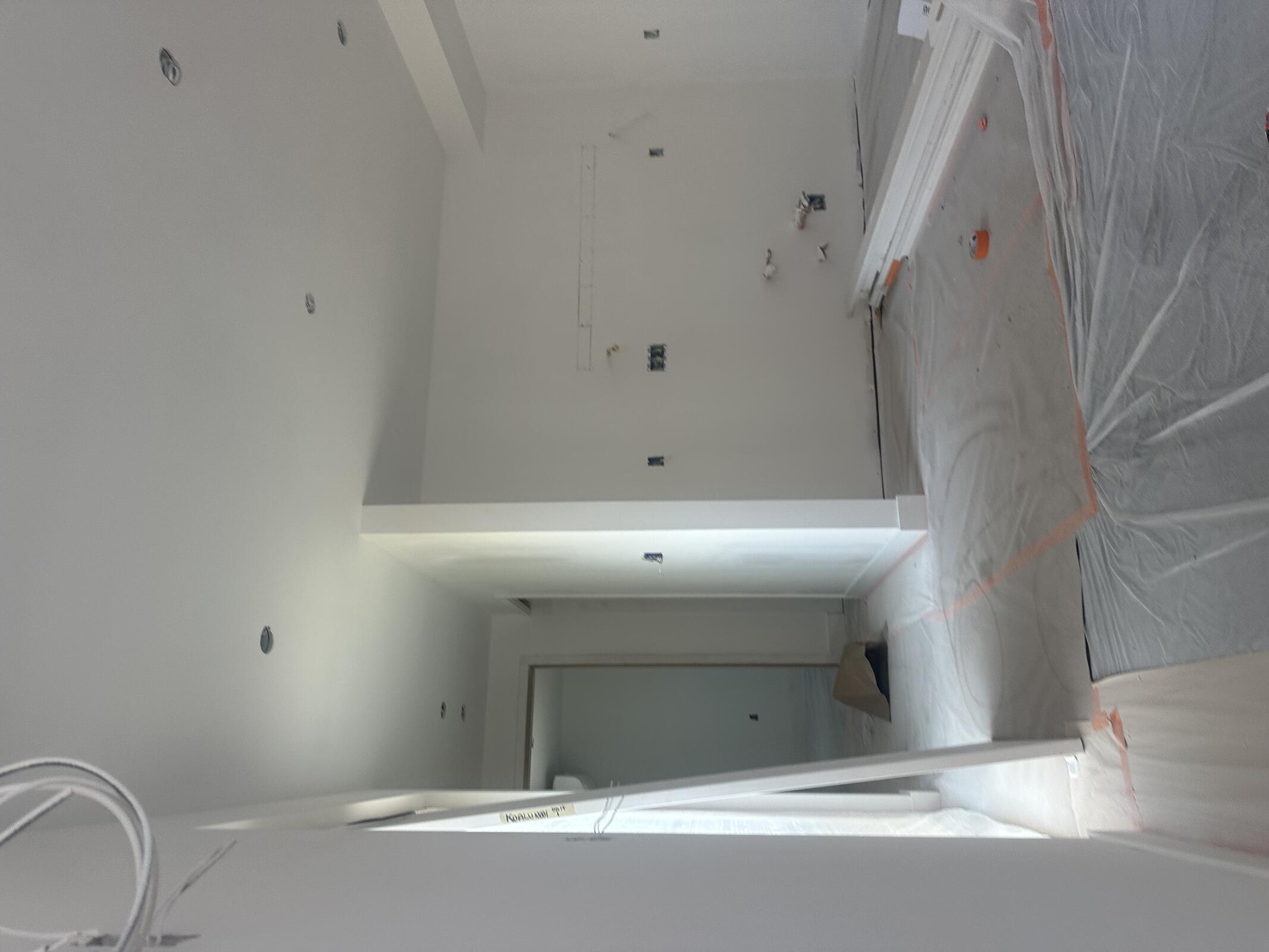

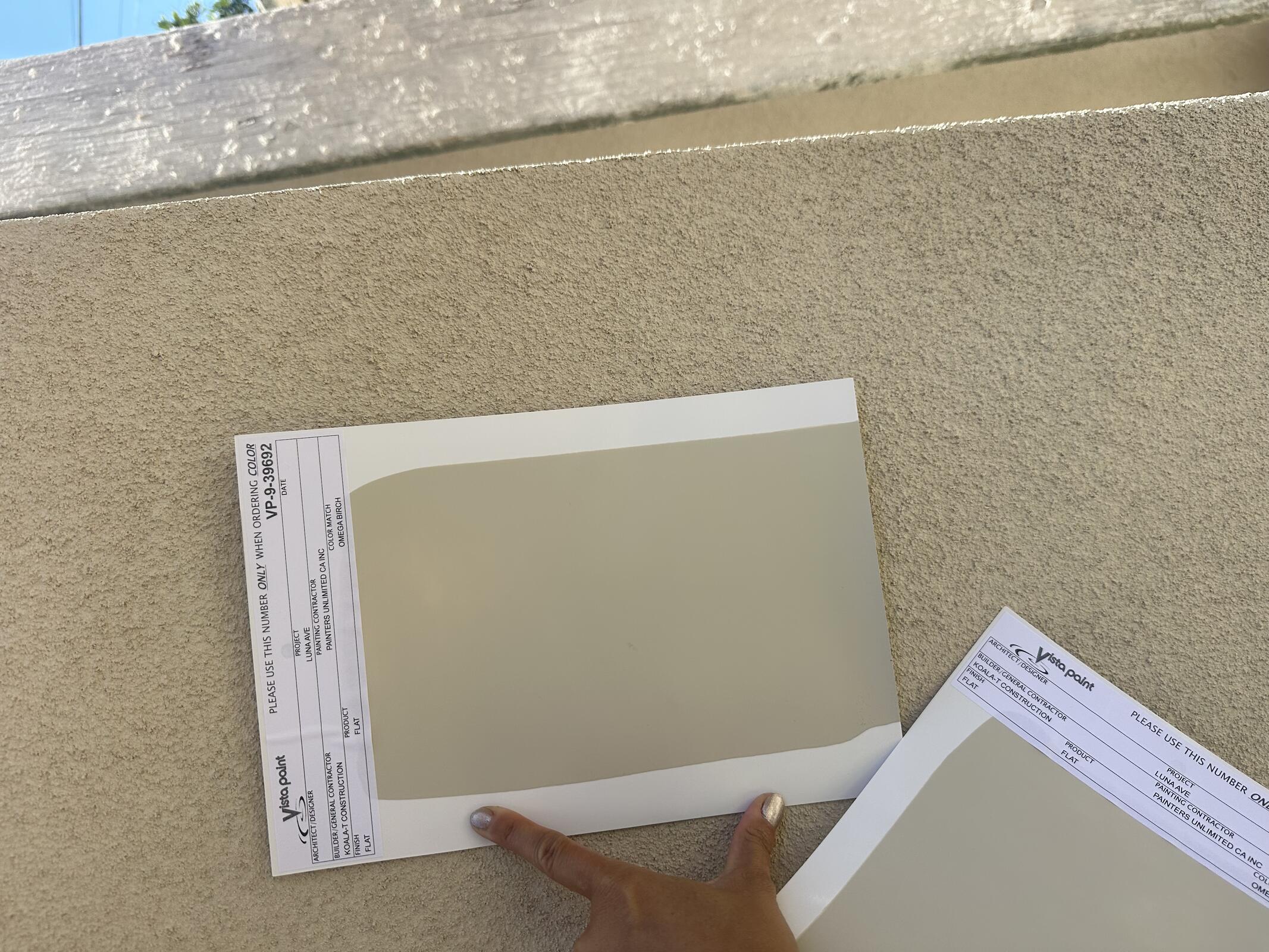

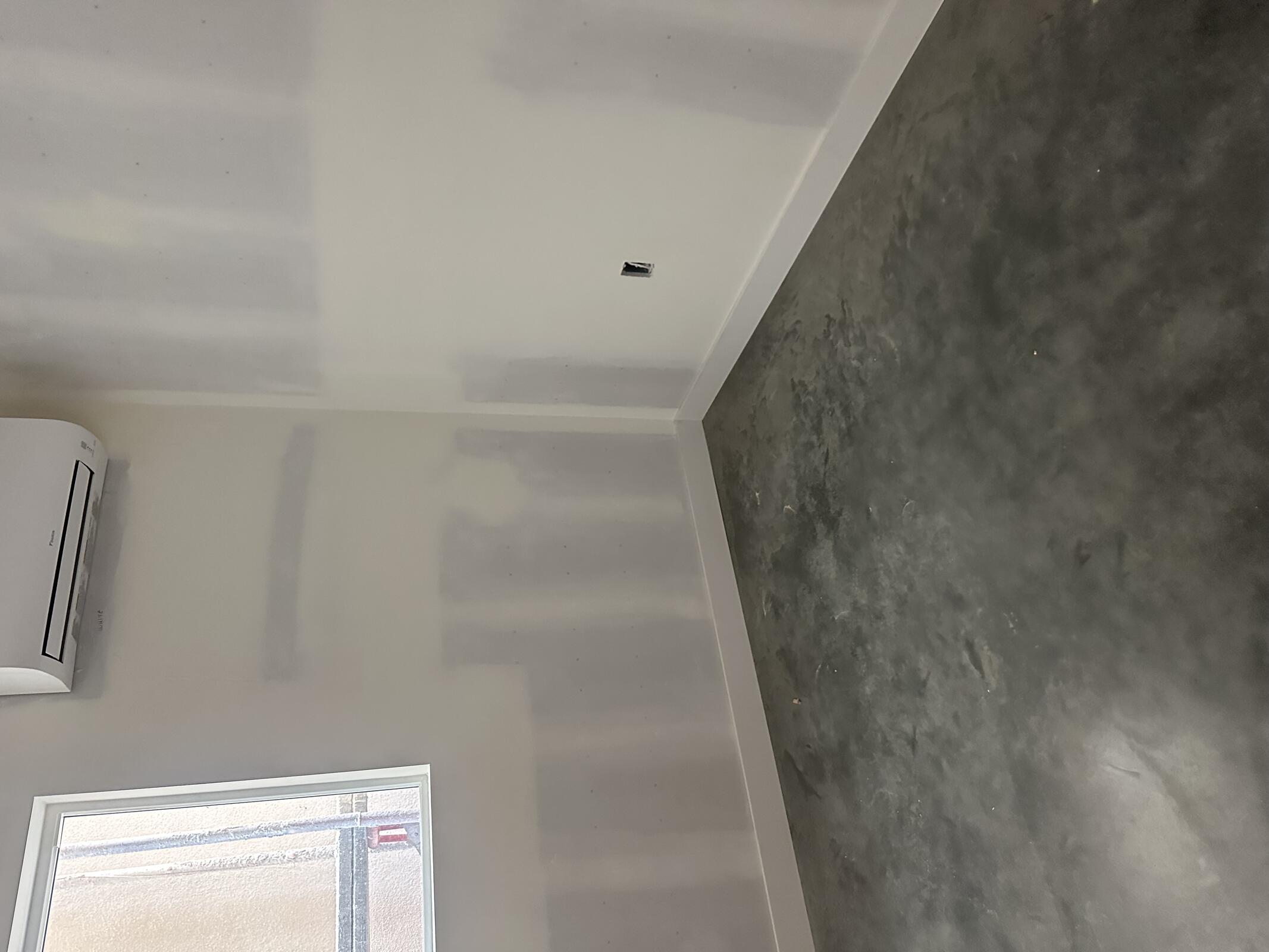

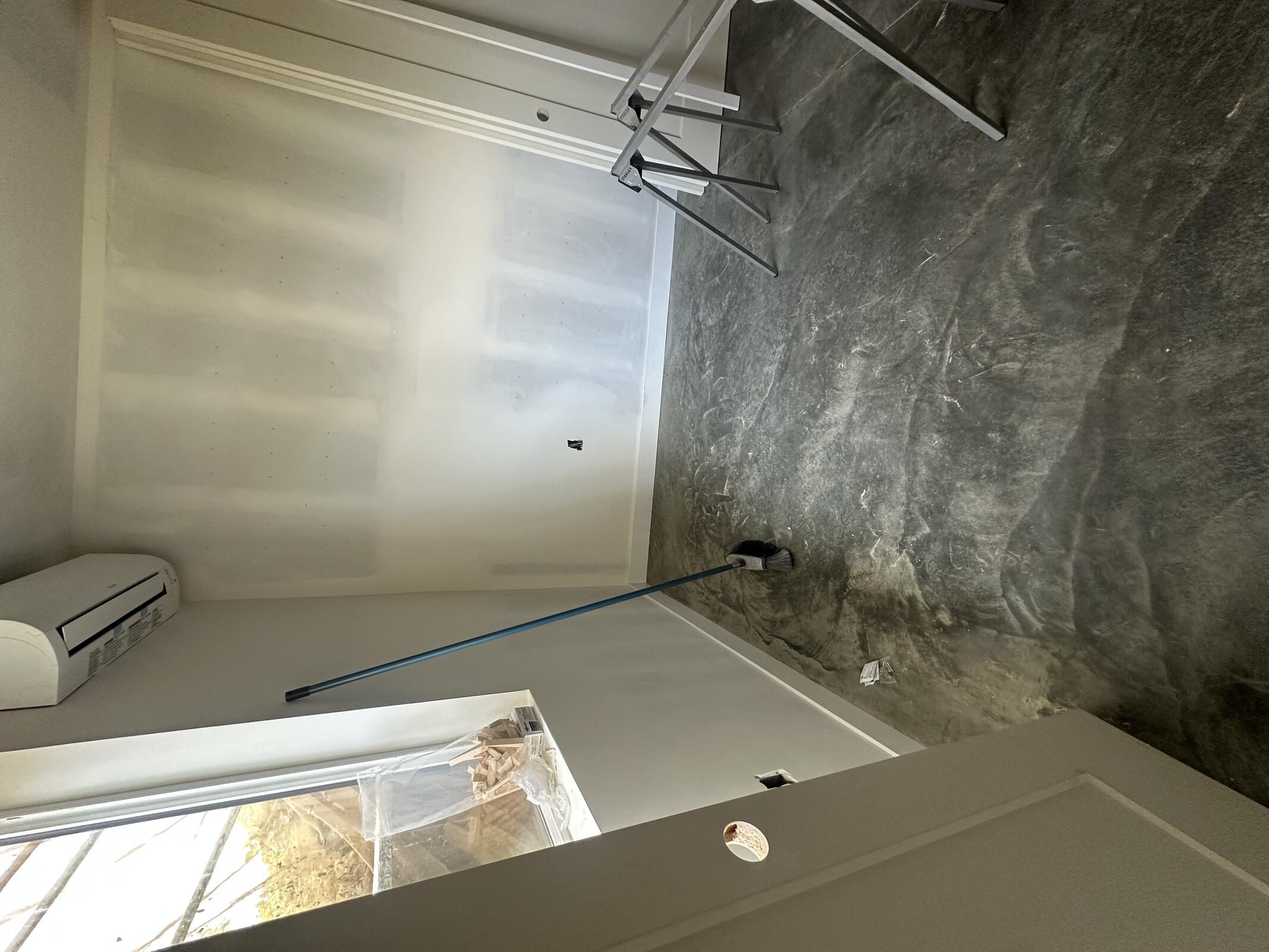

Painters Unlimited priming and painting first coat at B and C.
TDI taping garage.

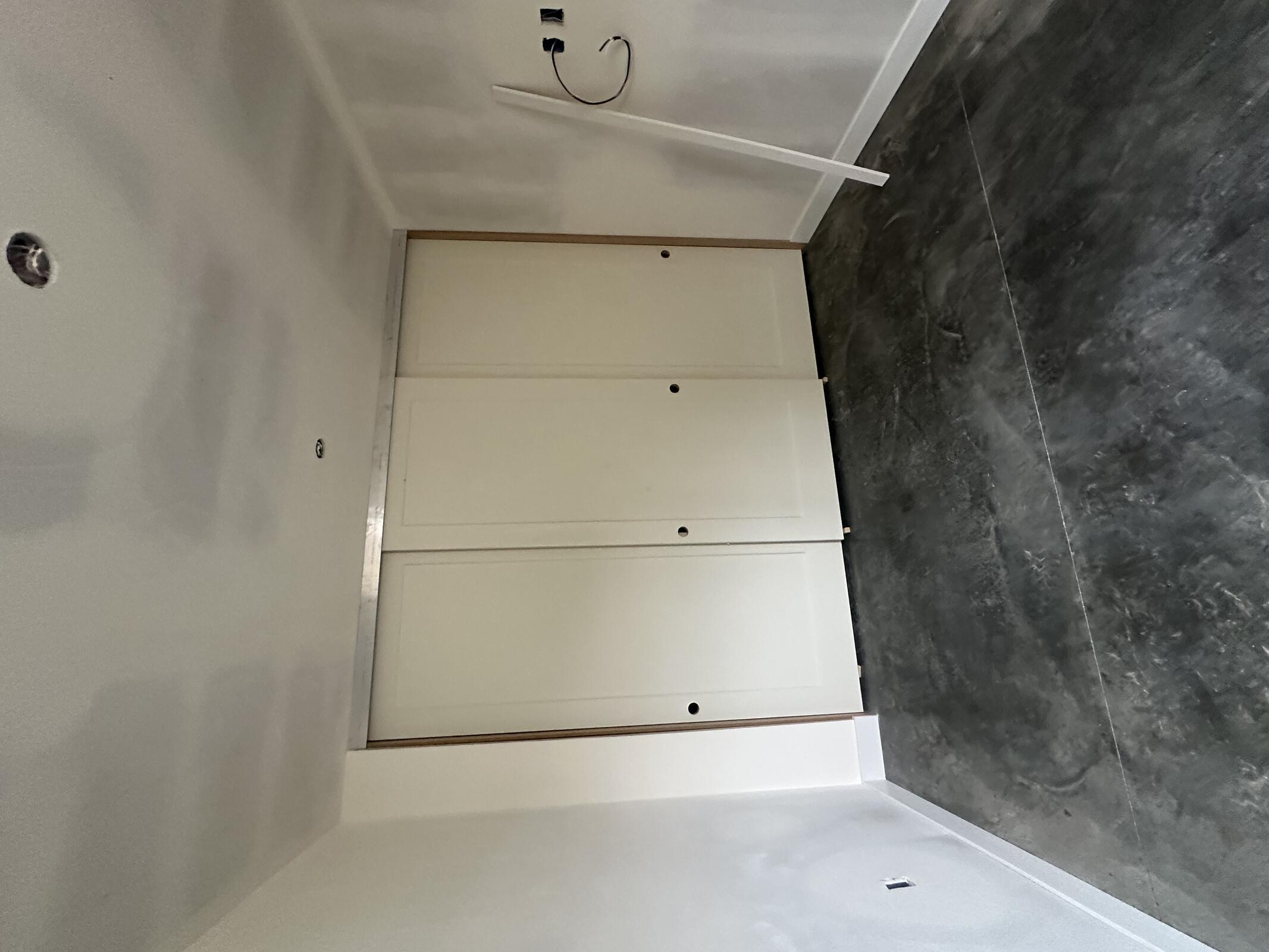

Coastal waterproofing garage shower walls.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| Aquasoltech | 2 | 8 | 16 |
| Marq | 5 | 8 | 40 |
| Painters Unlimited | 4 | 8 | 32 |
| TDI | 5 | 4 | 20 |
Coastal - 1 worker, 4 hours
Inspection: N/A
Delay: Call with 1070, Flores, and Michael Walker, regarding electrical delay. Sean (1070) and Sam (Flores) working on scheduling a meeting with Gino (Assistant Deputy Director, City of San Diego).

Wednesday, June 17, 2026
Partially cloudy, 73°F

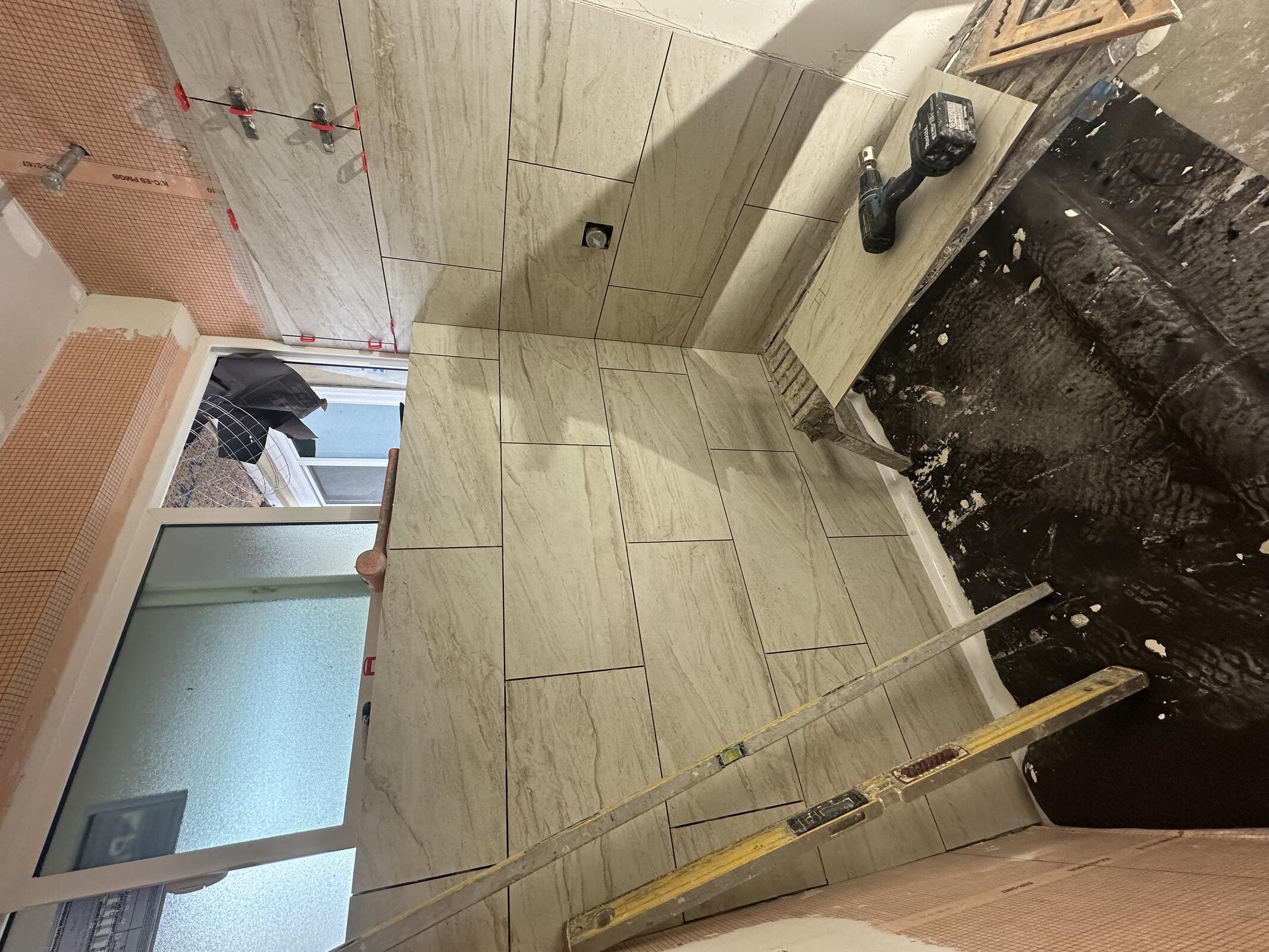

Coastal laying out wall tile at garage conversion shower.

ZSP relocating water lines between garage and existing duplex.

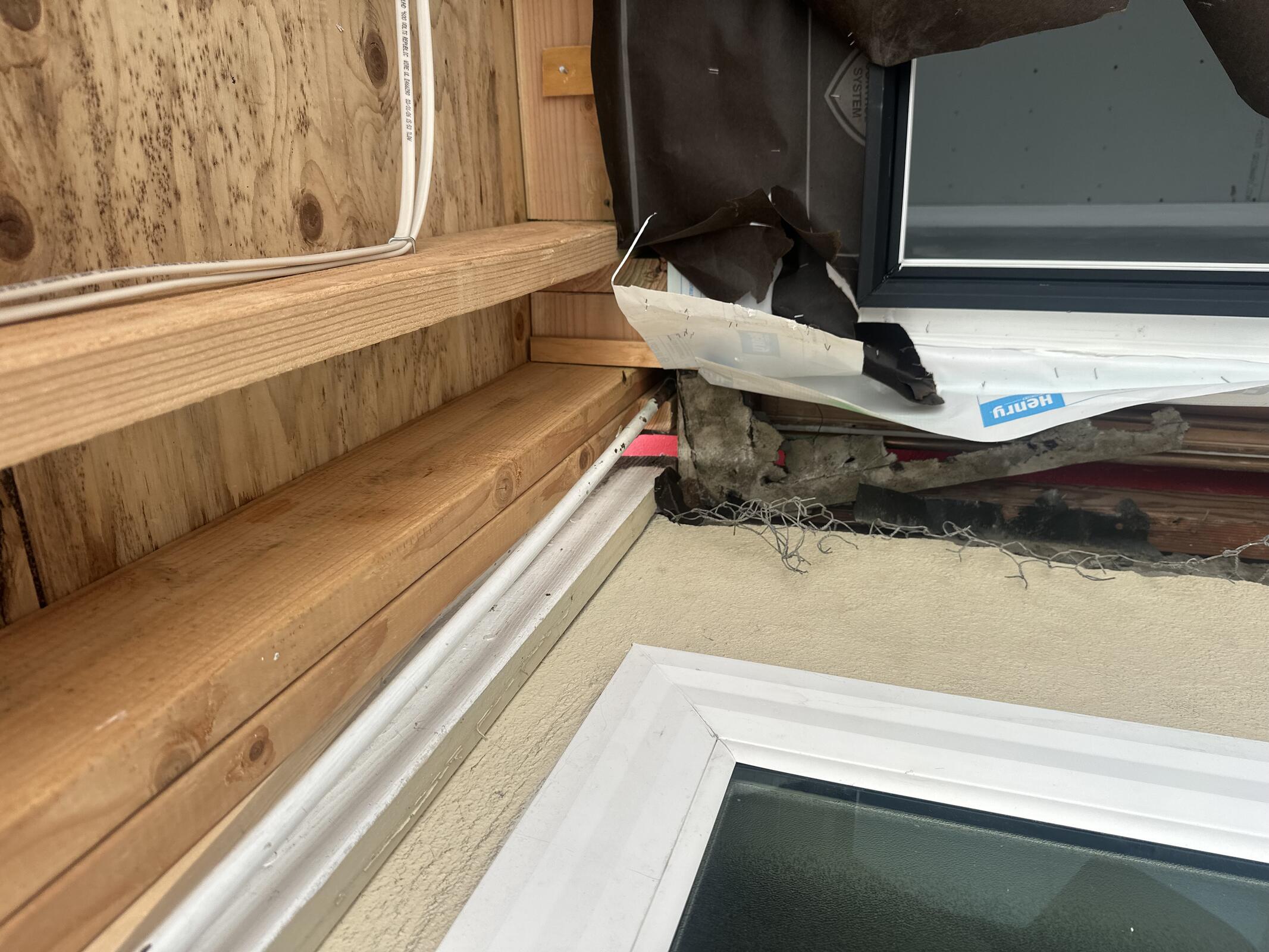

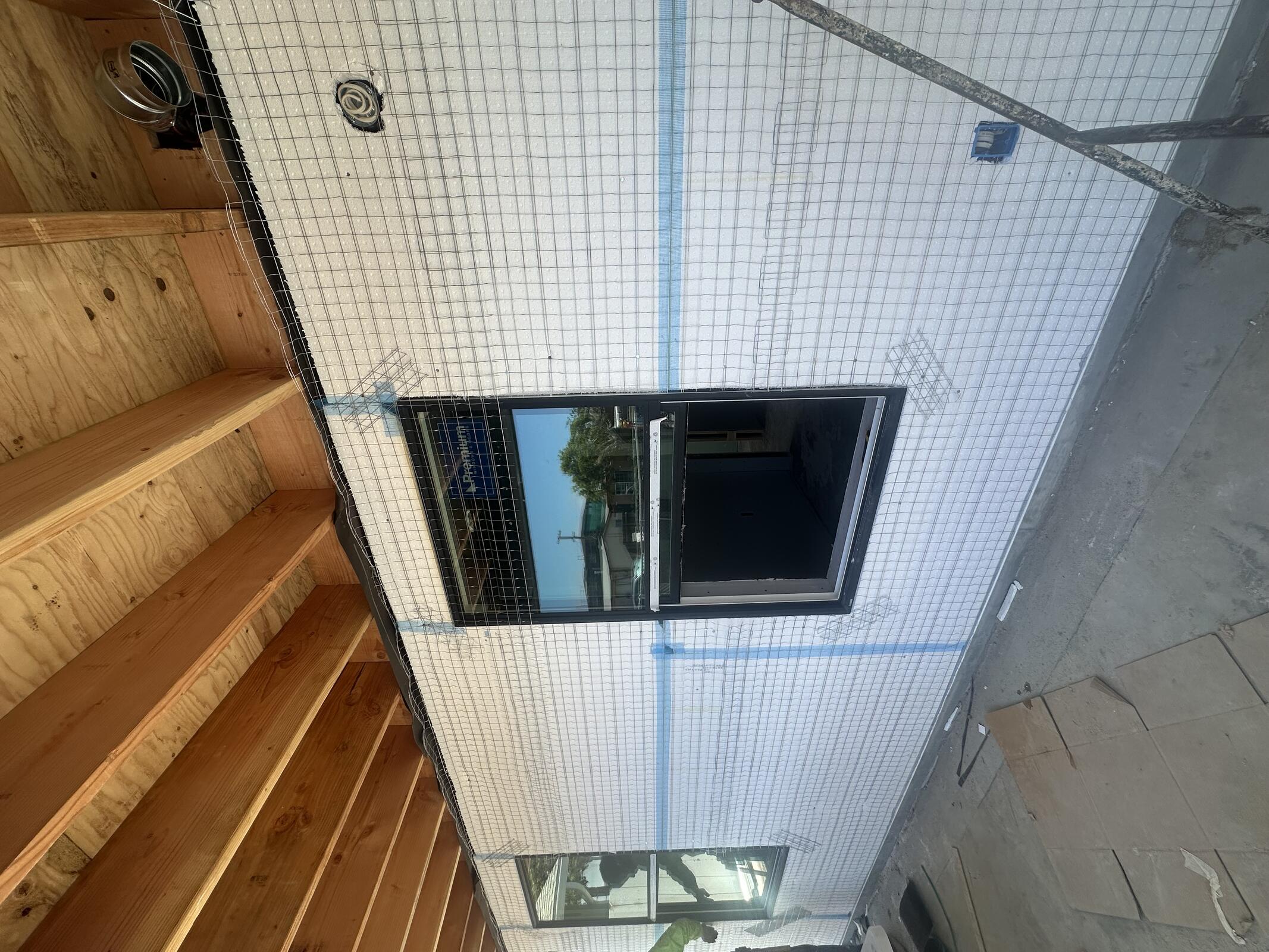

Marq installing siding at B and C.

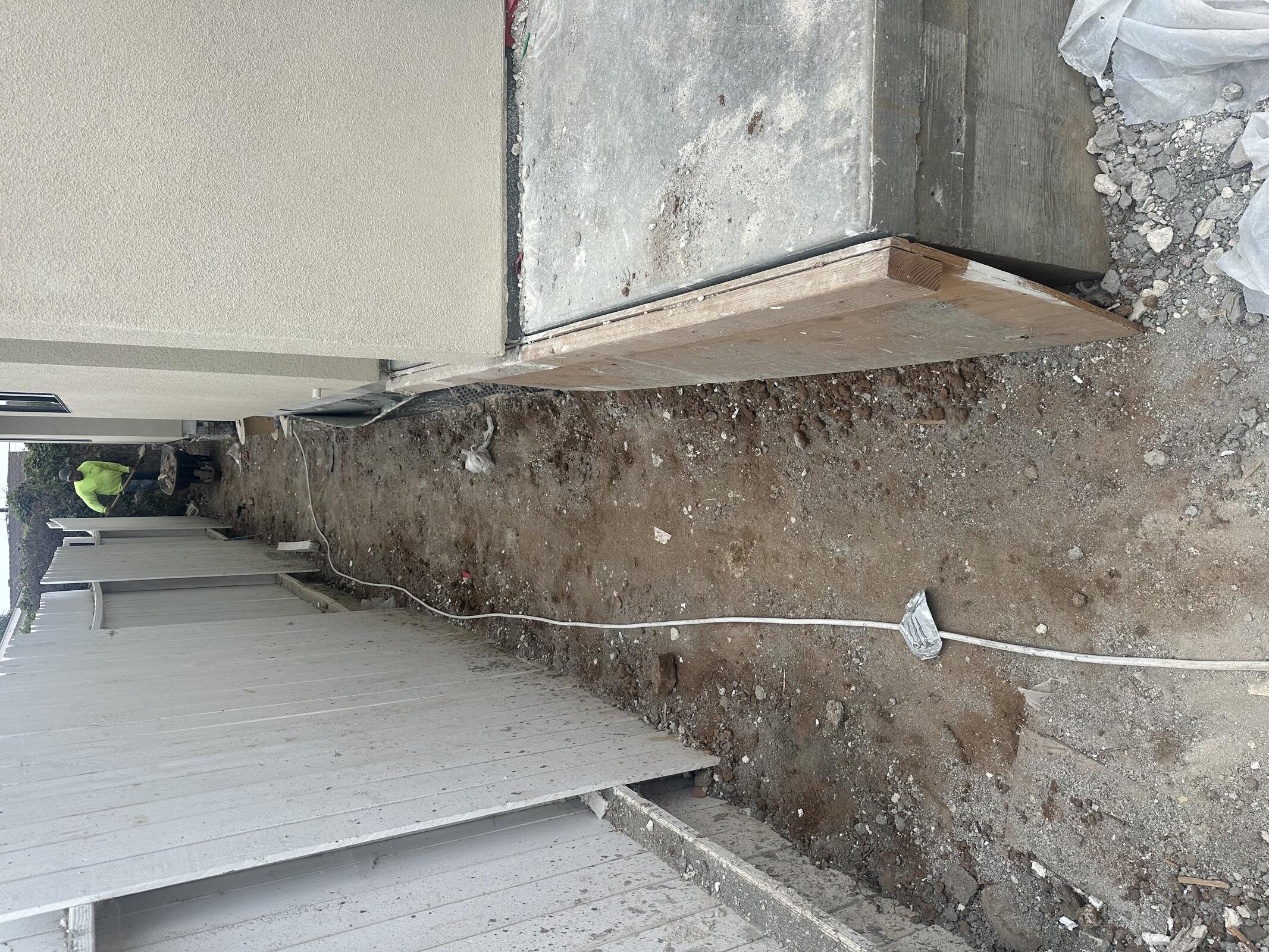

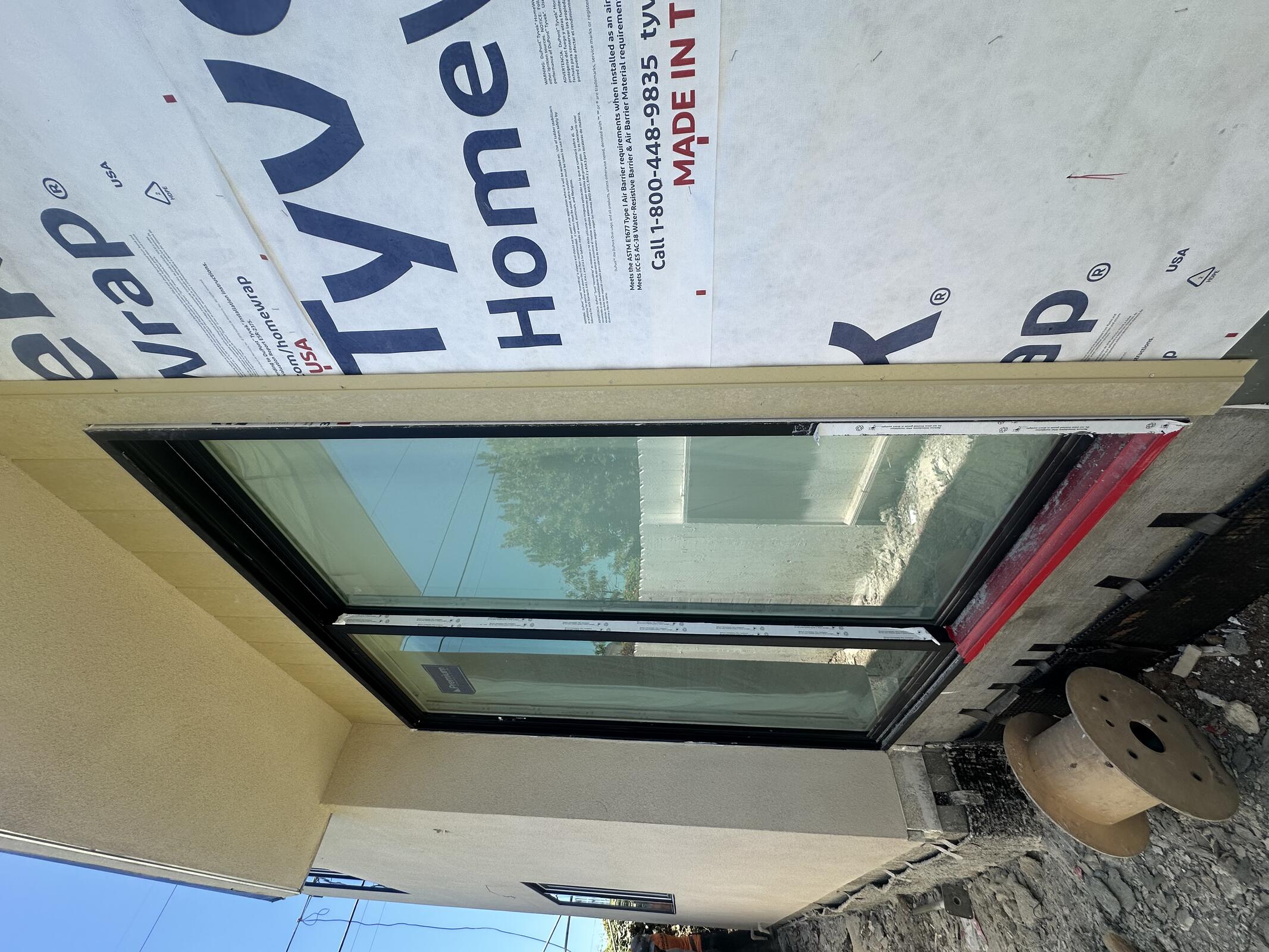

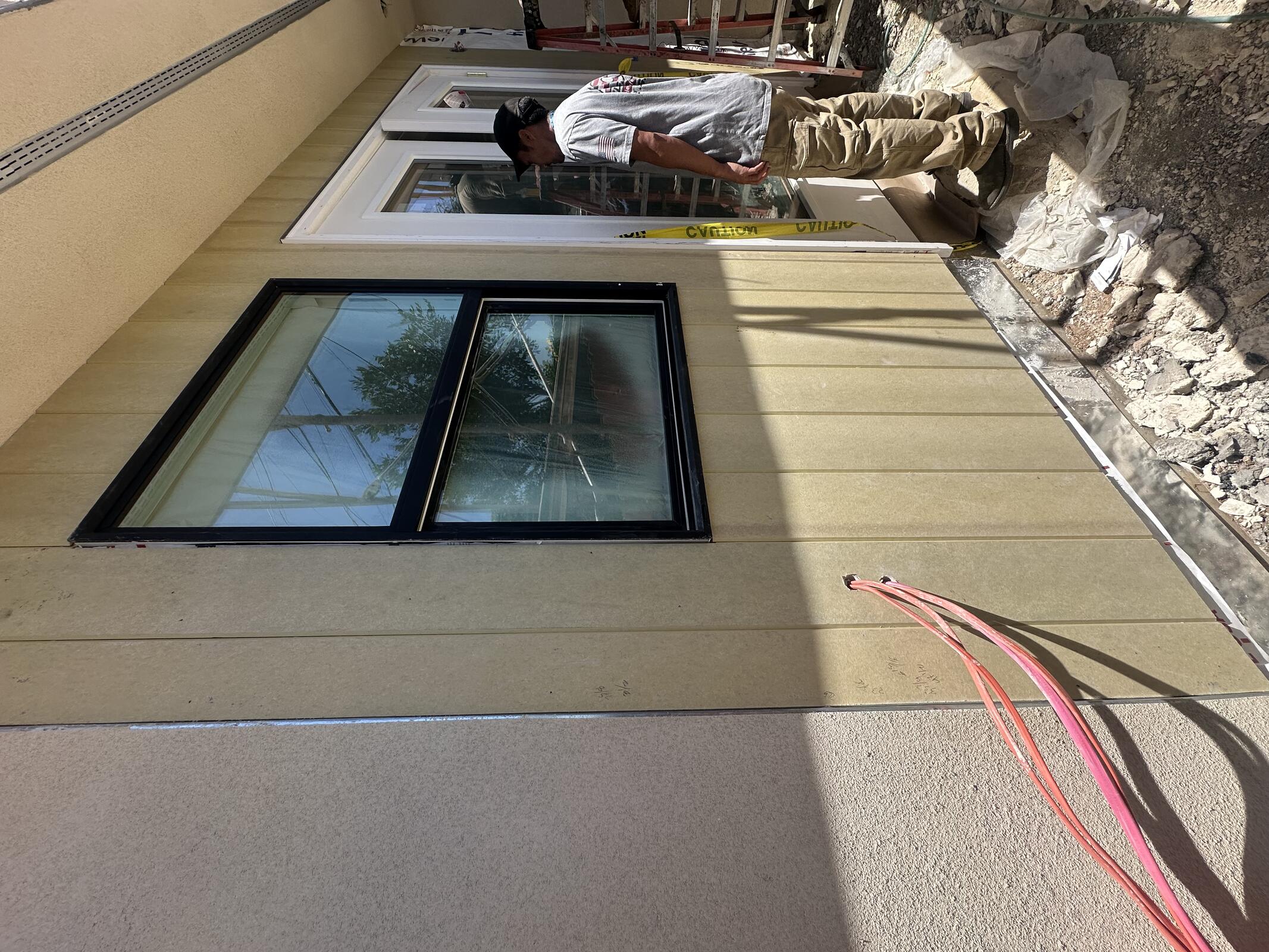

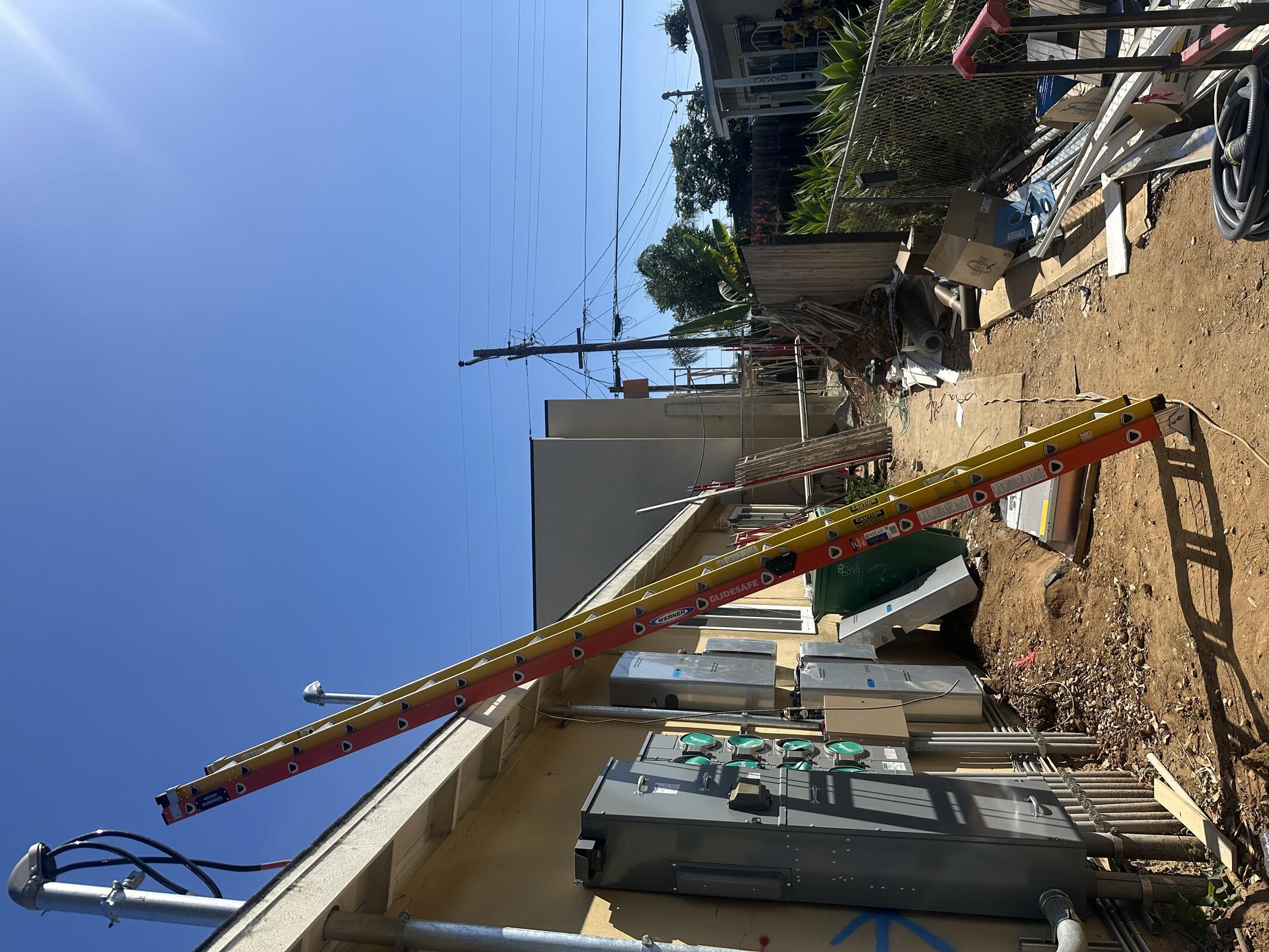

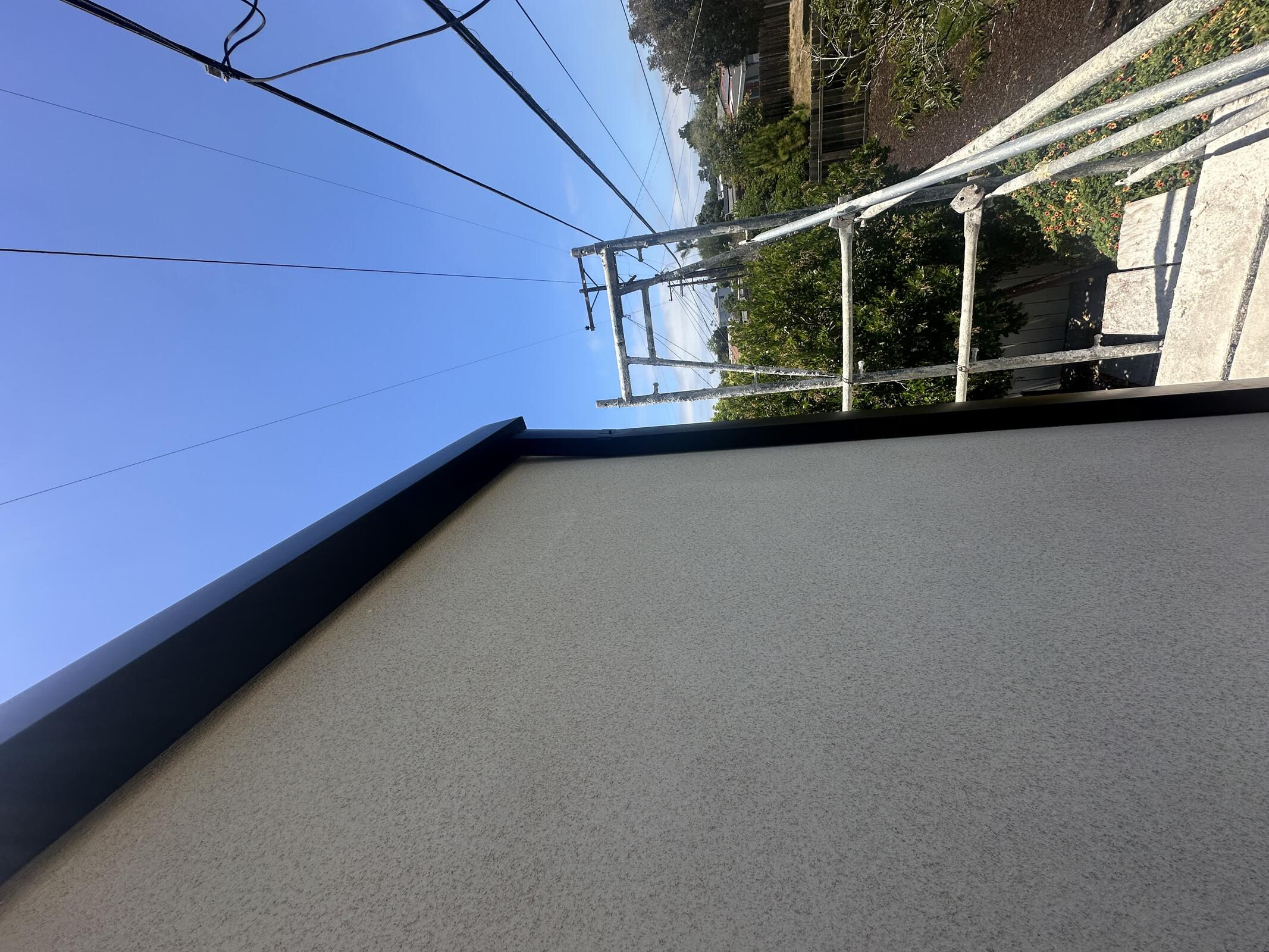

Scaffolding coming down.

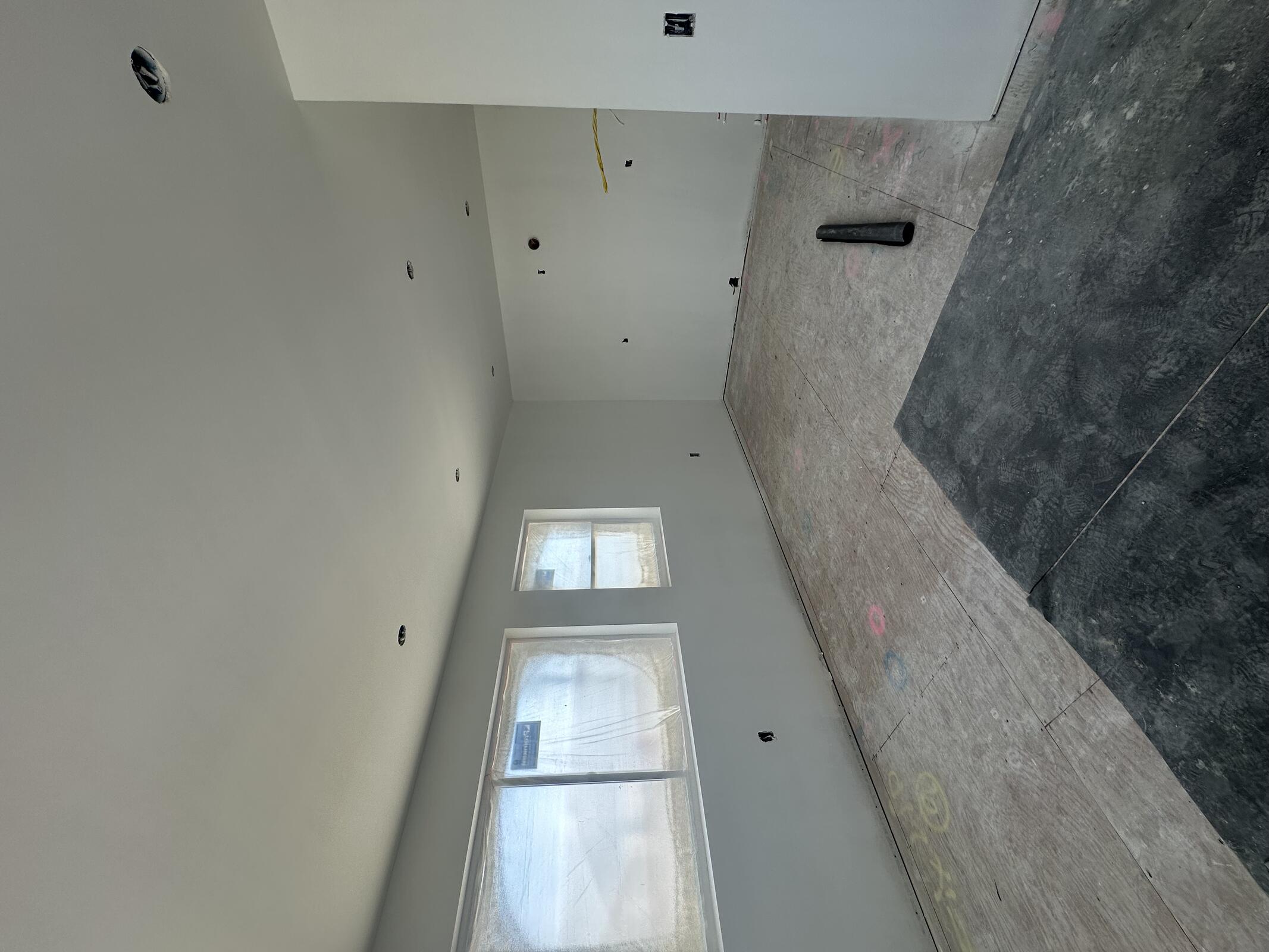

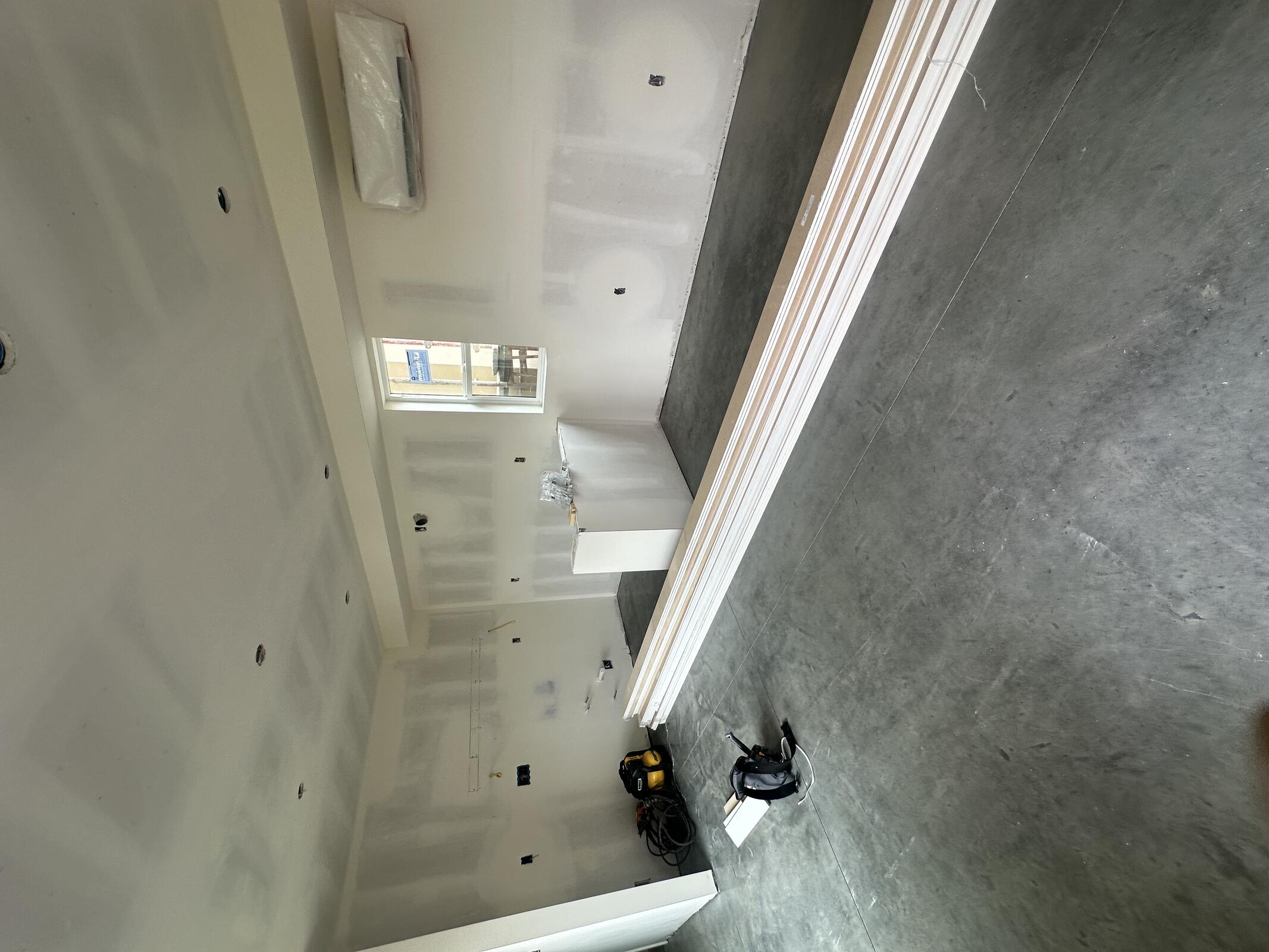

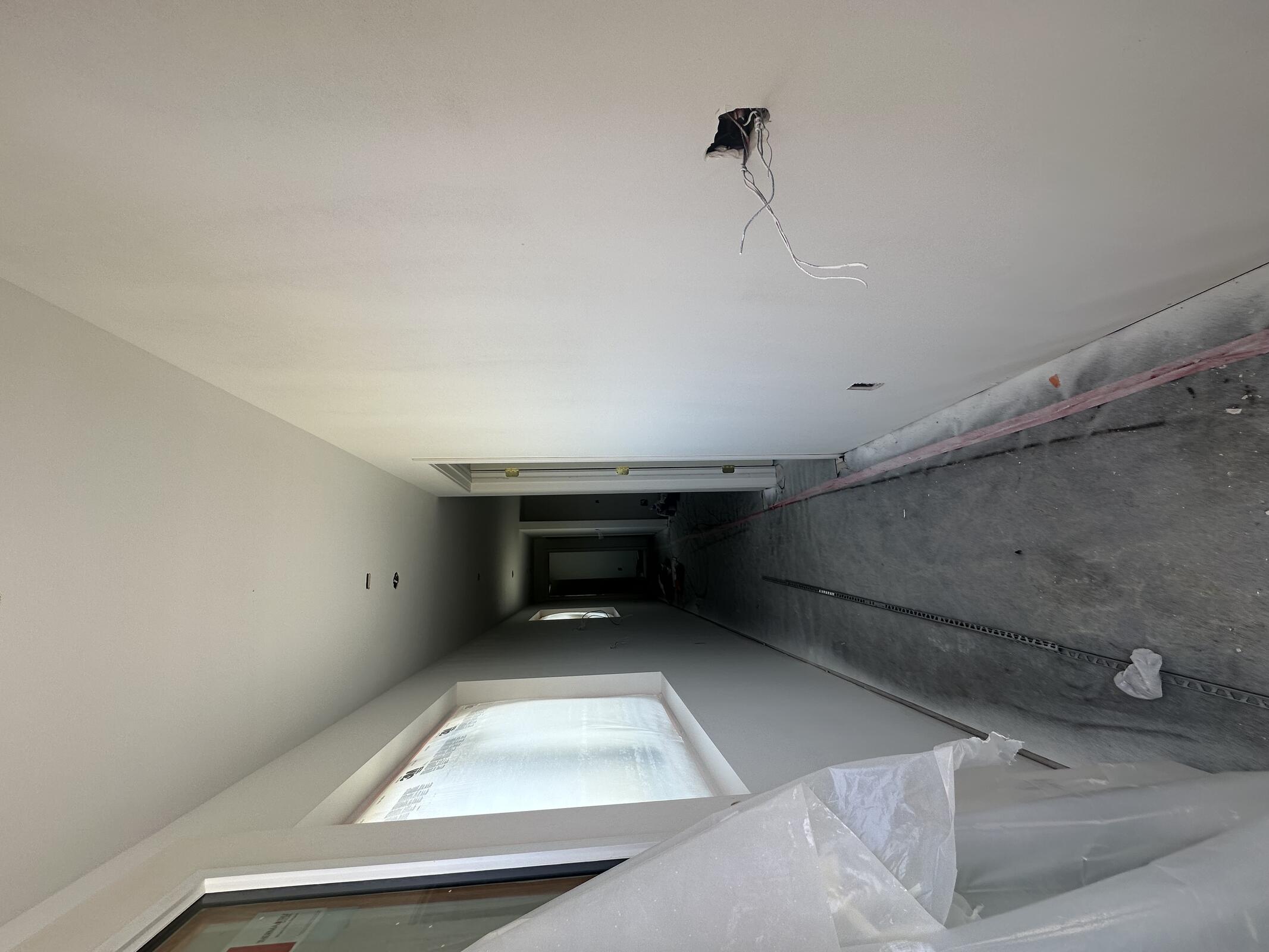

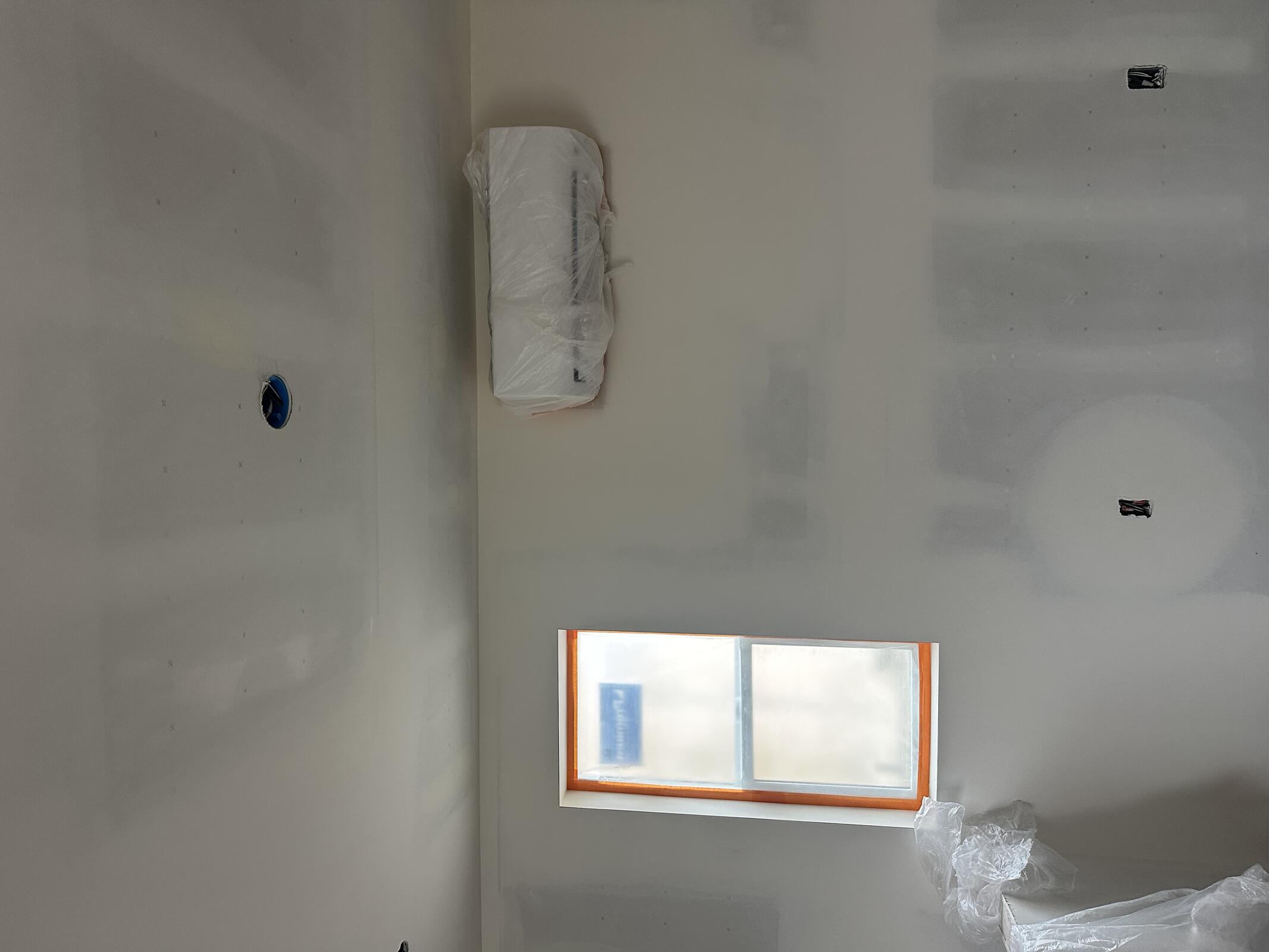

TDI patching drywall cuts at kitchen.

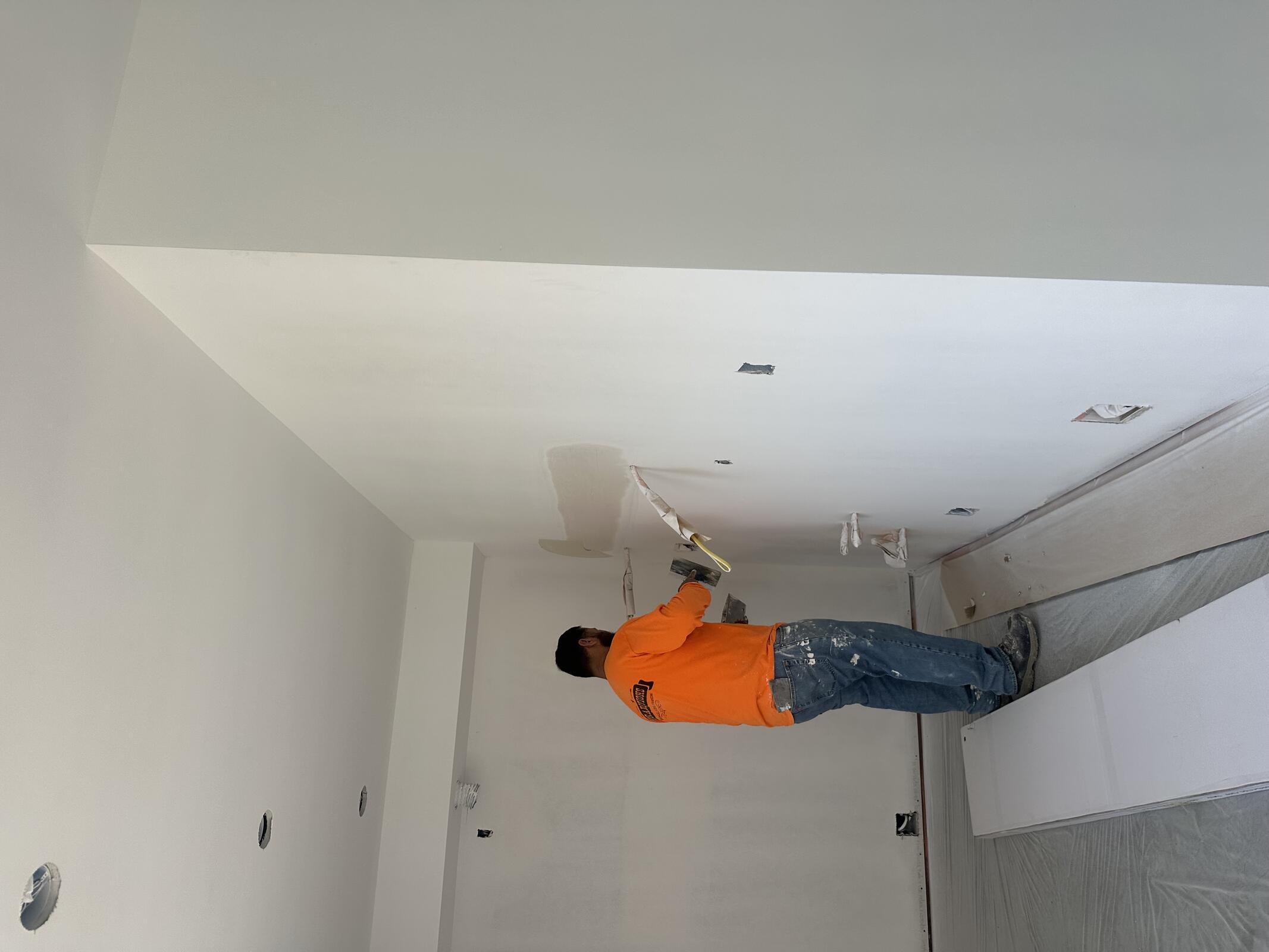

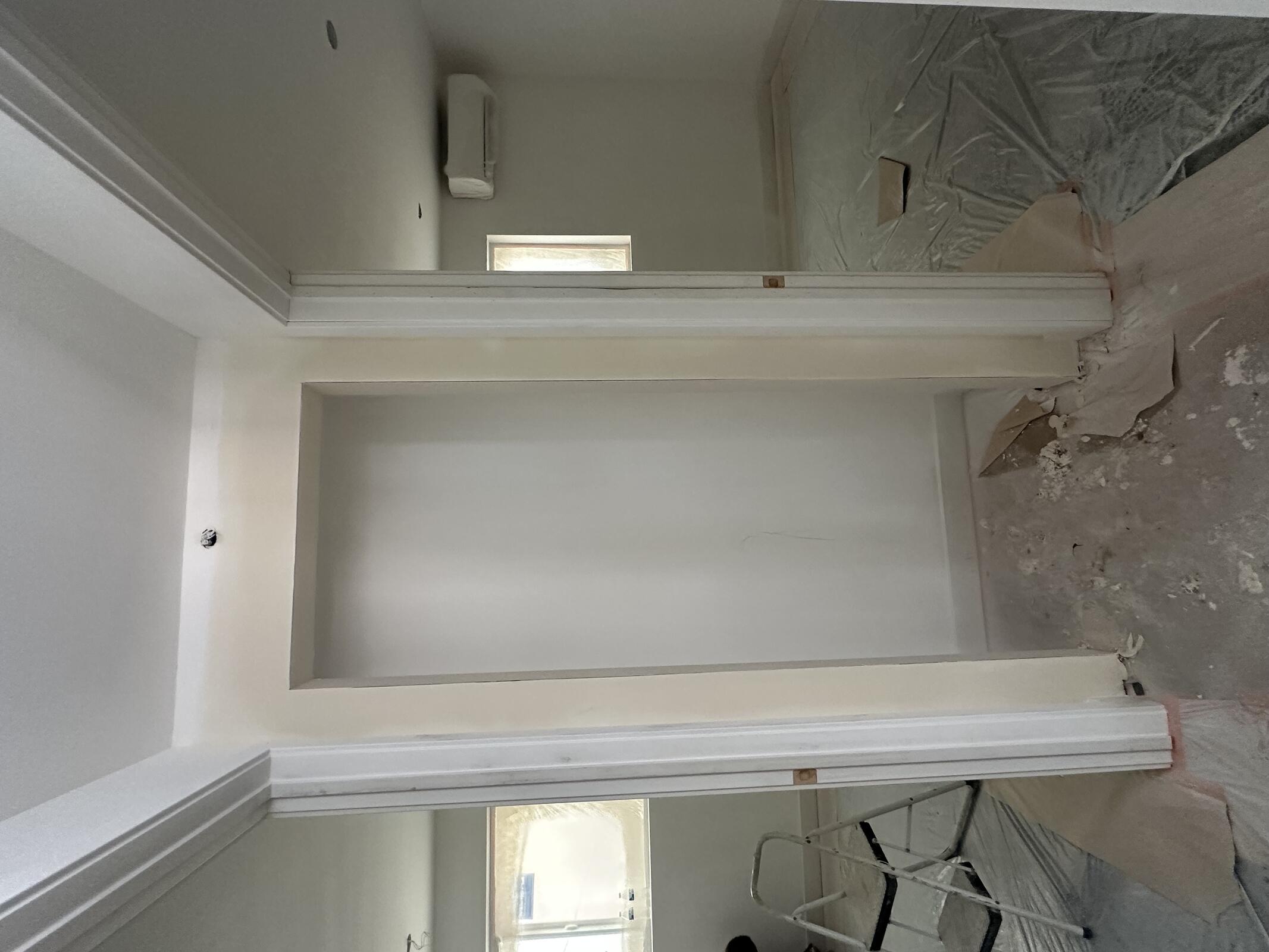

Painters unlimited continuing to paint B and C.

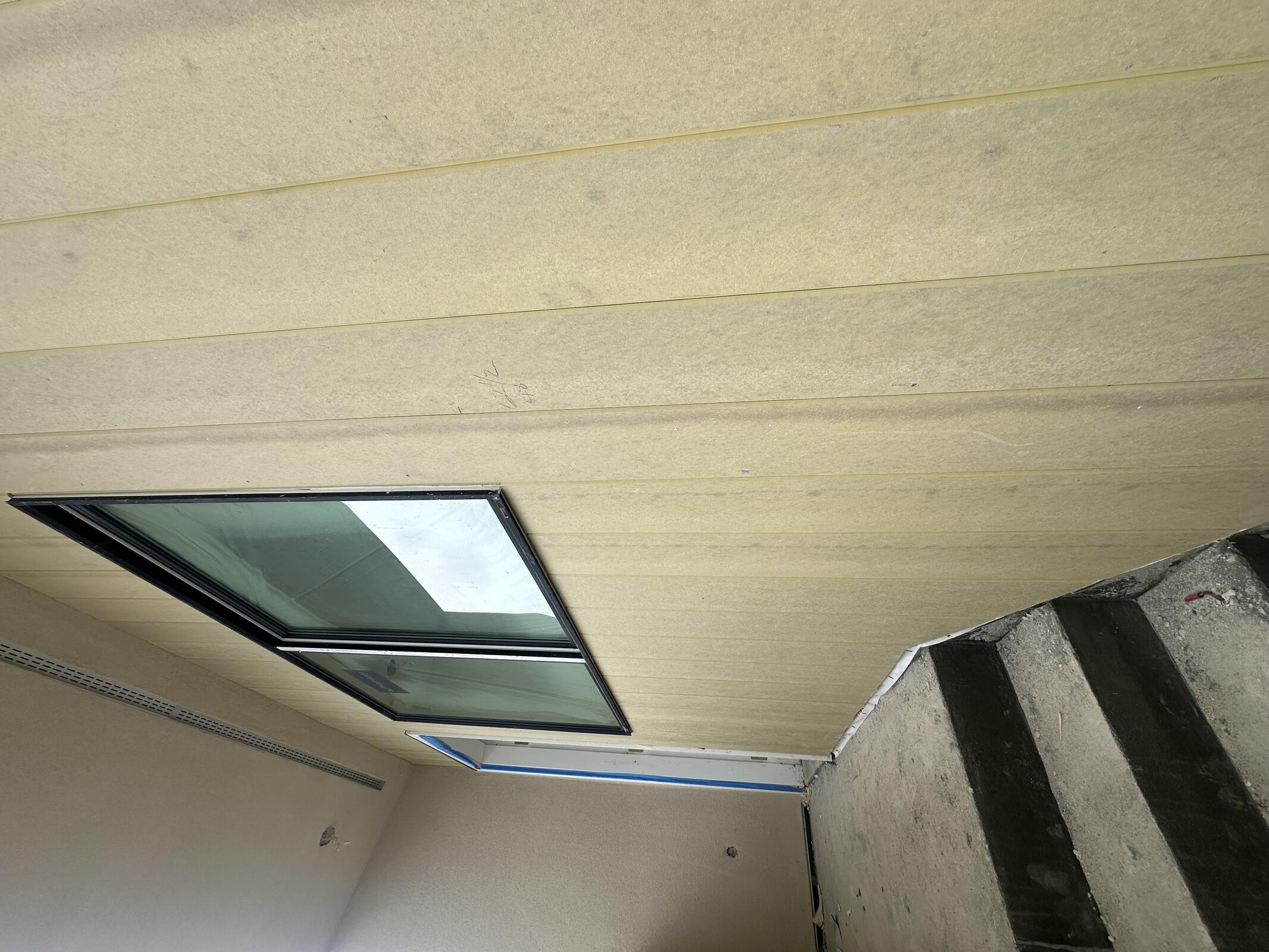

Sunline on site, continuing to install solar equipment.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| Coastal | 1 | 8 | 8 |
| ZSP | 1 | 4 | 4 |
| Marq | 2 | 8 | 16 |
| Painters Unlimited | 4 | 8 | 32 |
| TDI | 1 | 4 | 4 |
Inspection: N/A
Delay: Meeting with Gino and Margaret Q (DSD) did not produce any resolution. Gino and Sam (Flores Engineering) to have follow up discussion tomorrow at 2 to review a different code section.

Thursday, June 18, 2026
Overcast, 64°F

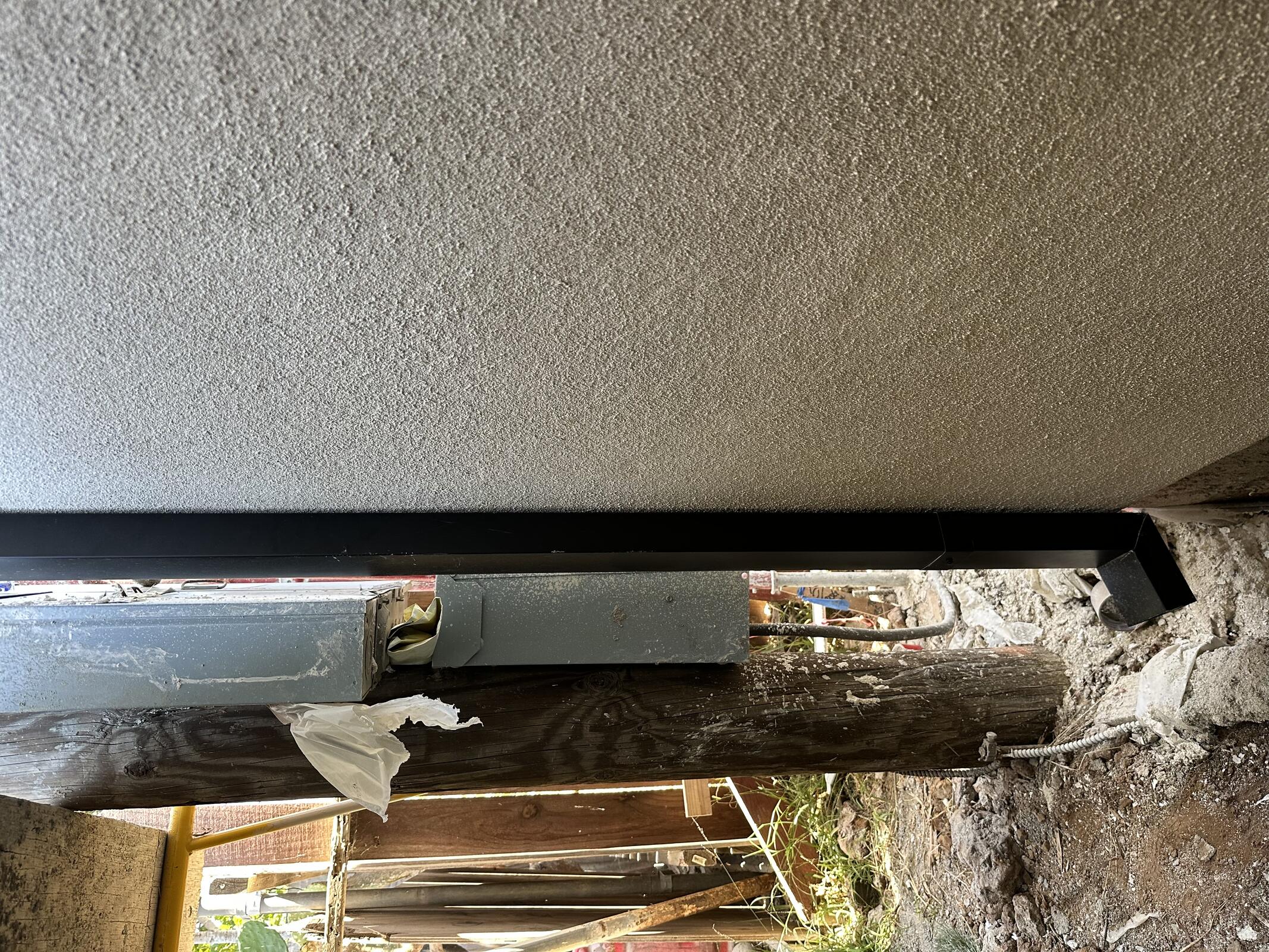

Marq Plastering loading all spoils into dumpster. Installing siding at Structure C, second floor.
Coastal continuing to work on tile at garage conversion.
Painters Unlimited touching up paint/sanding in B and C and painting doors.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| Marq | 4 | 8 | 32 |
| Coastal | 1 | 8 | 1 |
| Painters Unlimited | 2 | 8 | 16 |
Inspection: N/A

Friday, June 19, 2026
Clear, 72°F
Site shut down for Juneteenth.

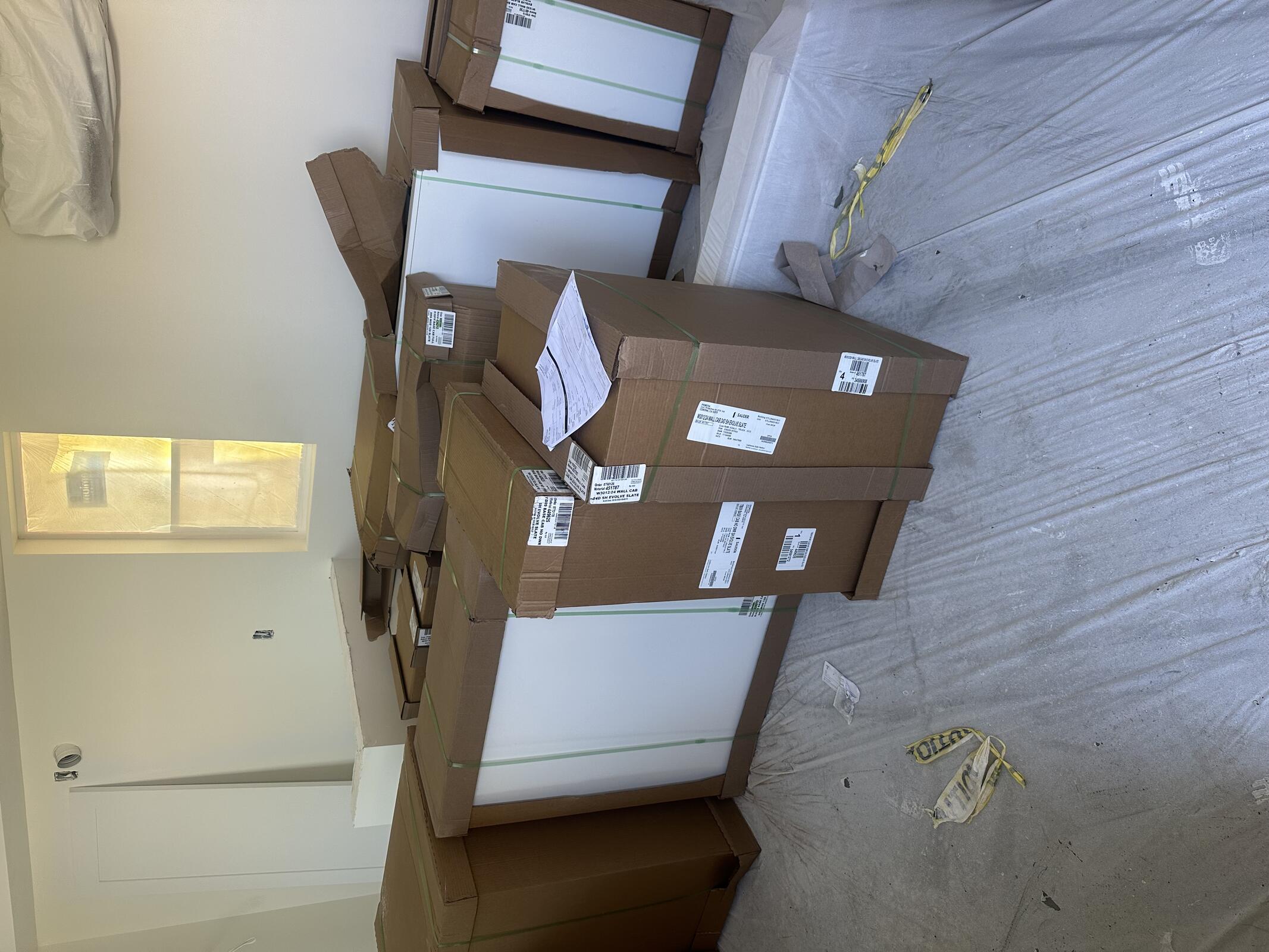

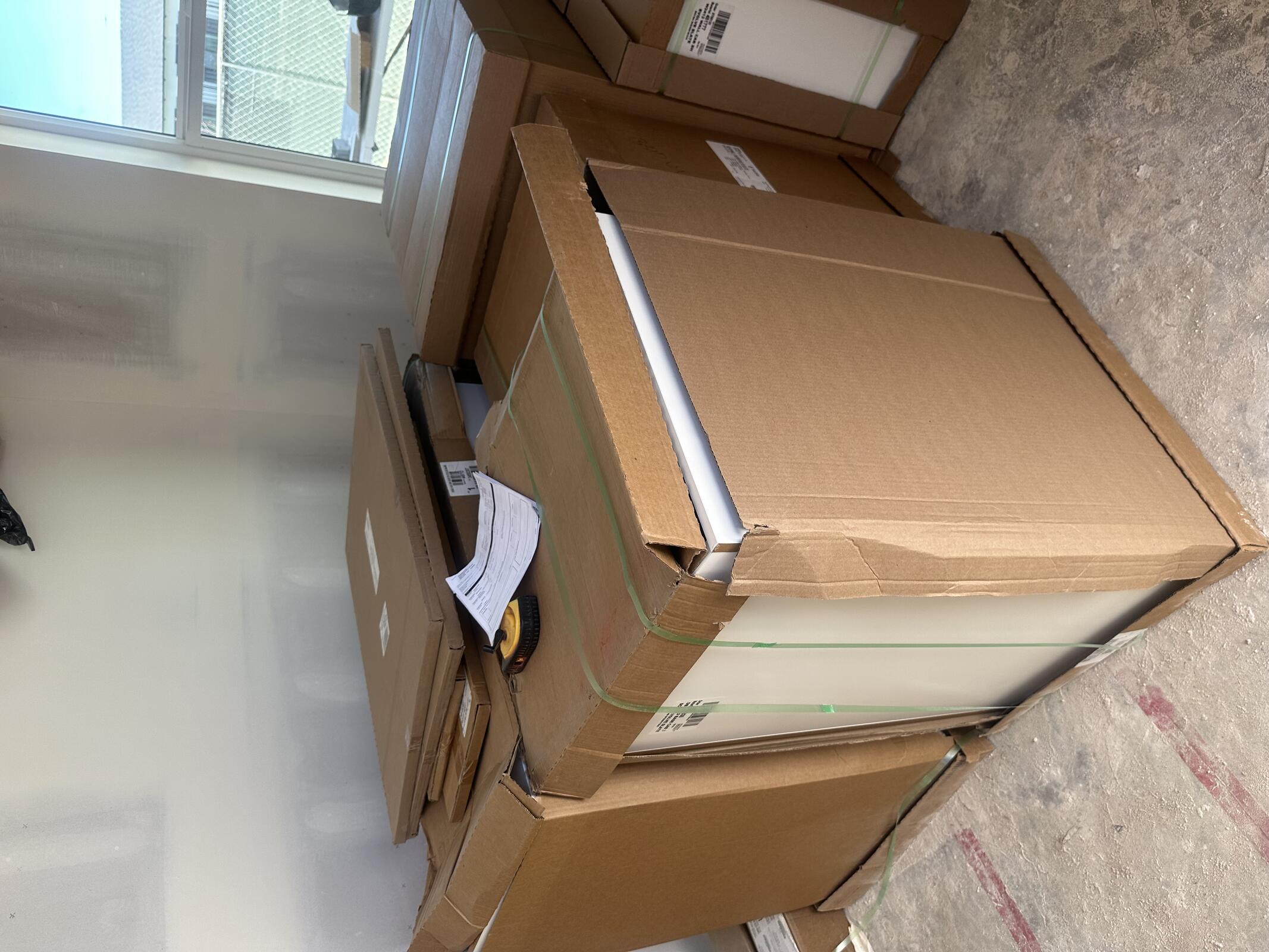

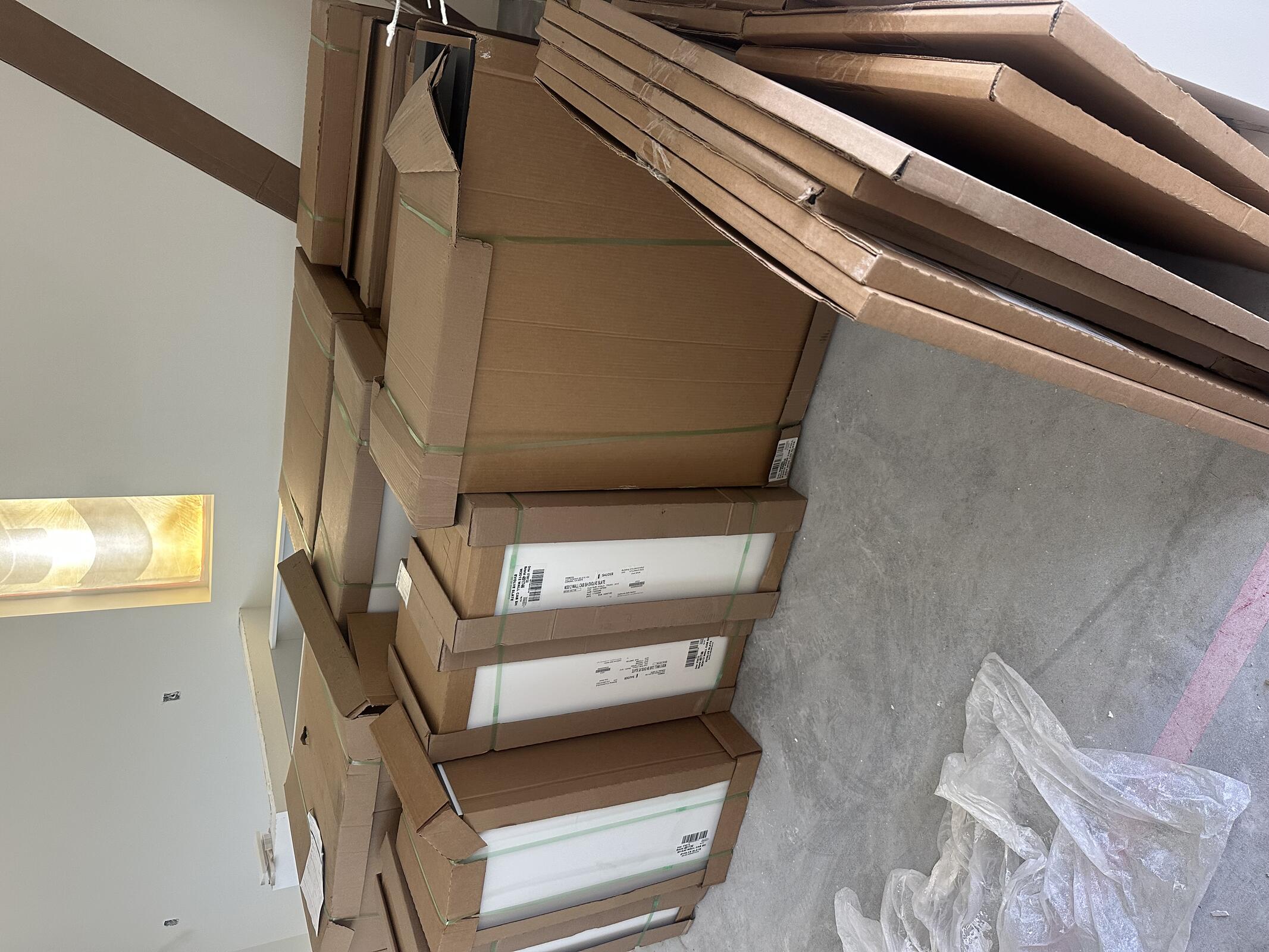

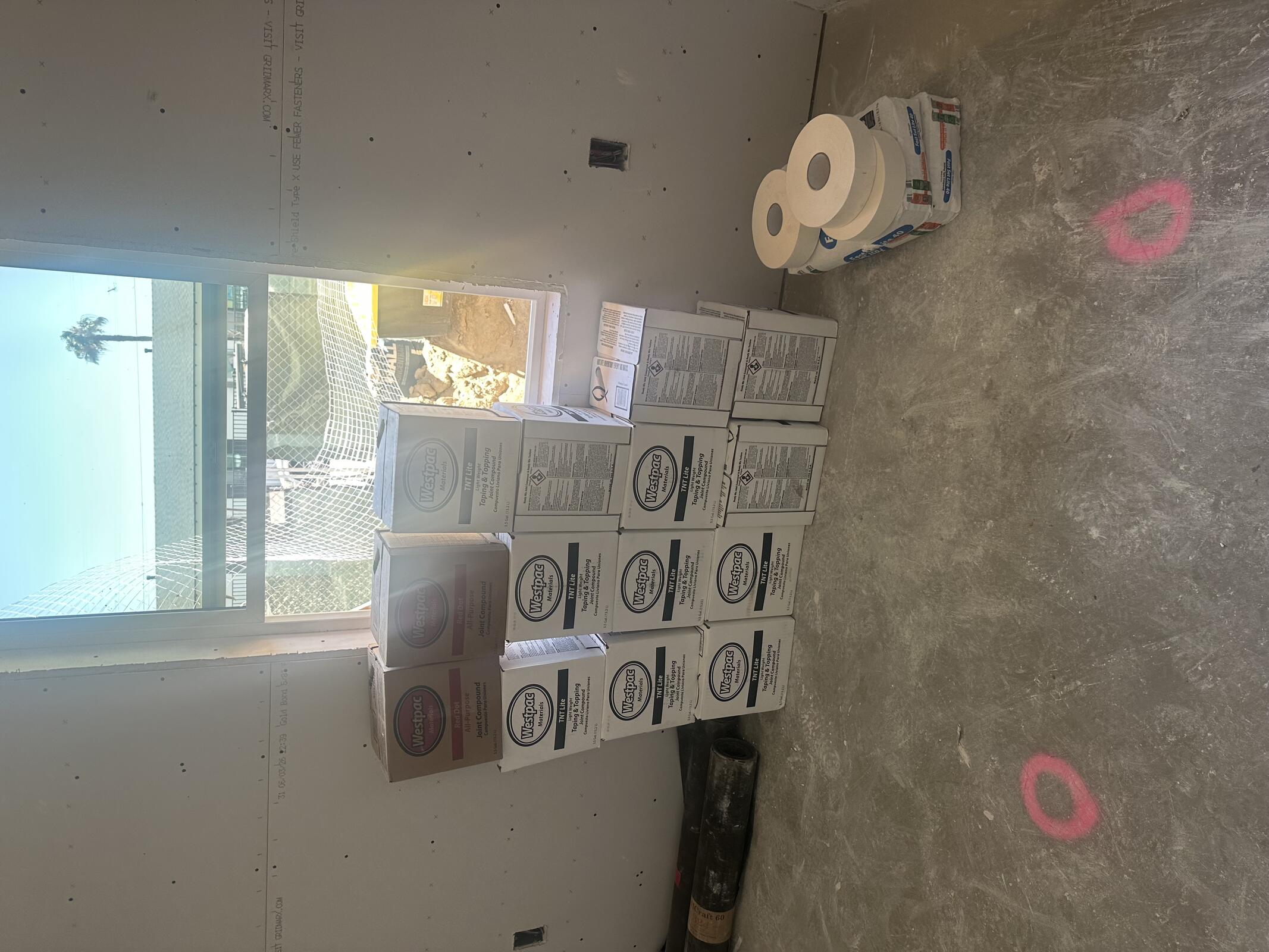

Cabinets delivered to site.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
Inspection: N/A

Saturday, June 20, 2026
Clear, 72°F
Marq Plastering continuing to clean up spoils.
JBG moving dirt and cleaning up to prepare for drainage installation.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| Marq | 2 | 8 | 16 |
| JBG | 2 | 8 | 16 |
Inspection: N/A
