Week 25 of 34

Week of June 08 — June 13, 2026

6 days on site. 84 photos. DFH, Drywall, Electric, Paint, Polished Concrete, Solar, Stucco, Tile.

June 8, 2026June 13, 20266 days84 photos
DFHDrywallElectricPaintPolished ConcreteSolarStuccoTile

Monday, June 08, 2026

Clear, 71°F

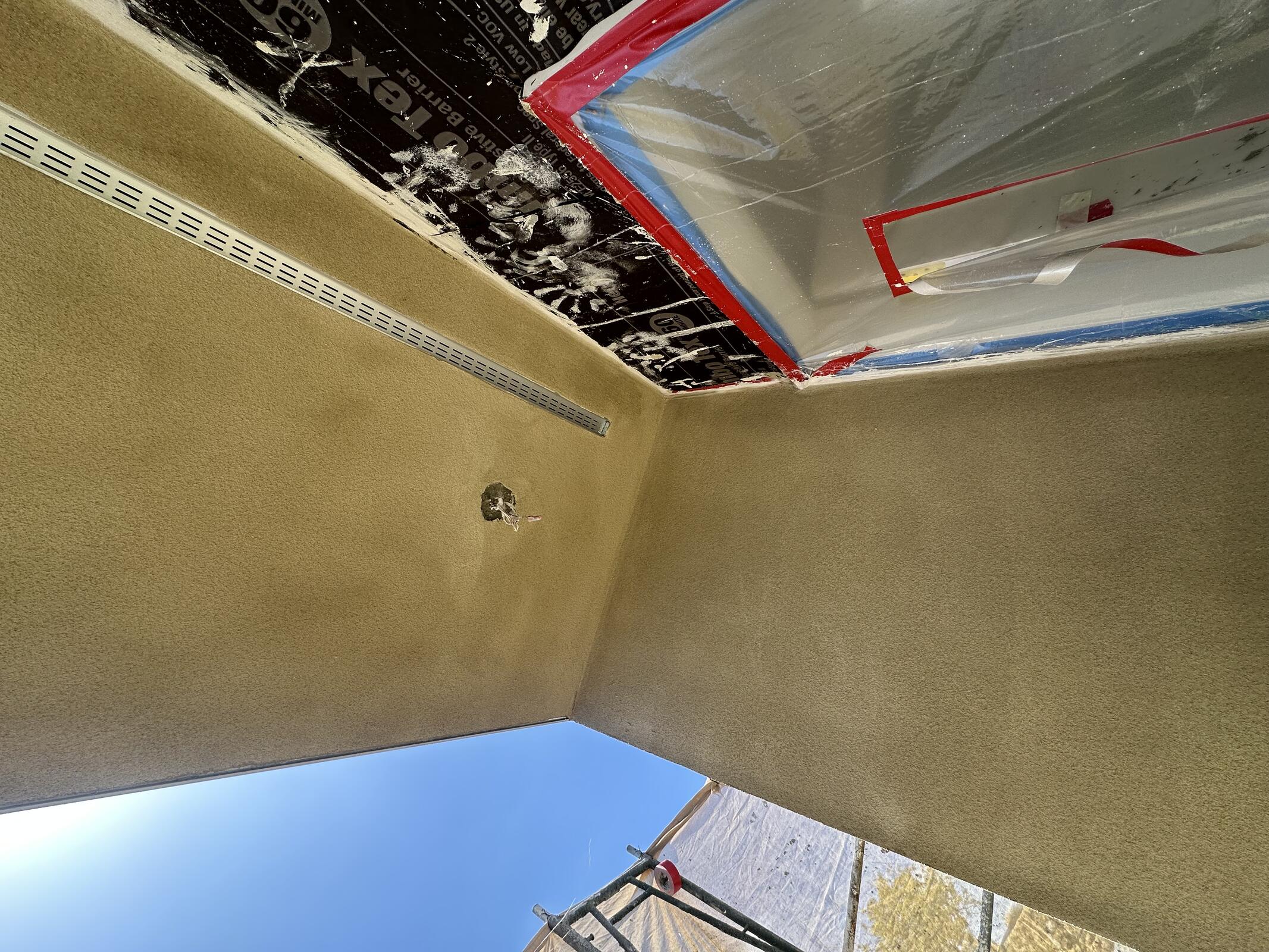

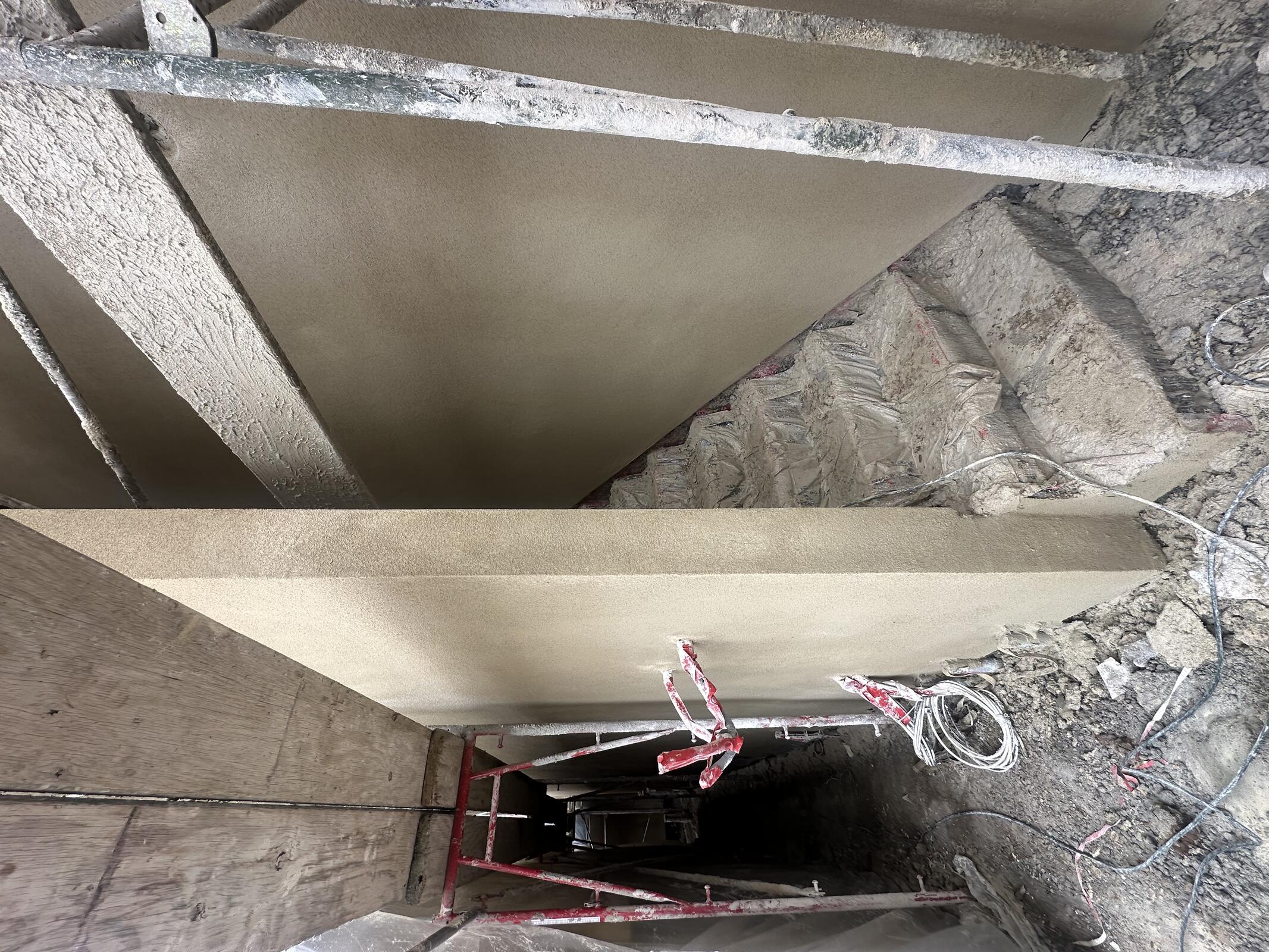

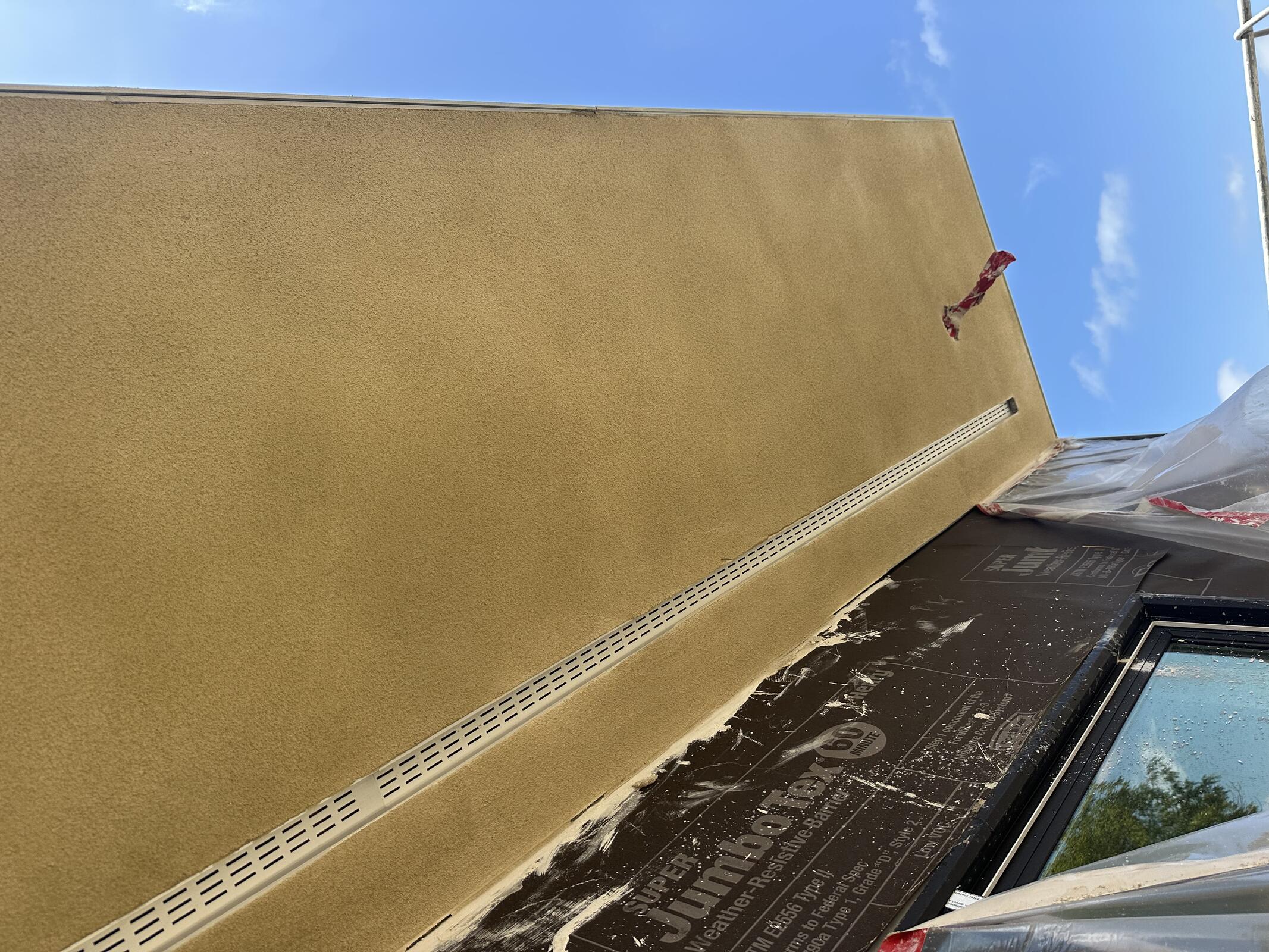

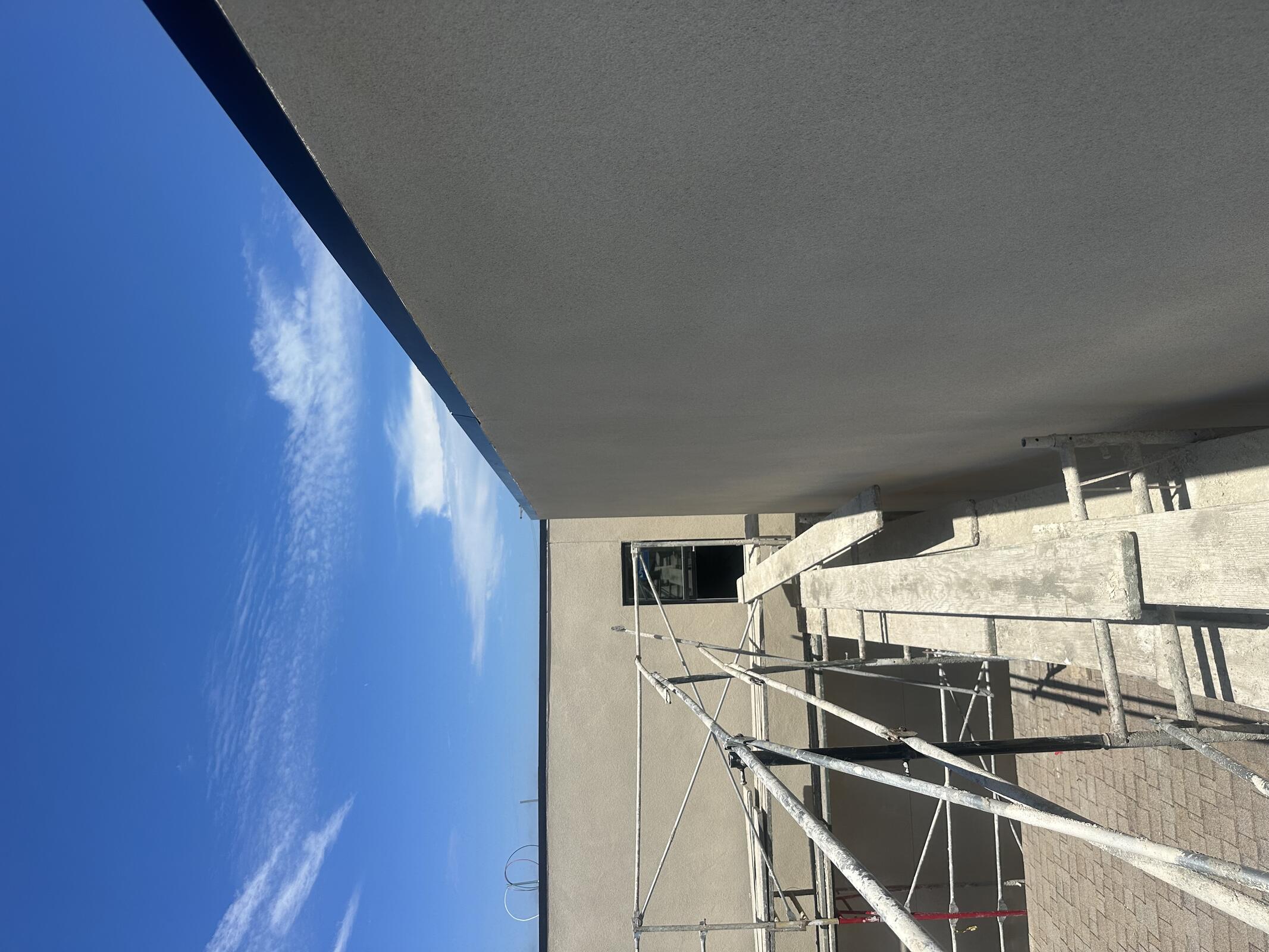

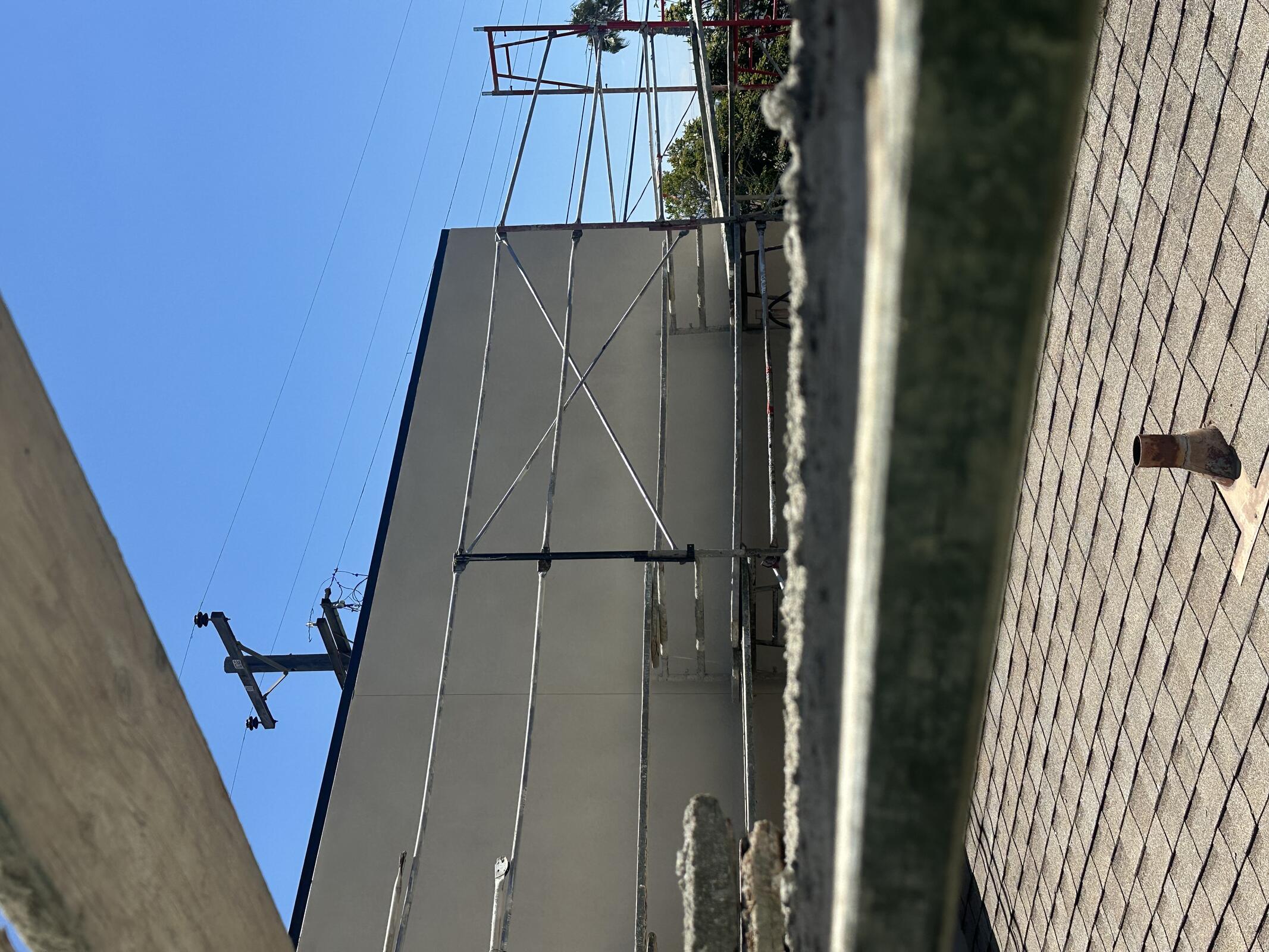

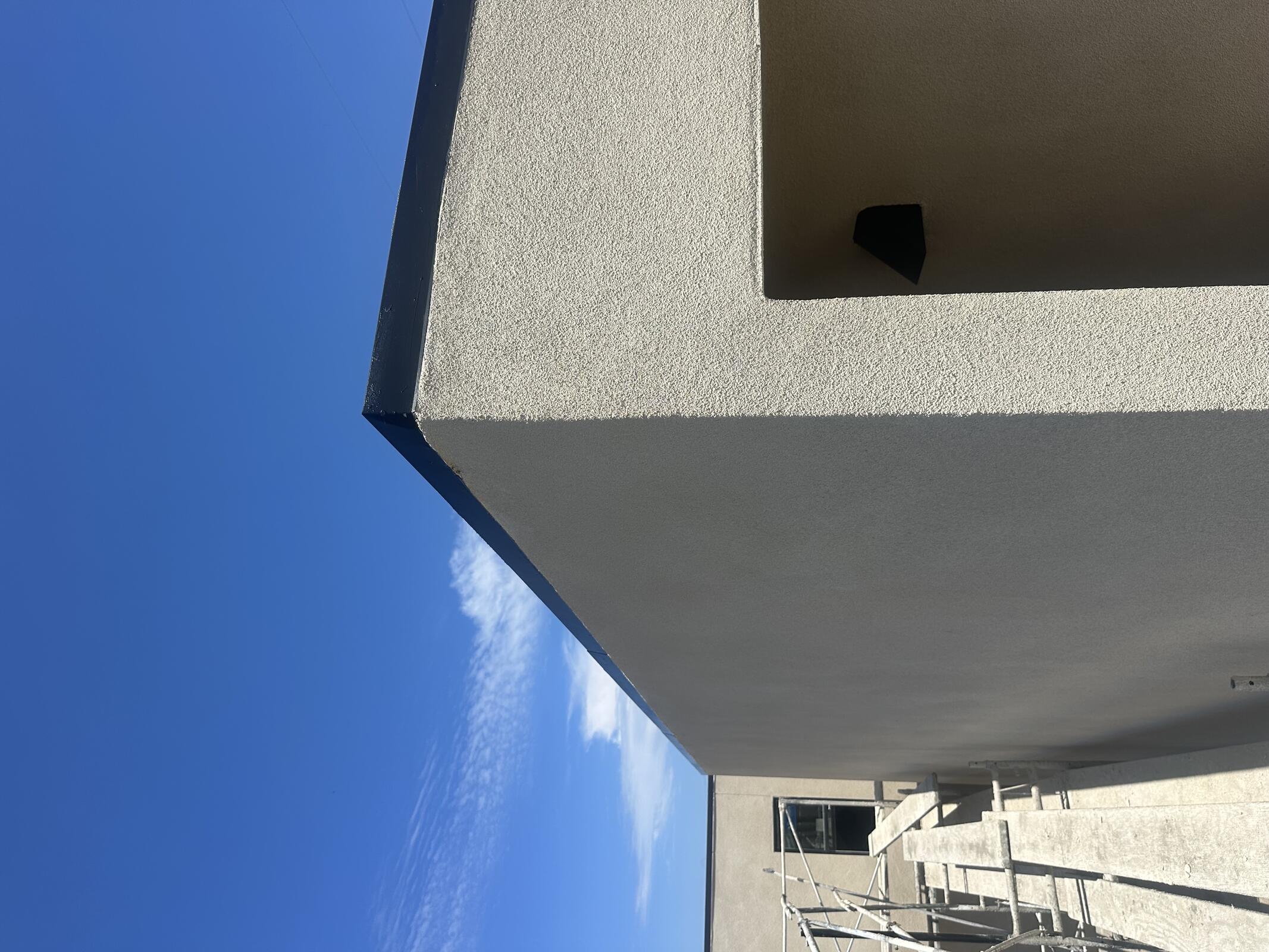

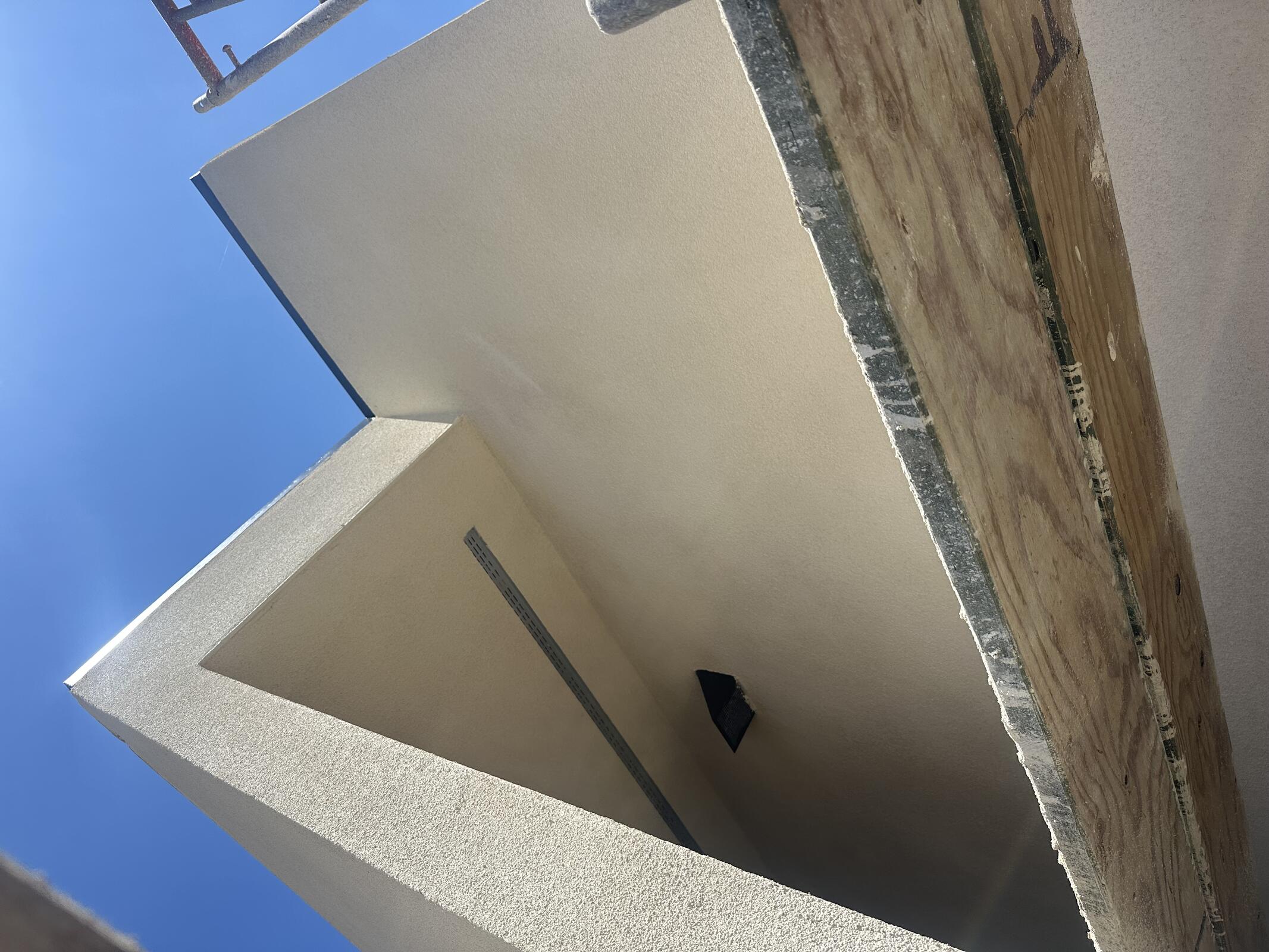

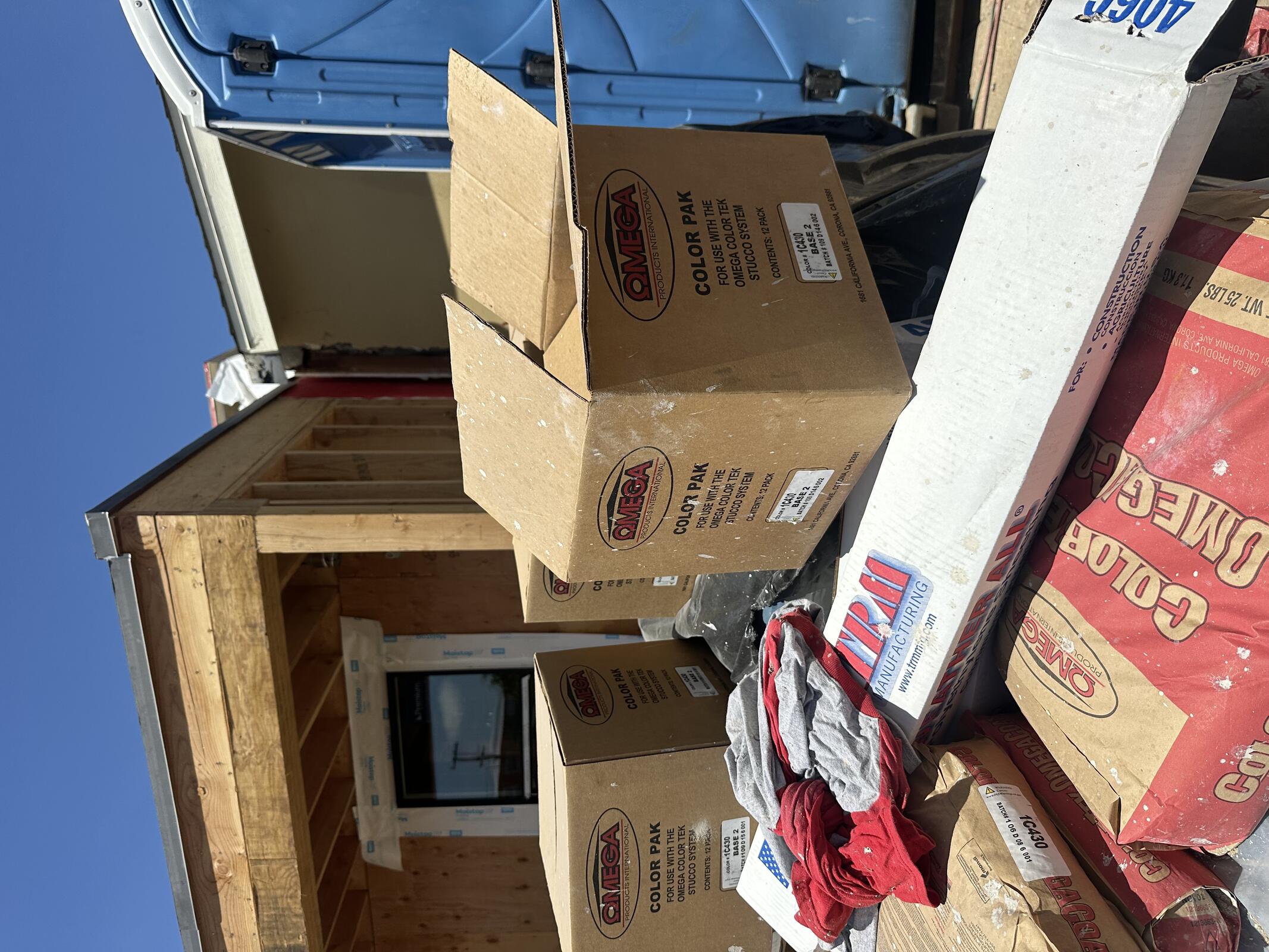

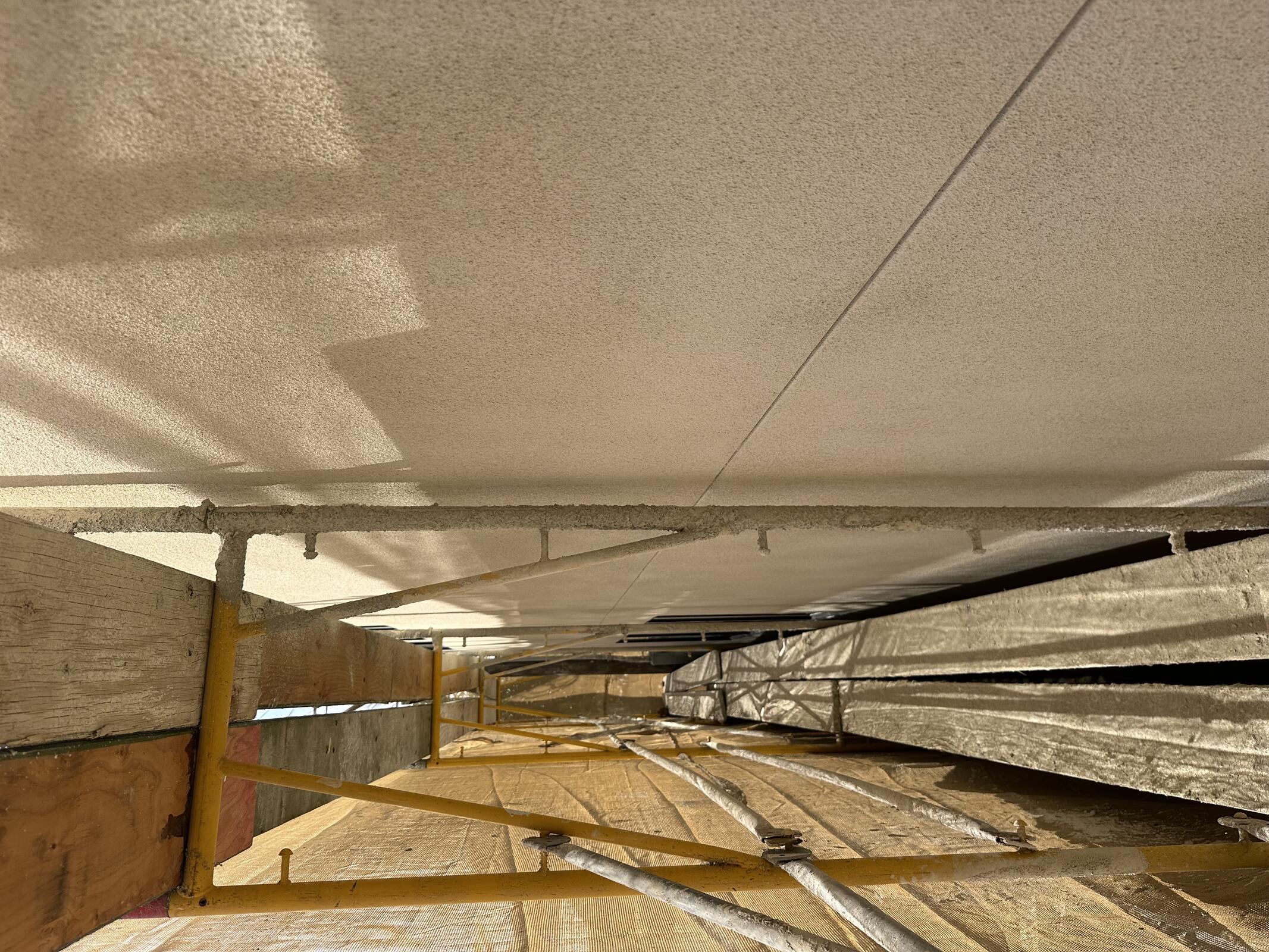

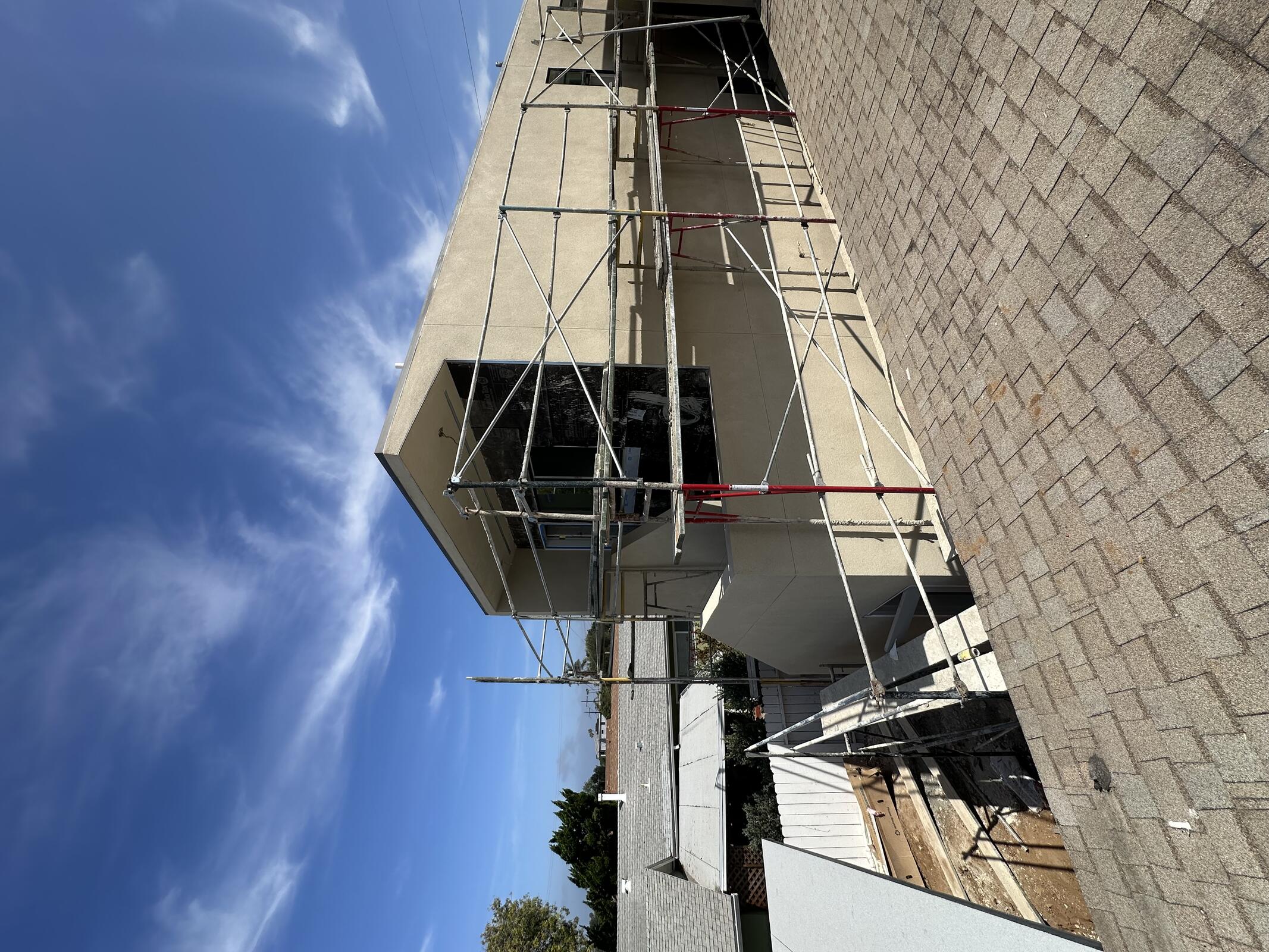

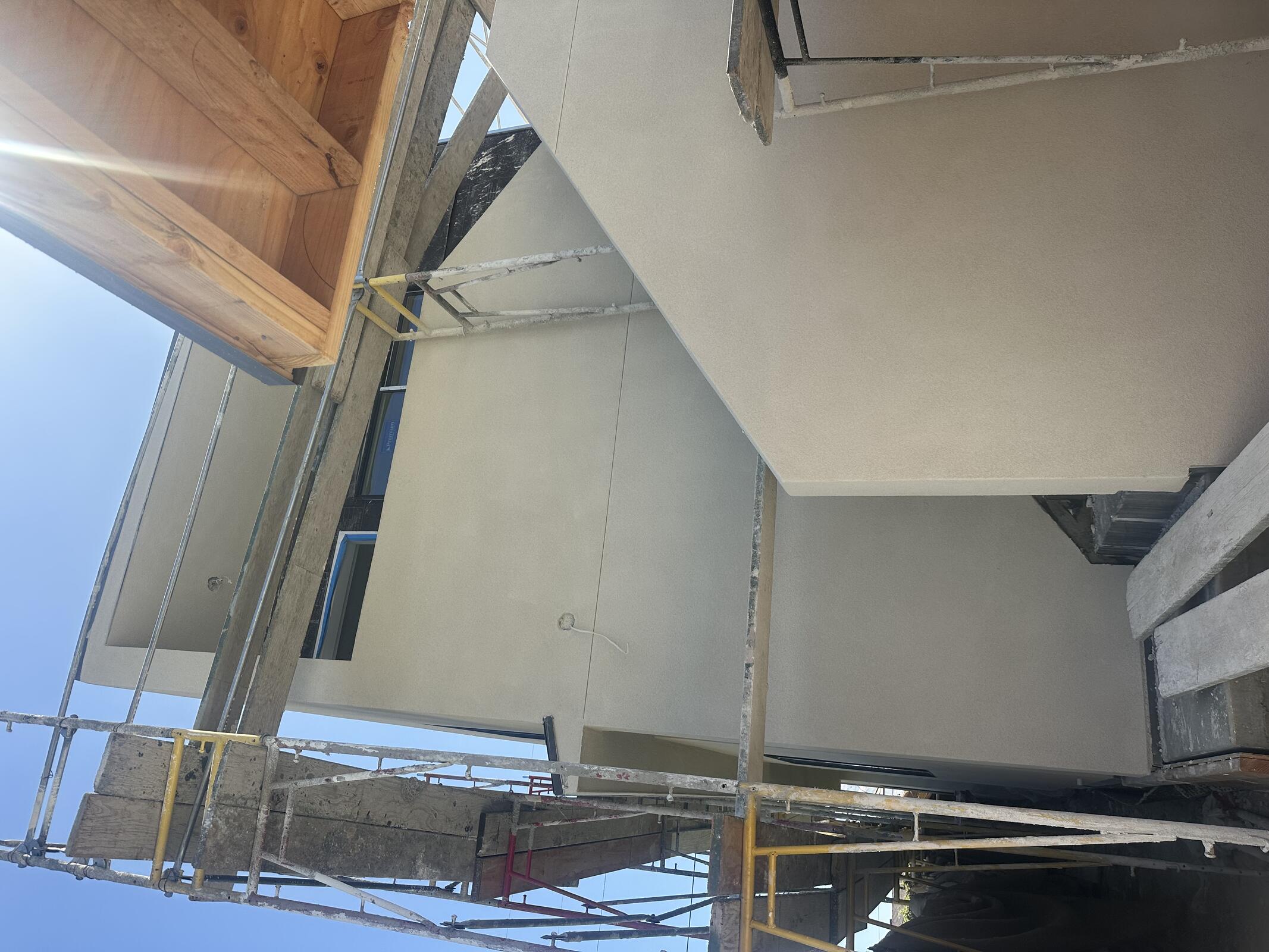

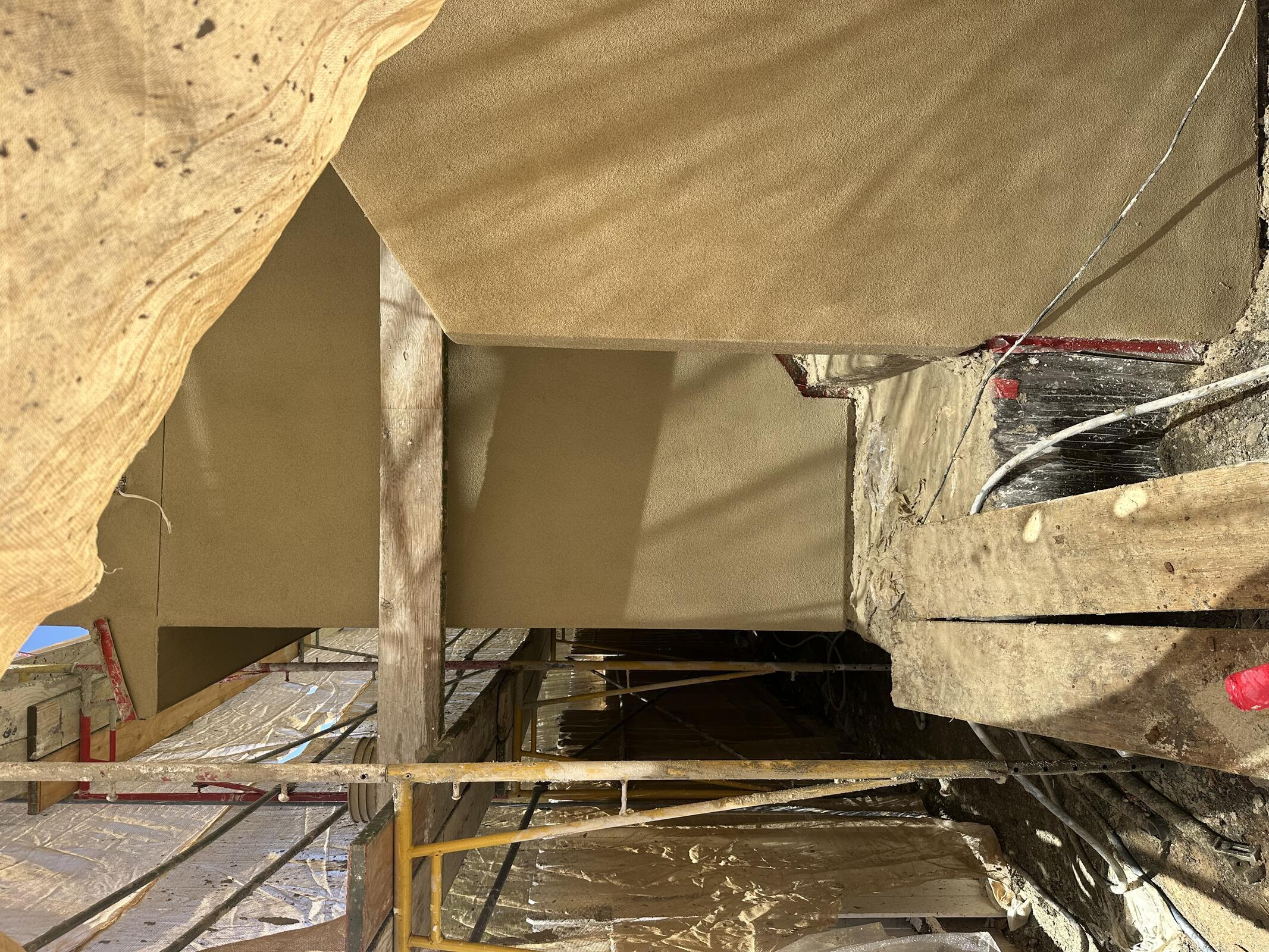

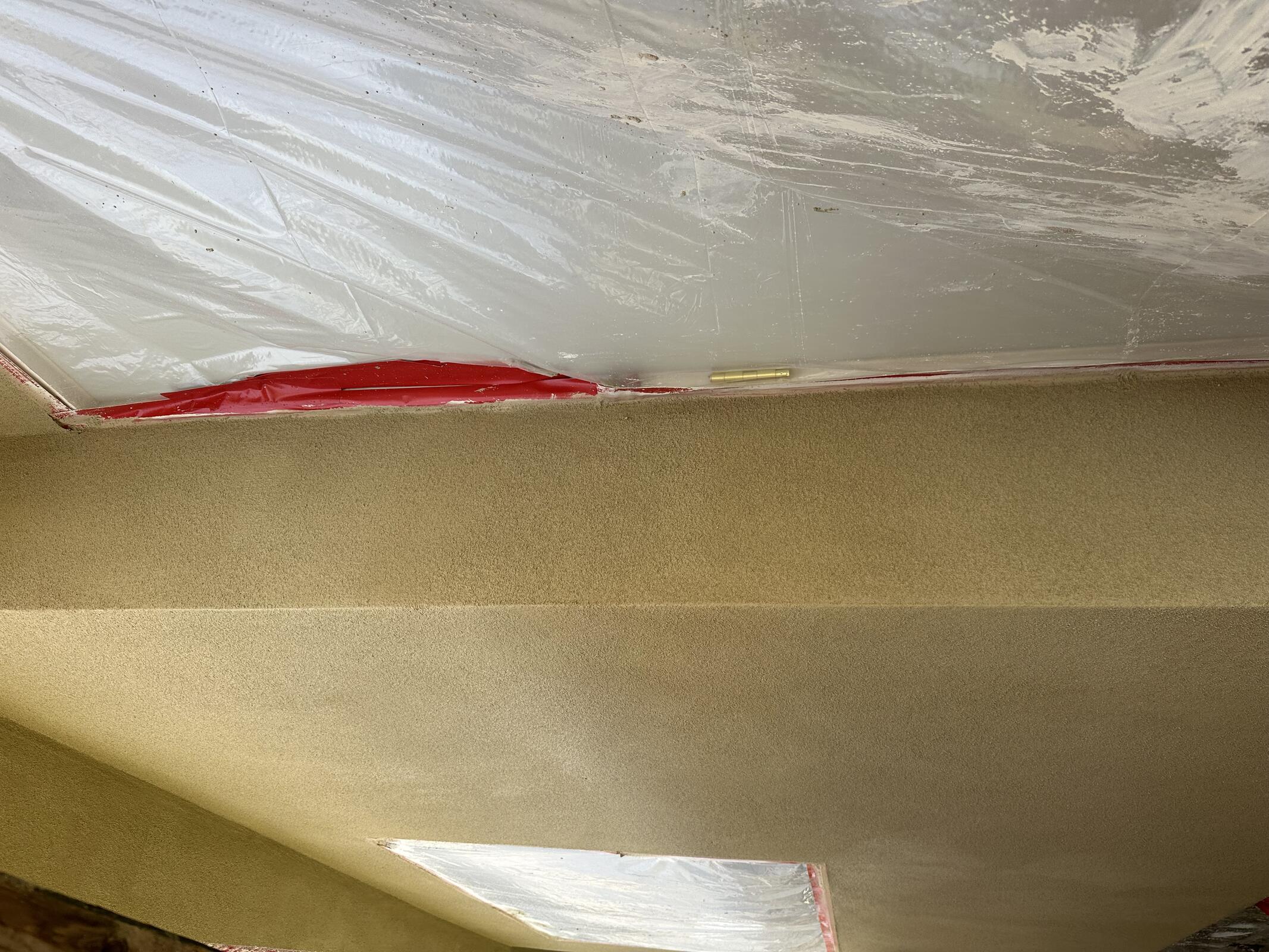

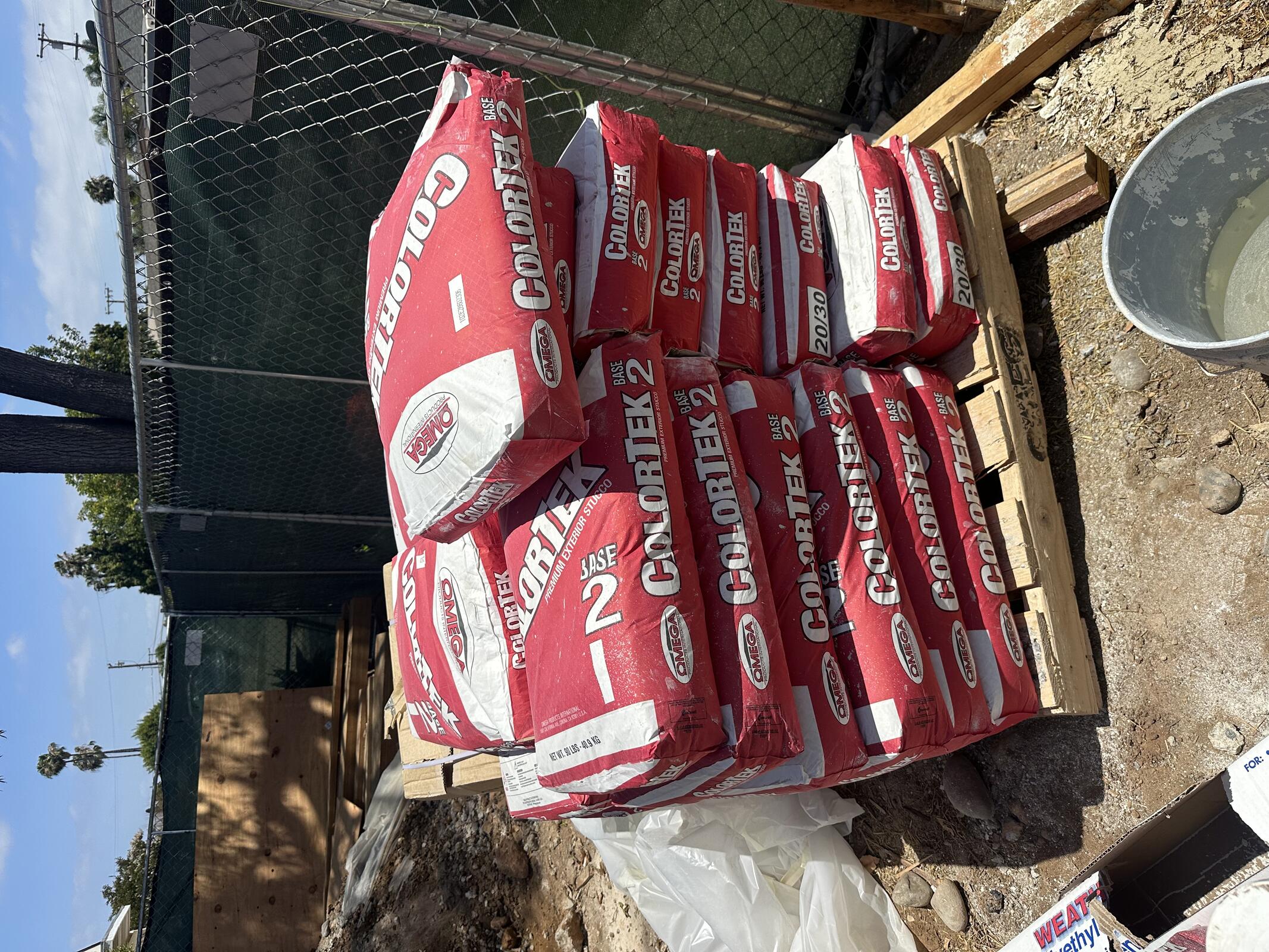

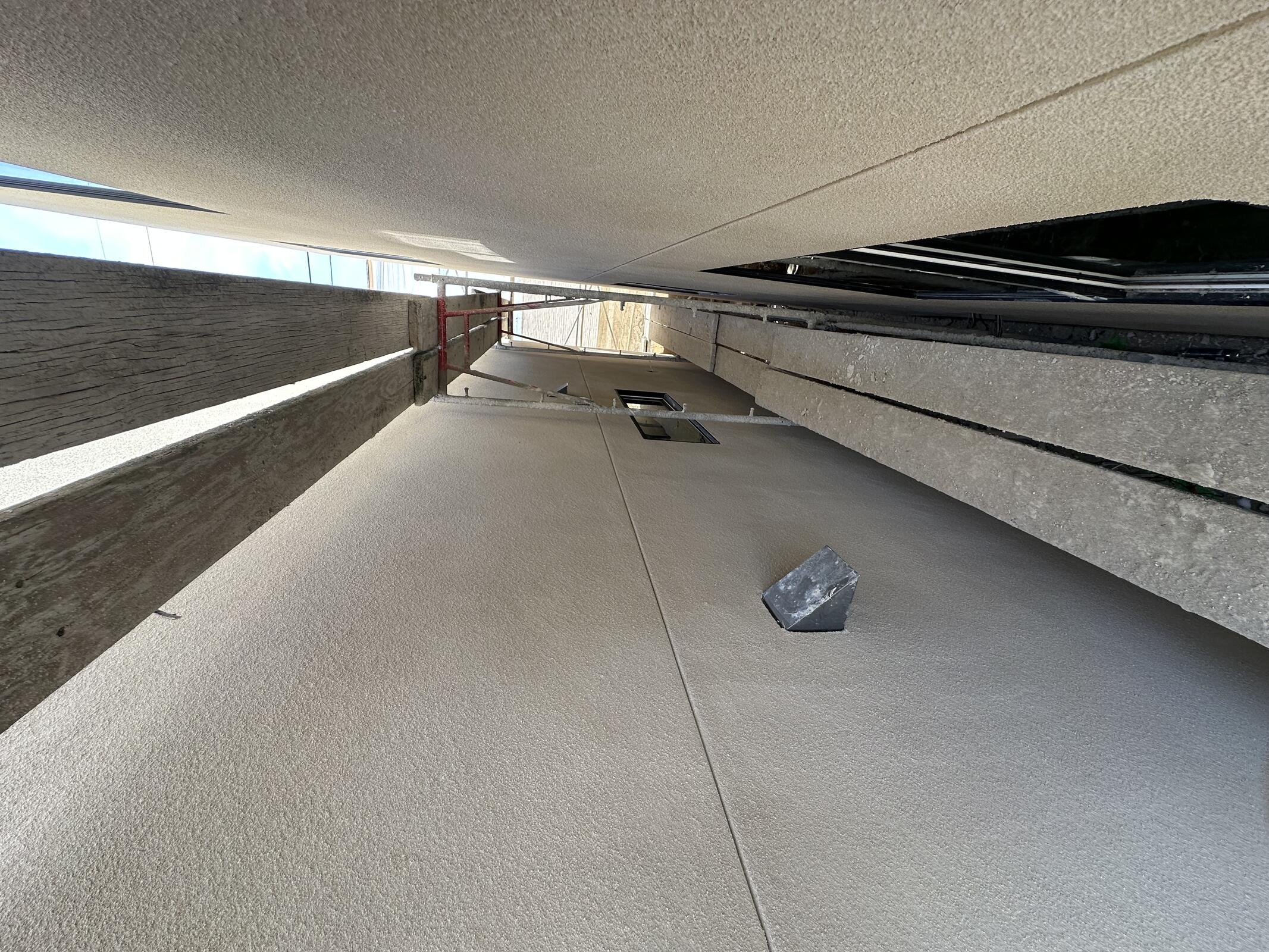

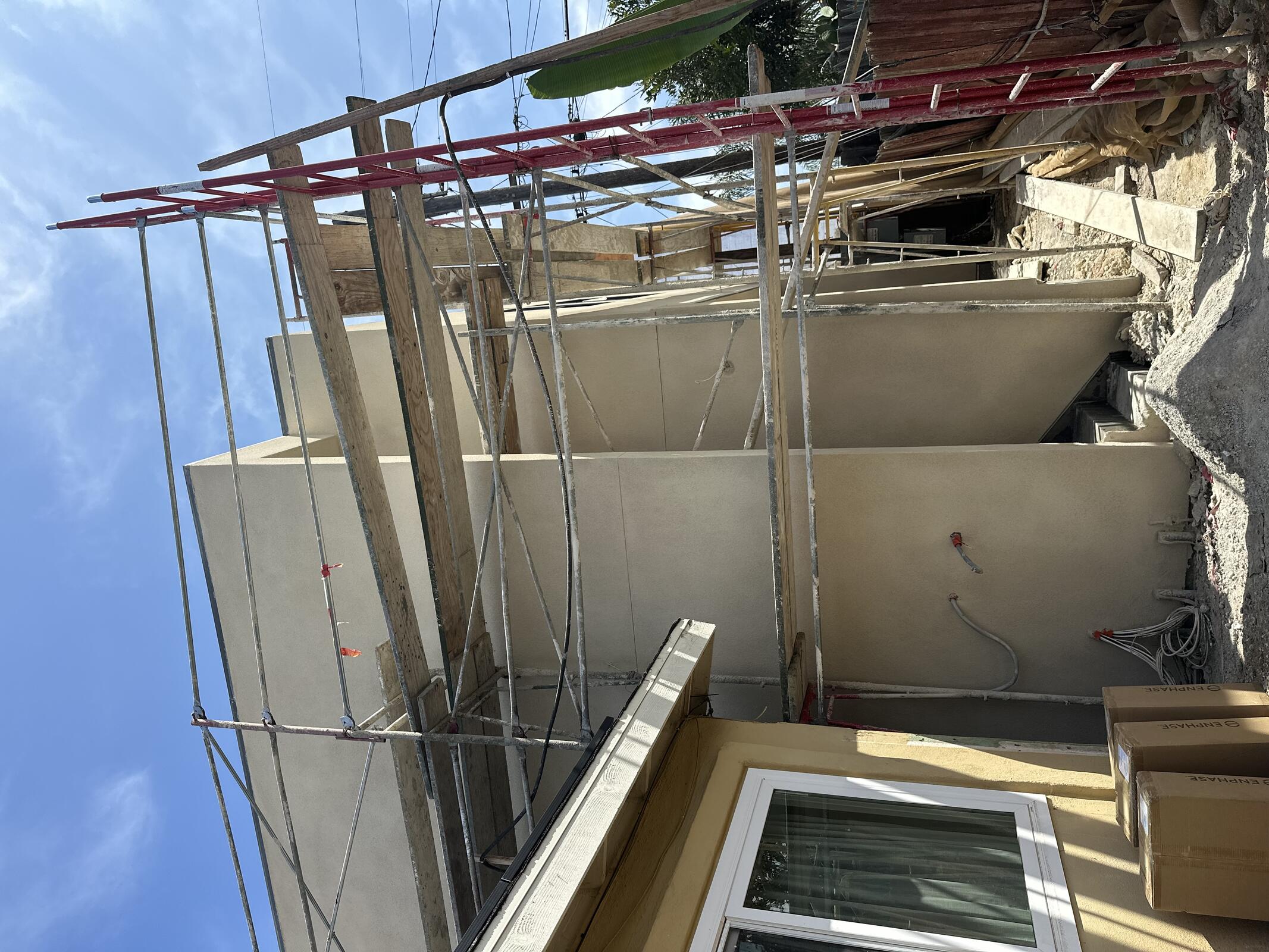

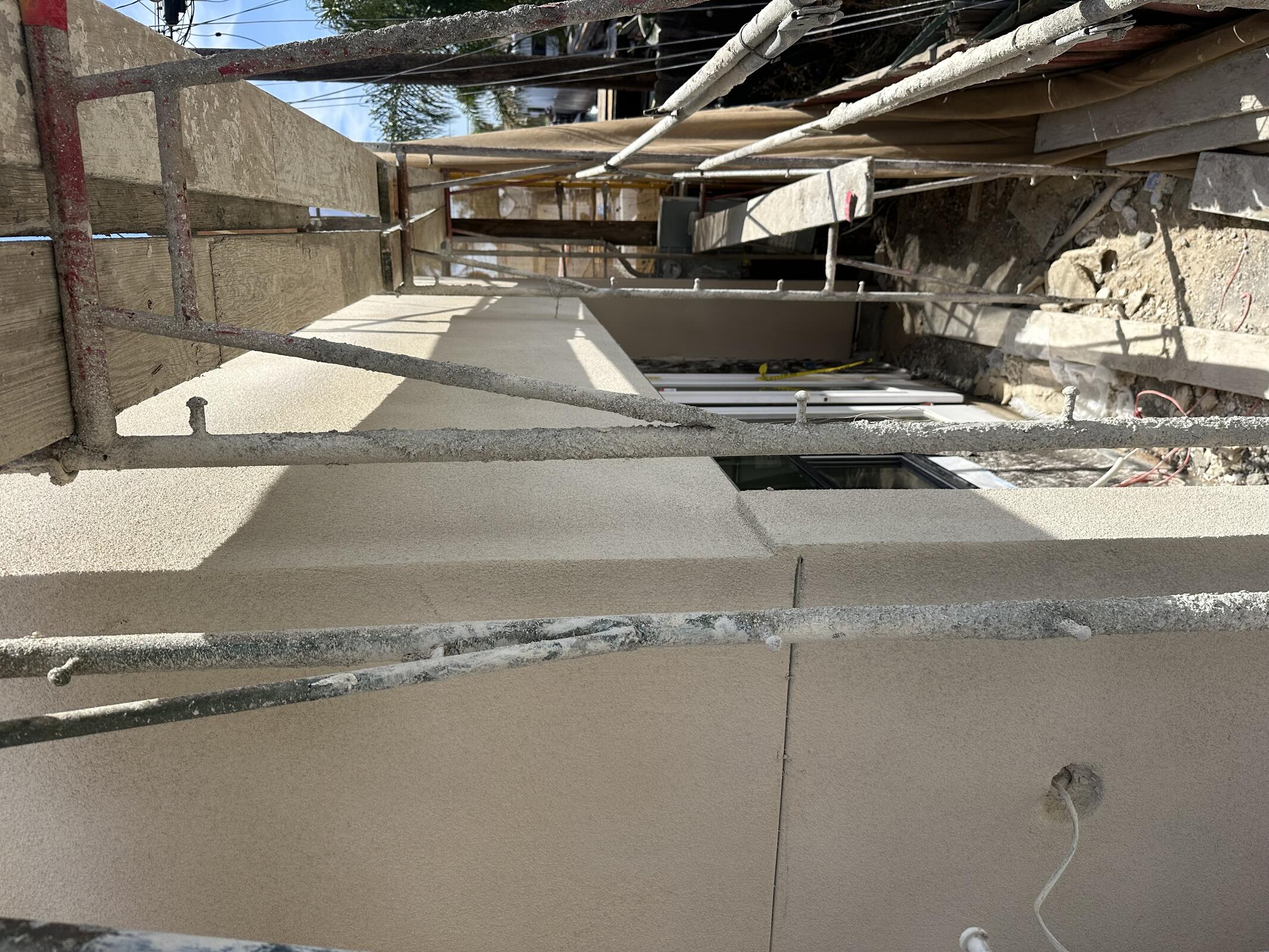

Marq Plastering color coating Building B and C.

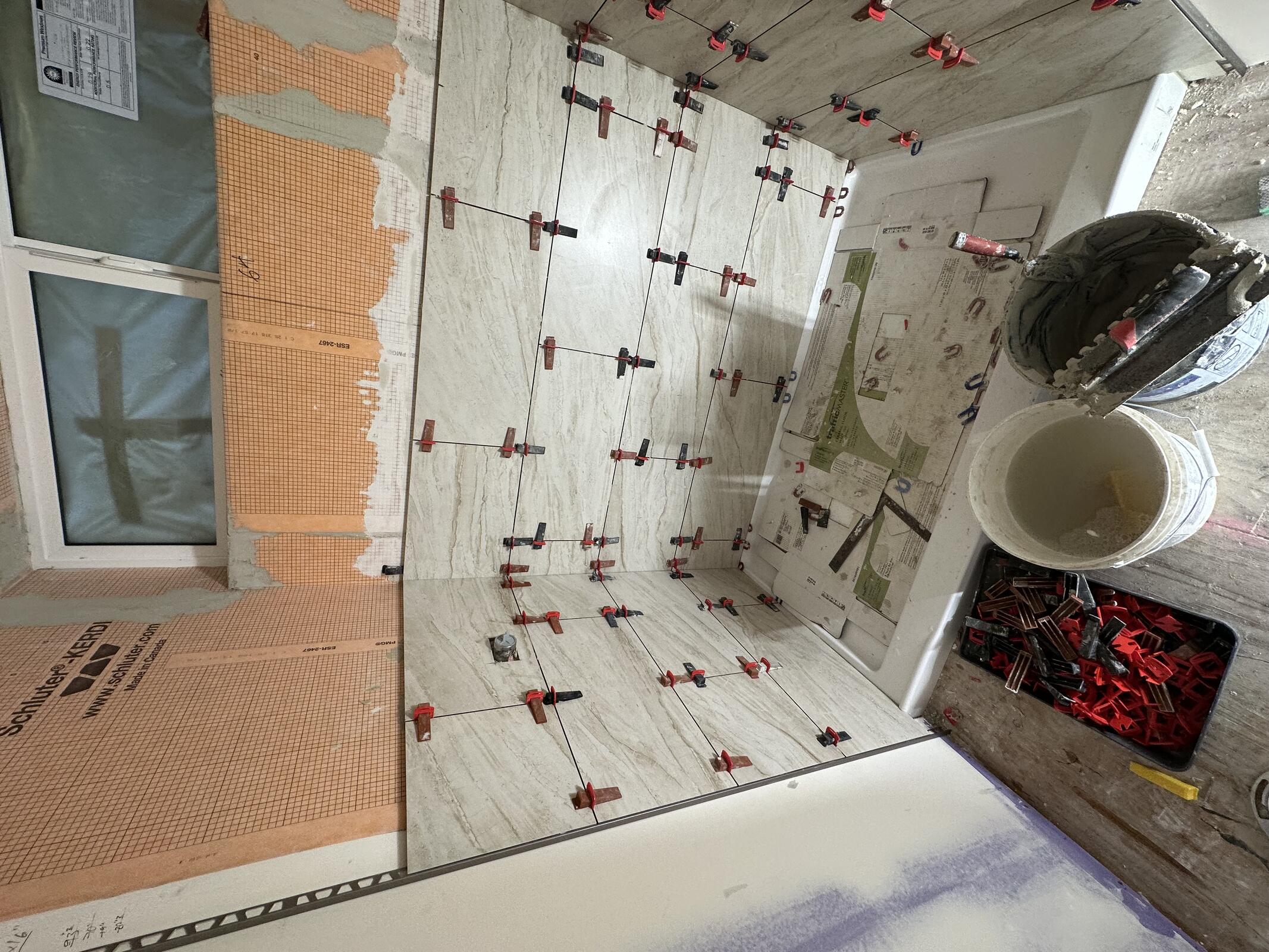

Coastal grouted walls and floors at B1 and C1.

JBG cleaning concrete to prepare for polish.

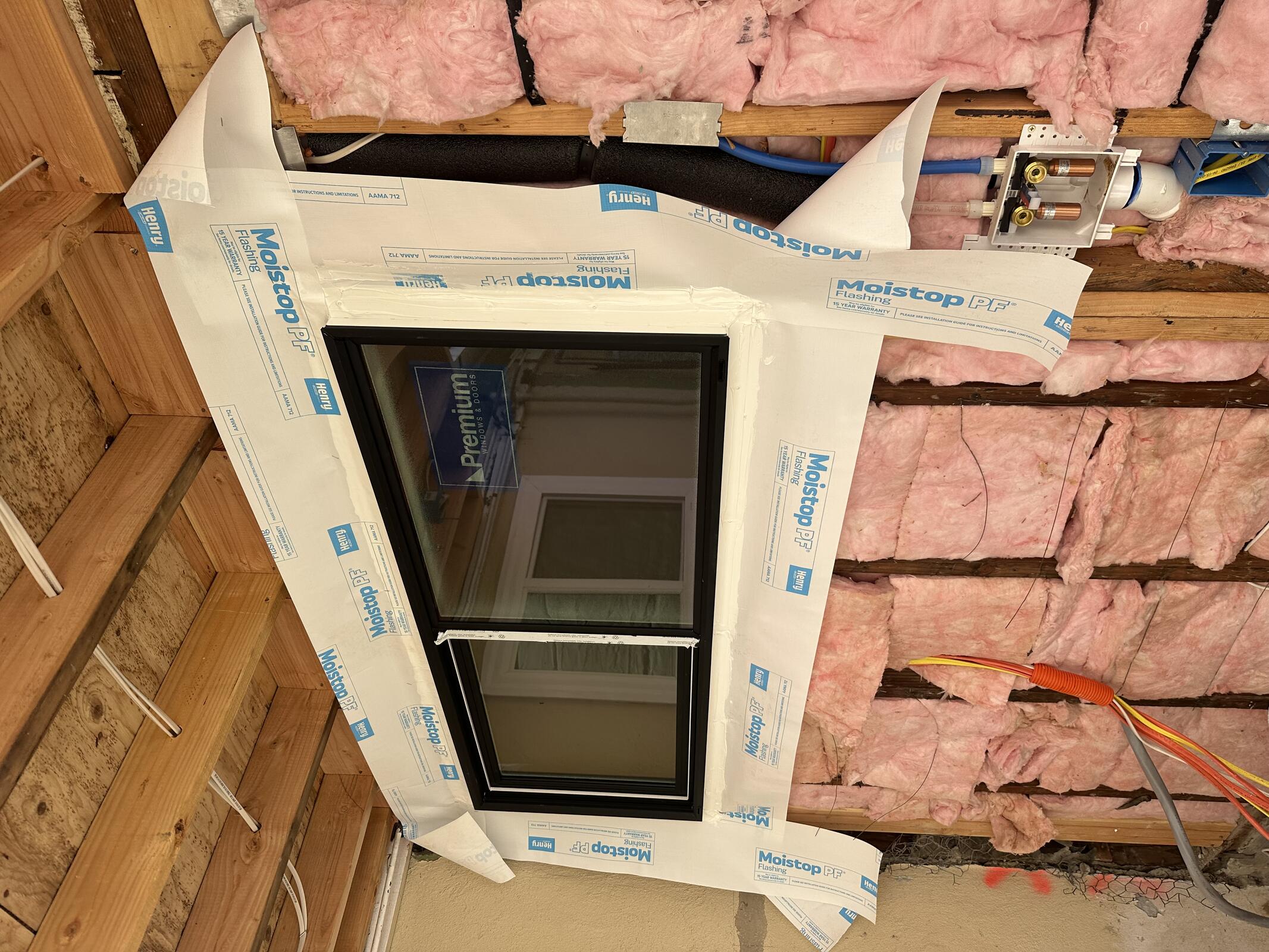

Window Solutions installed garage windows and changed out pane to tempered glass on B1 window next to door.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
Marq6848
JBG188
Coastal248
Window Solutions248

Inspection: N/A

Tuesday, June 09, 2026

Clear, 73°F

Marq plastering patching sections of color coat and cleaning up.

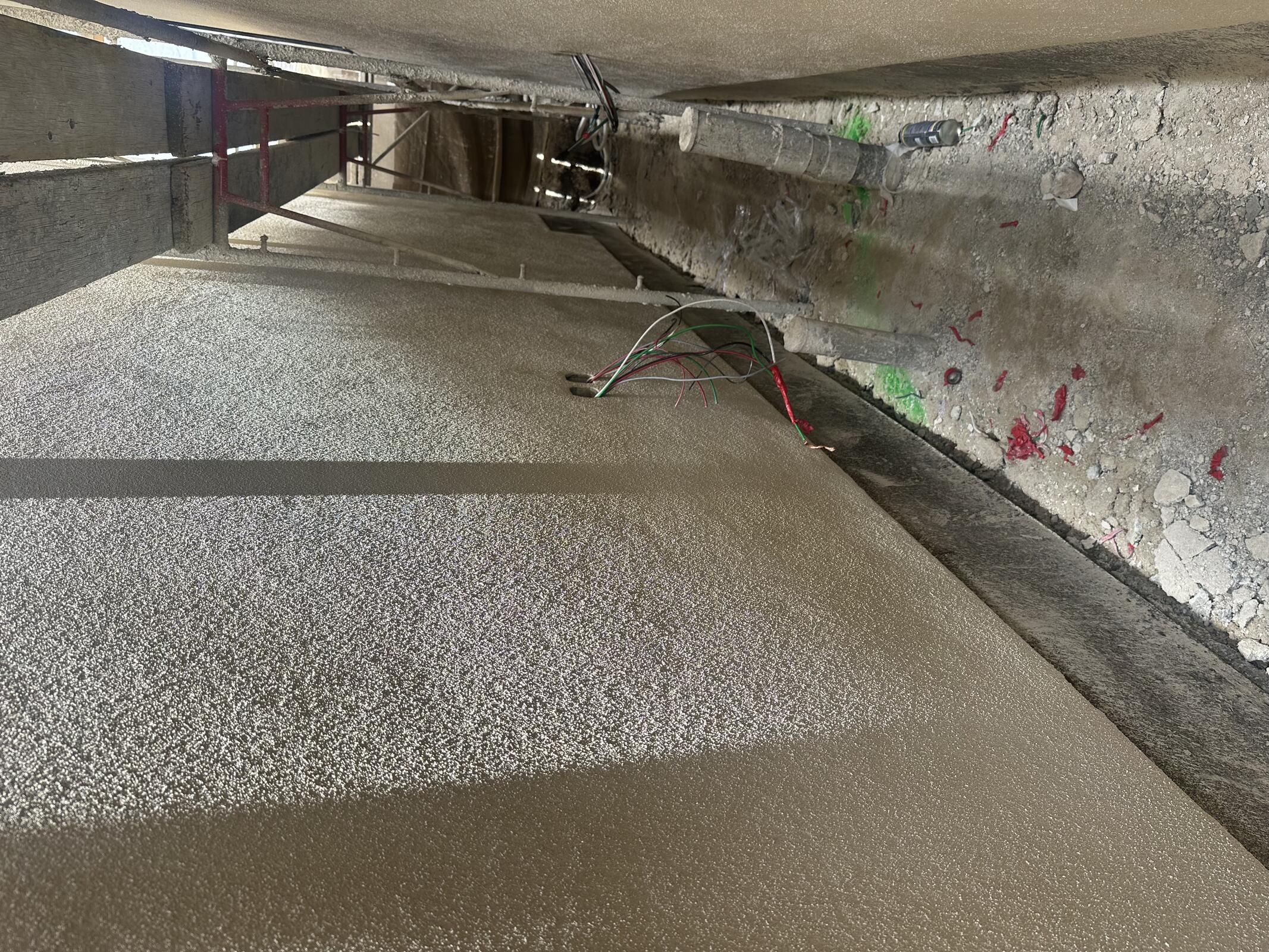

Coastal working on B2 shower. Poured 8 bags of self-levelling in the lower half of the garage. Will return tomorrow to finish. Delta of 1.25" in between low and high spots.

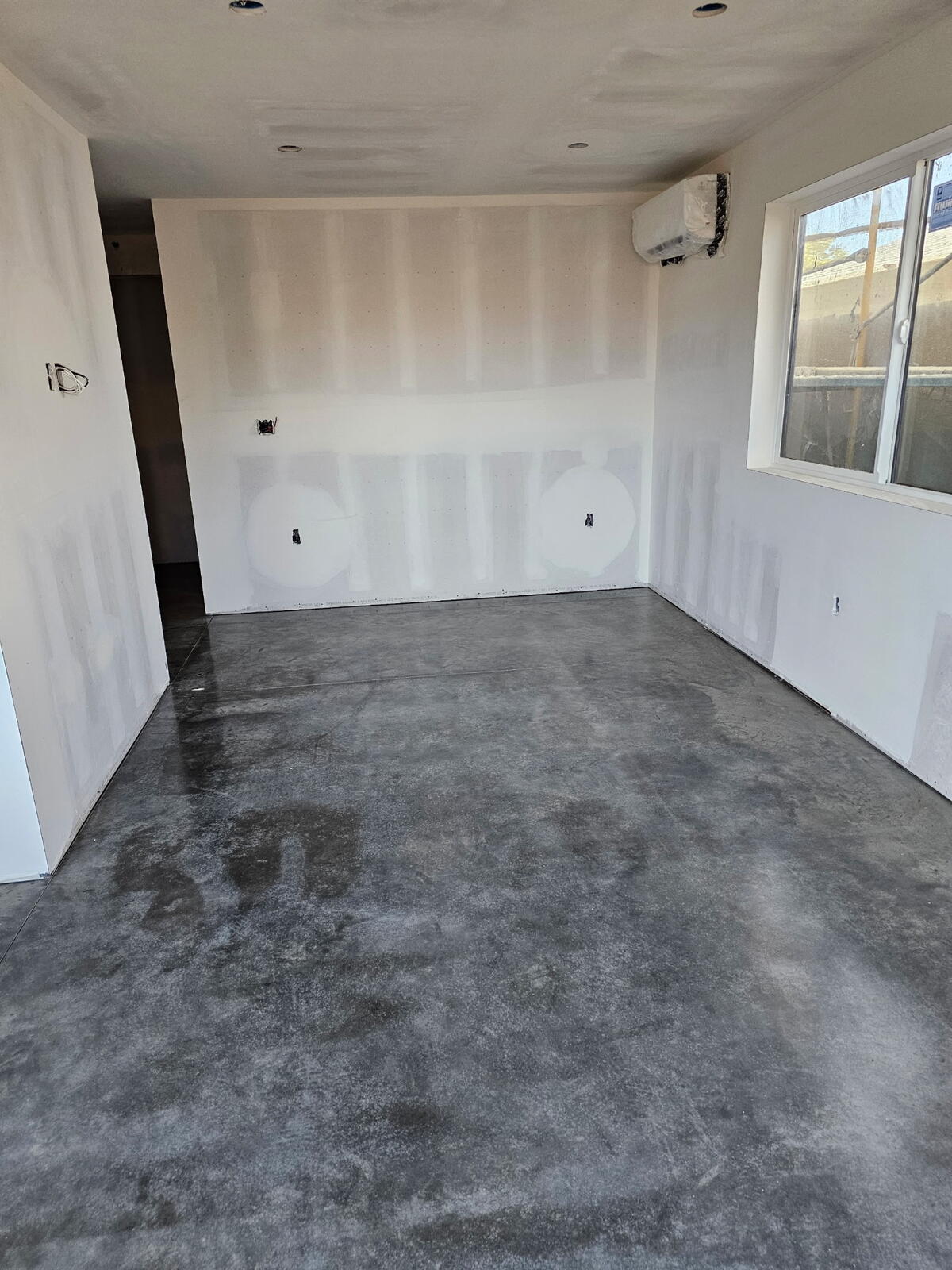

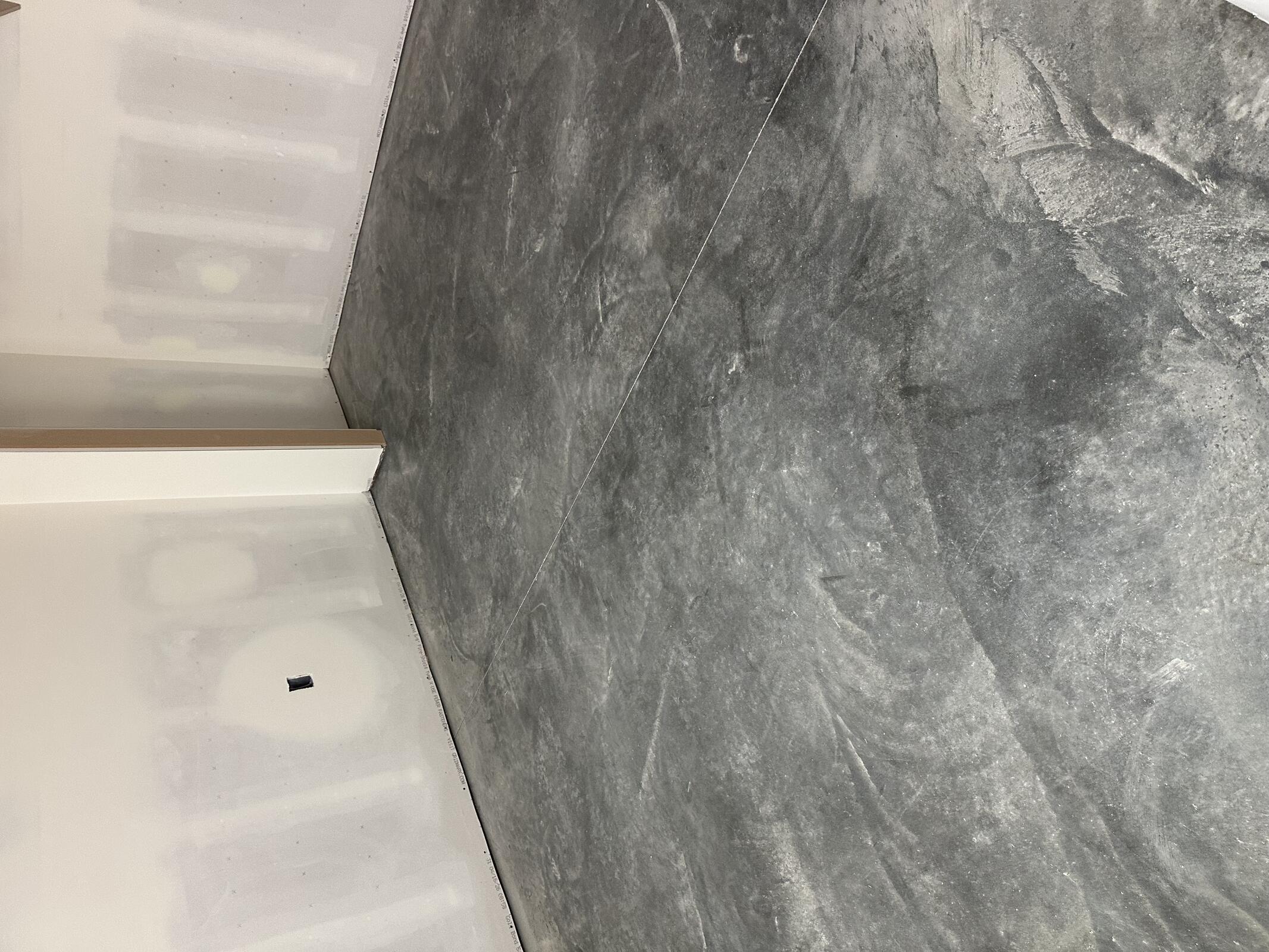

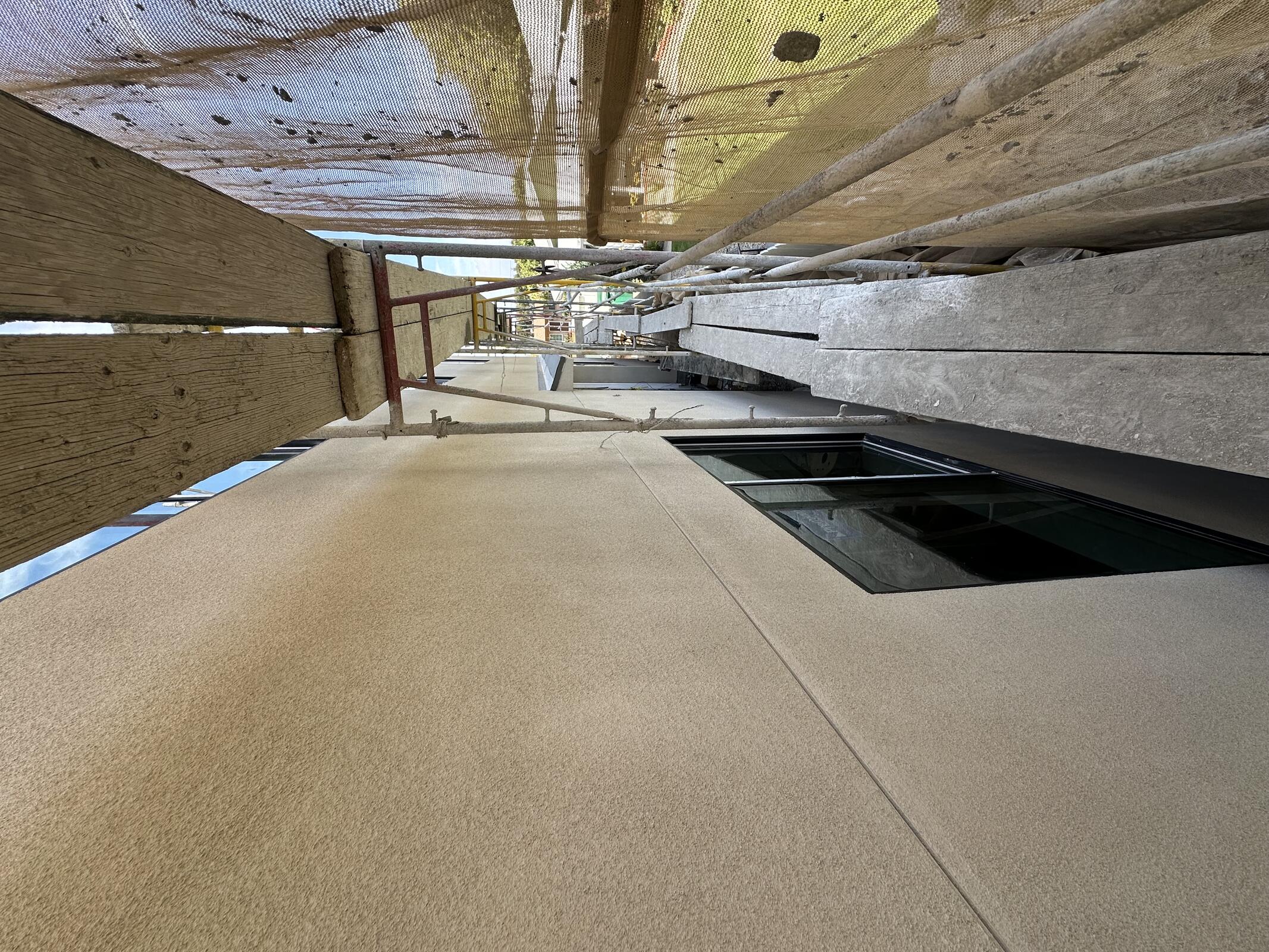

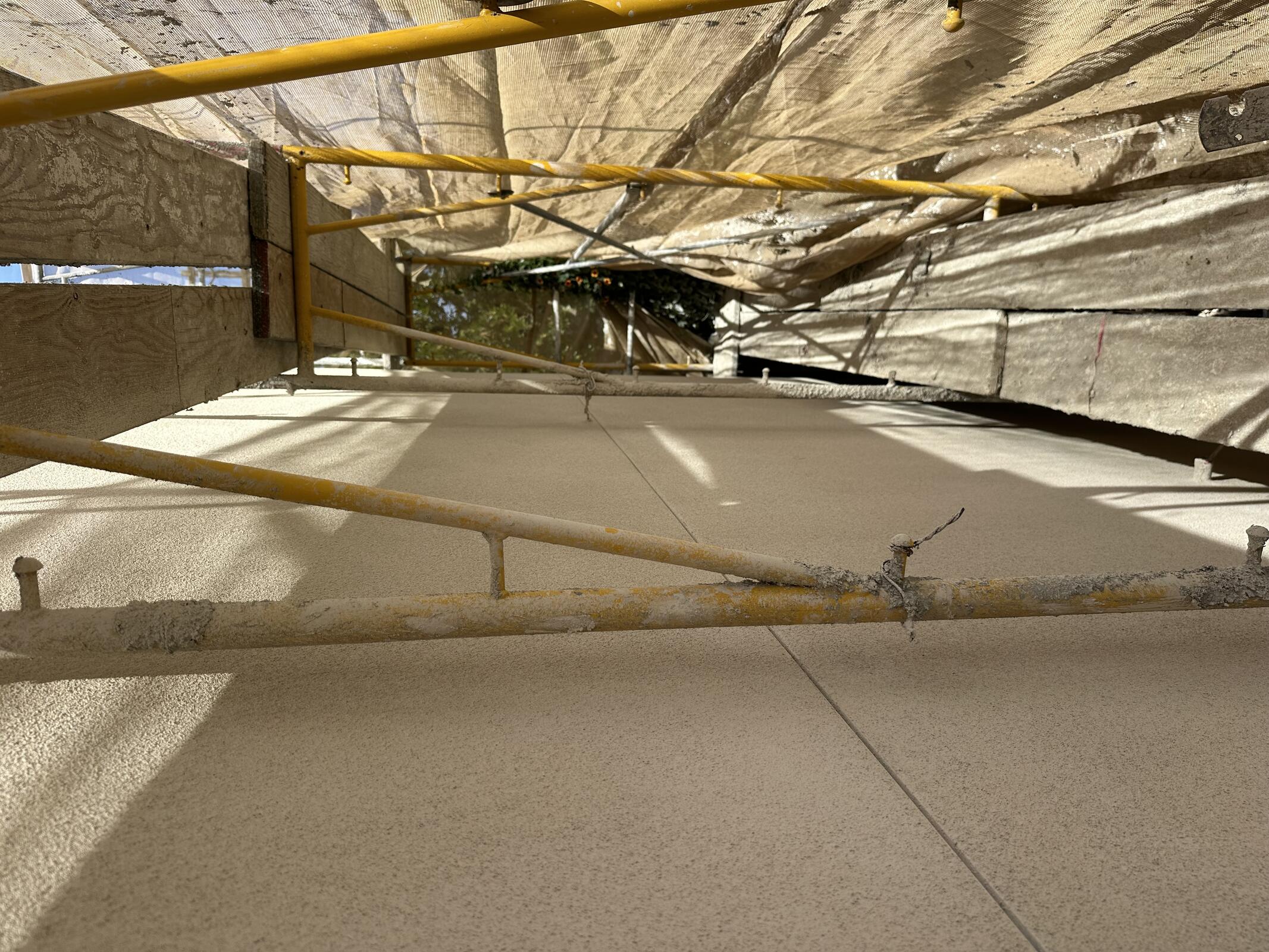

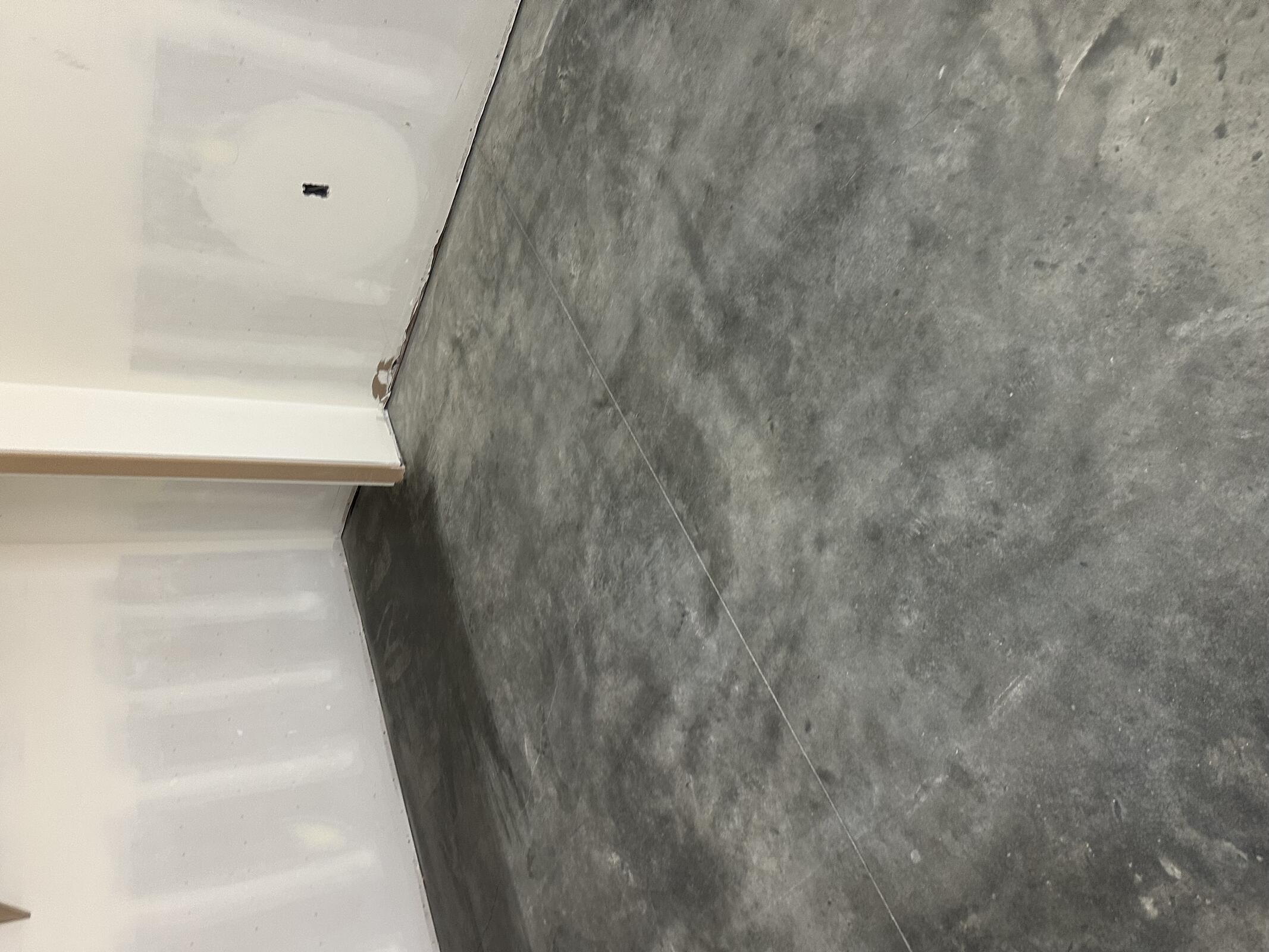

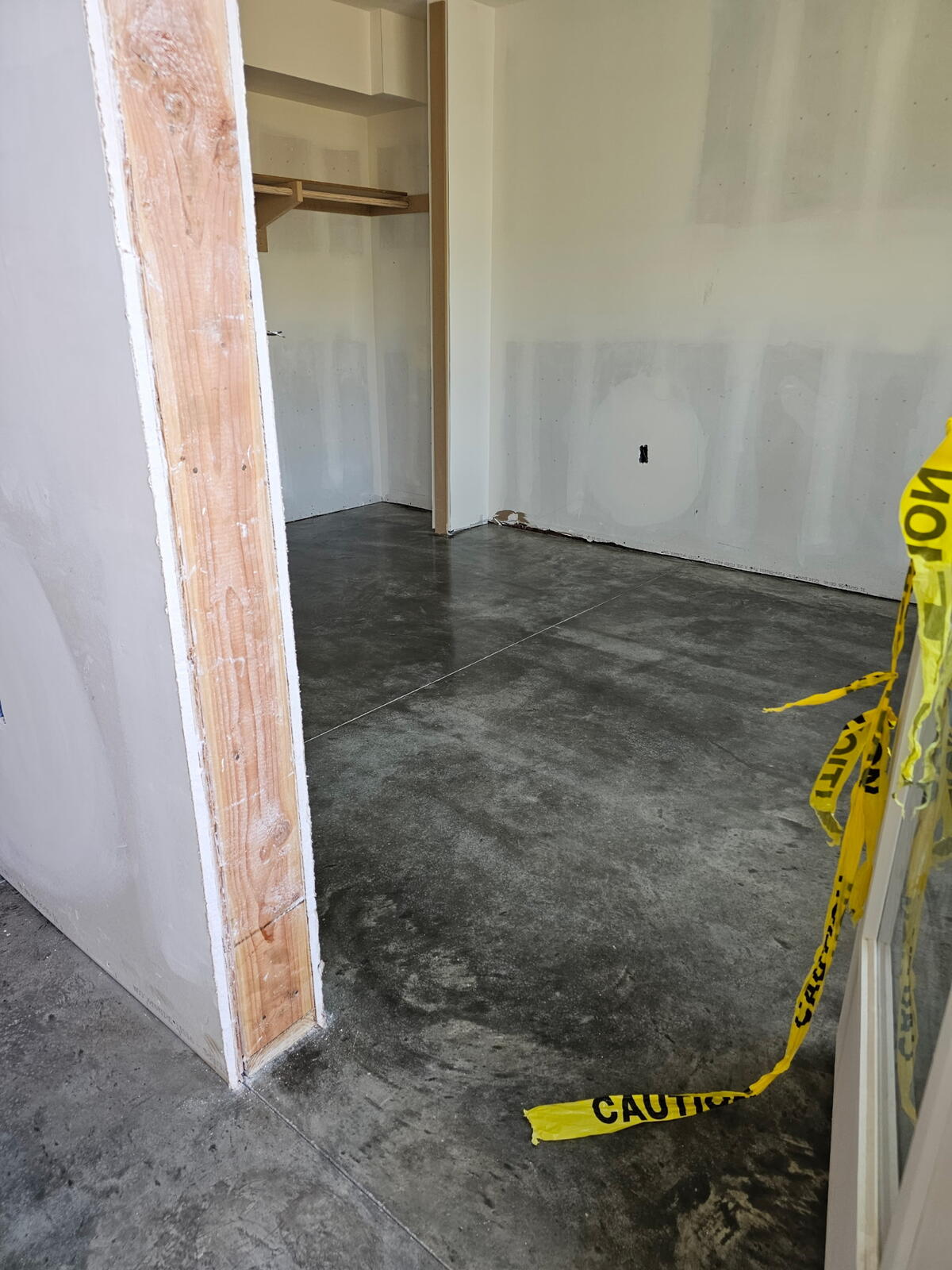

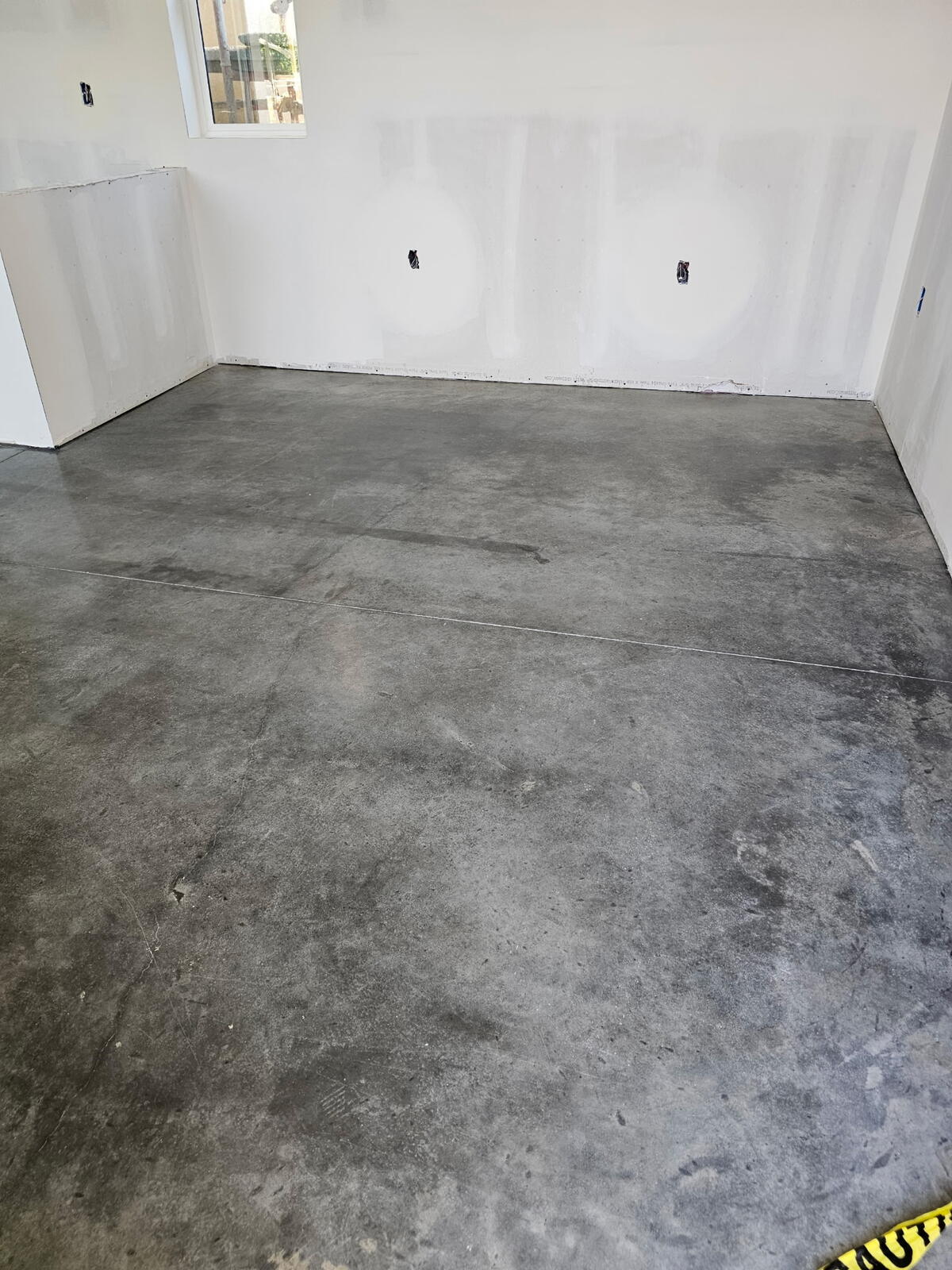

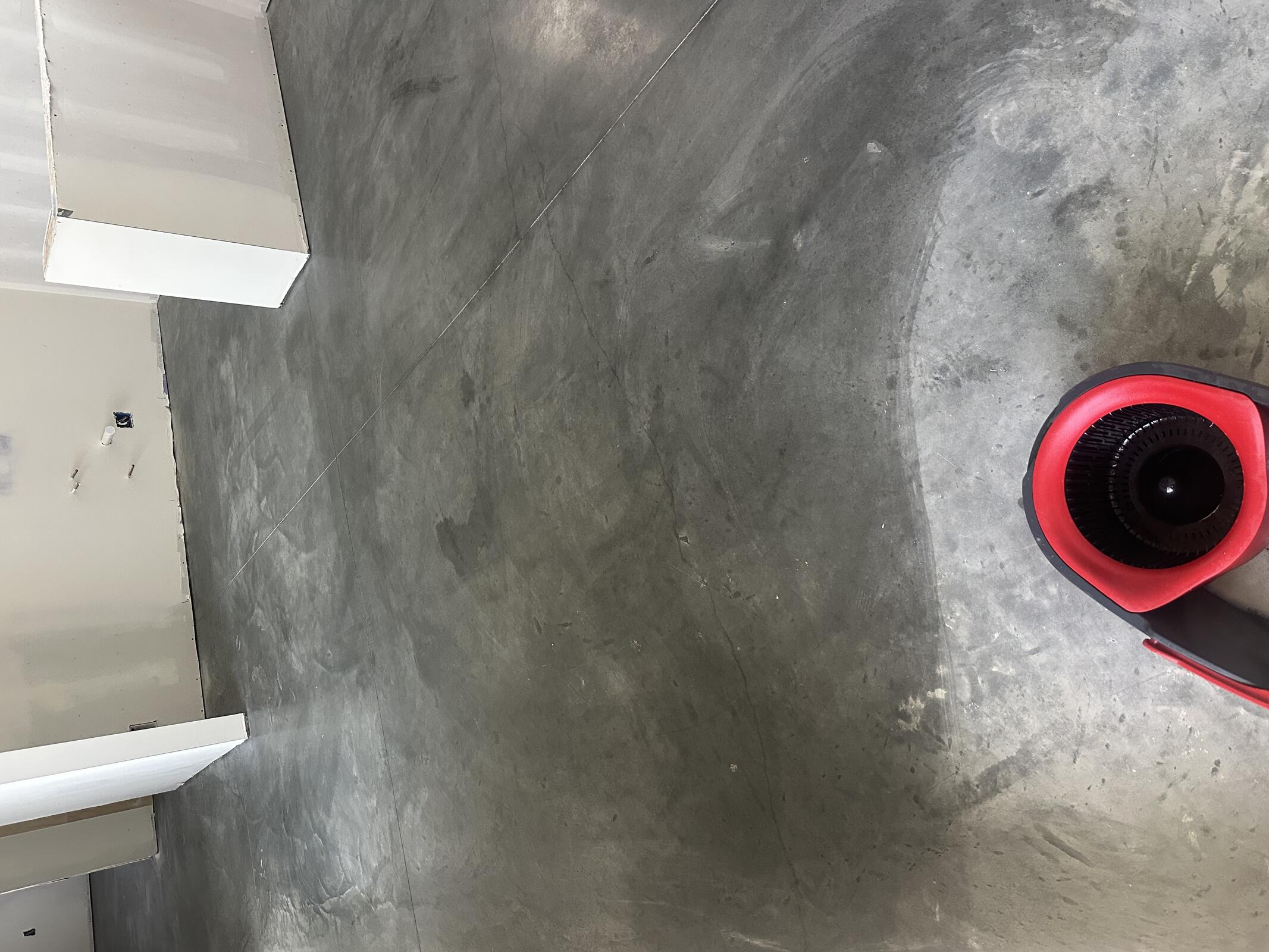

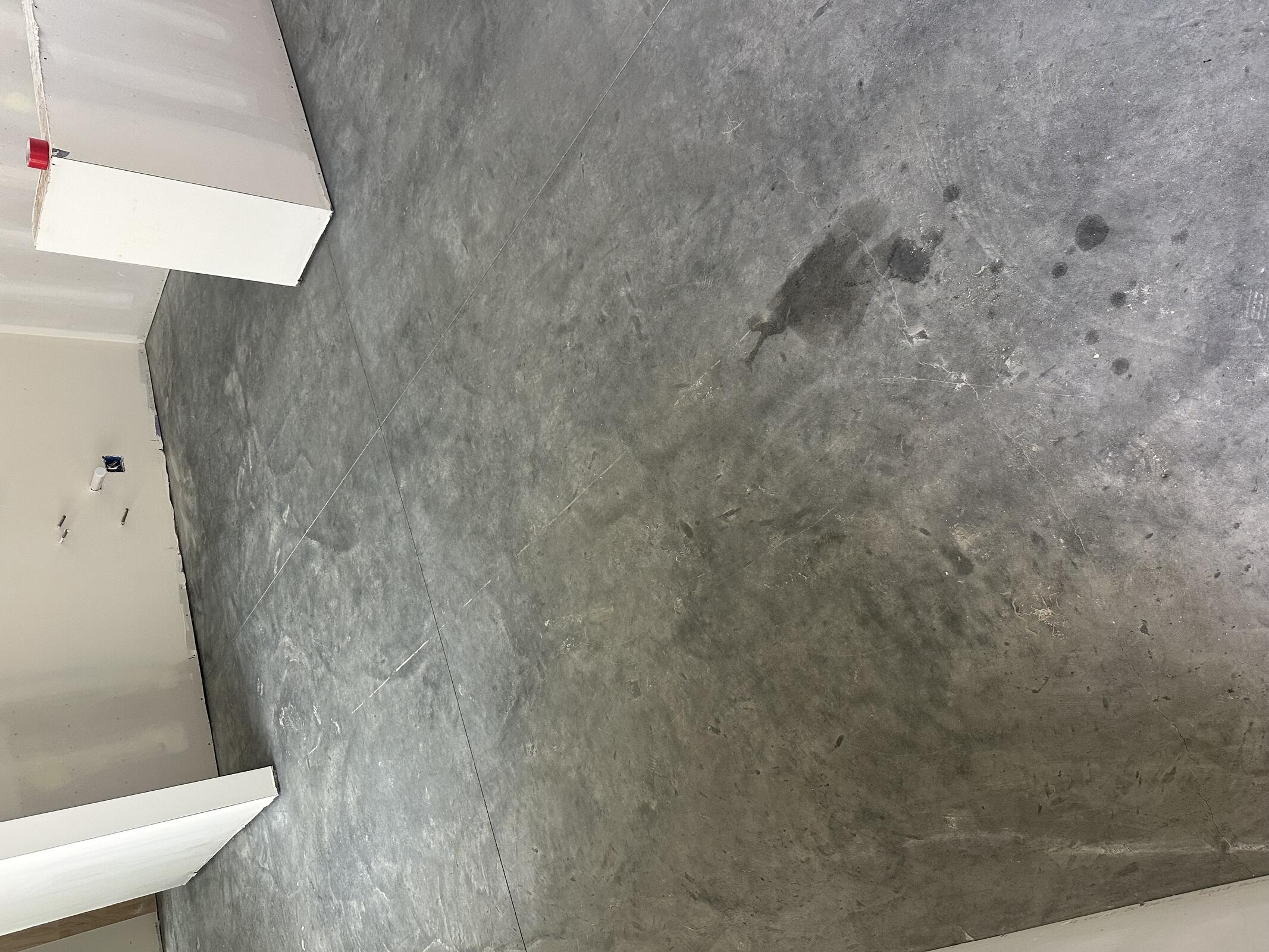

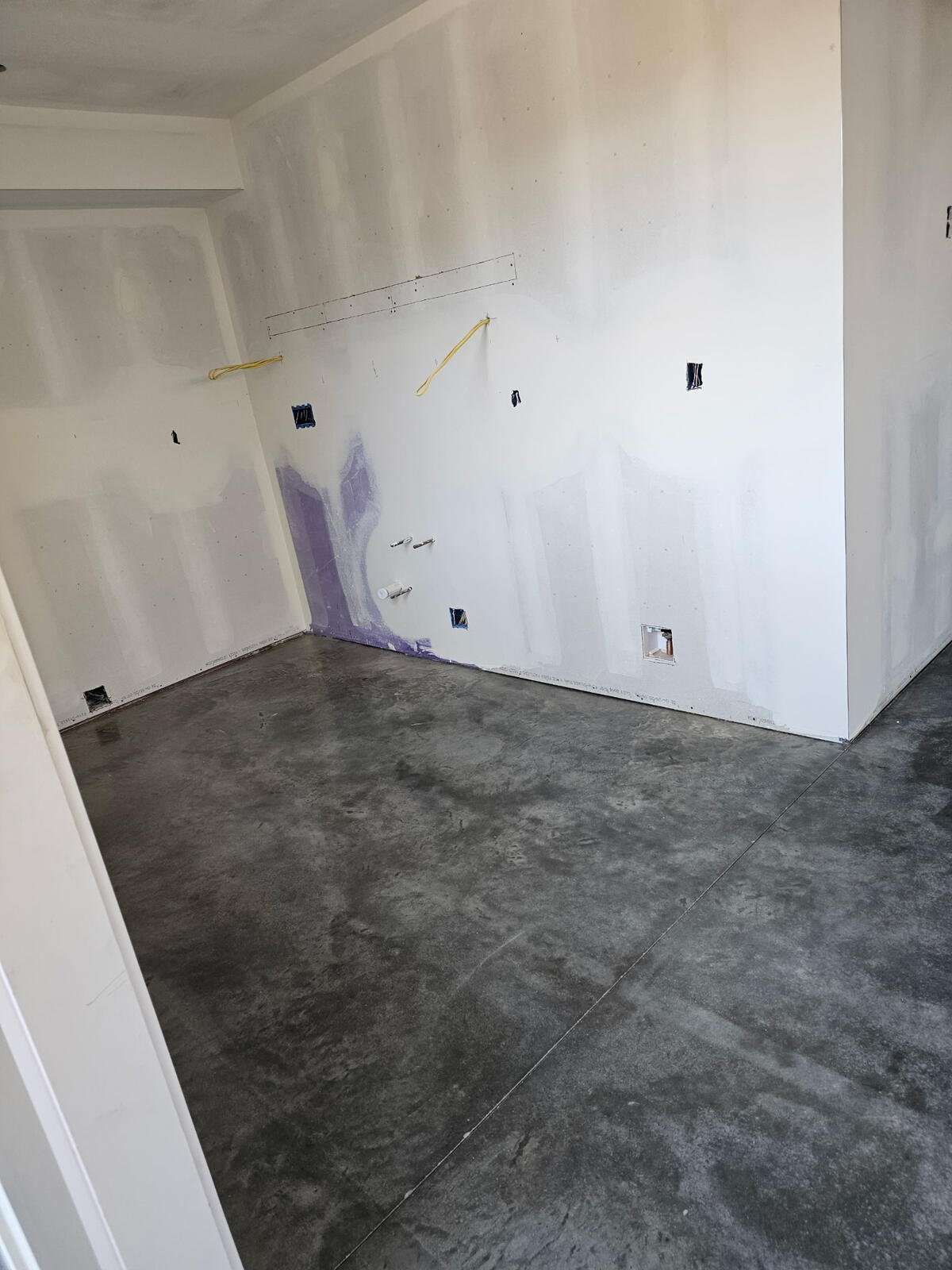

ML mopped B and C slabs to prepare for concrete burnishing and sealing.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
Coastal1.5812
Marq3824

Inspection: N/A

Wednesday, June 10, 2026

Clear, 72°F

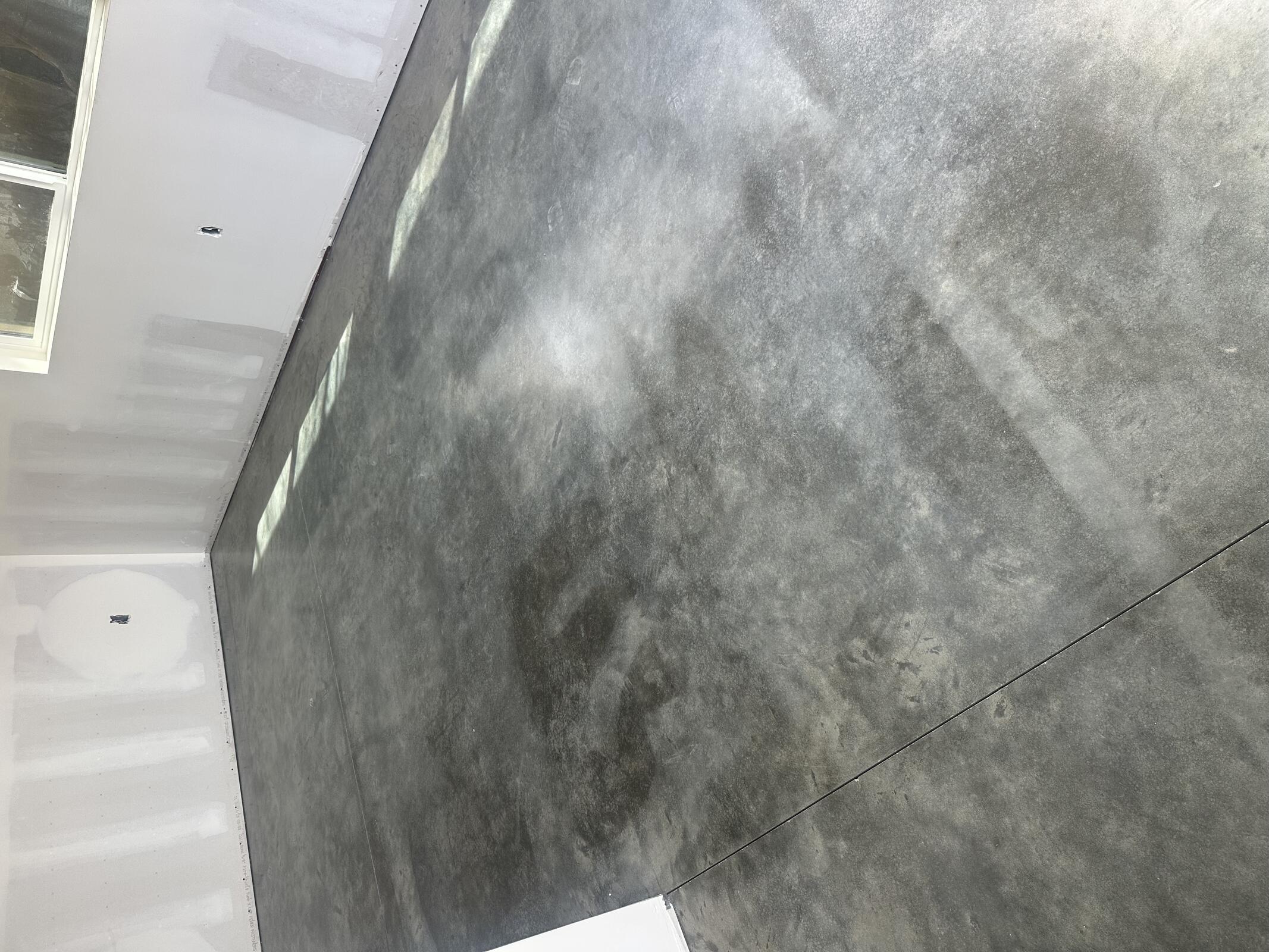

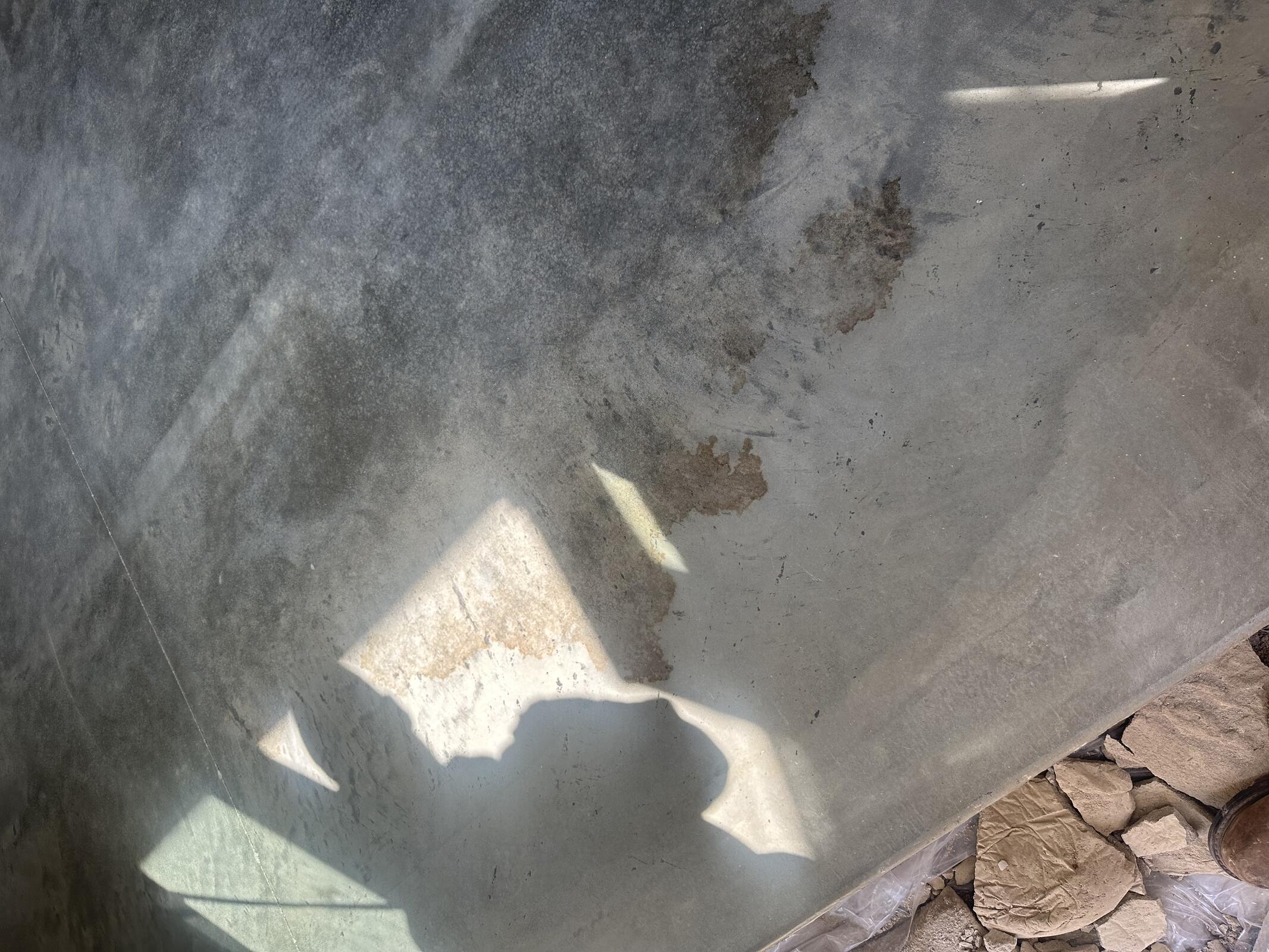

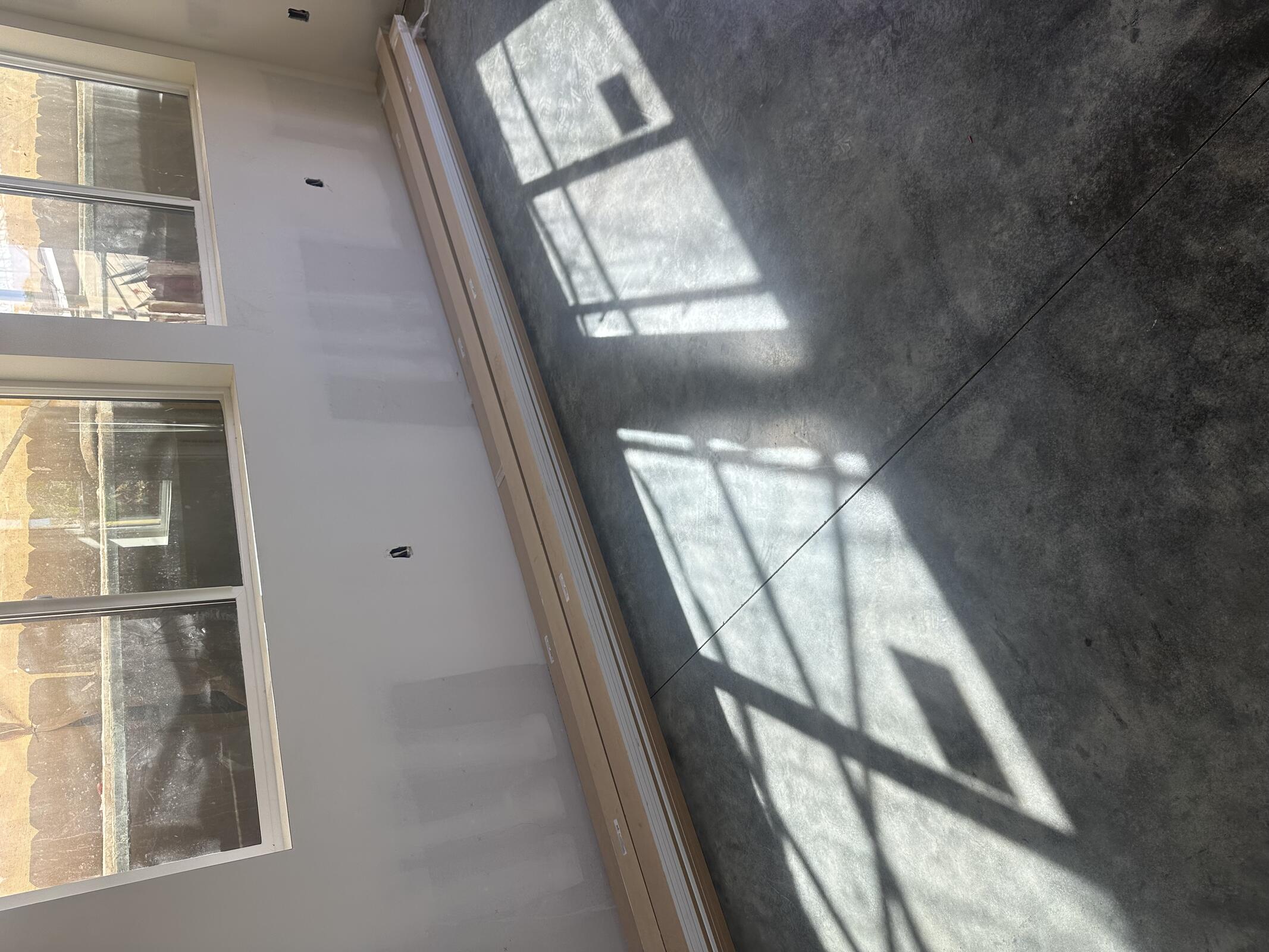

JBG applying sealant and burnishing B and C concrete floors.

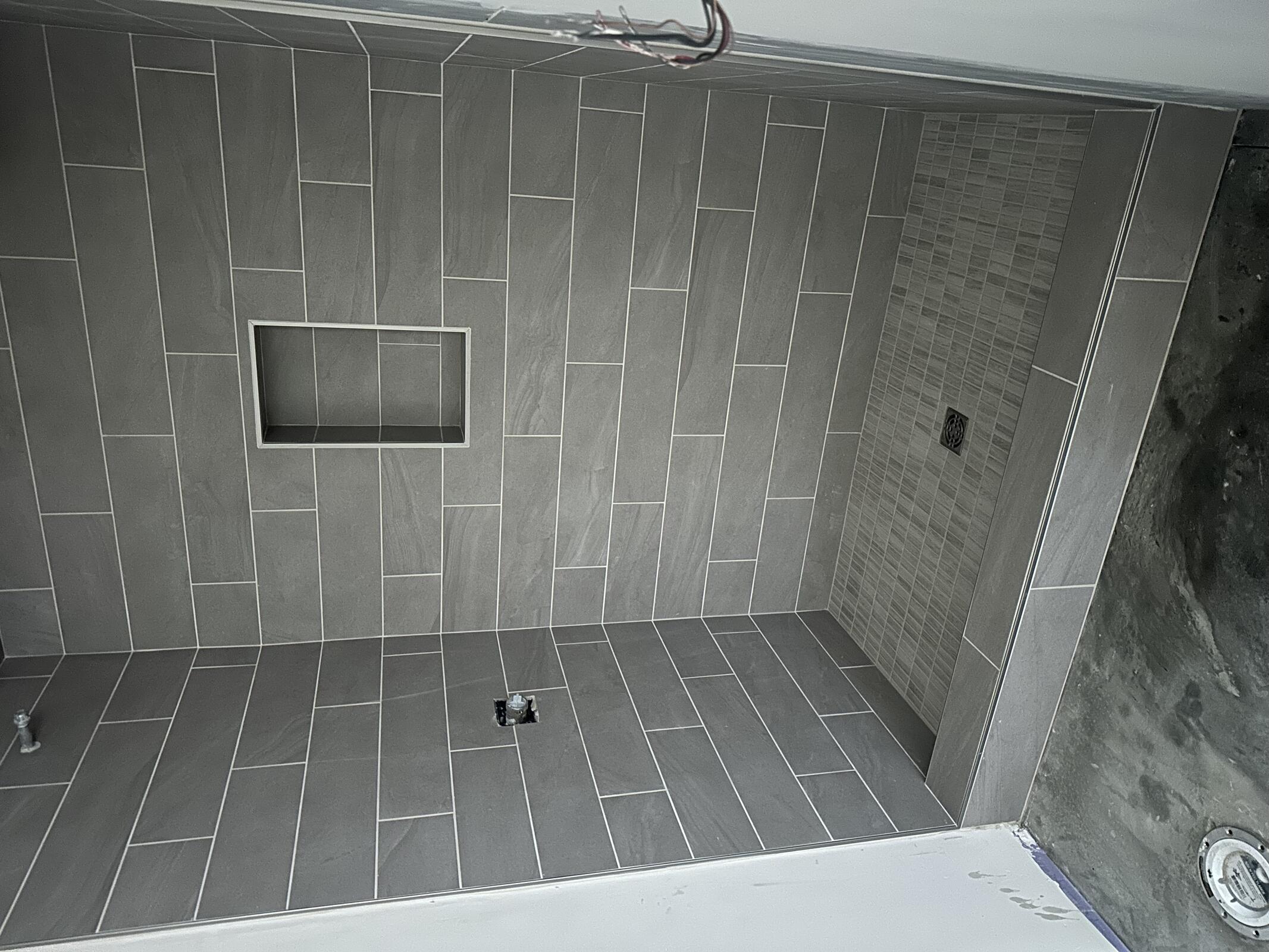

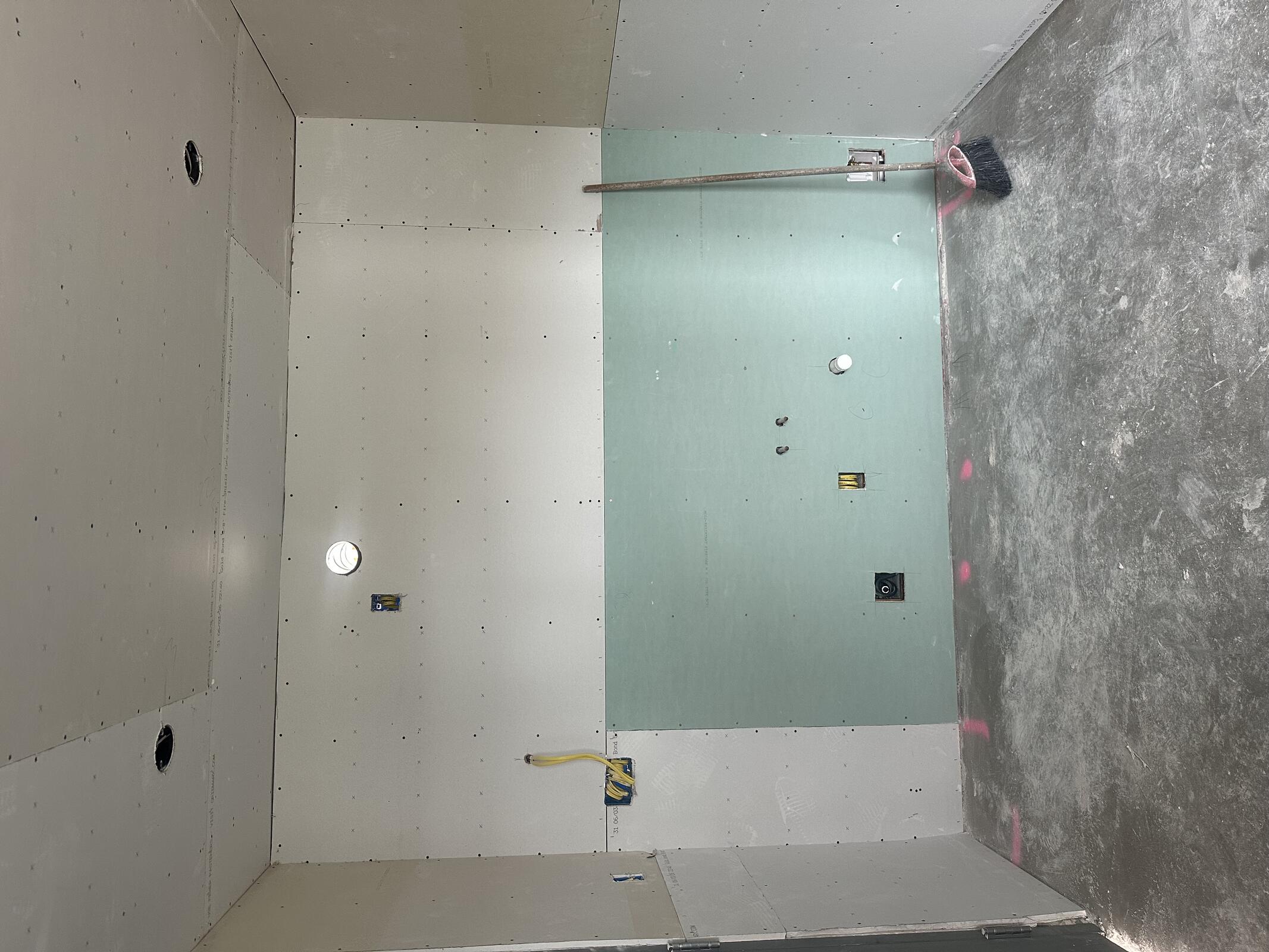

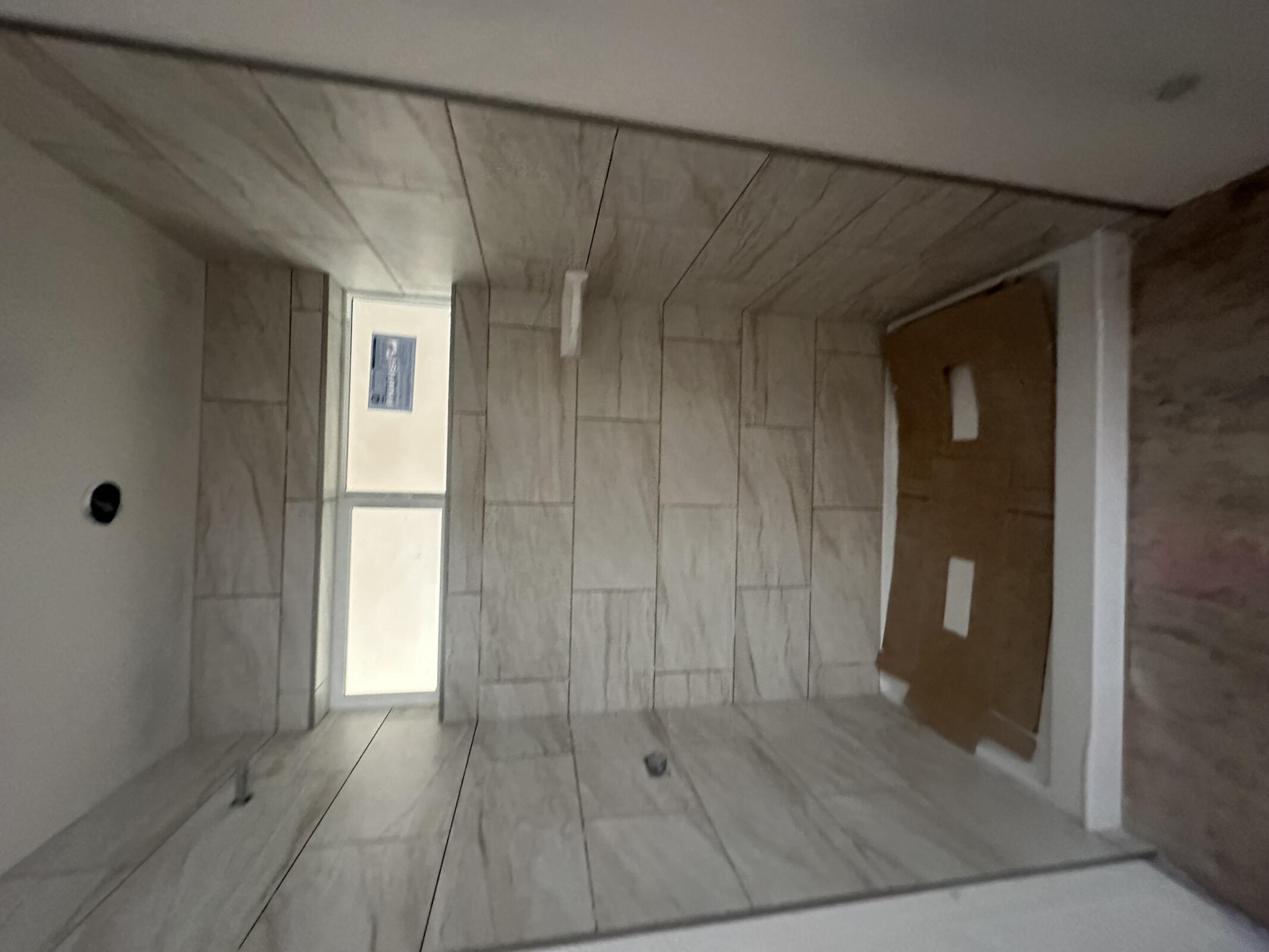

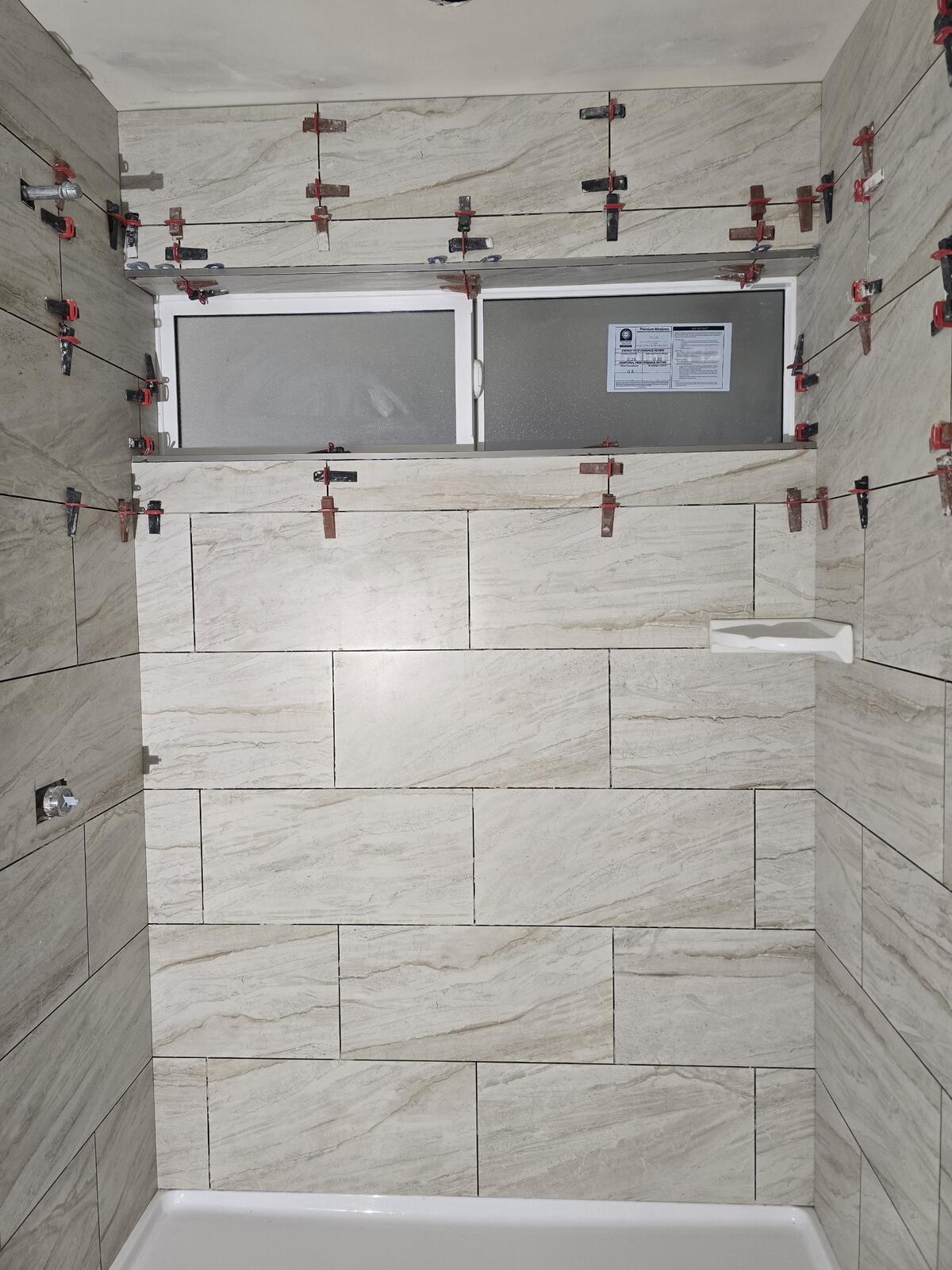

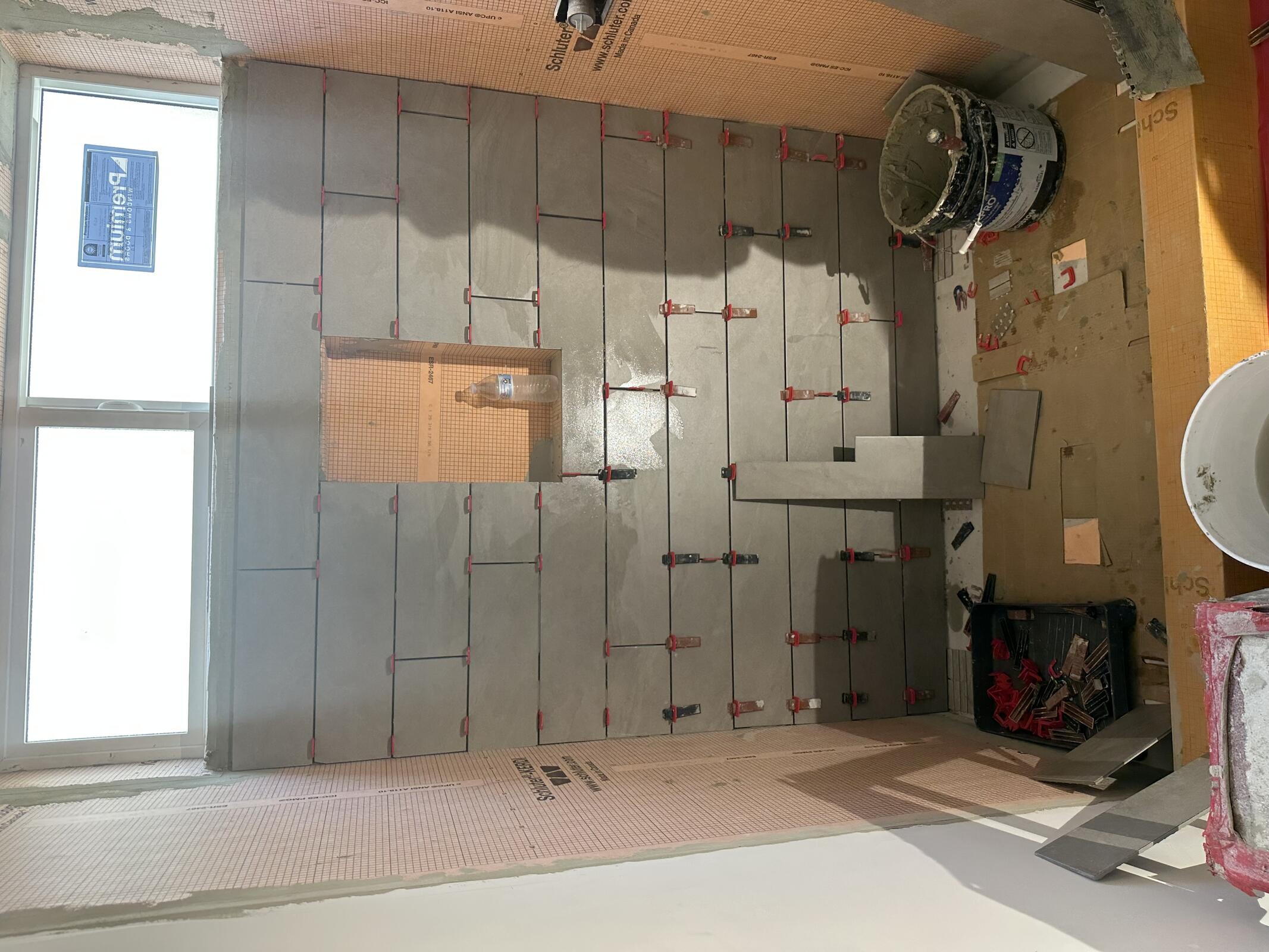

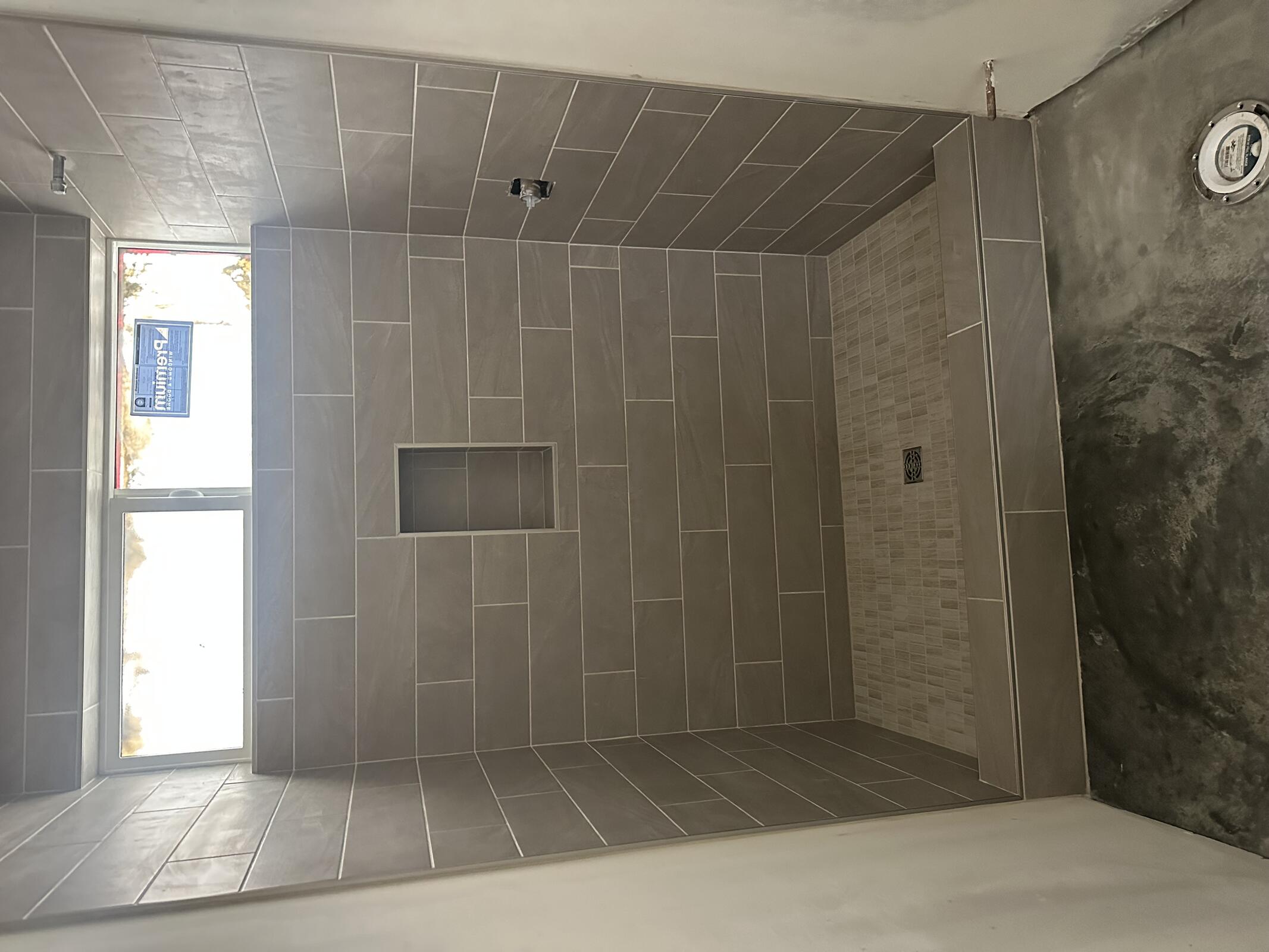

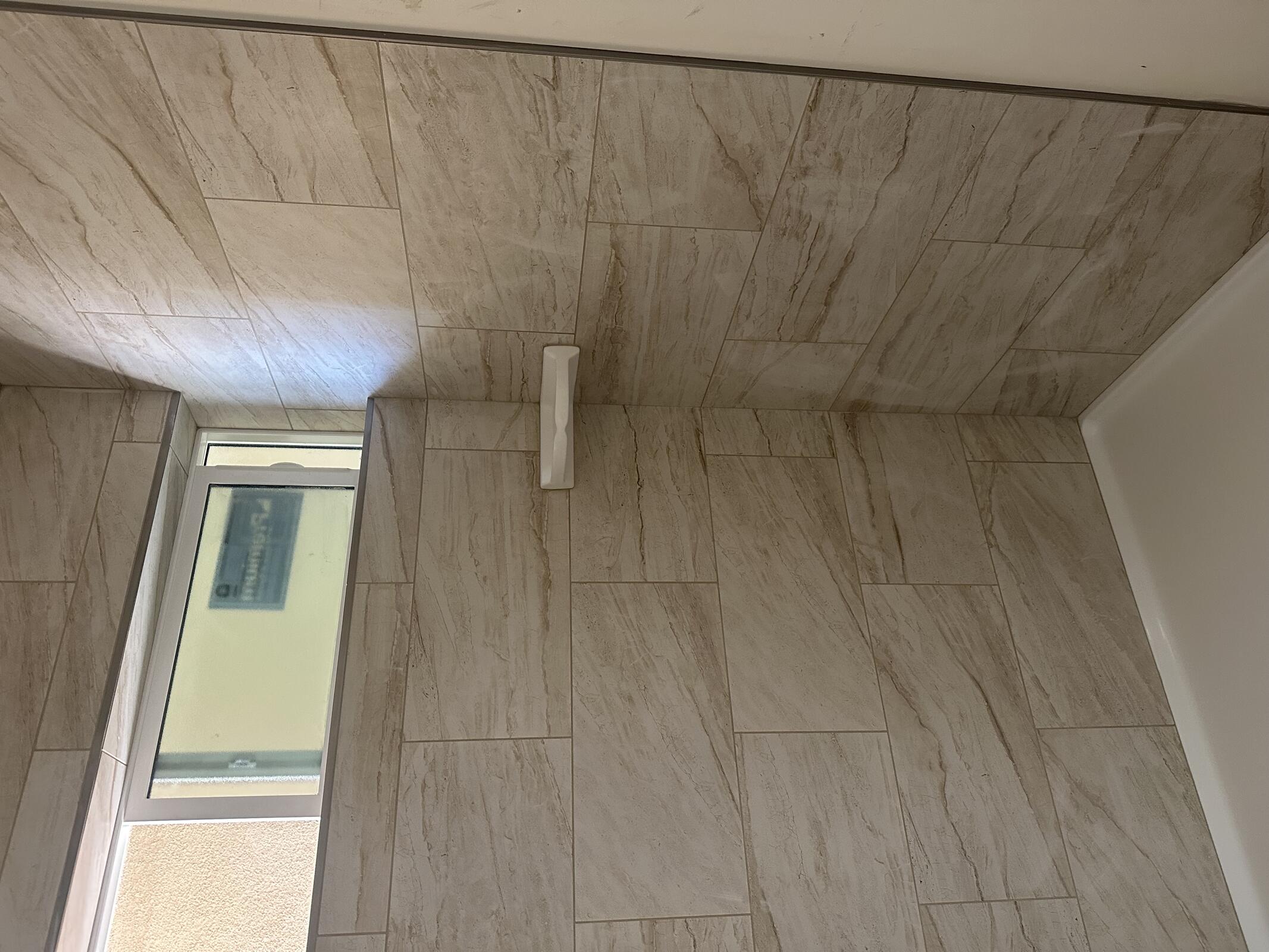

Coastal finishing leveling at garage conversion and continuing wall tile at B2.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
JBG2816
Coastal1.5812

Inspection: N/A

Thursday, June 11, 2026

Partially cloudy, 75°F

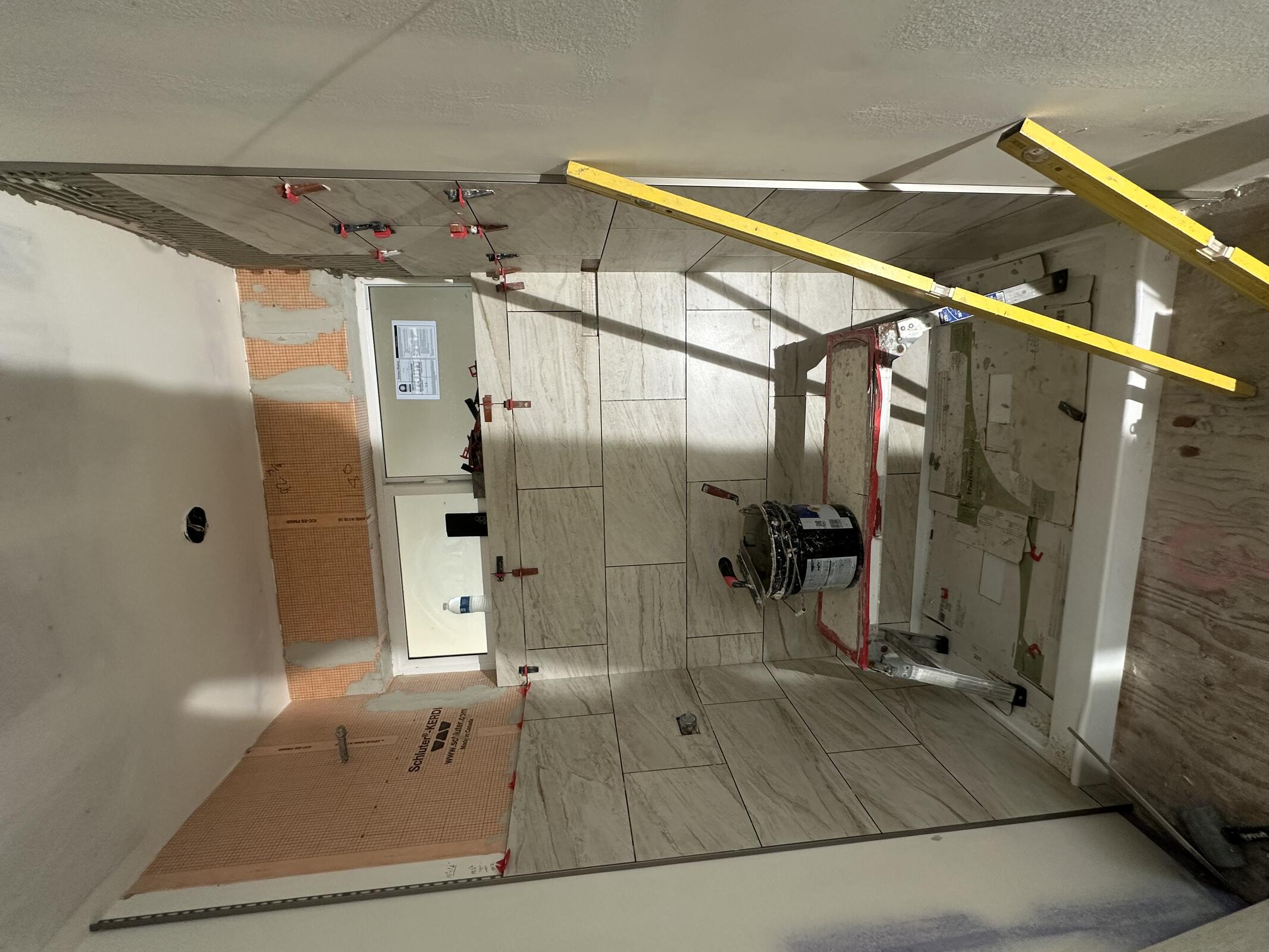

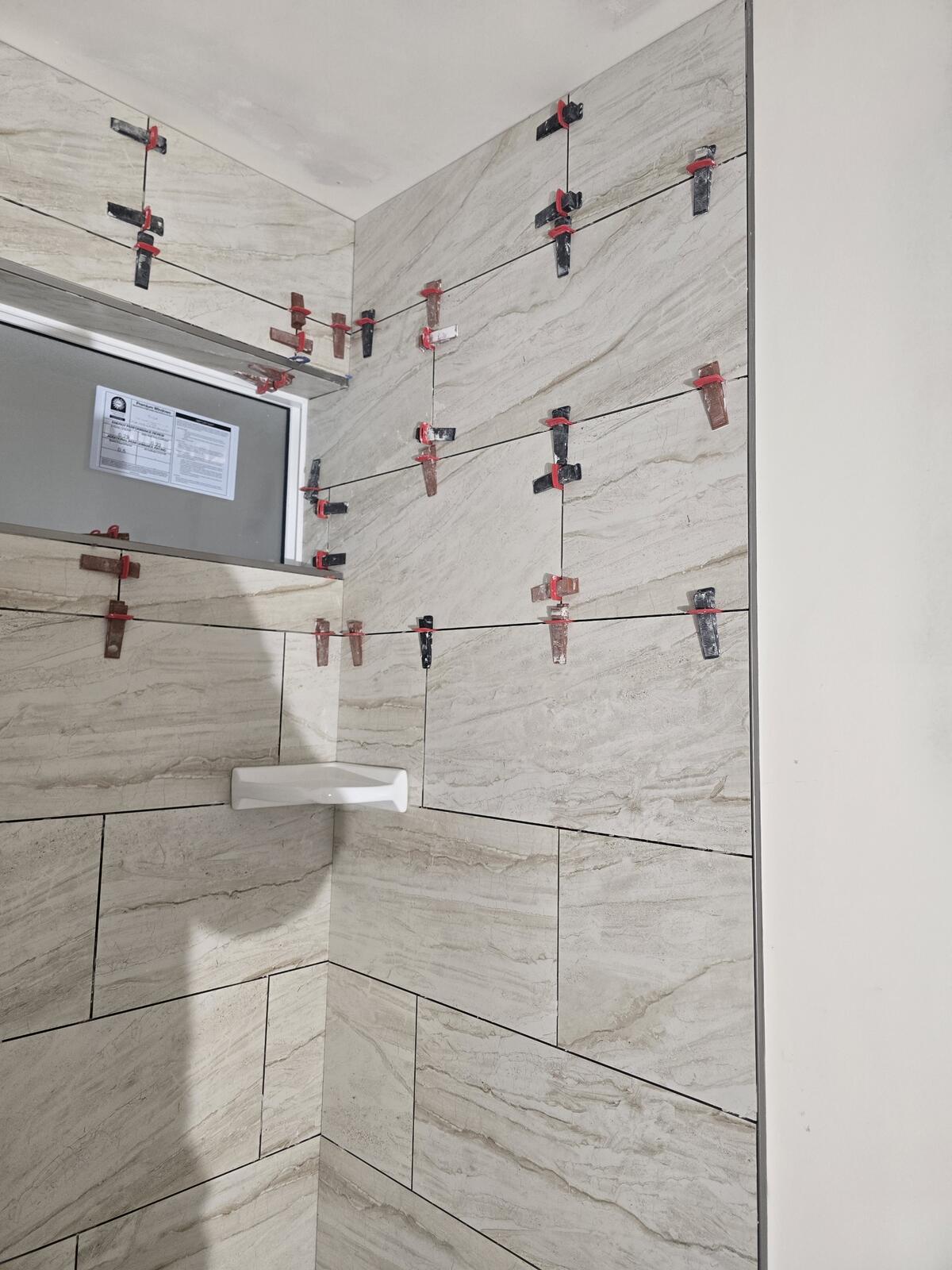

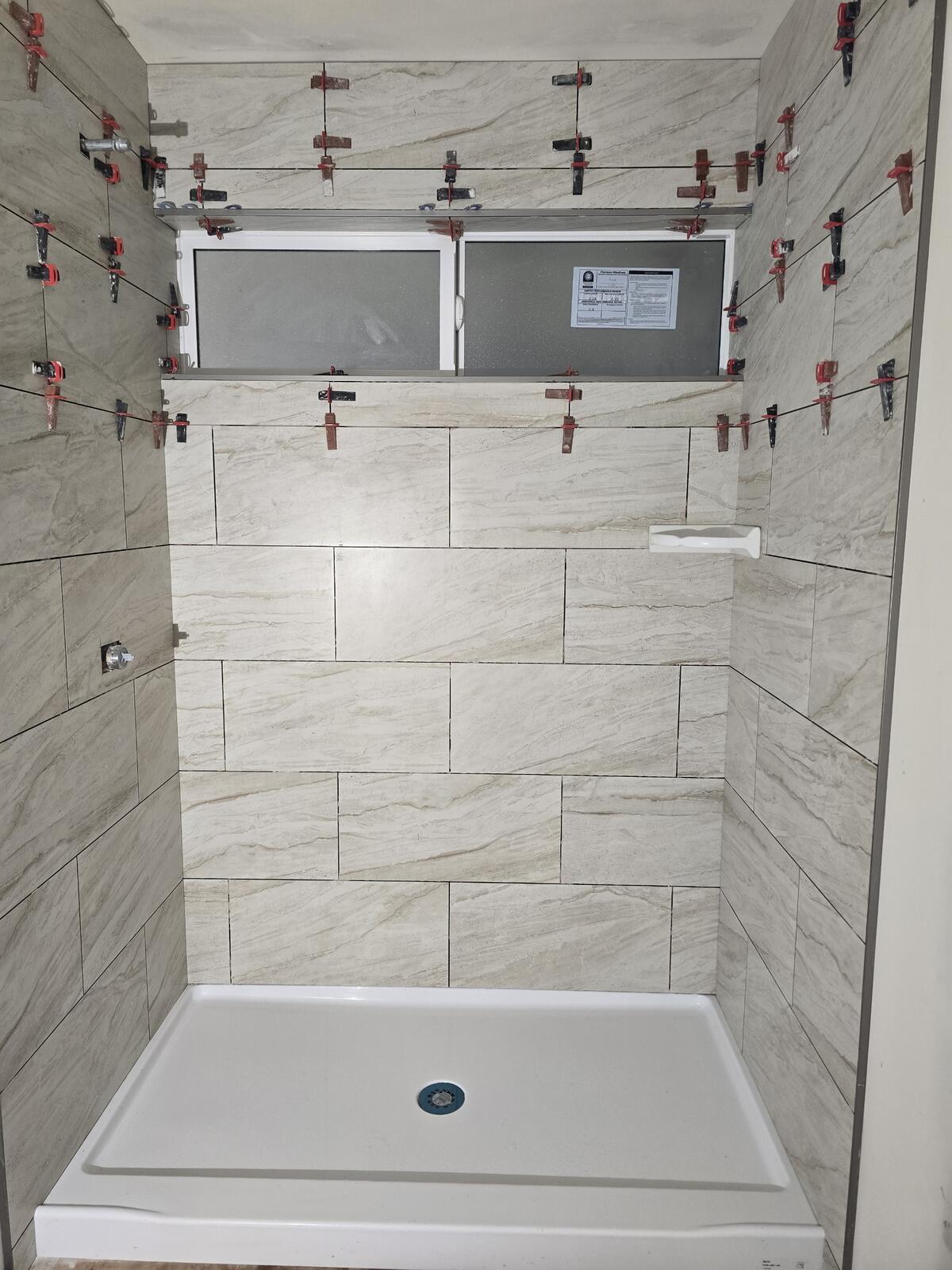

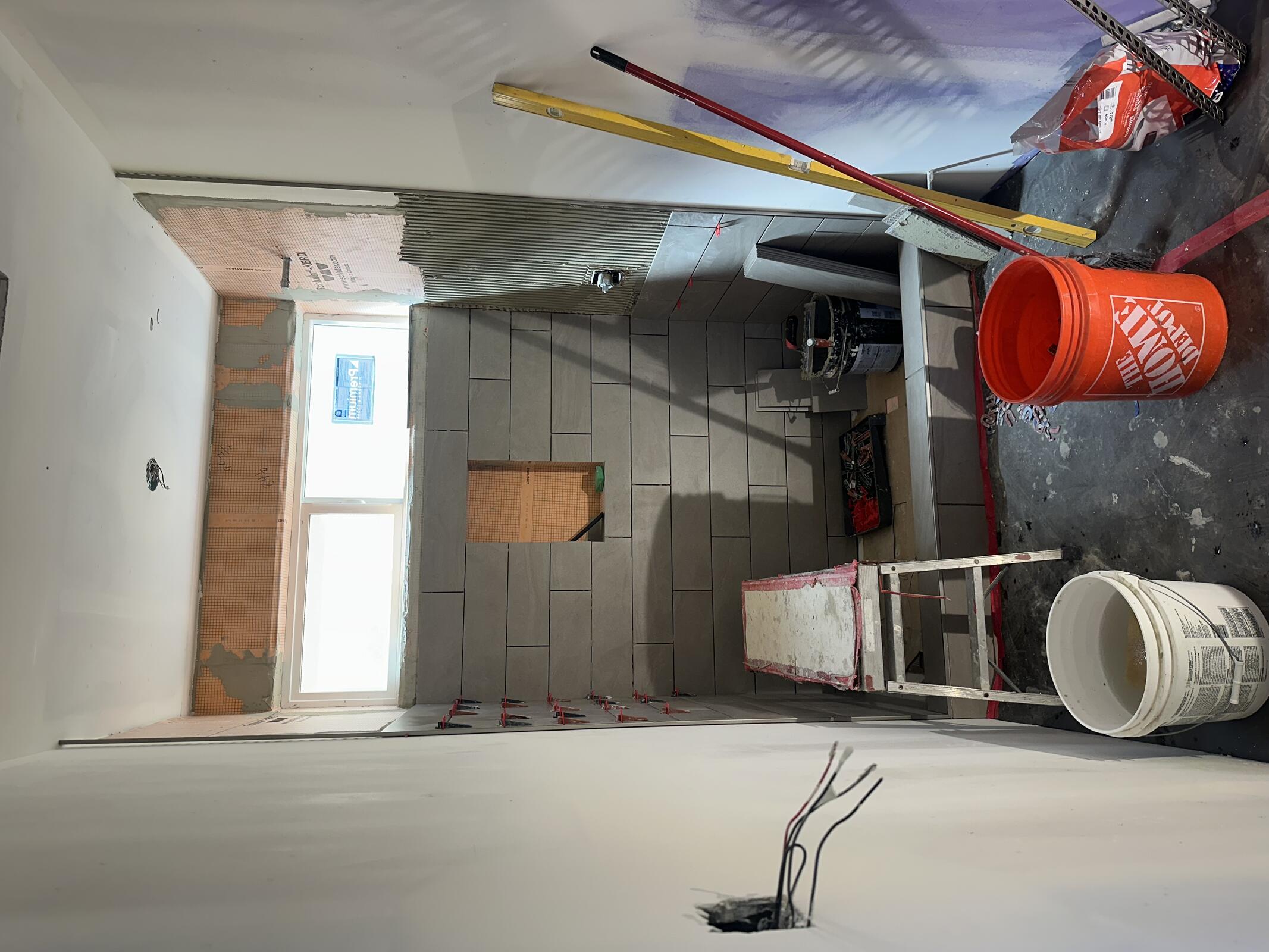

Coastal grouting shower wall tile in B2 and starting layout in C2.

AC Electric doing pick up items.

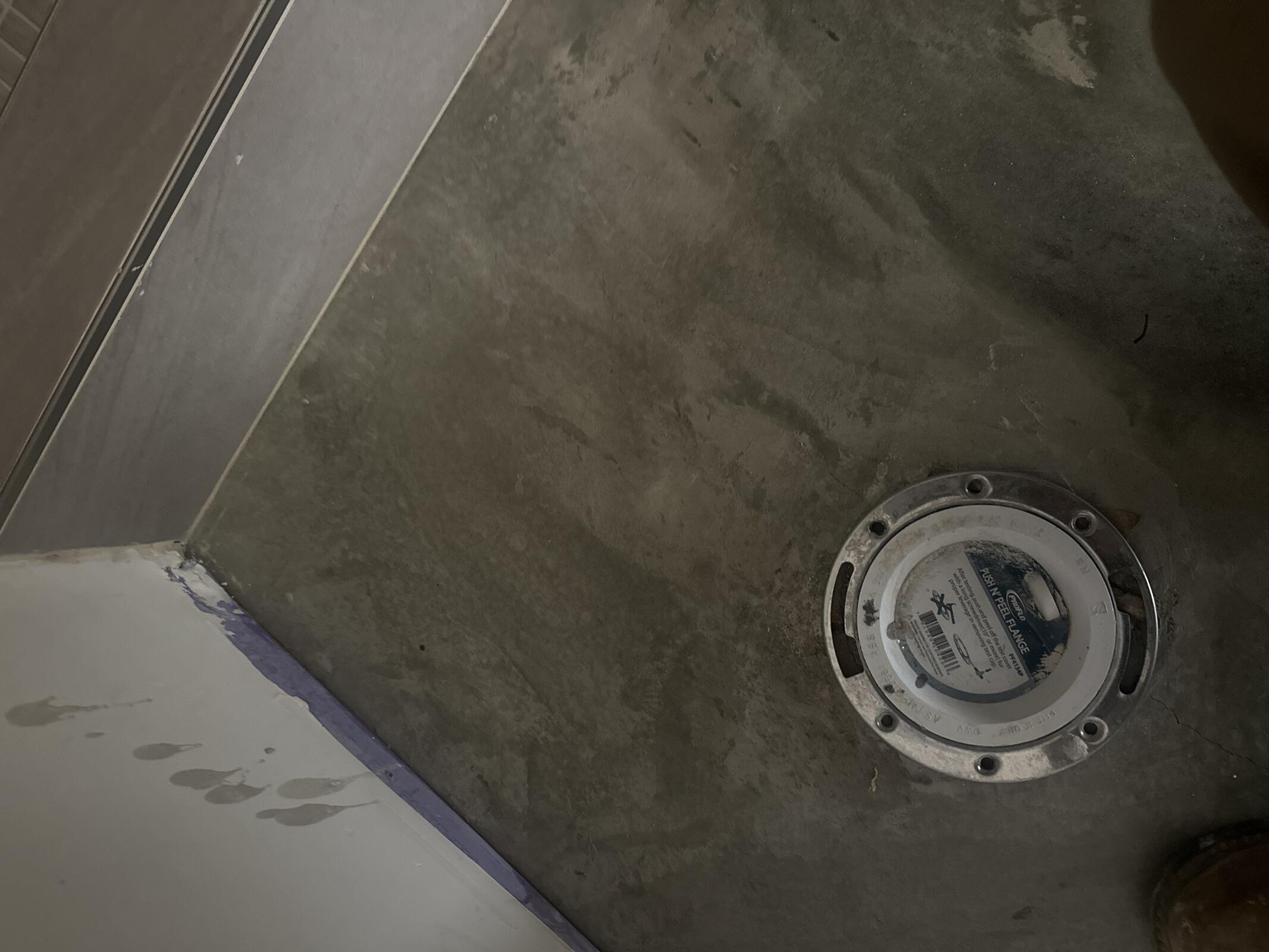

ZSP installing shower pan at Garage.

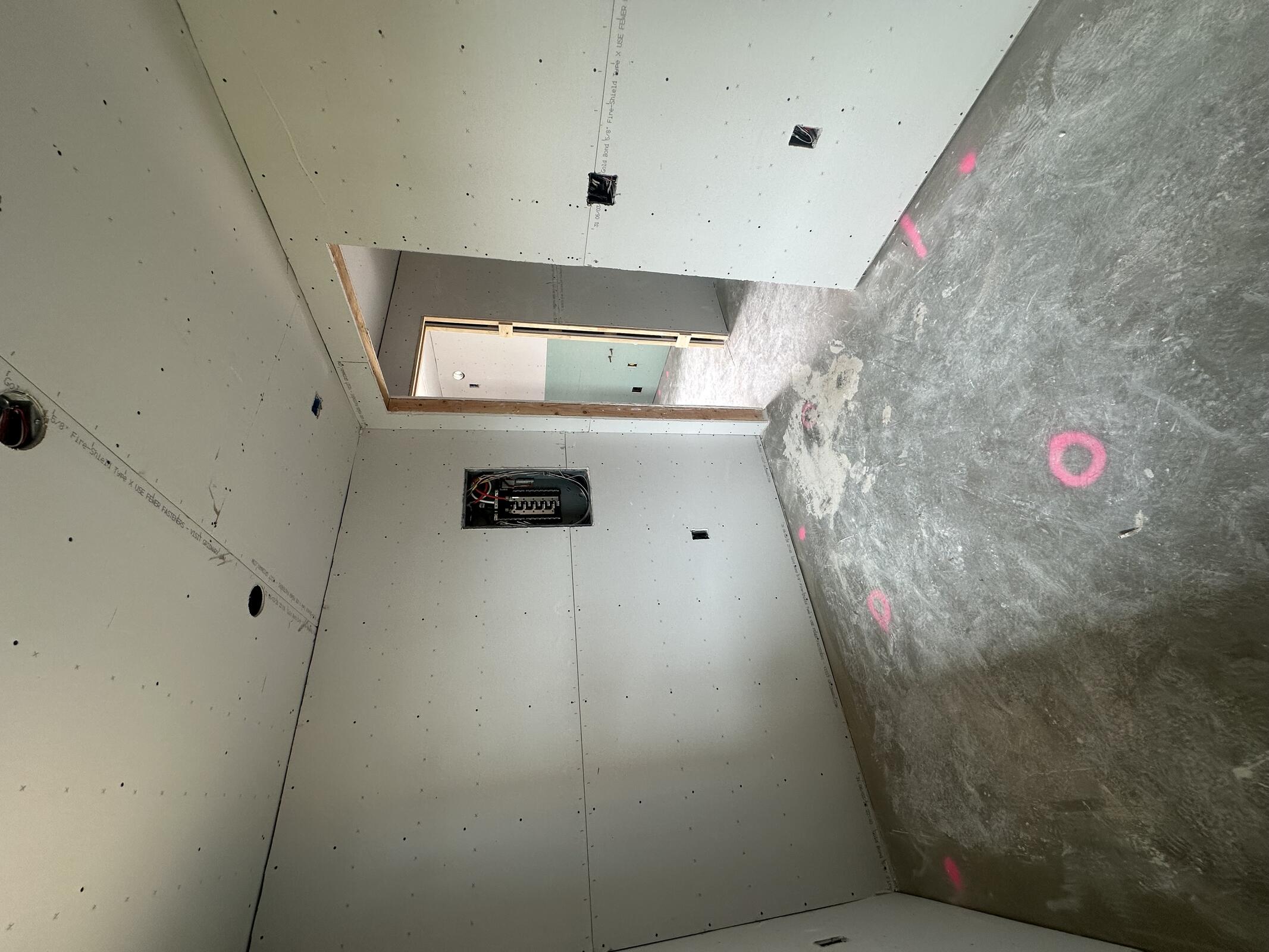

JBG fixing garage entry door RO.

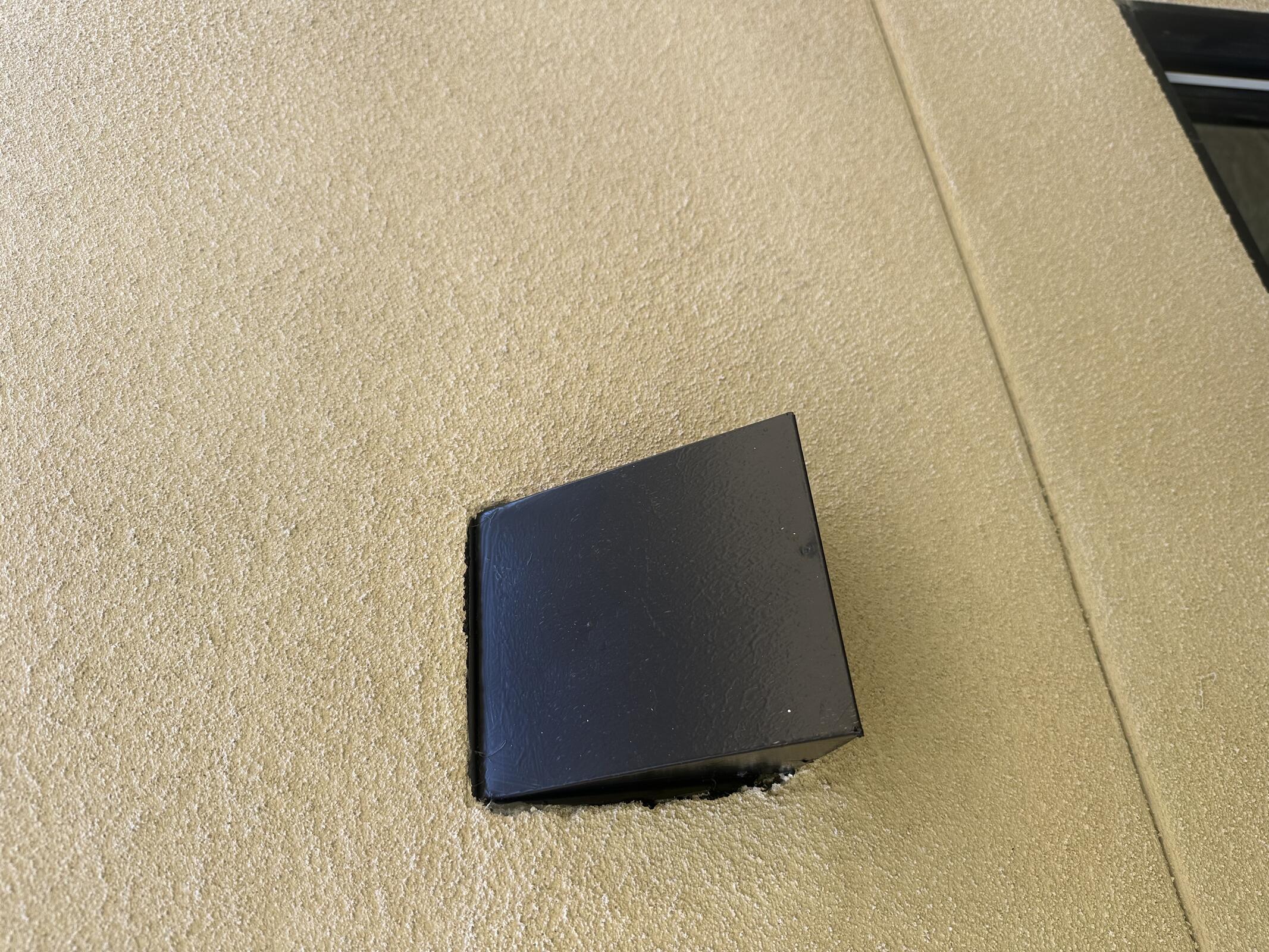

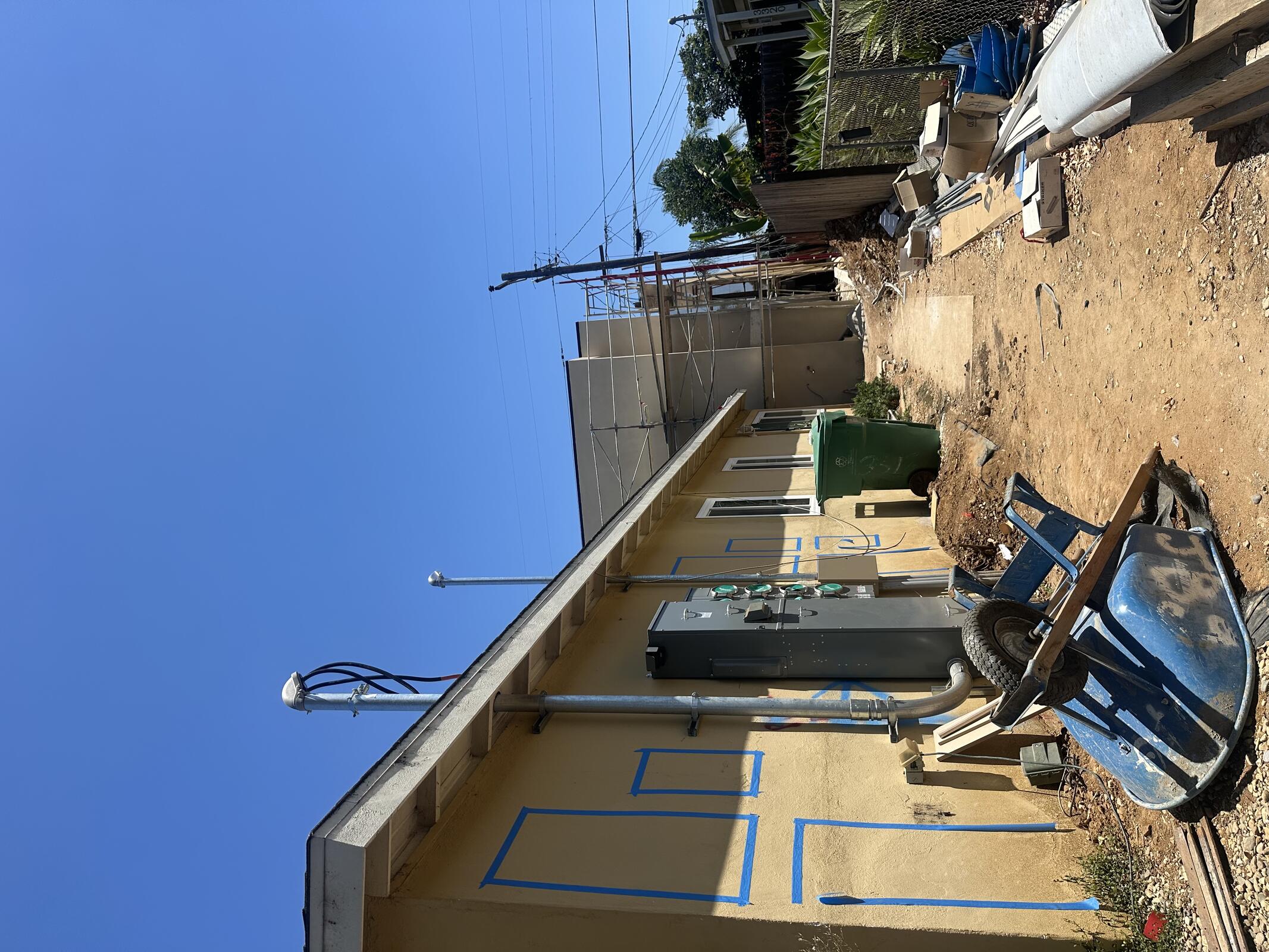

Sunline installing equipment on Building C wall.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
AC Electric122
Coastal188
JBG122

Inspection: N/A

Friday, June 12, 2026

Clear, 75°F

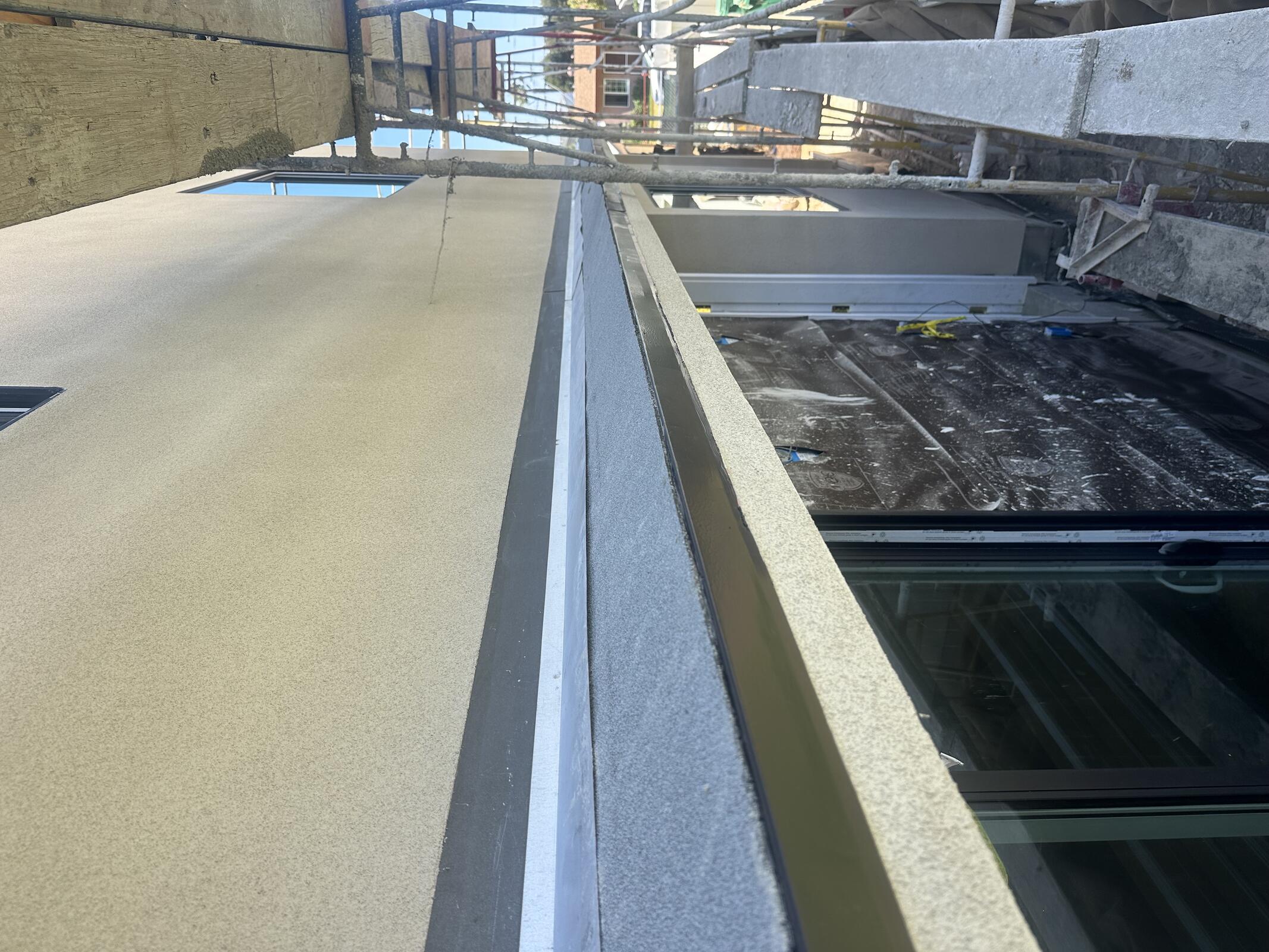

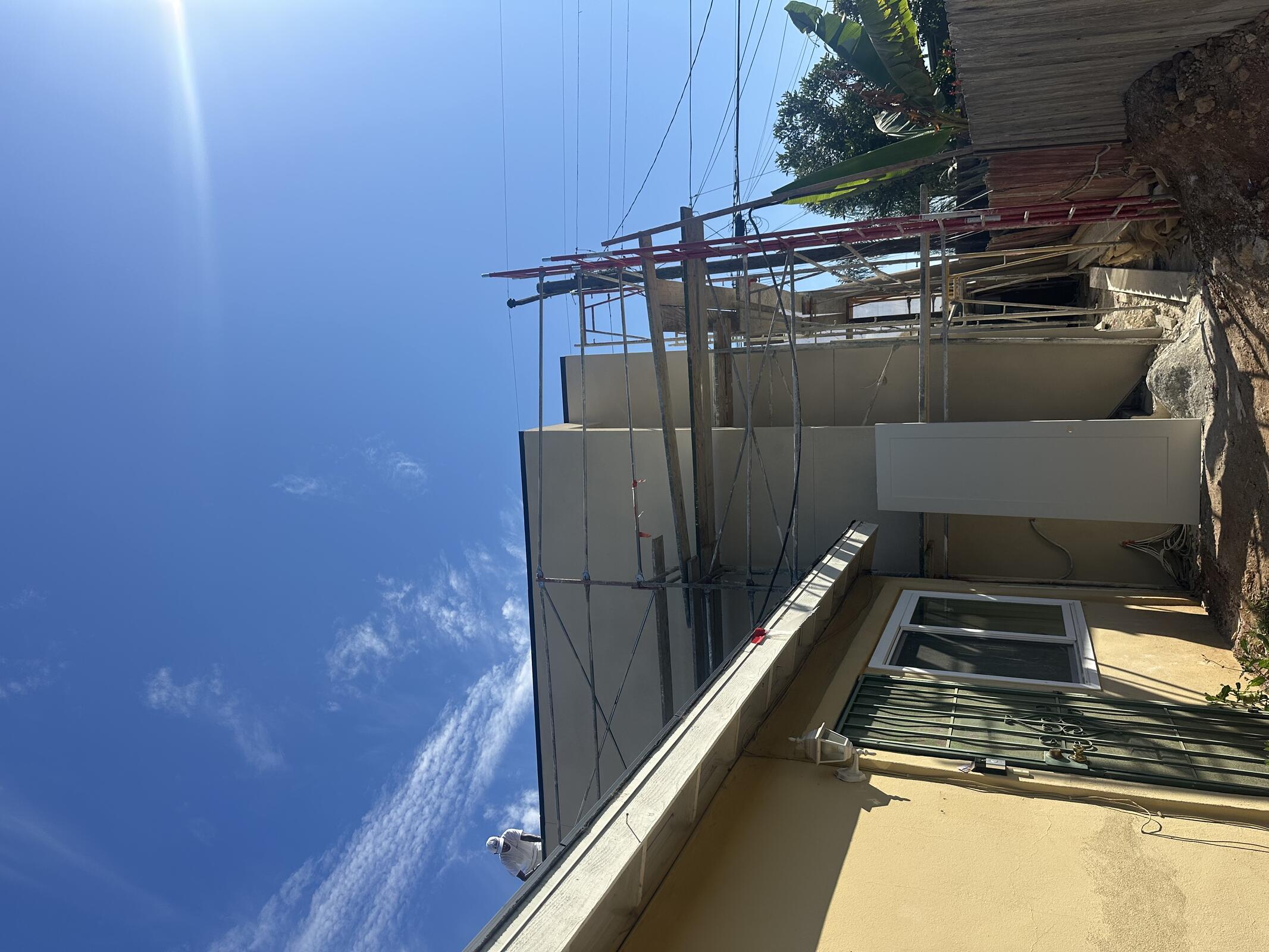

Painters Unlimited painting drip edge at B&C.

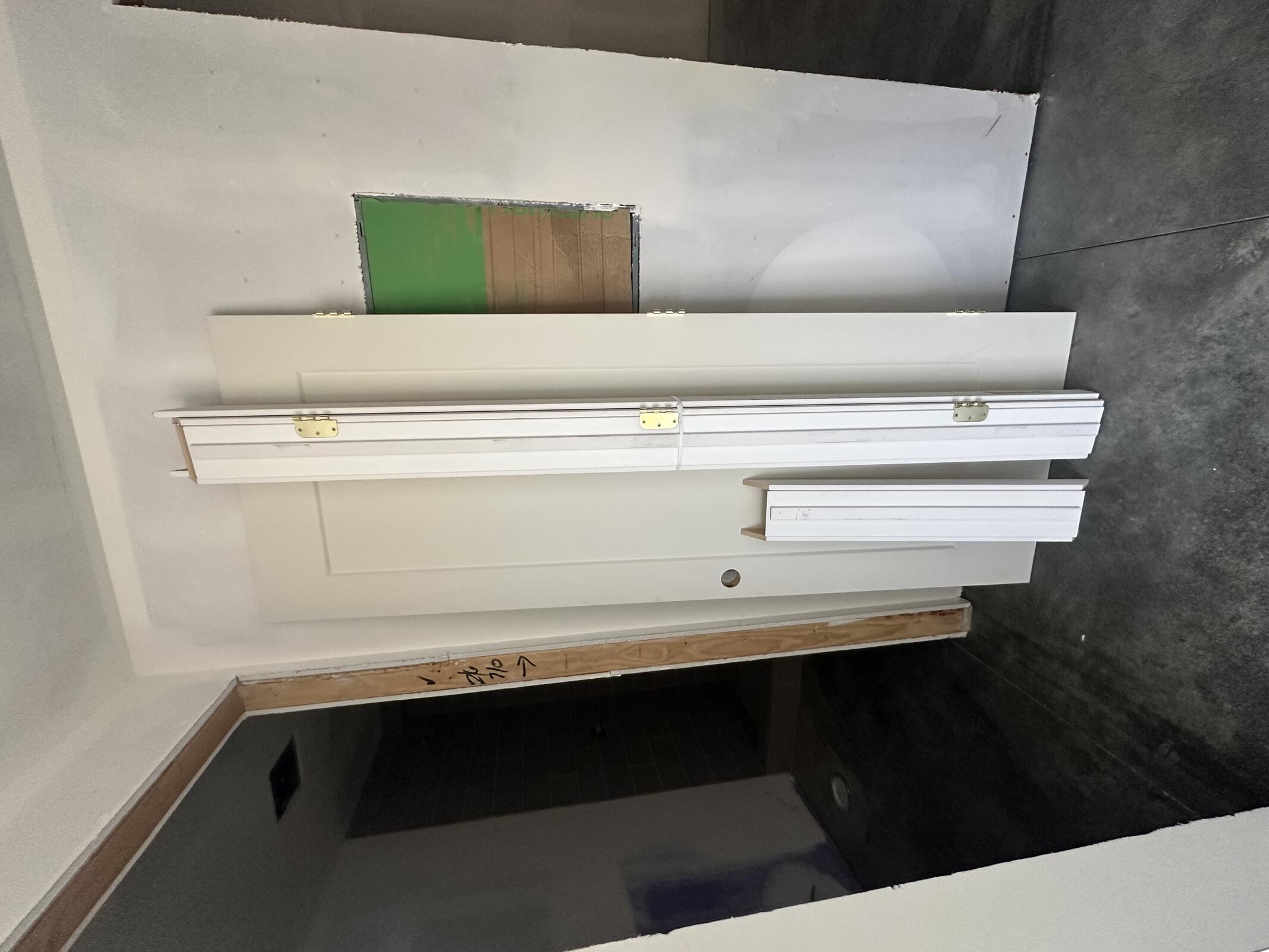

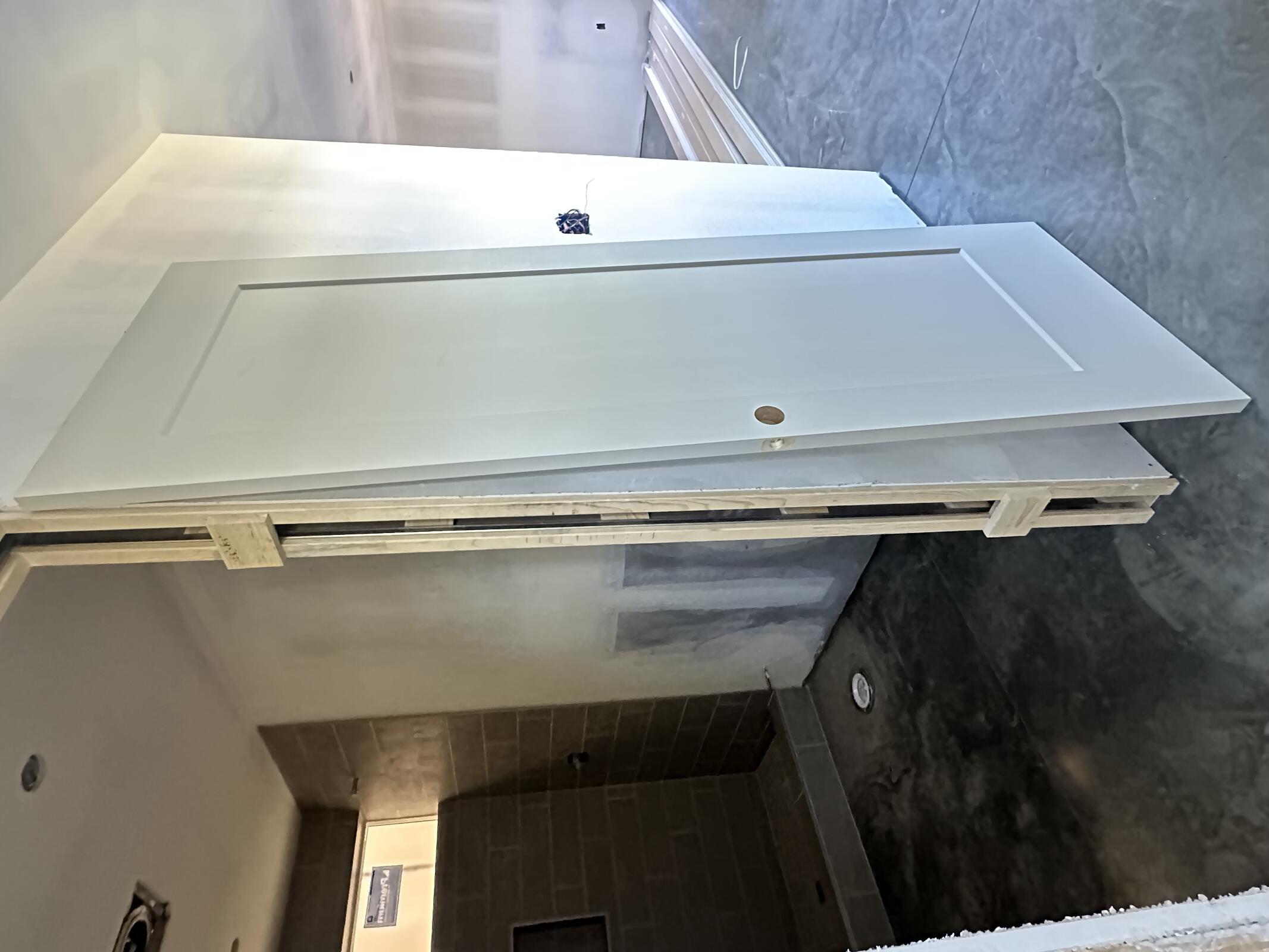

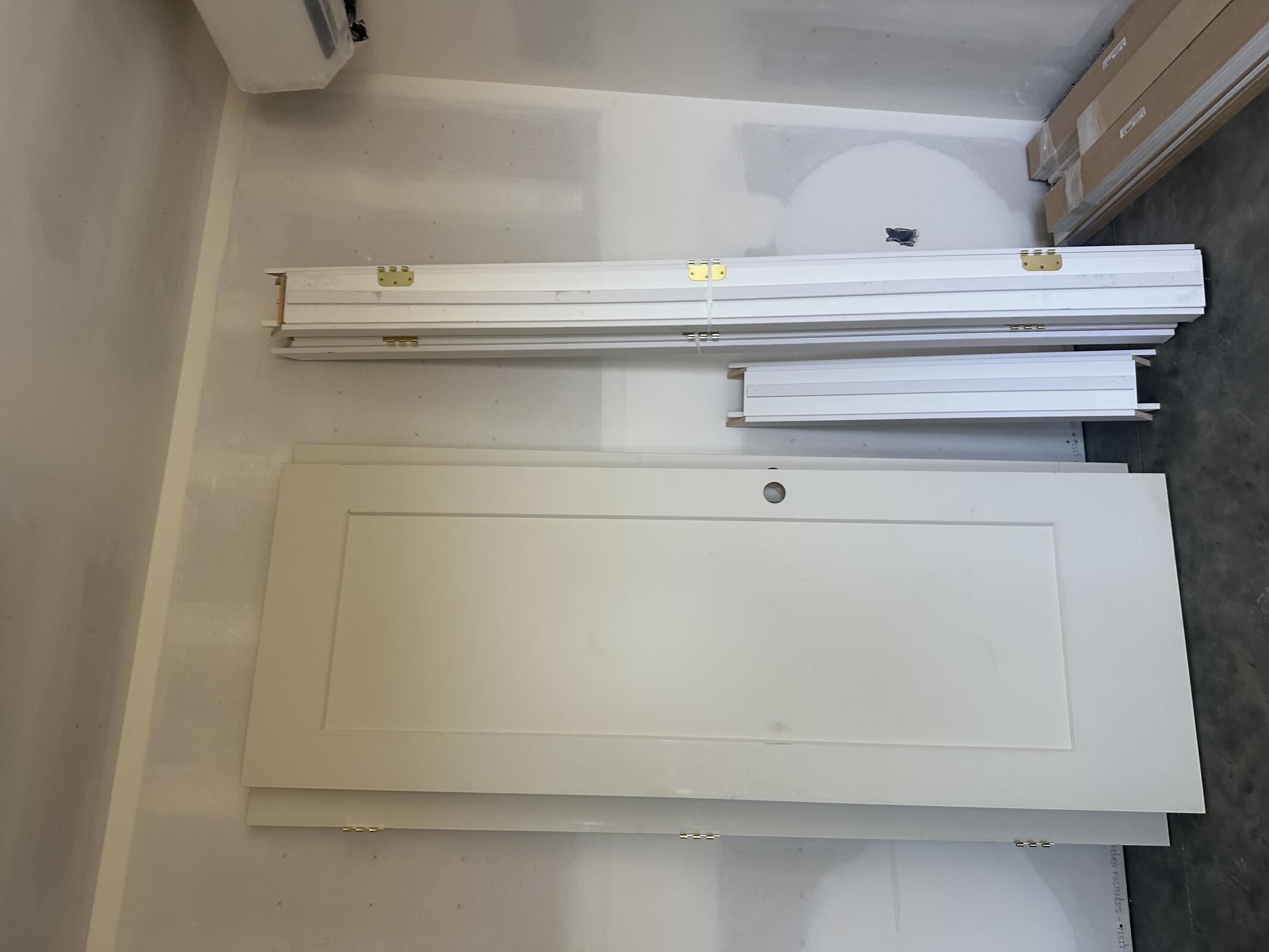

Taylor Trim installing interior door frames and doors at B&C. Baseboard delivered for Monday install.

Coastal working on B2&C2 bathrooms. Targeting Monday completion date.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
Coastal2816
Taylor Trim3816
Painters Unlimited144

Inspection: N/A

Saturday, June 13, 2026

Clear, 77°F

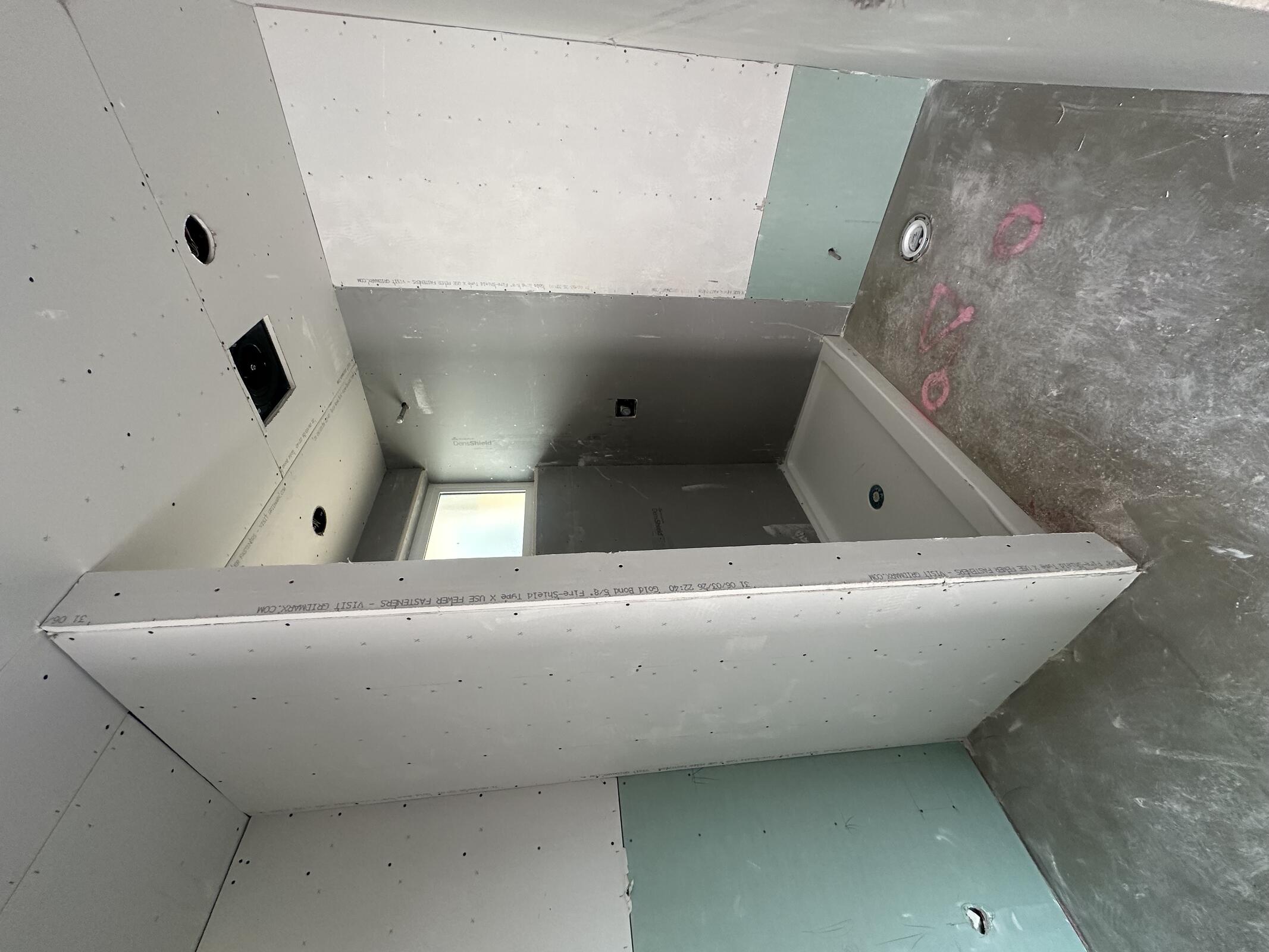

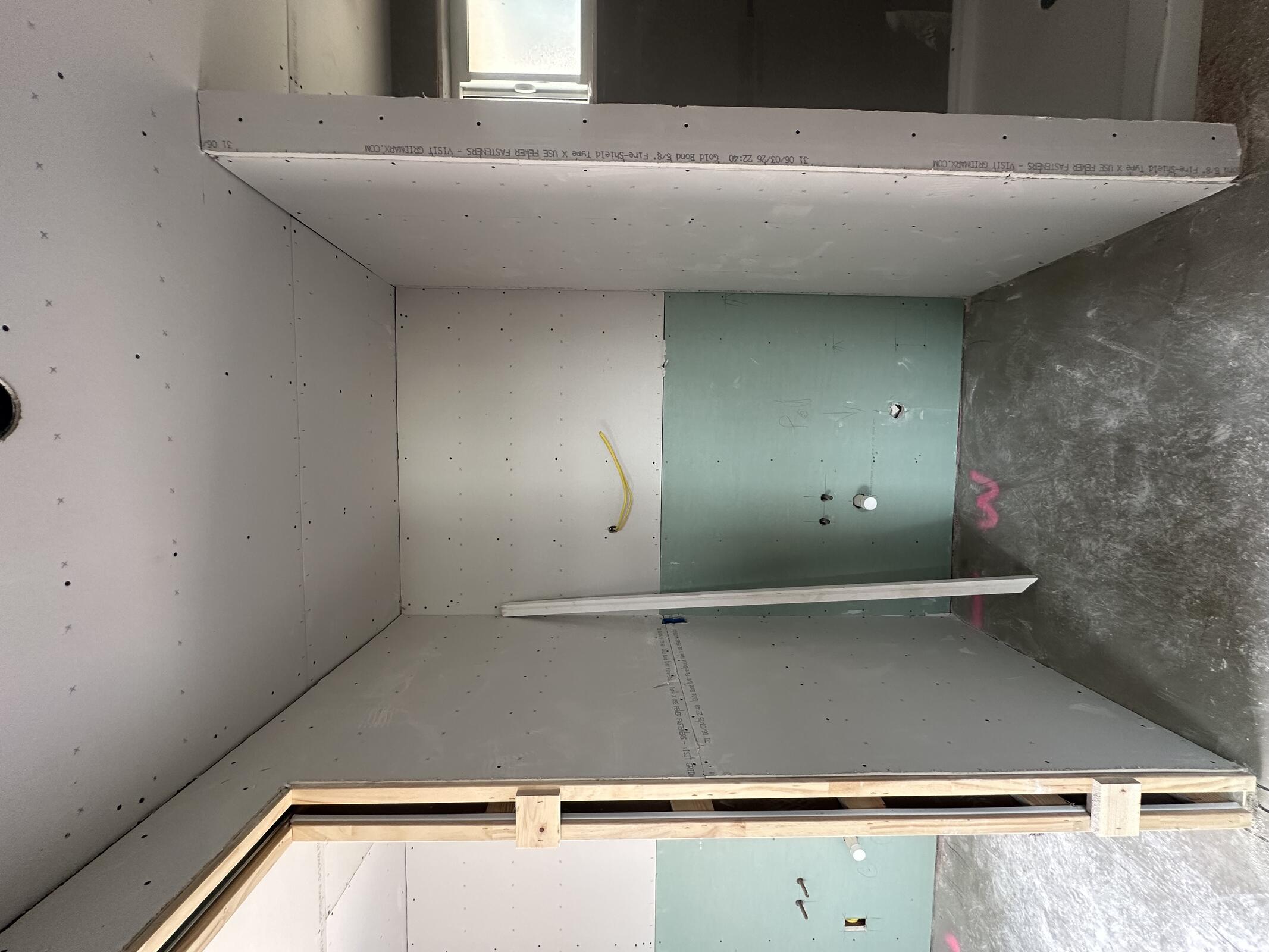

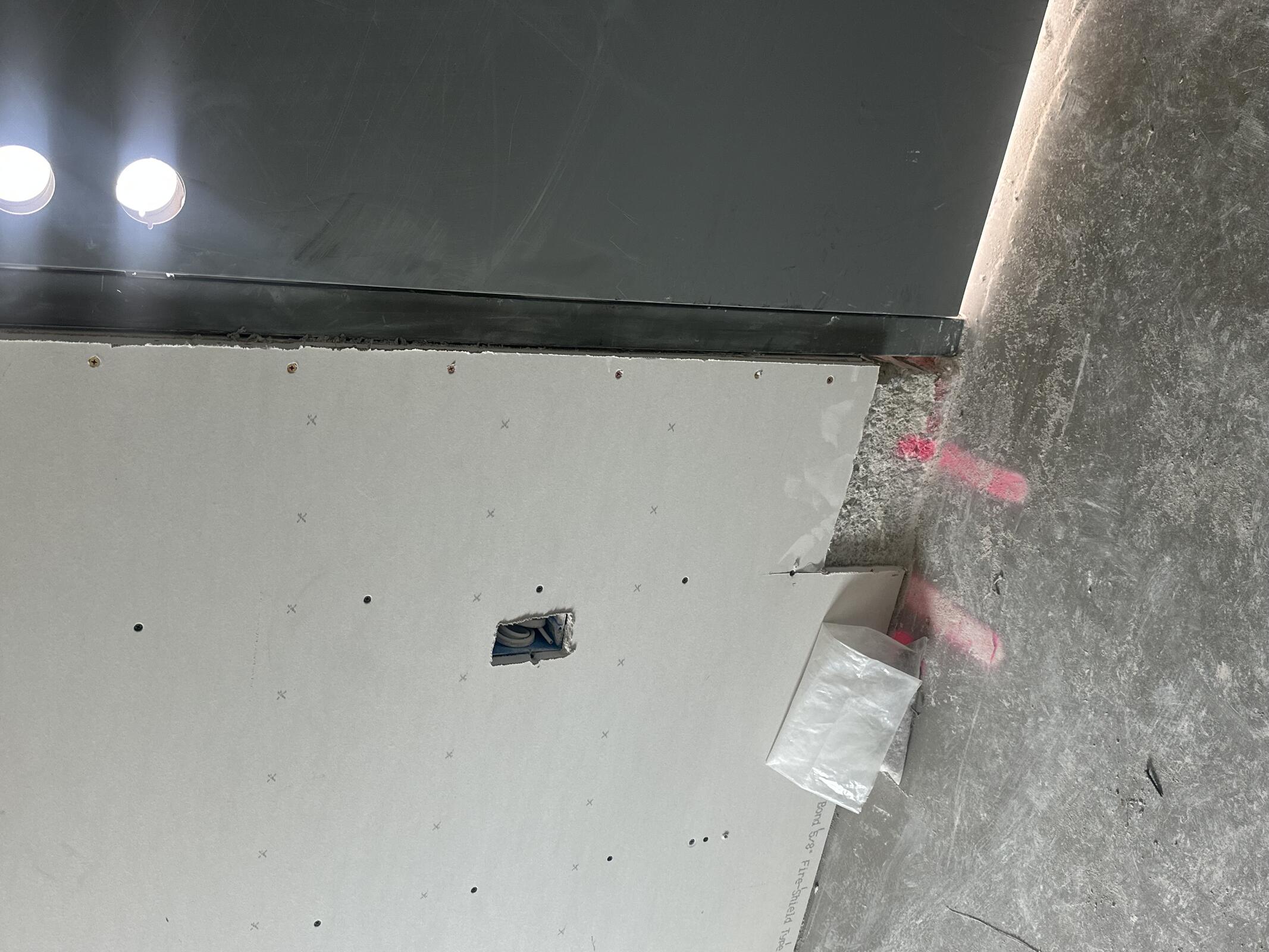

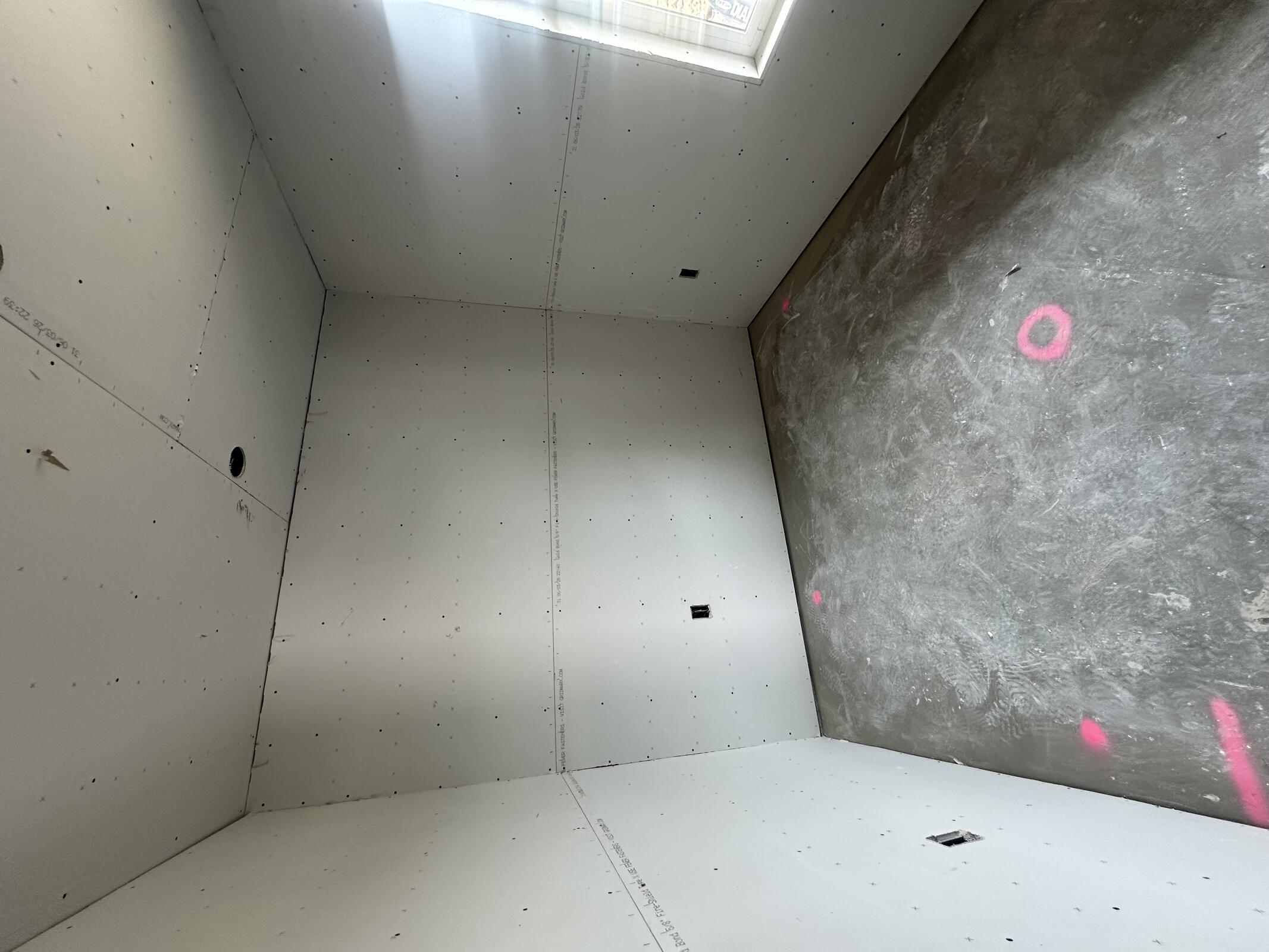

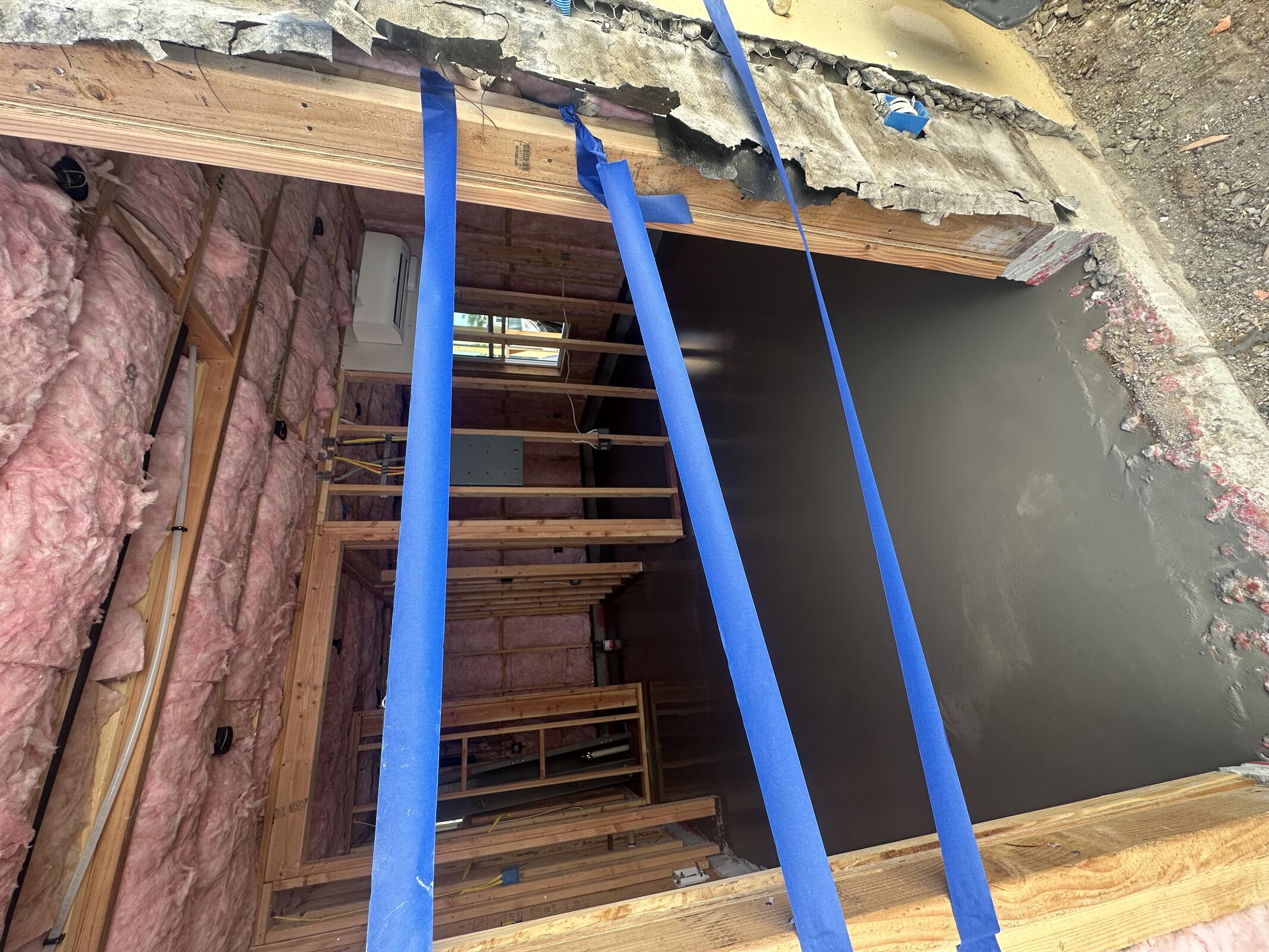

TDI hanging drywall at the garage conversion.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
TDI2816

Inspection: N/A
