All updates
Week 24 of 34

Week of June 01 — June 05, 2026

5 days on site. 76 photos. Electric, Inspection, Plumbing, Roofing, Stucco, Tile.

June 1, 2026June 5, 20265 days76 photos
ElectricInspectionPlumbingRoofingStuccoTile

Monday, June 01, 2026

Partially cloudy, 71°F

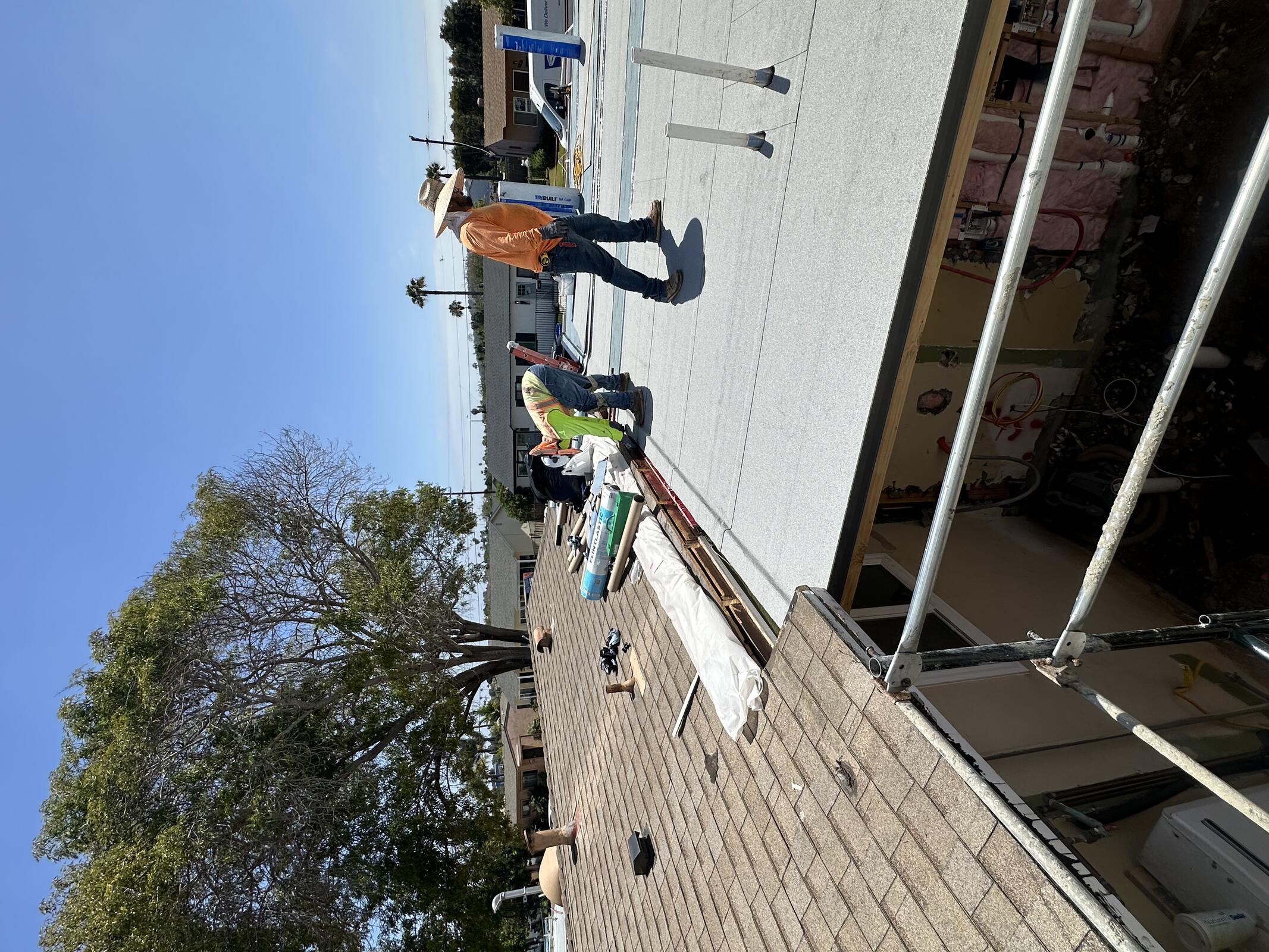

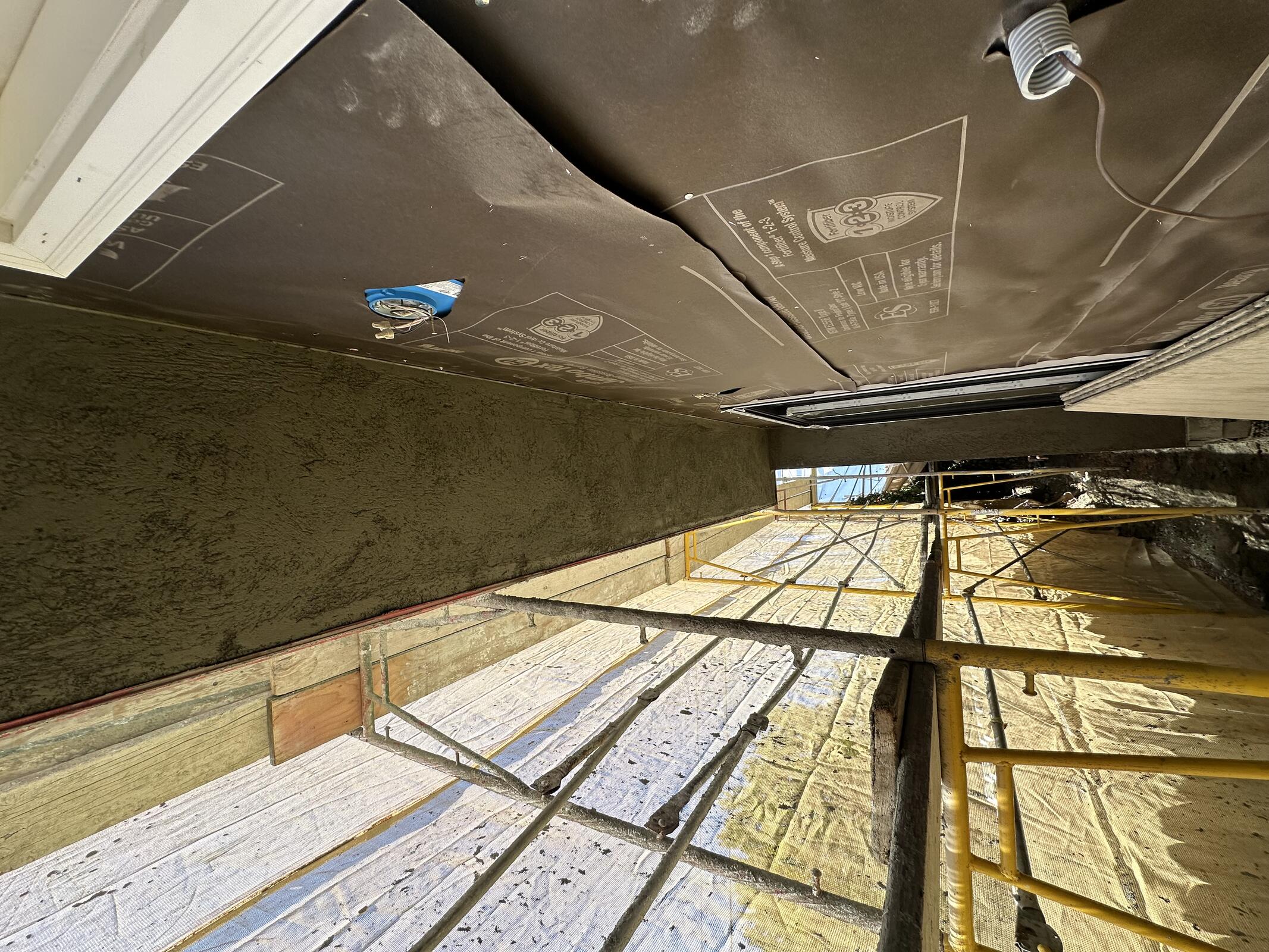

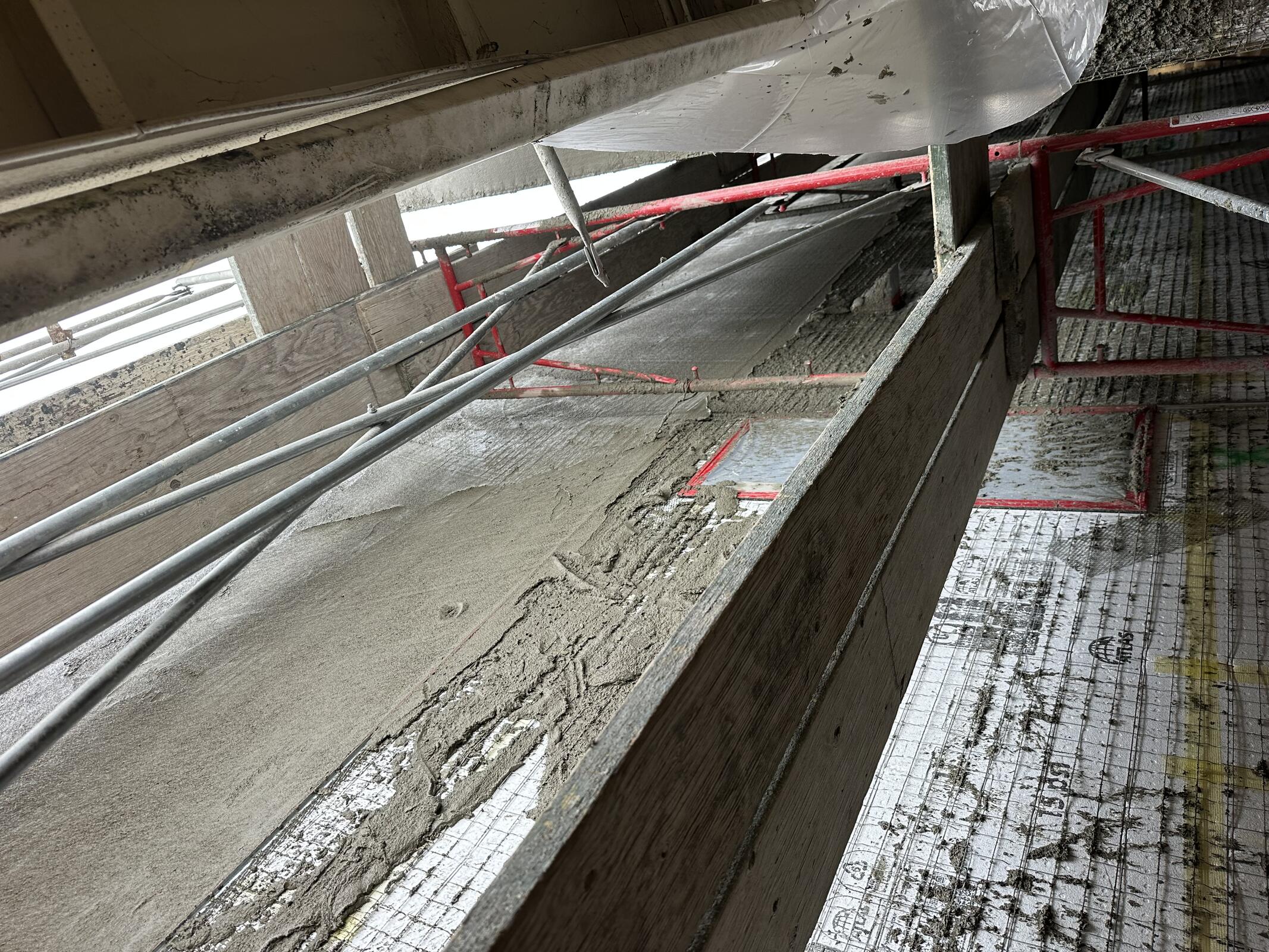

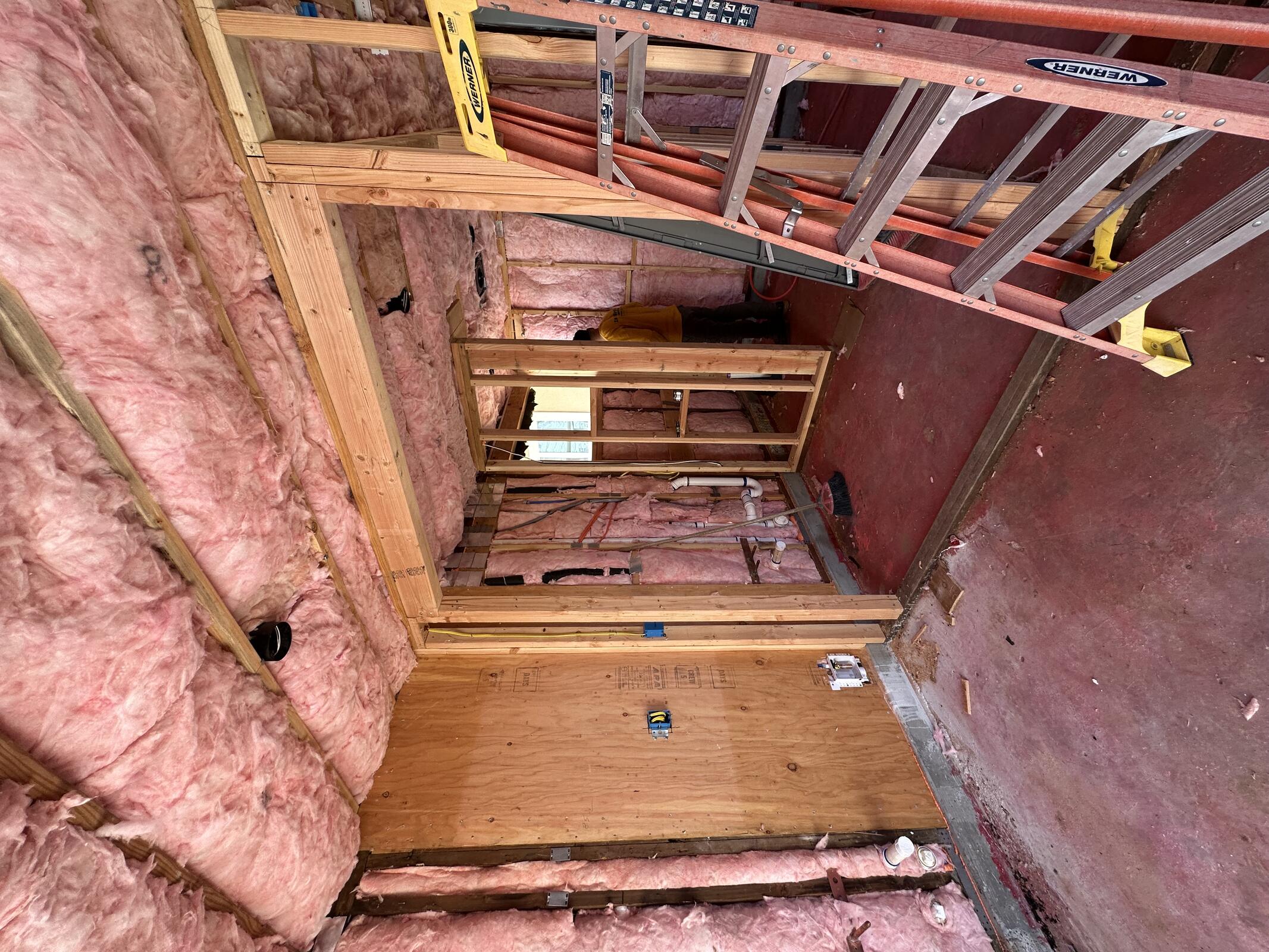

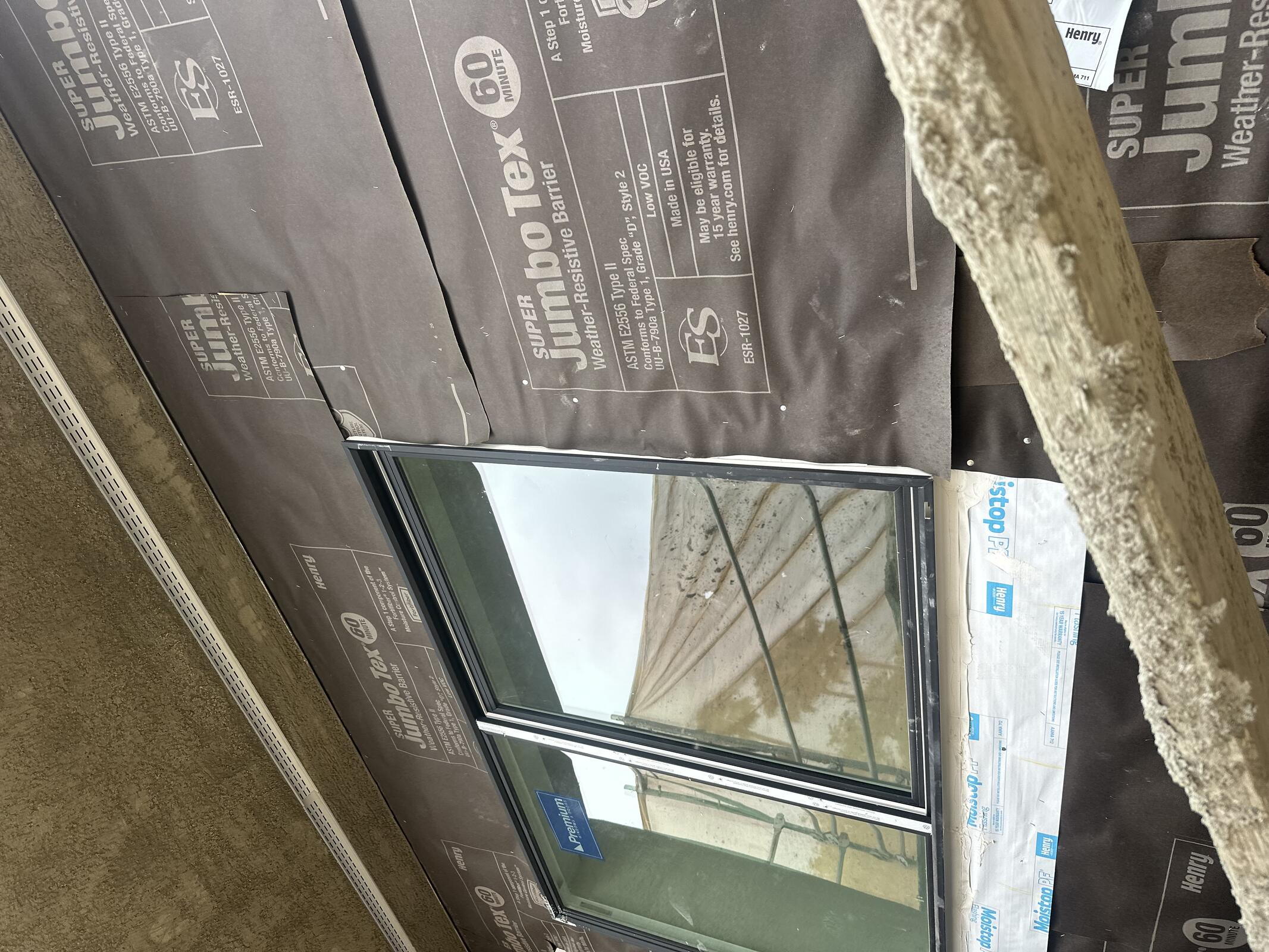

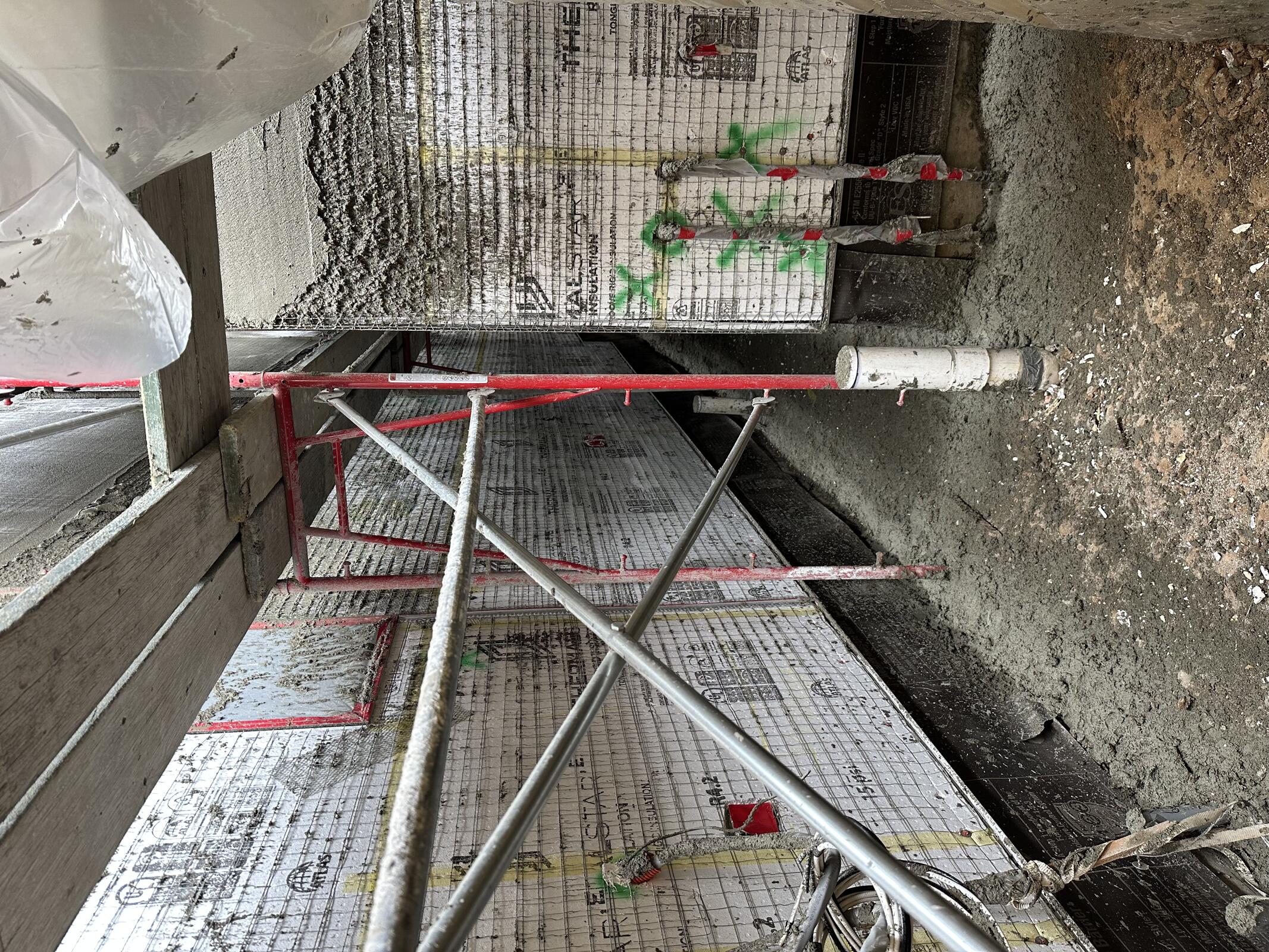

ACCI installing roofing at Garage Conversion. Metal Flashing at Existing Duplex/Garage Interface in production.

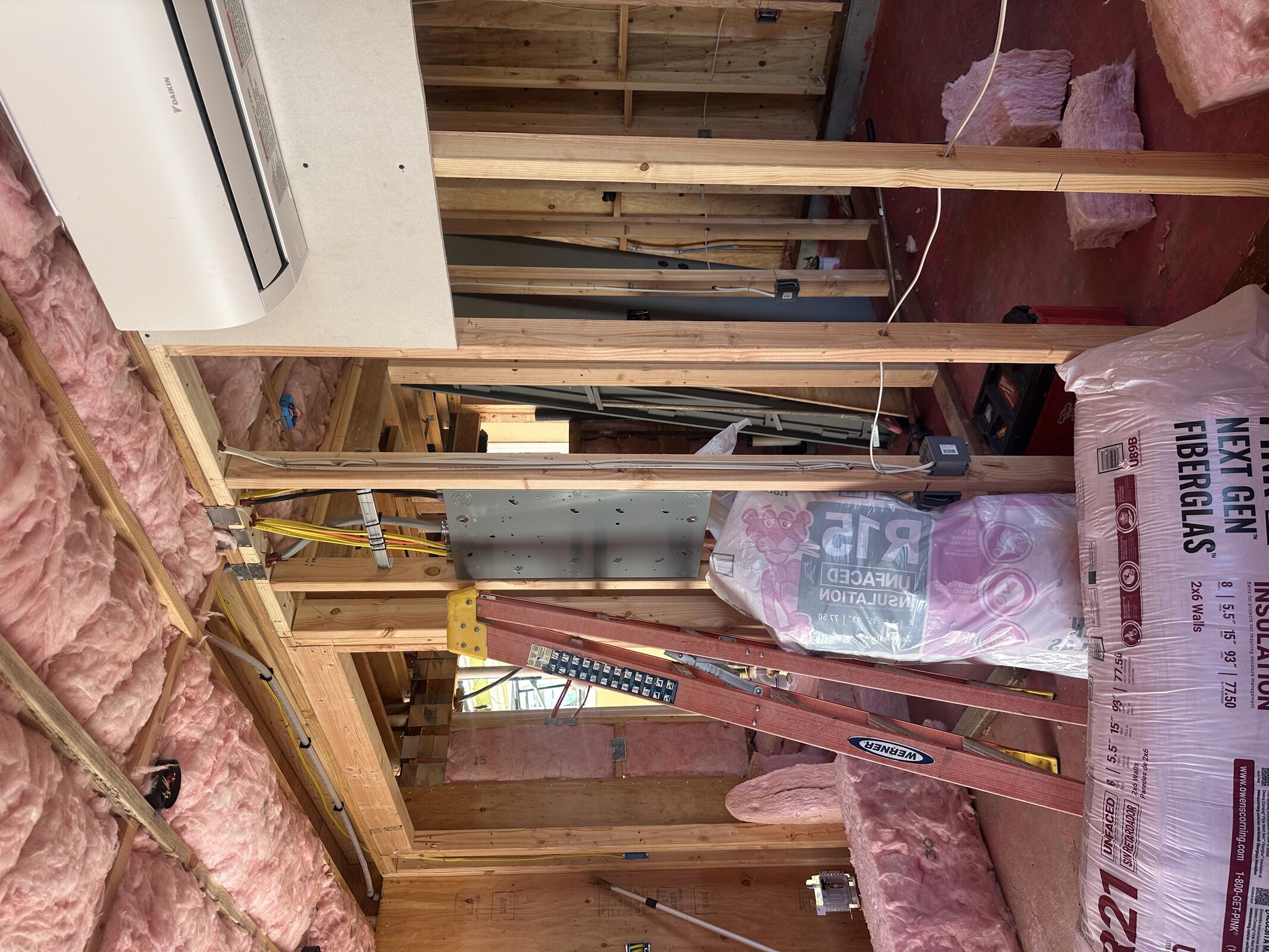

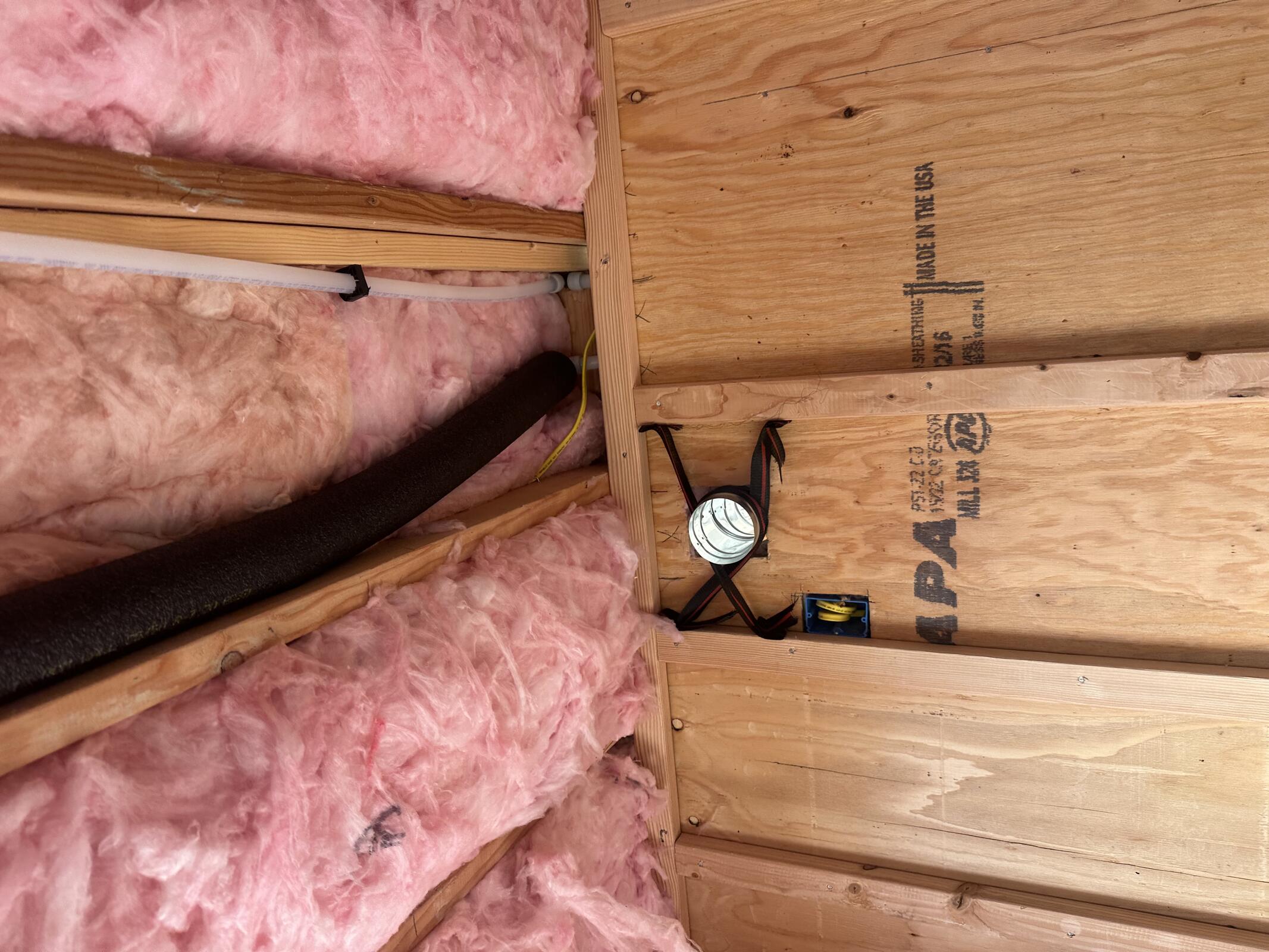

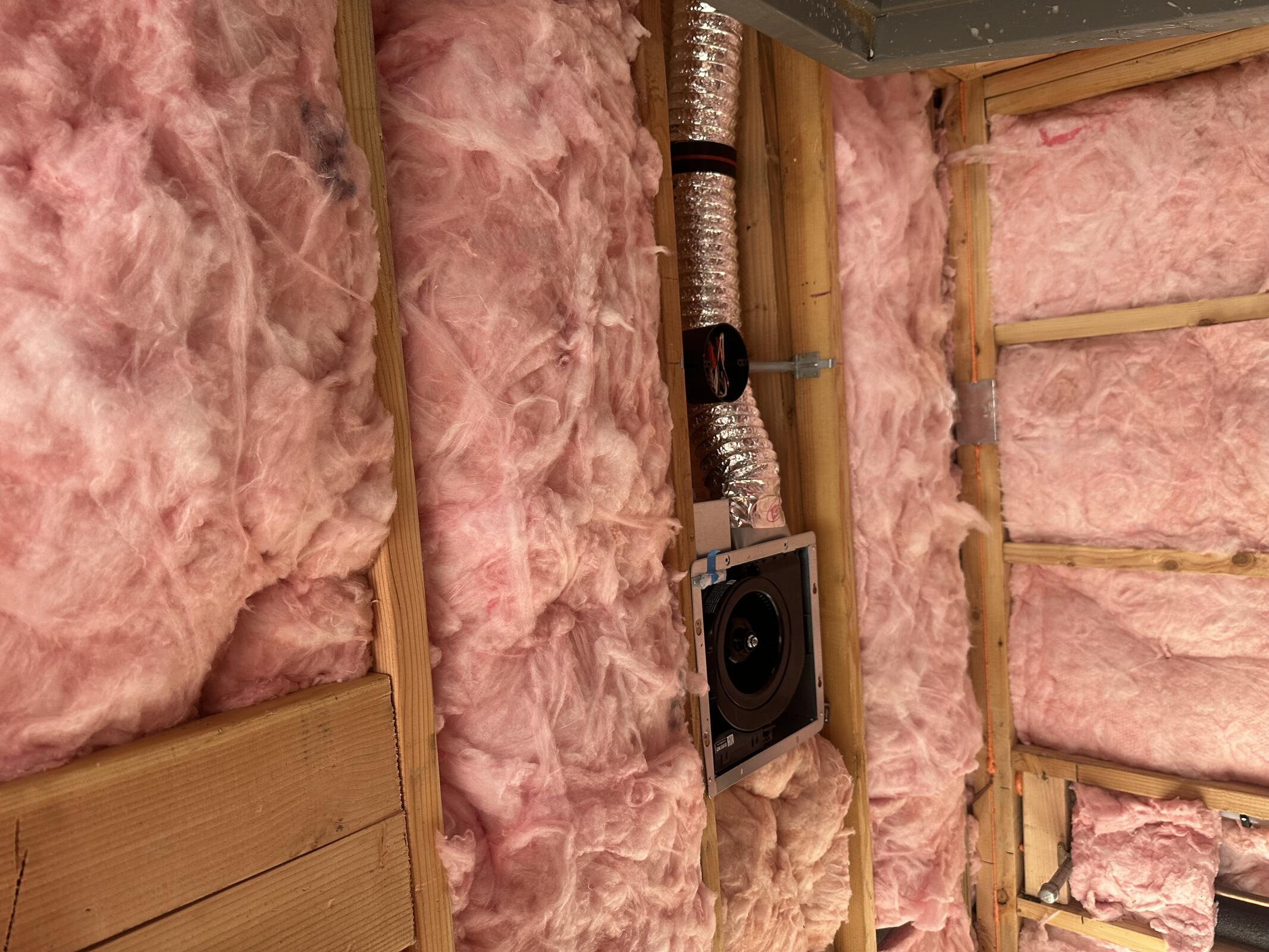

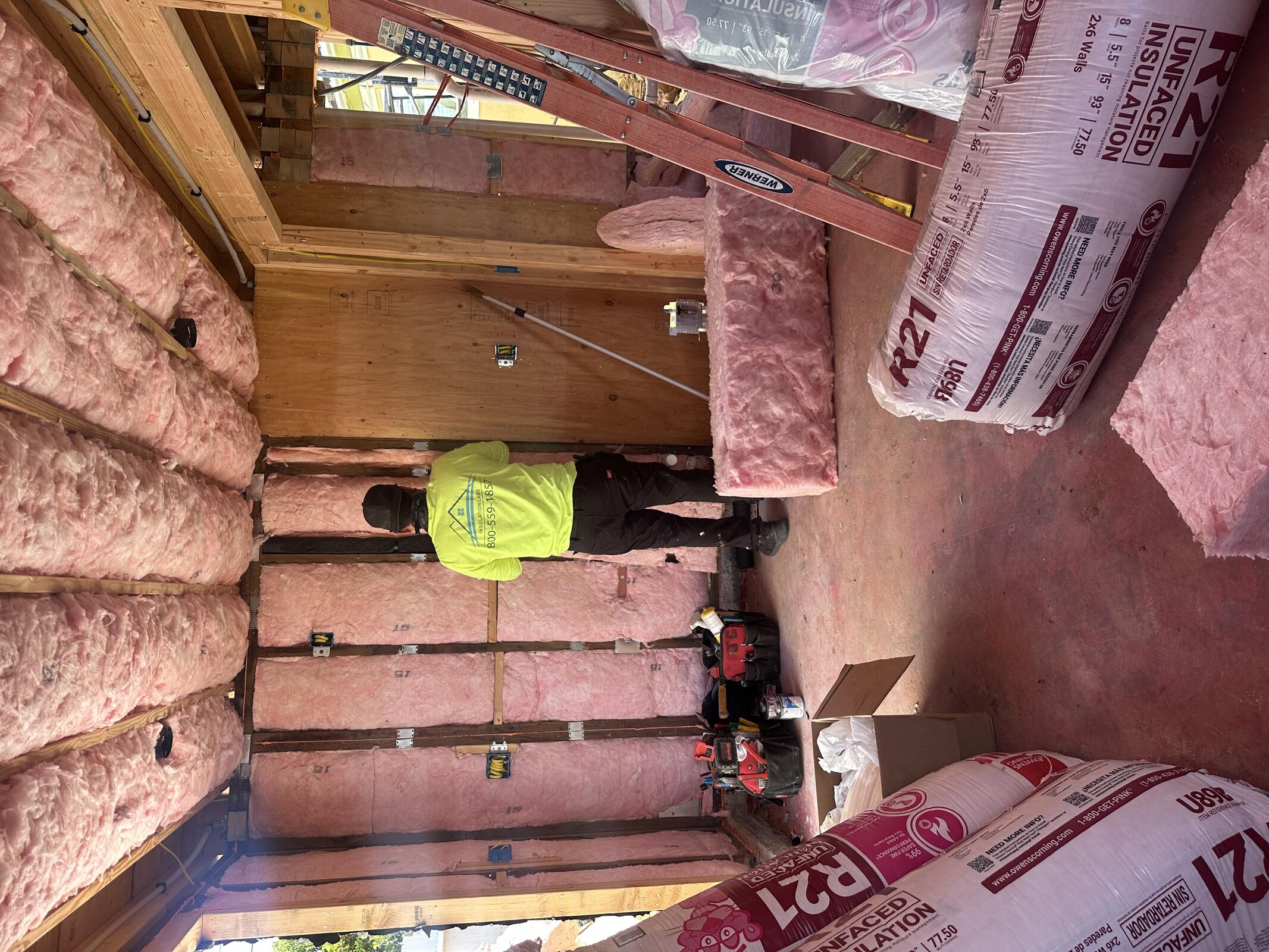

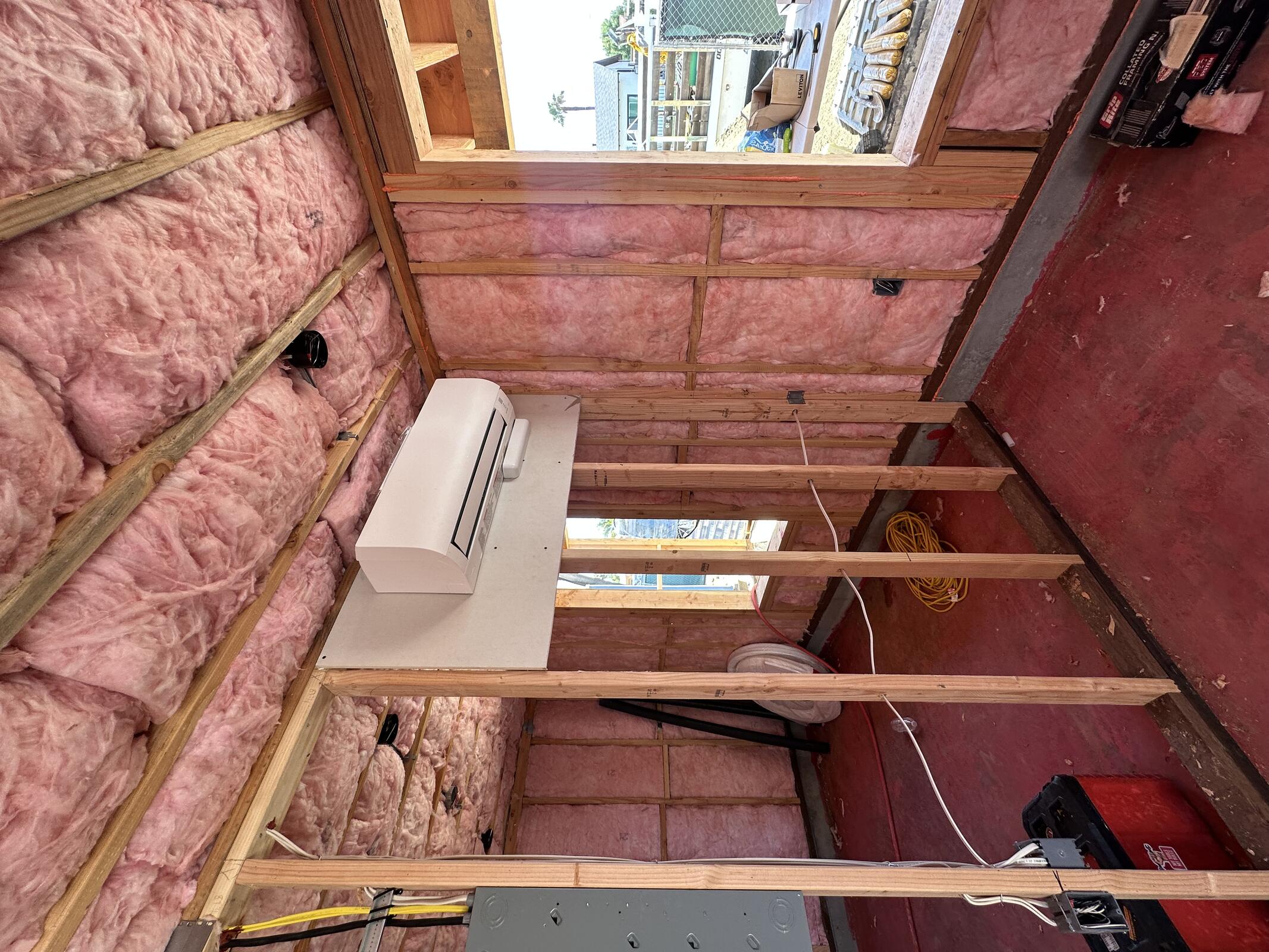

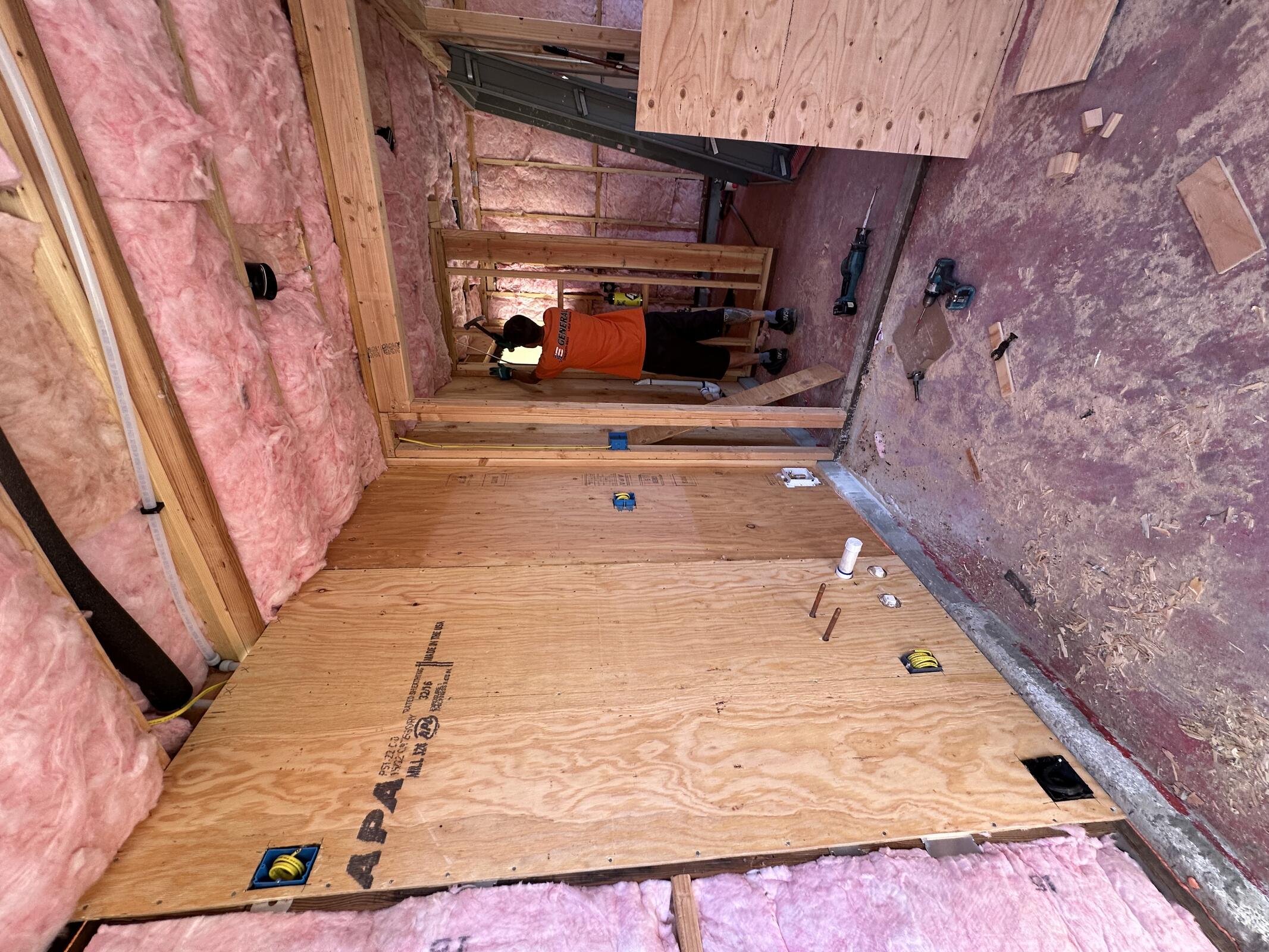

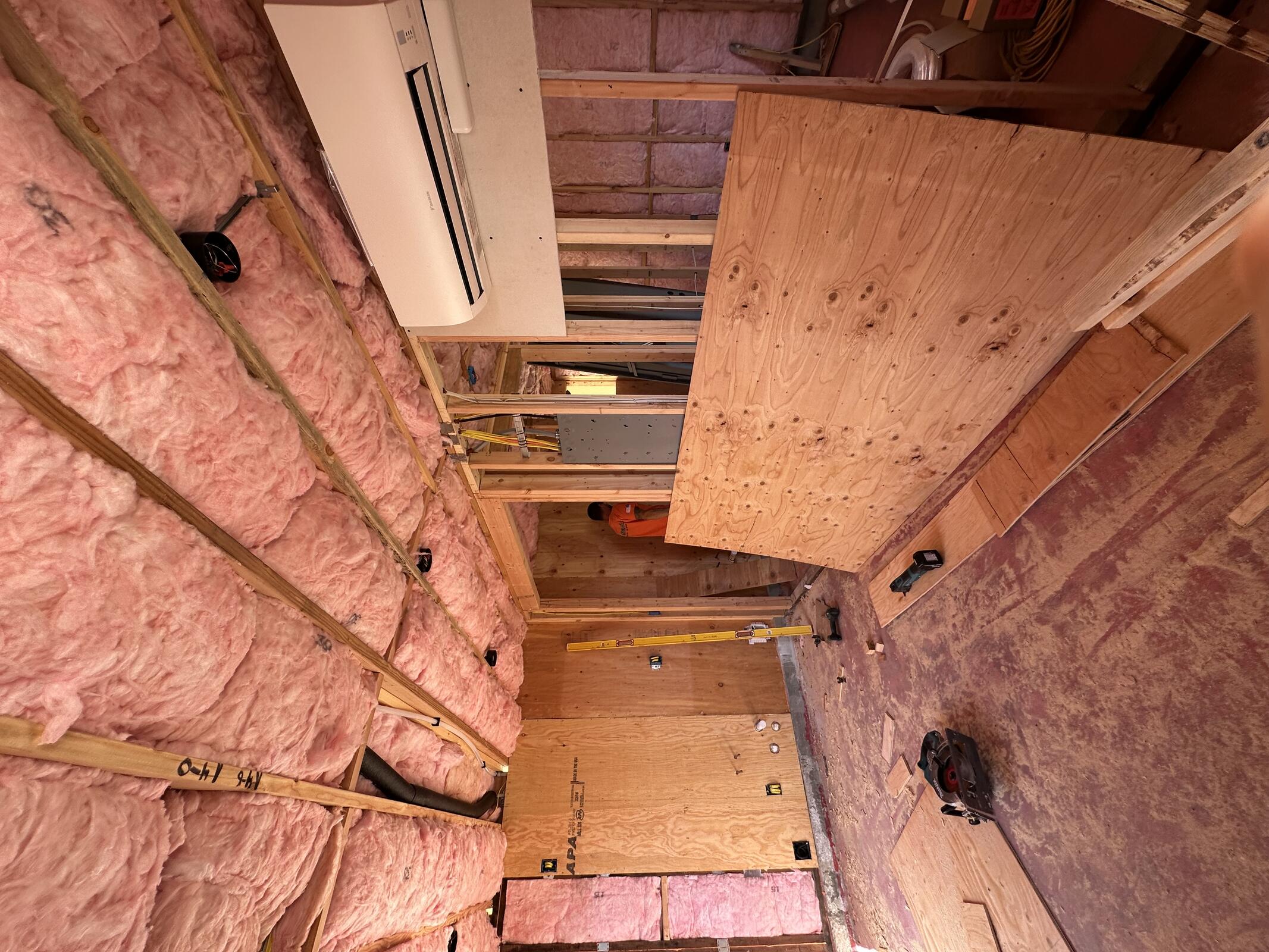

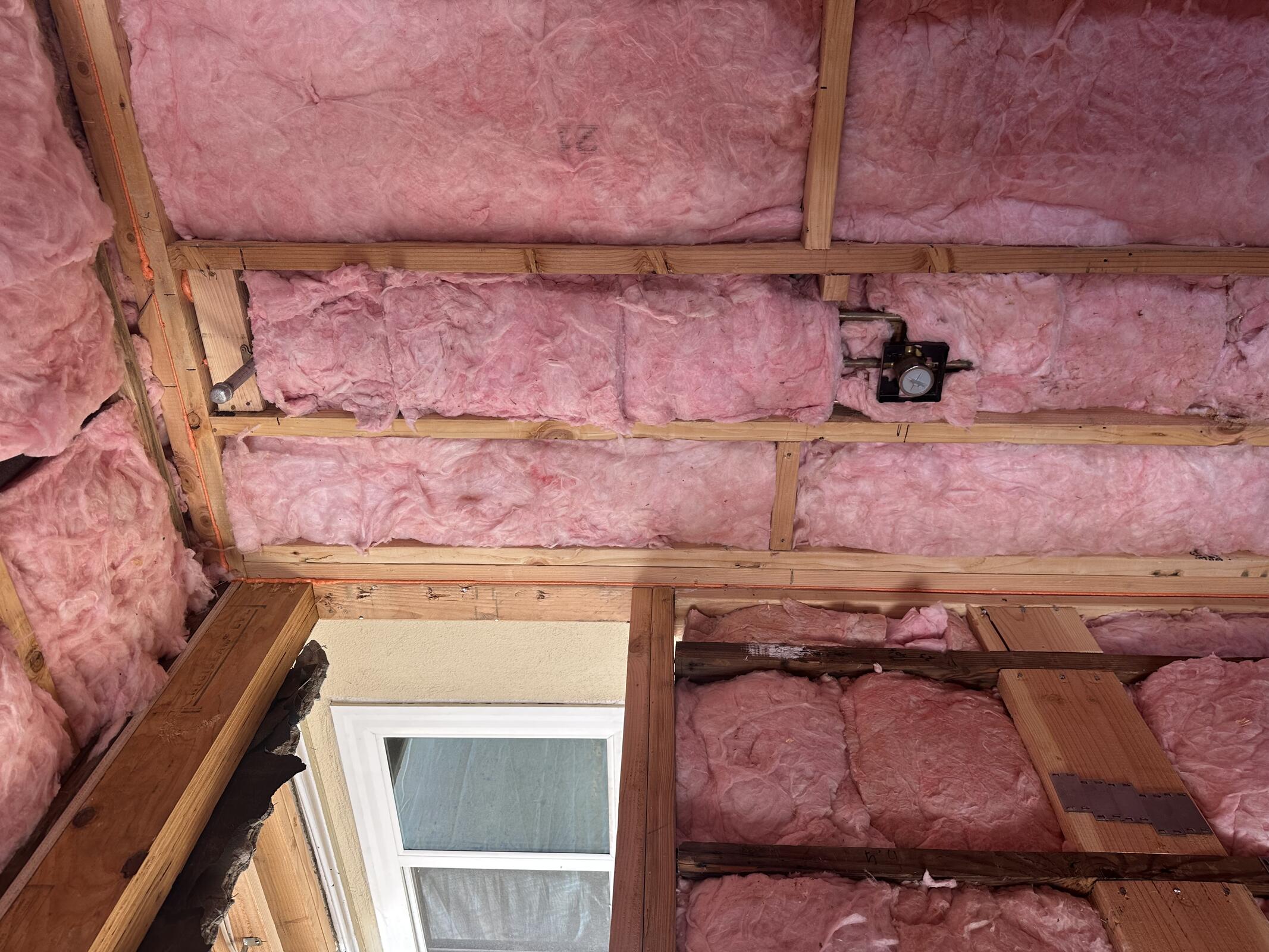

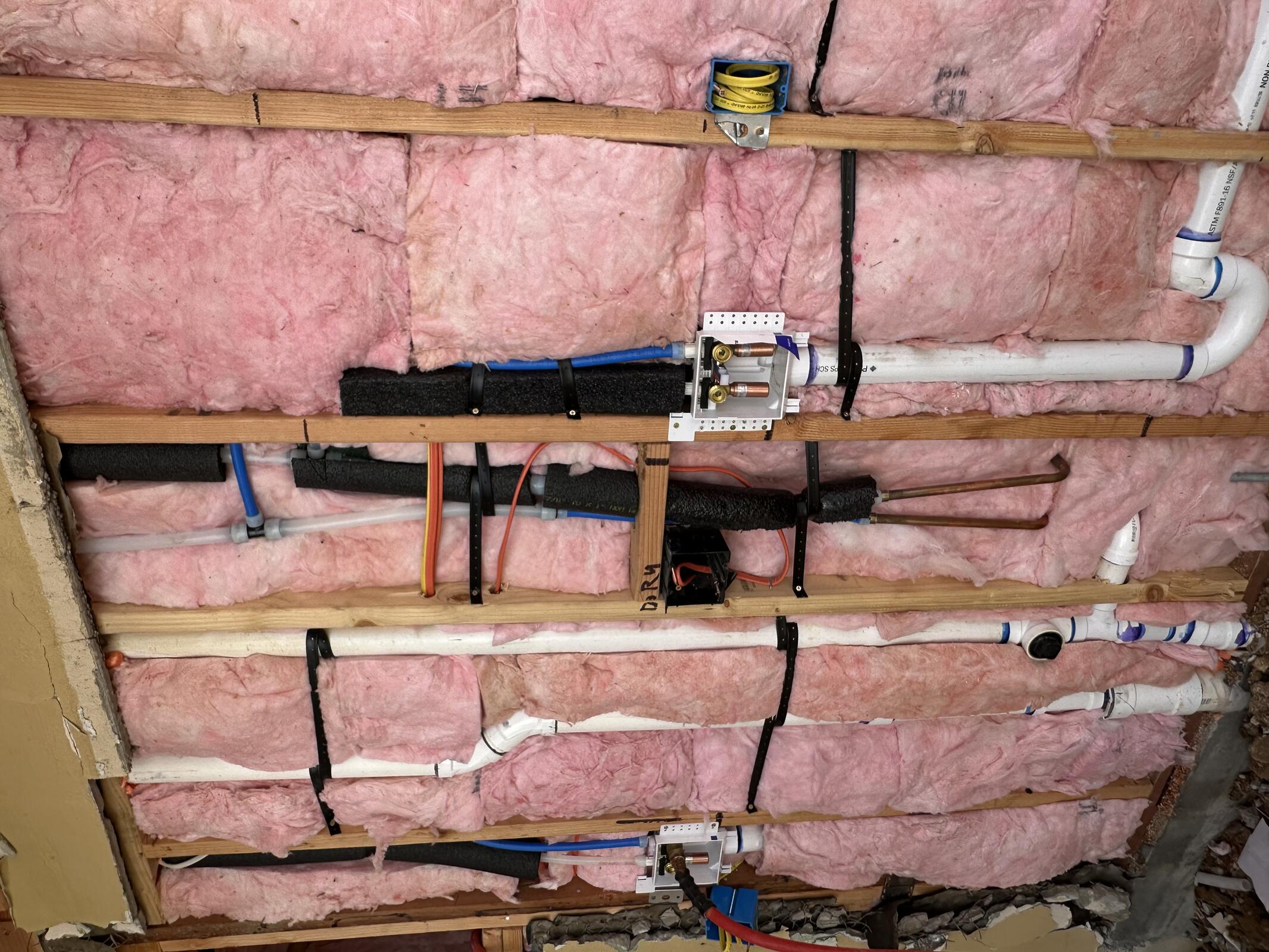

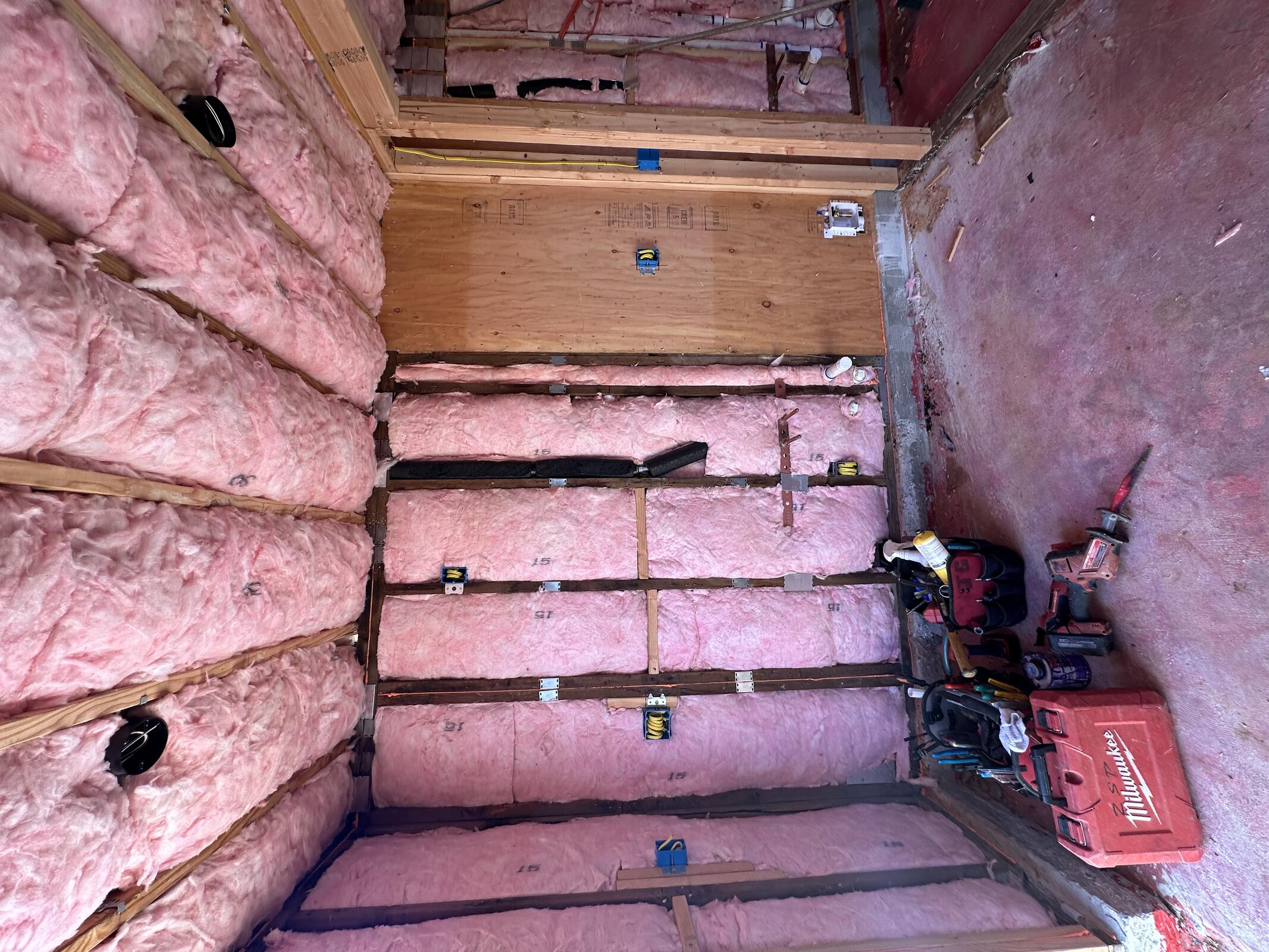

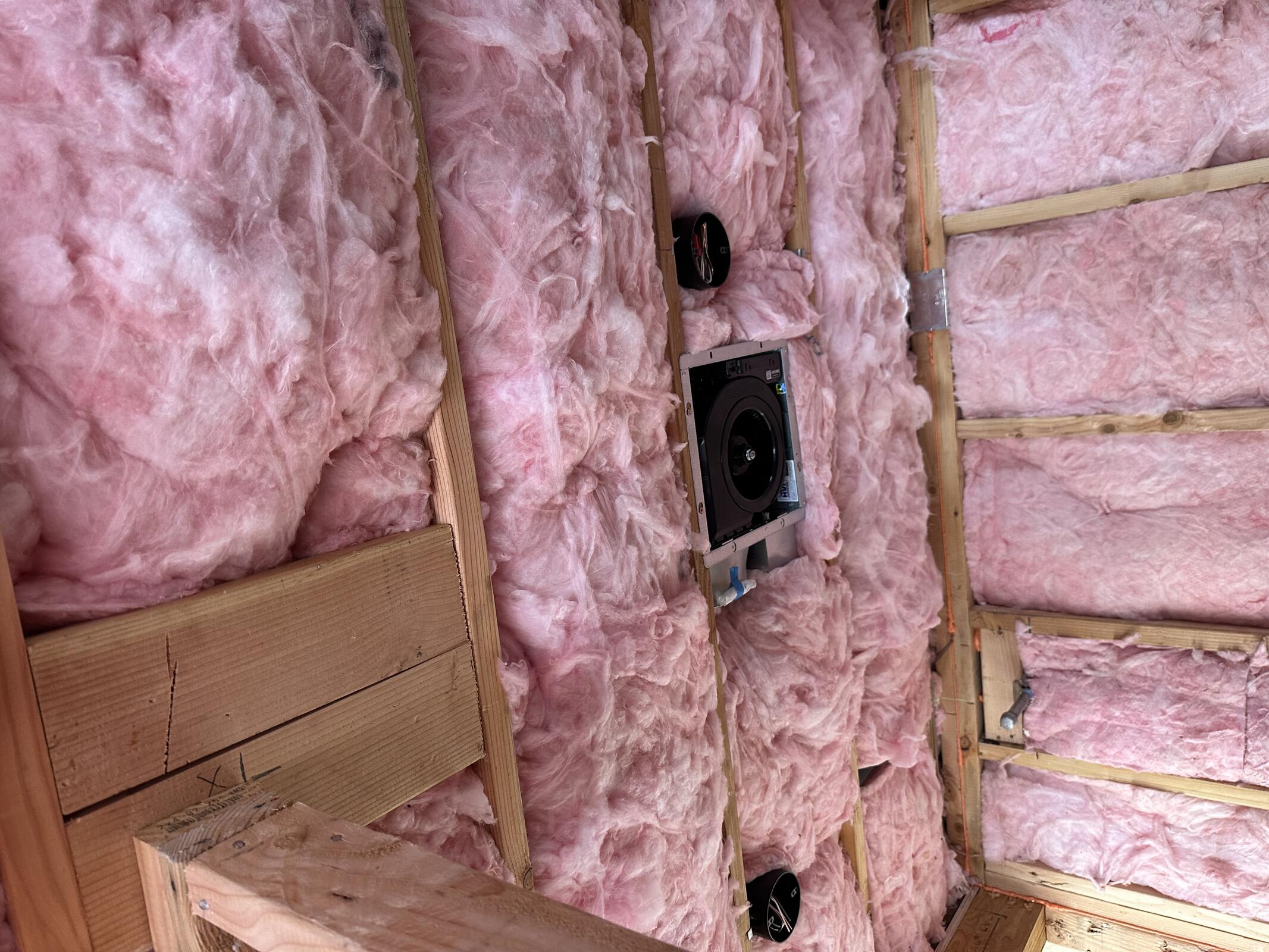

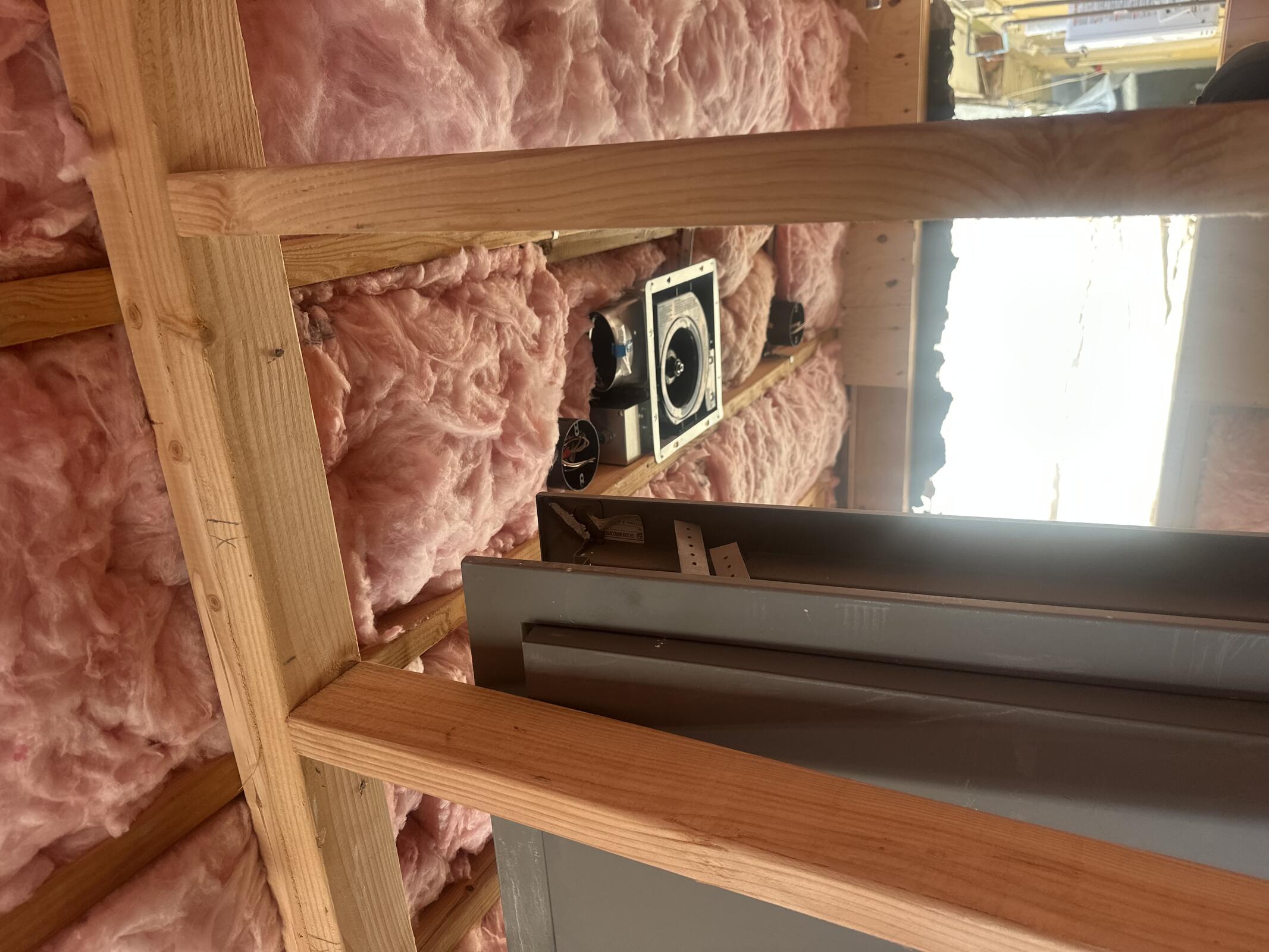

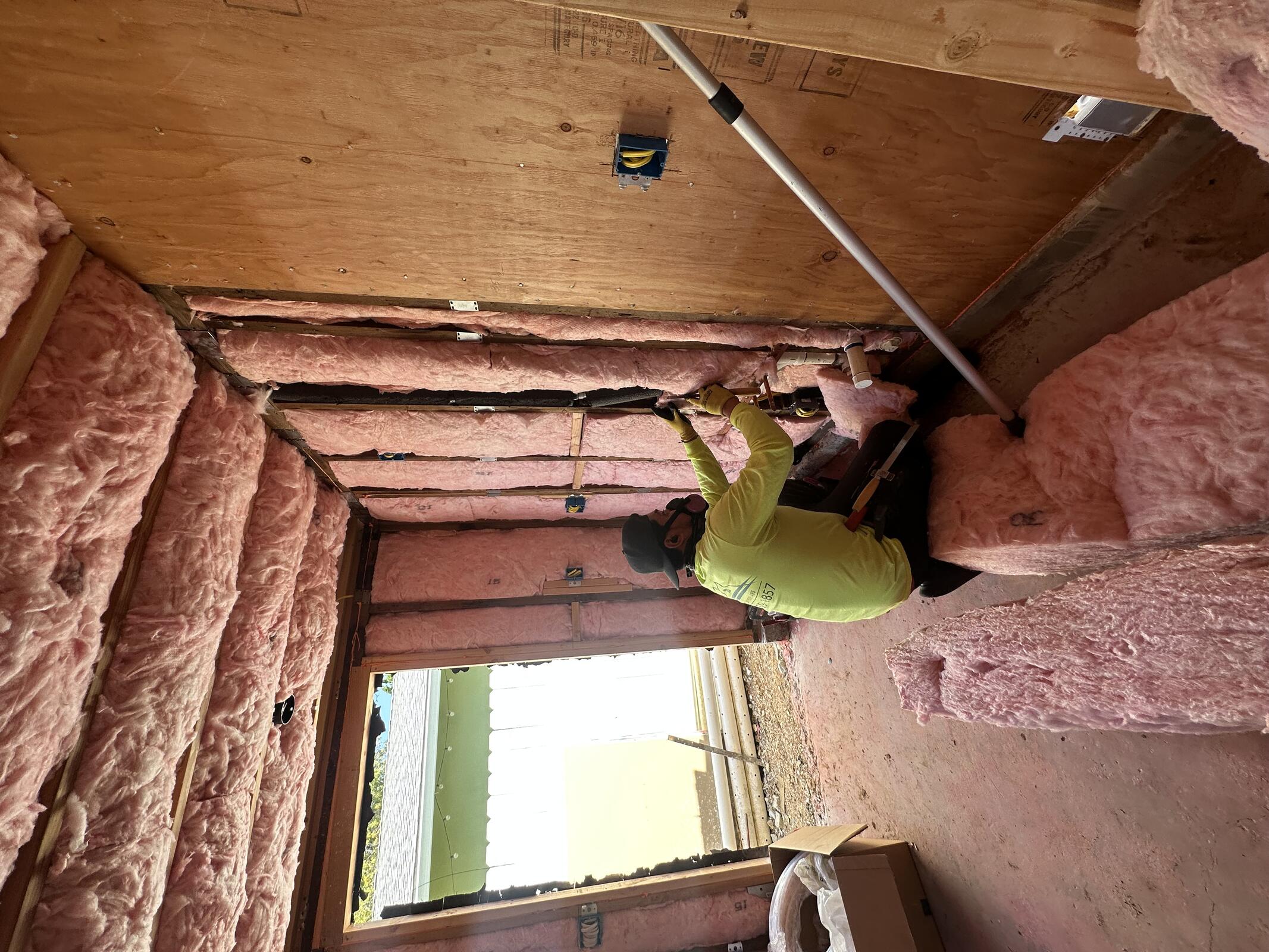

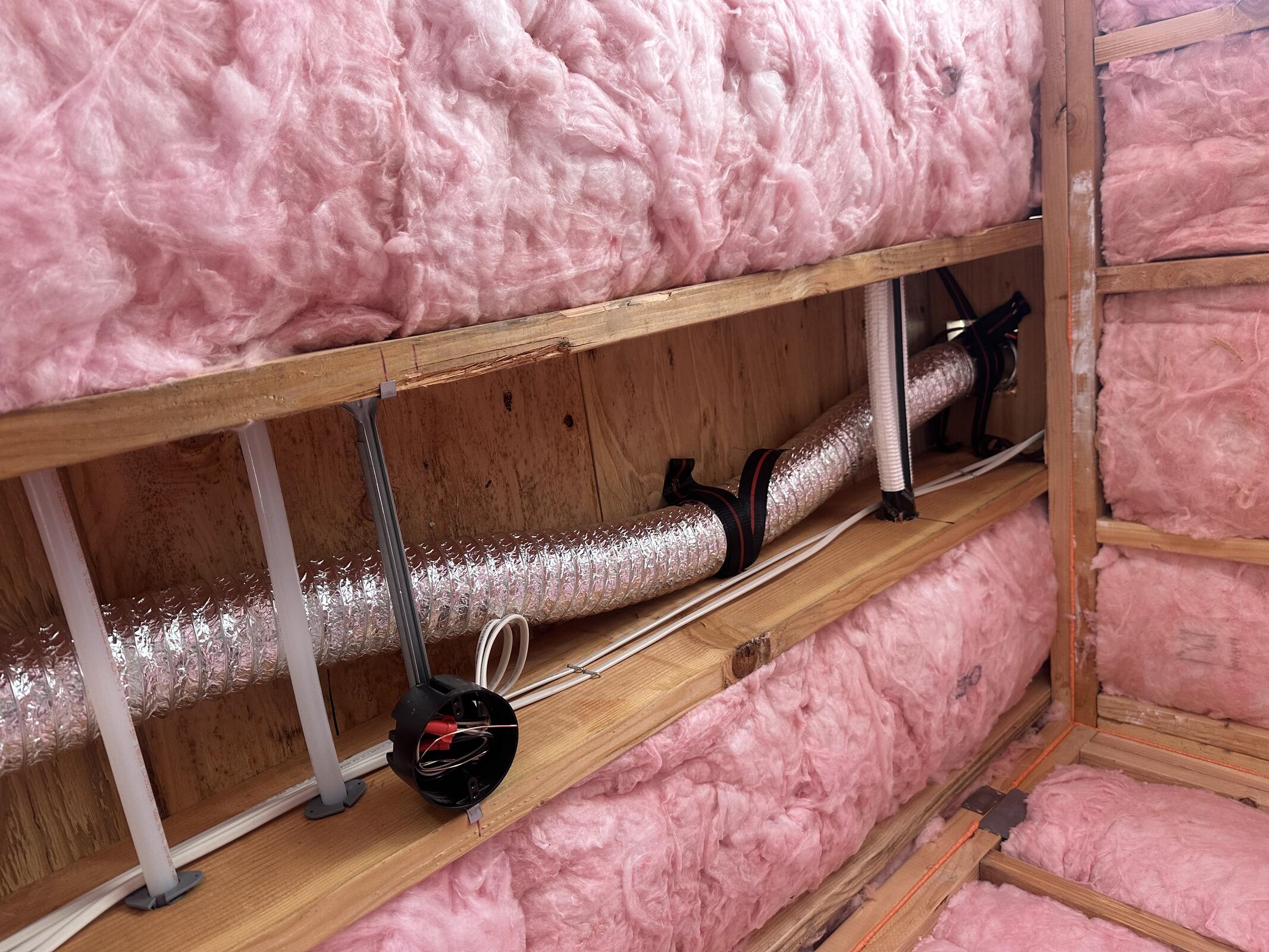

Insulation Labs installing insulation at Garage Conversion.

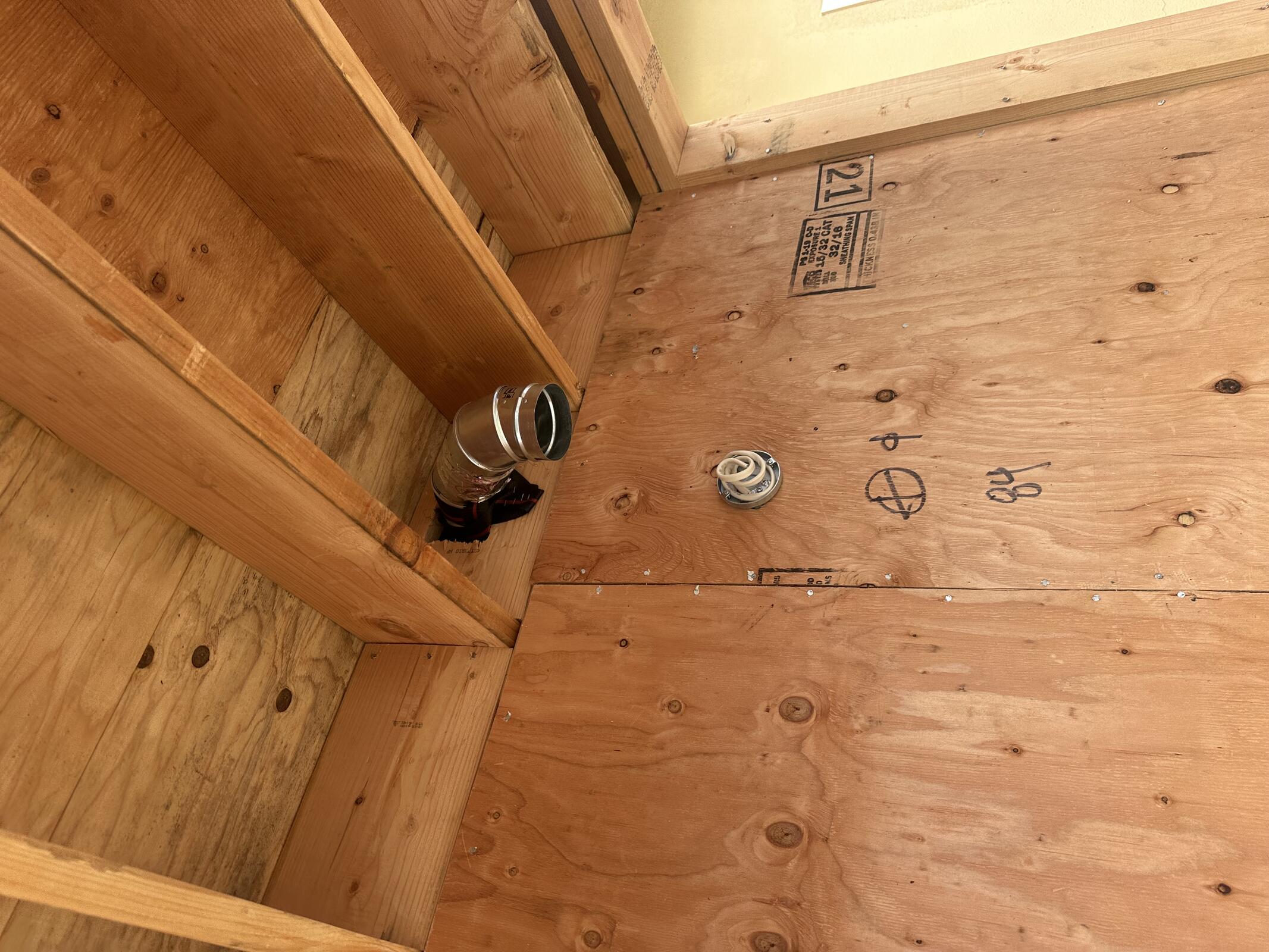

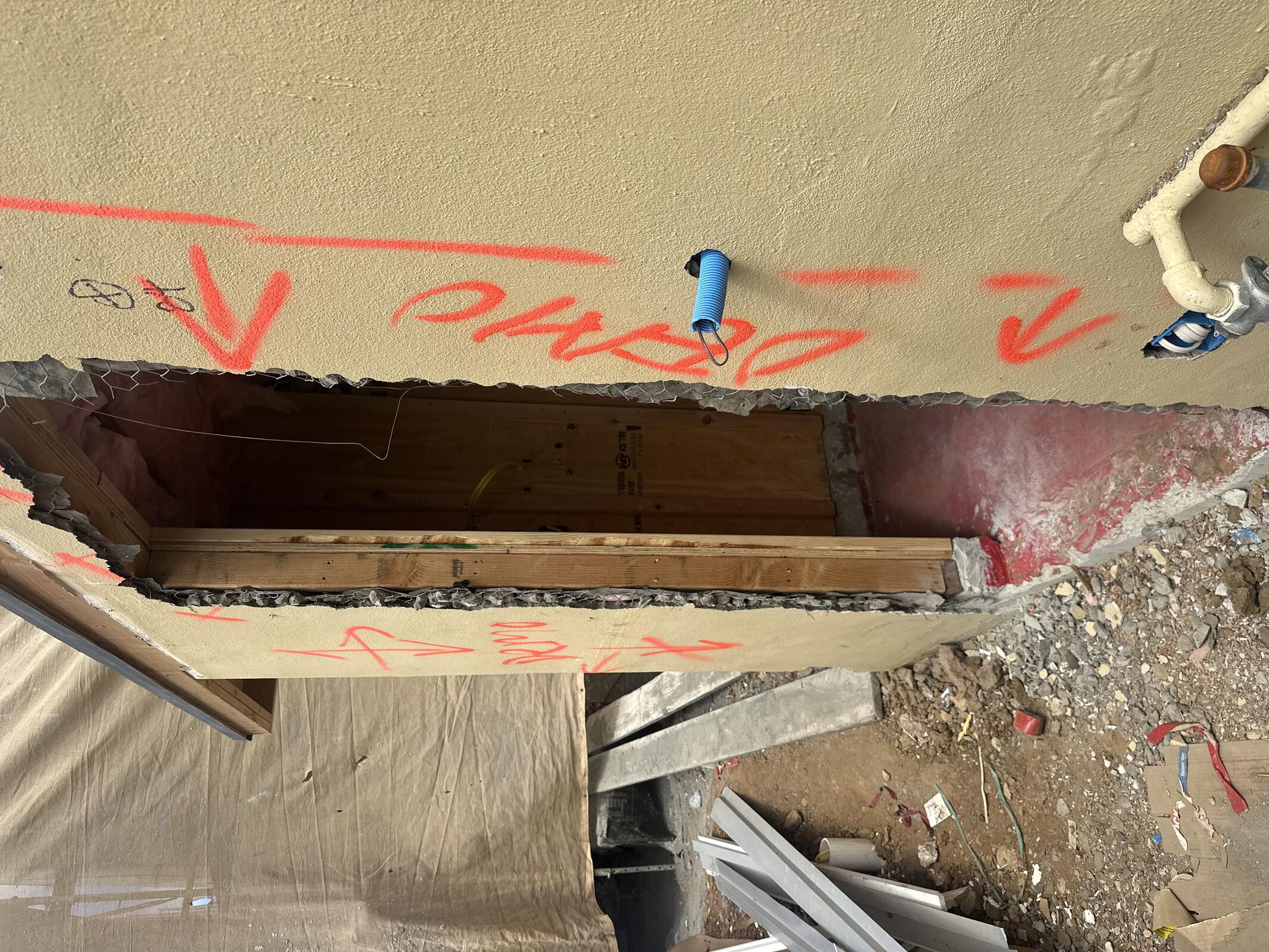

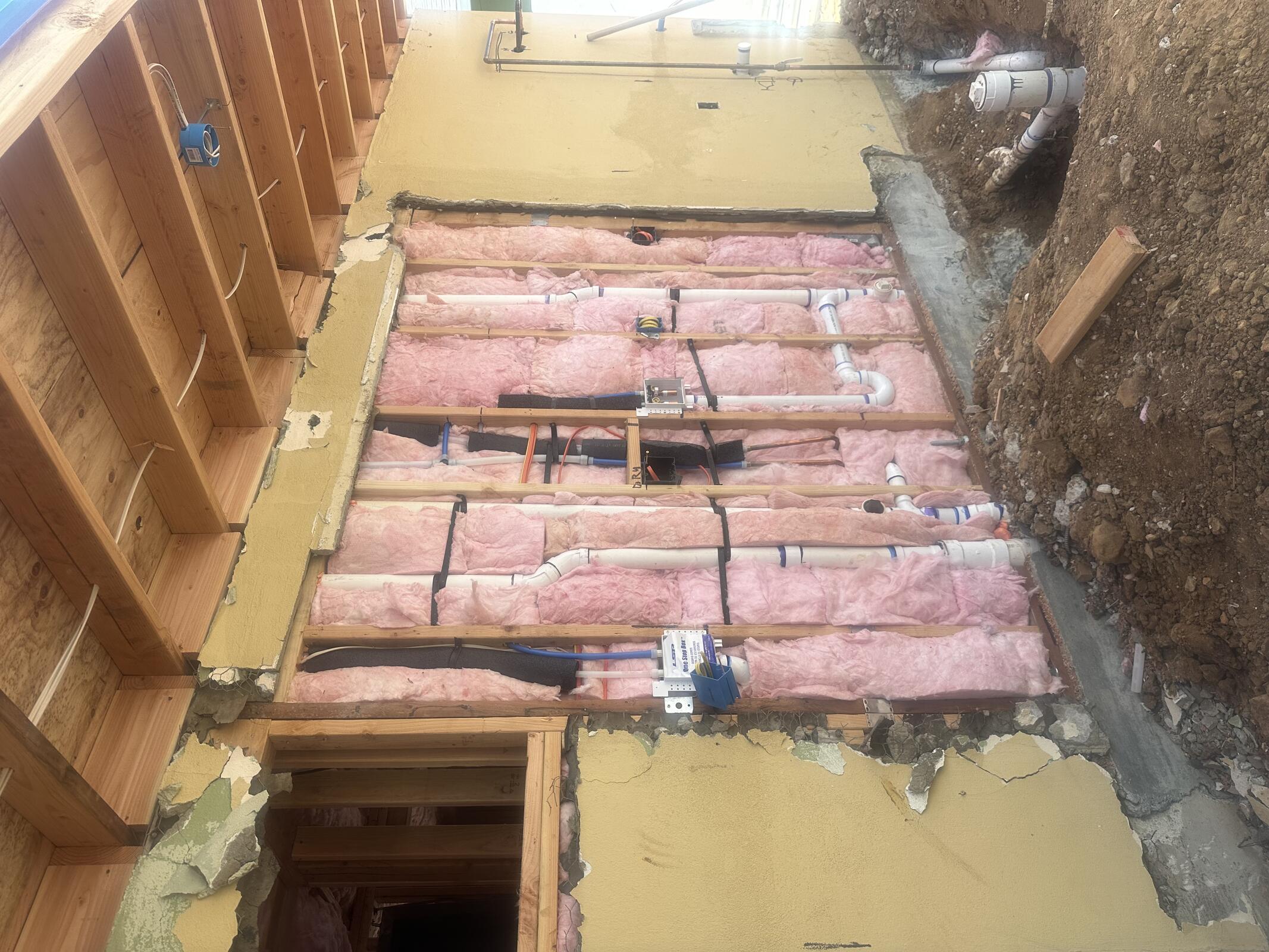

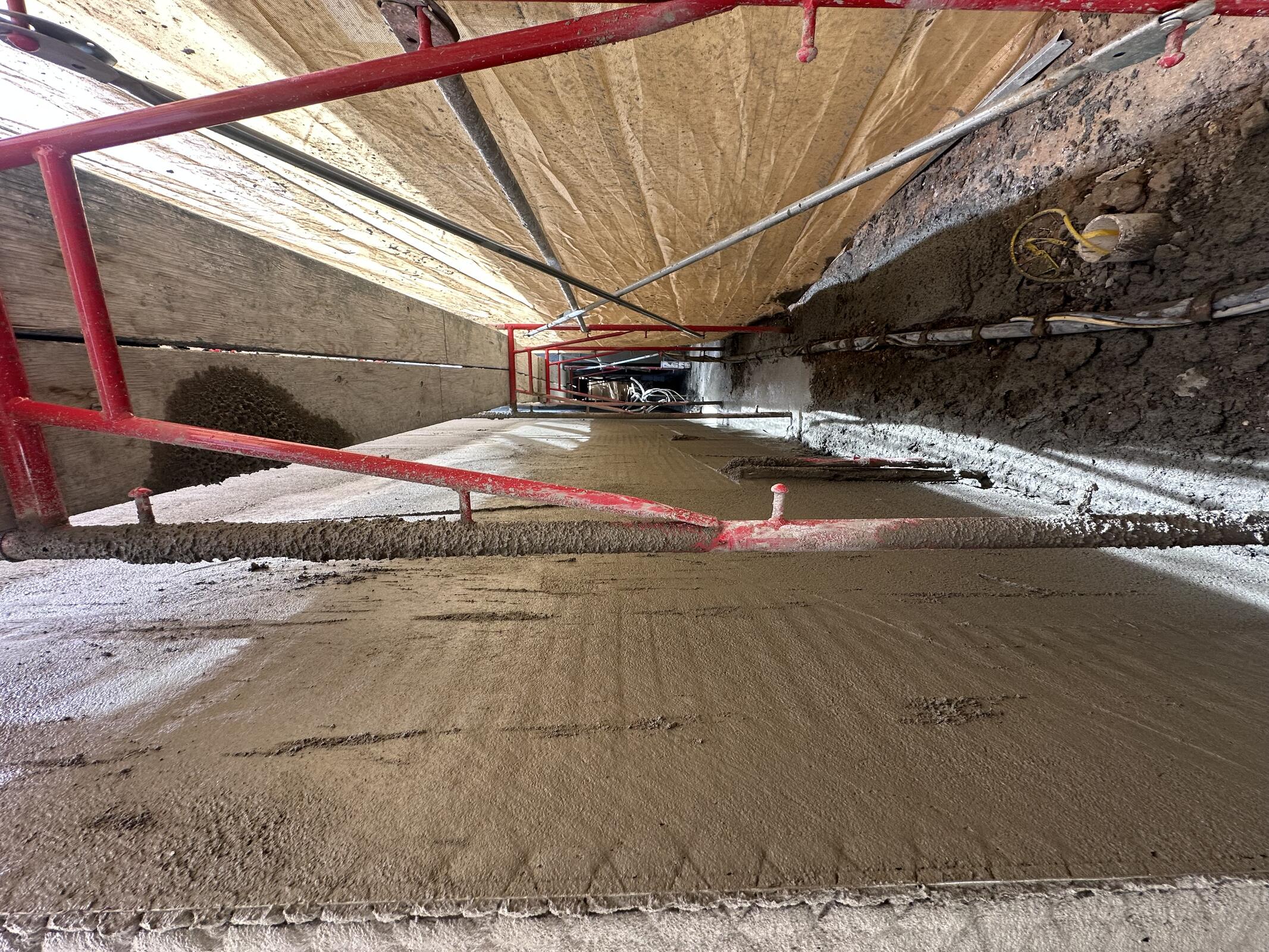

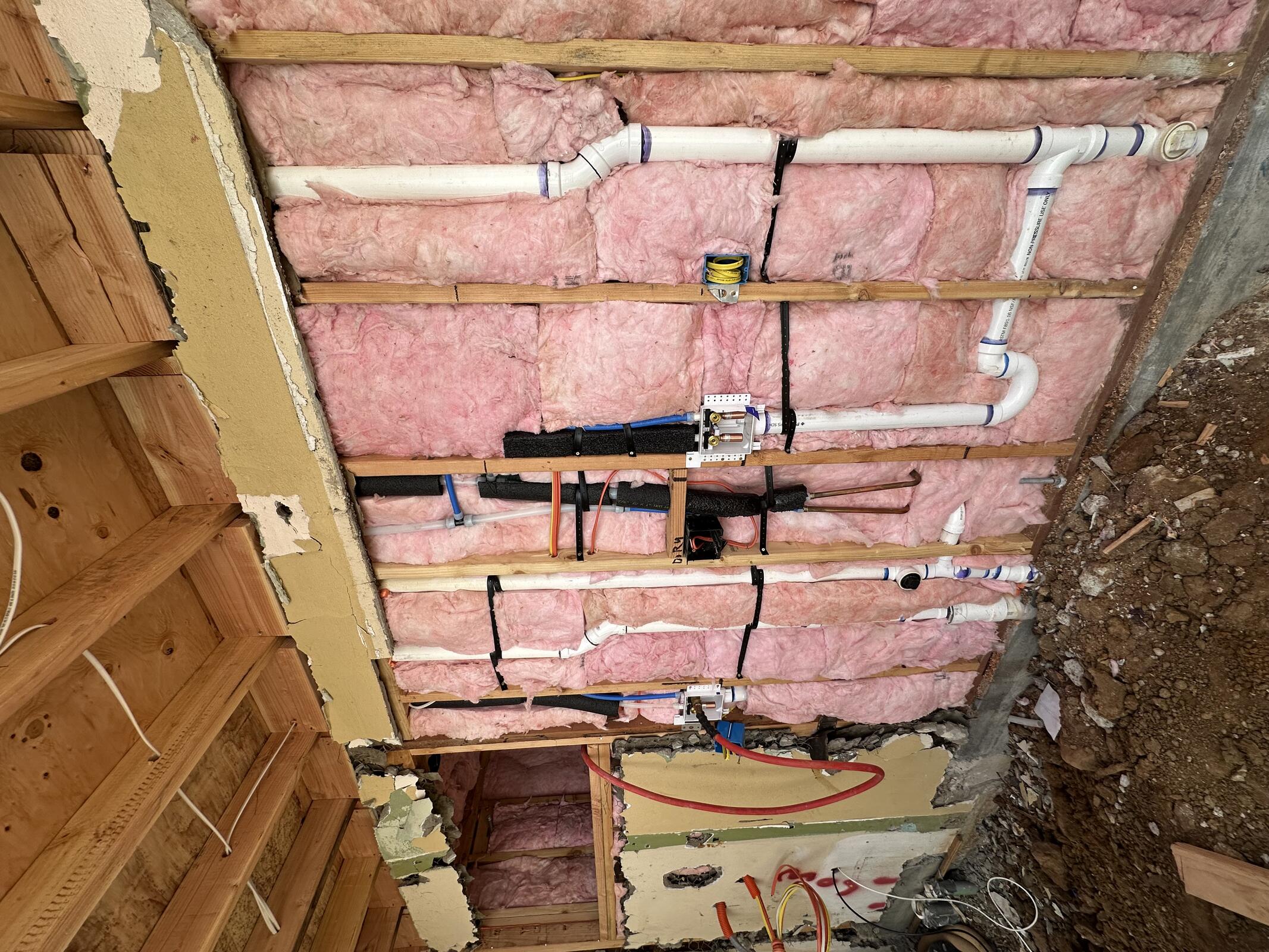

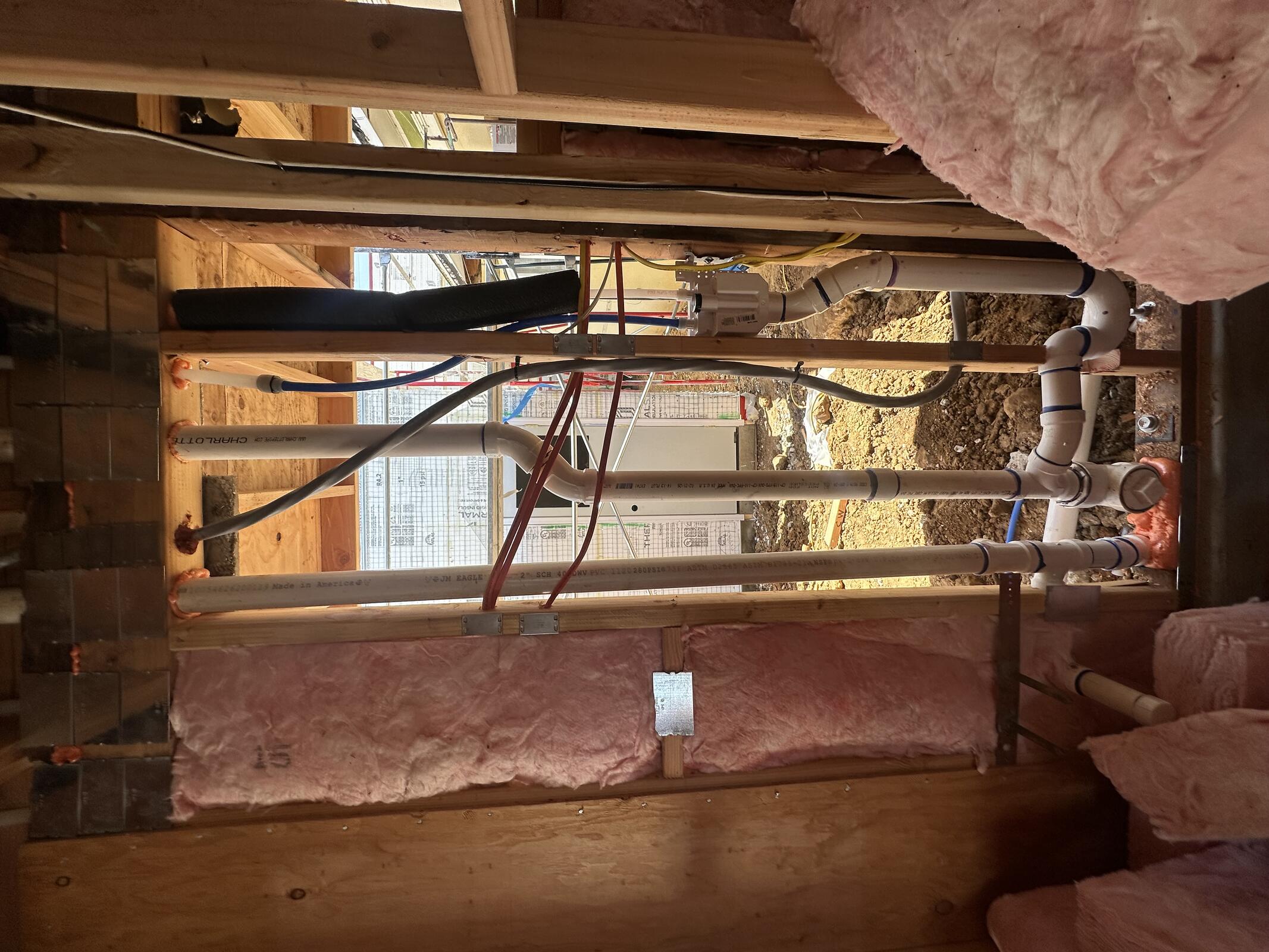

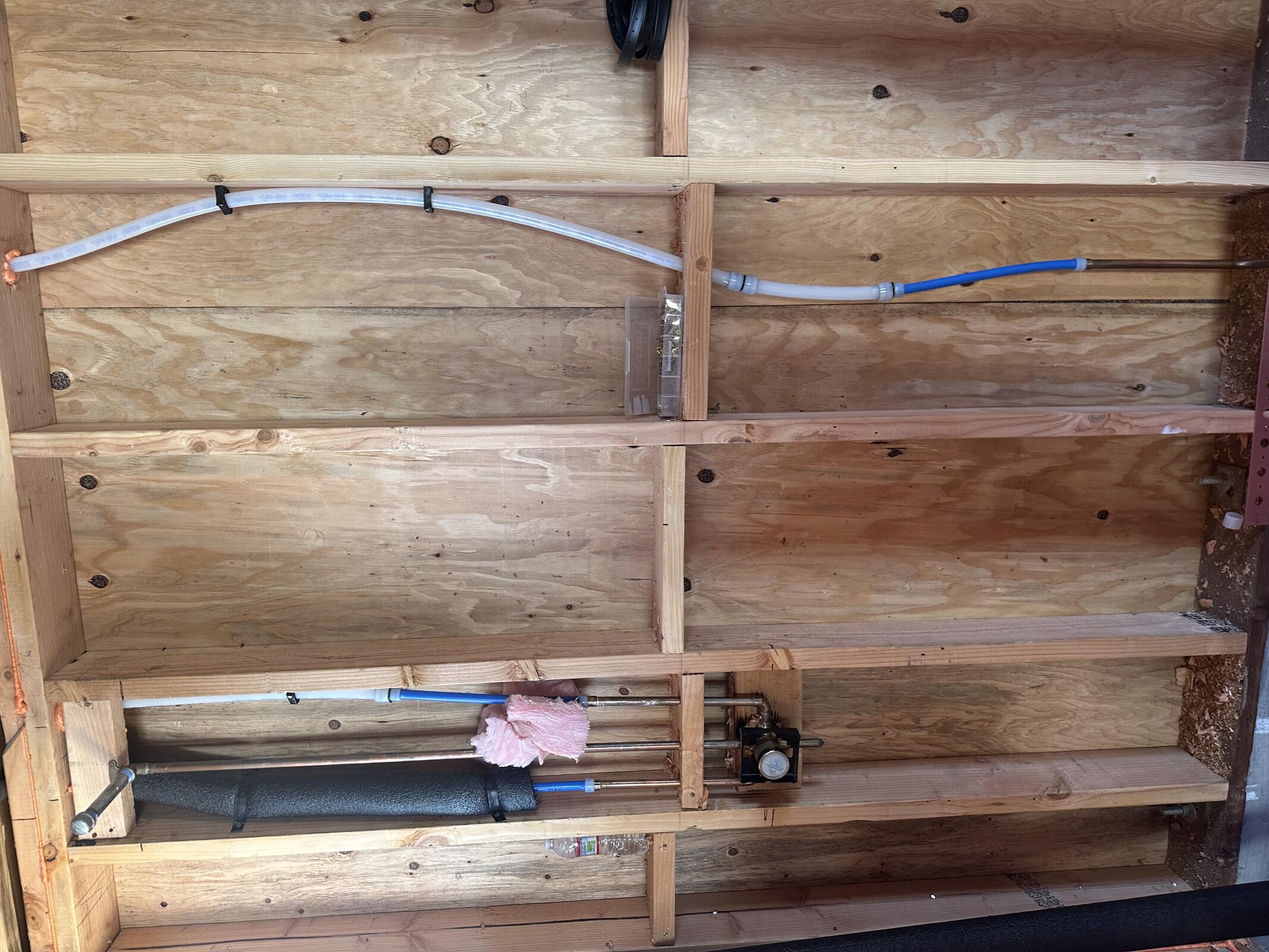

ZSP preparing garage and laundry area washer boxes for plumbing inspection tomorrow 6/2. Lines under pressure.

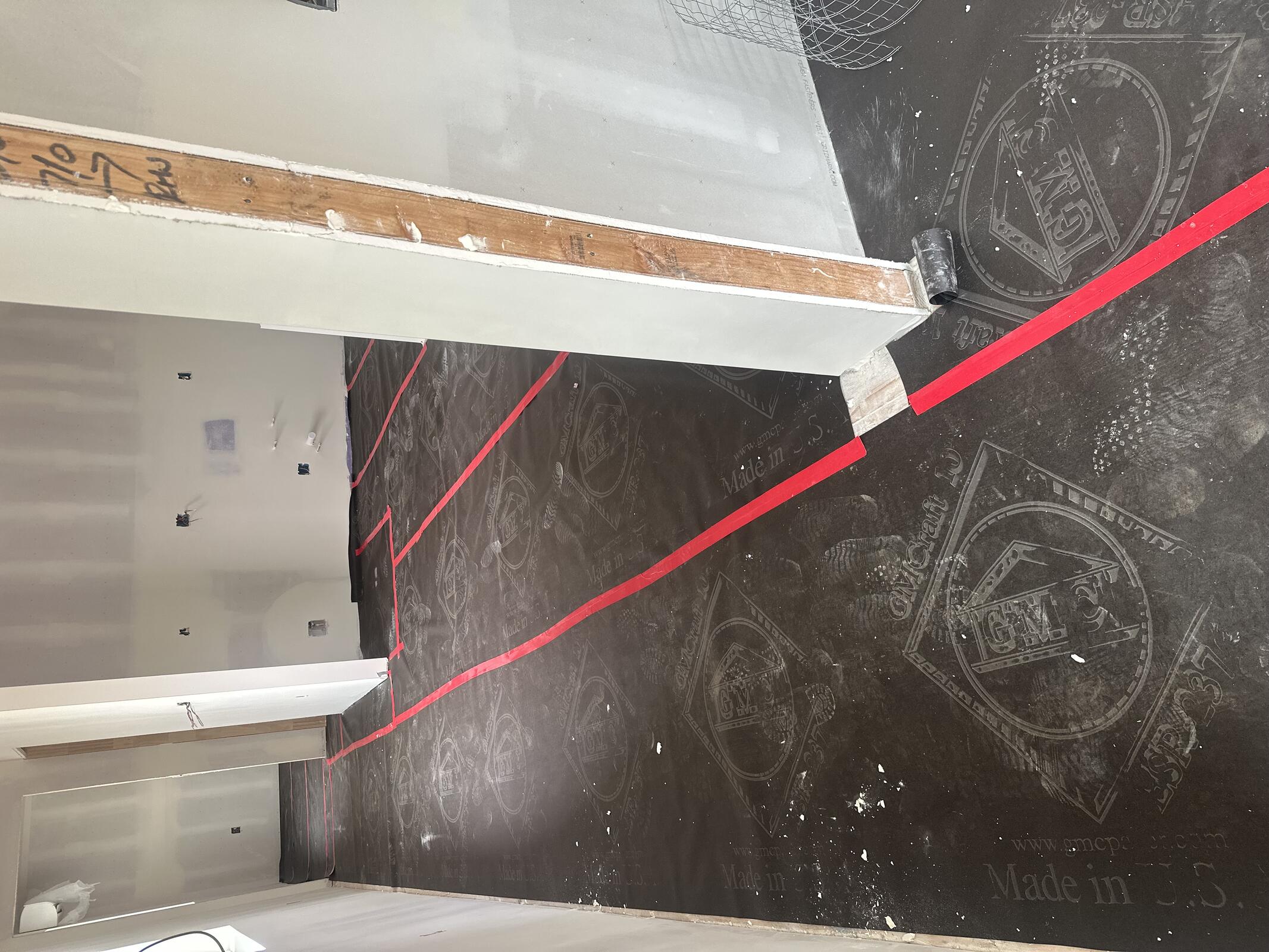

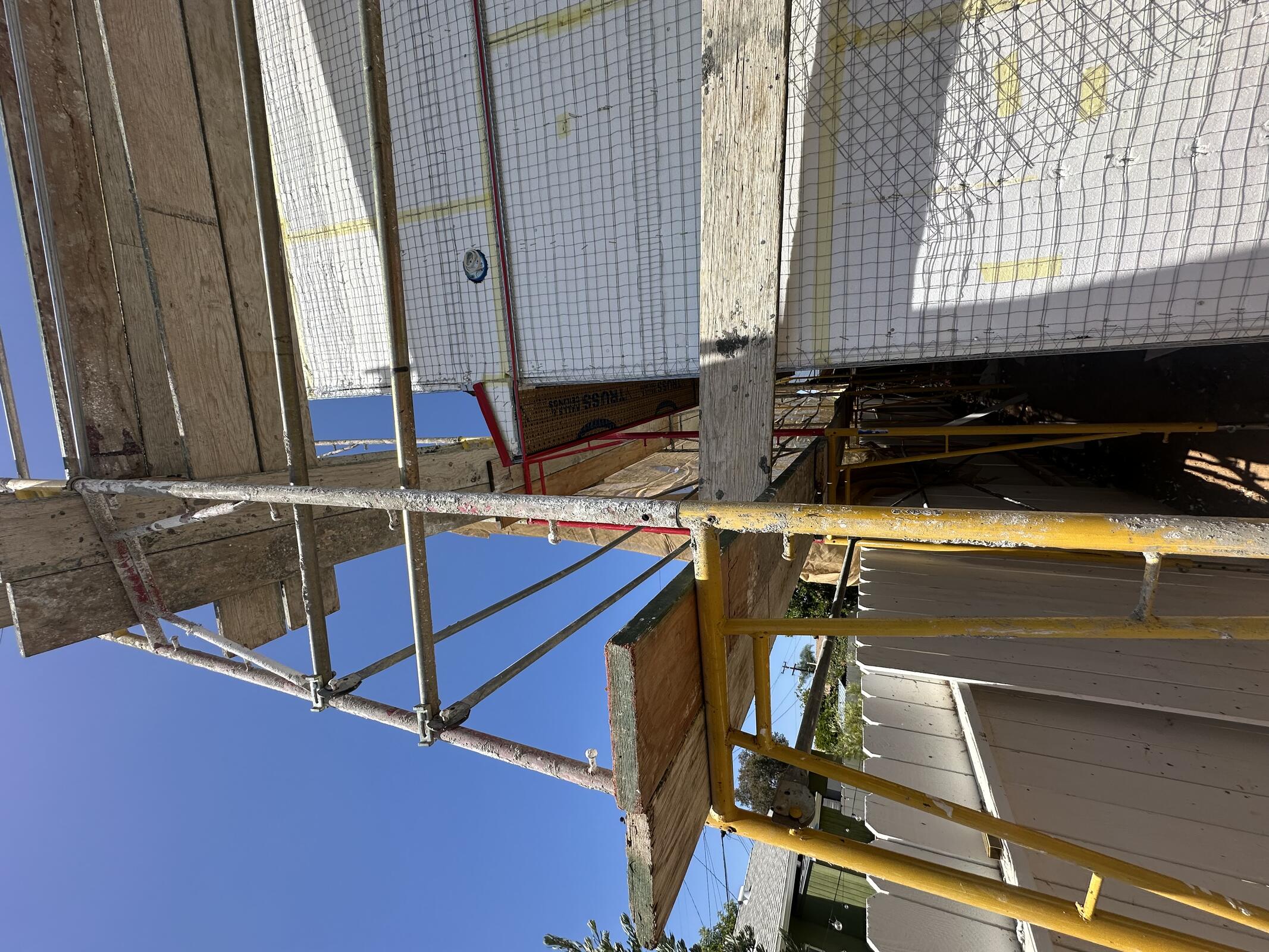

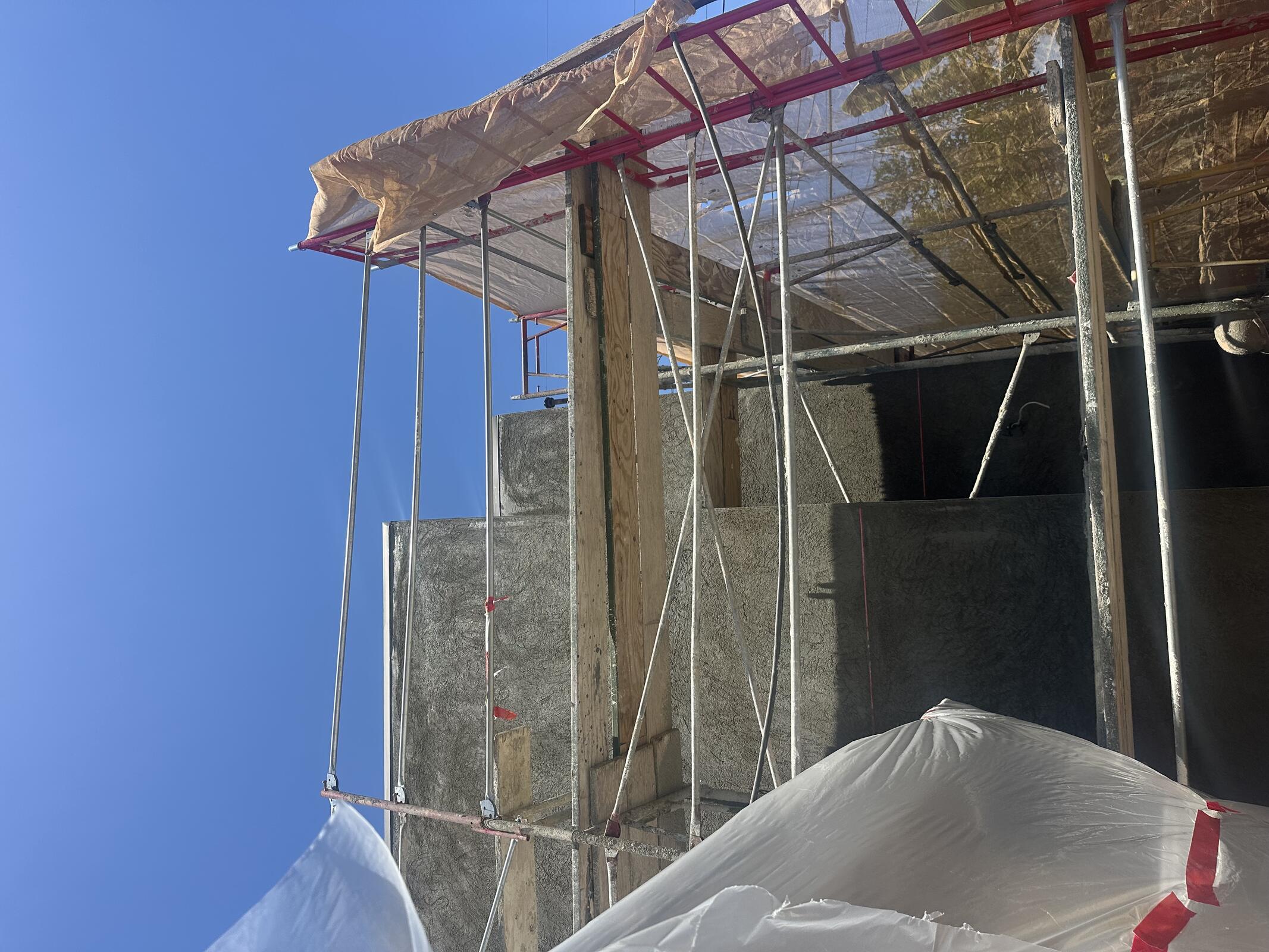

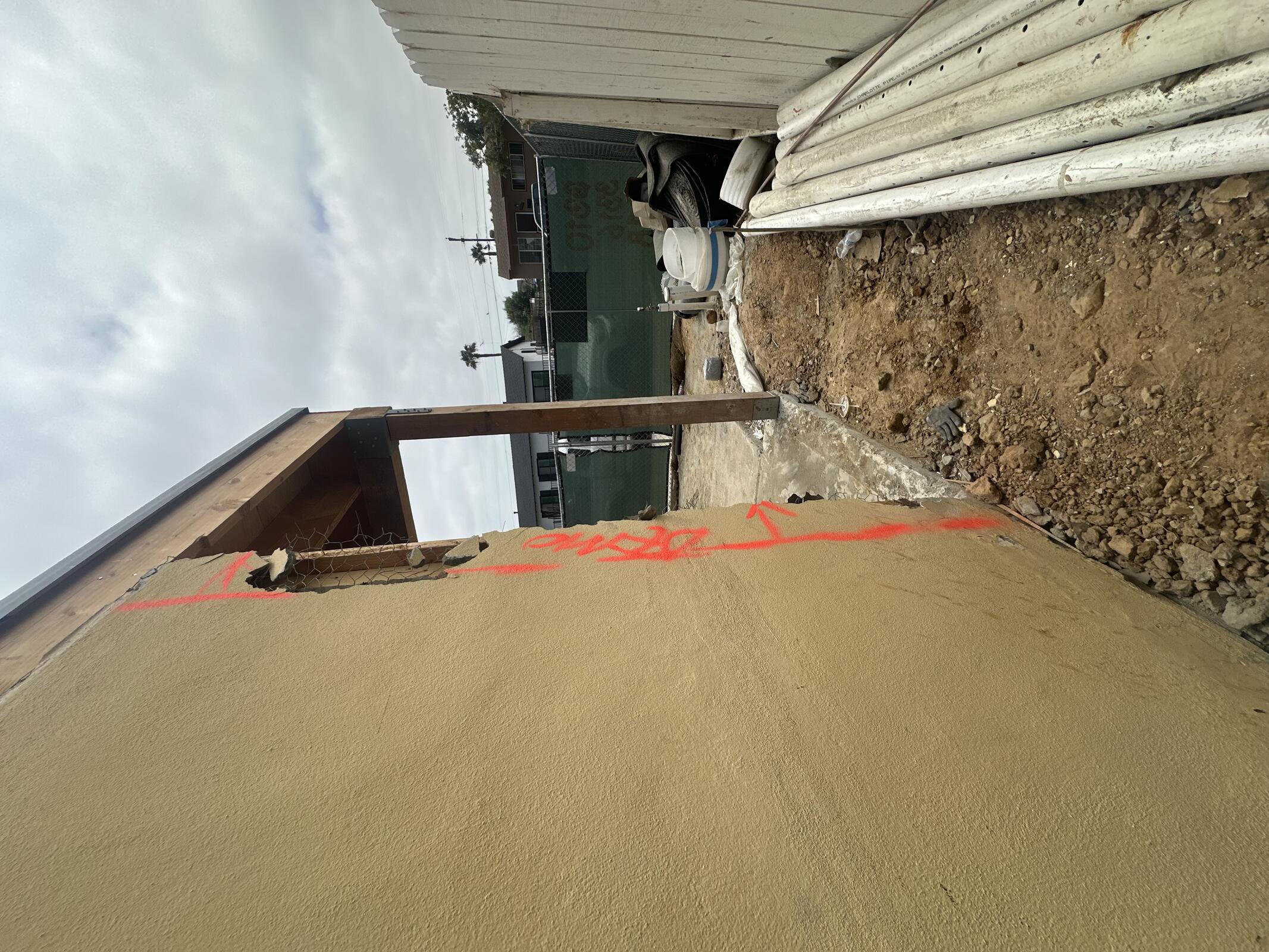

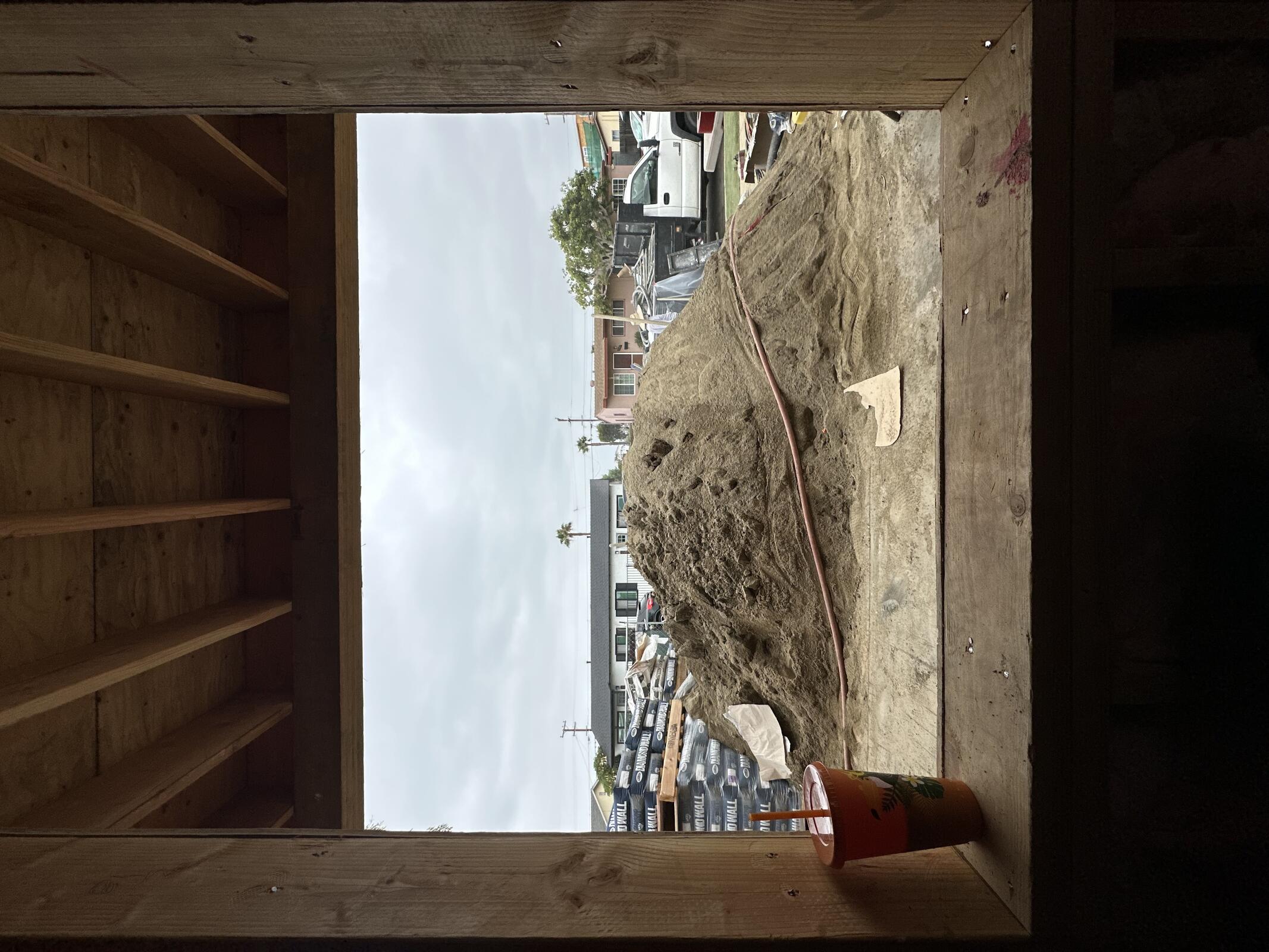

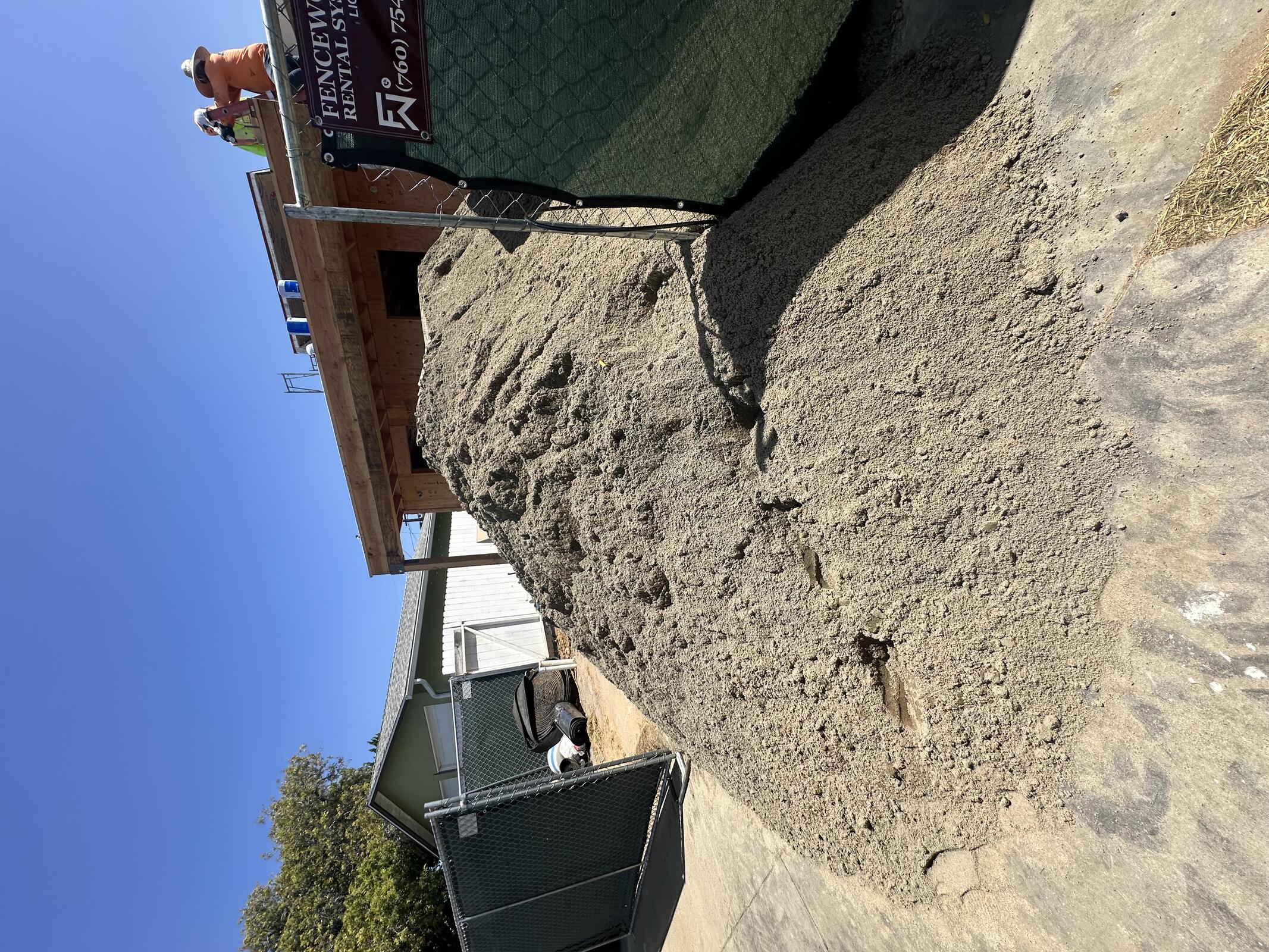

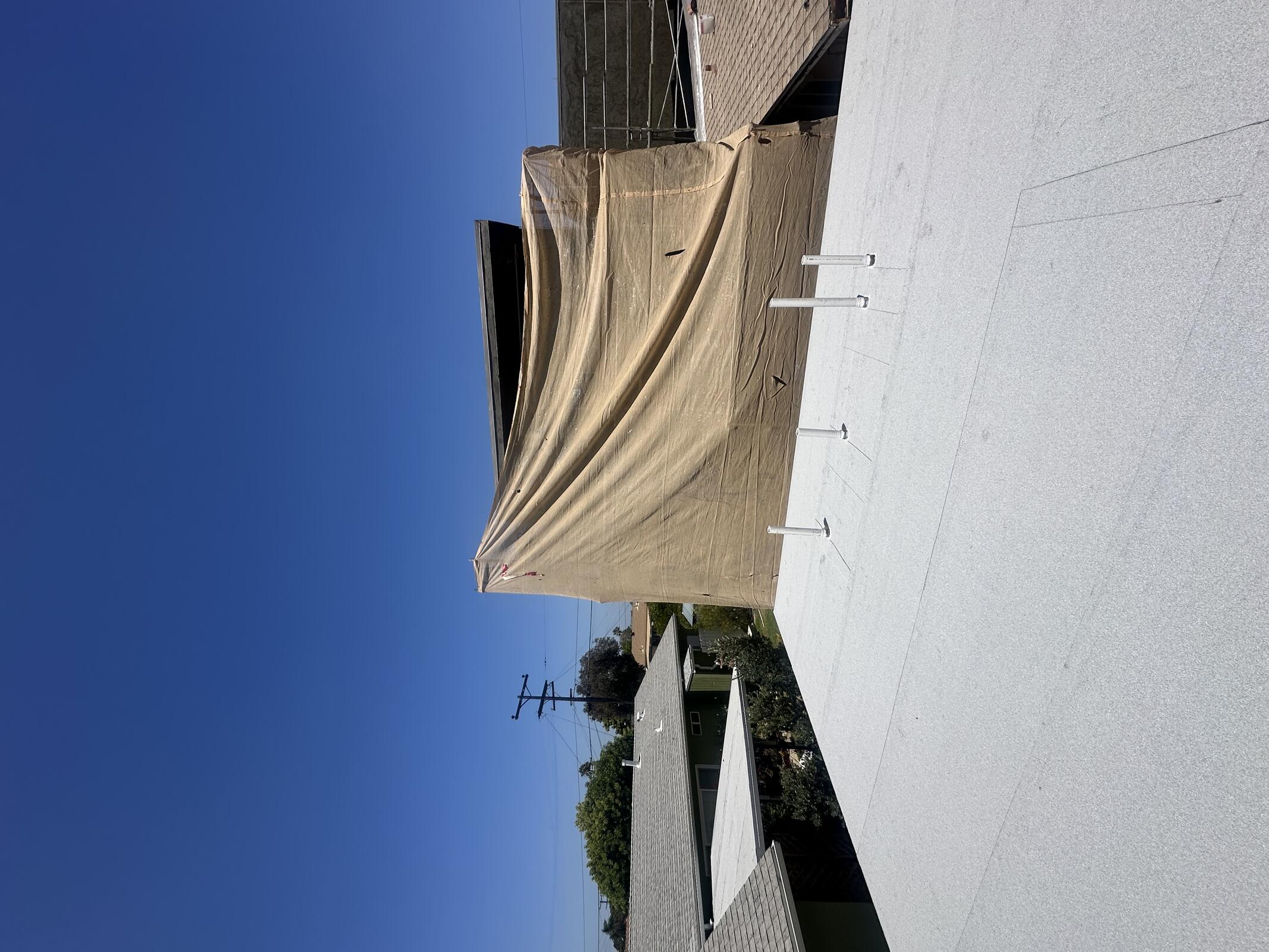

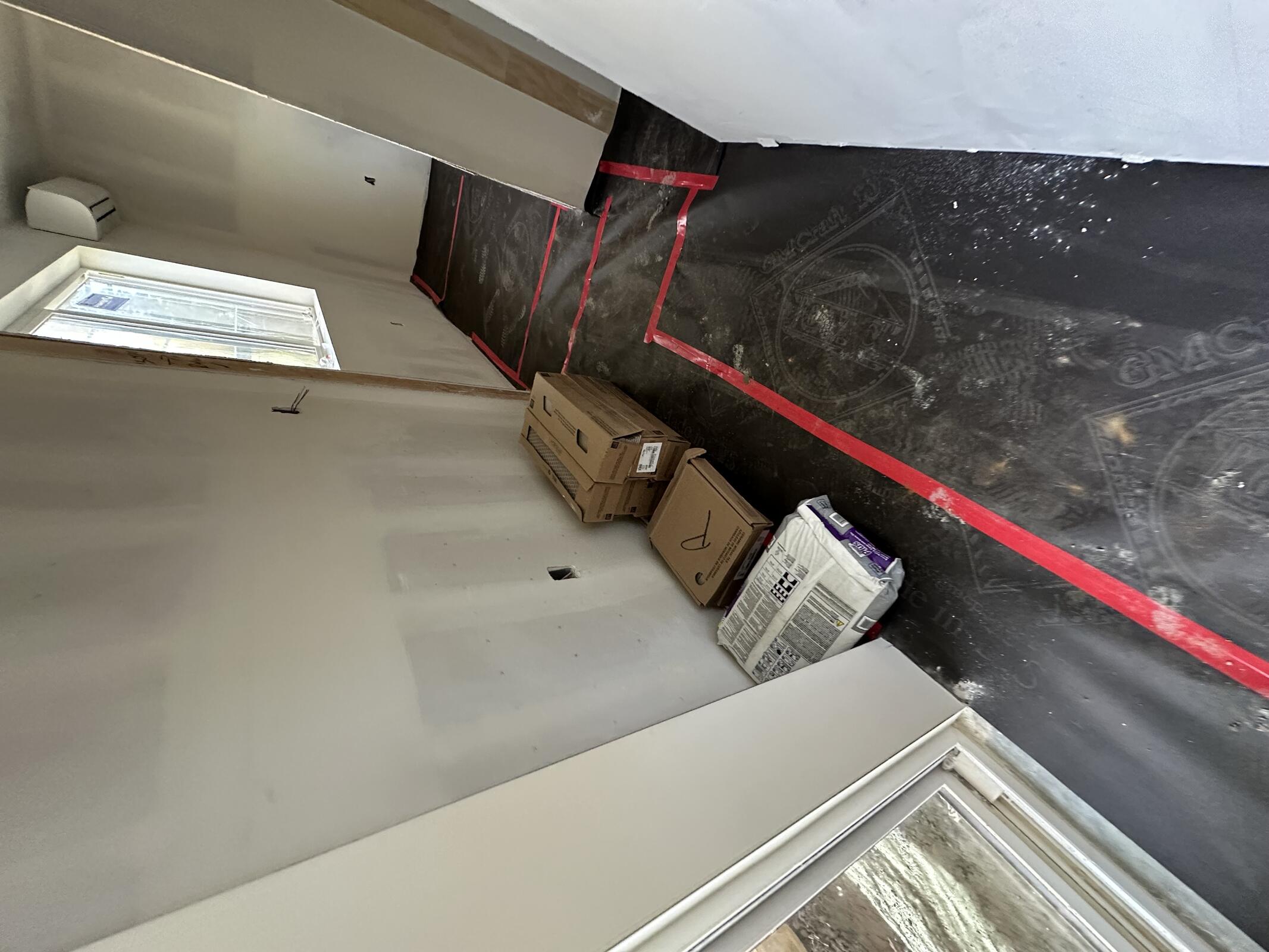

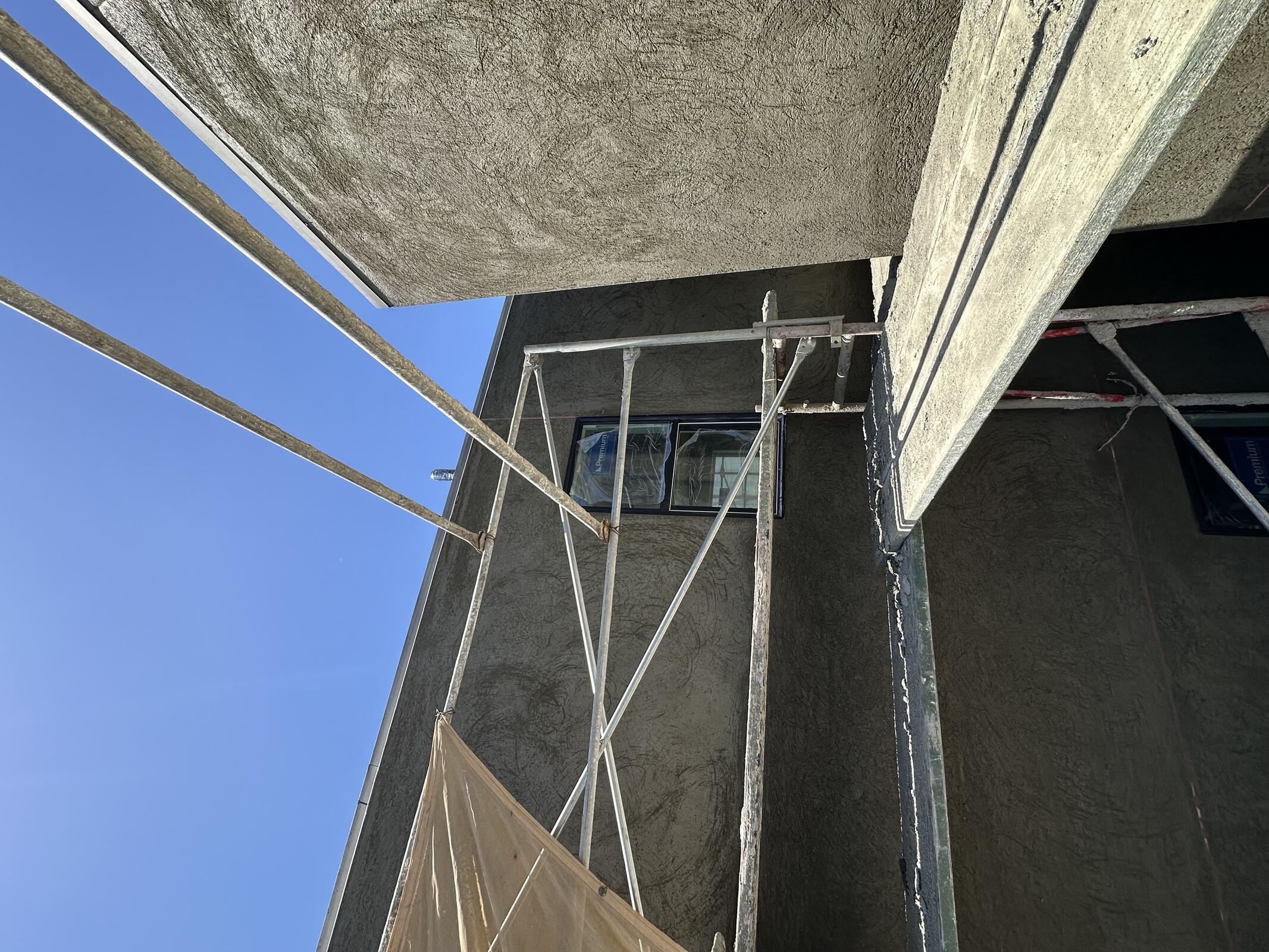

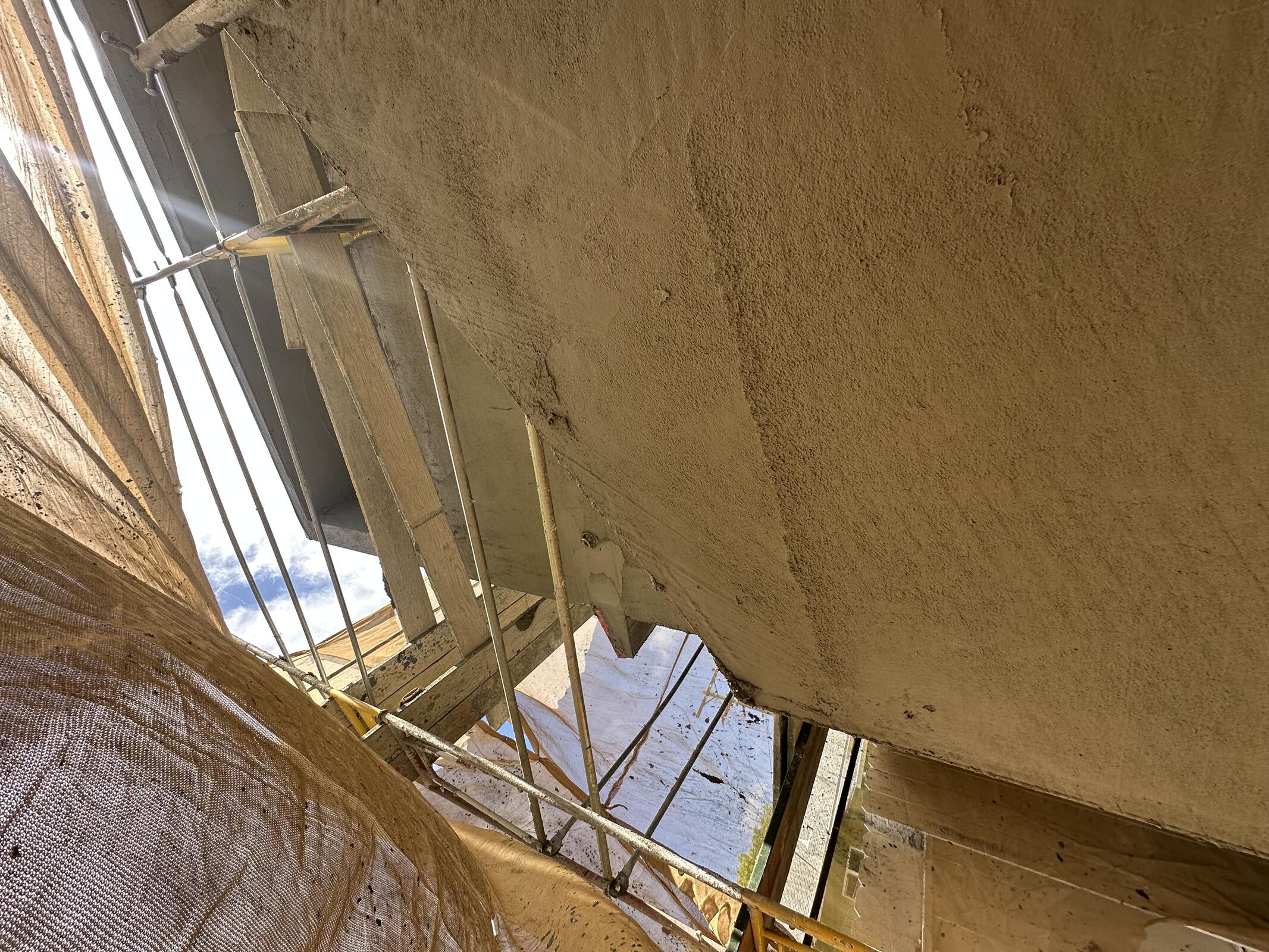

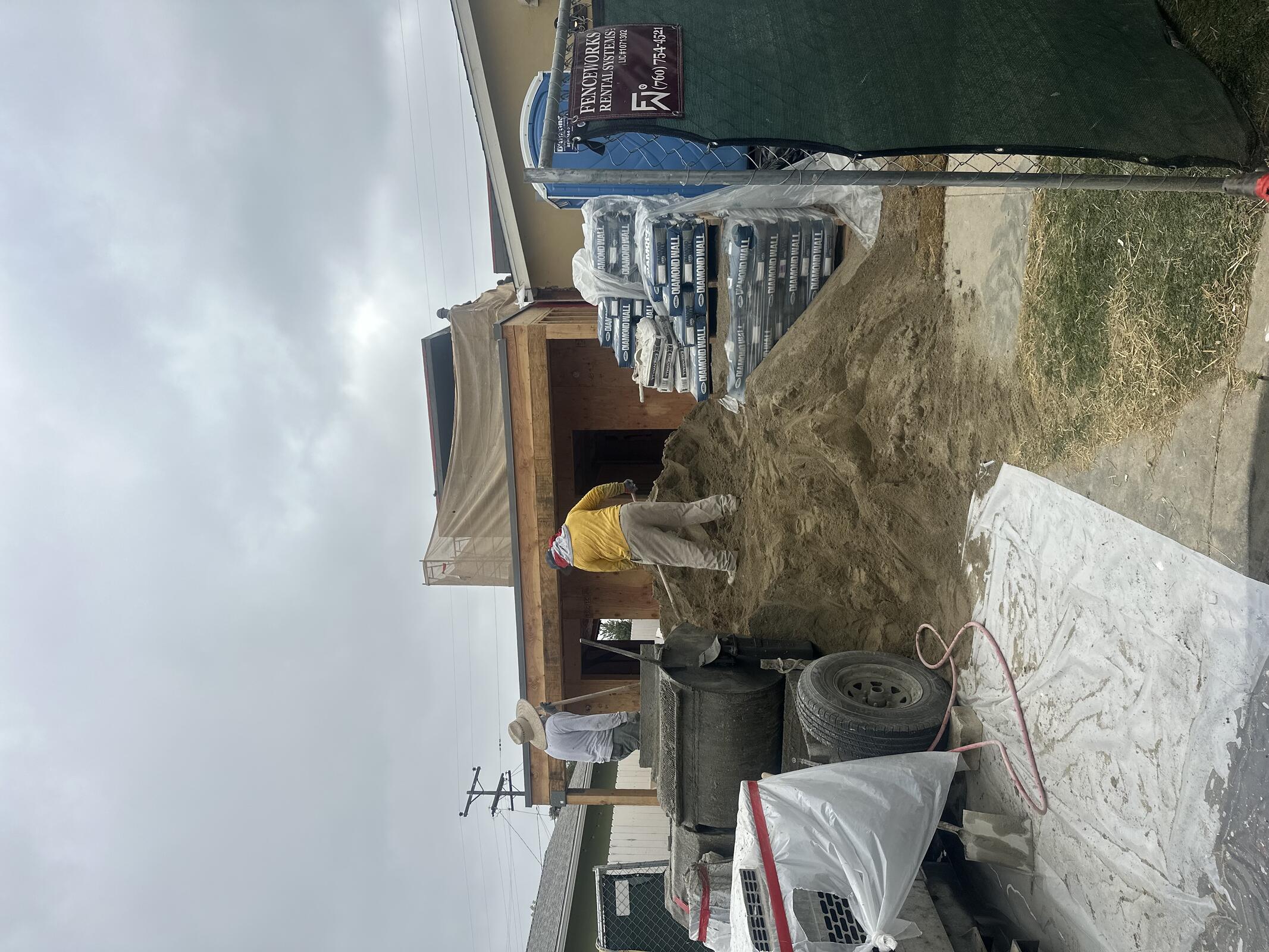

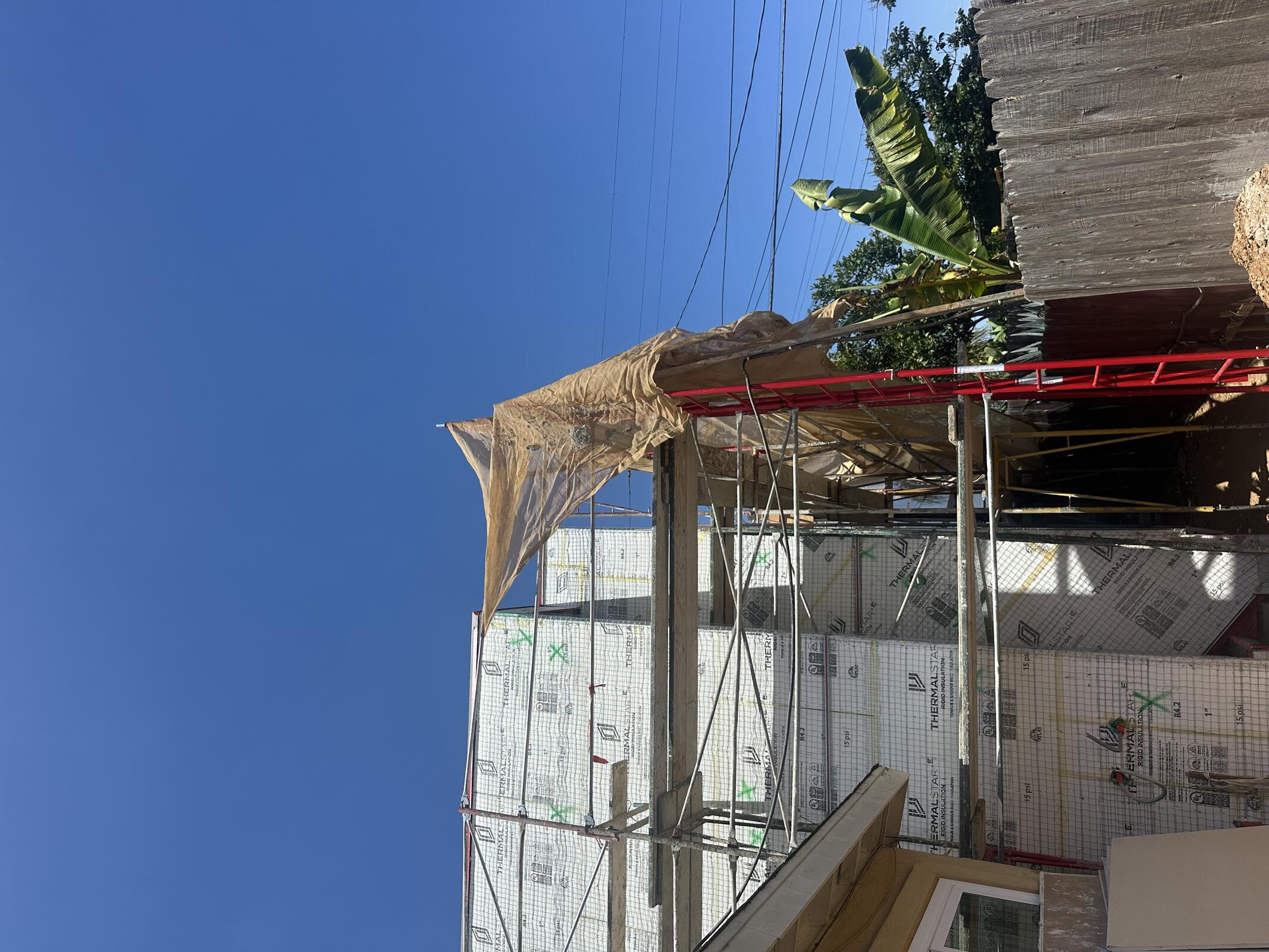

Marq Plastering moving sand out of side walk and tarping scaffolding to prepare for scratch and brown.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
ACCI3824
ZSP2816
Marq248

Inspection: N/A

Tuesday, June 02, 2026

Clear, 68°F

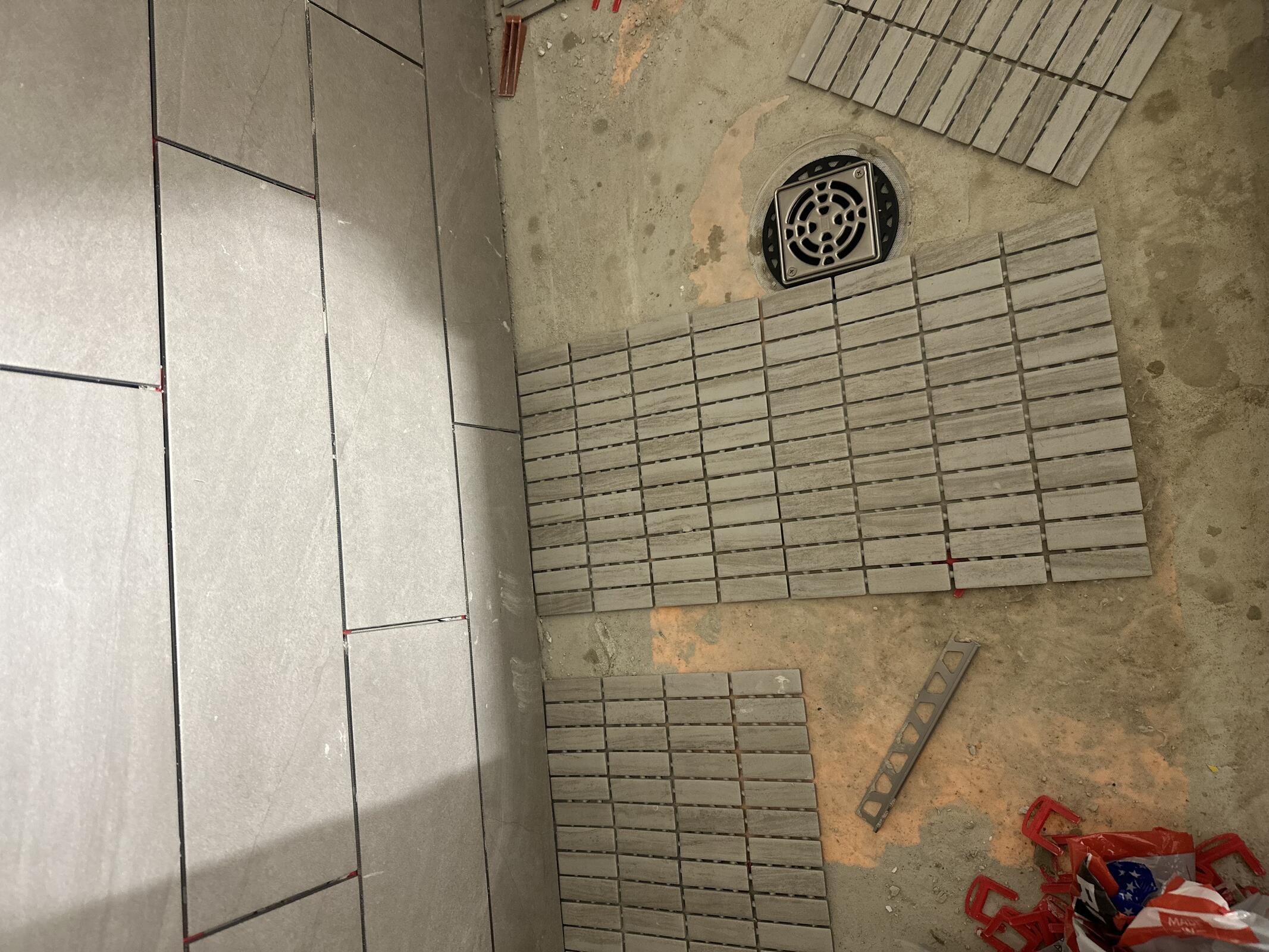

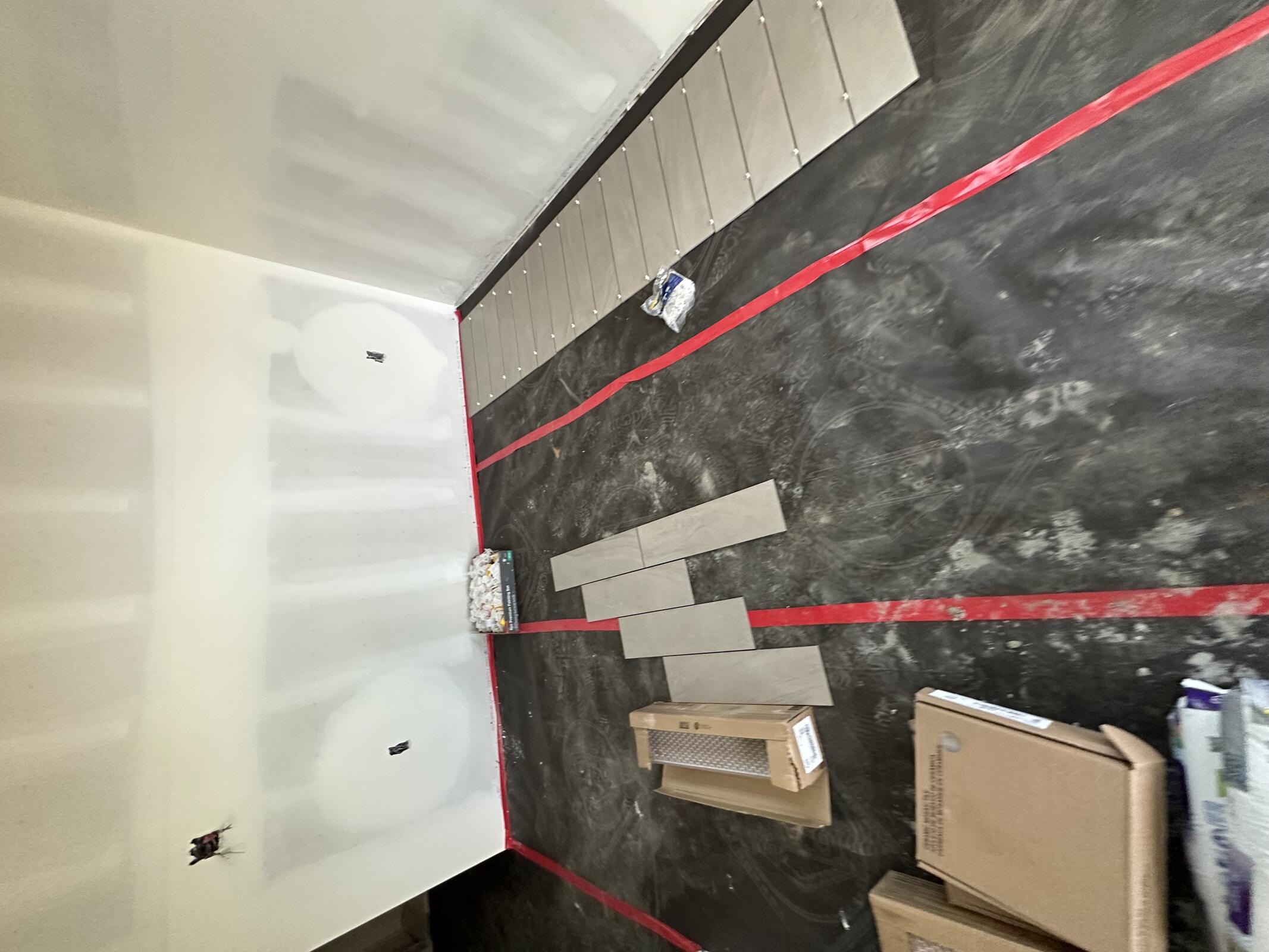

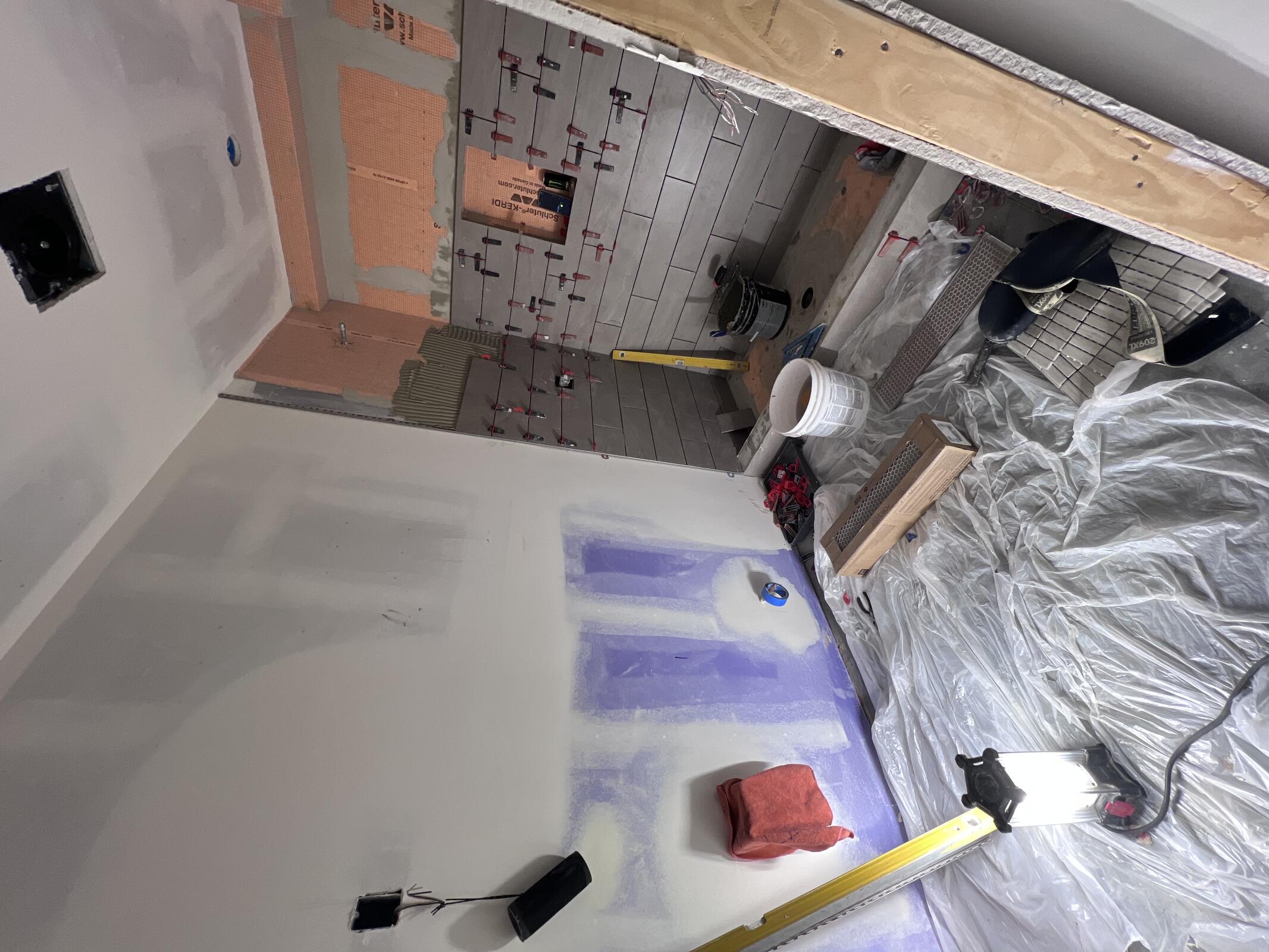

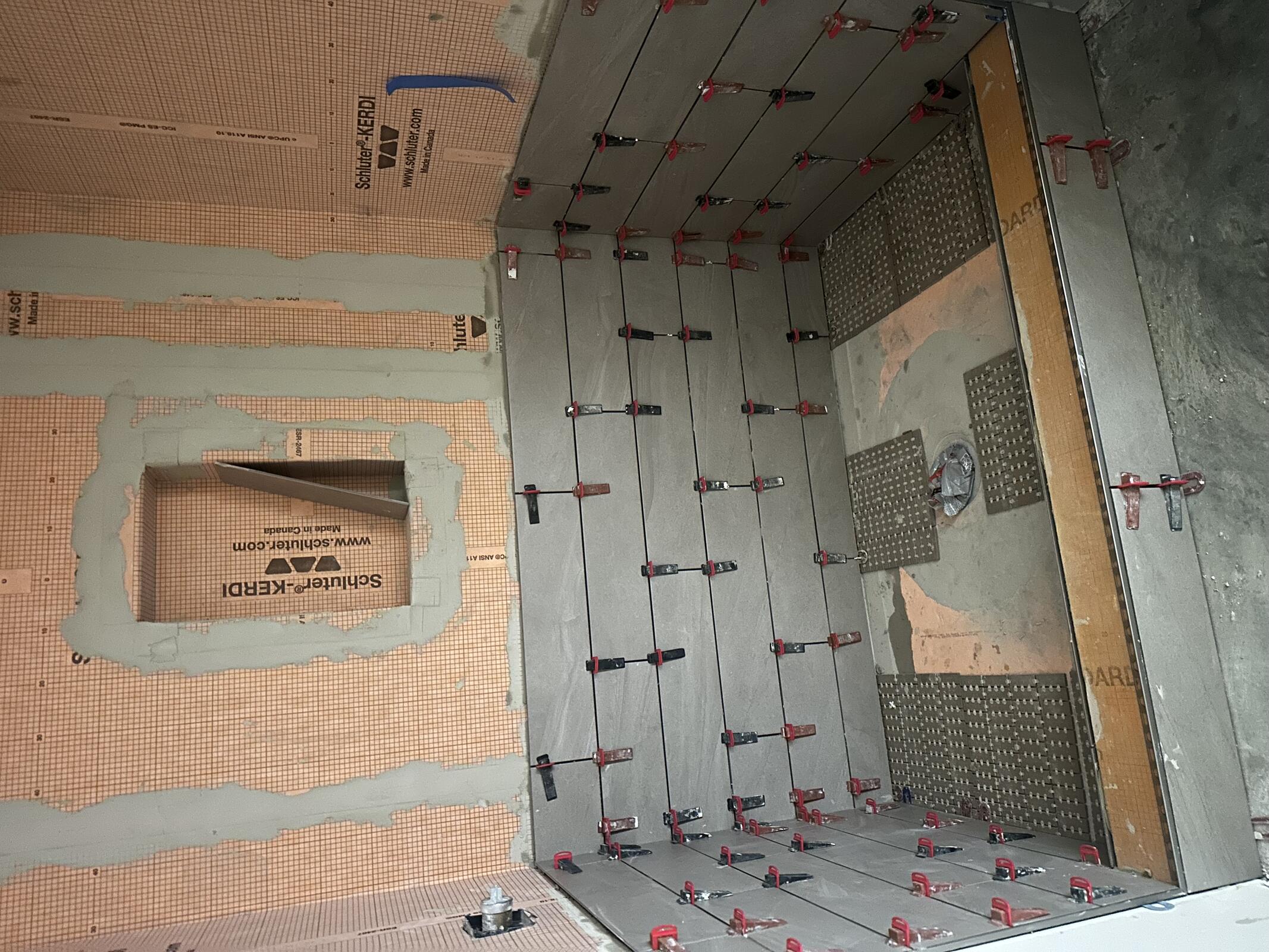

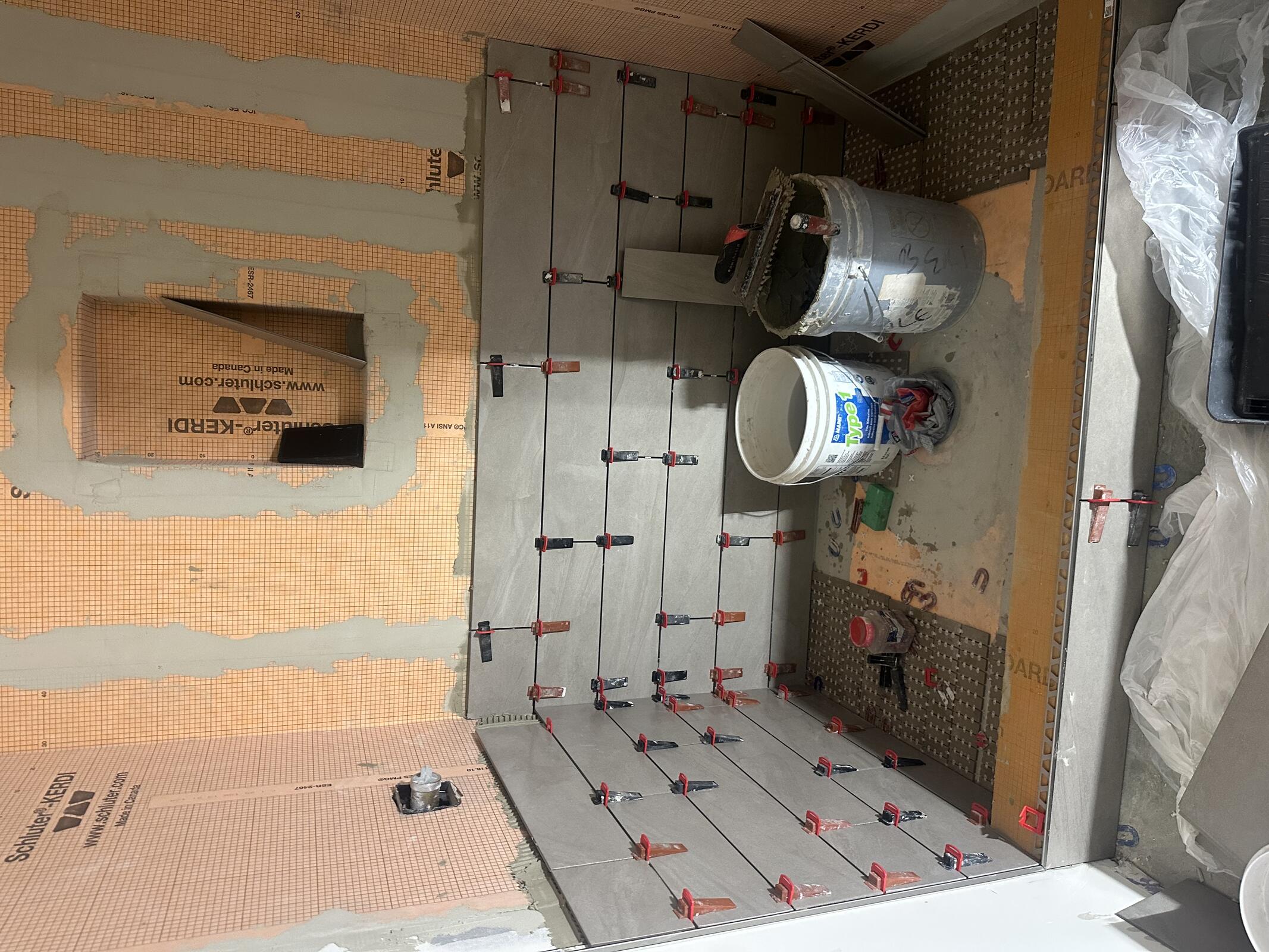

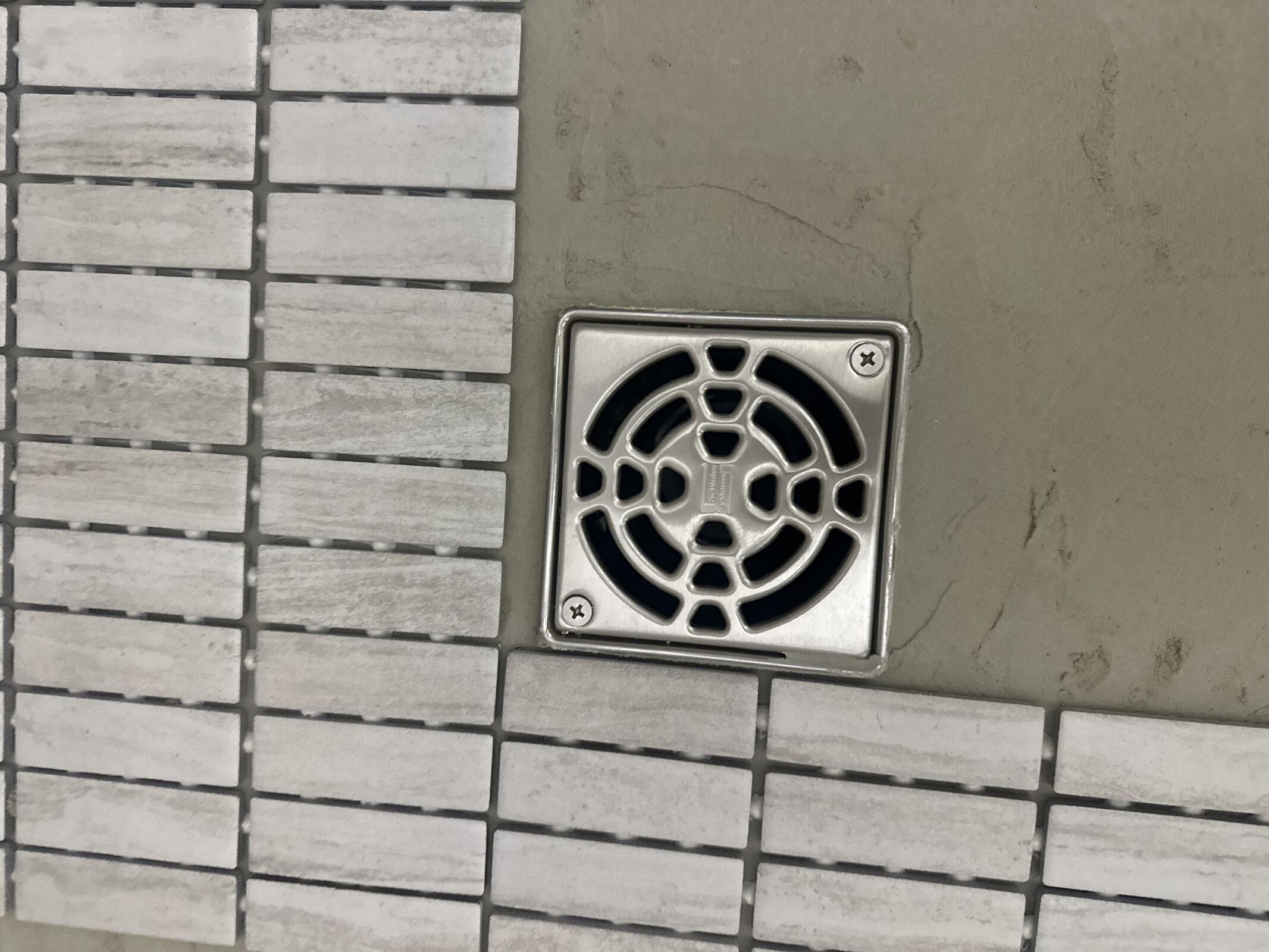

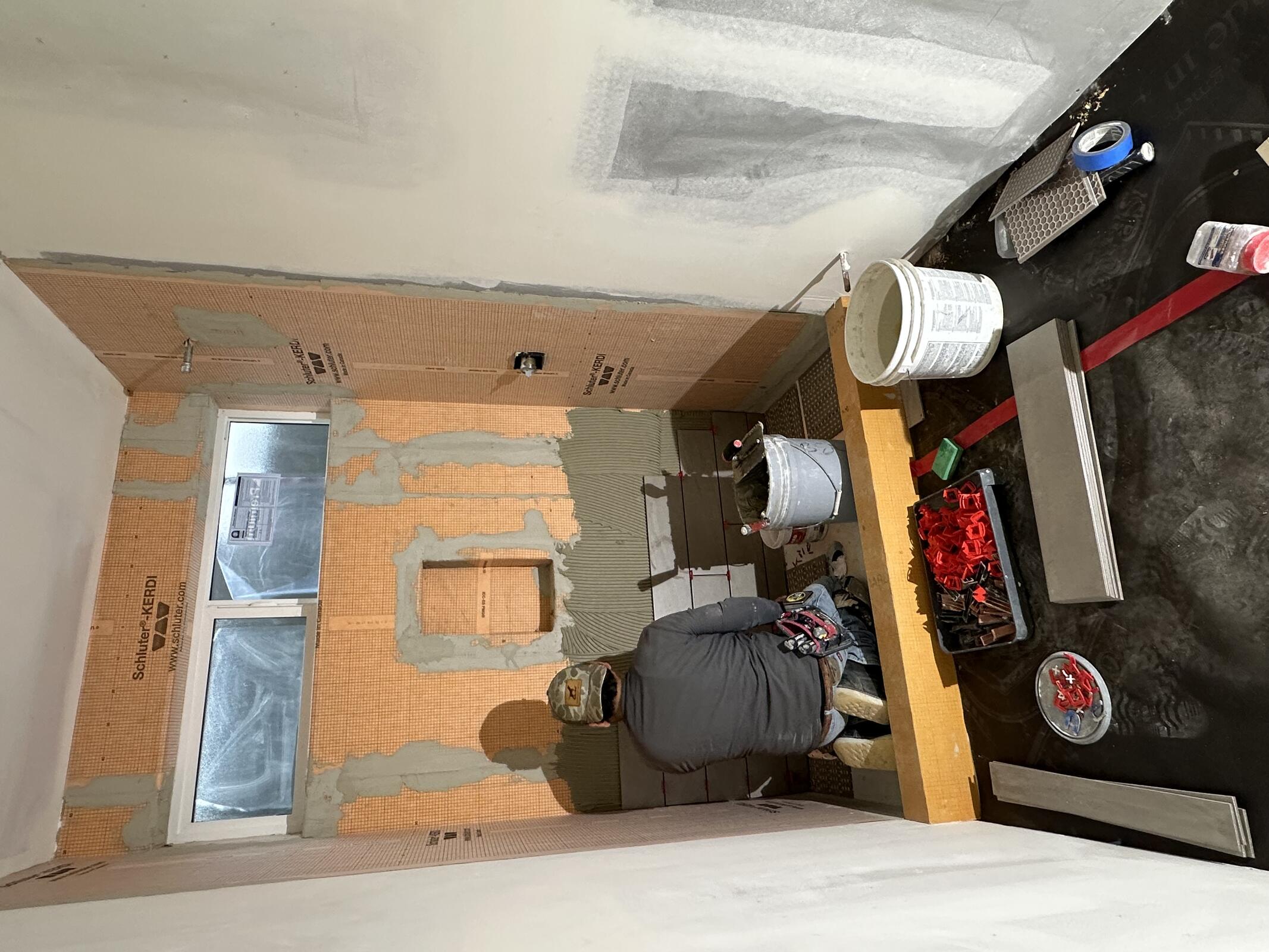

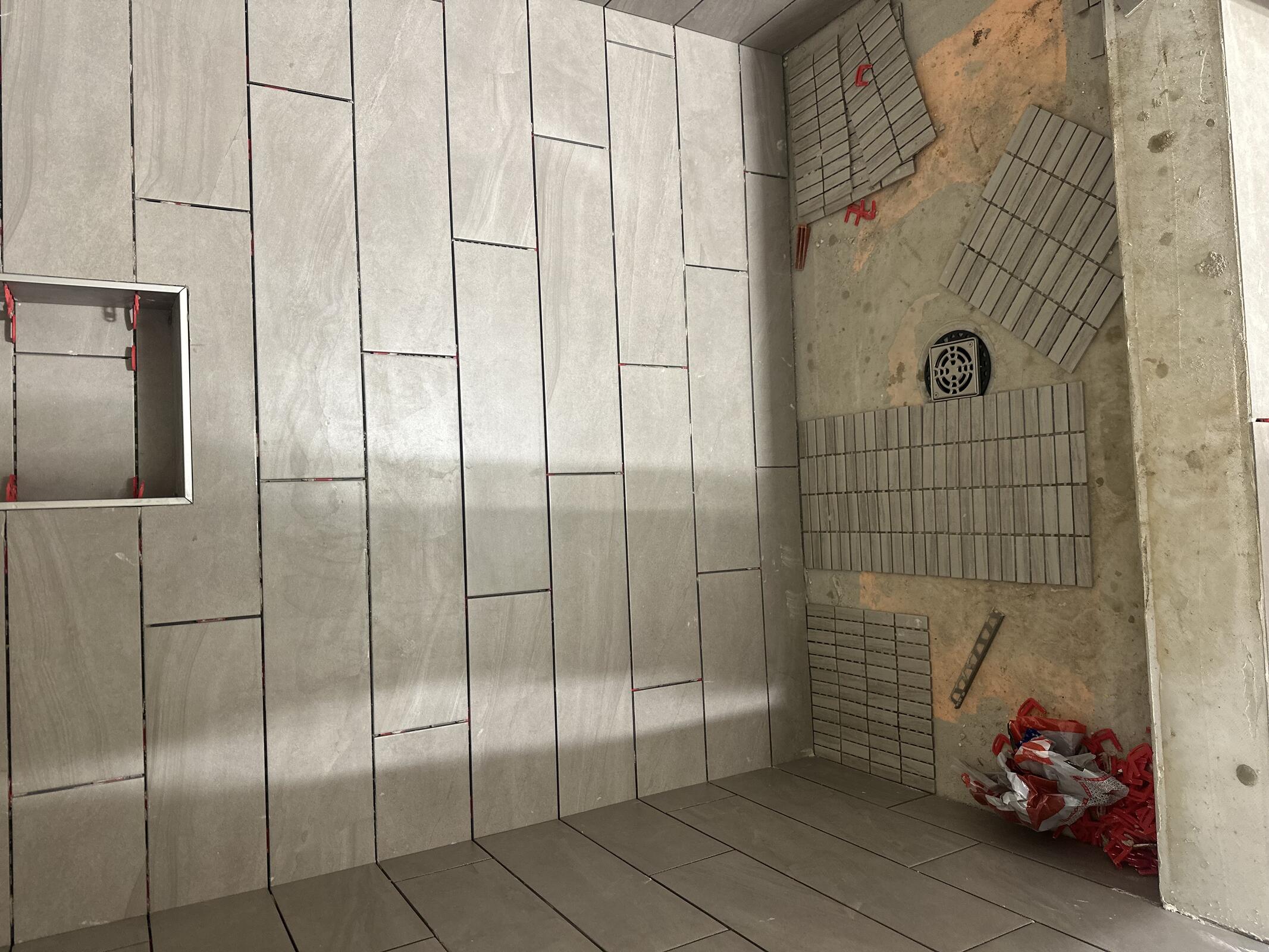

Coastal on site, laying out tile for bathroom in B1, C1, C2. All tile delivered to site.

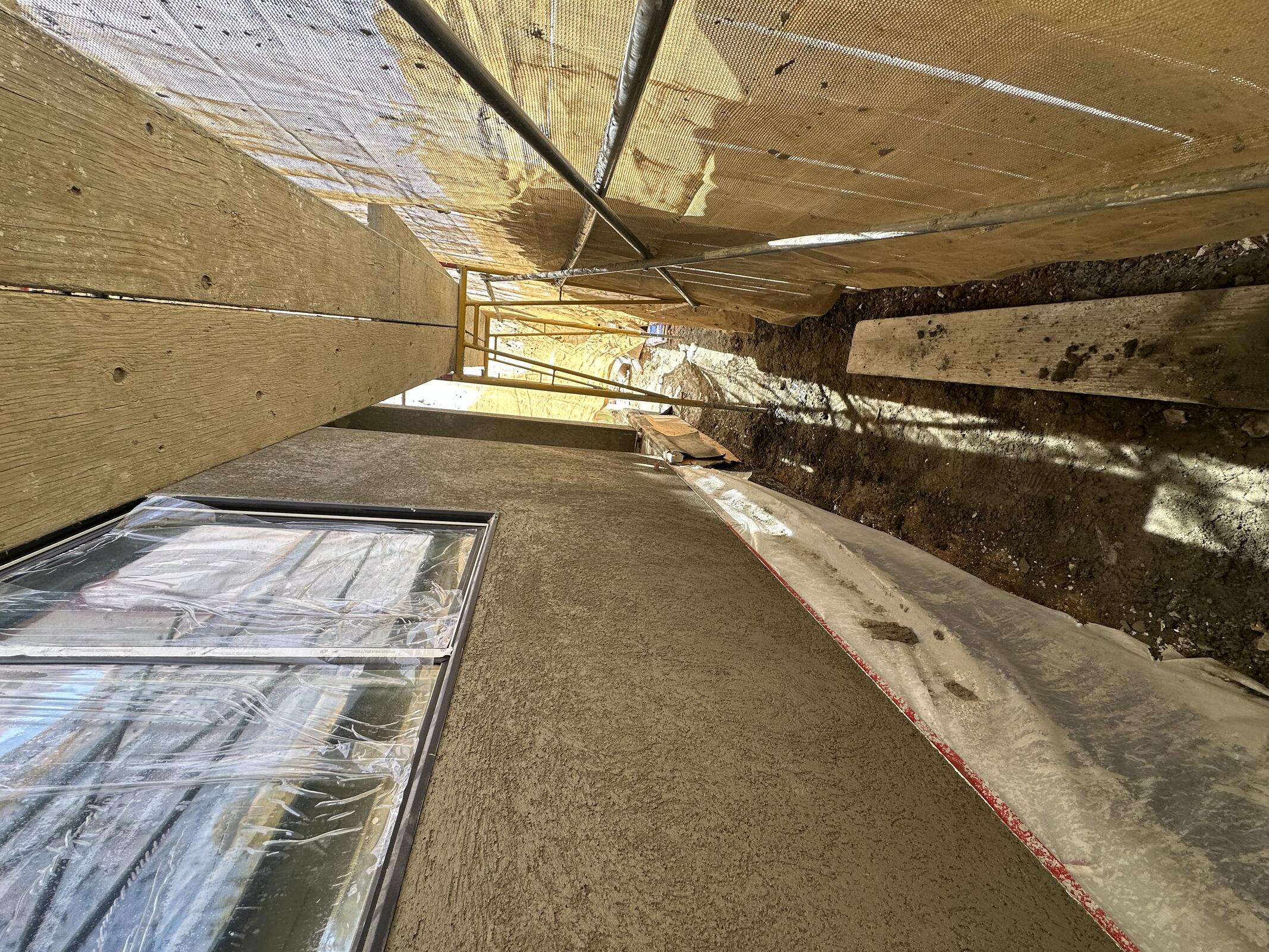

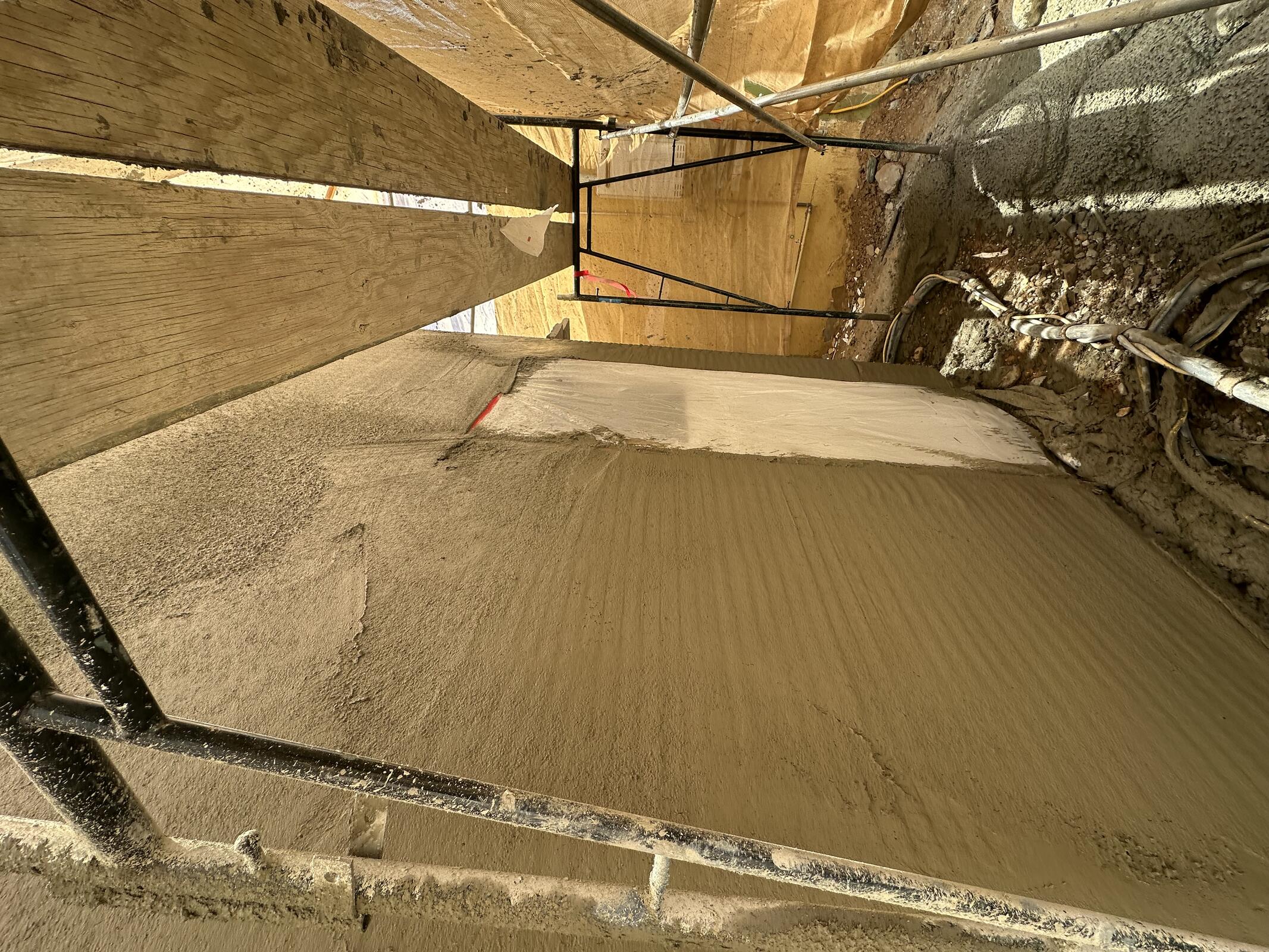

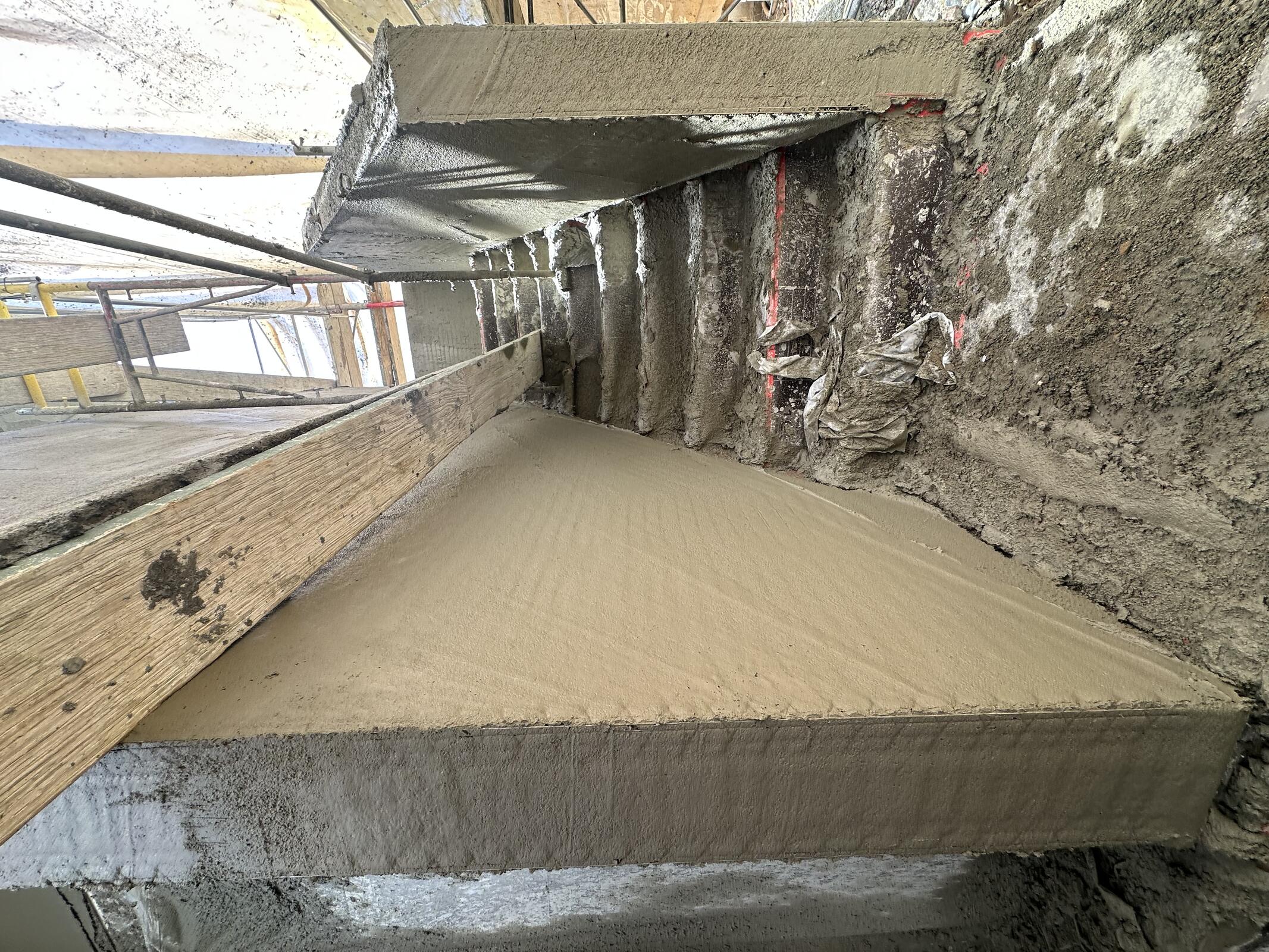

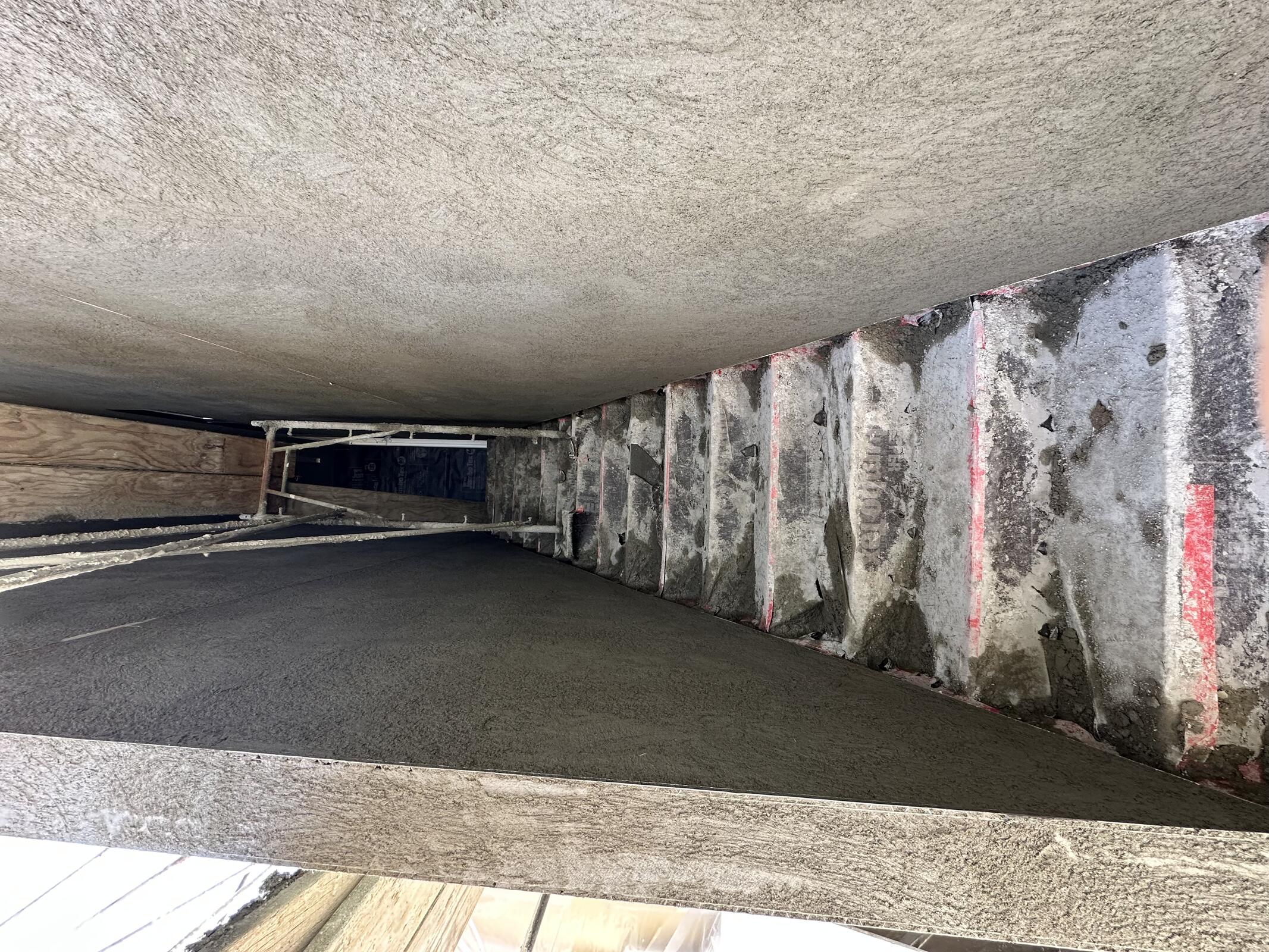

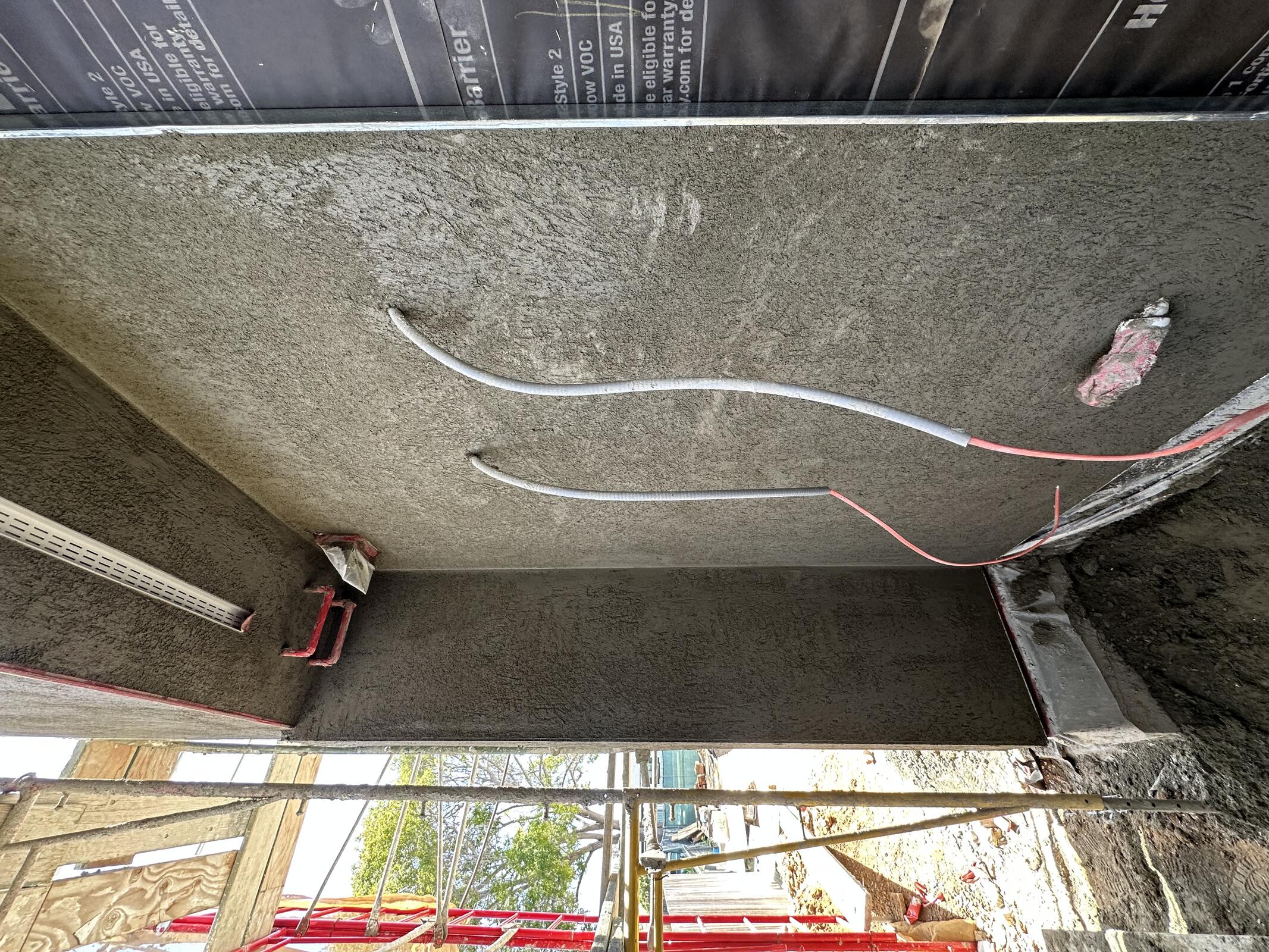

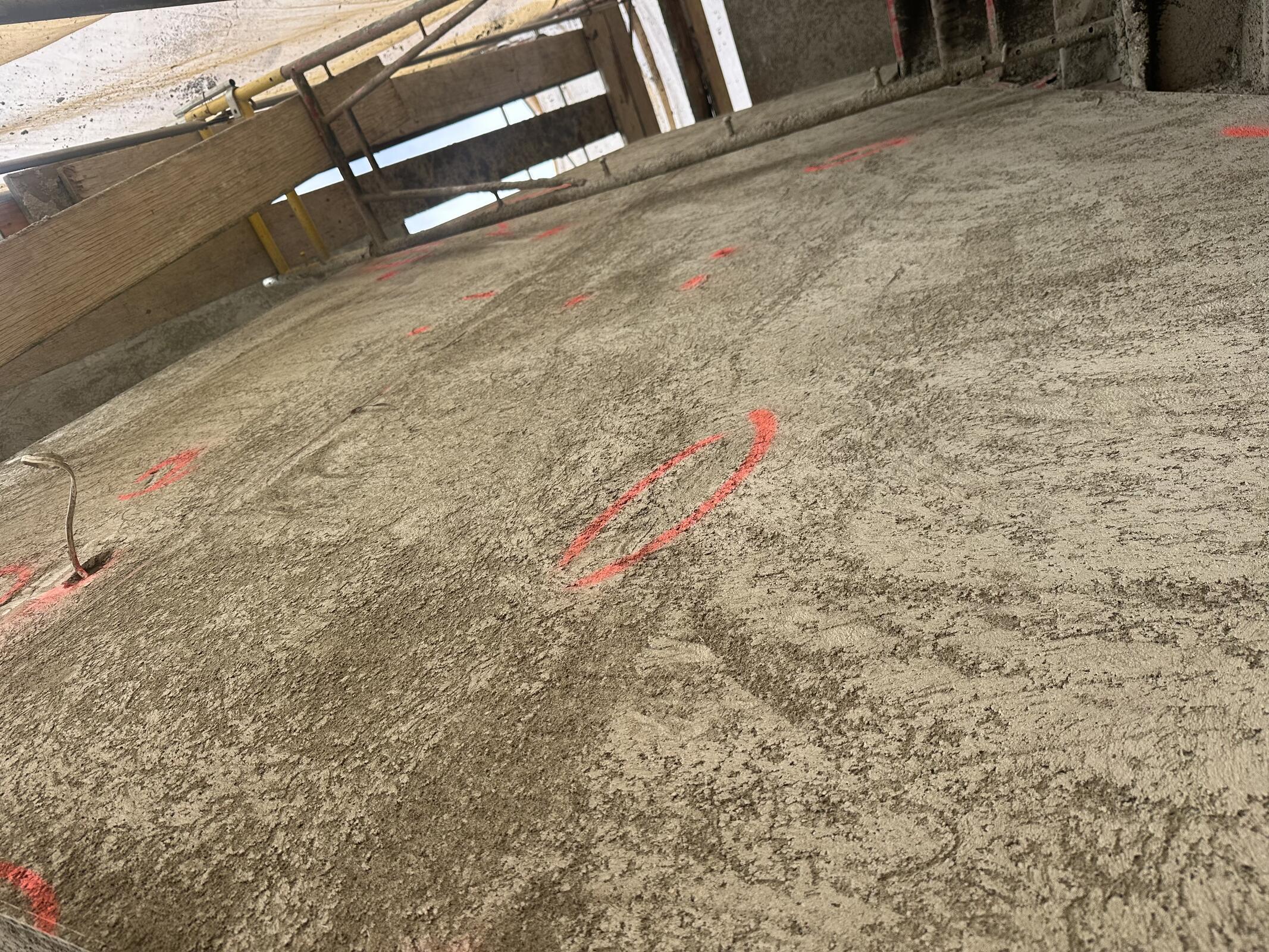

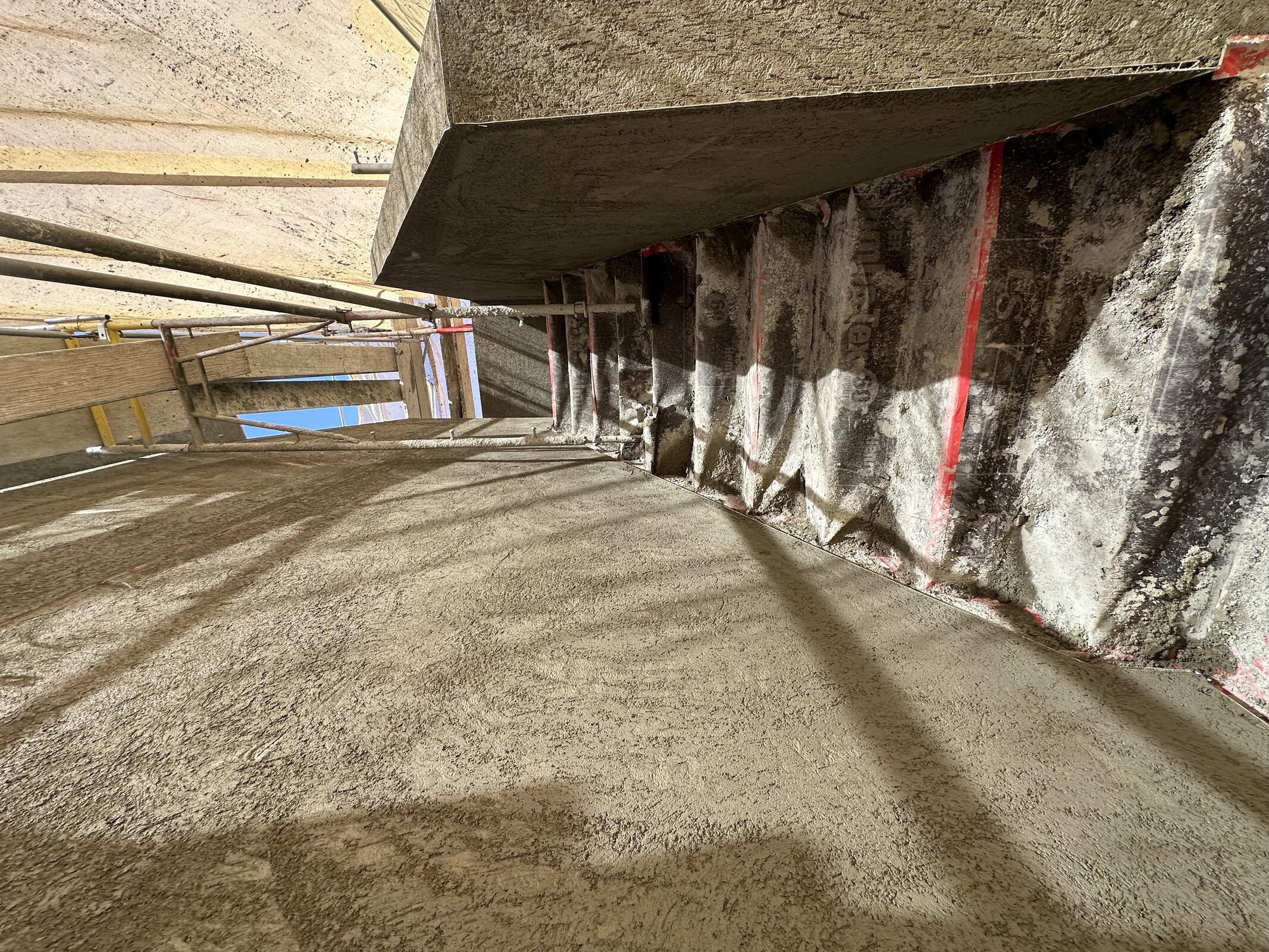

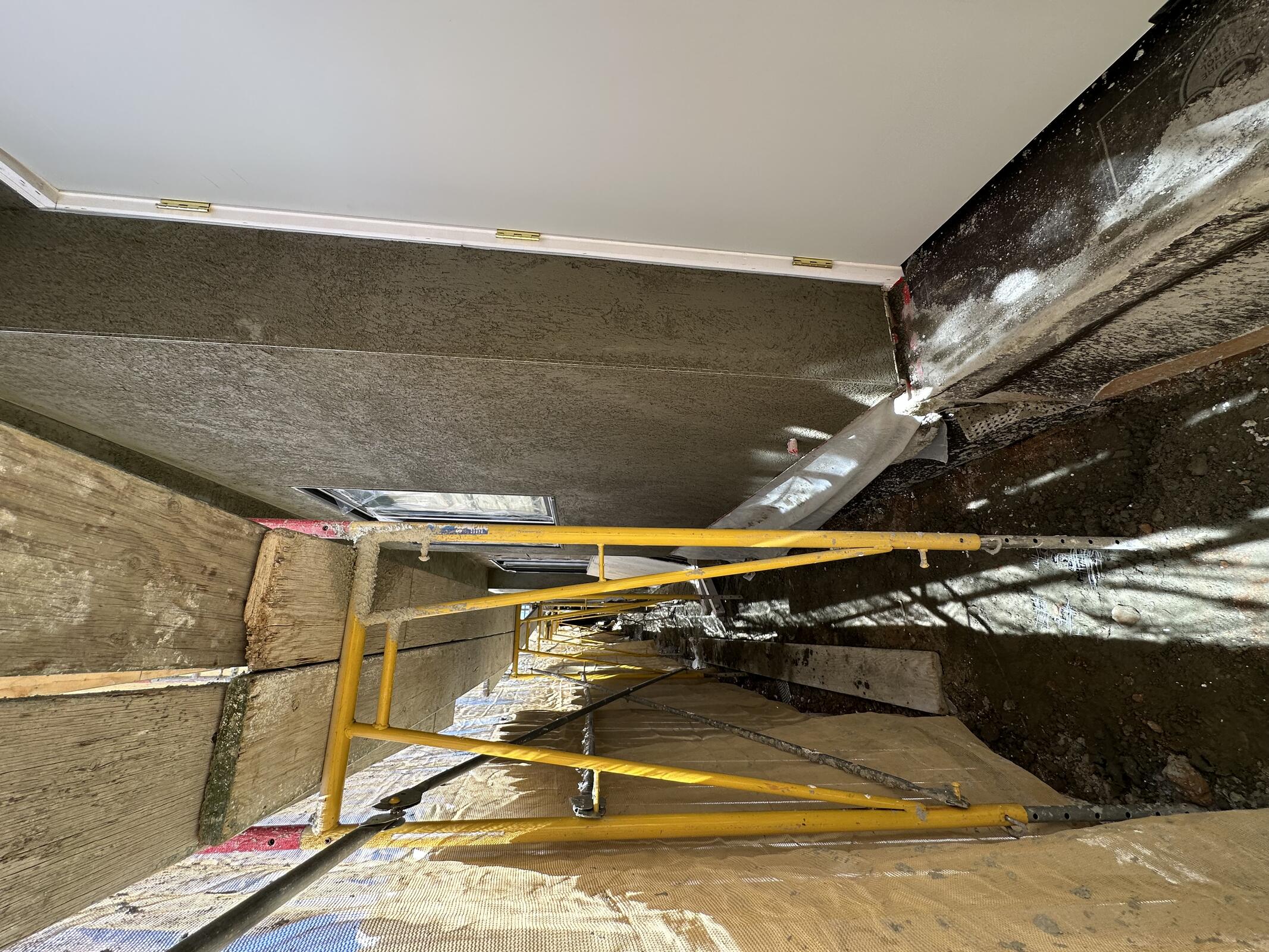

Marq shooting cement at B and C.

ZSP (Adrian) prepping for inspection and centering shower valves/head.

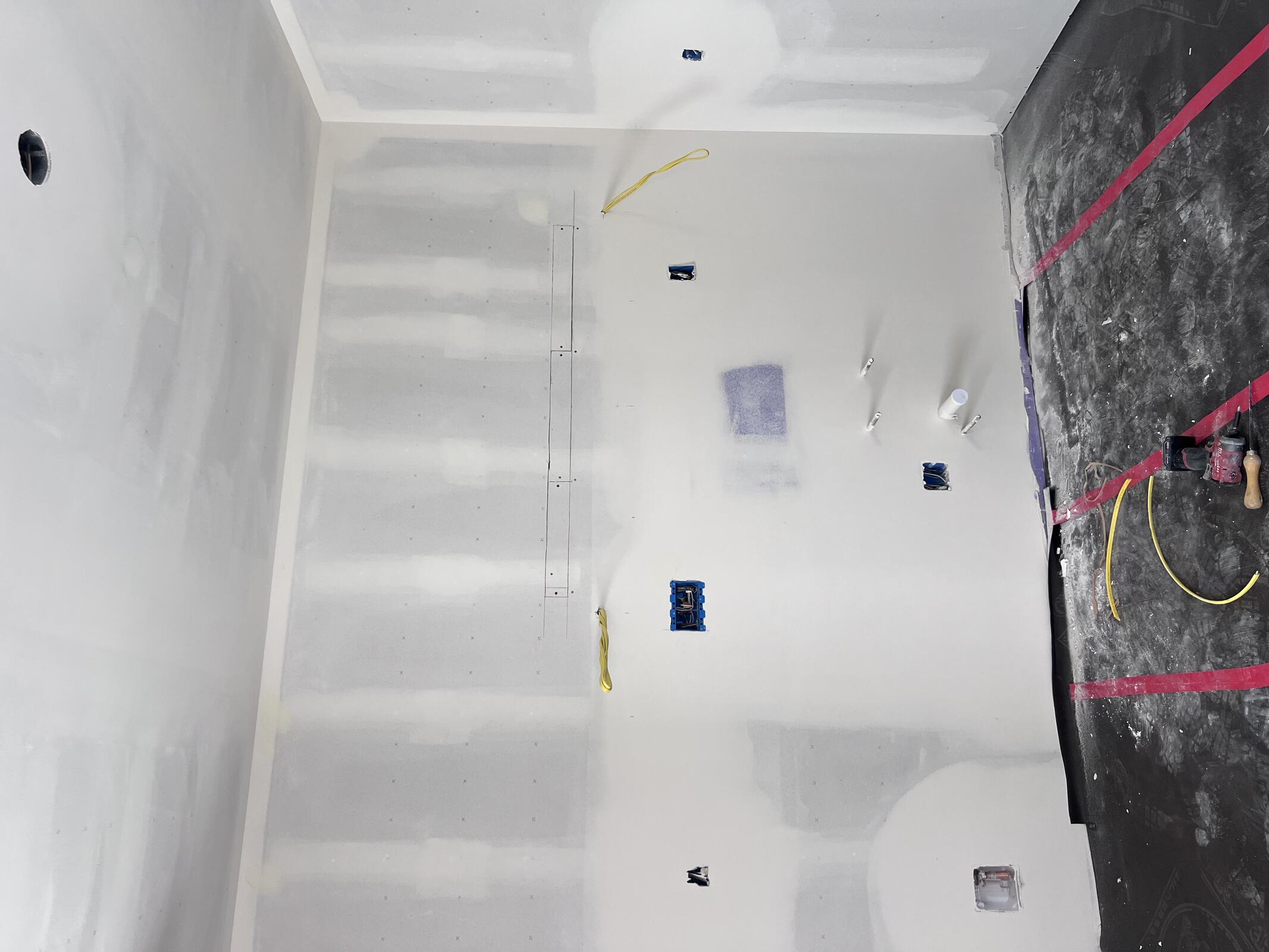

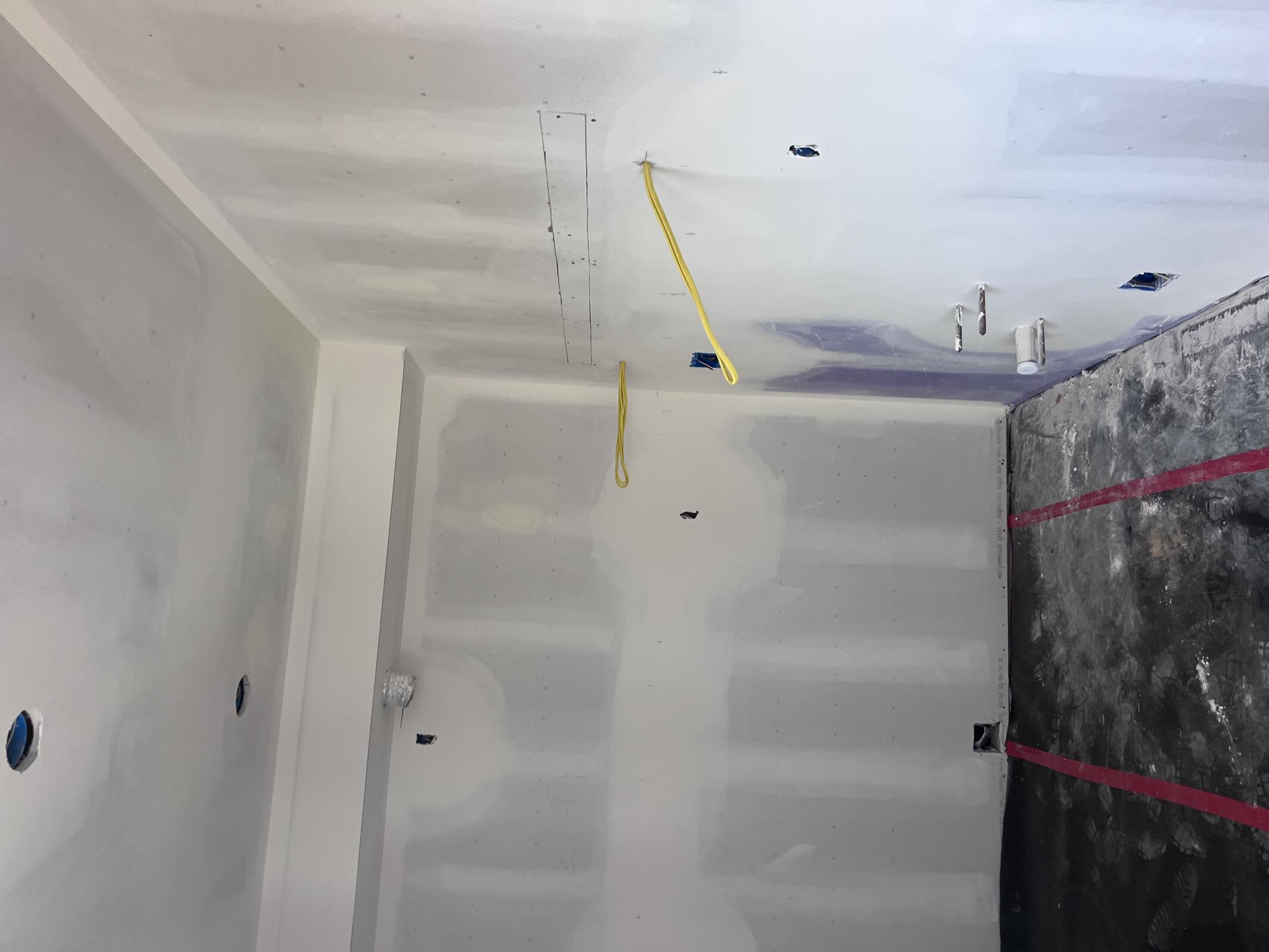

JBG finished shearing and furring out walls after inspection.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
Marq9872
Coastal2816

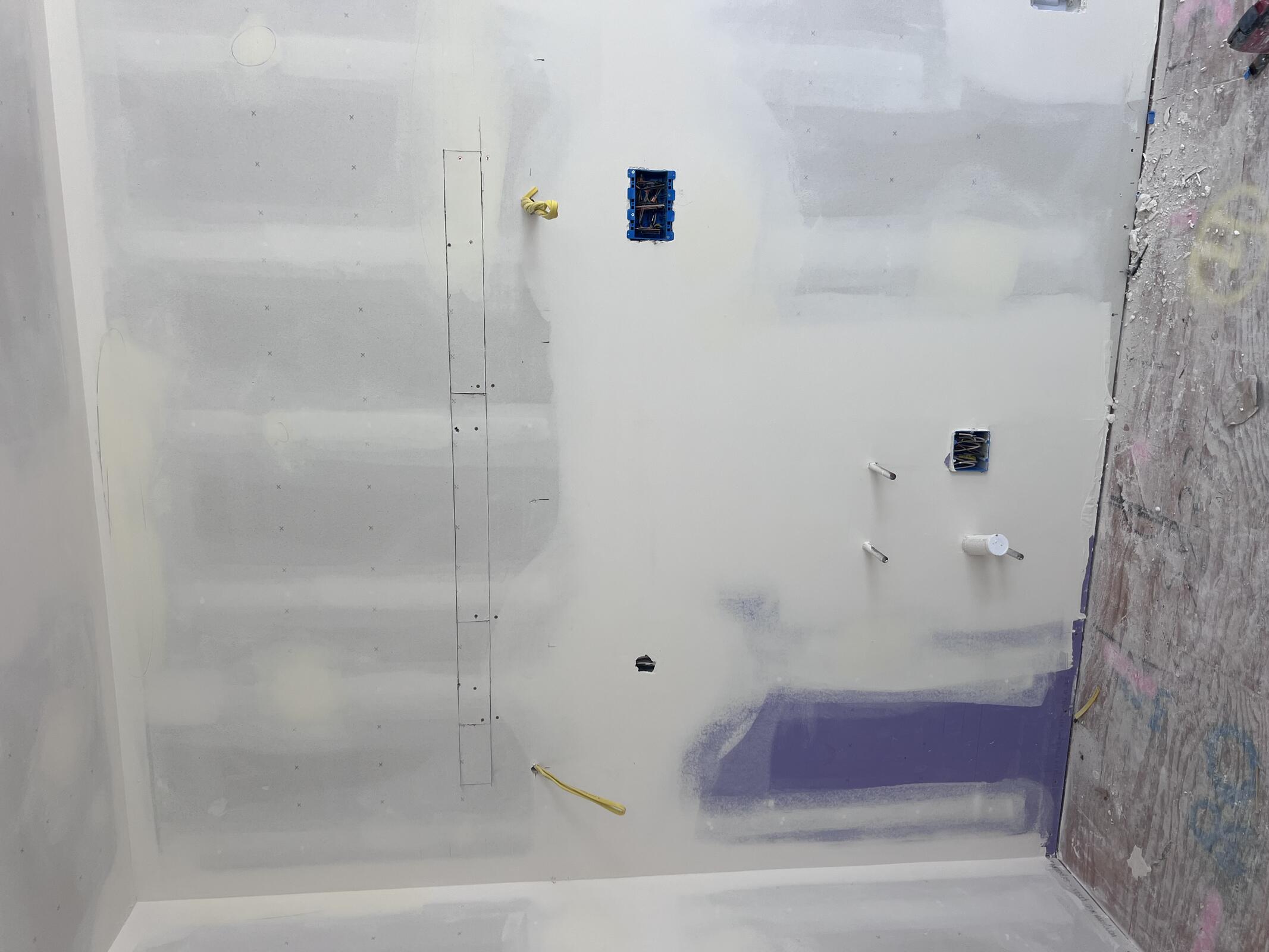

ZSPJBG124448

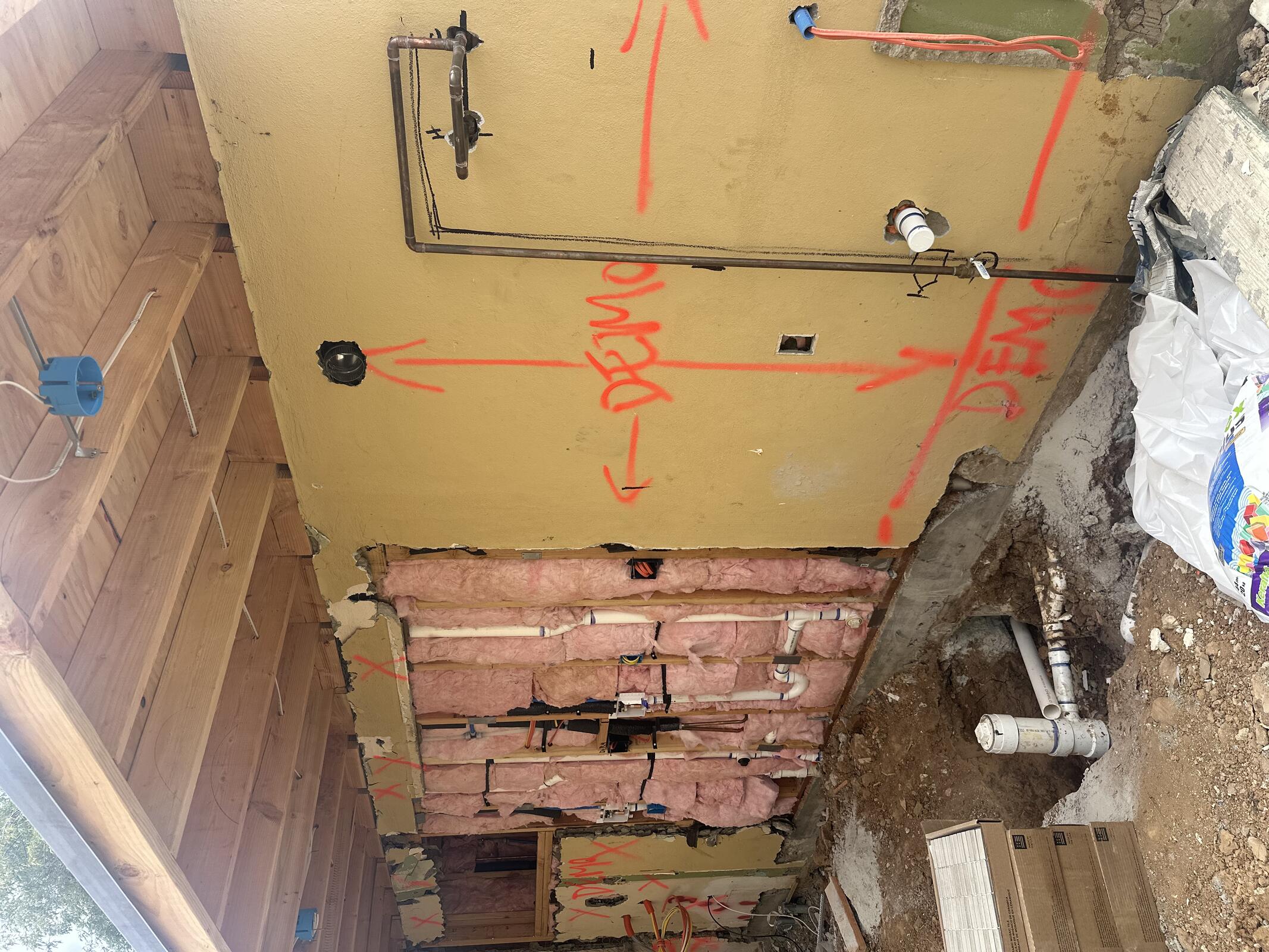

Inspection: Jim, city inspector (619-990-3772) on site at 10:00 AM to inspect garage MEP rough-in and insulation. Passed both. Only comment was to reverse direction of the bathroom fart fan and exhaust towards the parking area. Exhaust fans must have clearance from operable windows.

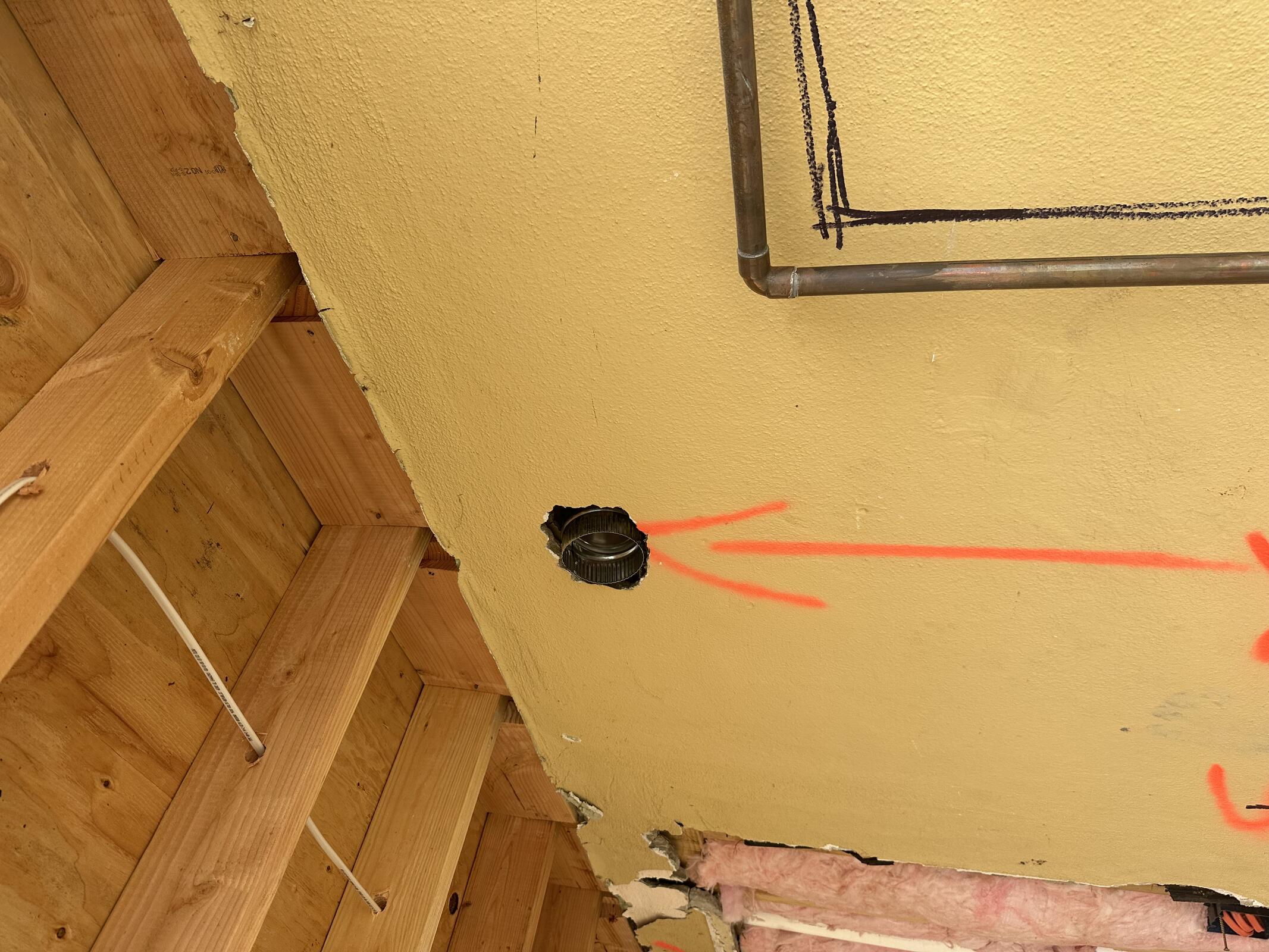

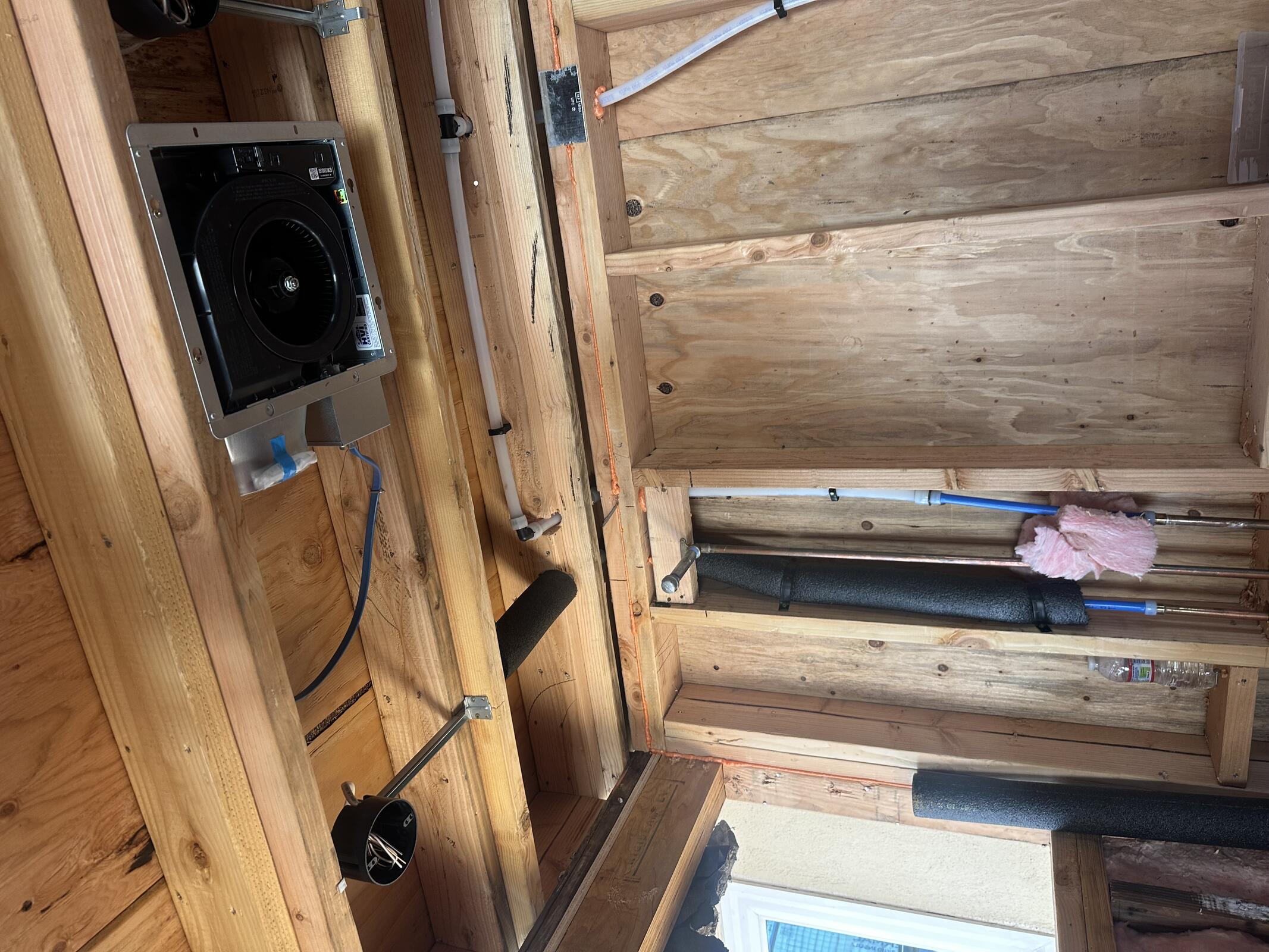

AC Electric fixed fan orientation.

Wednesday, June 03, 2026

Clear, 69°F

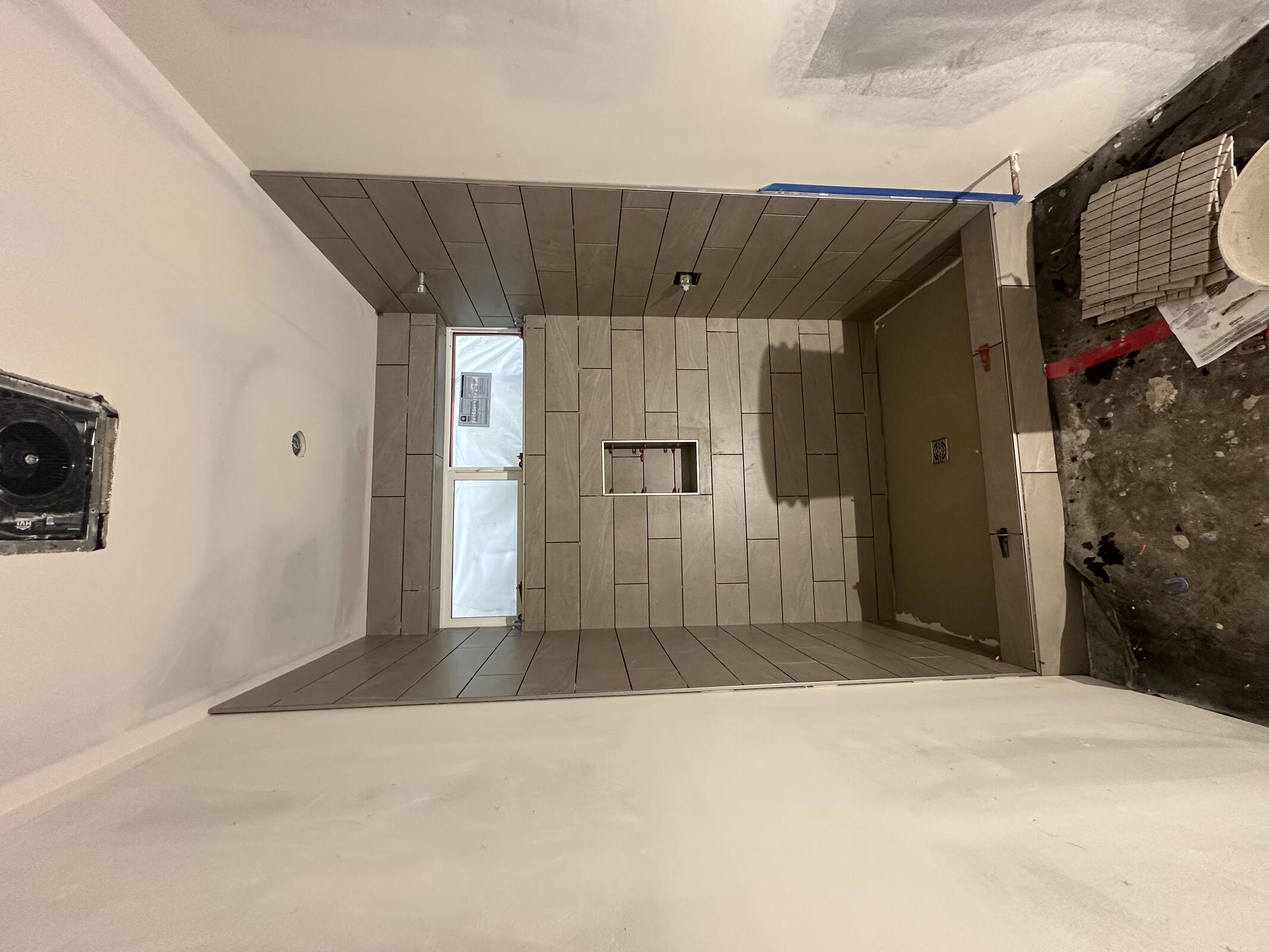

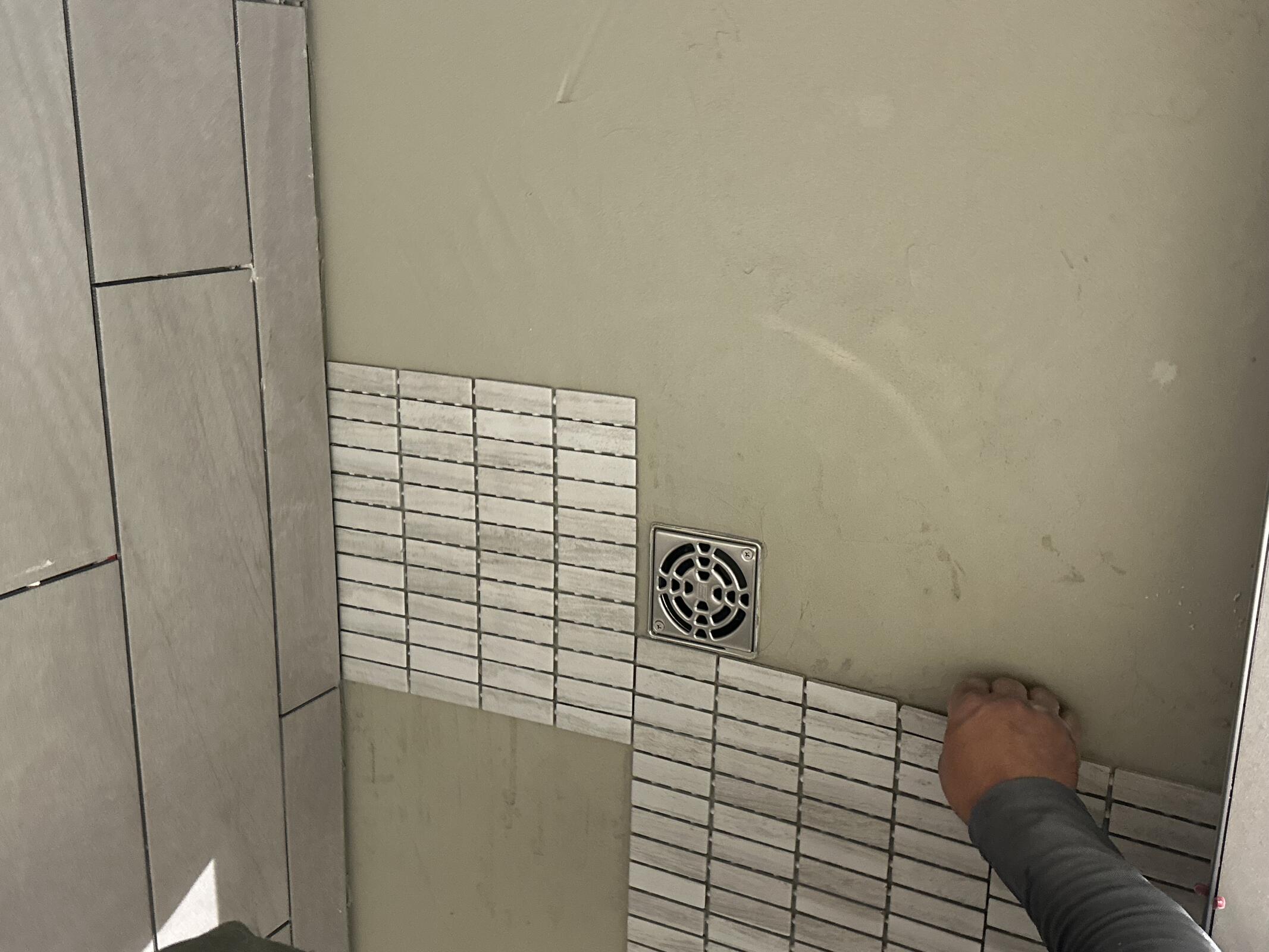

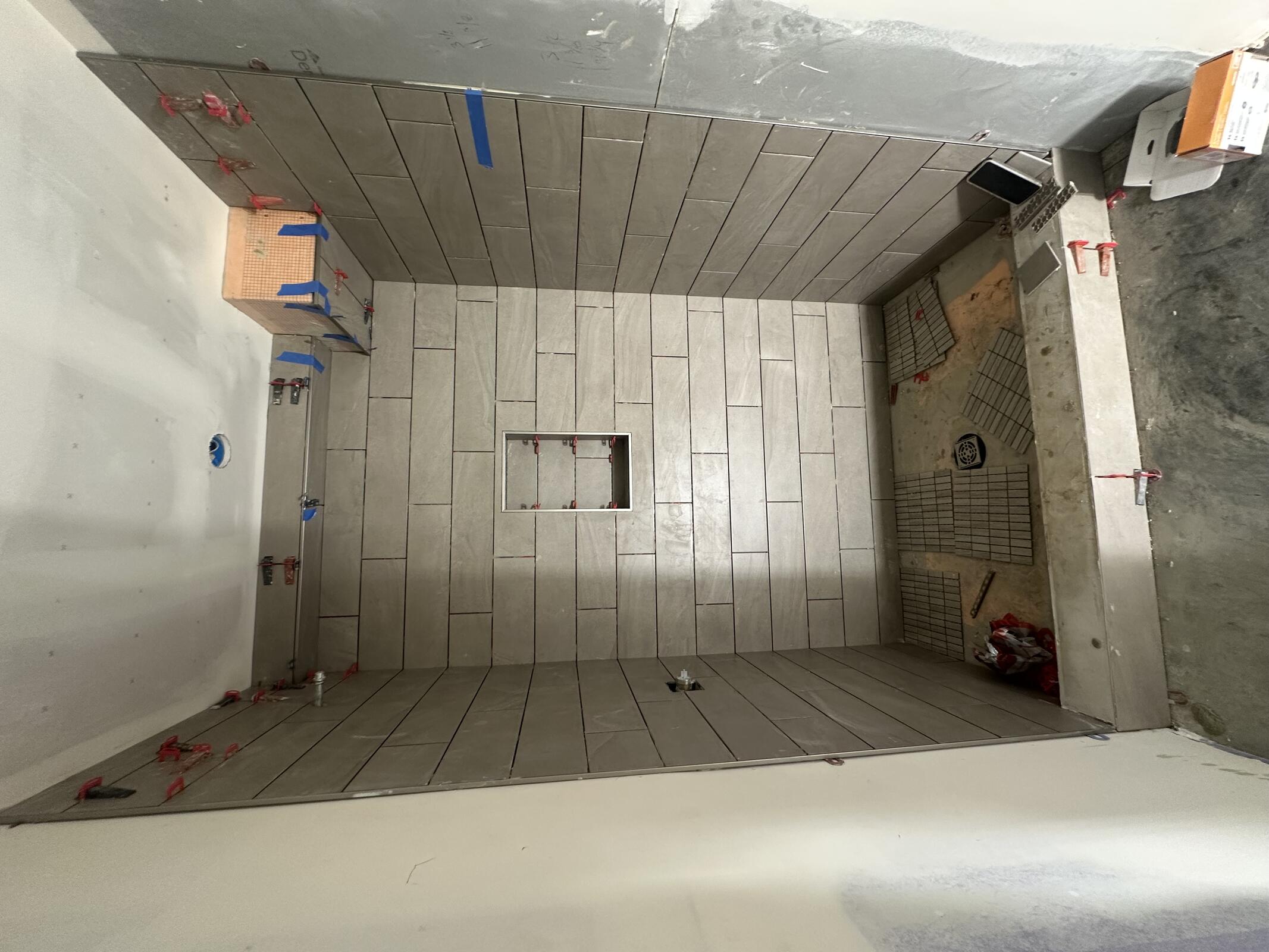

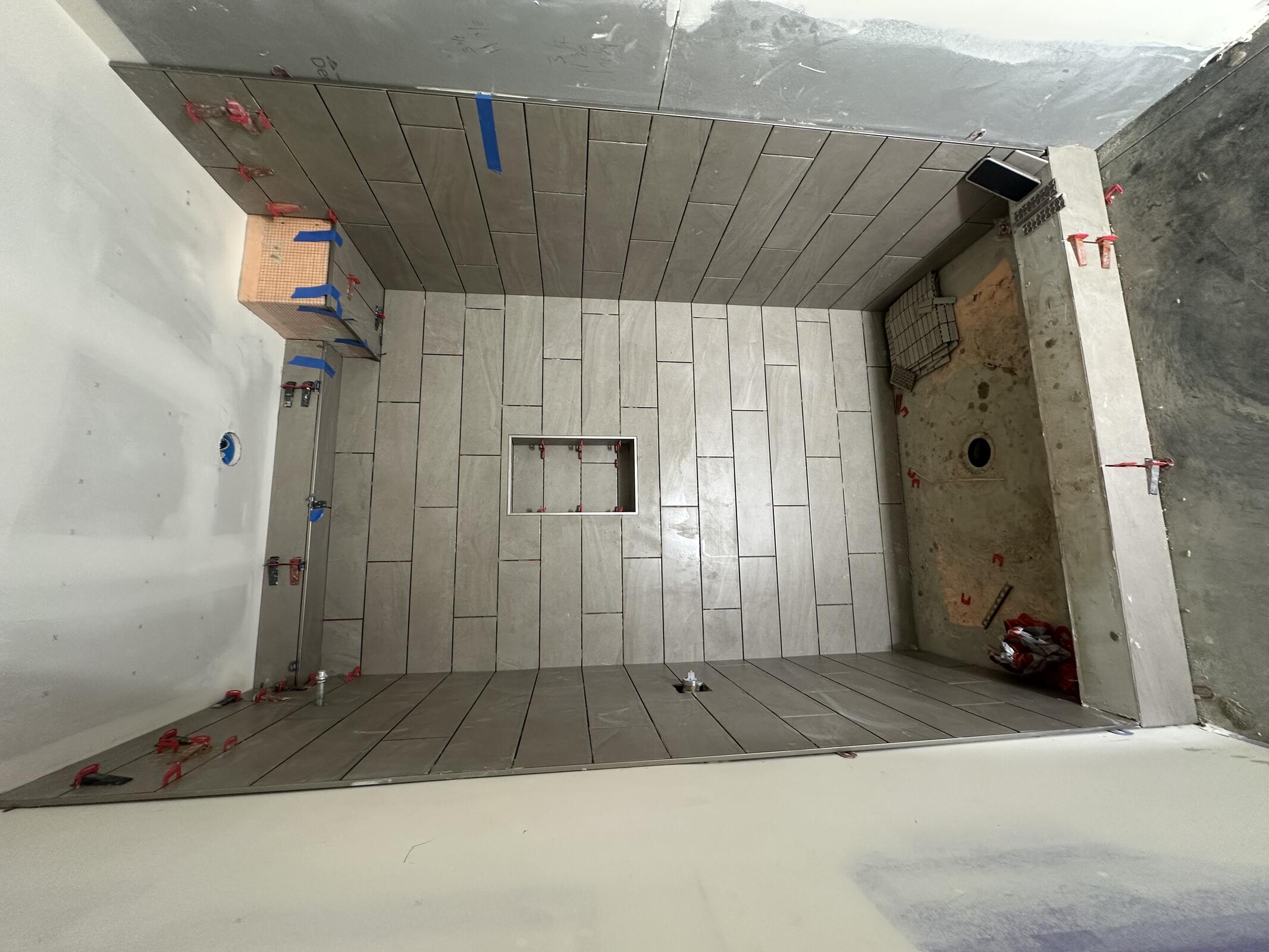

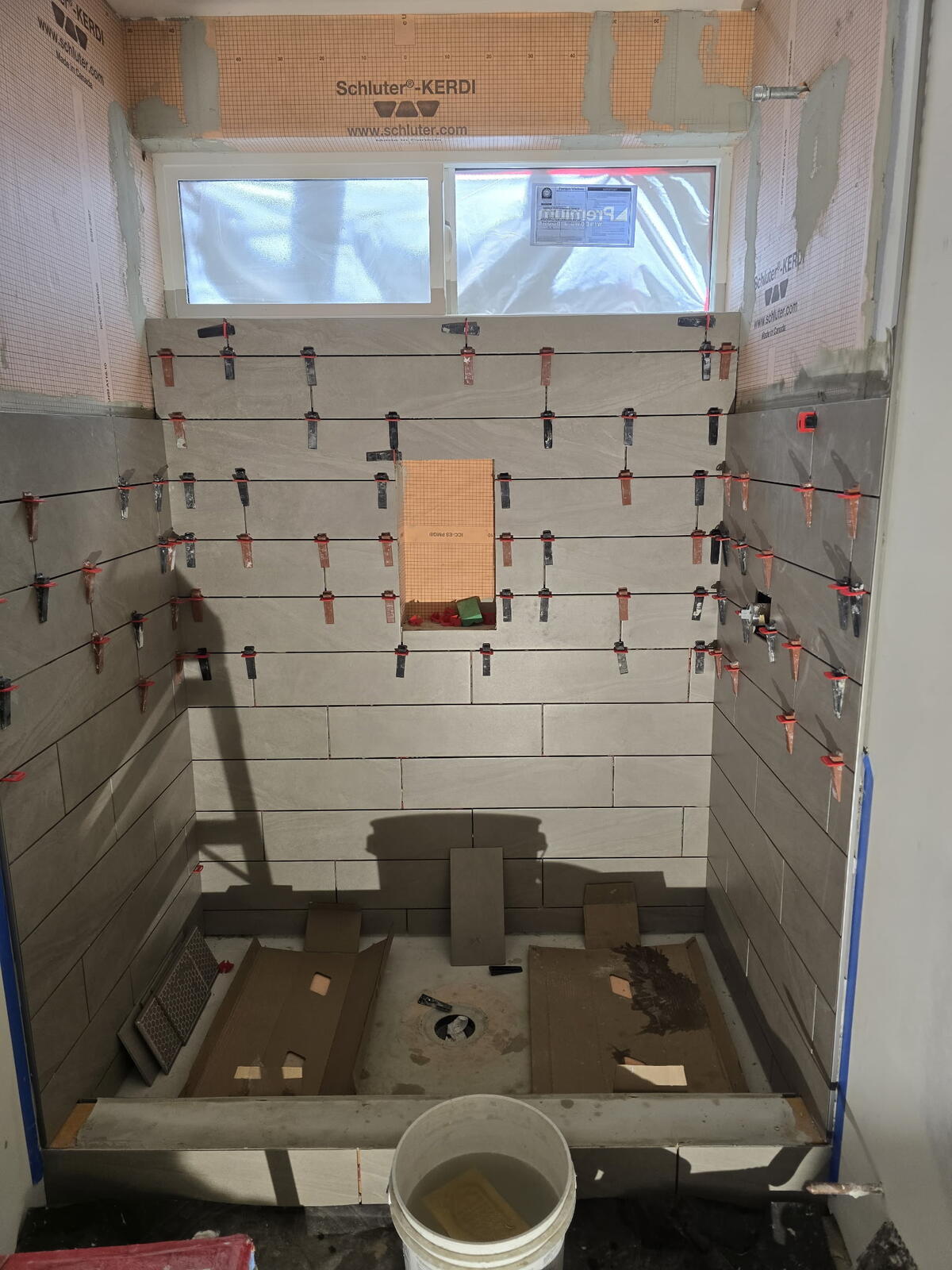

Coastal installing wall tile at B1 and C1 showers. Targeting 6/5 completion date for first floor showers.

Nick (Clear HVAC) on site to confirm what material is needed to complete garage conversion ducting.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
Coastal2816

Inspection: N/A

Thursday, June 04, 2026

Clear, 71°F

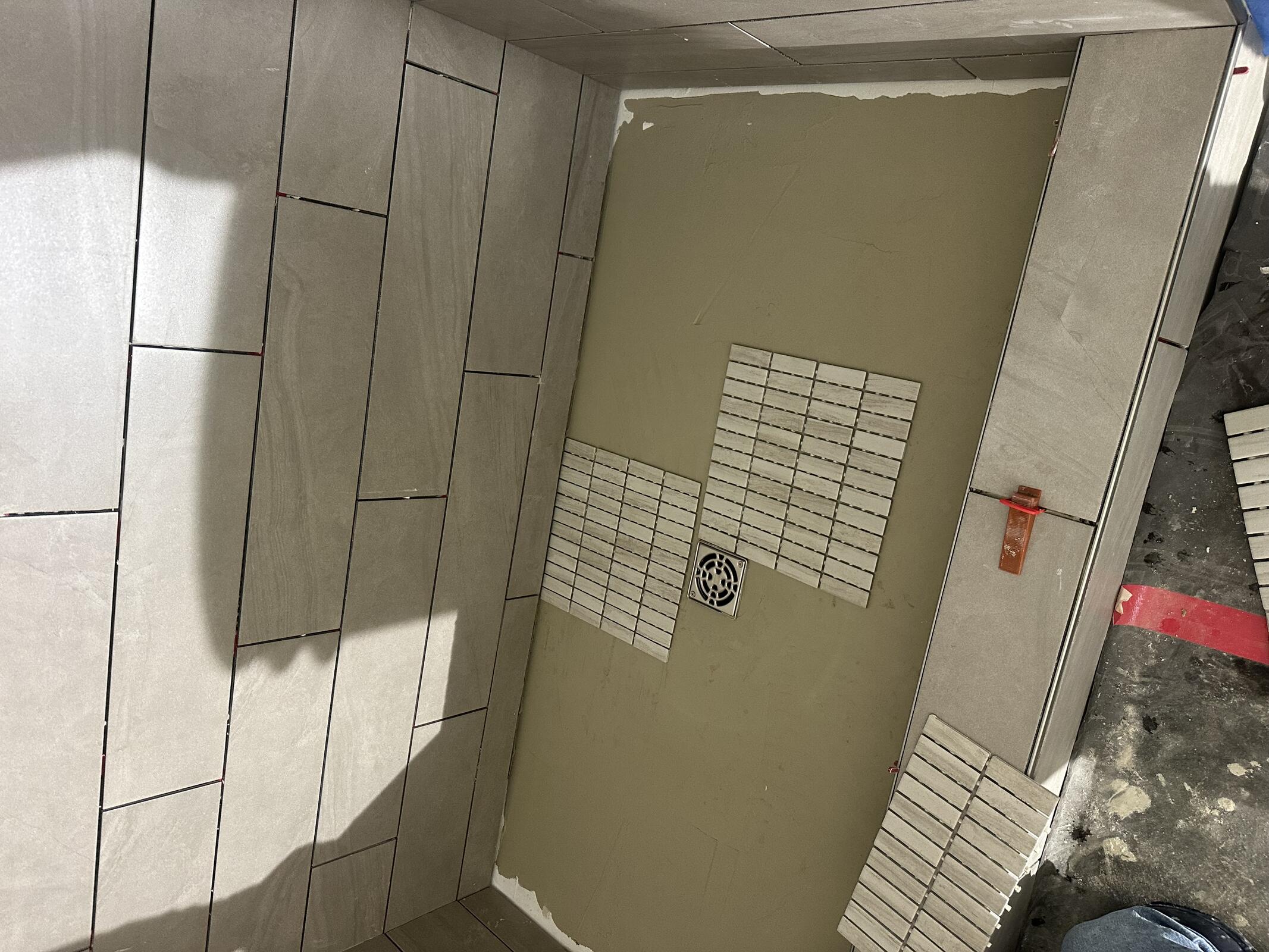

Coastal continuing to install tile at B1 and C1 showers.

AC Electric wiring in missed under cabinet lights. TDI to mud and sand patches when drywall at garage is installed.

Marq powerwashing and masking to prepare for colorcoat.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
Coastal2816
AC Electric144
Marq2816

Inspection: N/A

Friday, June 05, 2026

Overcast, 64°F

Marq picking up quality control patching and preparing for color coat.

Coastal finishing wall tile at B1/C1. Grouting on saturday. Discussed floor tile layout with Paige. Decided to do whatever required less cuts and would be the most waterproof.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
Coastal2816
Marq188

Inspection: N/A
