Week 22 of 34

Week of May 18 — May 22, 2026

5 days on site. 65 photos. DFH, Demolition, Drywall, Electric, Framing, Insulation, Tile, Traffic Coating.

May 18, 2026May 22, 20265 days65 photos
DFHDemolitionDrywallElectricFramingInsulationTileTraffic Coating

Monday, May 18, 2026

Partially cloudy, 67°F

JB General fixing stair framing. Demo of garage wall and roof complete. Garage framing in progress.

AC Electric installing ATT weather head.

TDI finishing soffit at Building C and sanding.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
AC Electric248
JB General4832

Inspection: N/A

Tuesday, May 19, 2026

Partially cloudy, 72°F

Garage framing in progress. Curb chipped out and new wall erected. Stair repair complete.

TDI finishing sanding and cleaning up site.

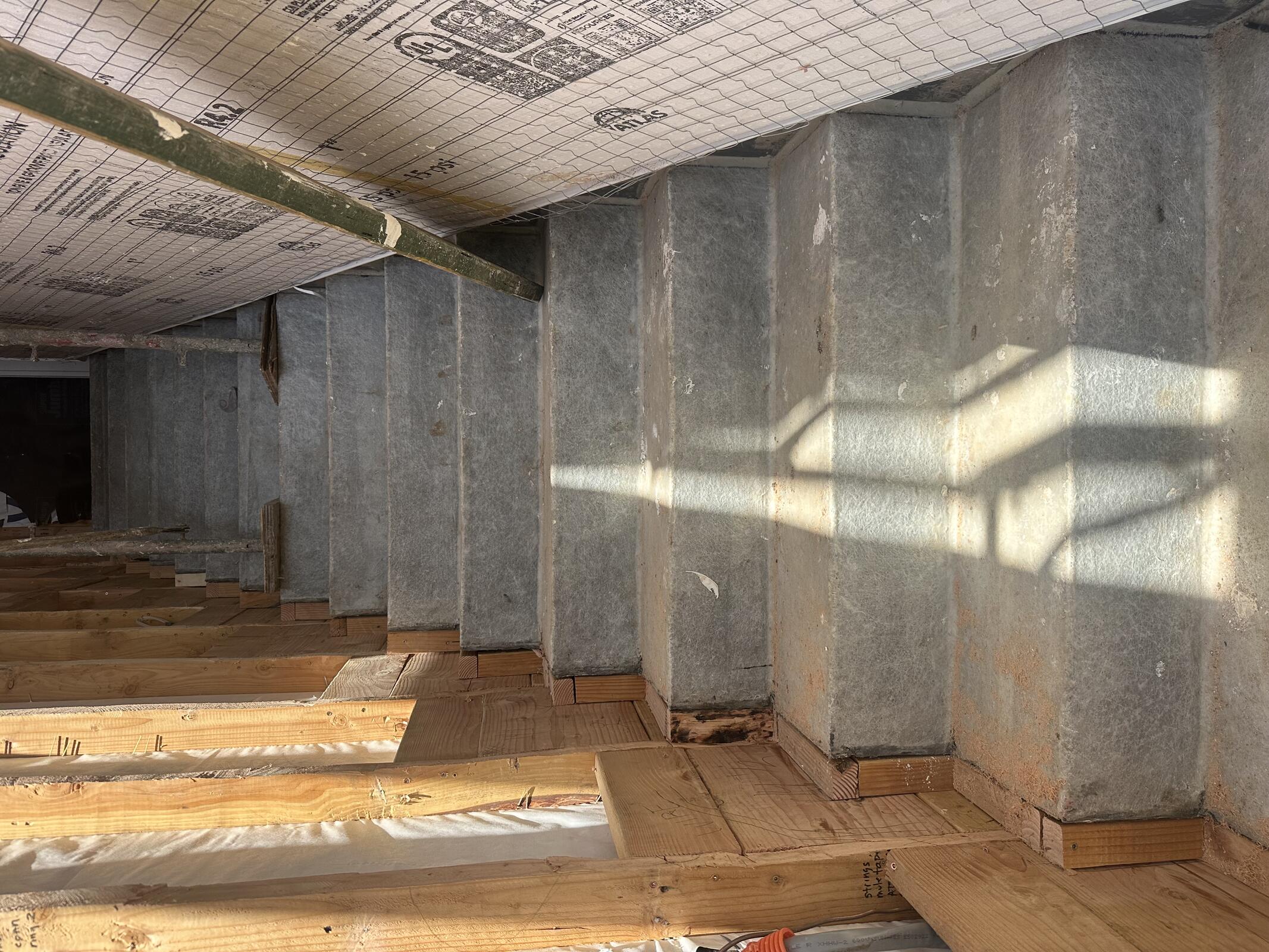

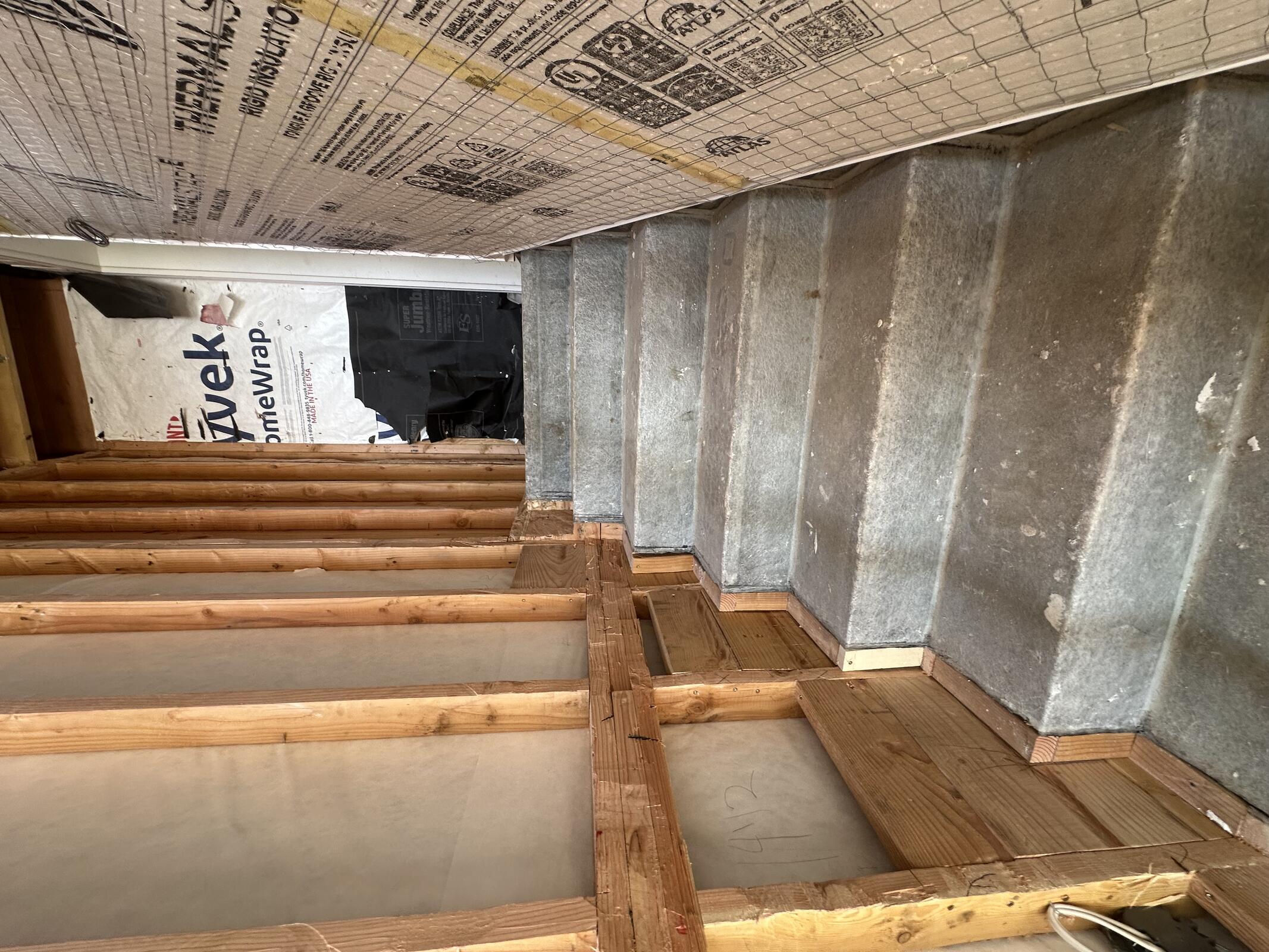

Insulation Labs insulating existing duplex wall.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
JB General6848
TDI188
Insulation Labs224

Inspection: N/A

Wednesday, May 20, 2026

Clear, 72°F

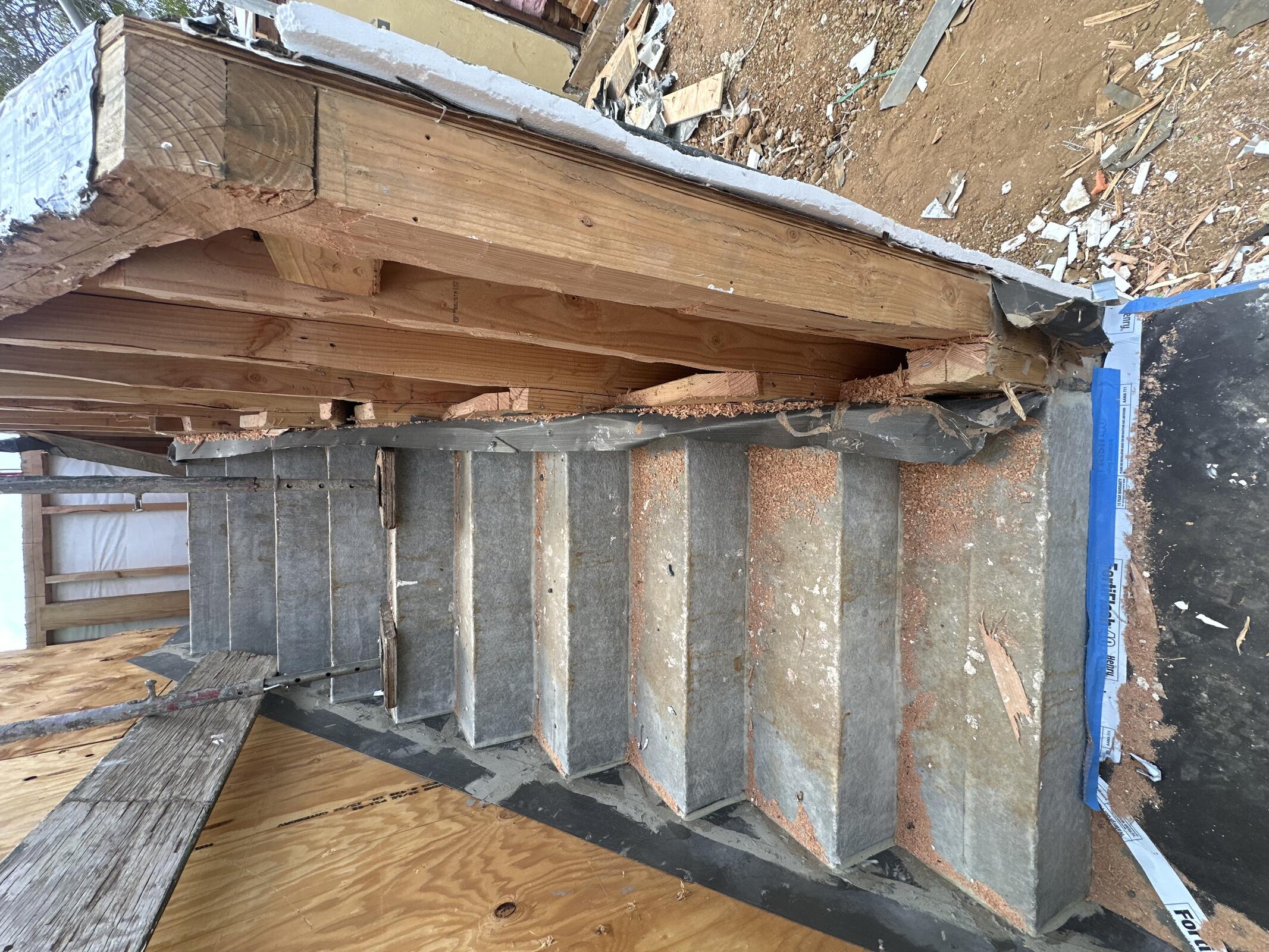

Stair correction completed. Ready for waterproofing.

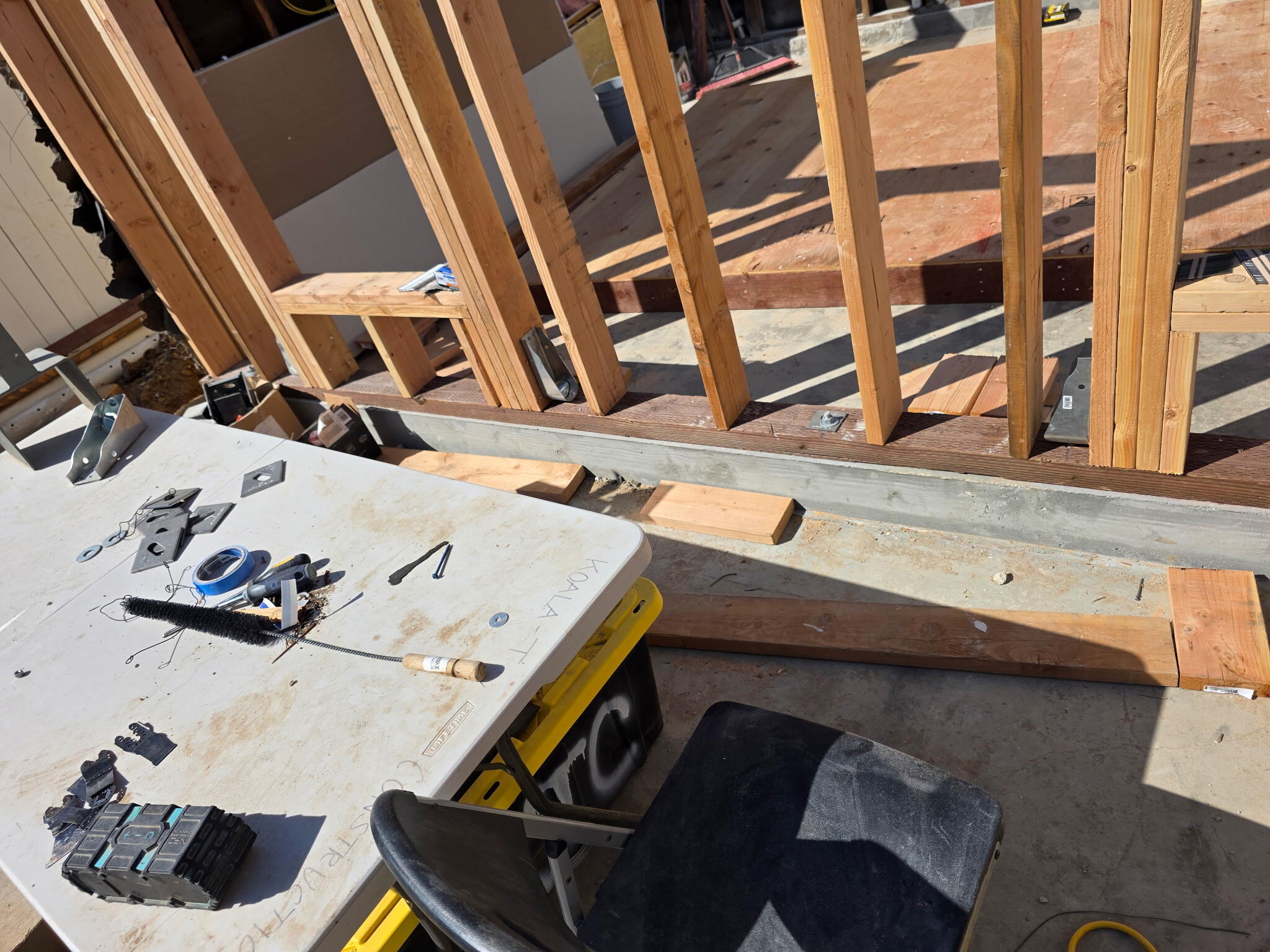

Existing duplex wall at garage conversion interface completed. Interior walls erected. Joists being ripped and prepped for installation. Curb at new entry door being chipped out.

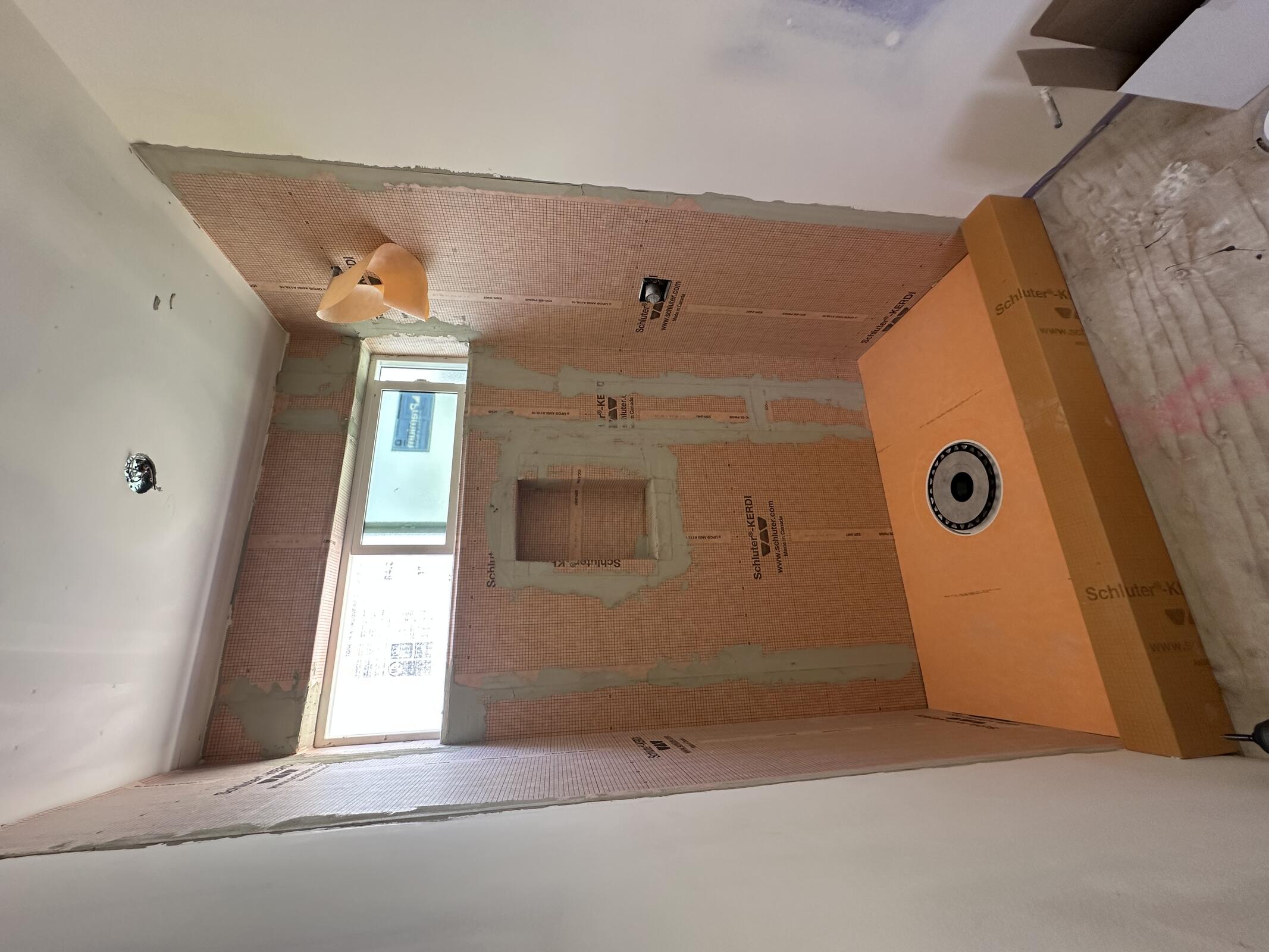

Shower waterproofing in progress.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
JB General4.5836
Coastal188

Inspection: N/A

Thursday, May 21, 2026

Clear, 68°F

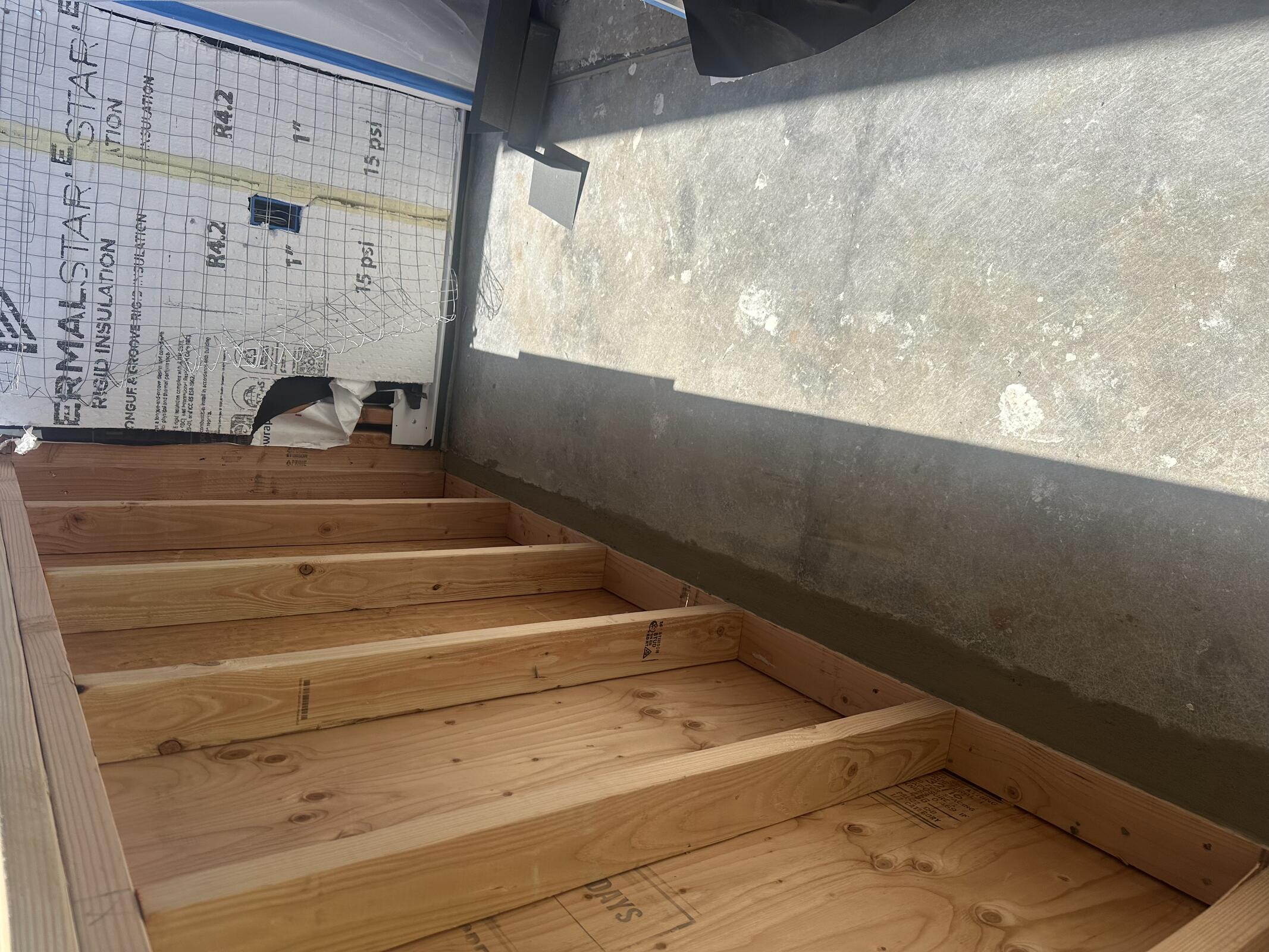

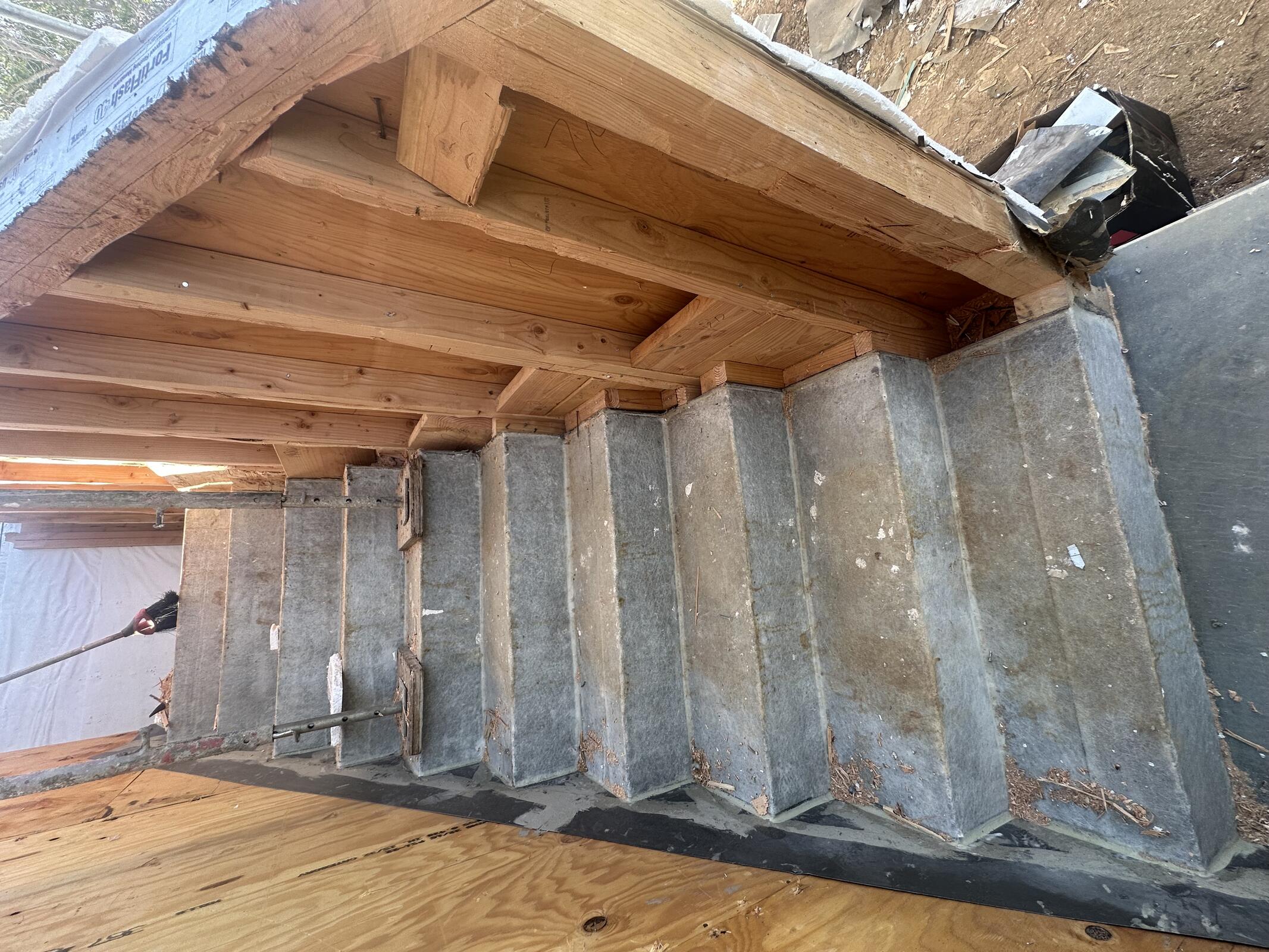

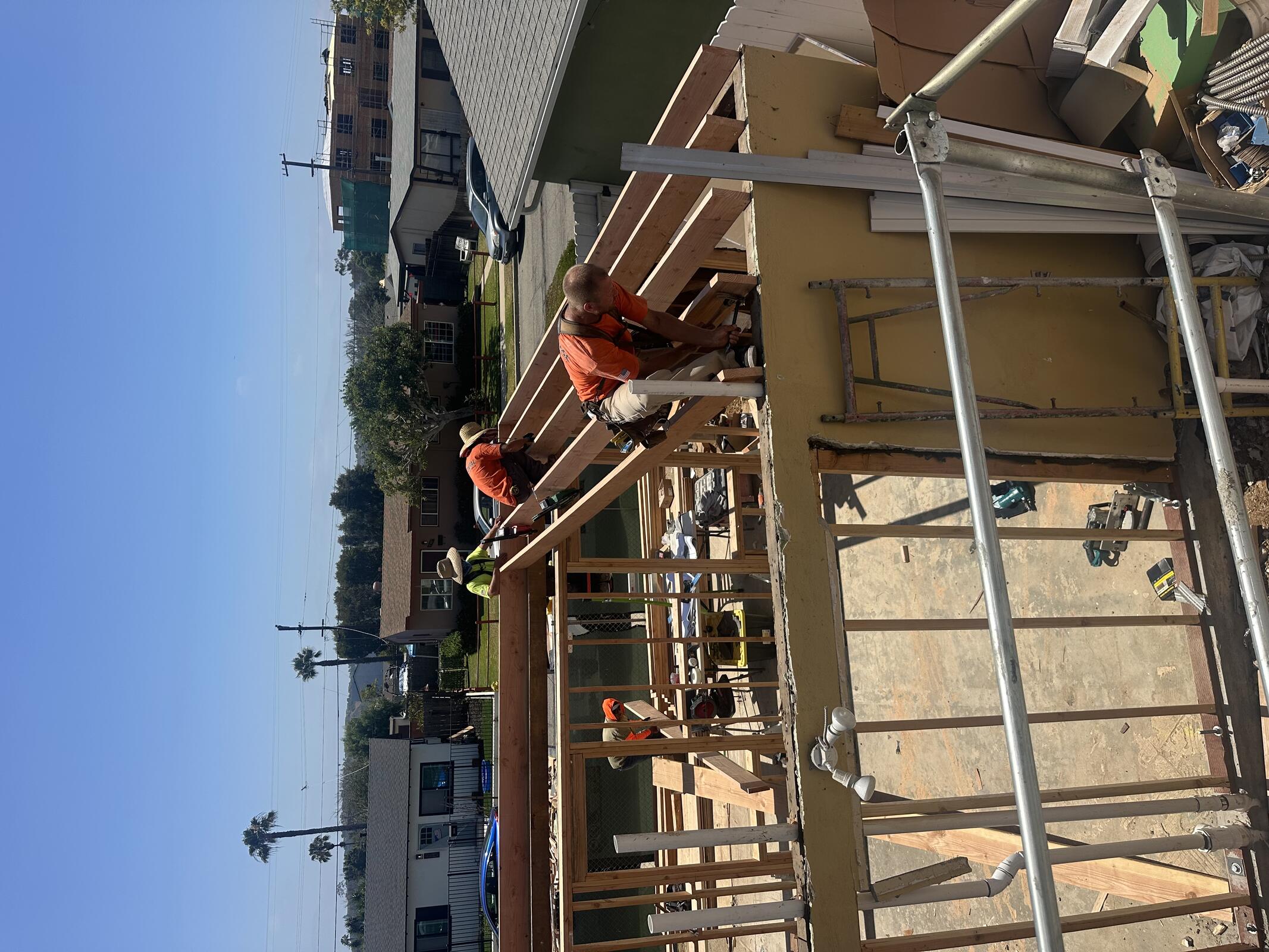

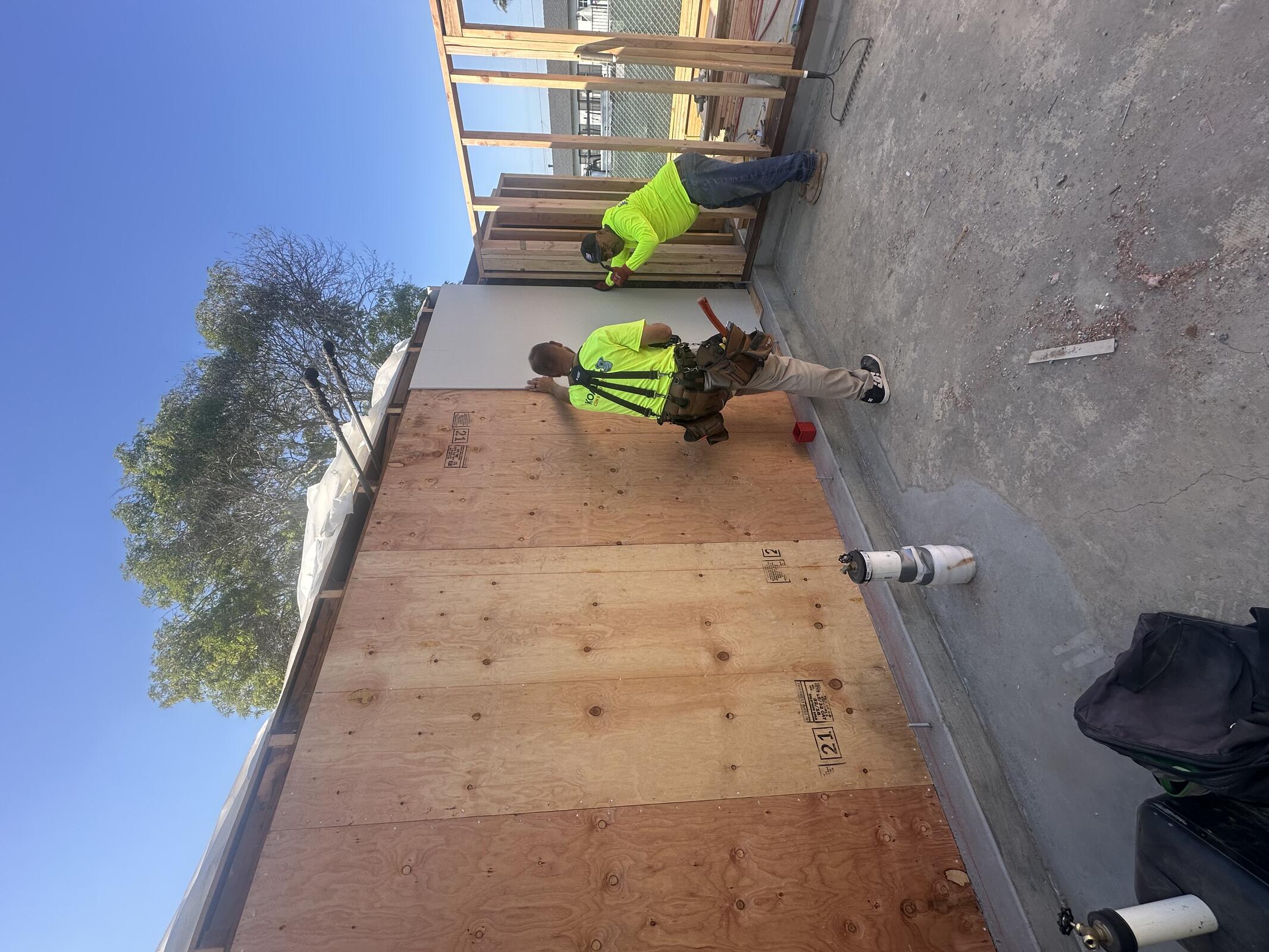

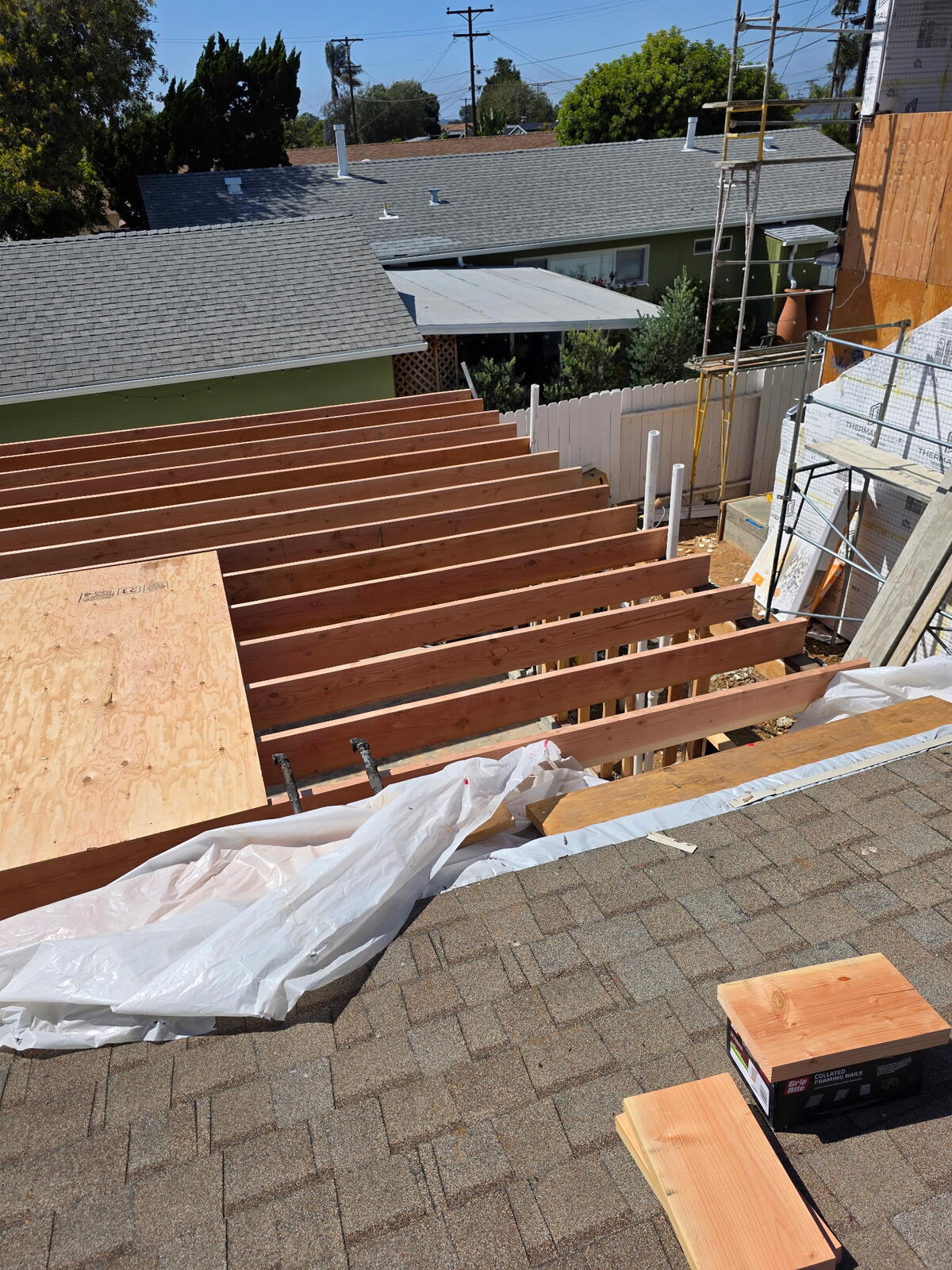

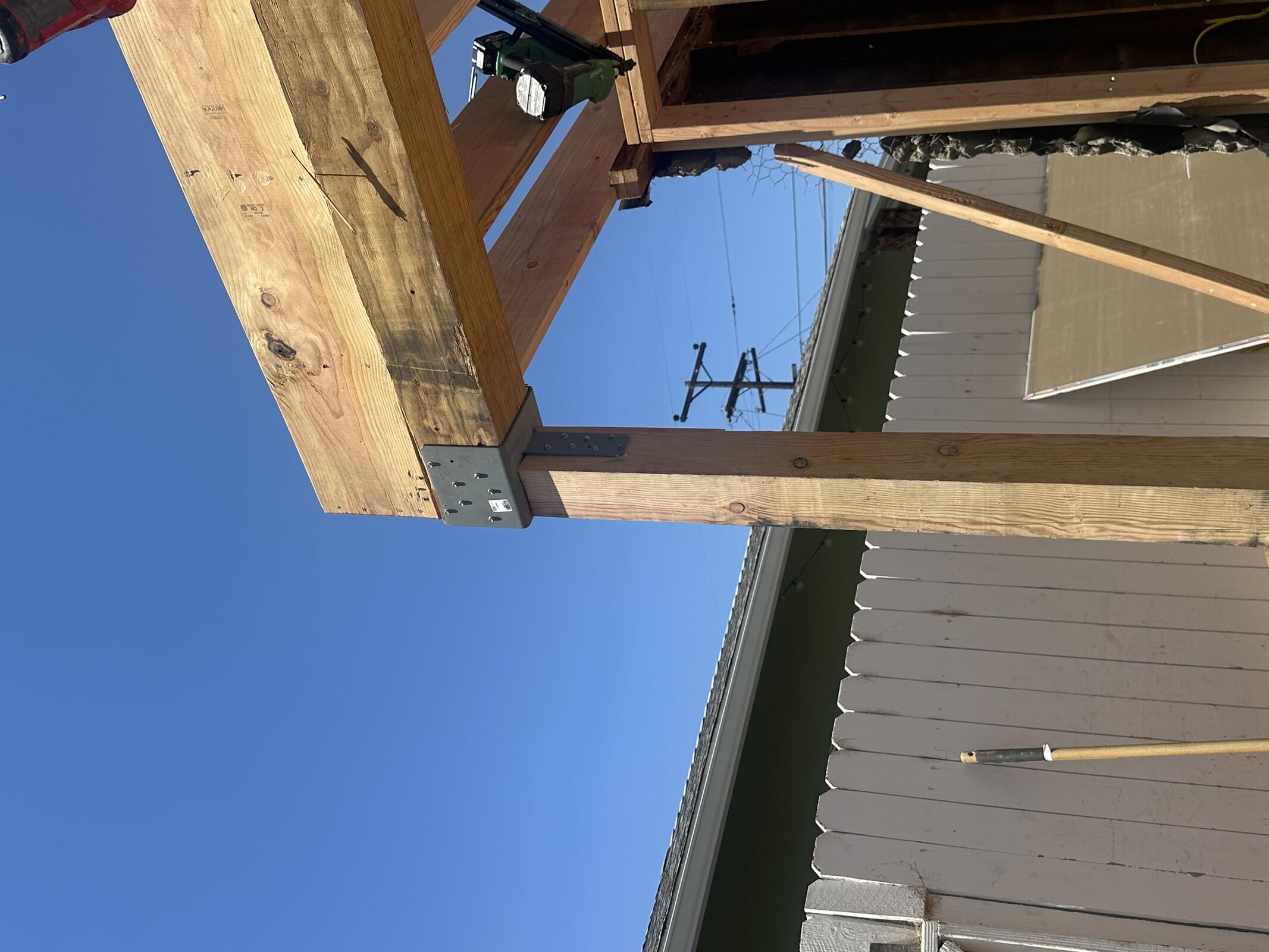

JB General working on garage conversion. Redguarding seismic gaps between garage and existing duplex. Joists installed and roof sheathing started. Blocking of exterior walls completed.

Coastal waterproofing showers.

Rete's patching traffic coating at stairs.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
JB General6848
Coastal2816
Rete's3515

Inspection: N/A

Friday, May 22, 2026

Clear, 69°F

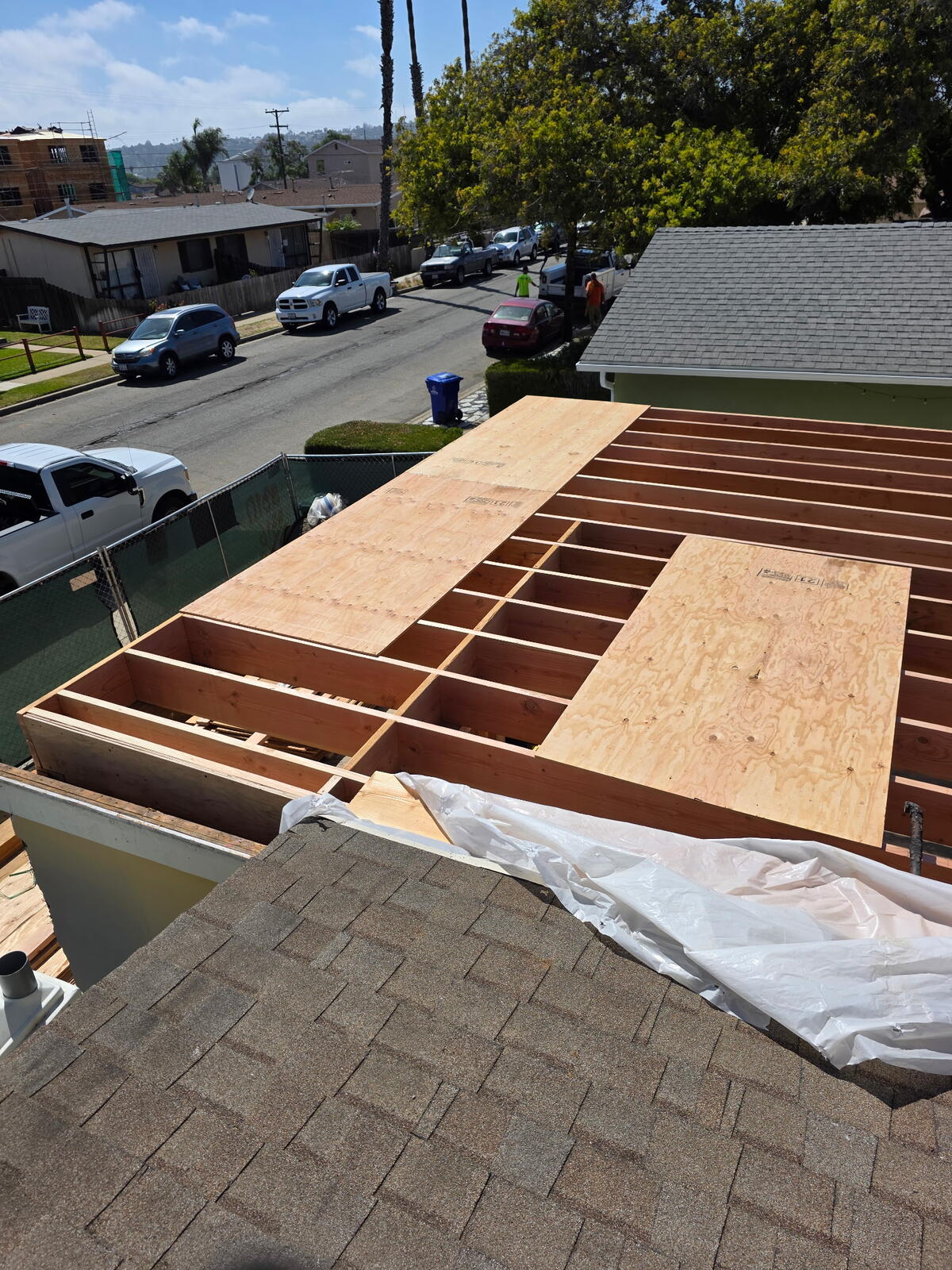

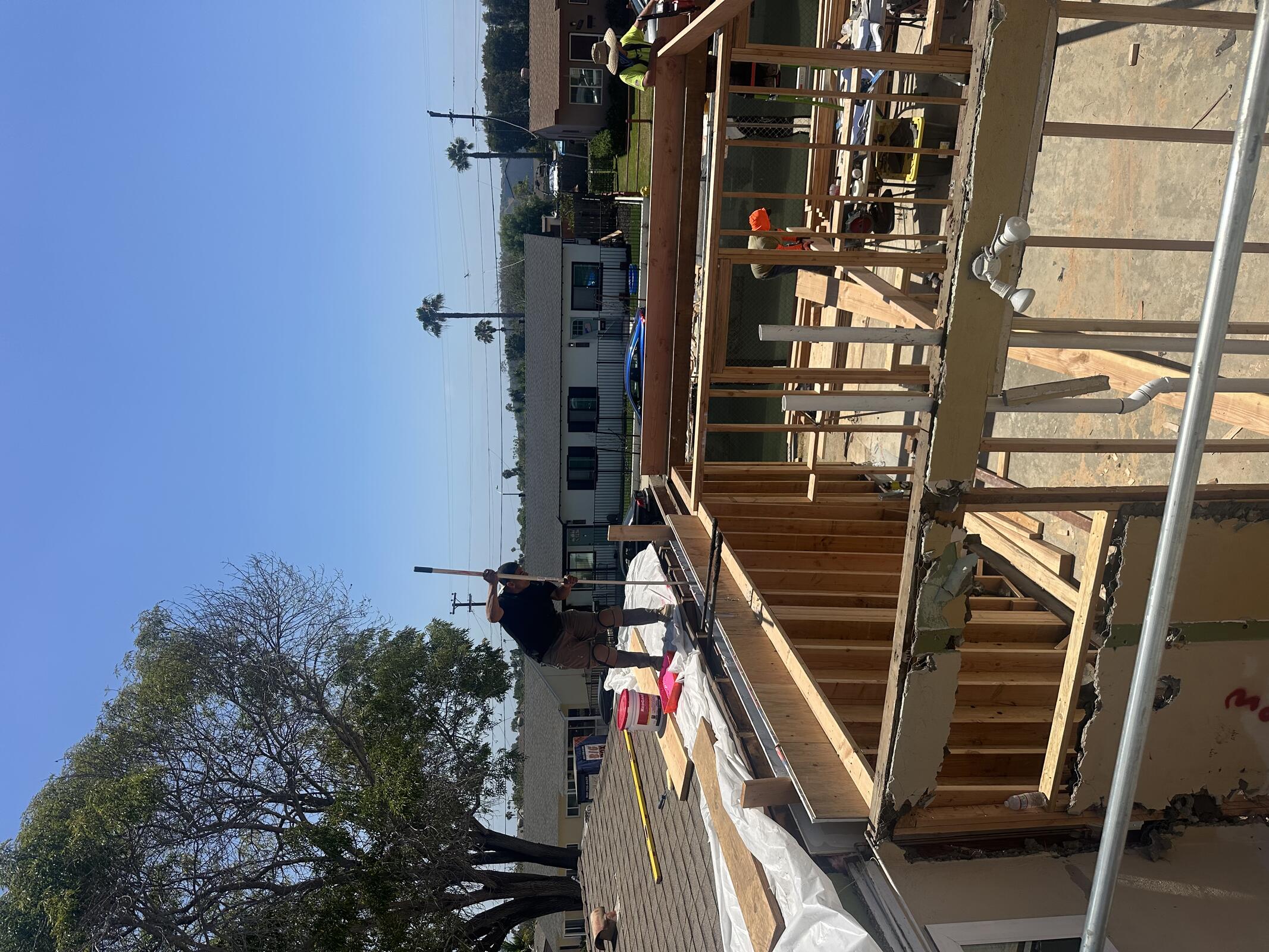

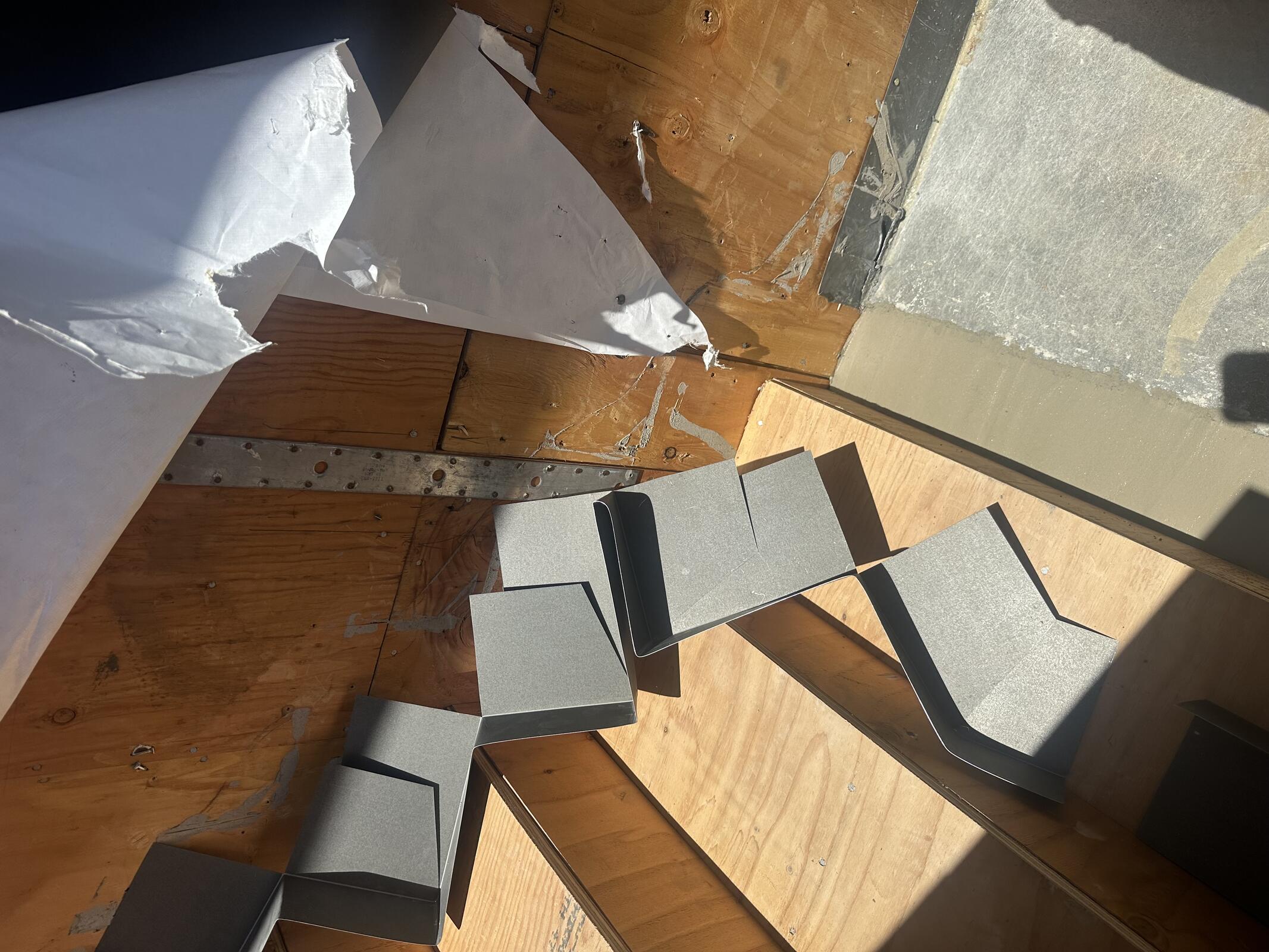

JB General blocking garage walls, installing roof sheathing, and cutting back existing duplex wing wall.

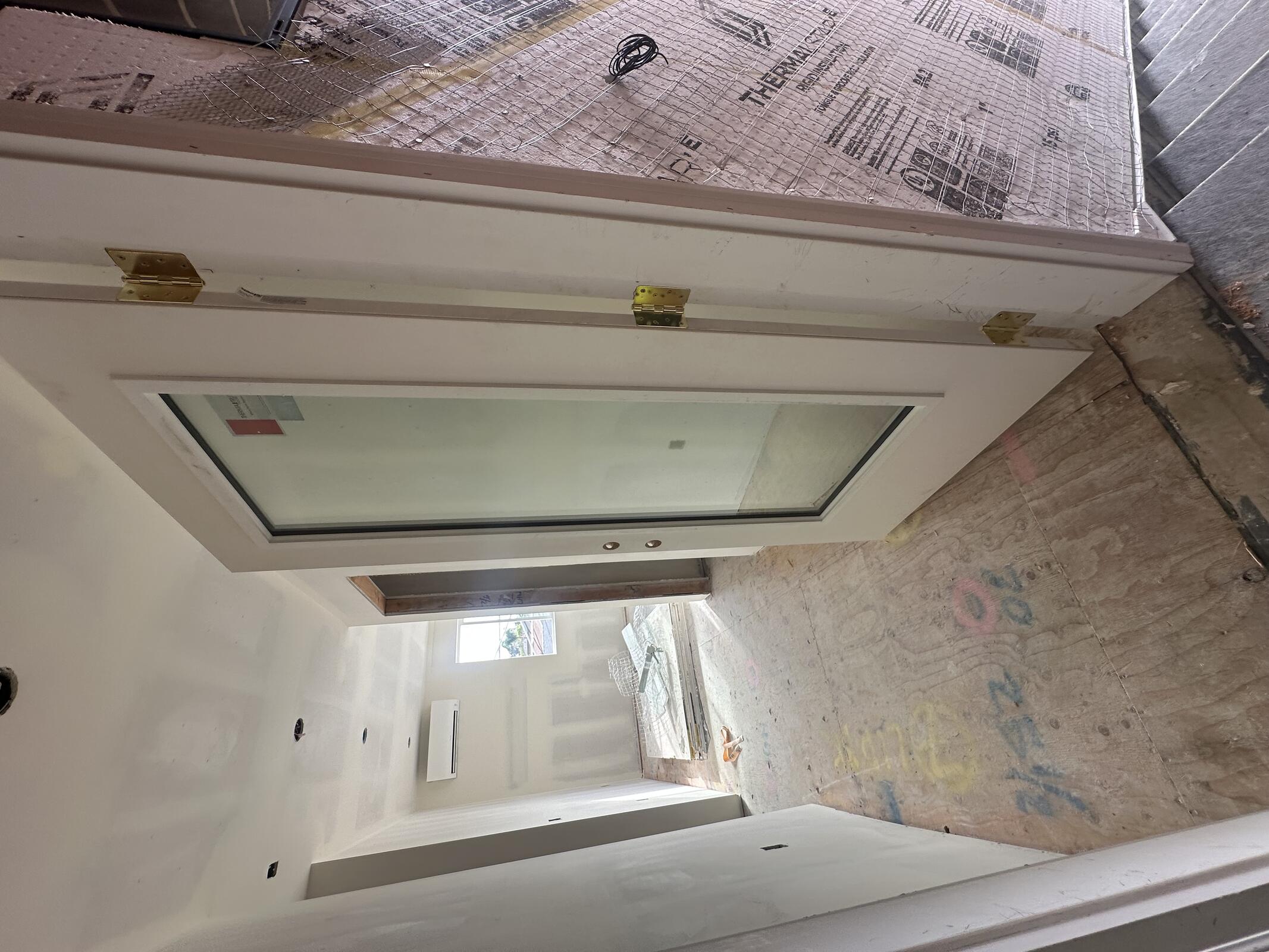

Taylor Trim installing exterior doors at B and C and closet shelf and pole.

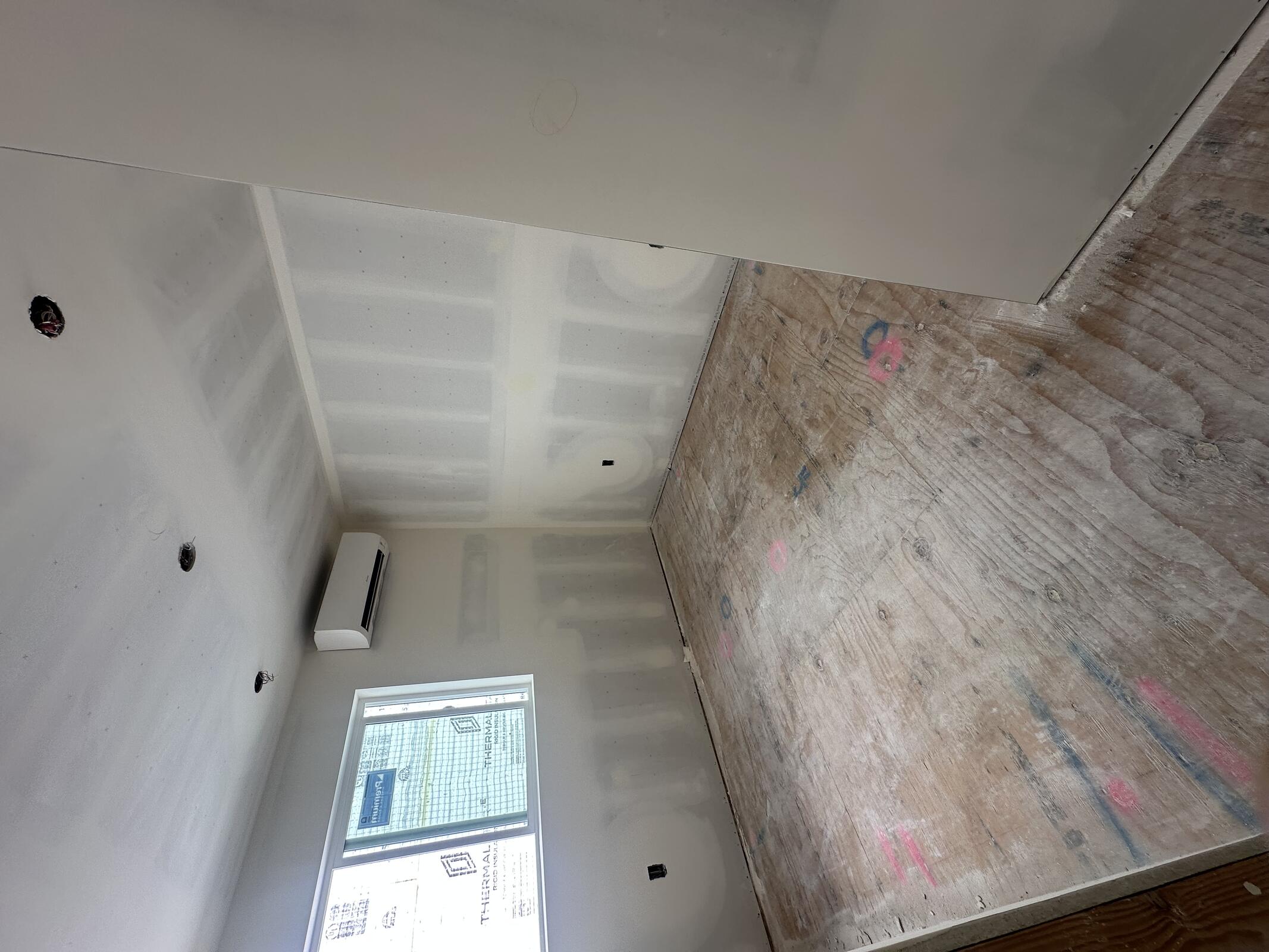

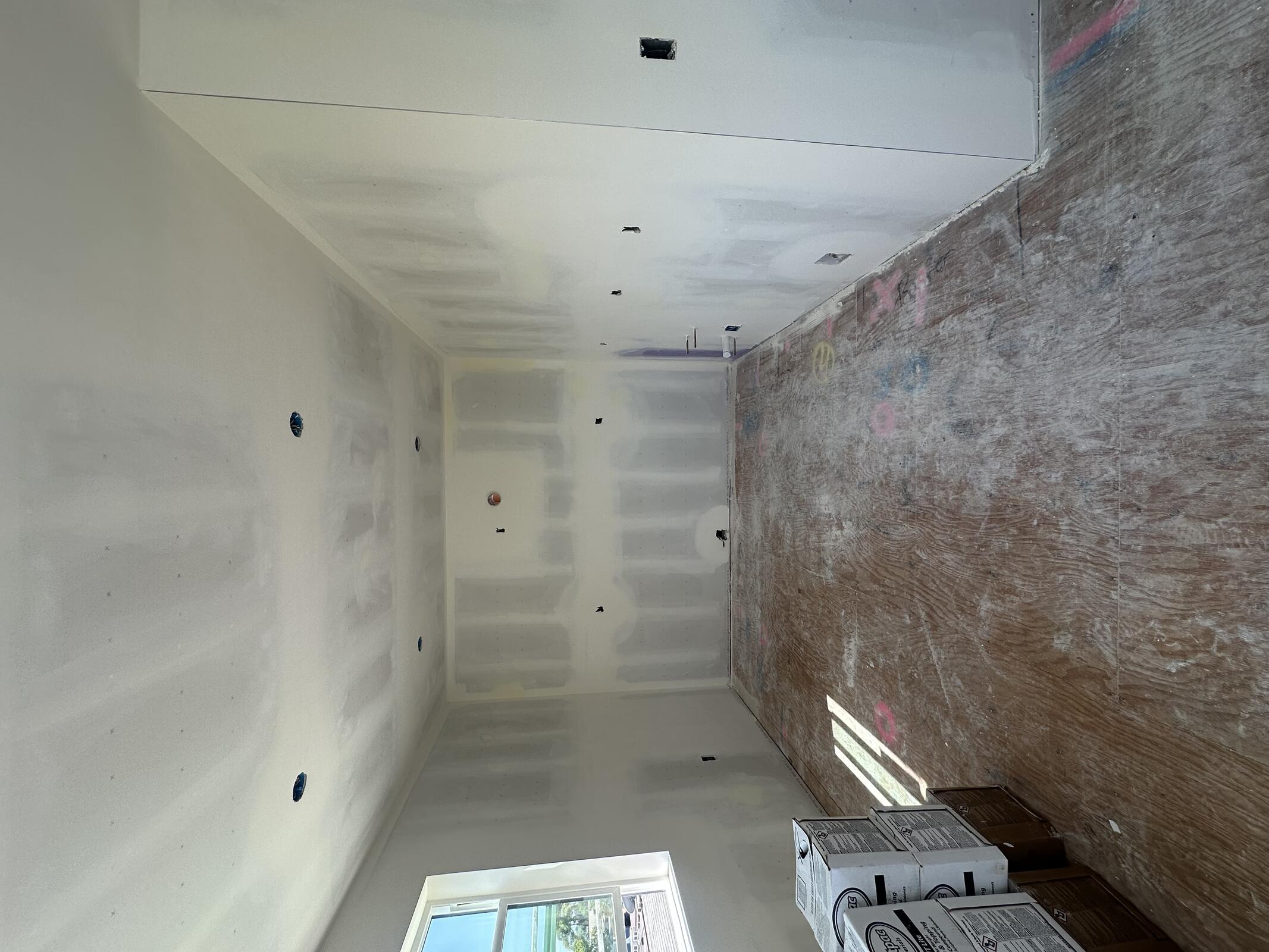

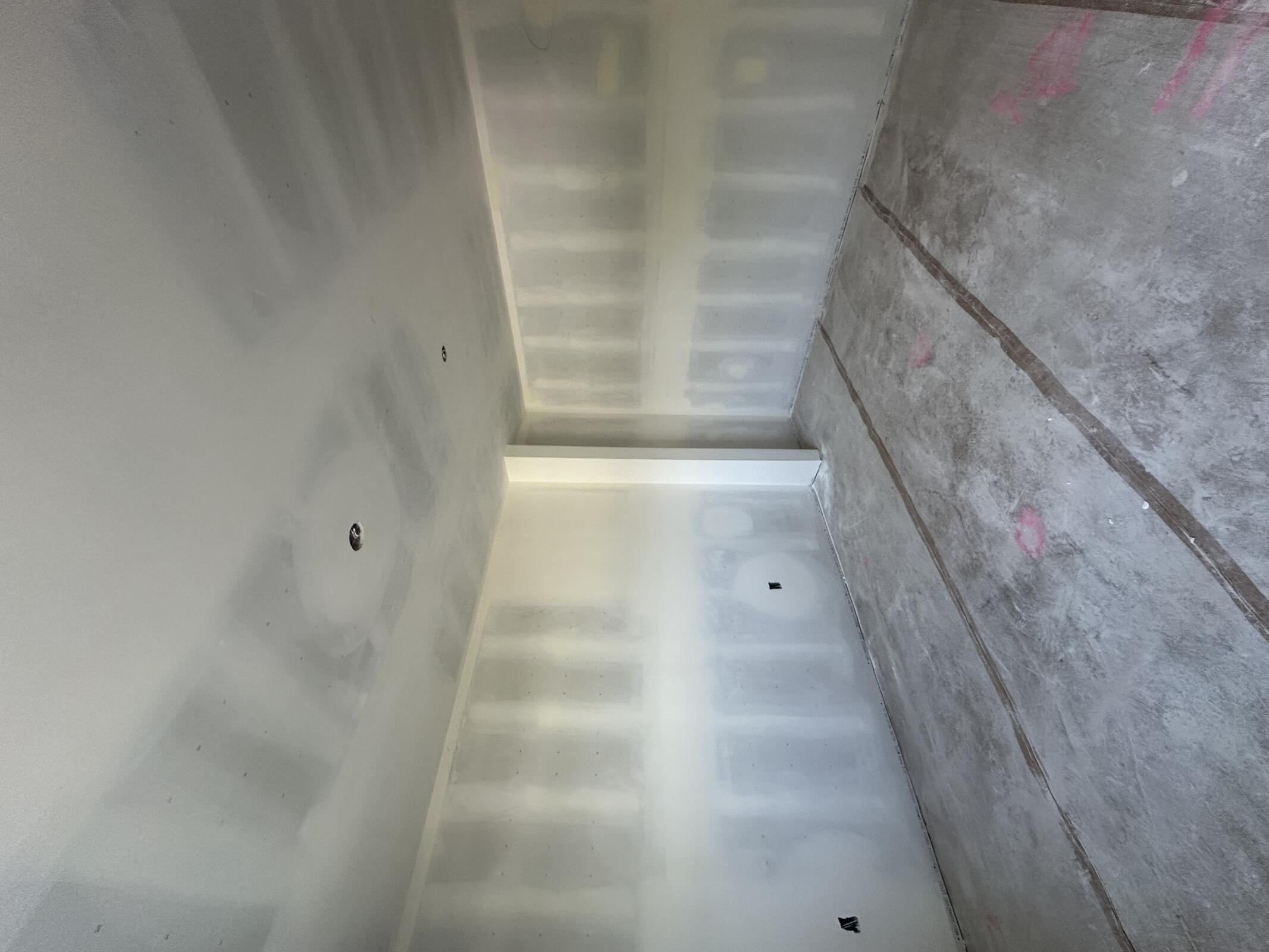

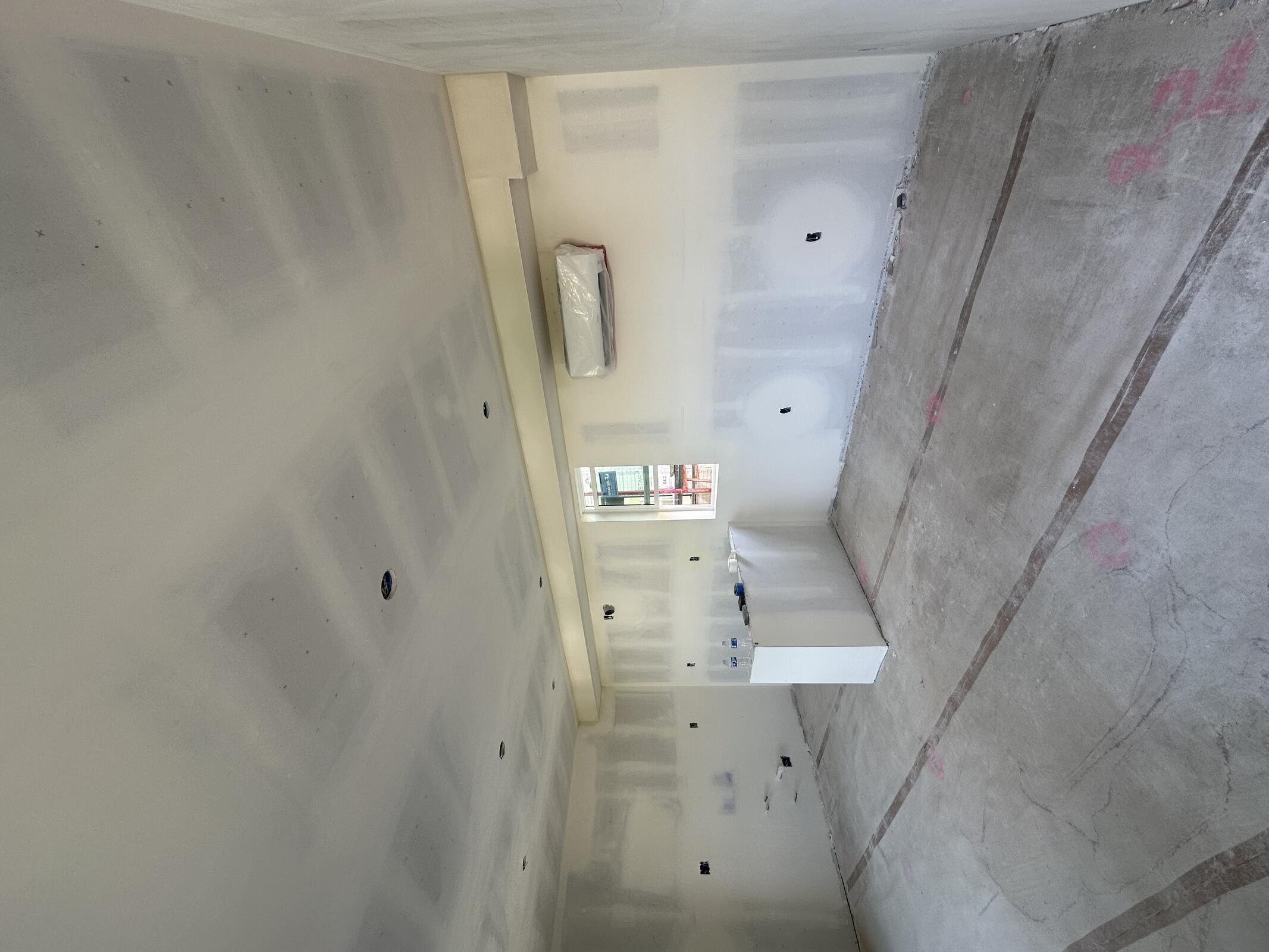

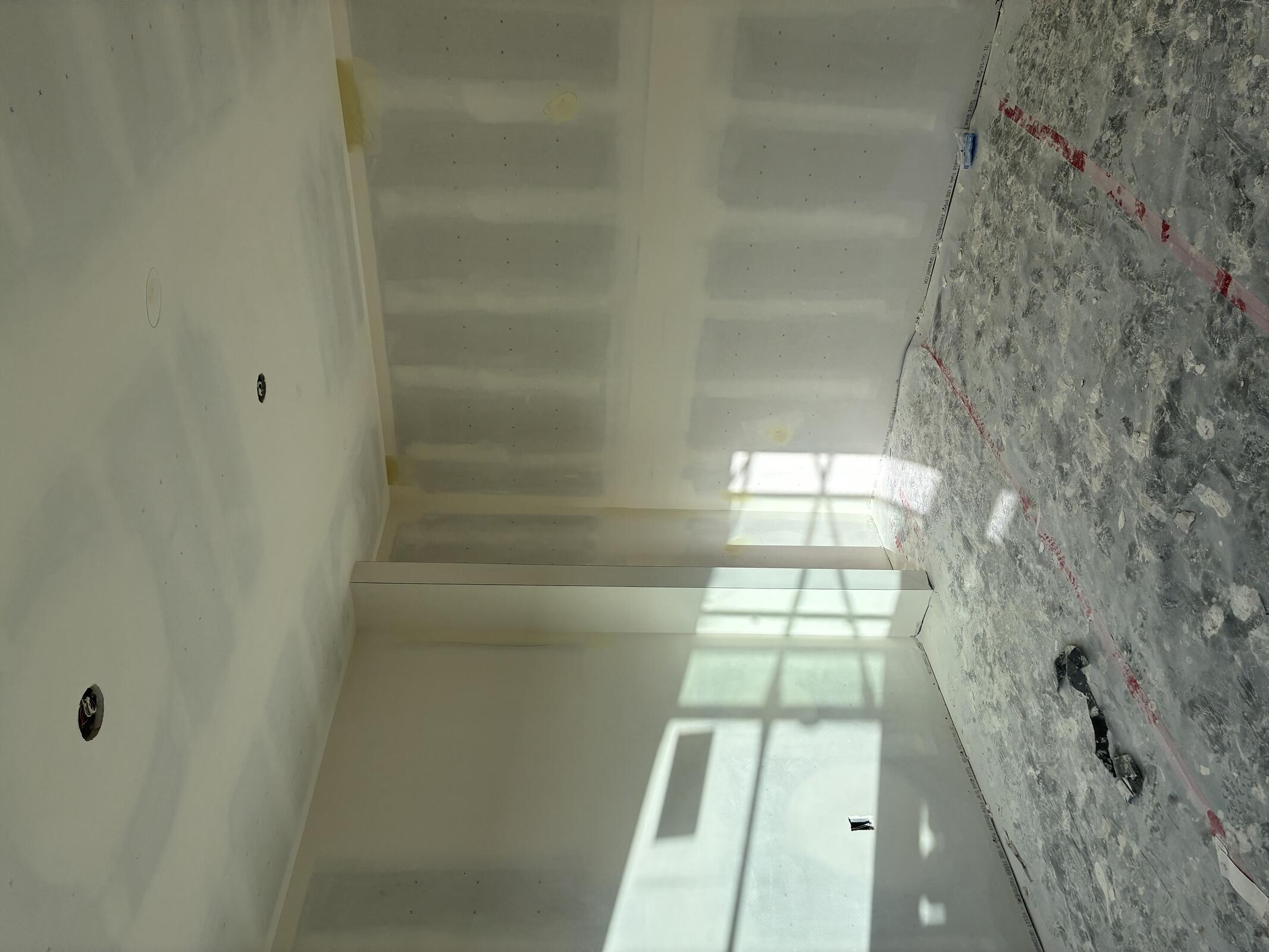

TDI fixing soffit in Building B 1 shower. Coastal waterproofing walls.

Rete's working on stair repairs.

ML picked up job site.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
JB General6848
Taylor Trim2816
Rete's2816
Coastal188

Inspection: N/A

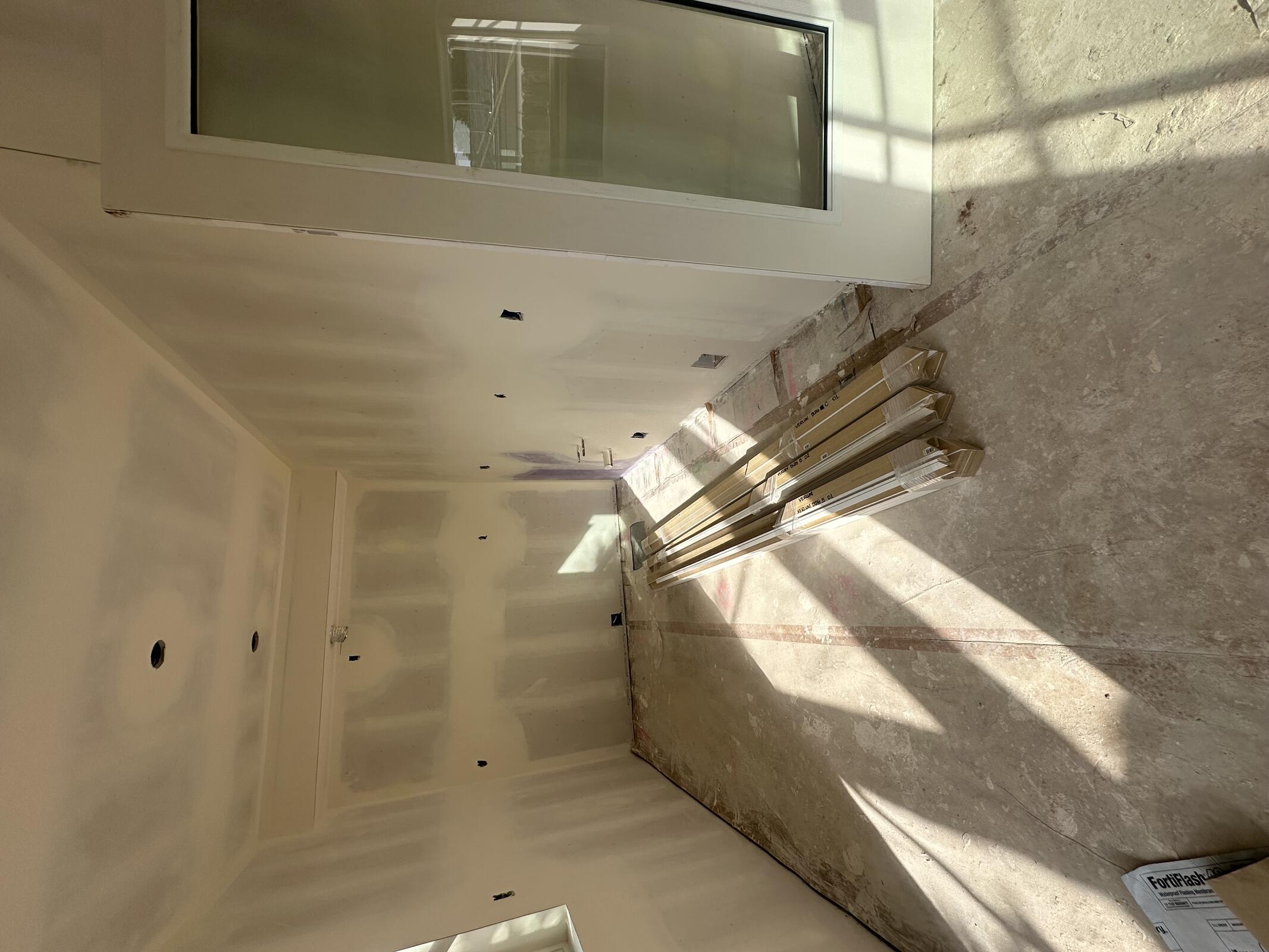

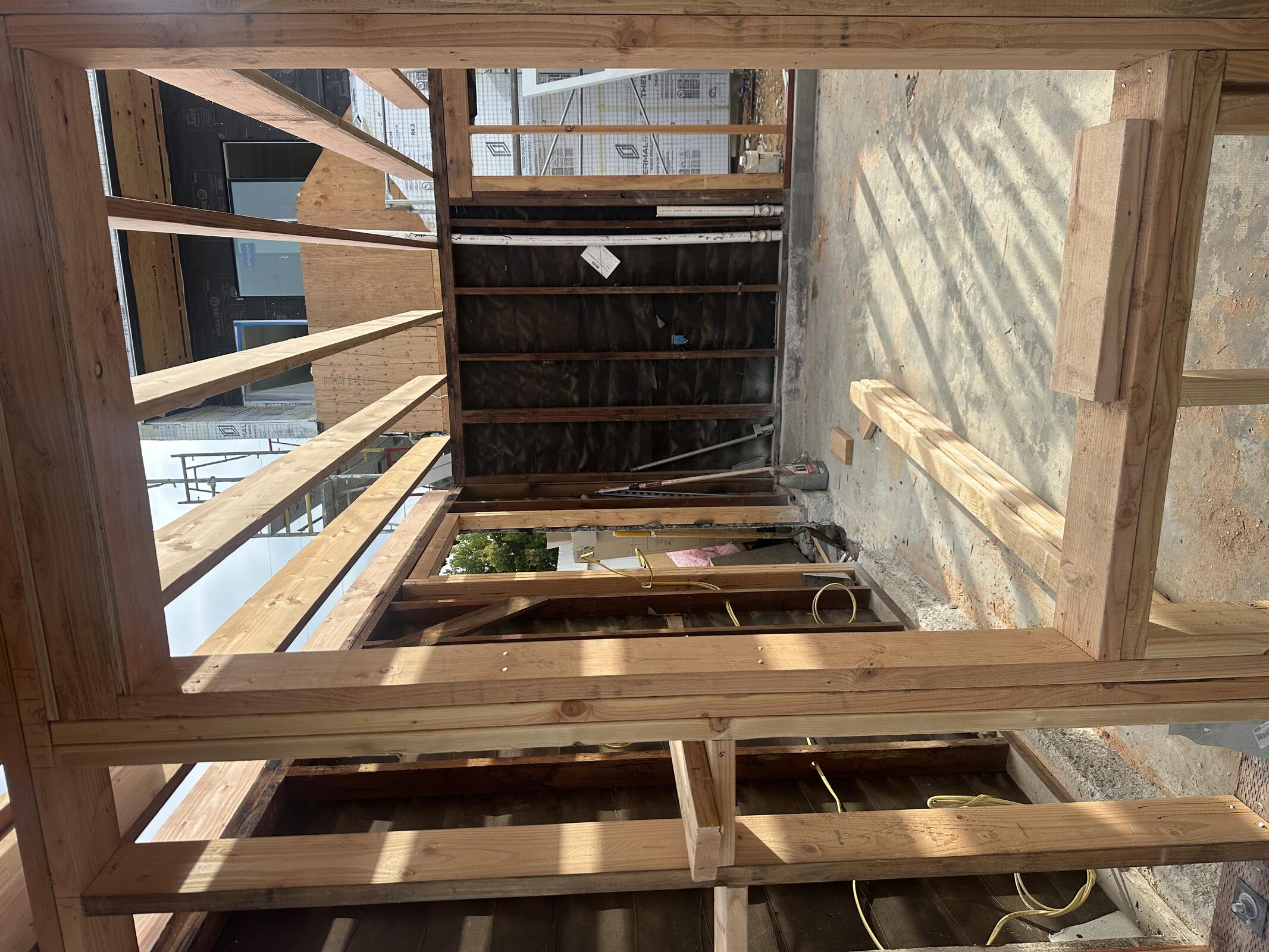

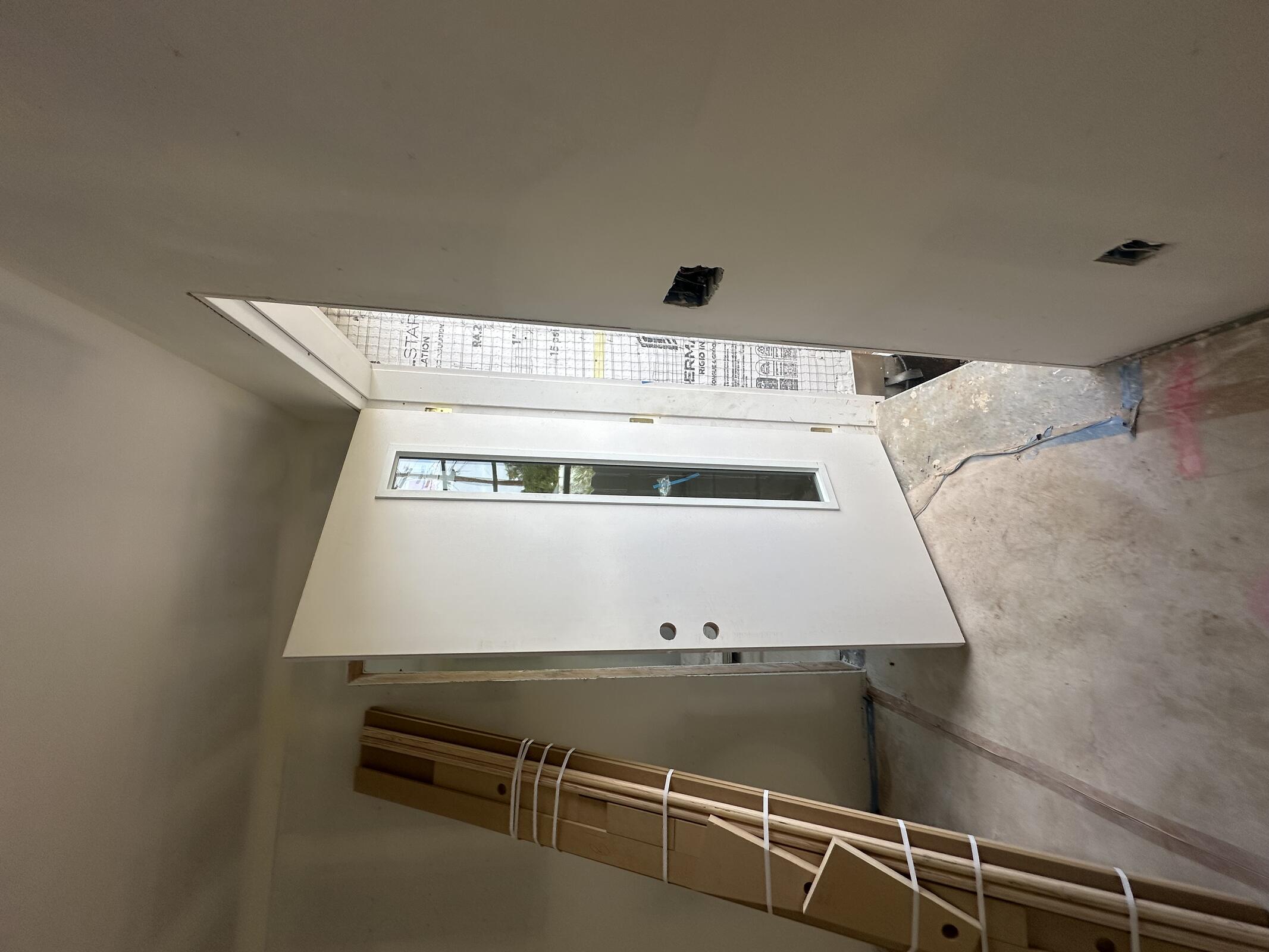

![IMG_1754 - 1.jpeg](/photos/2026-05-22/IMG_1754 - 1.jpeg)

![IMG_1757 - 1.jpeg](/photos/2026-05-22/IMG_1757 - 1.jpeg)

![IMG_1763 - 1.jpeg](/photos/2026-05-22/IMG_1763 - 1.jpeg)

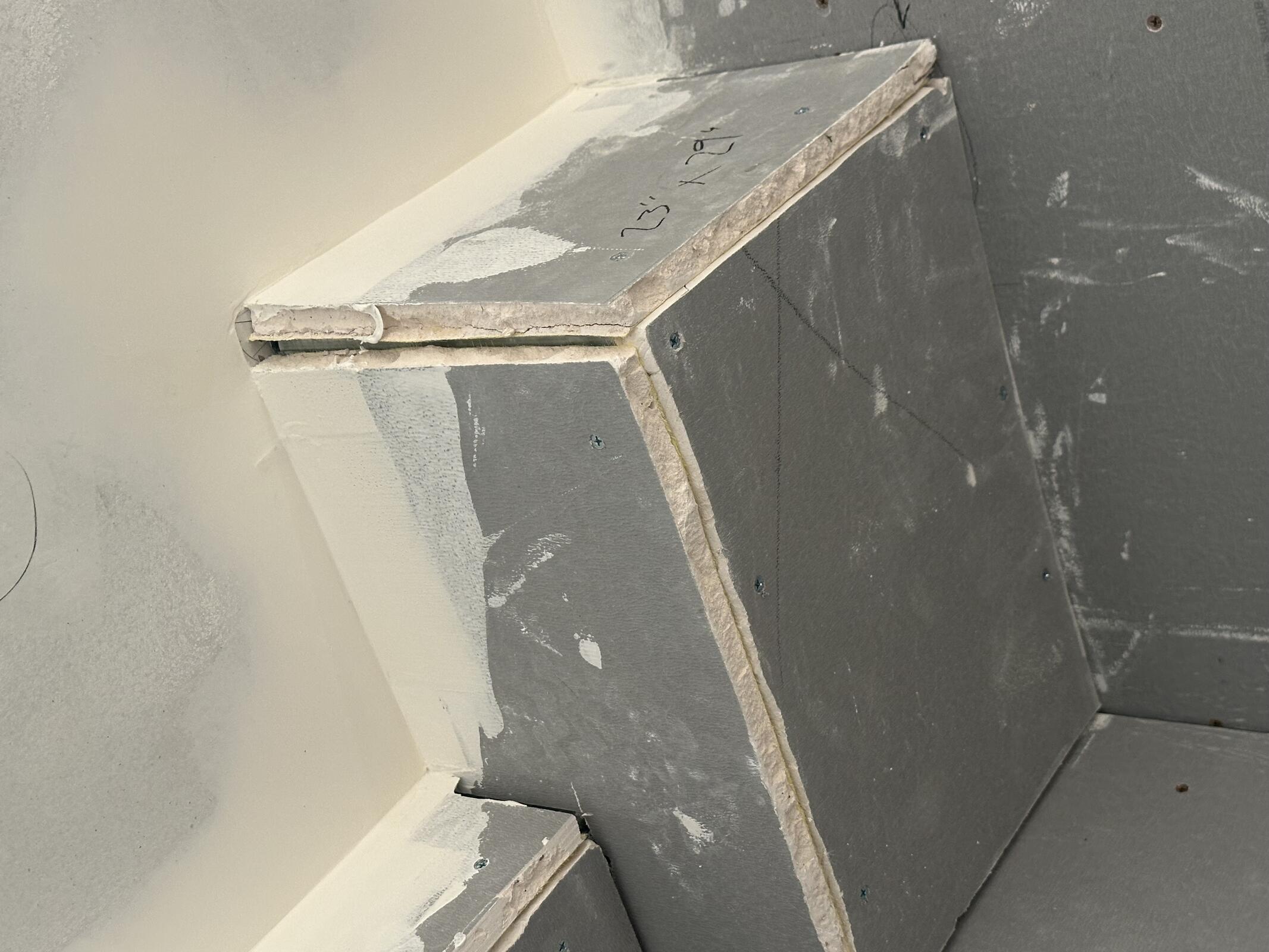

![IMG_1762 - 1.jpeg](/photos/2026-05-22/IMG_1762 - 1.jpeg)

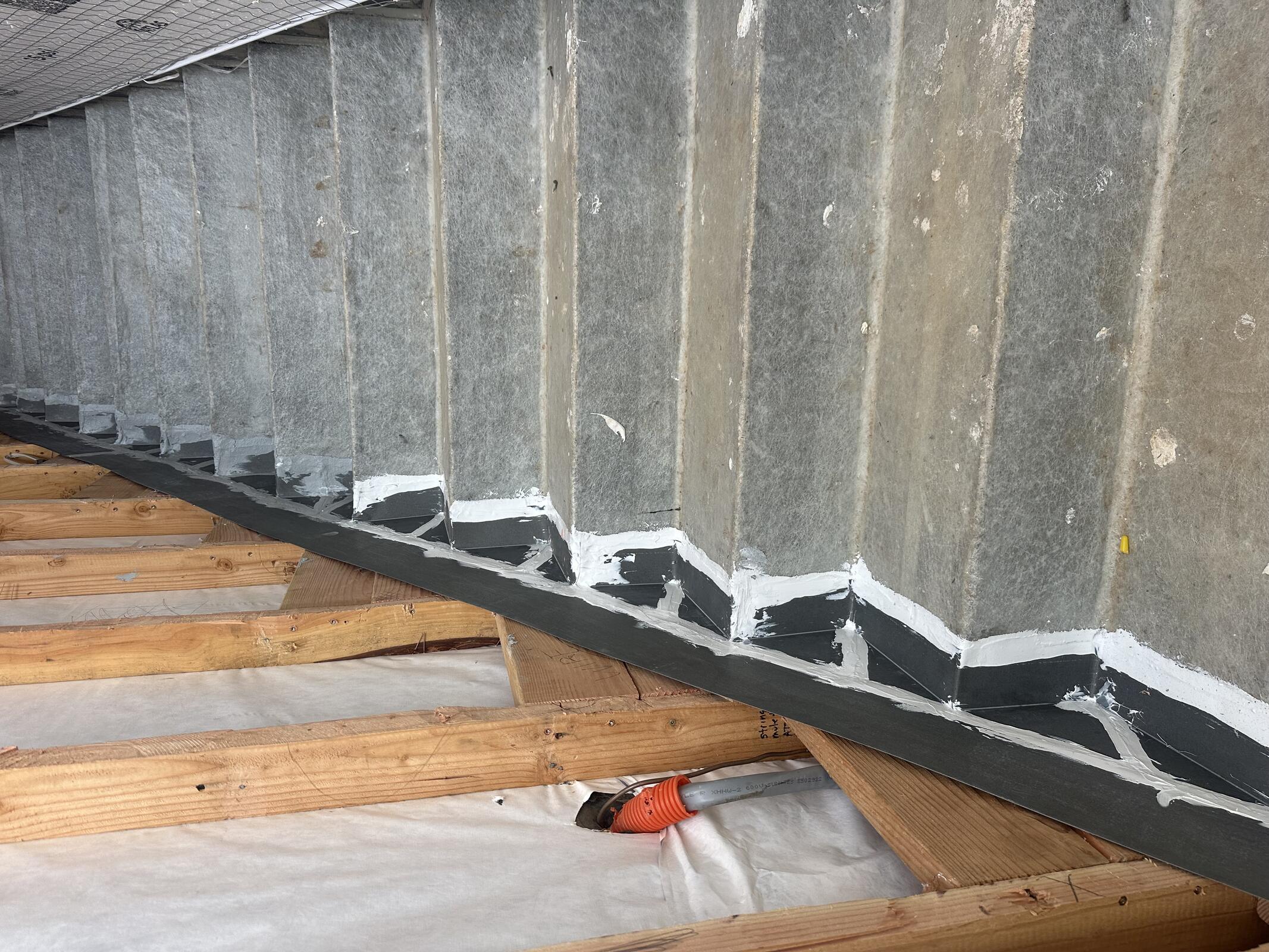

![IMG_1759 - 1.jpeg](/photos/2026-05-22/IMG_1759 - 1.jpeg)

![IMG_1764 - 1.jpeg](/photos/2026-05-22/IMG_1764 - 1.jpeg)
