Week of May 11 — May 15, 2026
5 days on site. 70 photos. Demolition, Drywall, Foundations, Framing, HVAC, Inspection, Plumbing, Roofing, Stucco.
Monday, May 11, 2026
Clear, 74°F

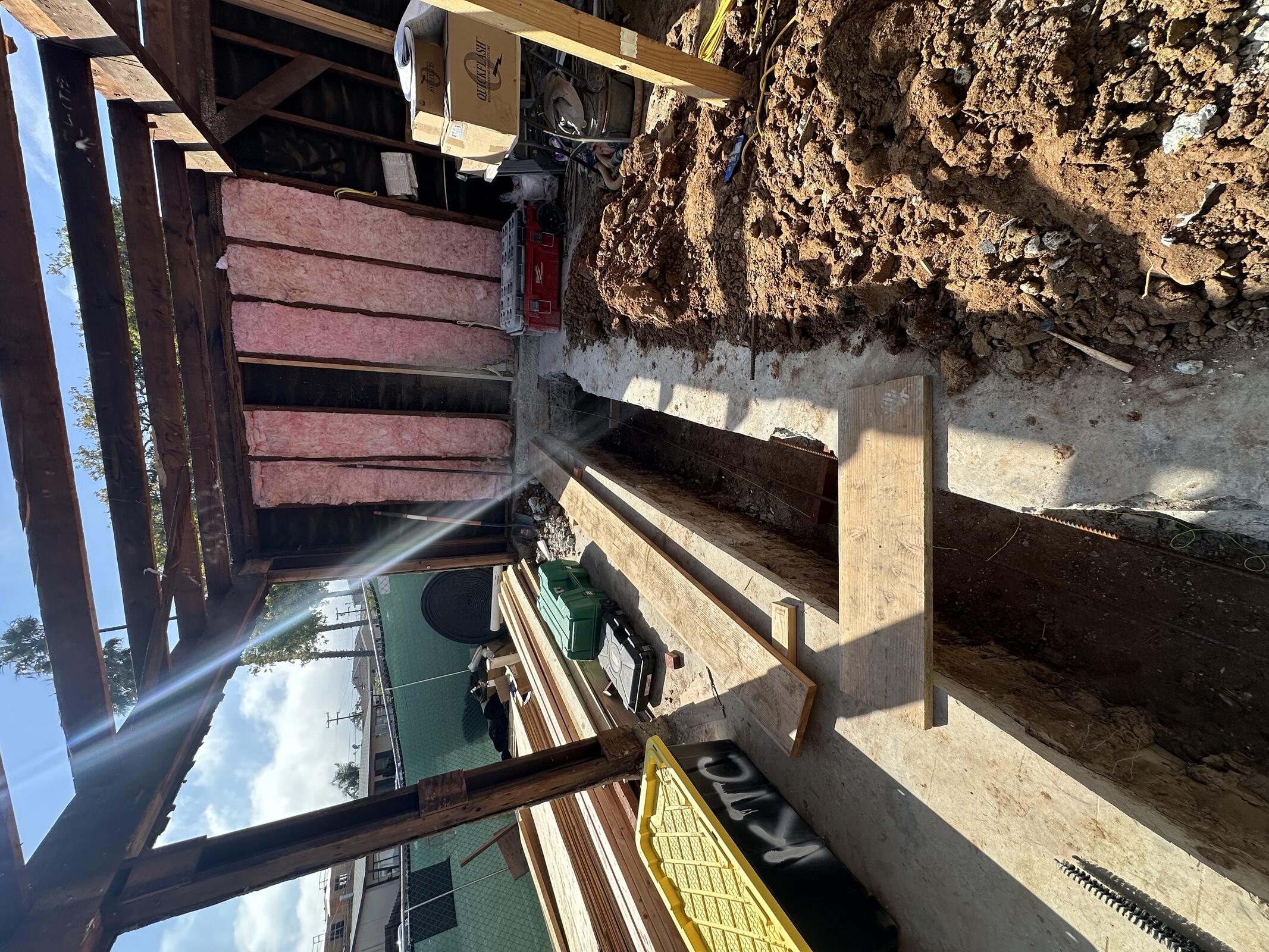

JB General demoing garage roof and working on Garage Conversion Foundations.

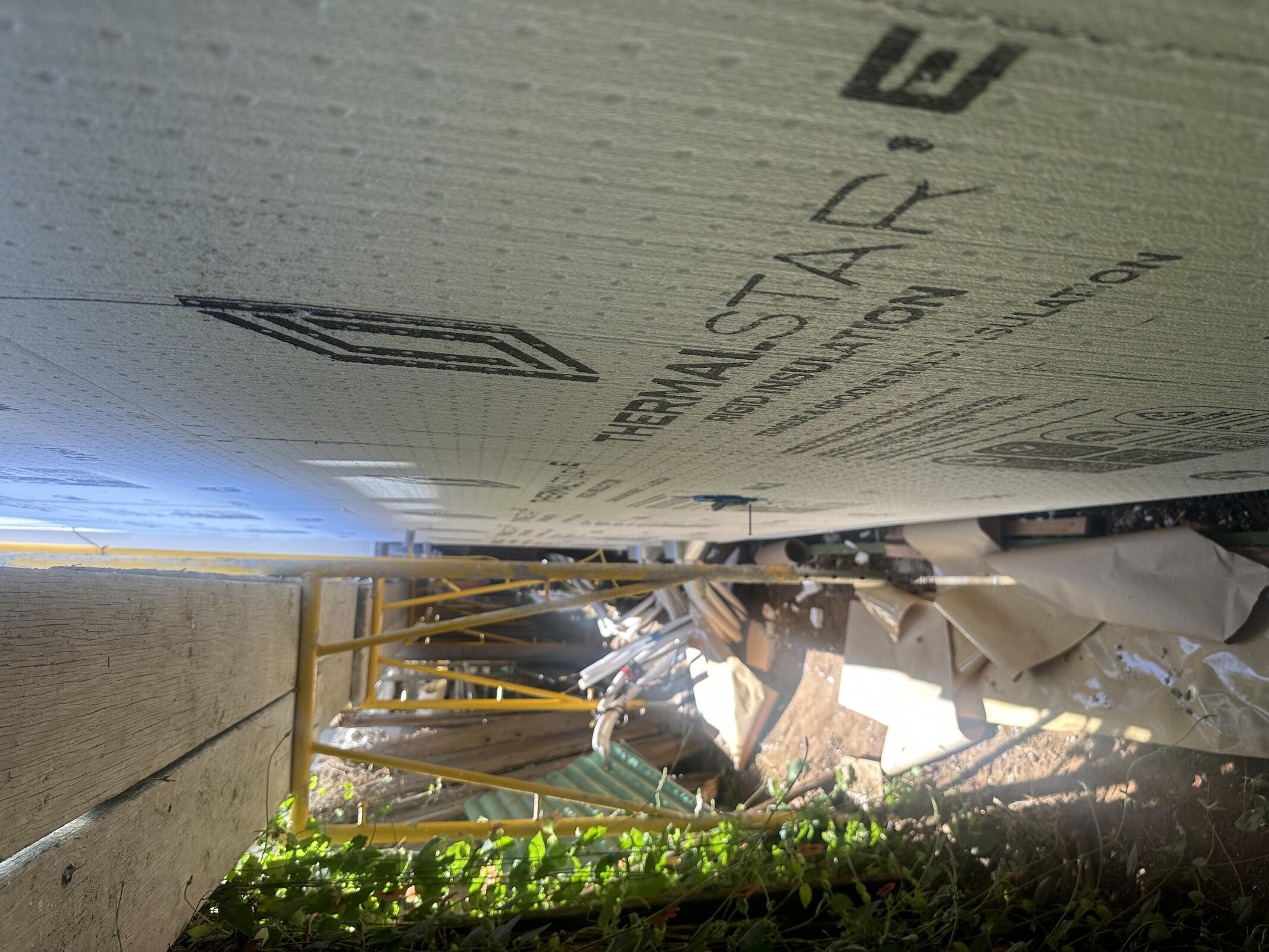

Marq plastering continuing to paper and lath.

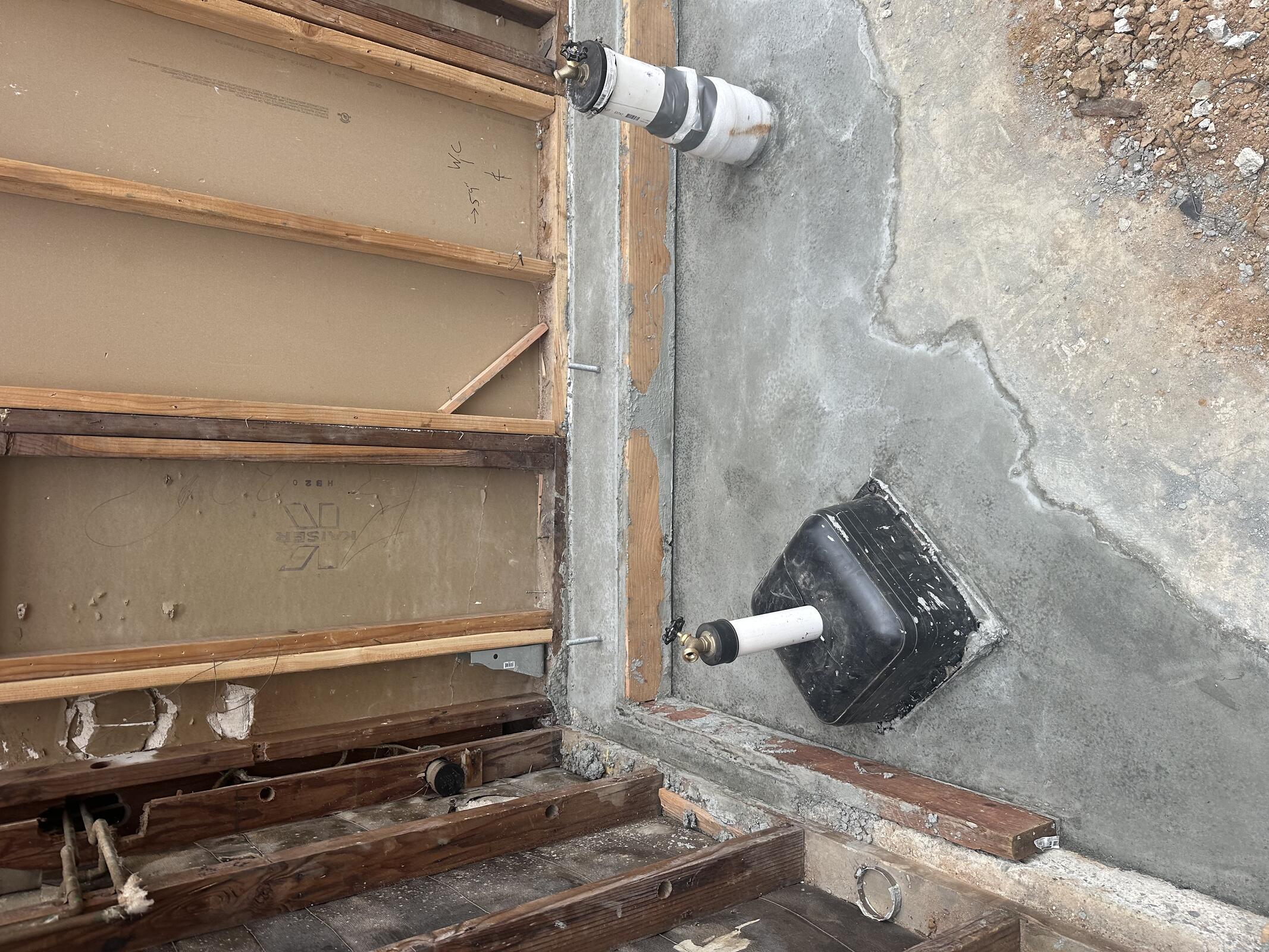

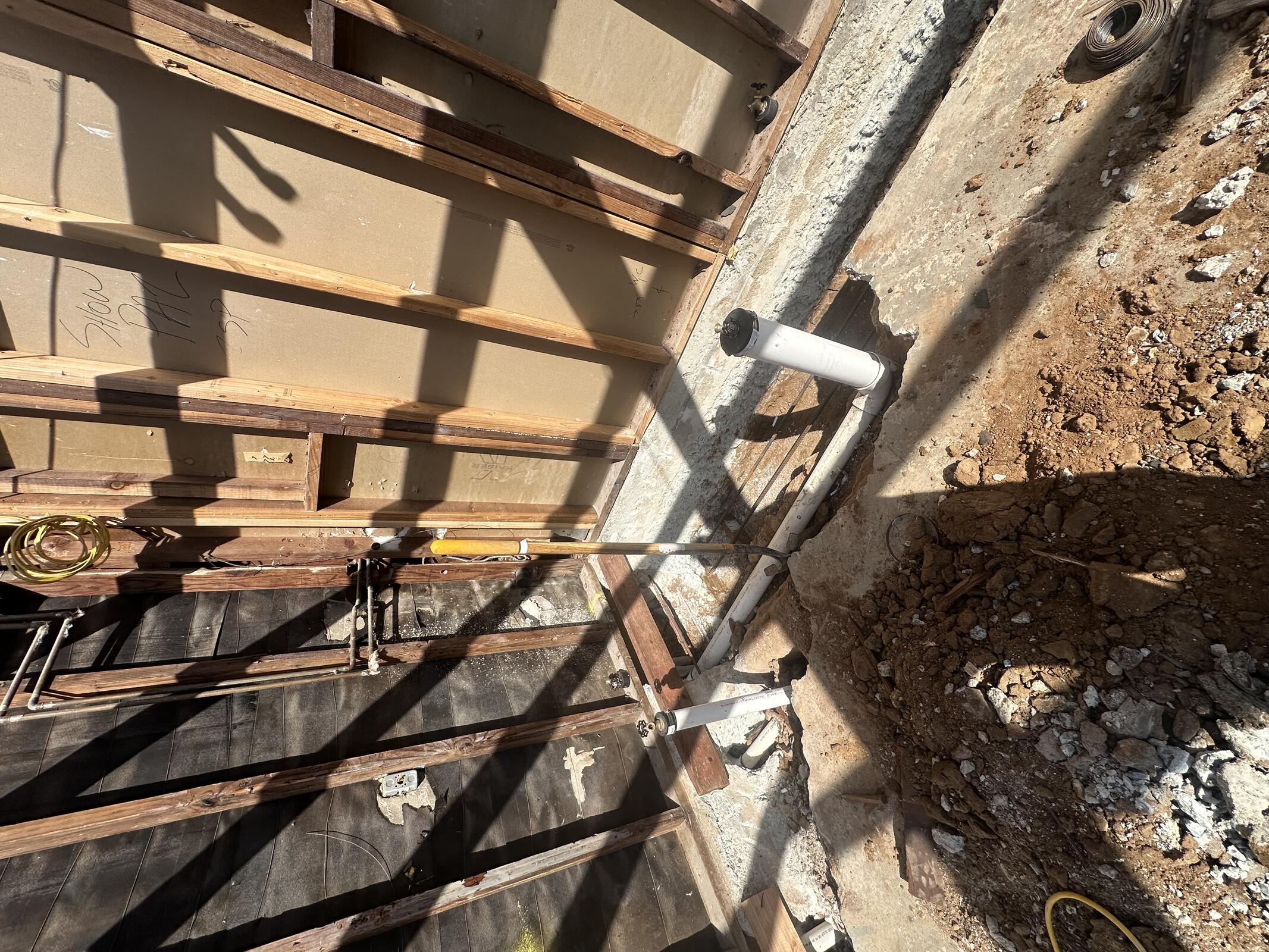

Zack Smith on site for UG plumbing inspection at Garage.

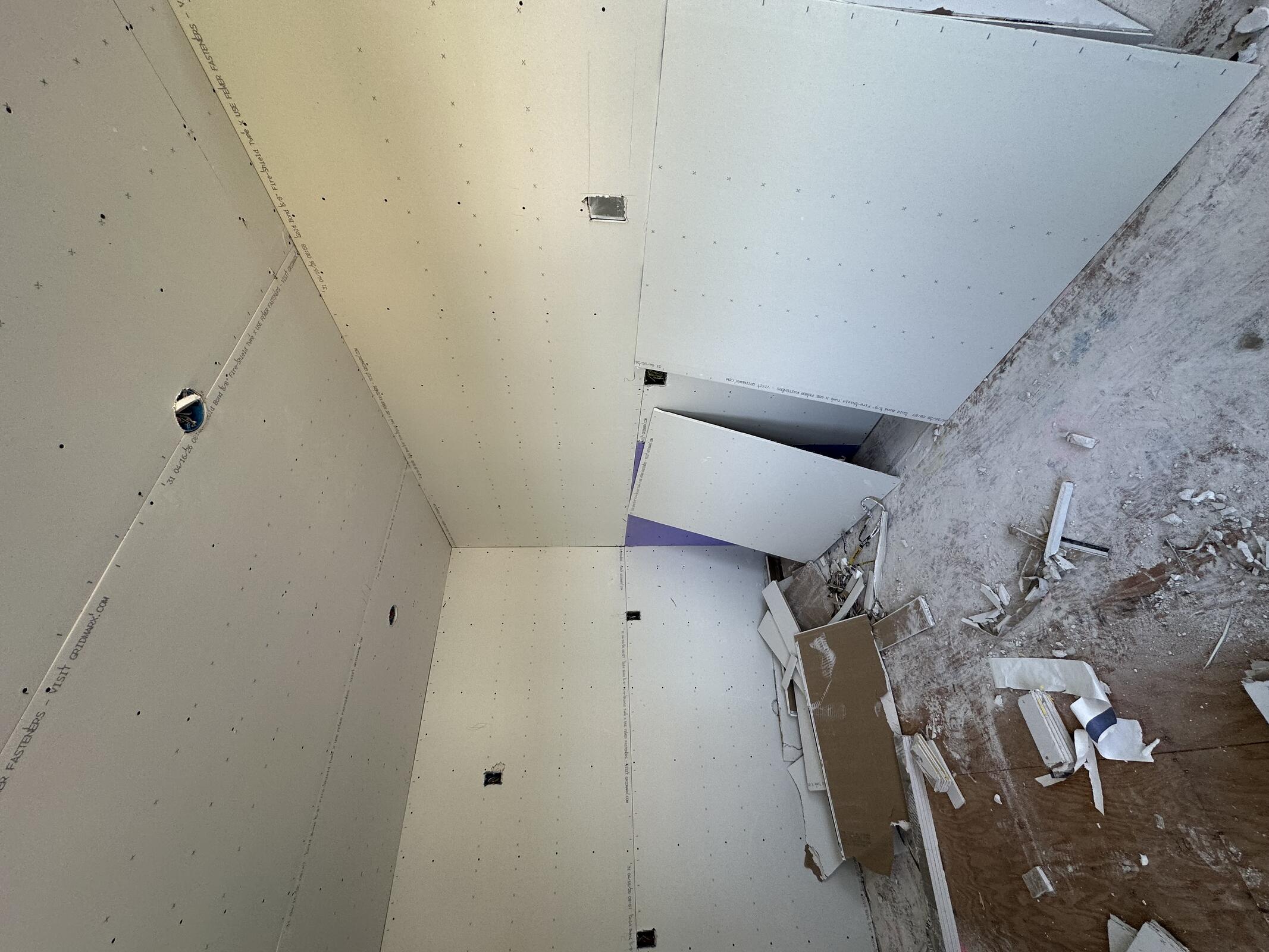

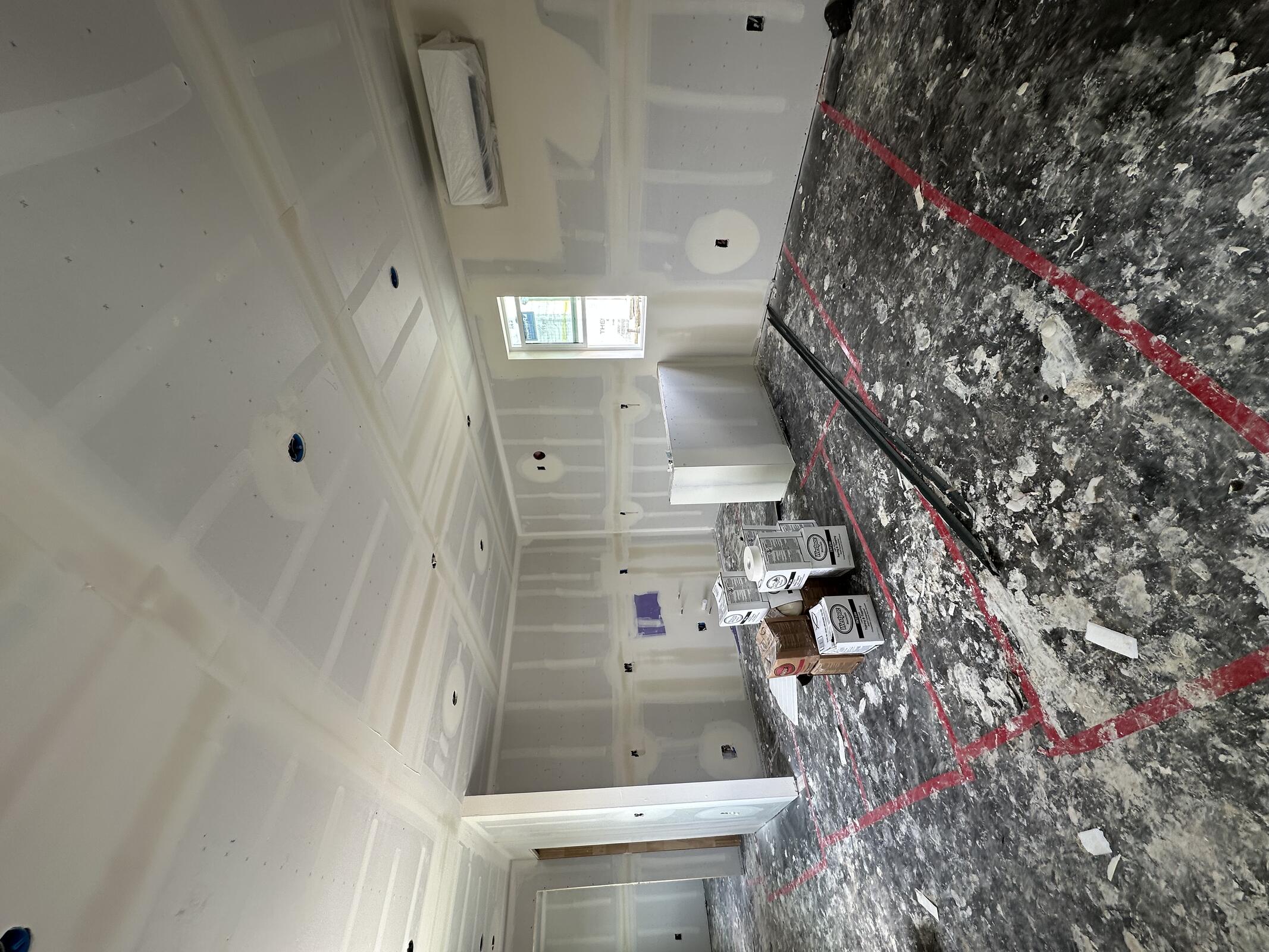

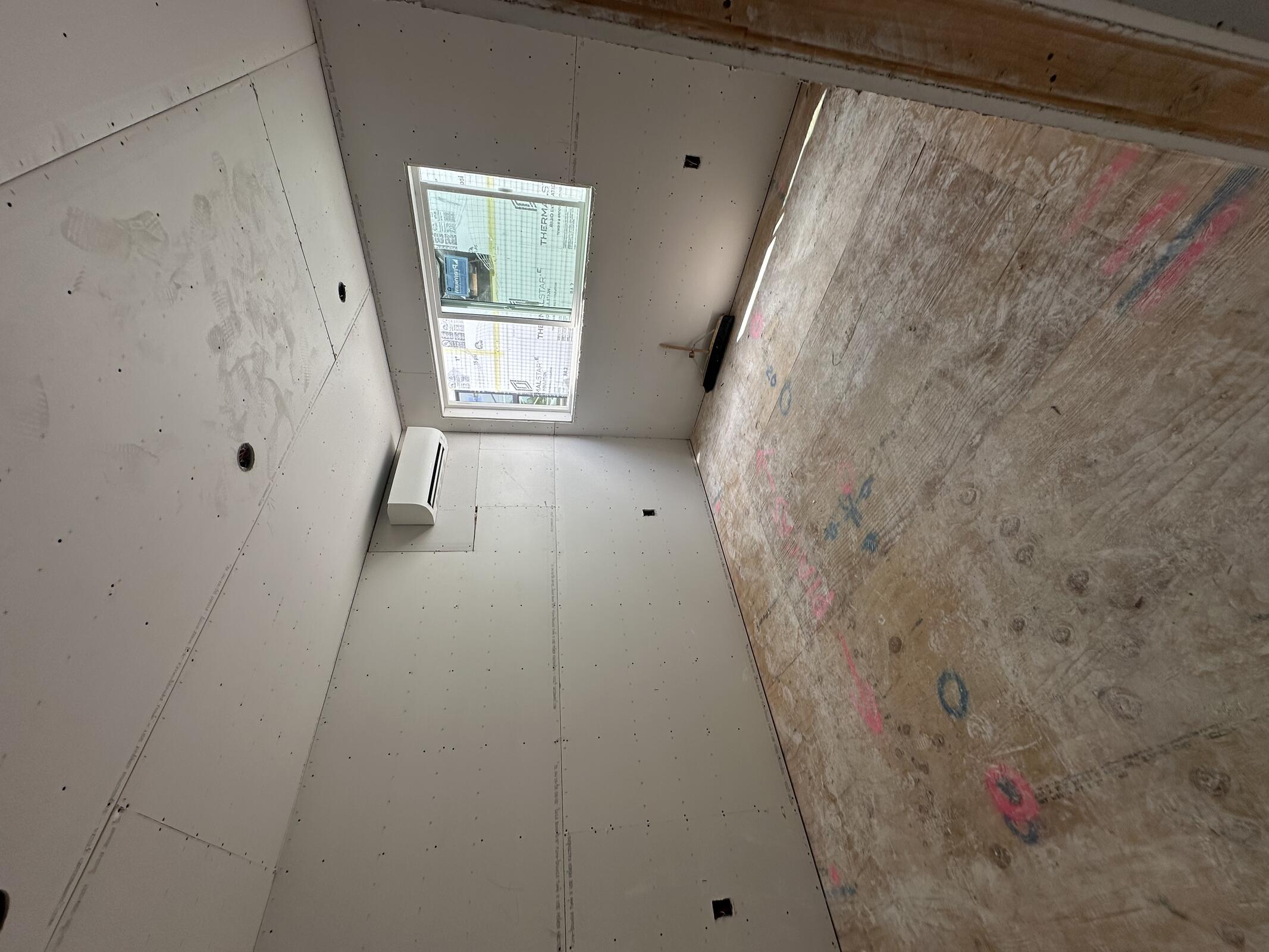

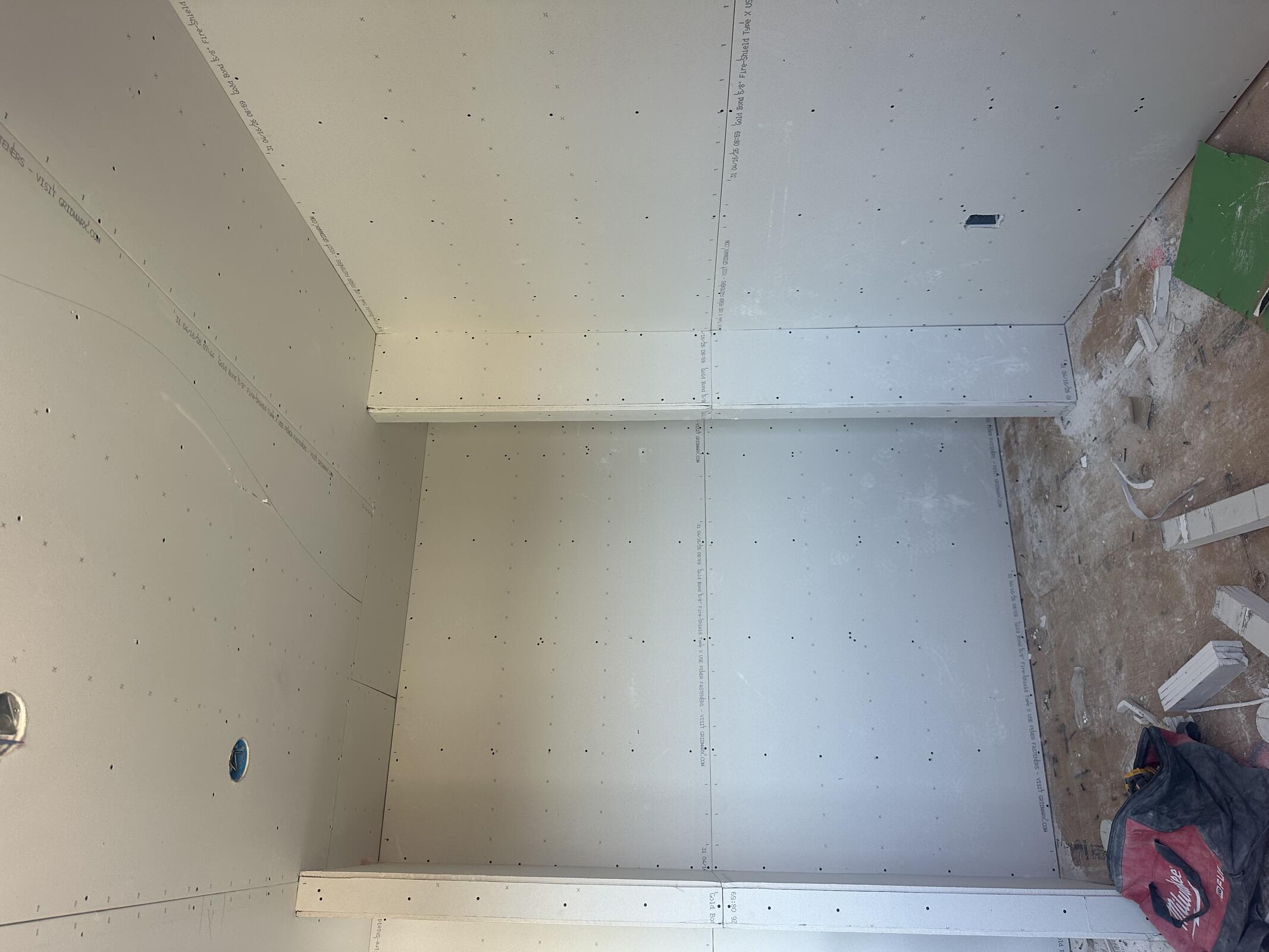

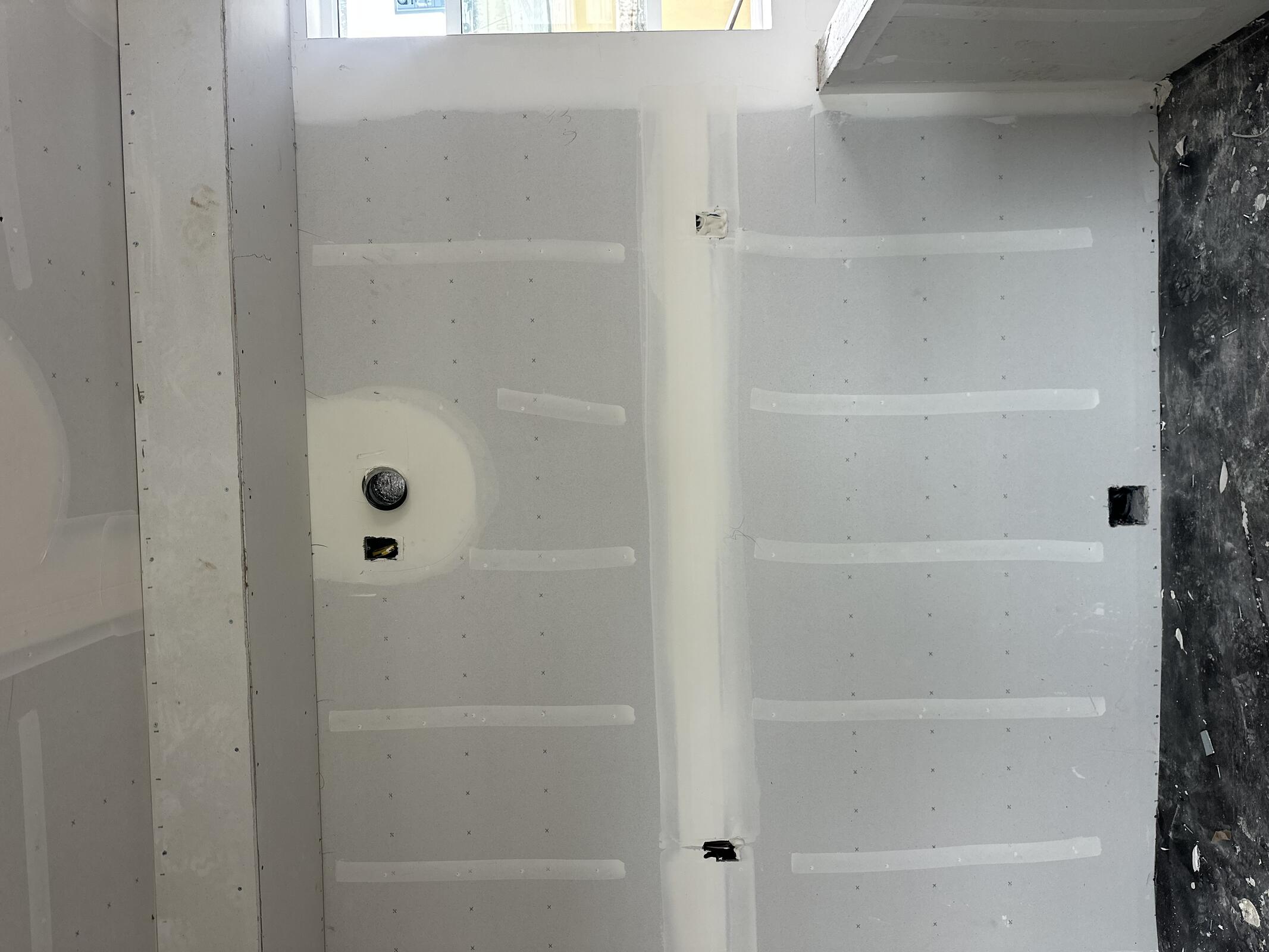

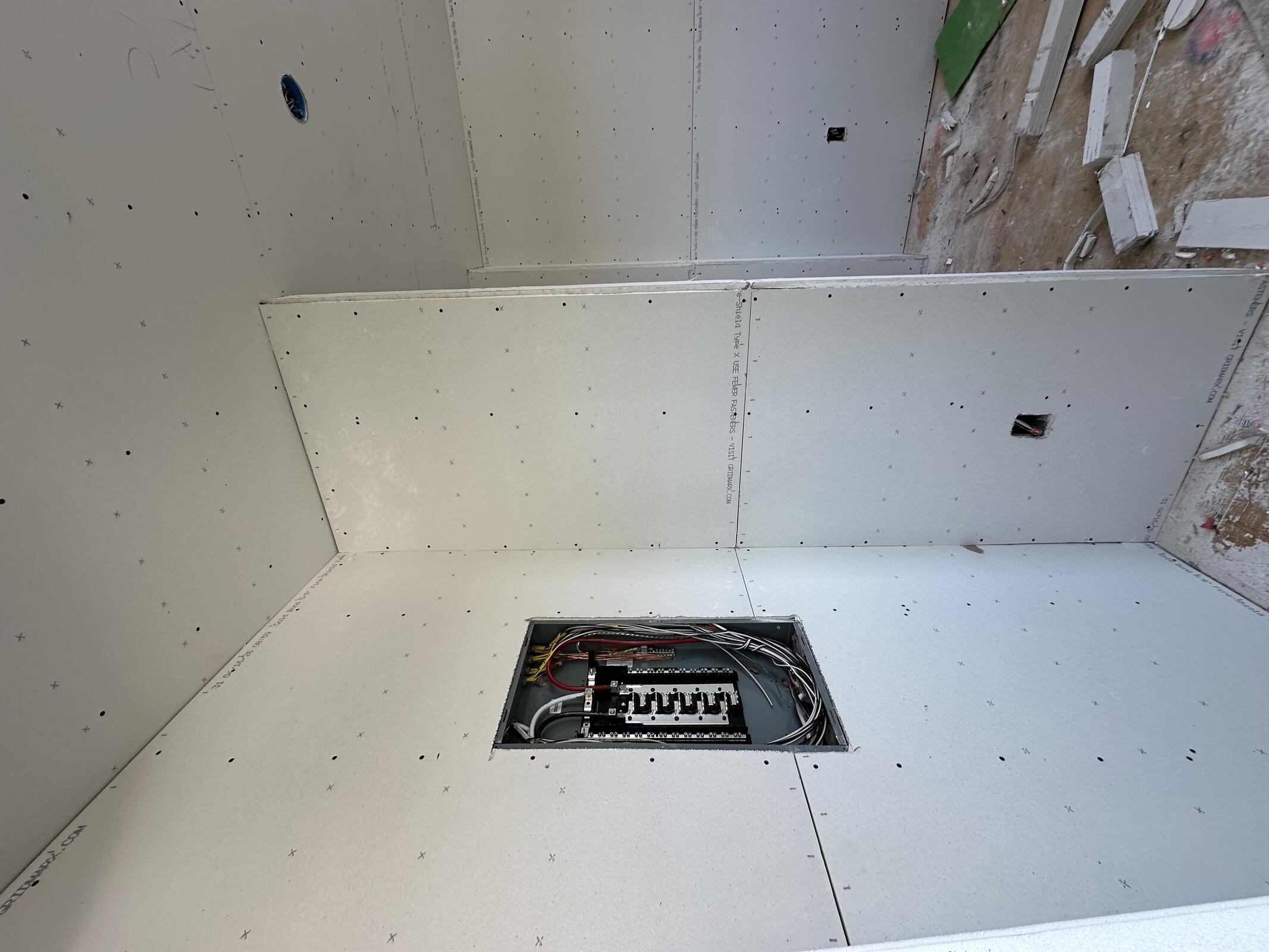

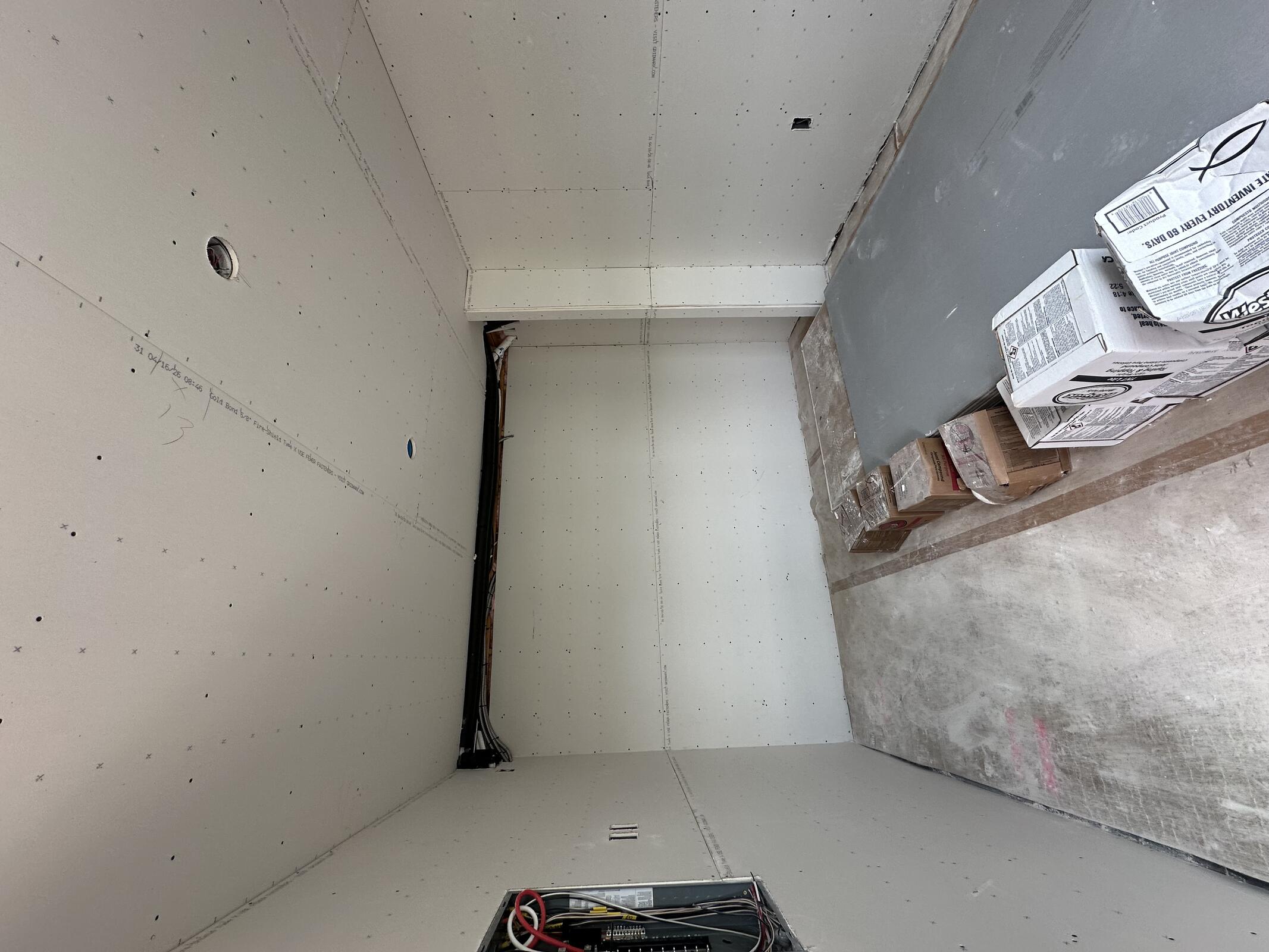

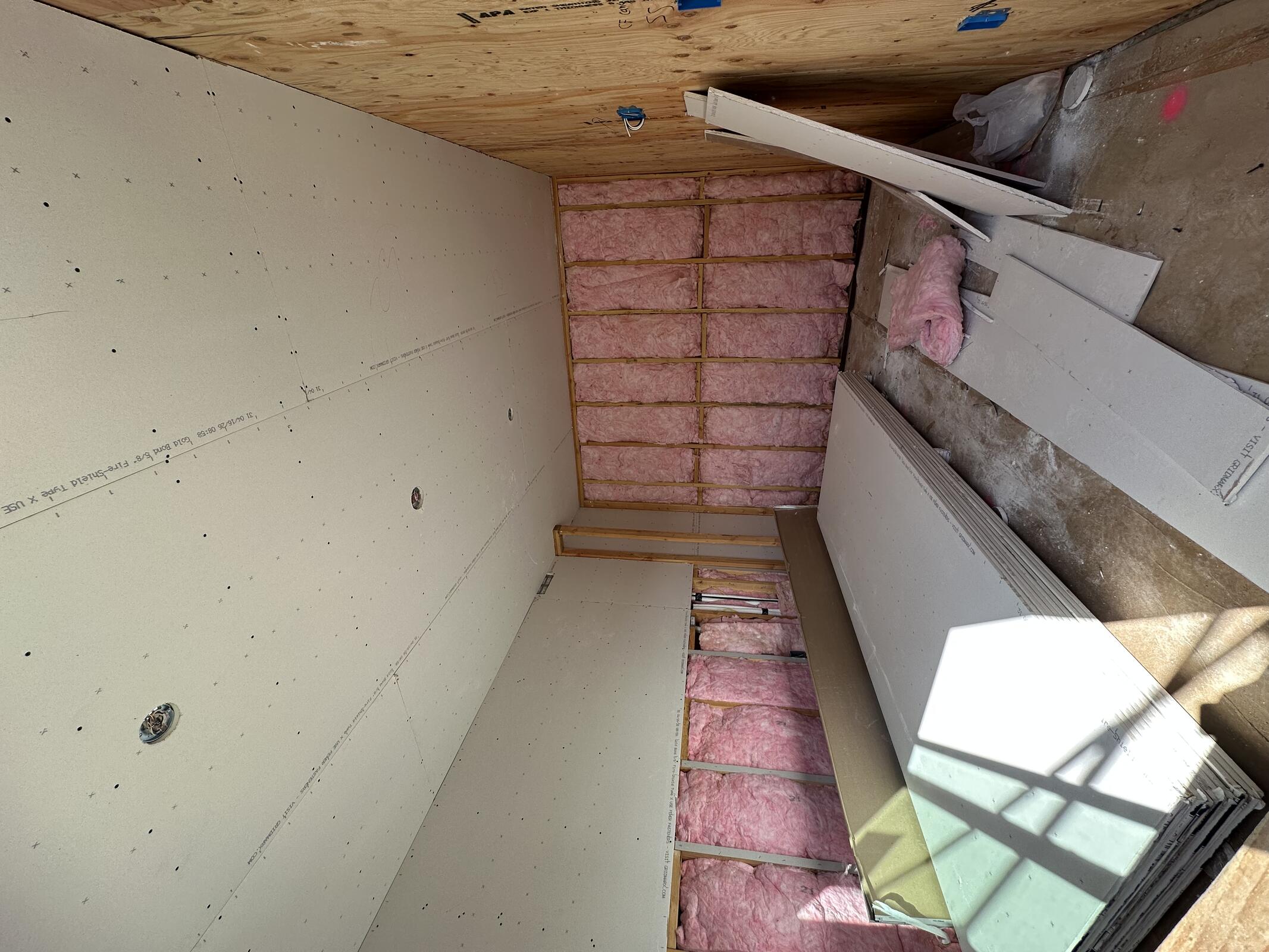

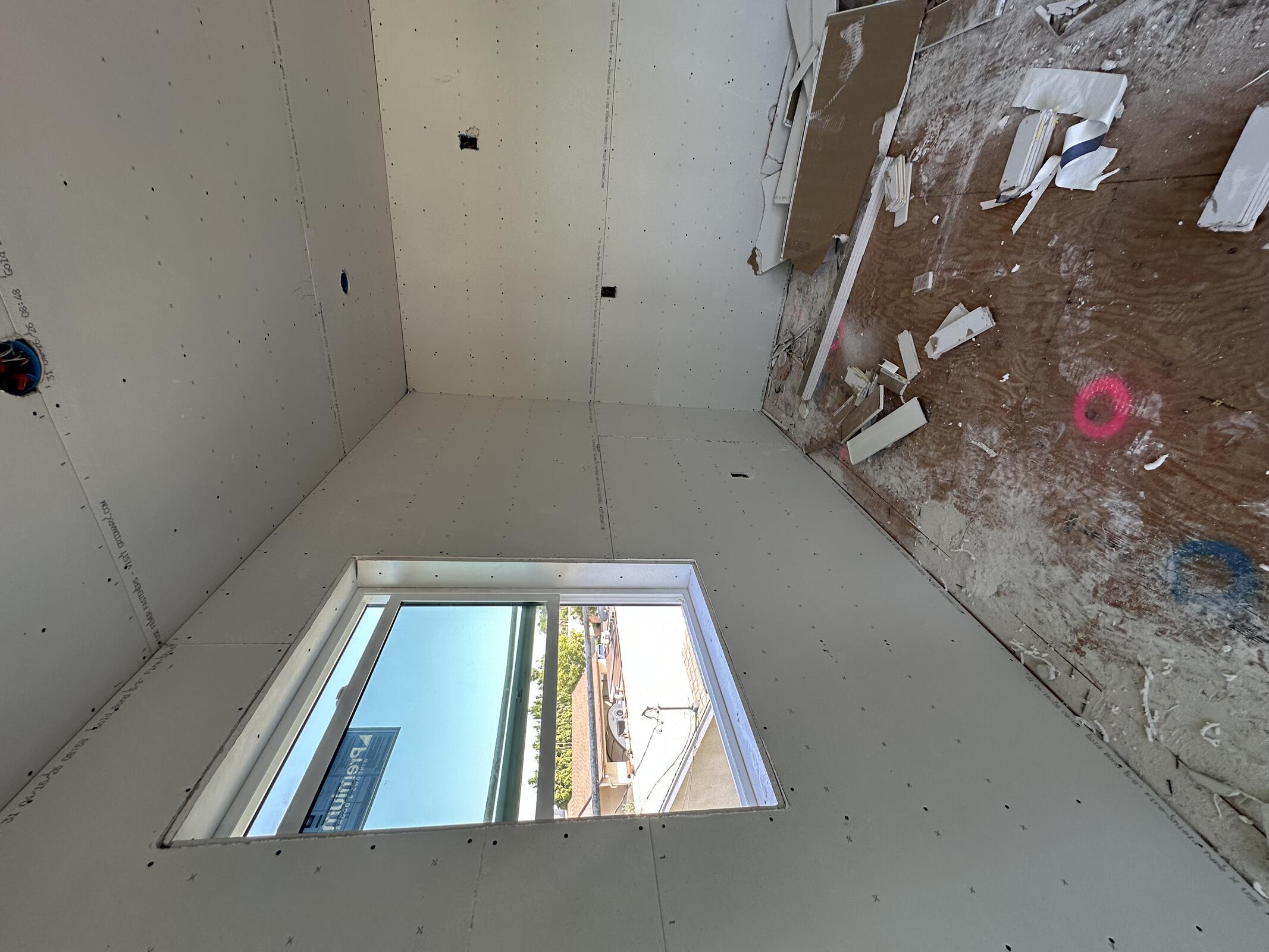

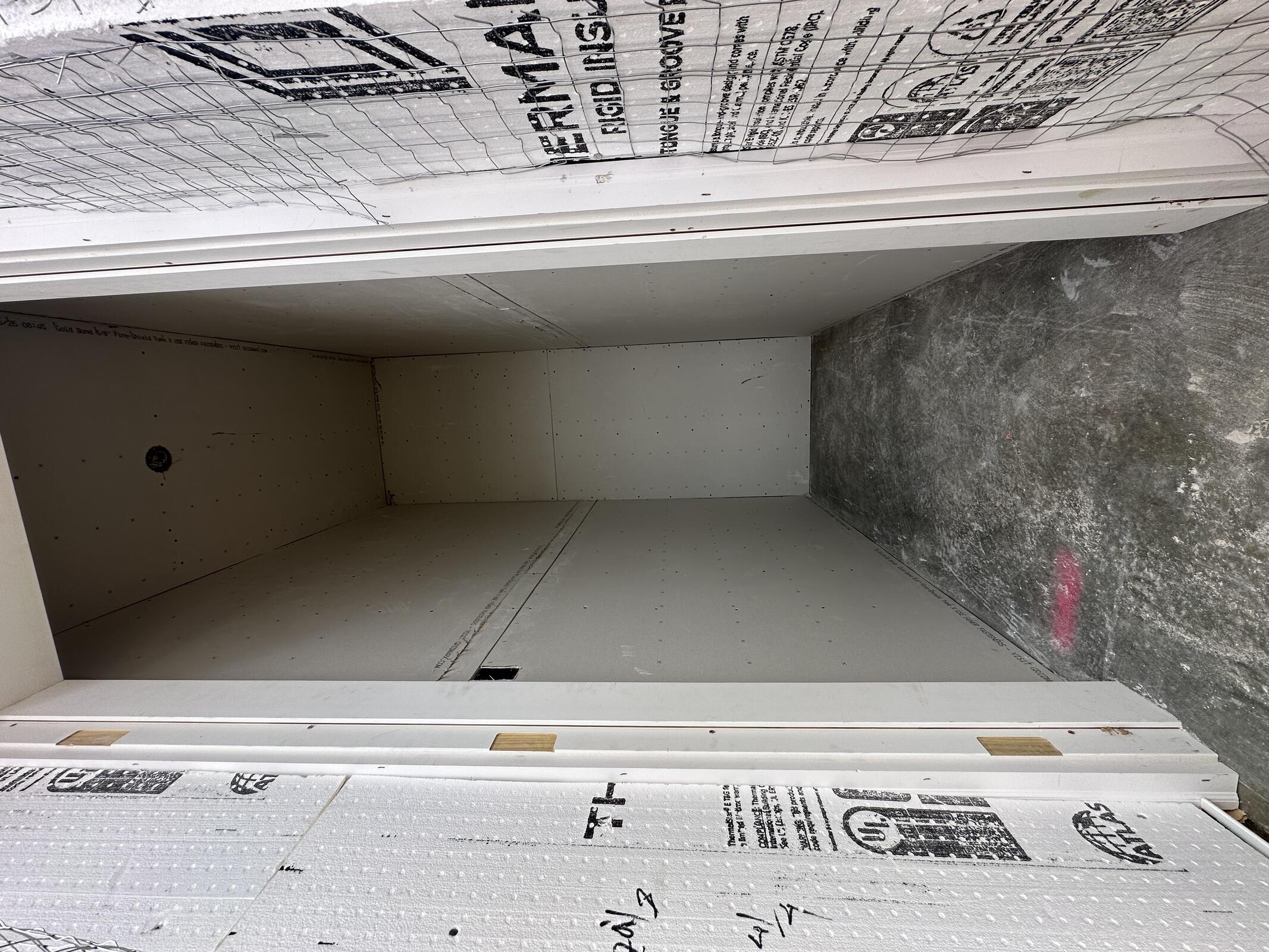

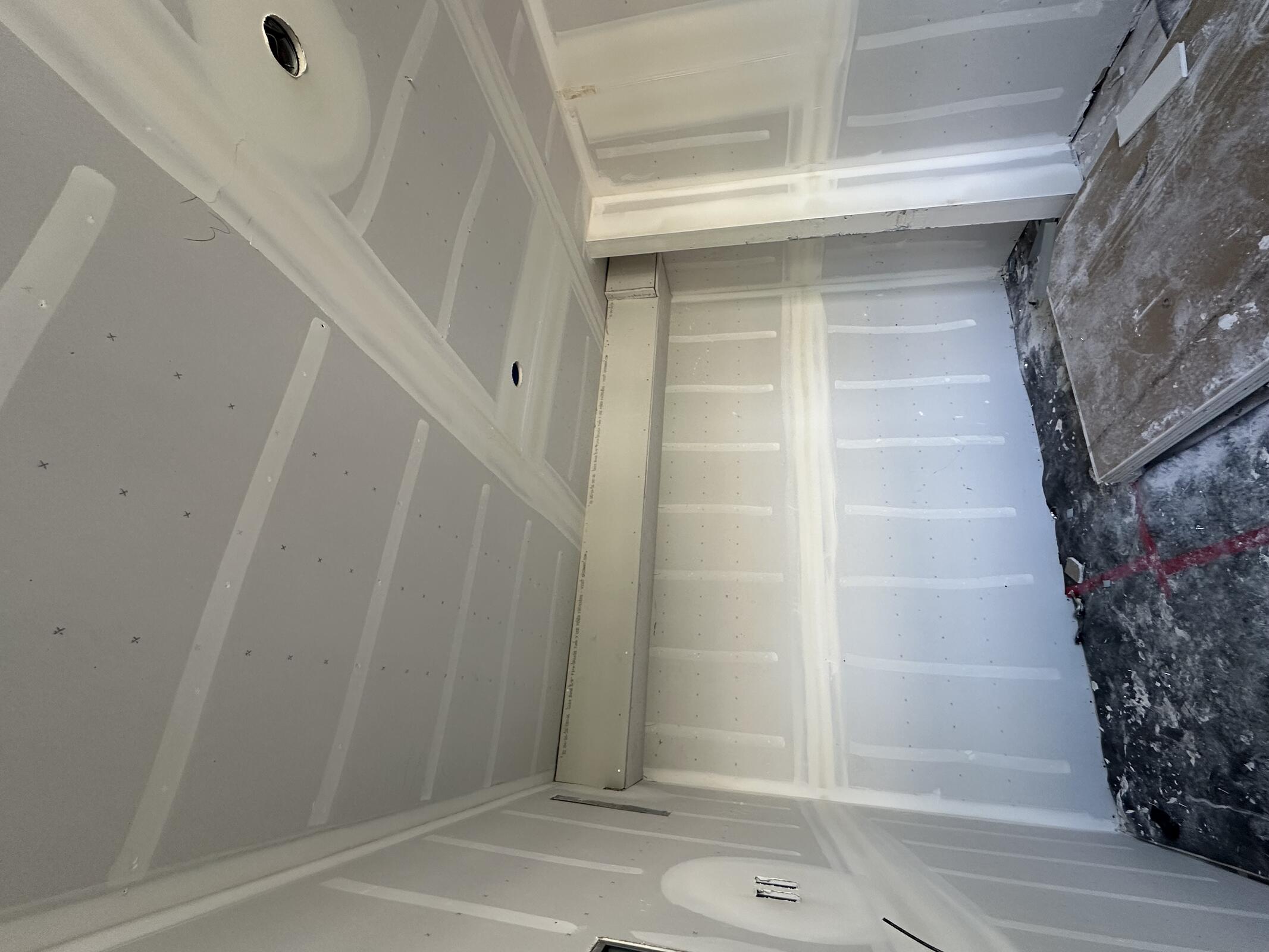

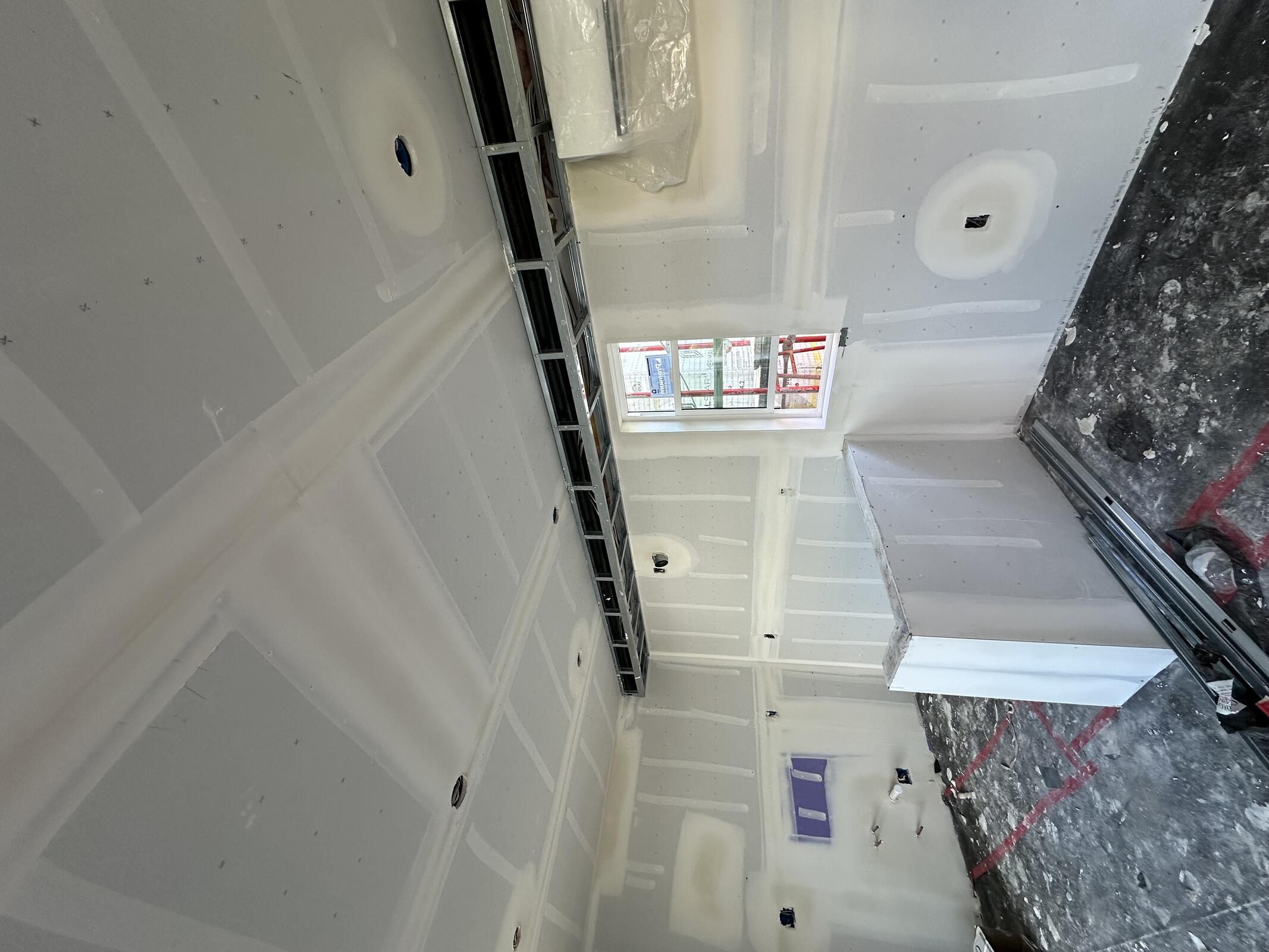

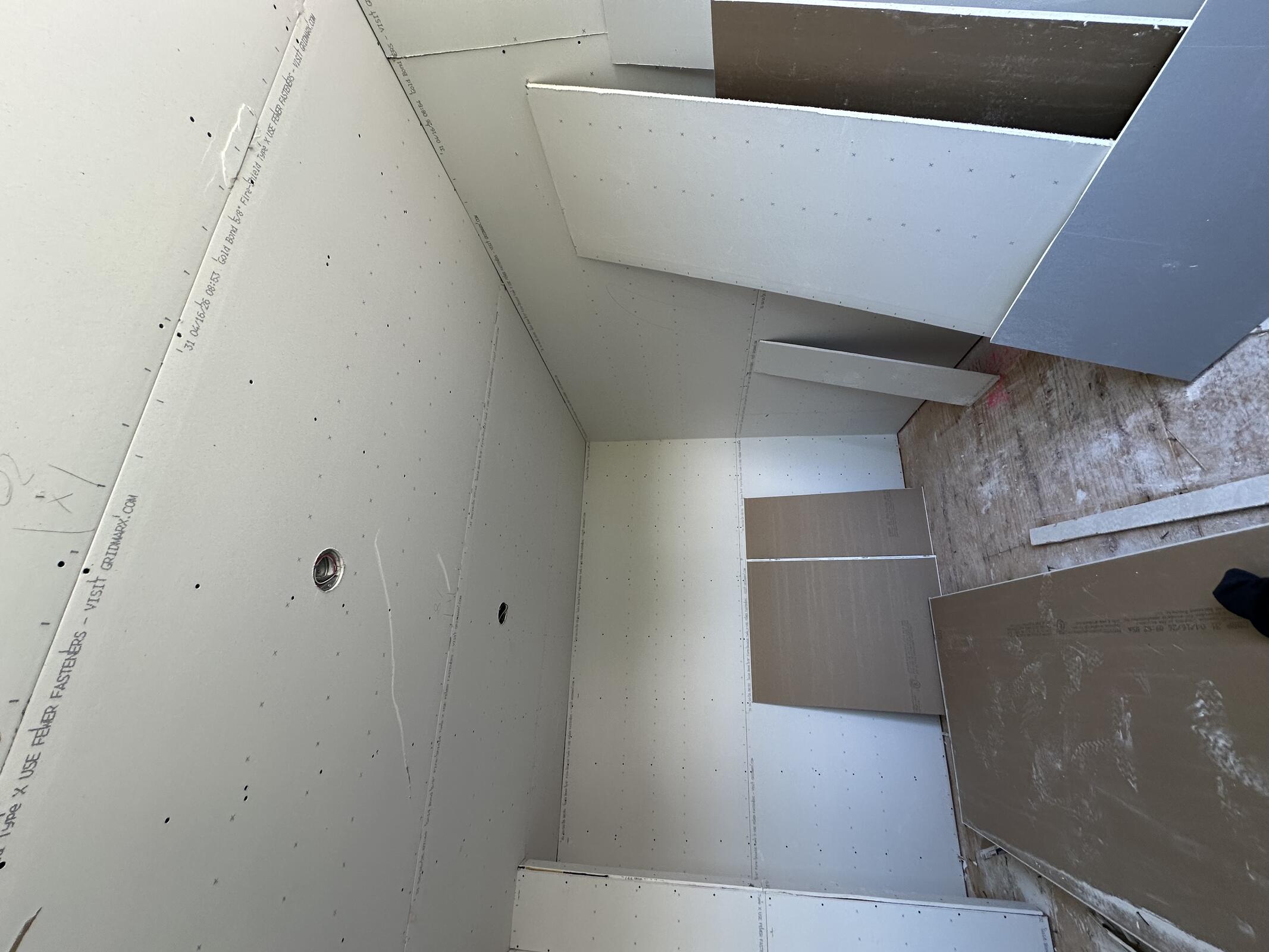

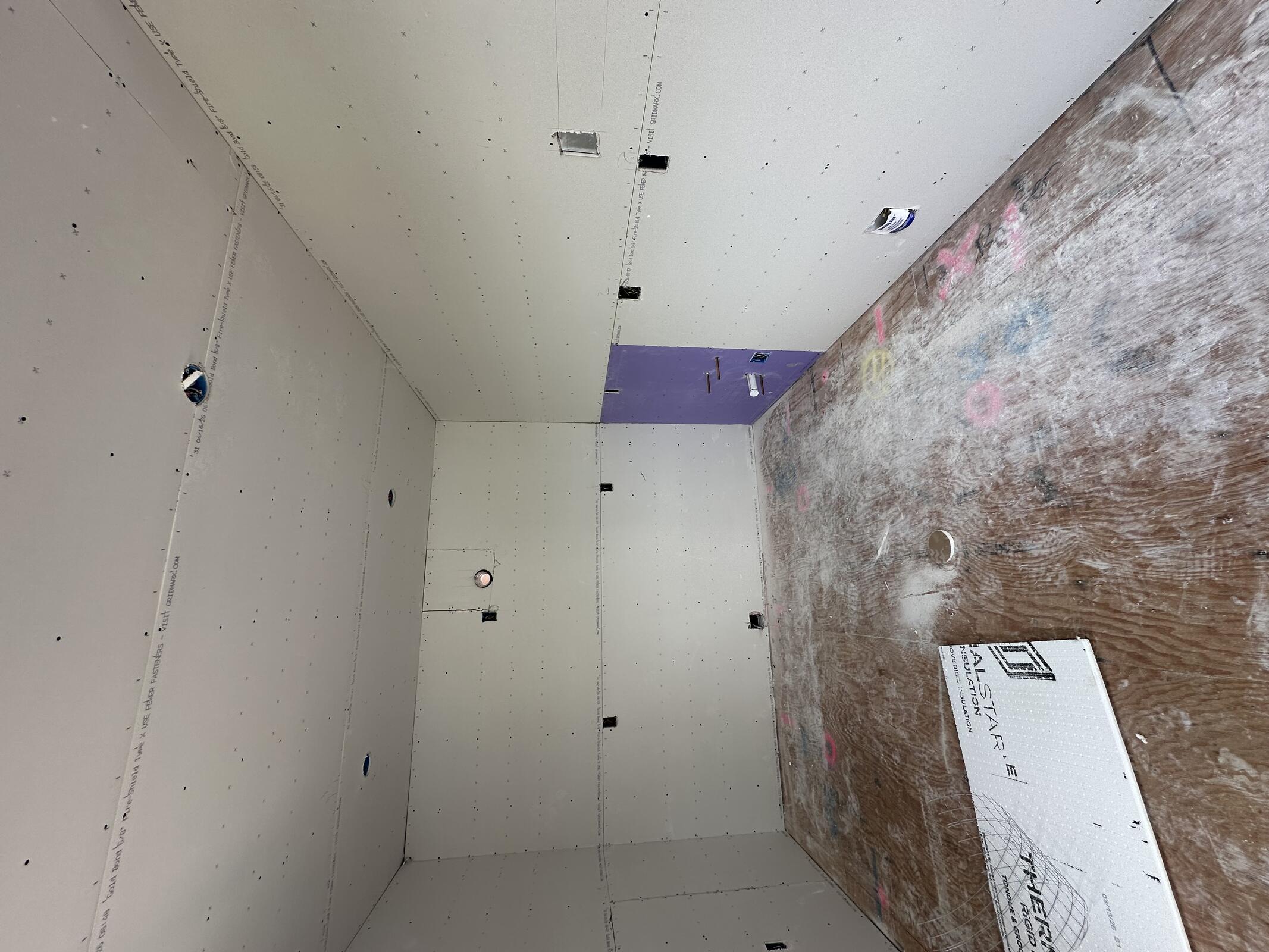

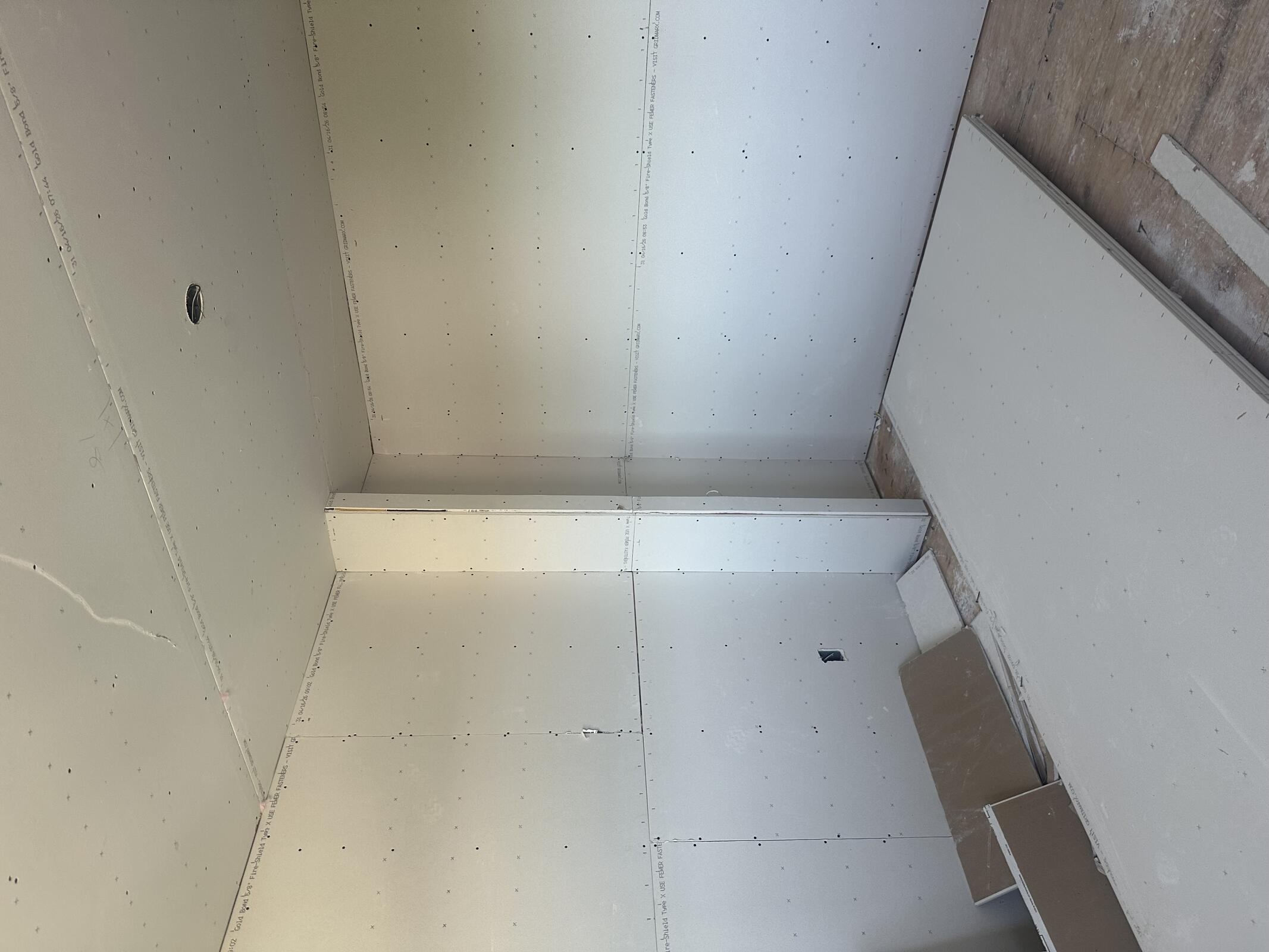

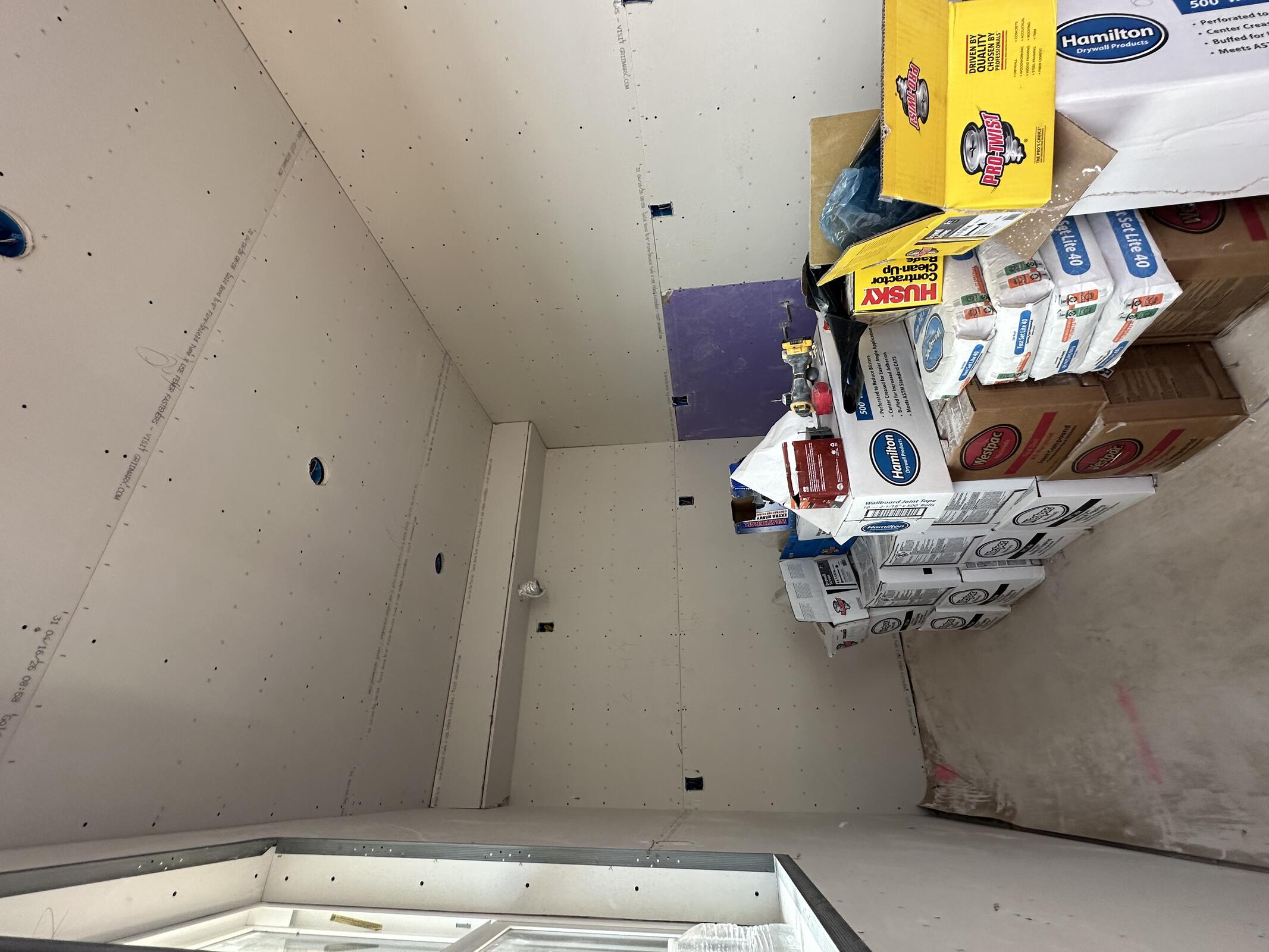

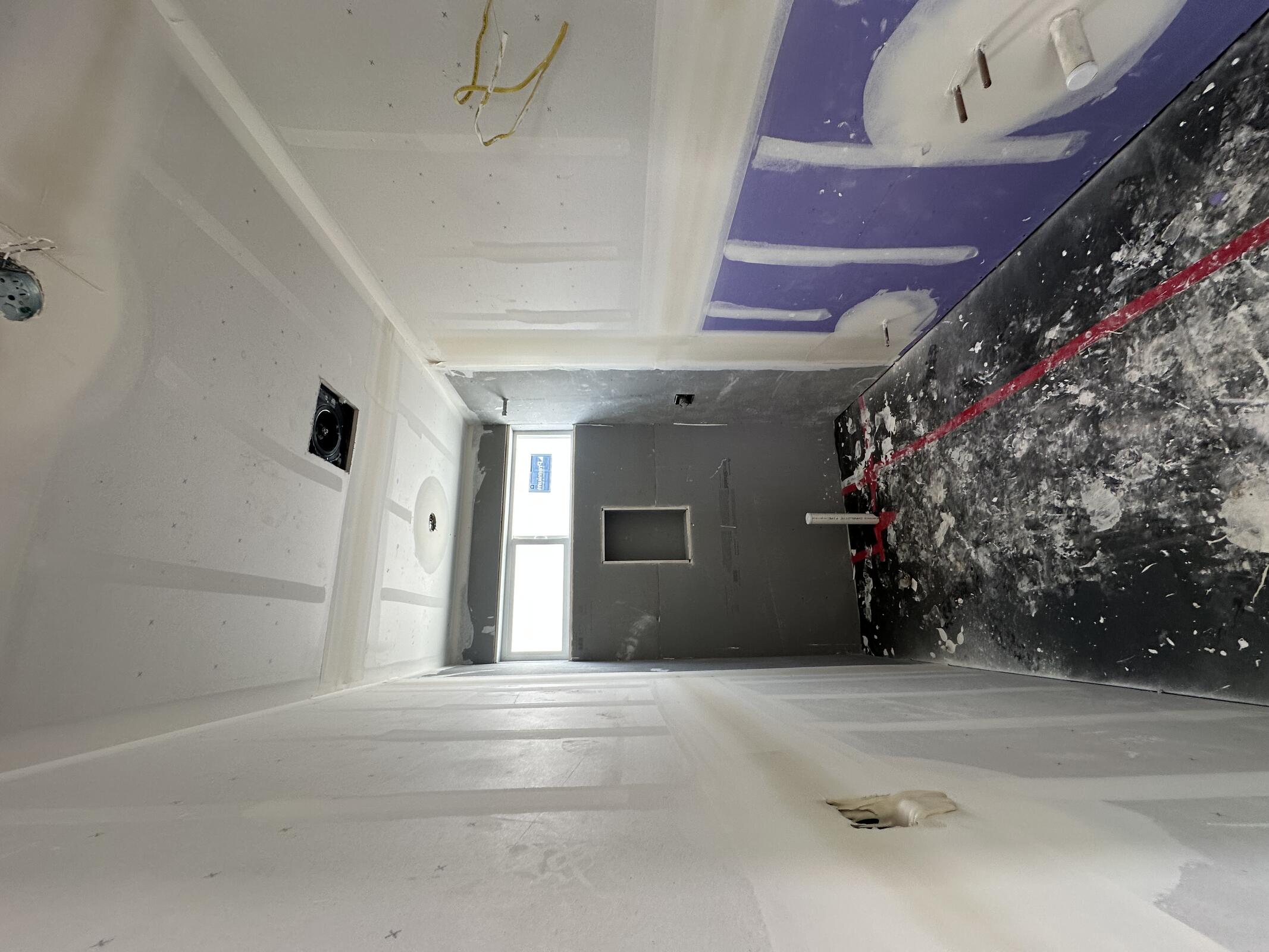

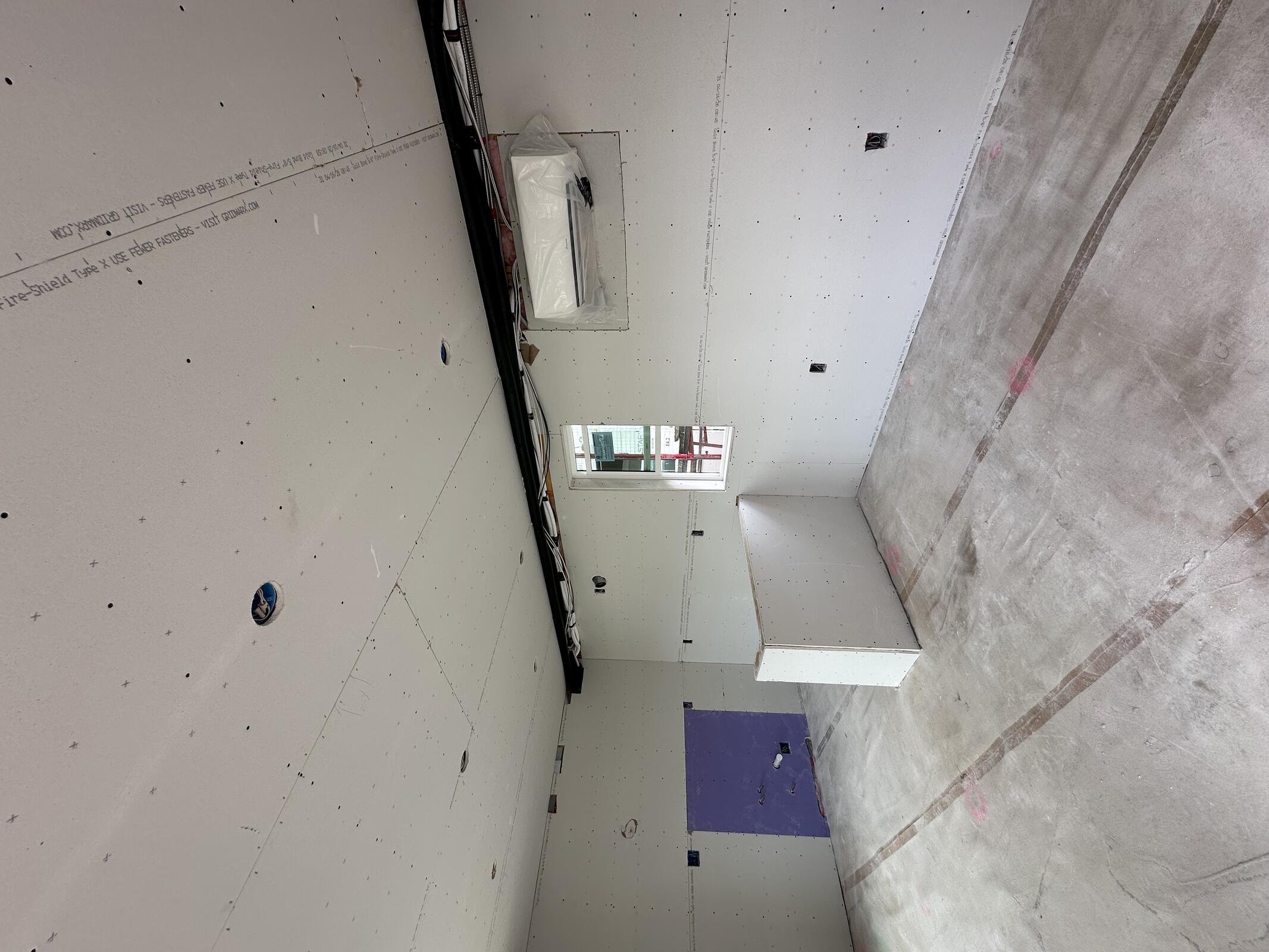

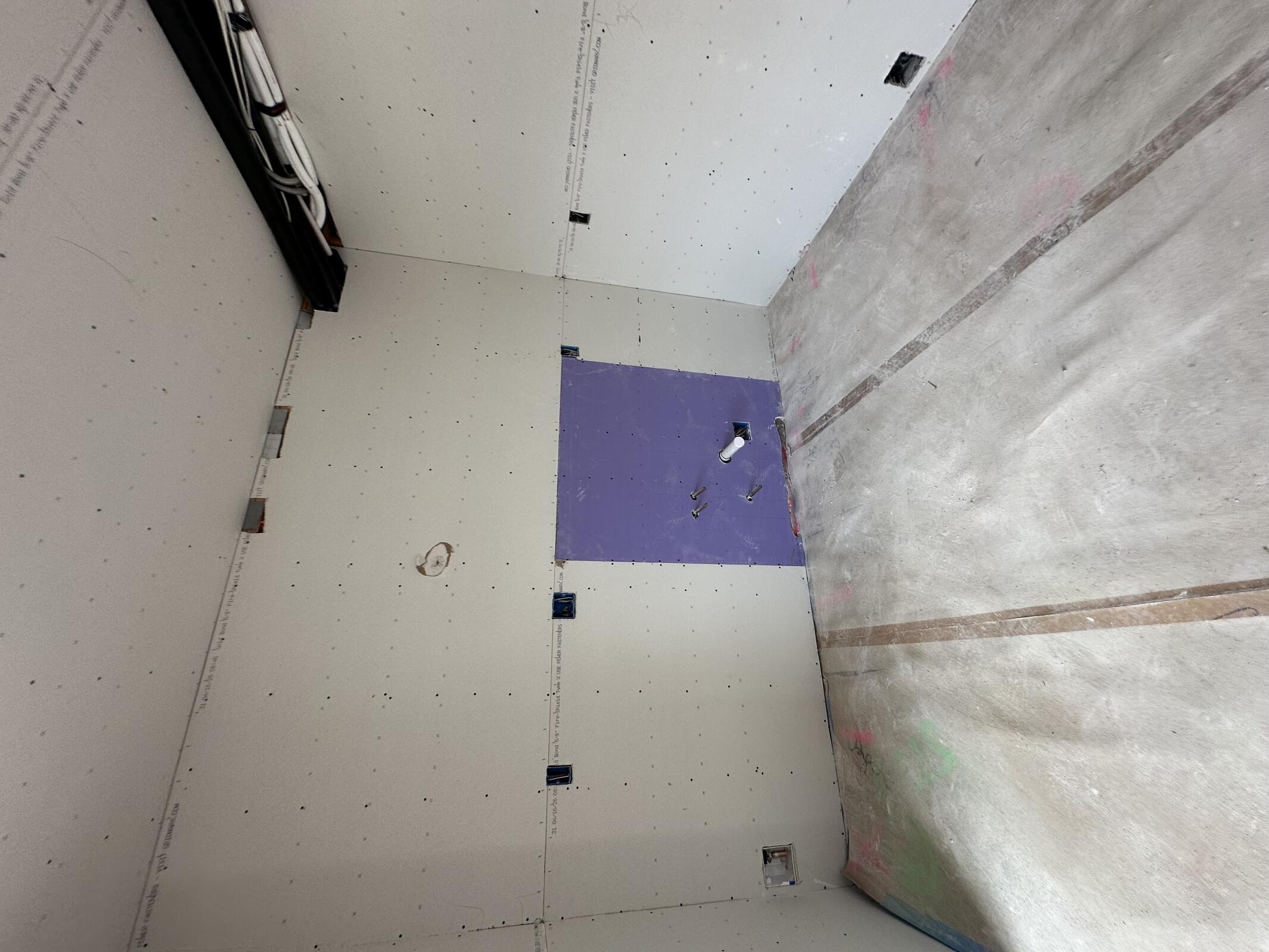

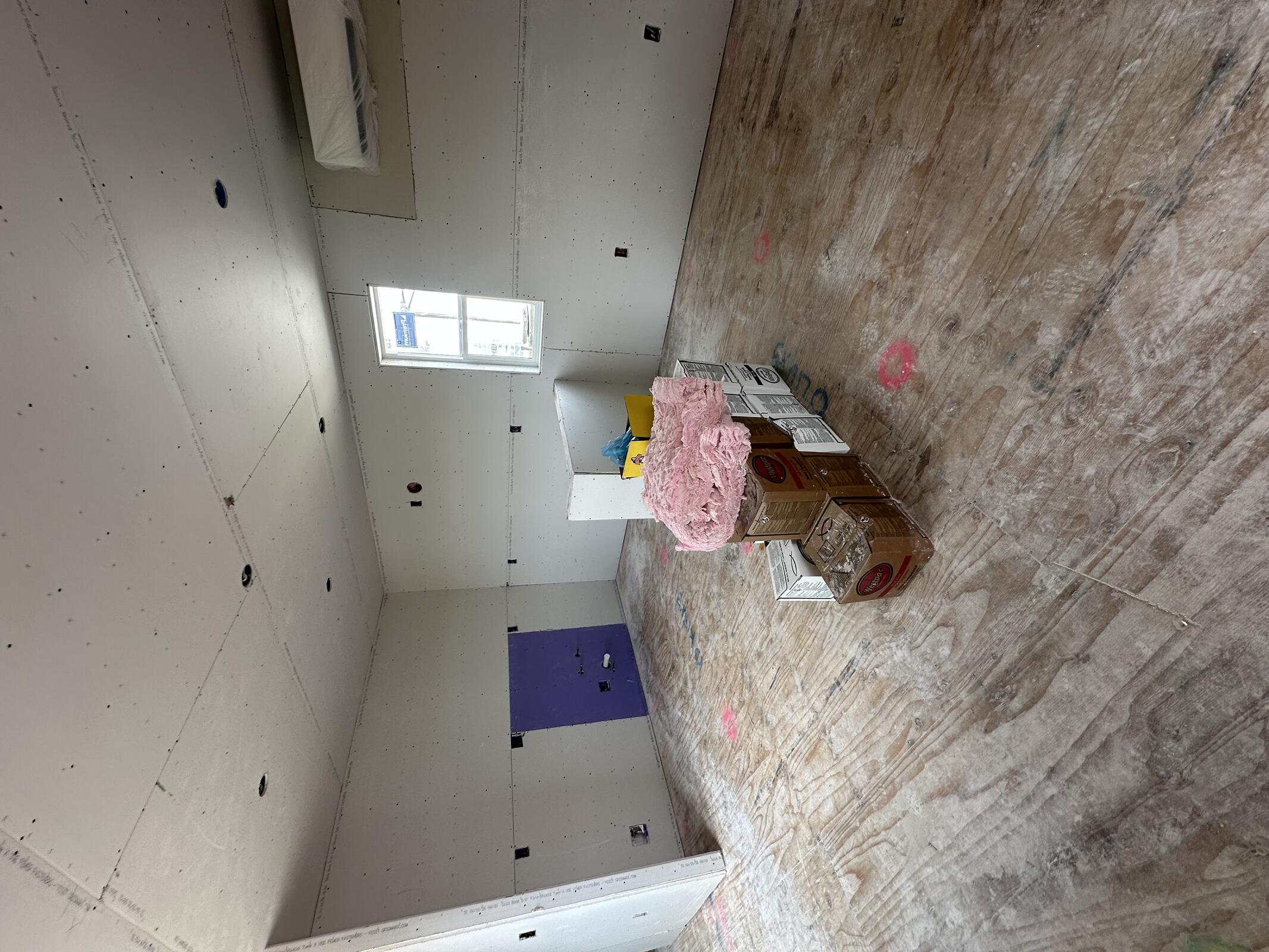

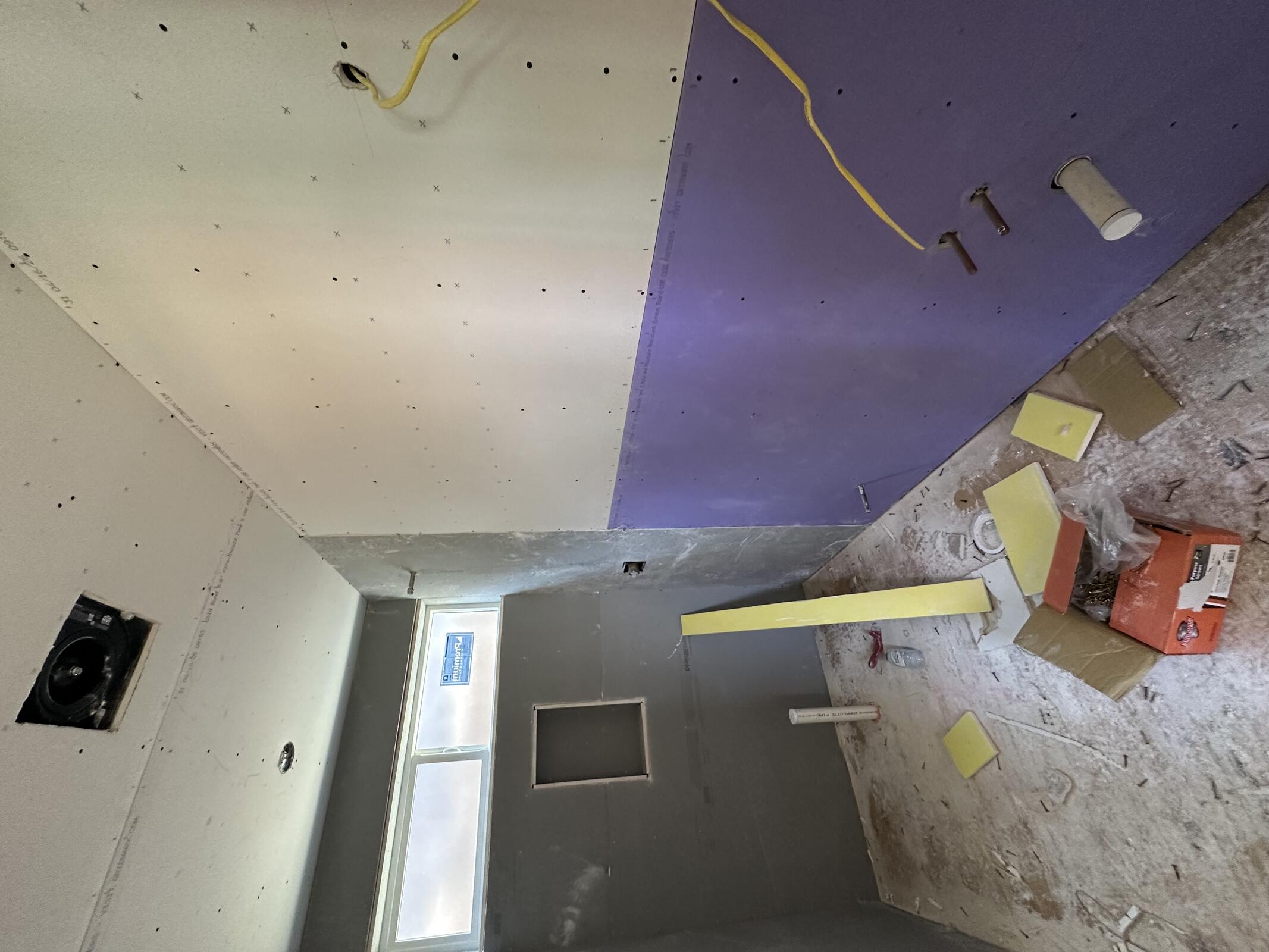

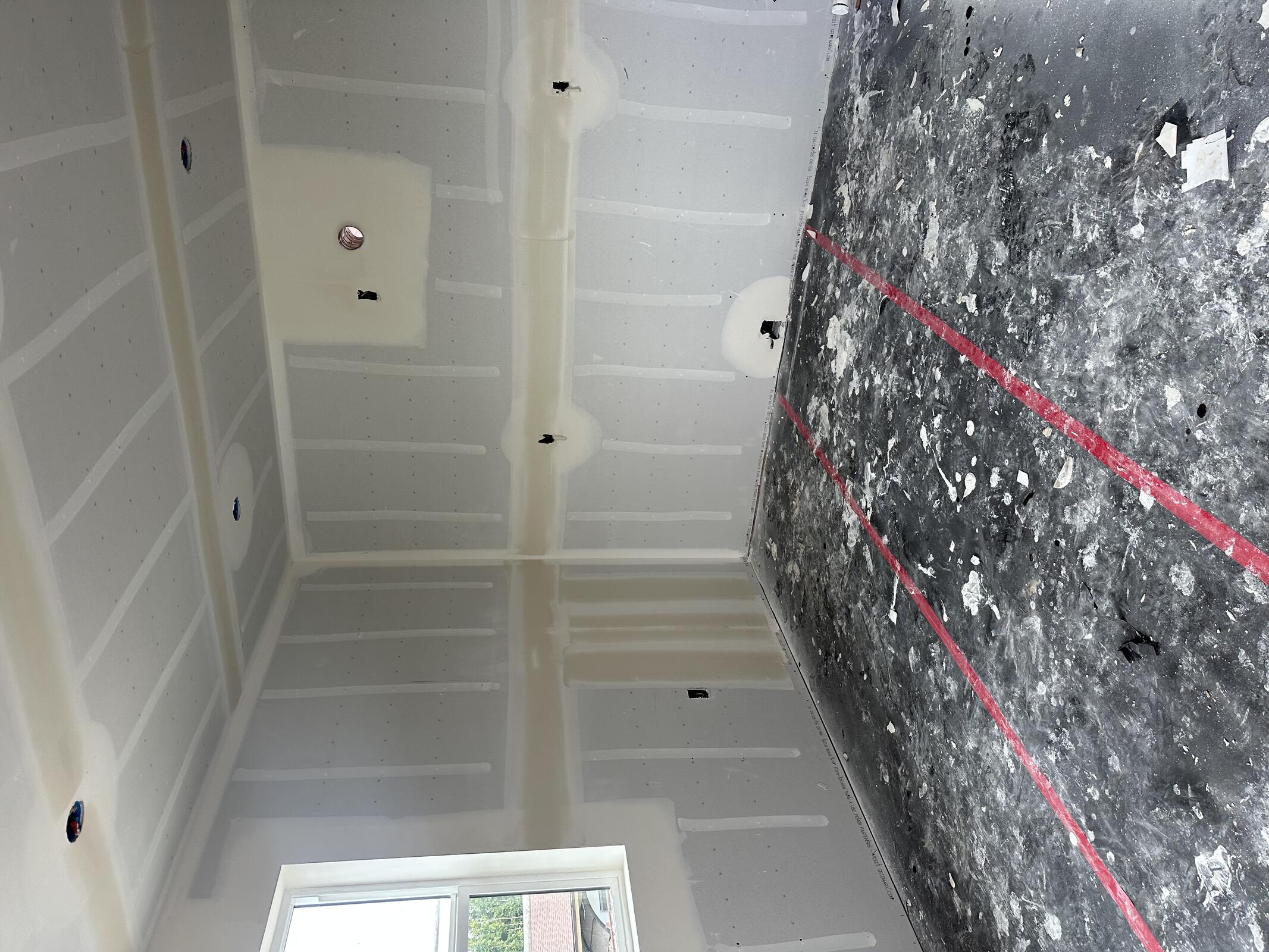

Traditions Drywall hanging drywall in upstairs units.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| Traditions | 4.5 | 8 | 36 |
| JB General | 4 | 8 | 32 |
| Marq | 2 | 8 | 2 |
Inspection: Dave Finney on site around 12:30. Passed underground plumbing at garage.

Tuesday, May 12, 2026
Partially cloudy, 67°F

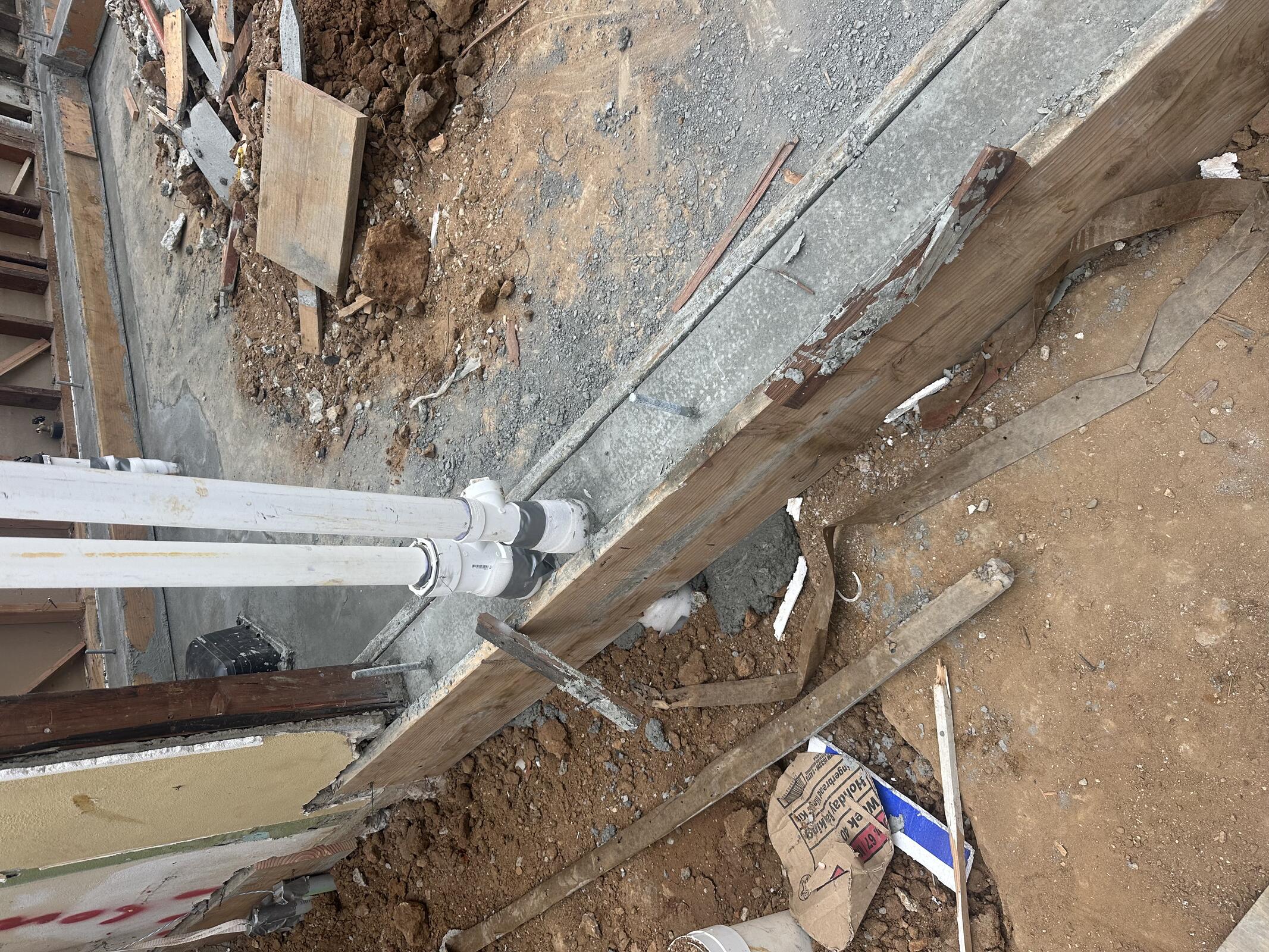

ZSP on site, adjusting drain locations and working on laundry area.

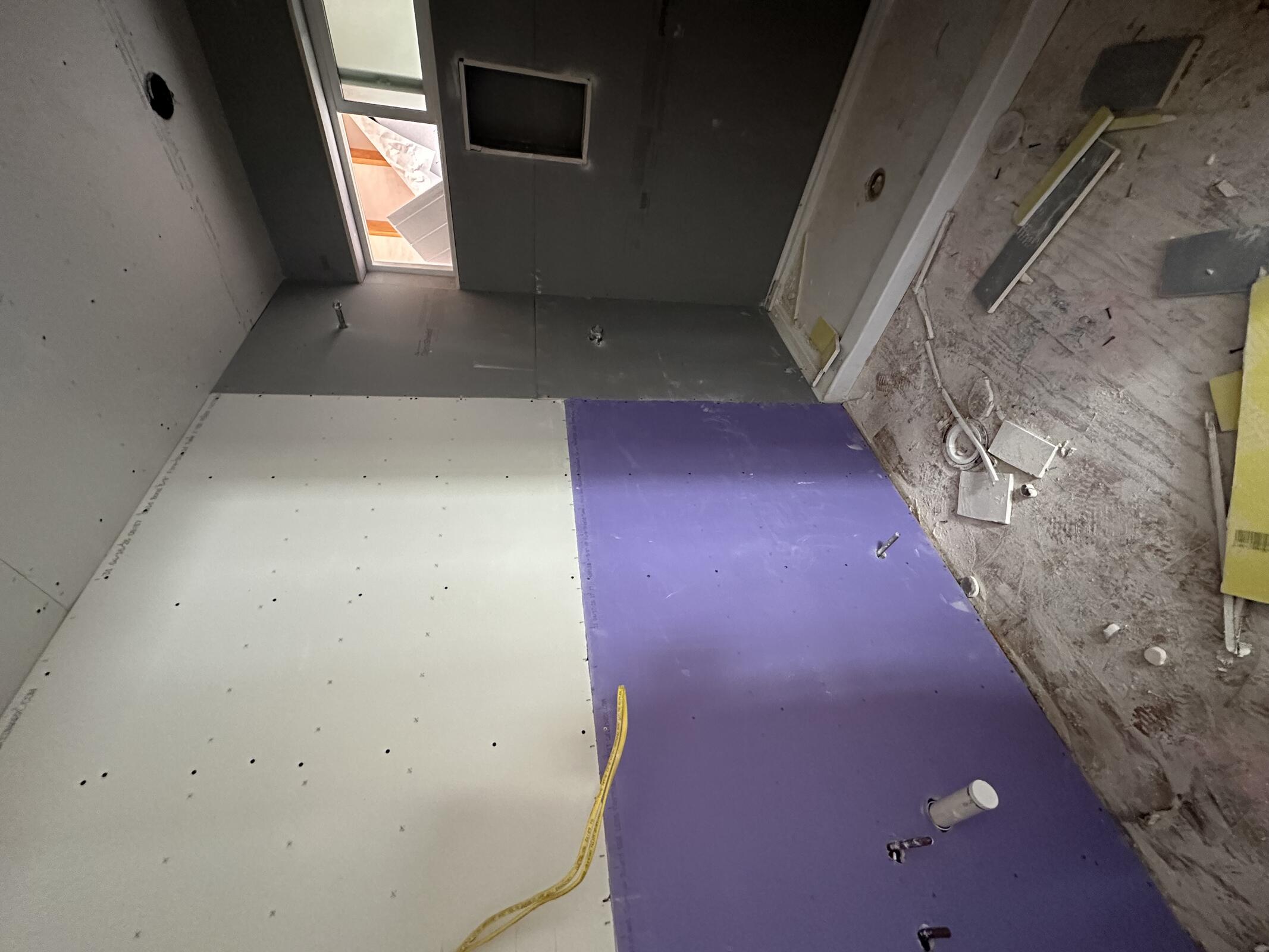

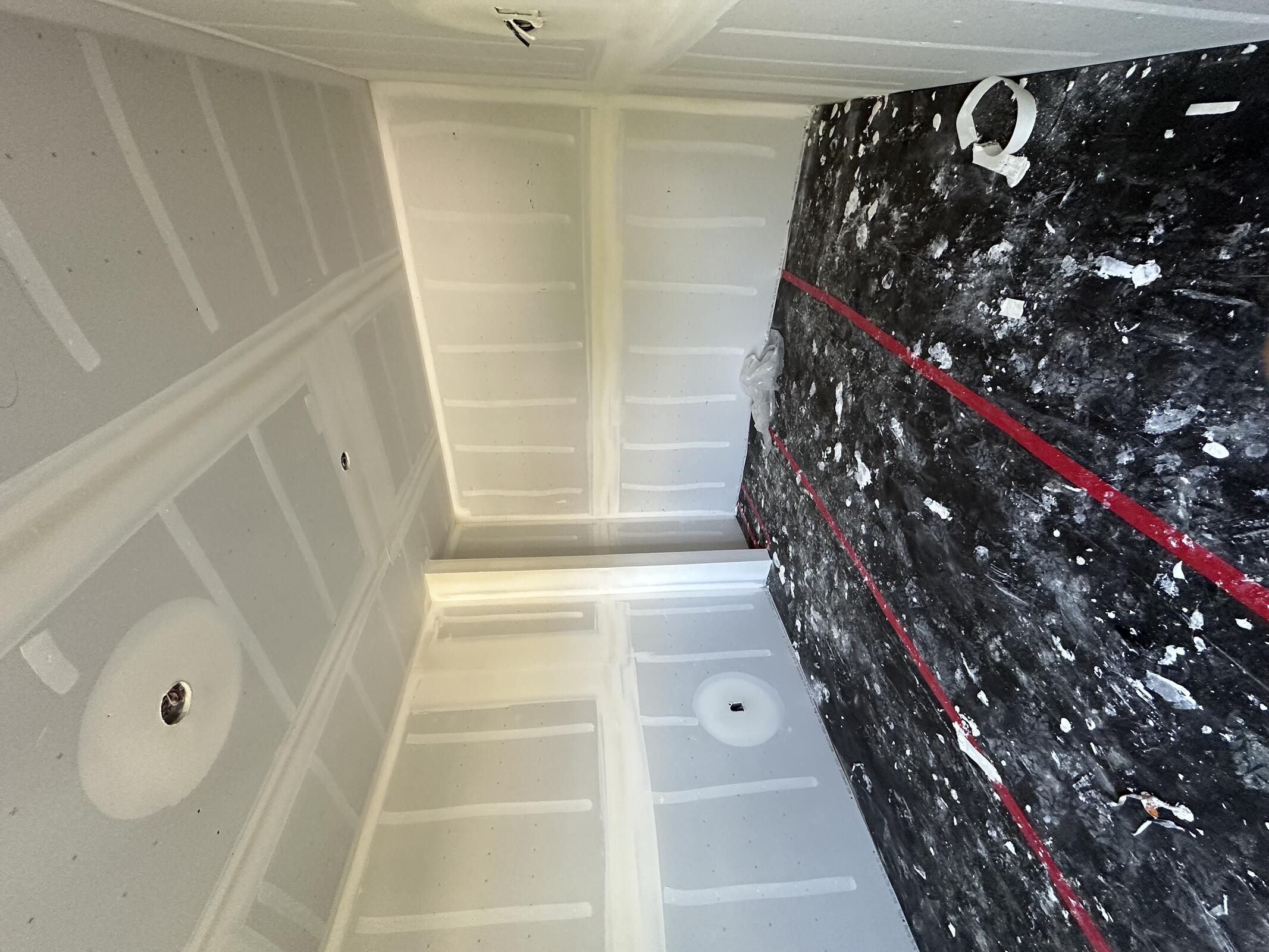

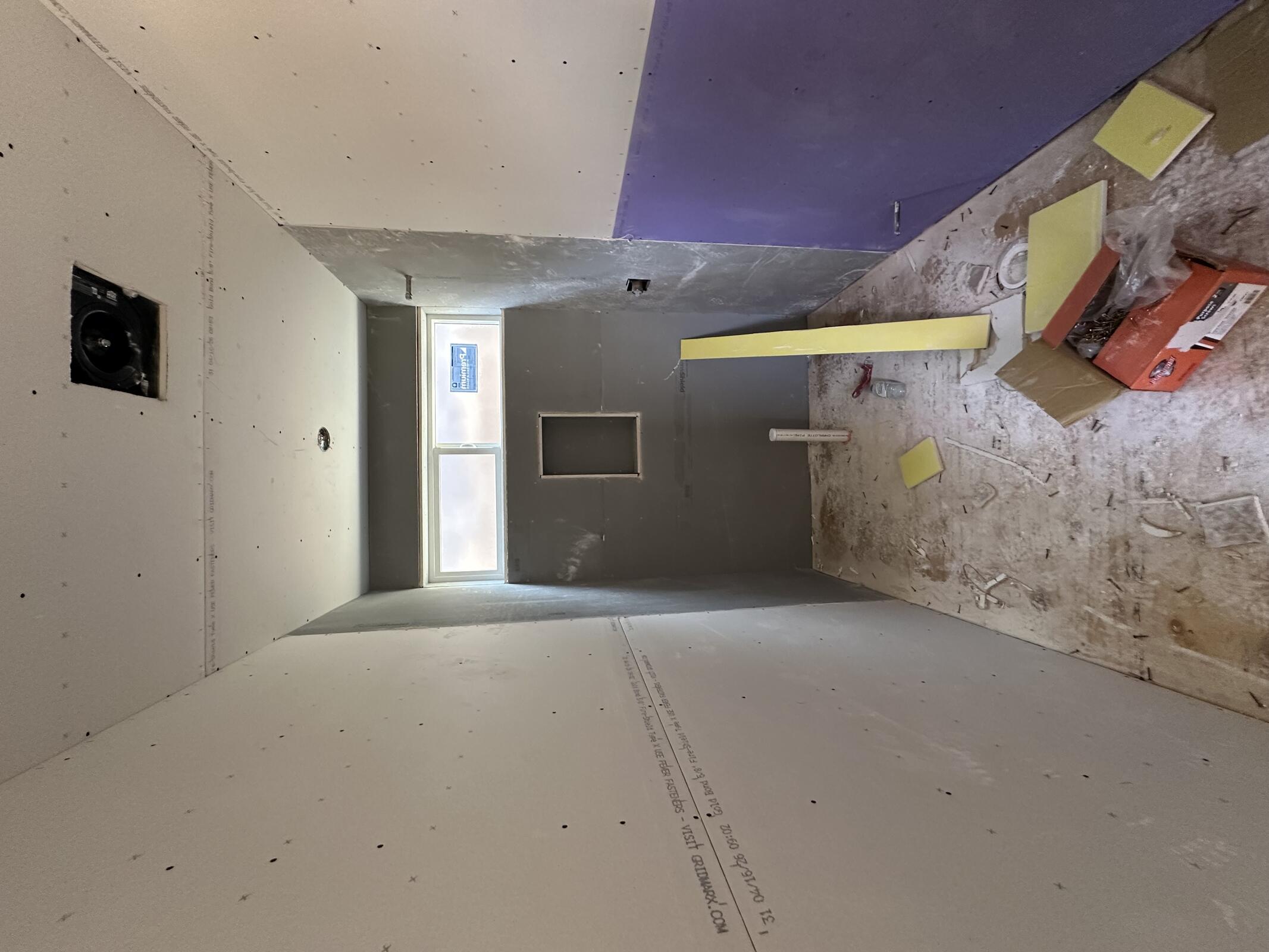

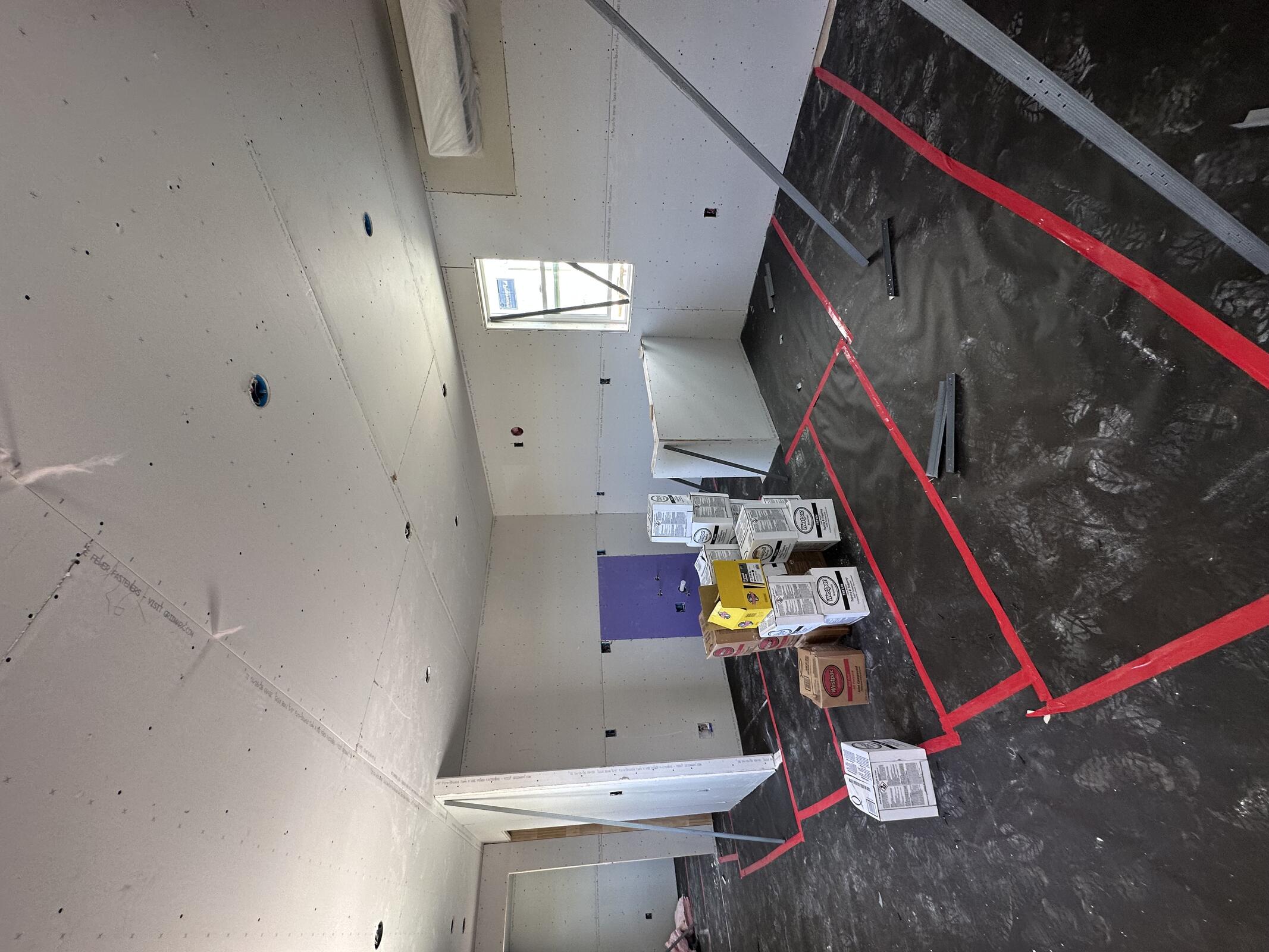

Traditions Drywall finishing hanging drywall in downstairs units and cleaning up.

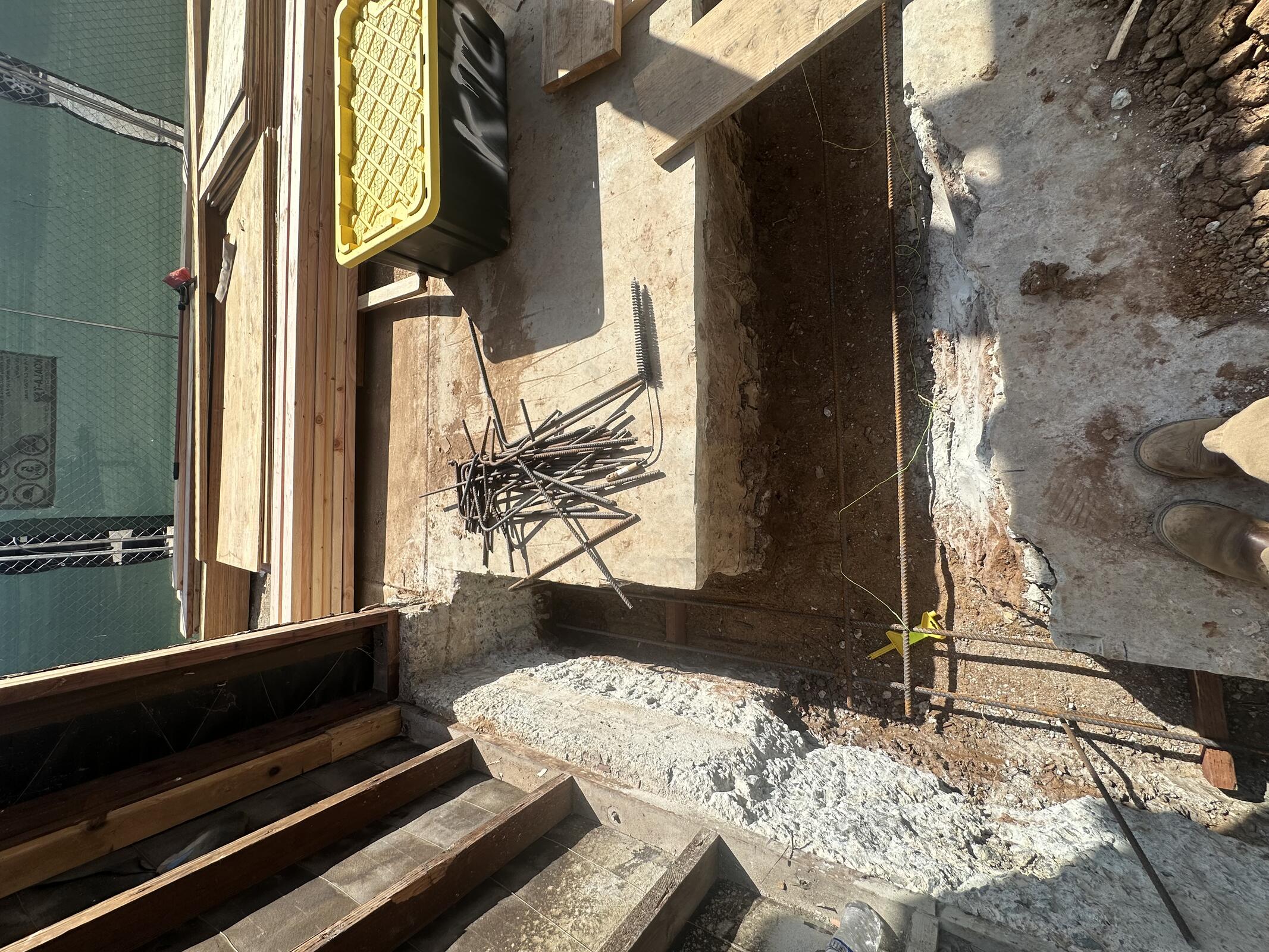

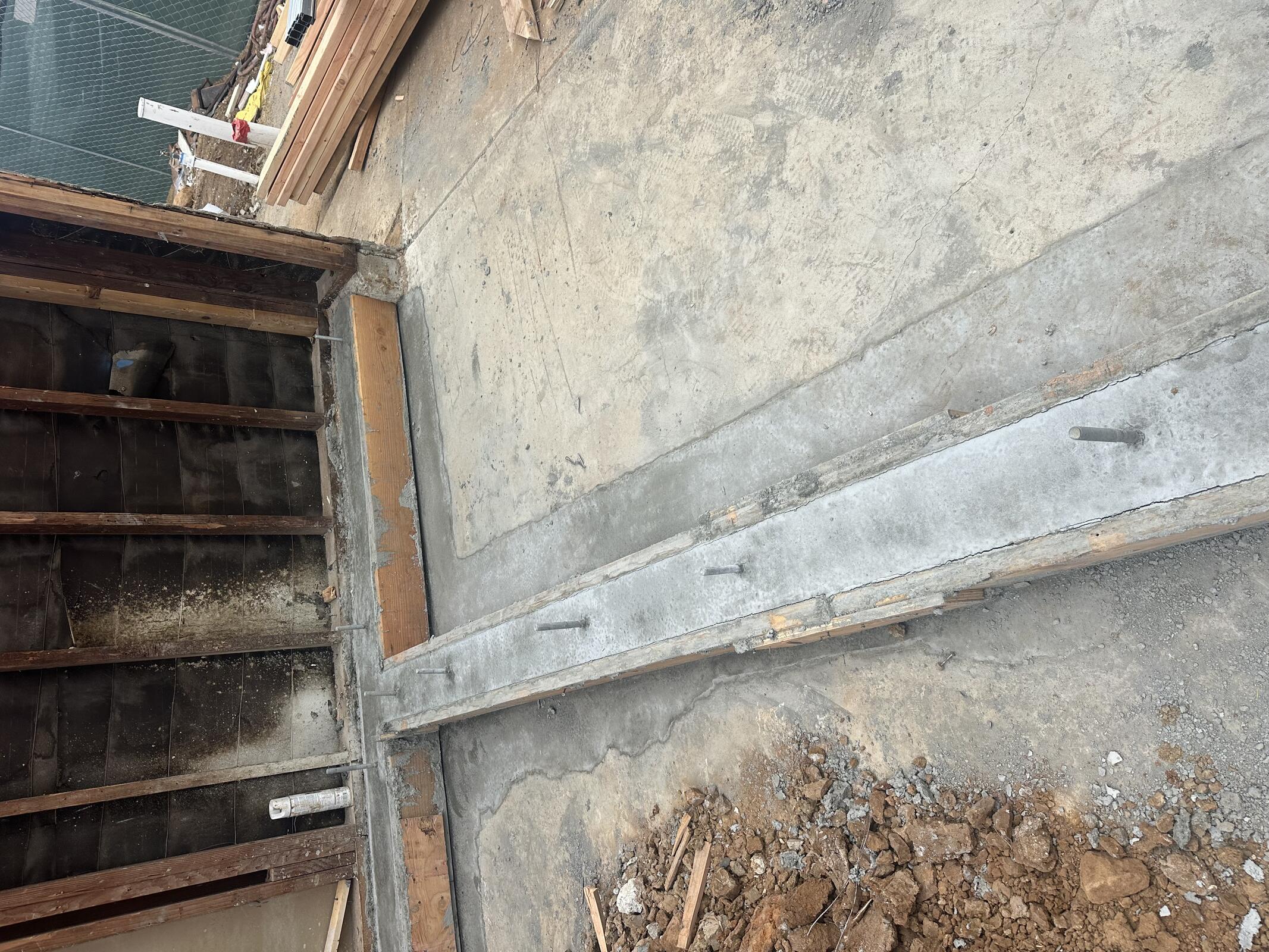

JB General setting rebar and dowels in garage footings. Inspection at 1:30 PM. Poured at 2:15 PM.

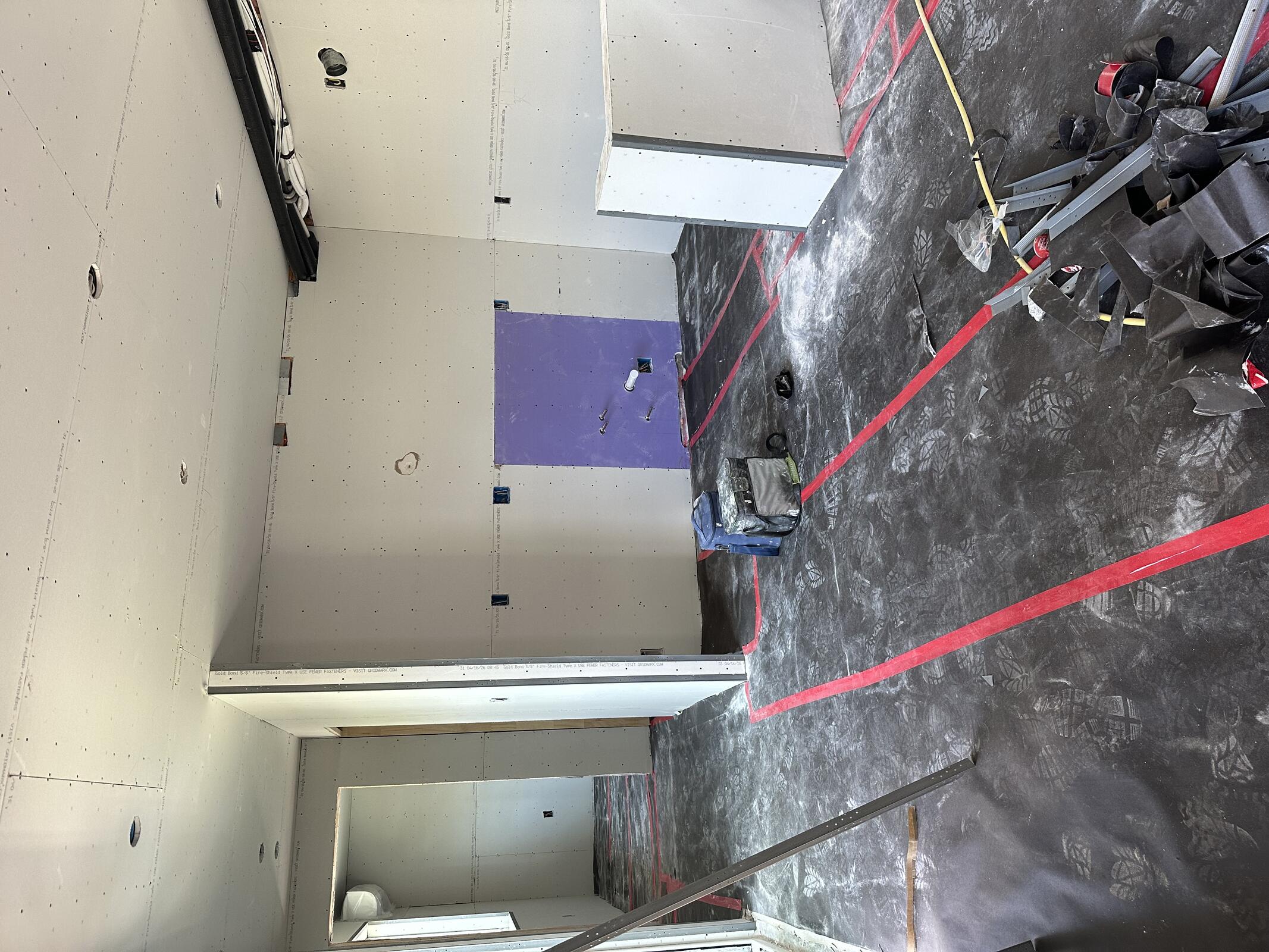

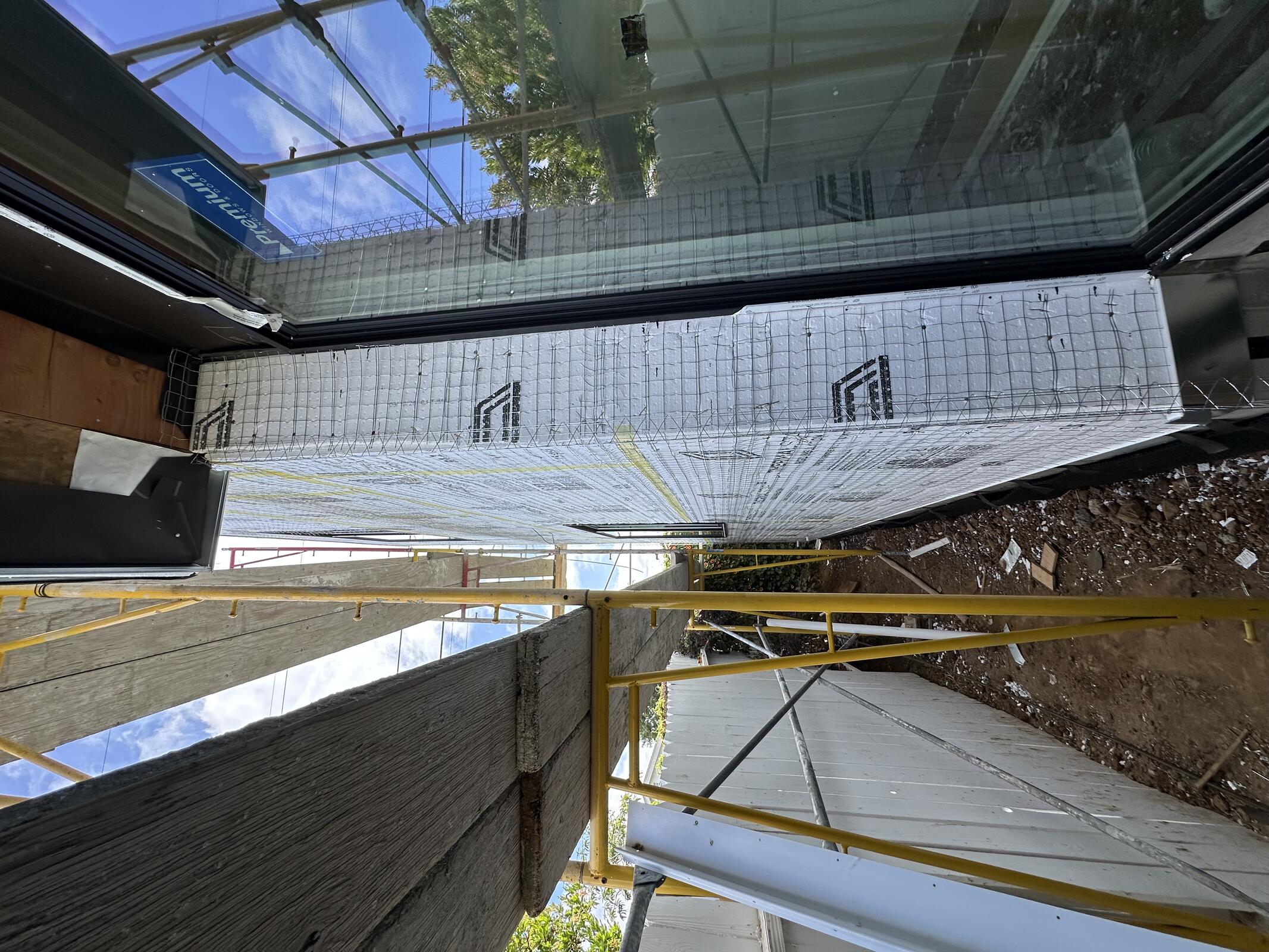

Marq Plastering installing lath on B and C.

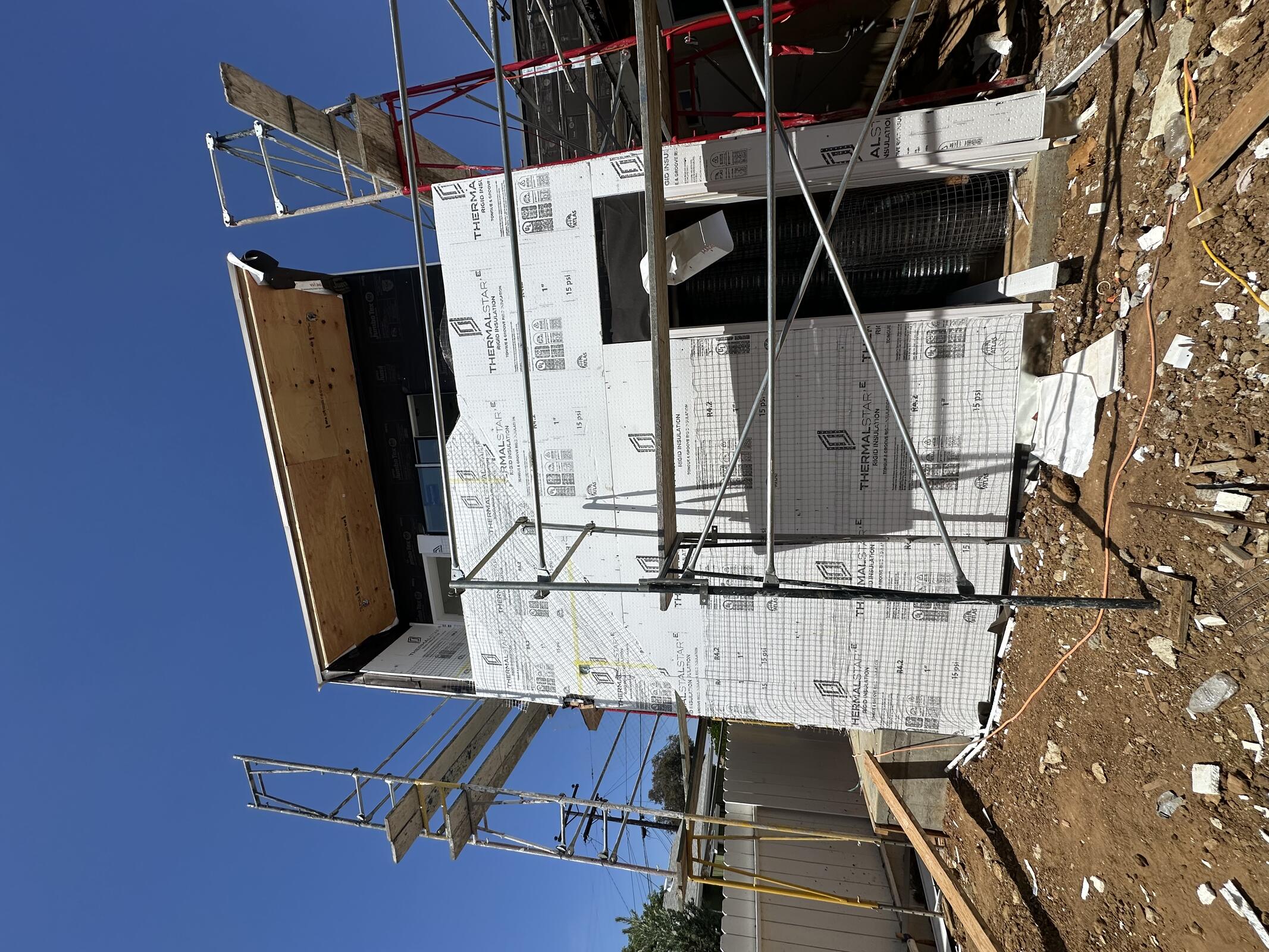

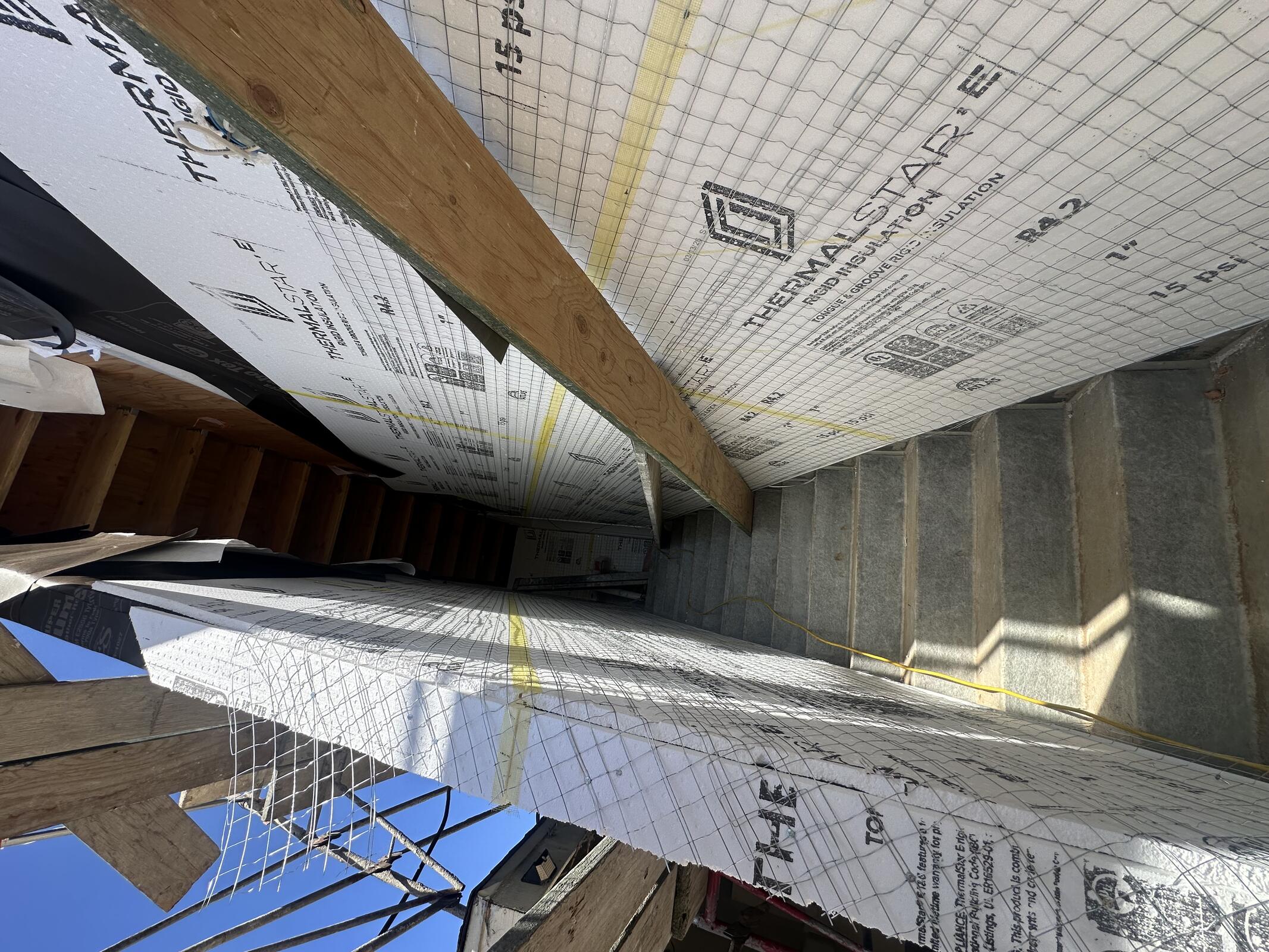

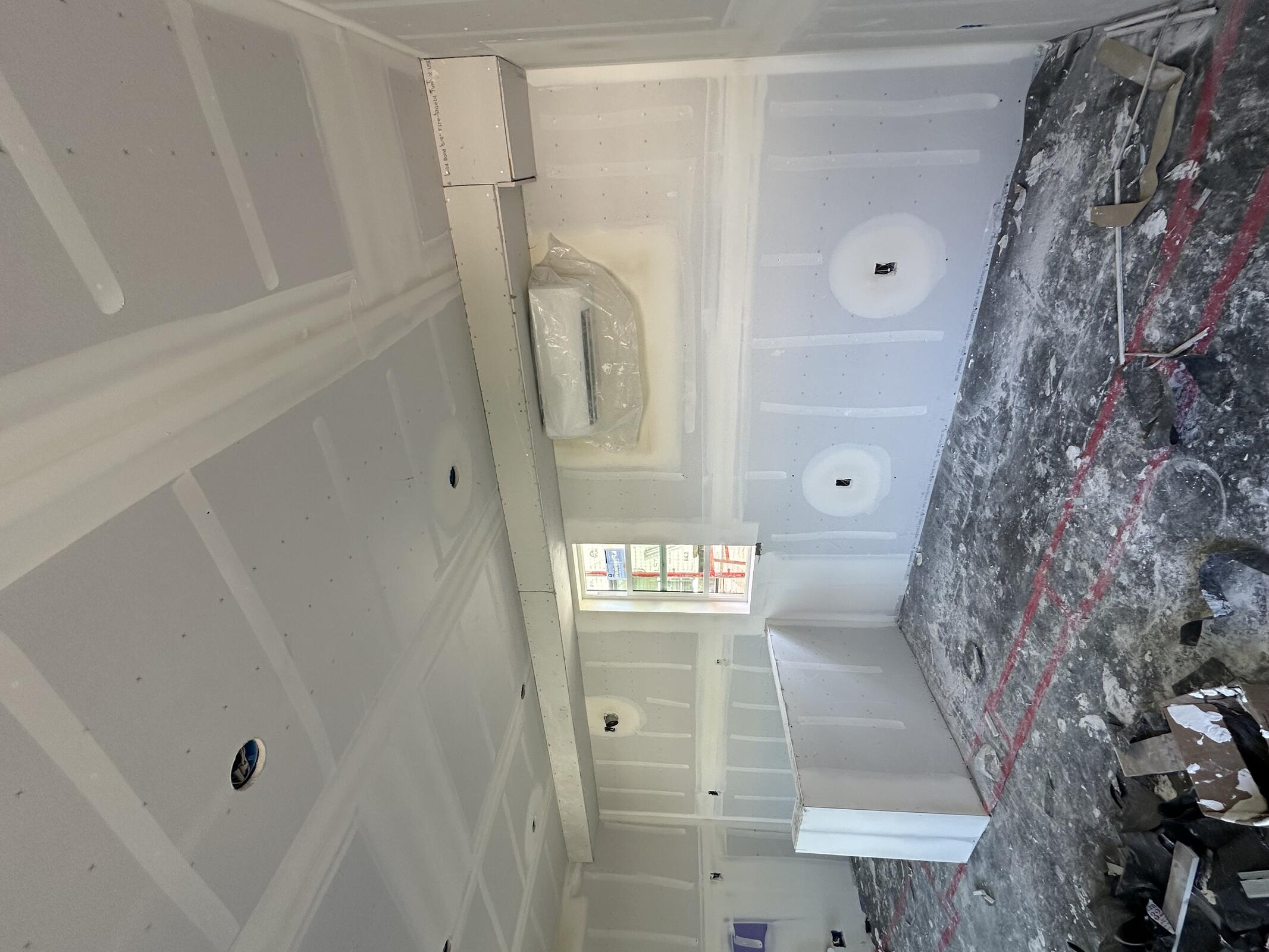

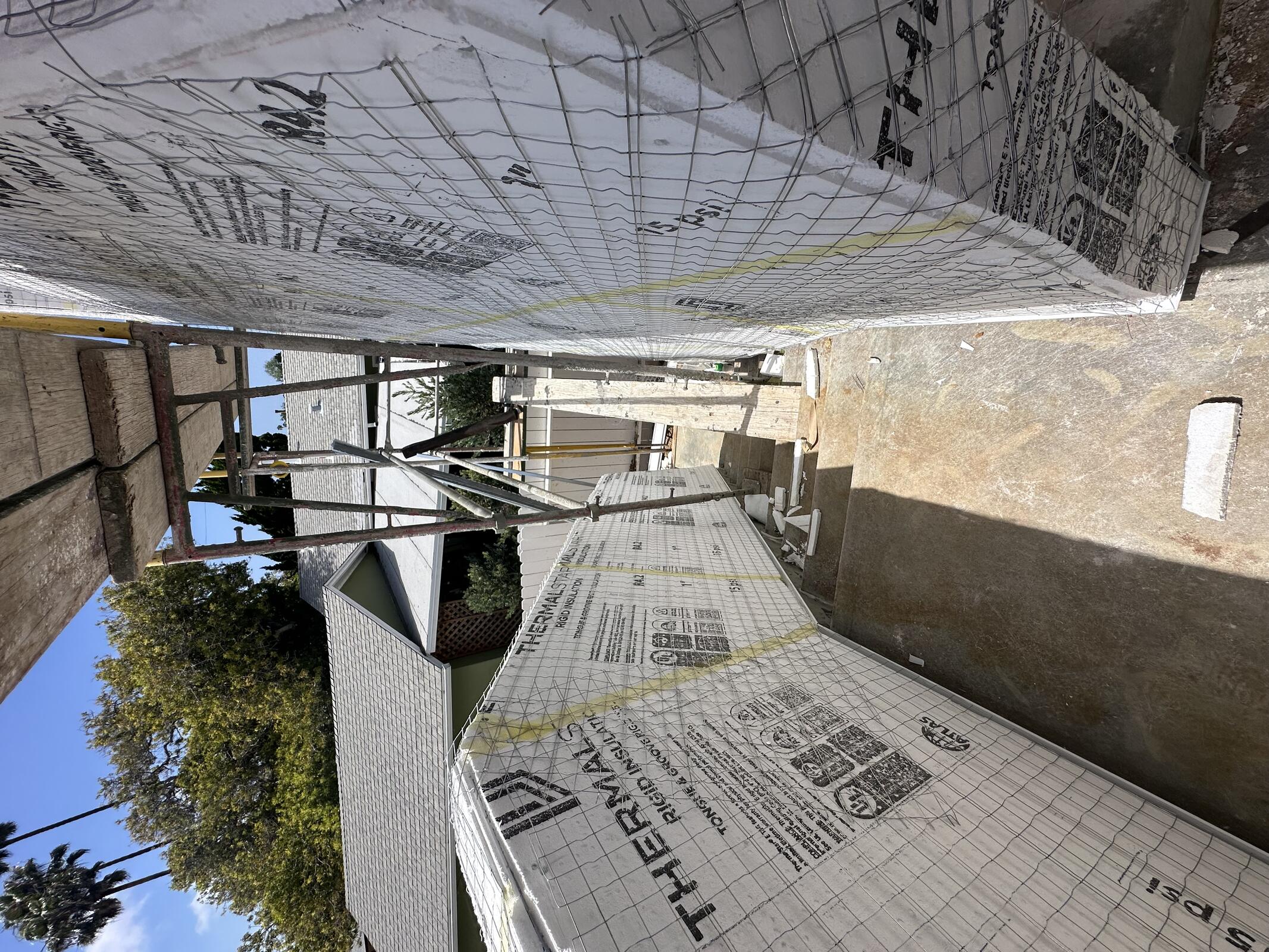

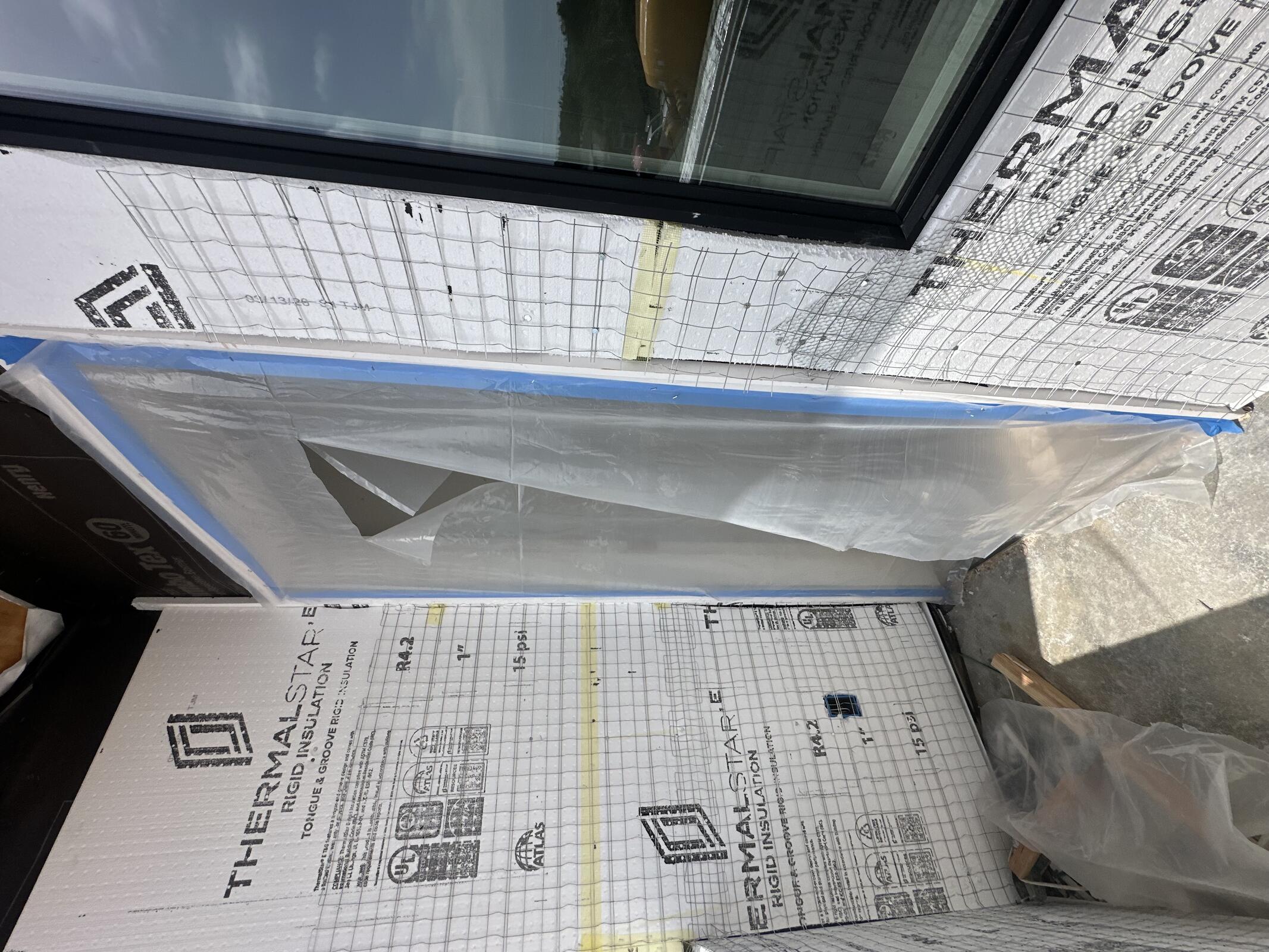

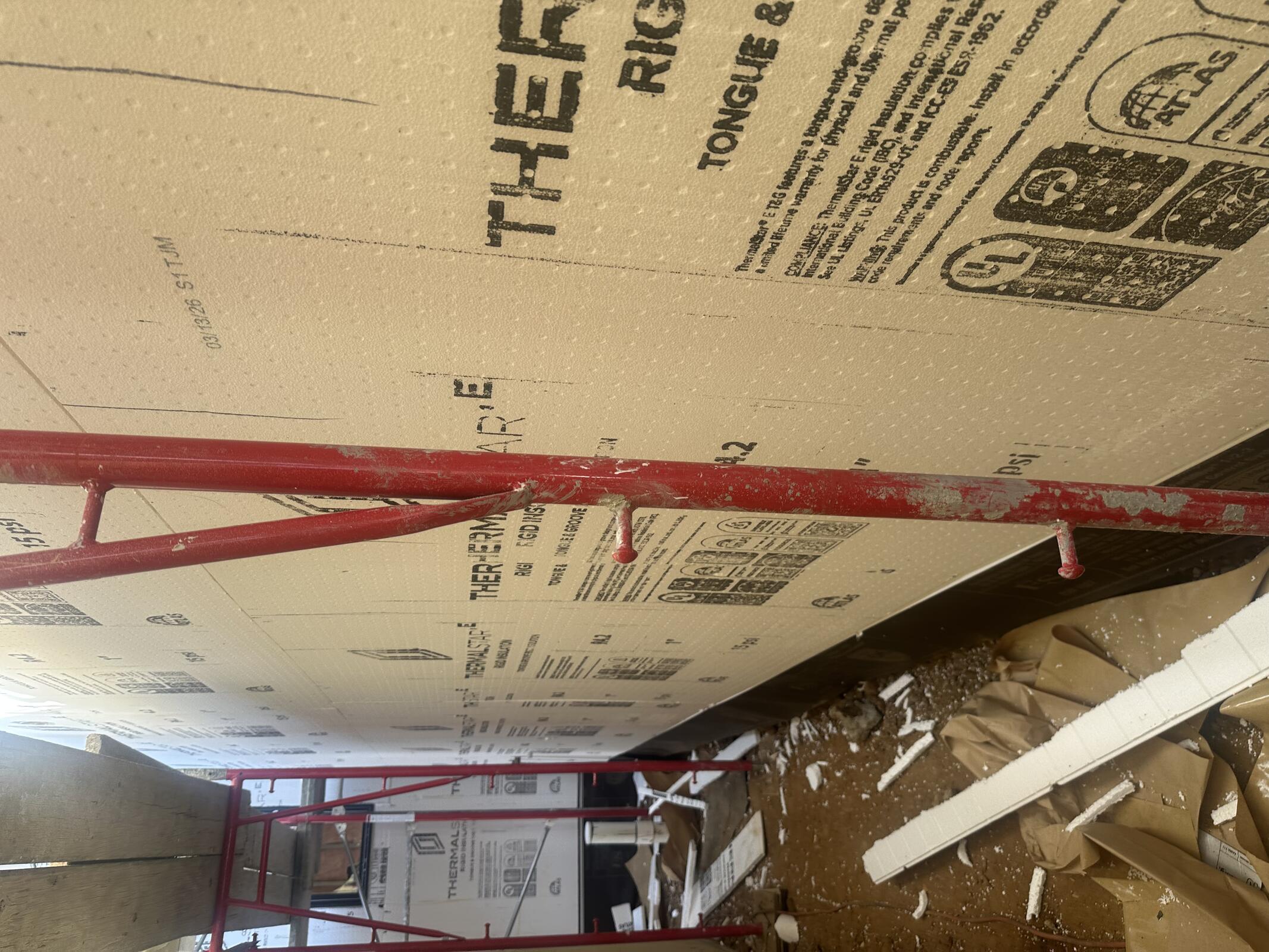

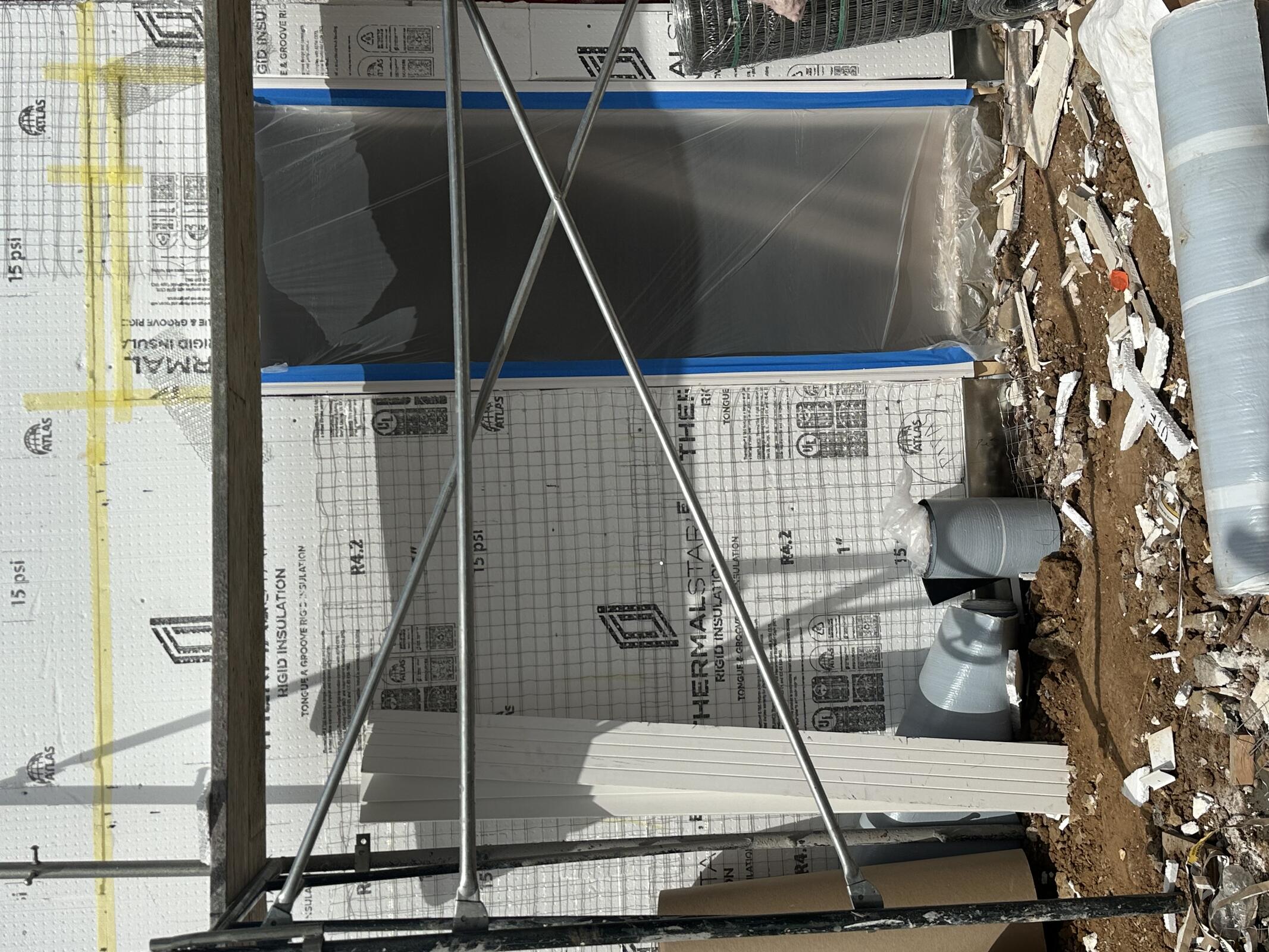

Clear HVAC adding backing to vents to account for one-coat stucco system. Installing ducting for kitchen vents.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| ZSP | 2 | 8 | 16 |
| JB General | 3 | 8 | 24 |
| Marq | 2 | 8 | 16 |
| Clear HVAC | 1 | 4 | 4 |
| Traditions | 6 | 8 | 48 |
Inspection: Rebar inspection at Garage Conversion. Partial pass pending special inspection report.

Wednesday, May 13, 2026
Overcast, 66°F

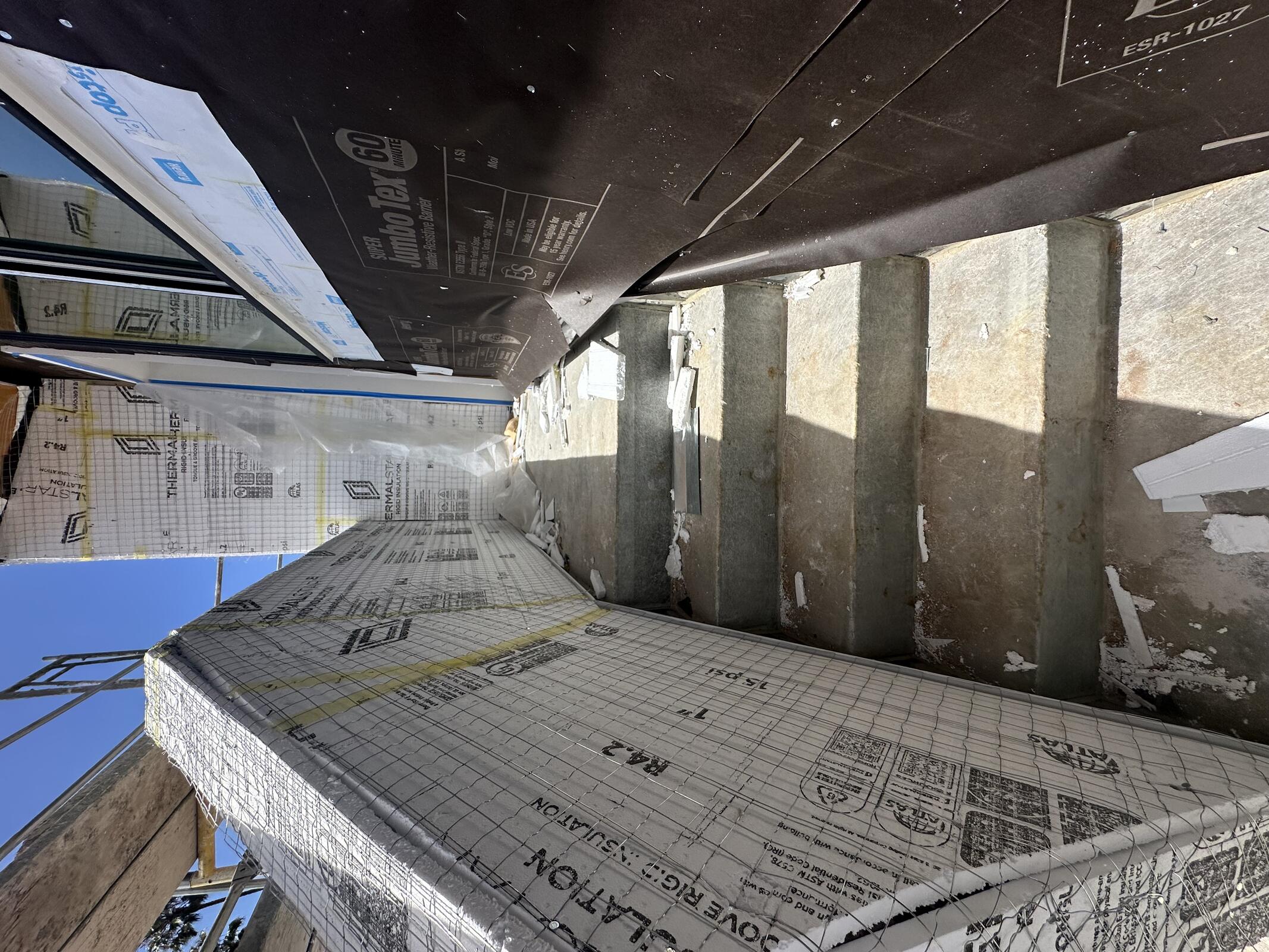

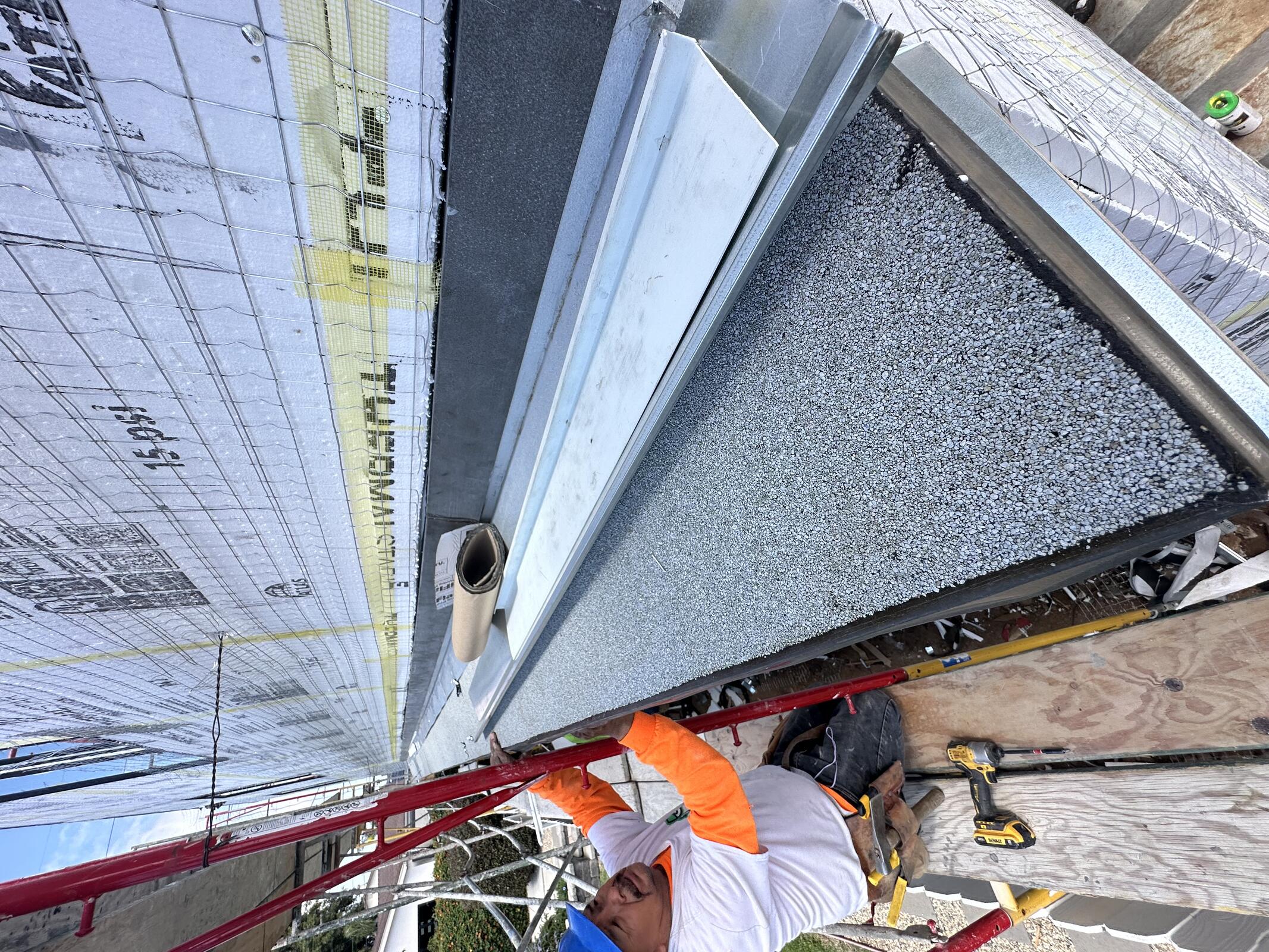

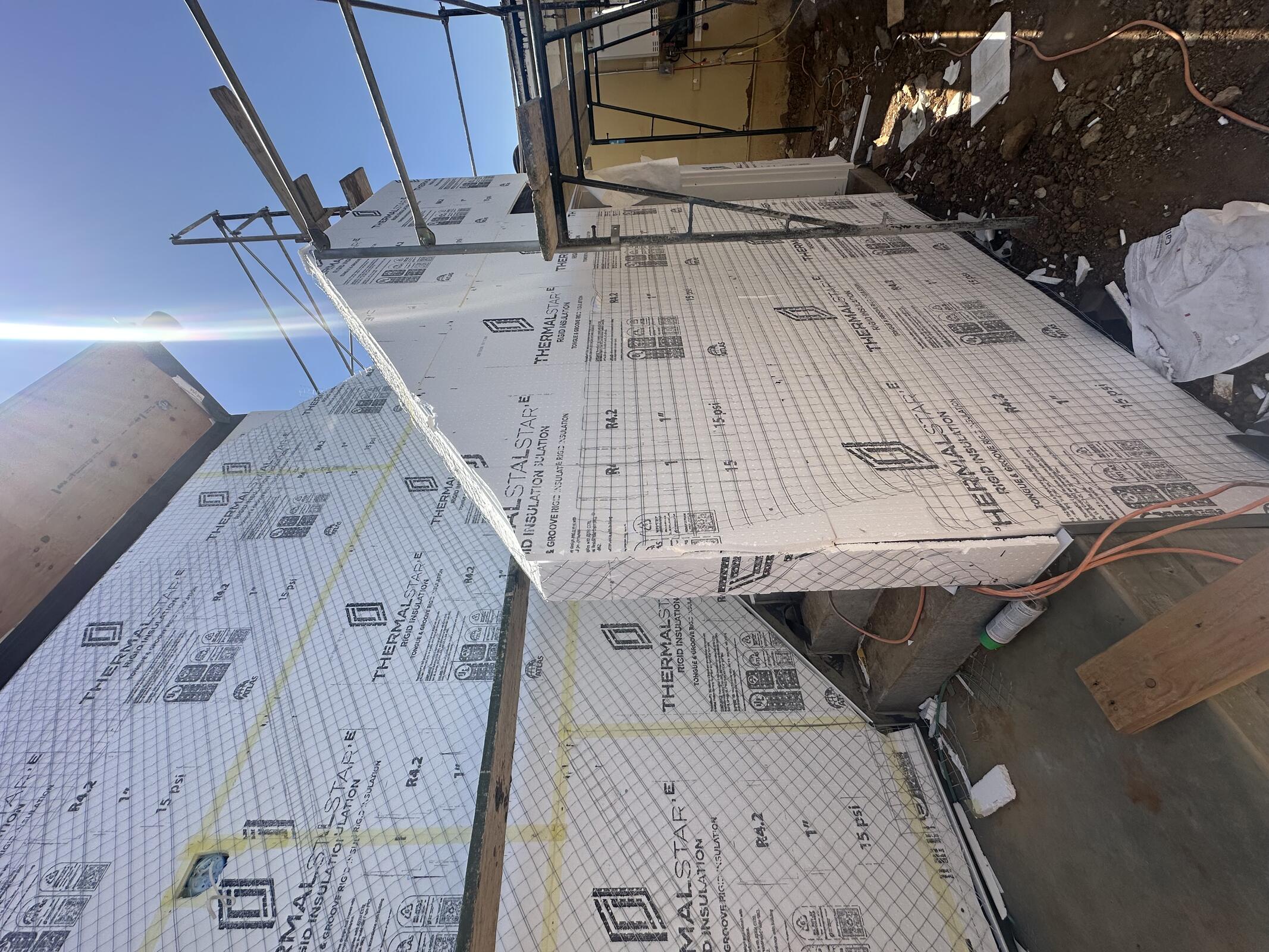

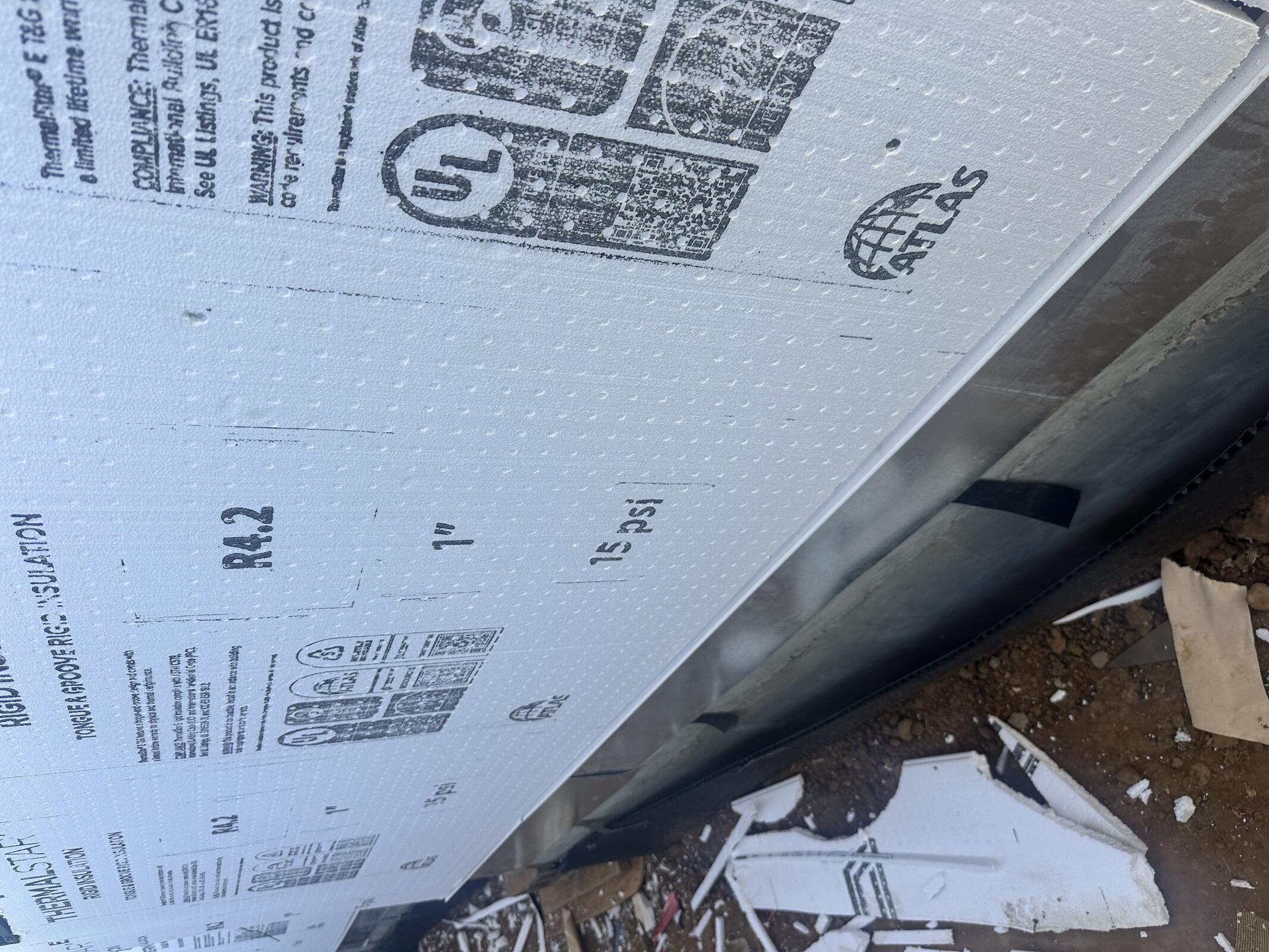

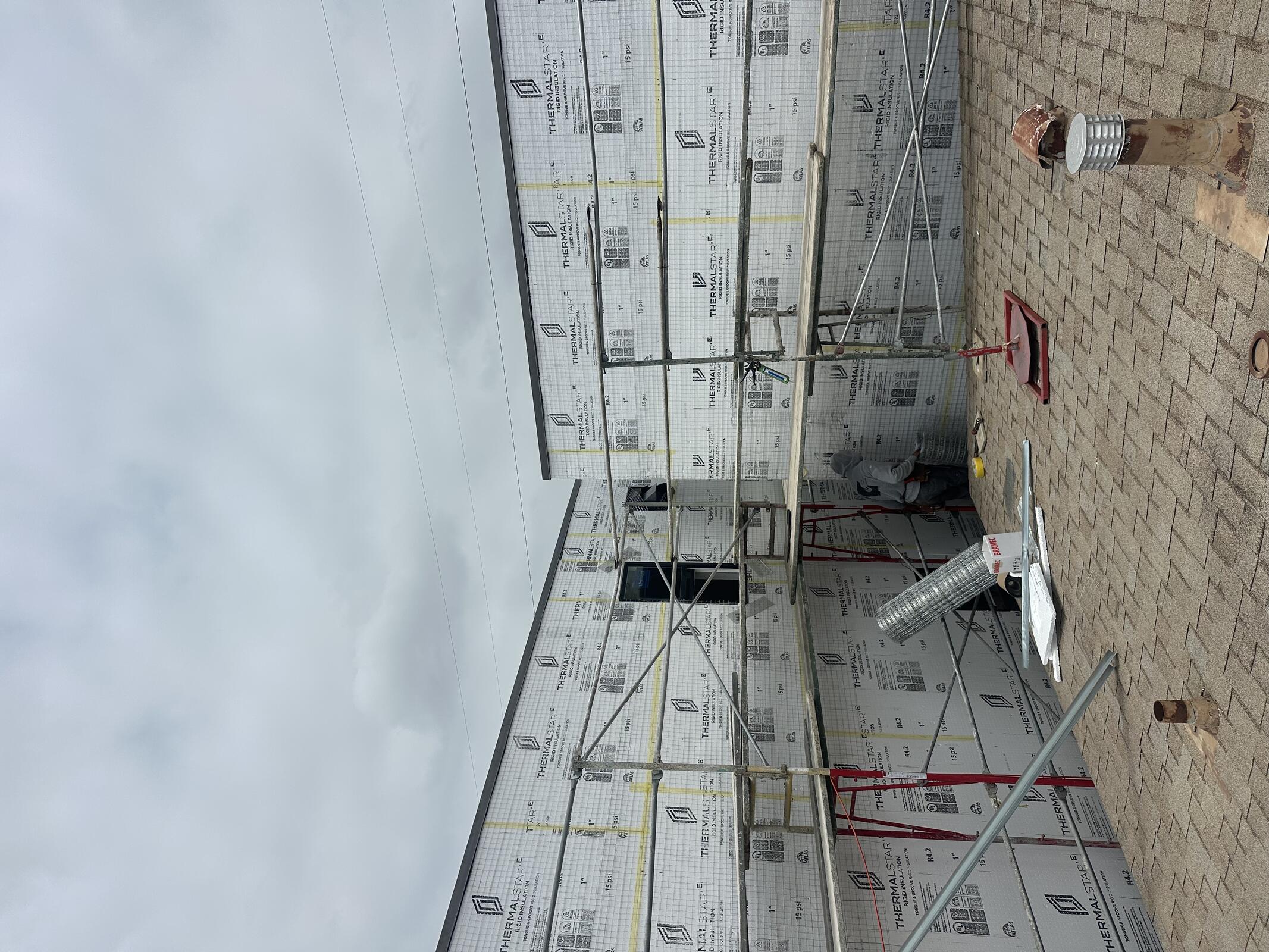

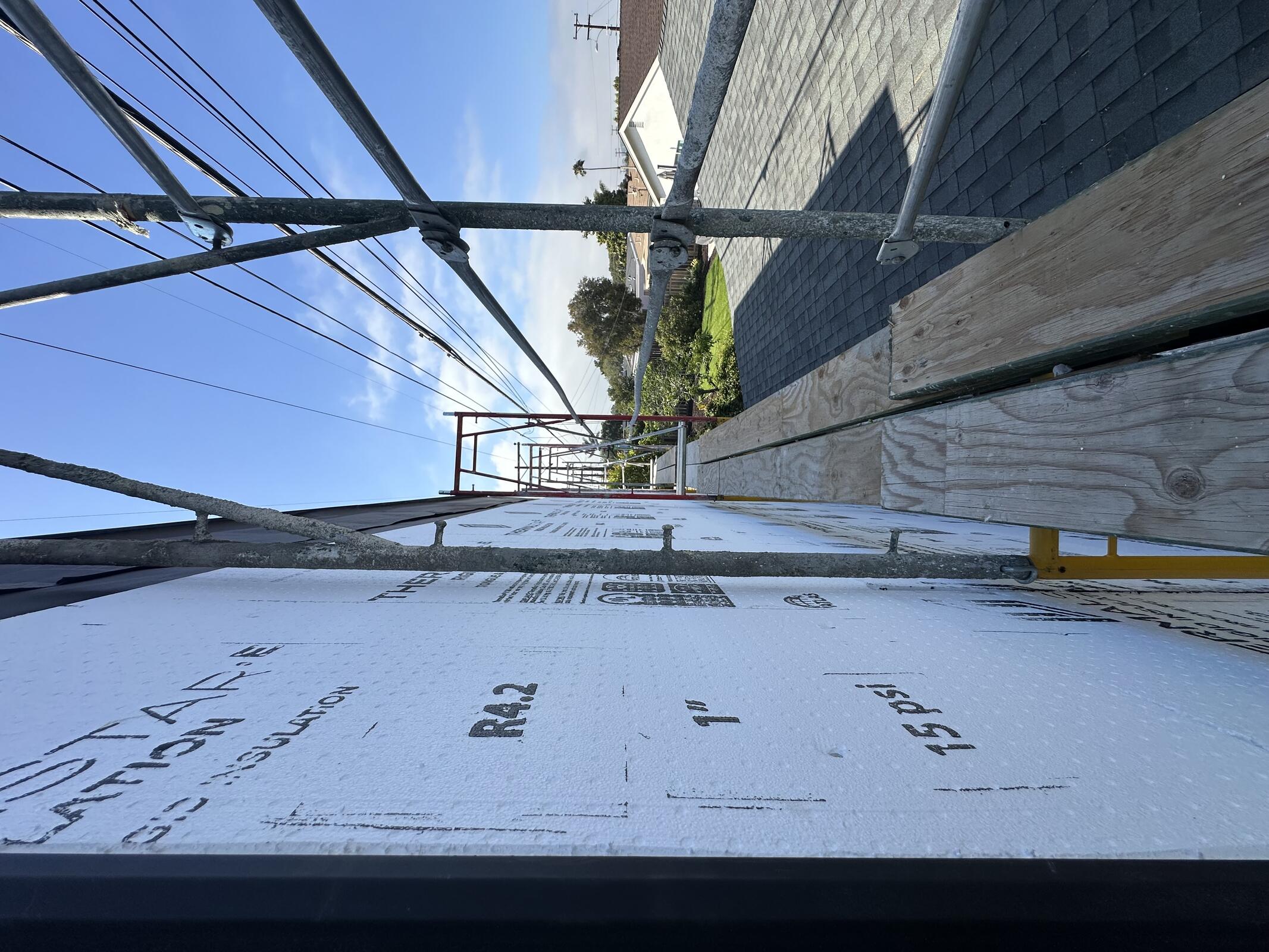

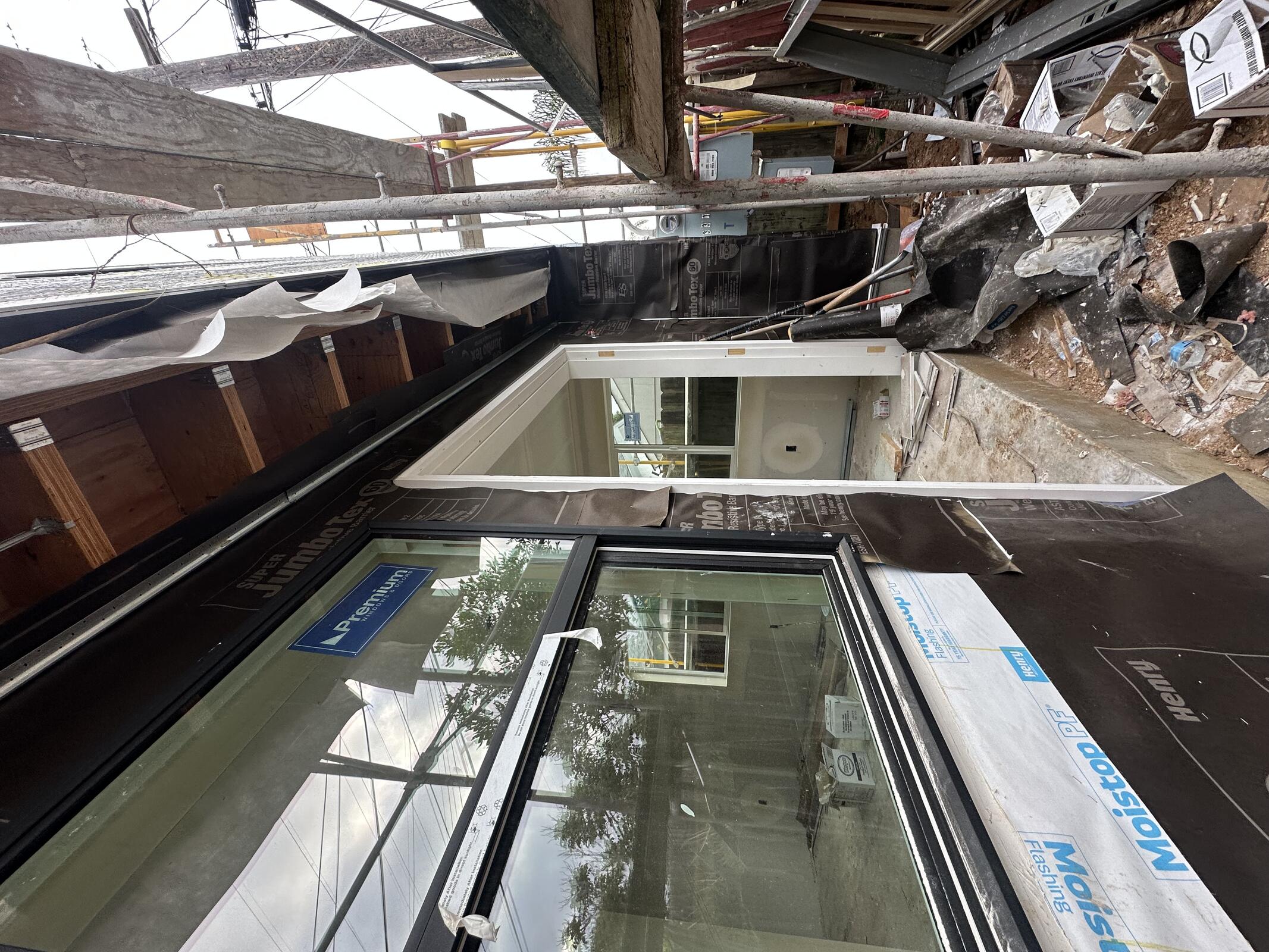

ACCI finishing roofing at Building C overhang.

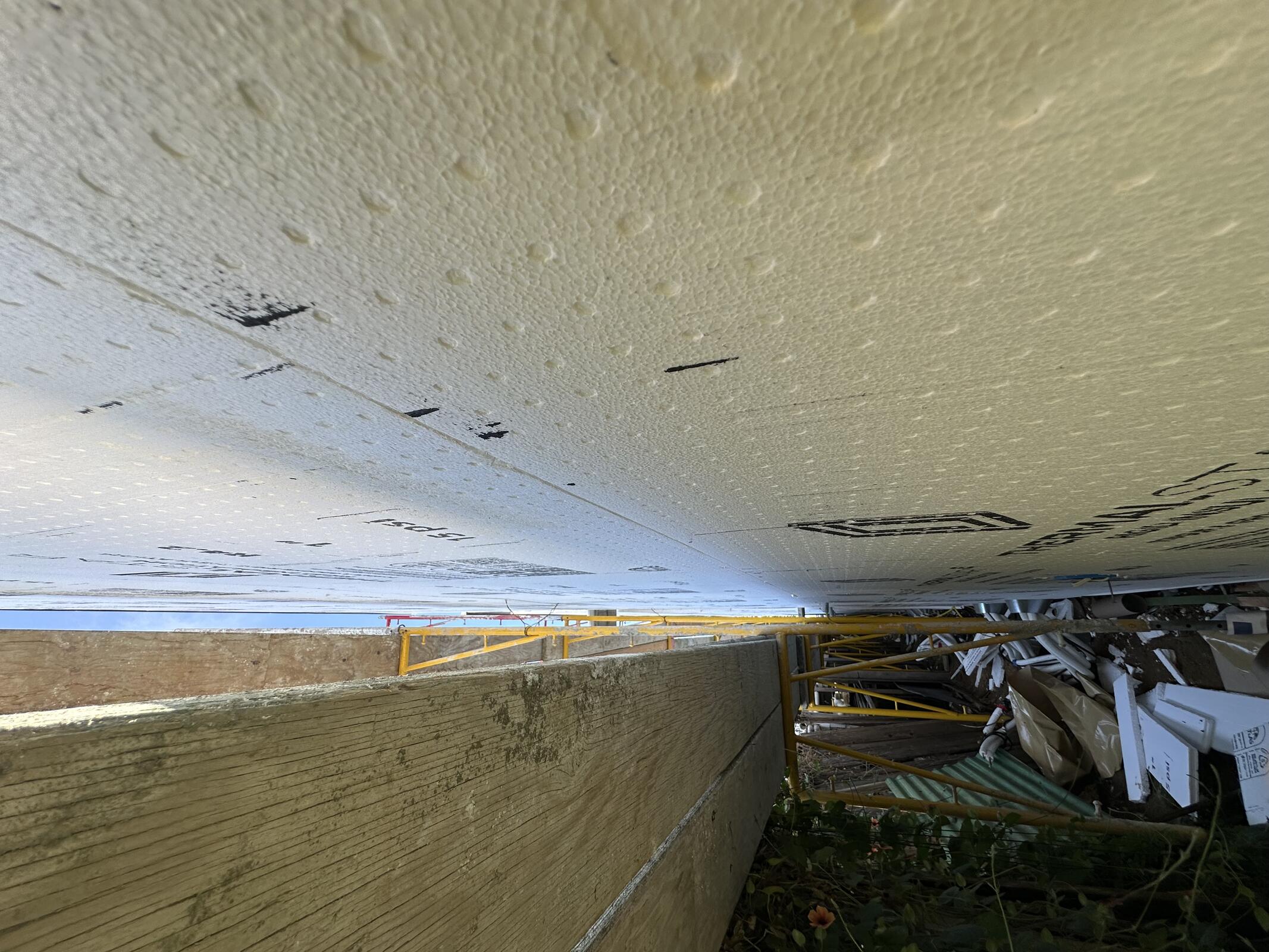

Marq Plastering continuing to Lath.

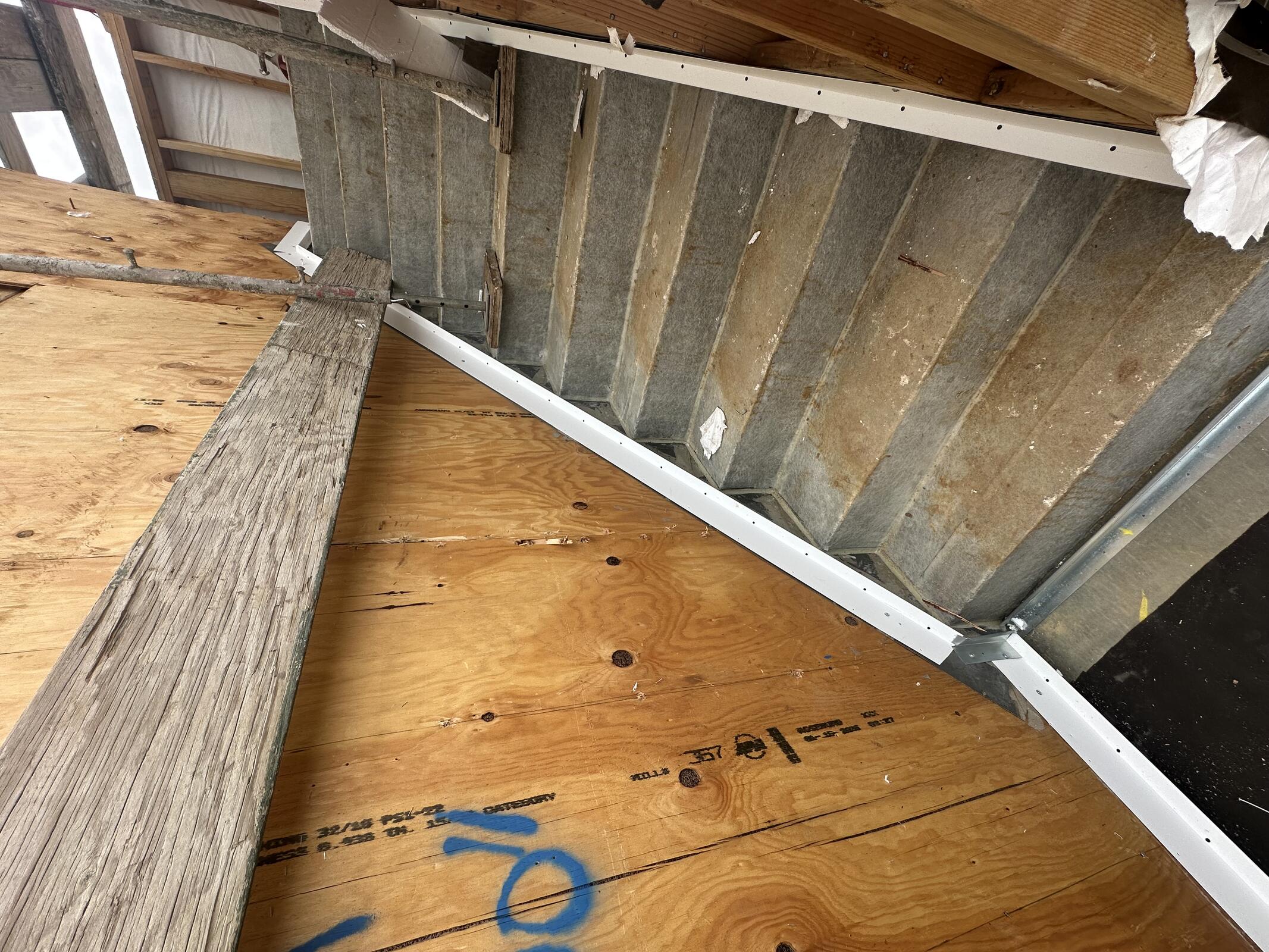

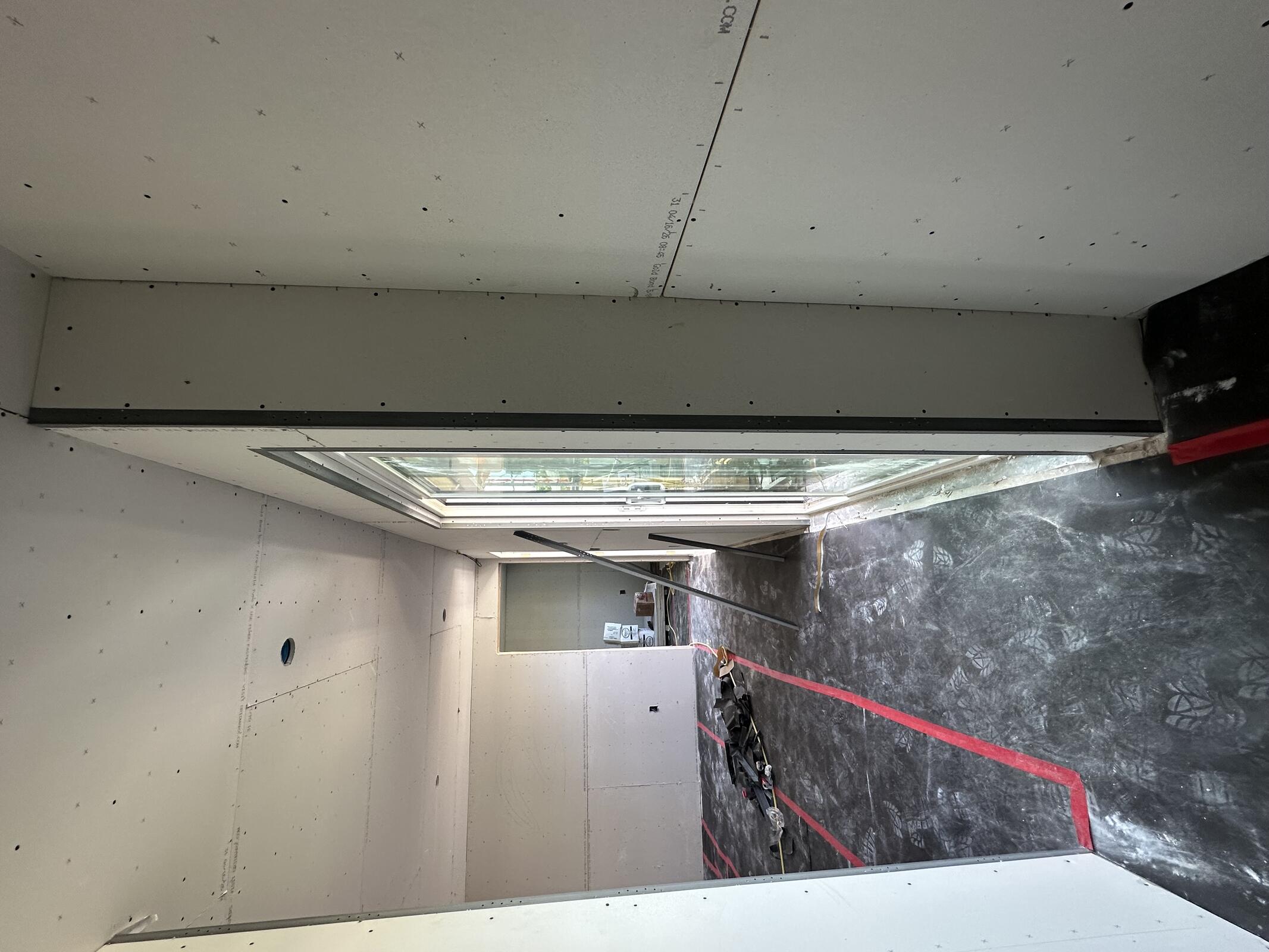

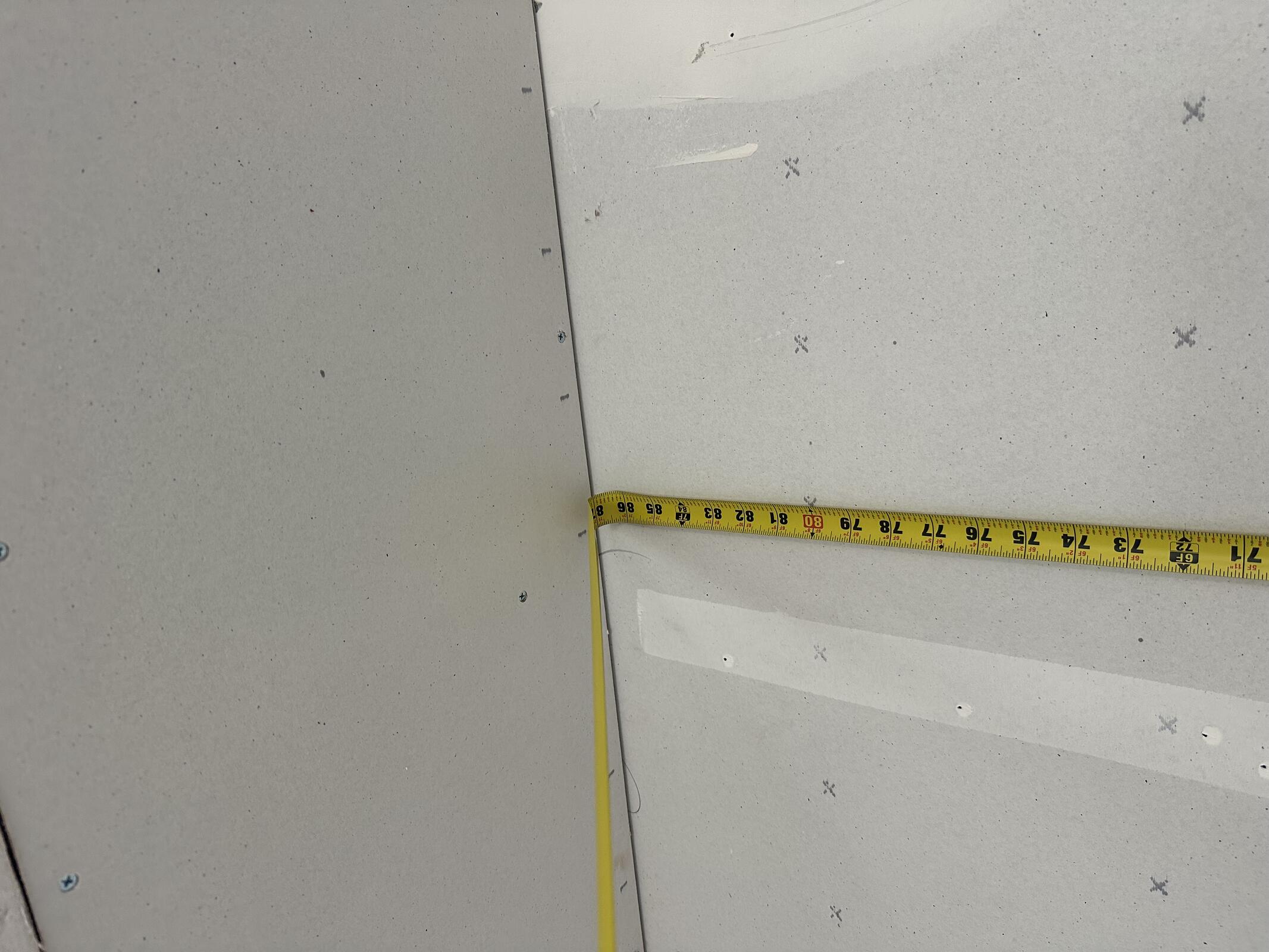

TDI installing soffits and prepping for drywall screw inspection.
JB General cleaning up spoils from garage foundations and stripping.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| ACCI | 4 | 4 | 16 |
| TDI | 2 | 8 | 16 |
| Marq | 2 | 8 | 16 |
| JB General | 2 | 6 | 12 |

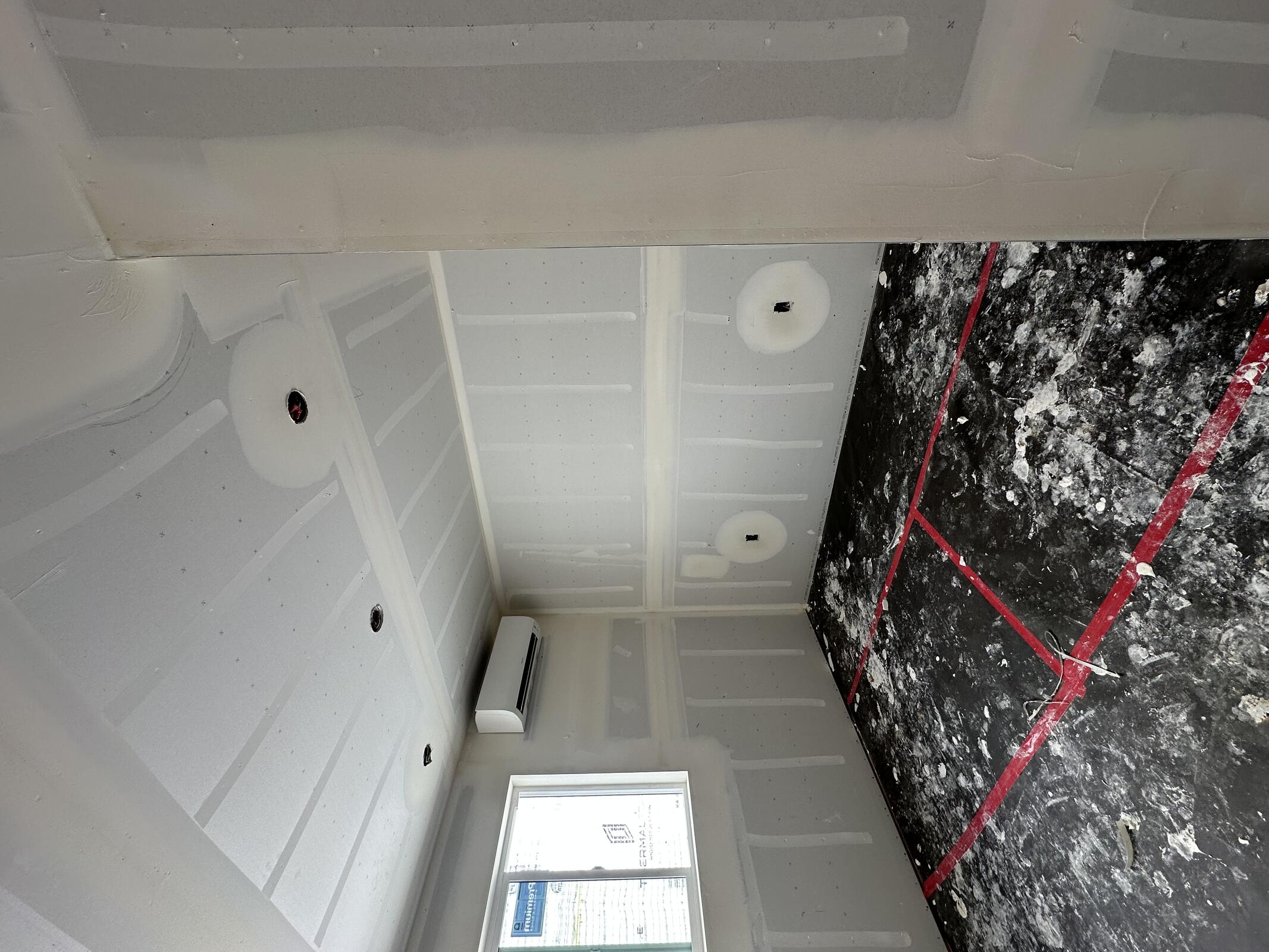

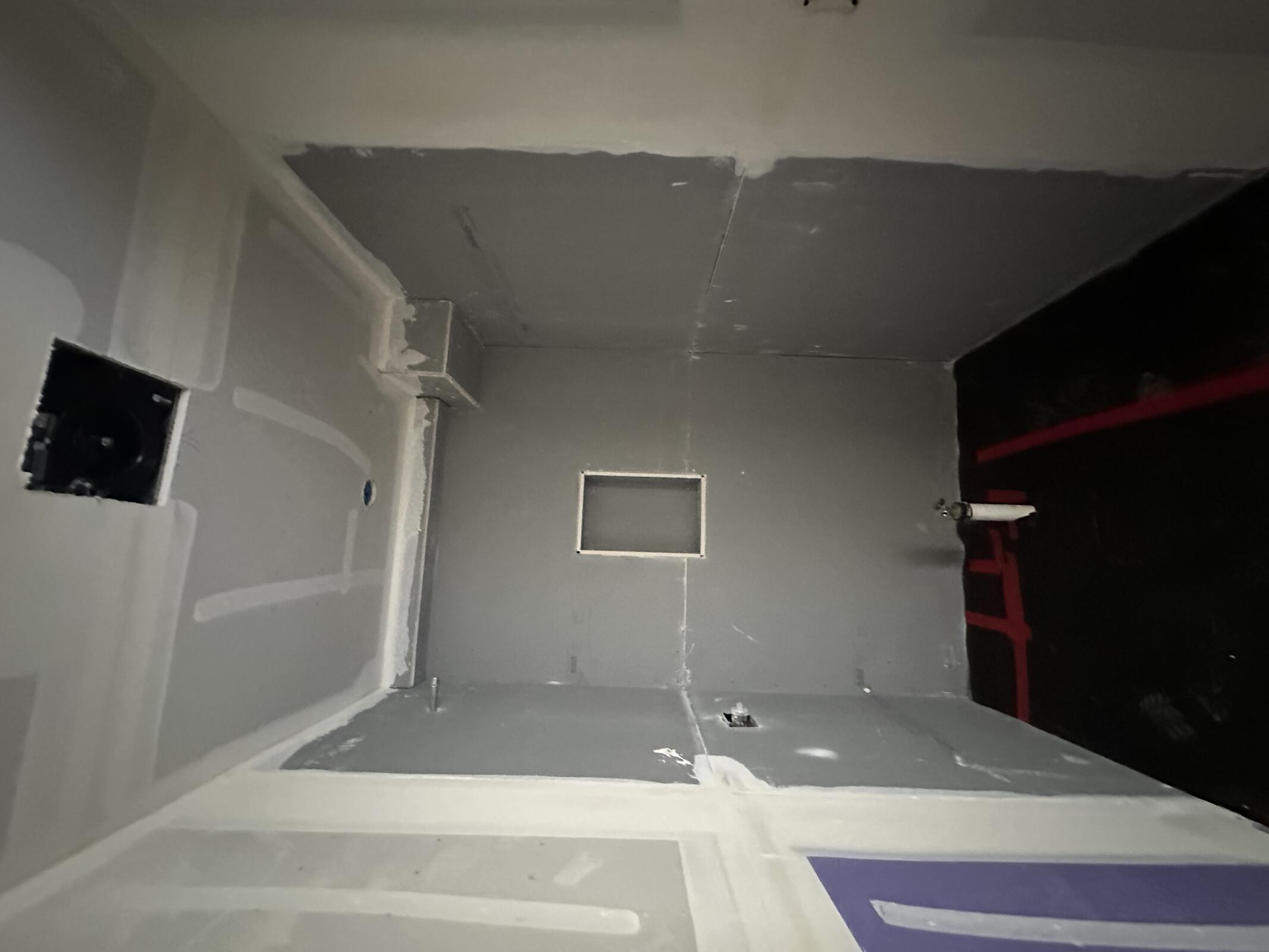

Inspection: Dave Finney on site around 12:30 for Building B and C drywall screw inspection.

Thursday, May 14, 2026
Partially cloudy, 69°F

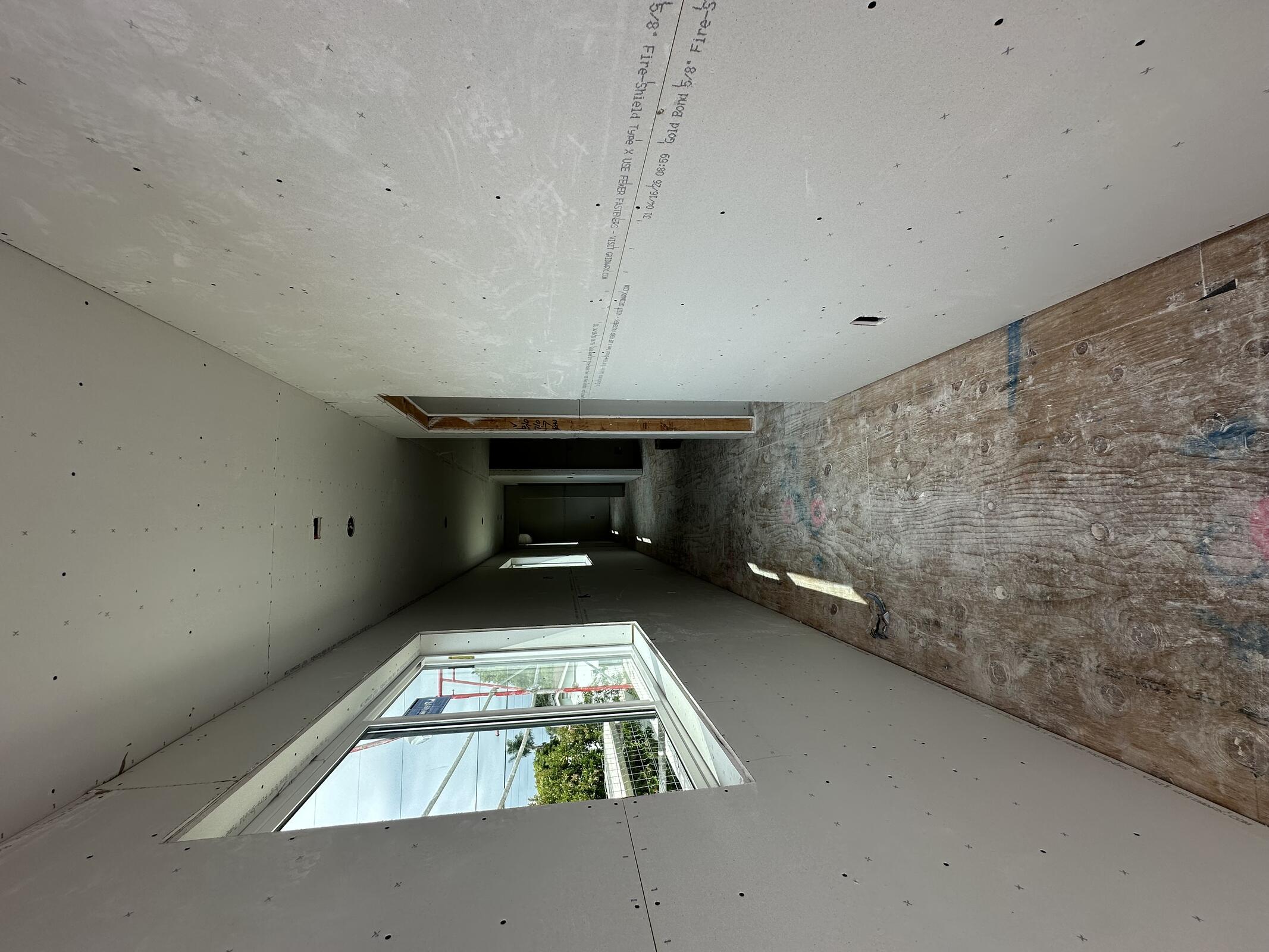

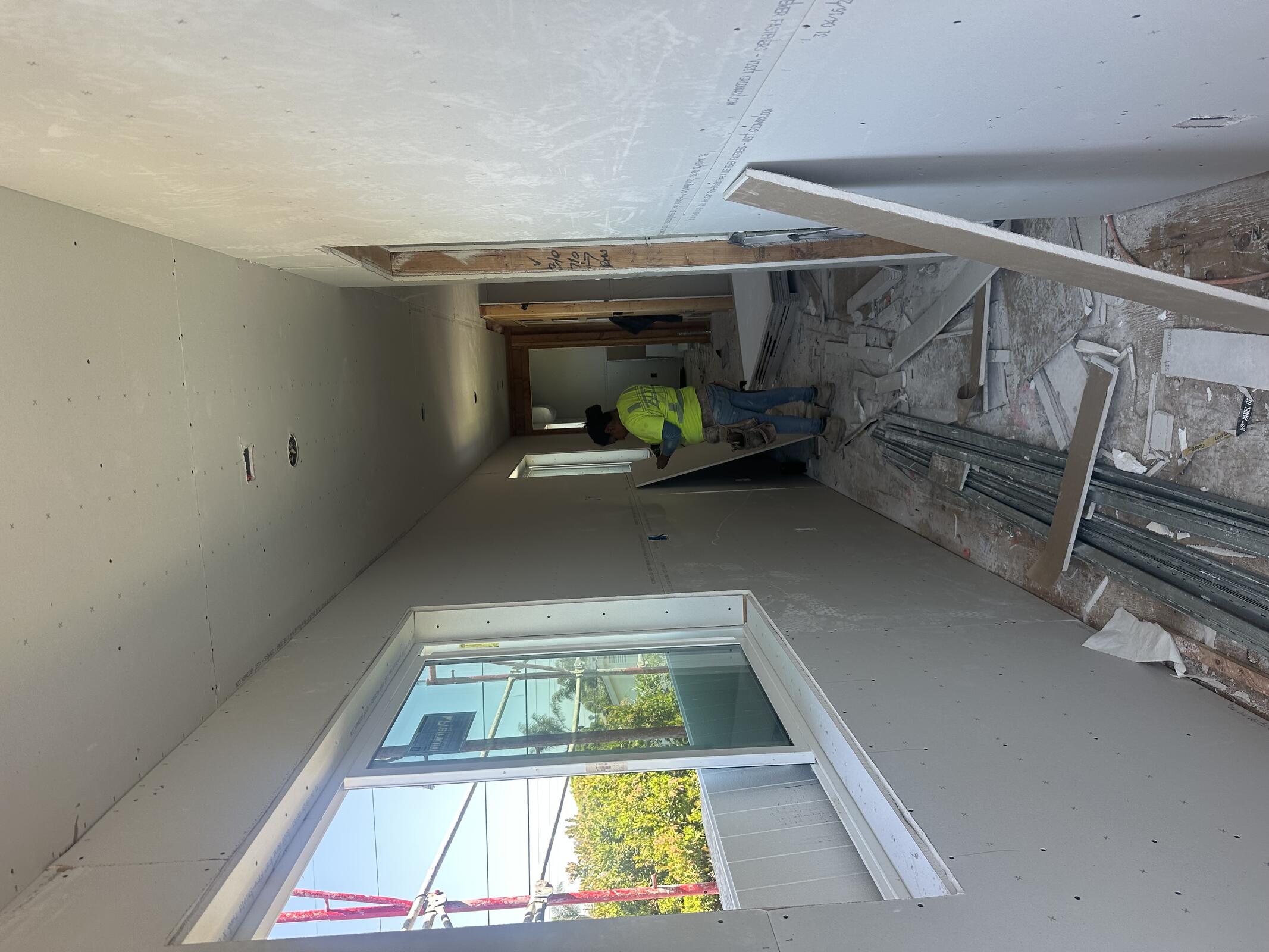

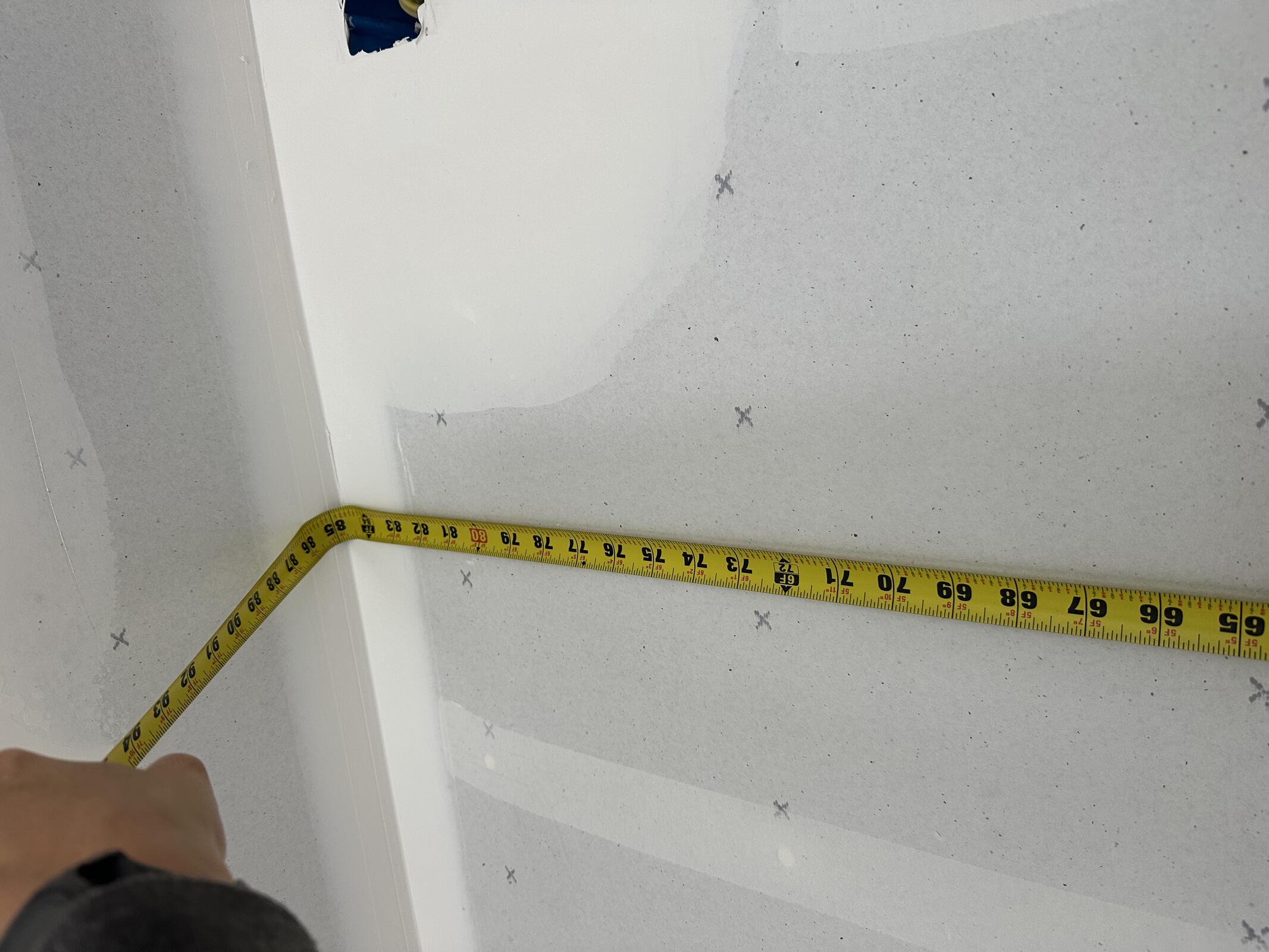

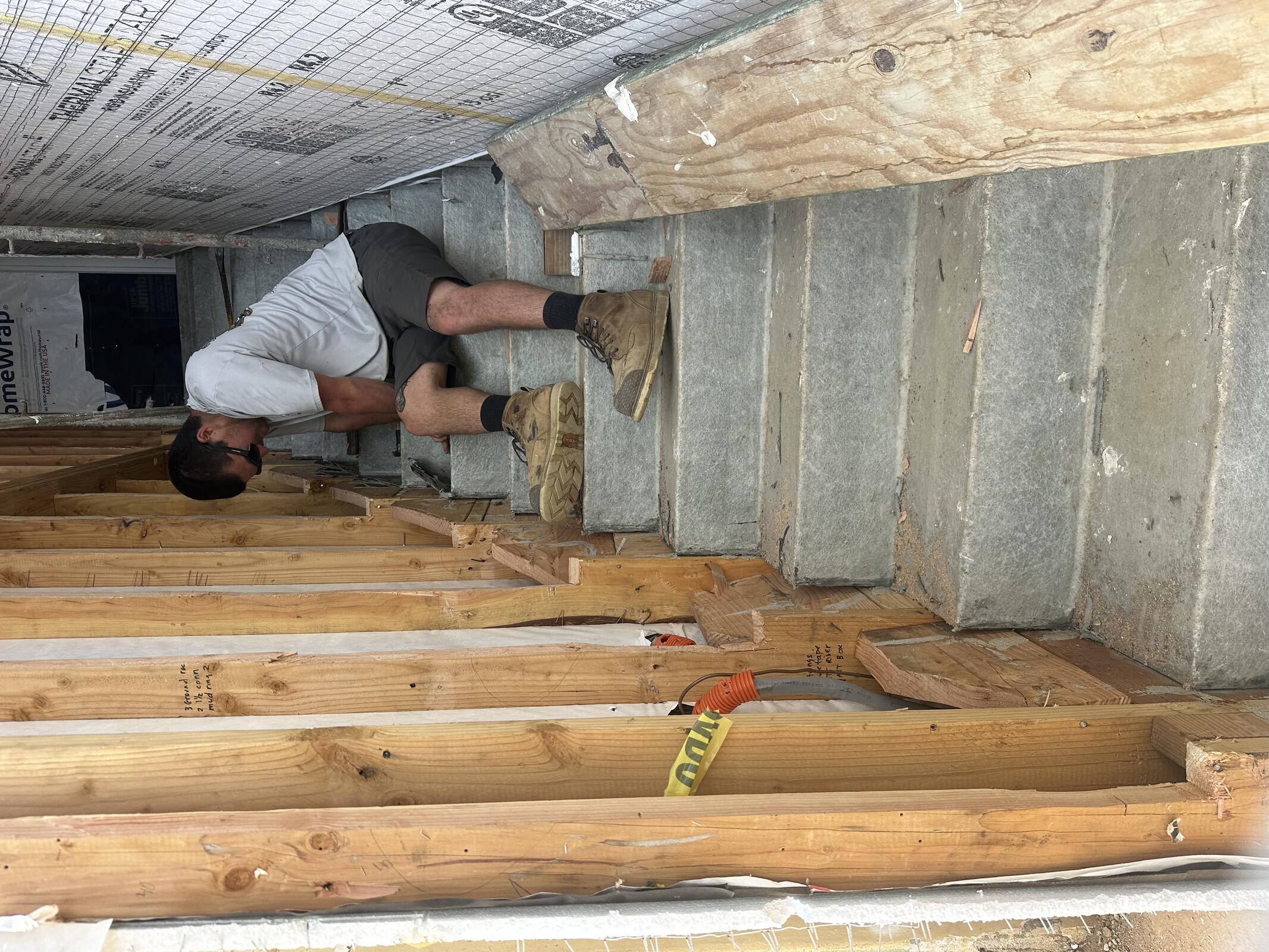

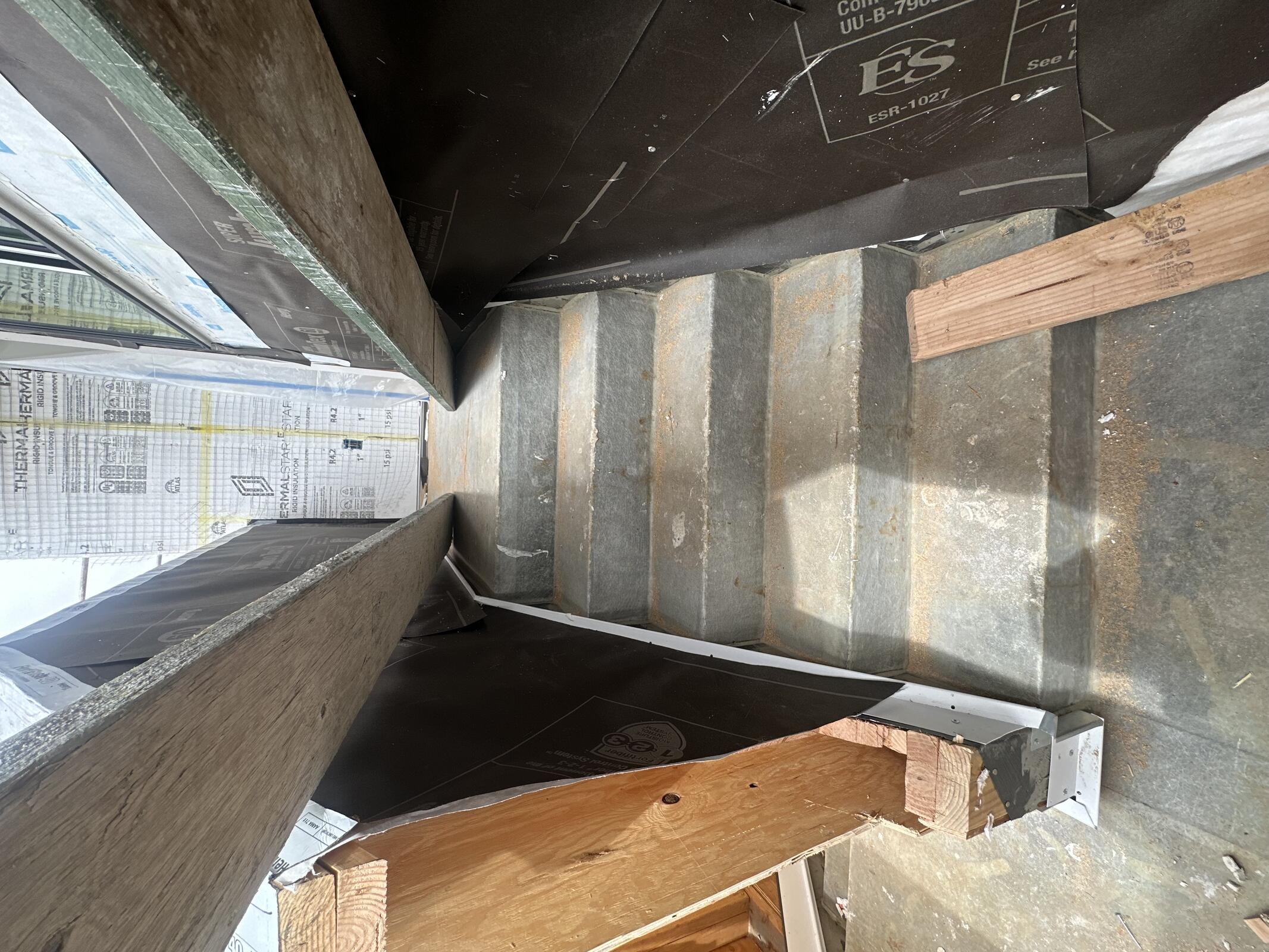

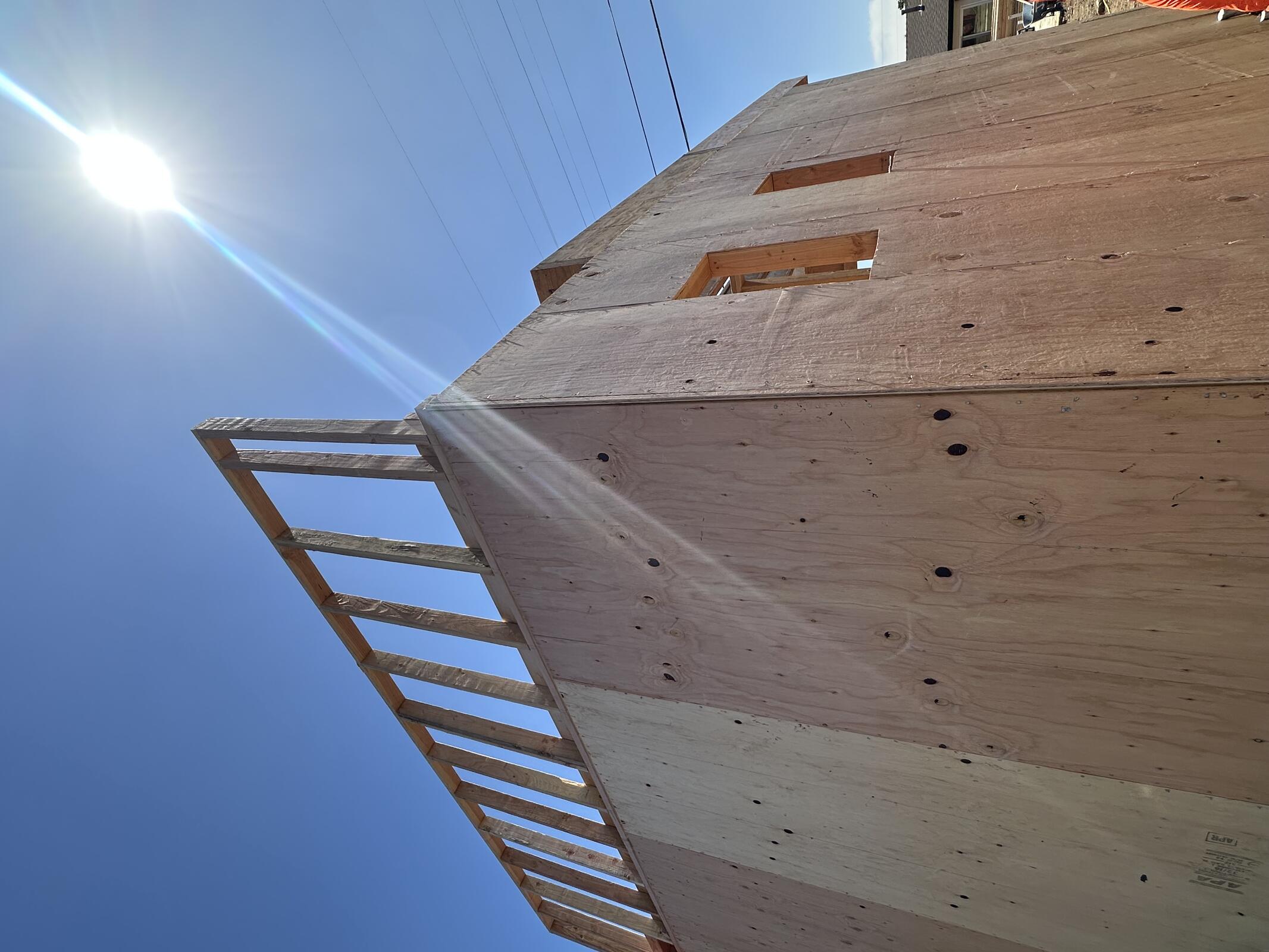

JB General cleaning up site and fixing stair framing at both buildings to achieve 36” clearance. Expected complete by EOD Friday (5/15).

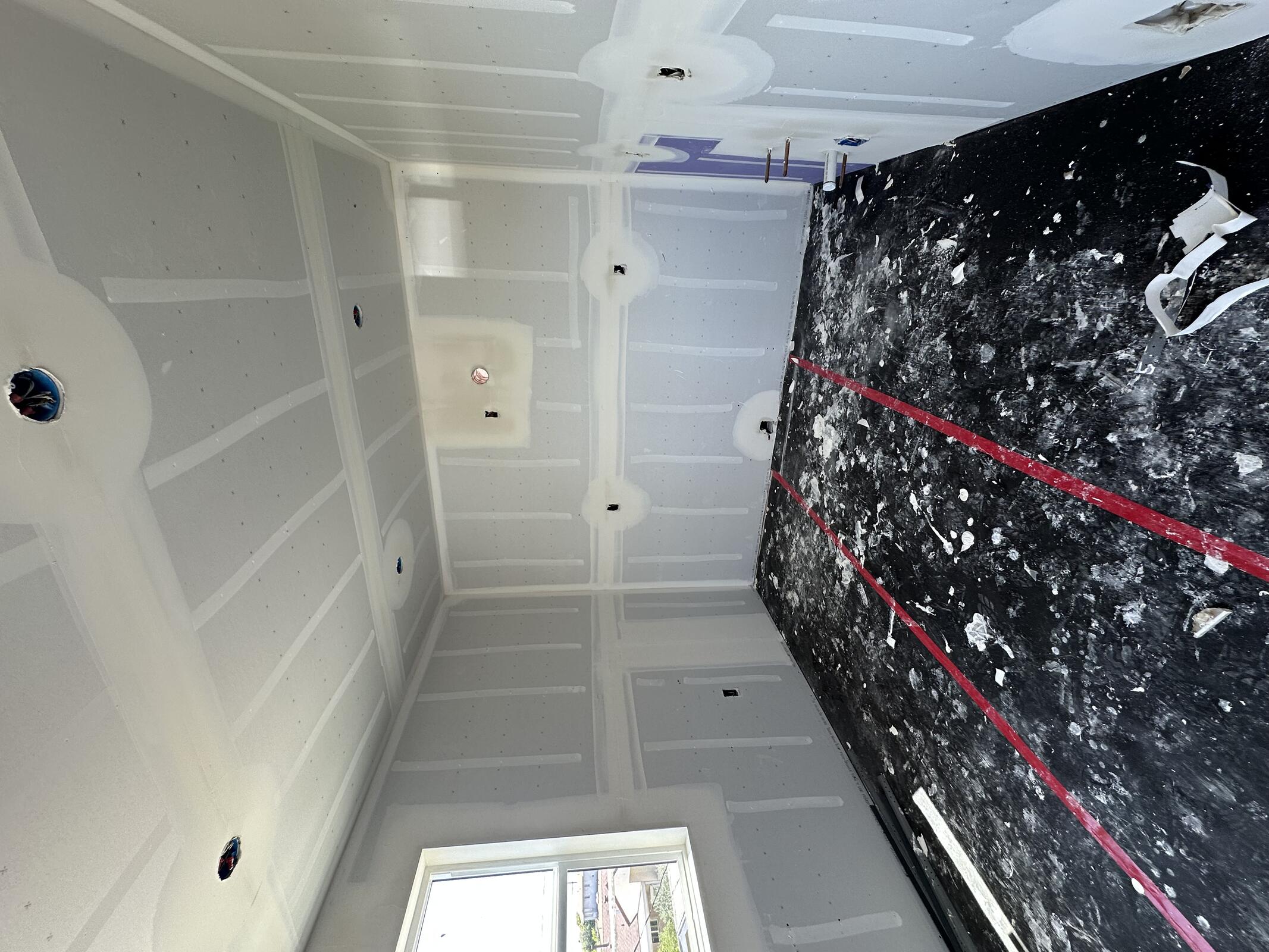

Marq plastering completing lath and installing corner pieces and vents.

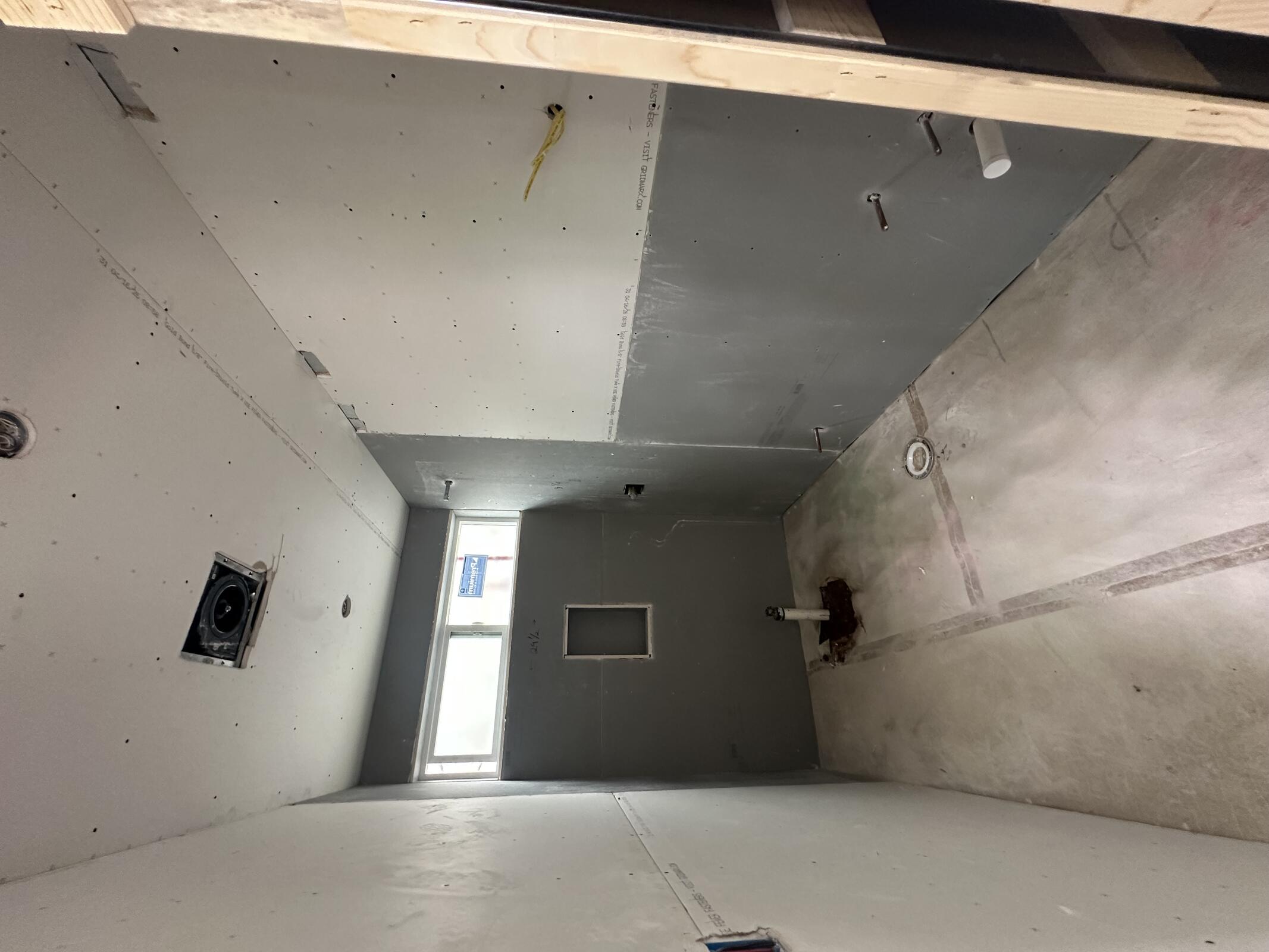

TDI cleaning up site and mudding. More floor protection put down at first floors of B and C. Soffits completed. Expecting to be done EOD Monday.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| TDI | 1.5 | 8 | 12 |
| JB General | 2 | 8 | 16 |
| Marq | 2 | 8 | 16 |
Inspection: N/A

Friday, May 15, 2026
Overcast, 63°F

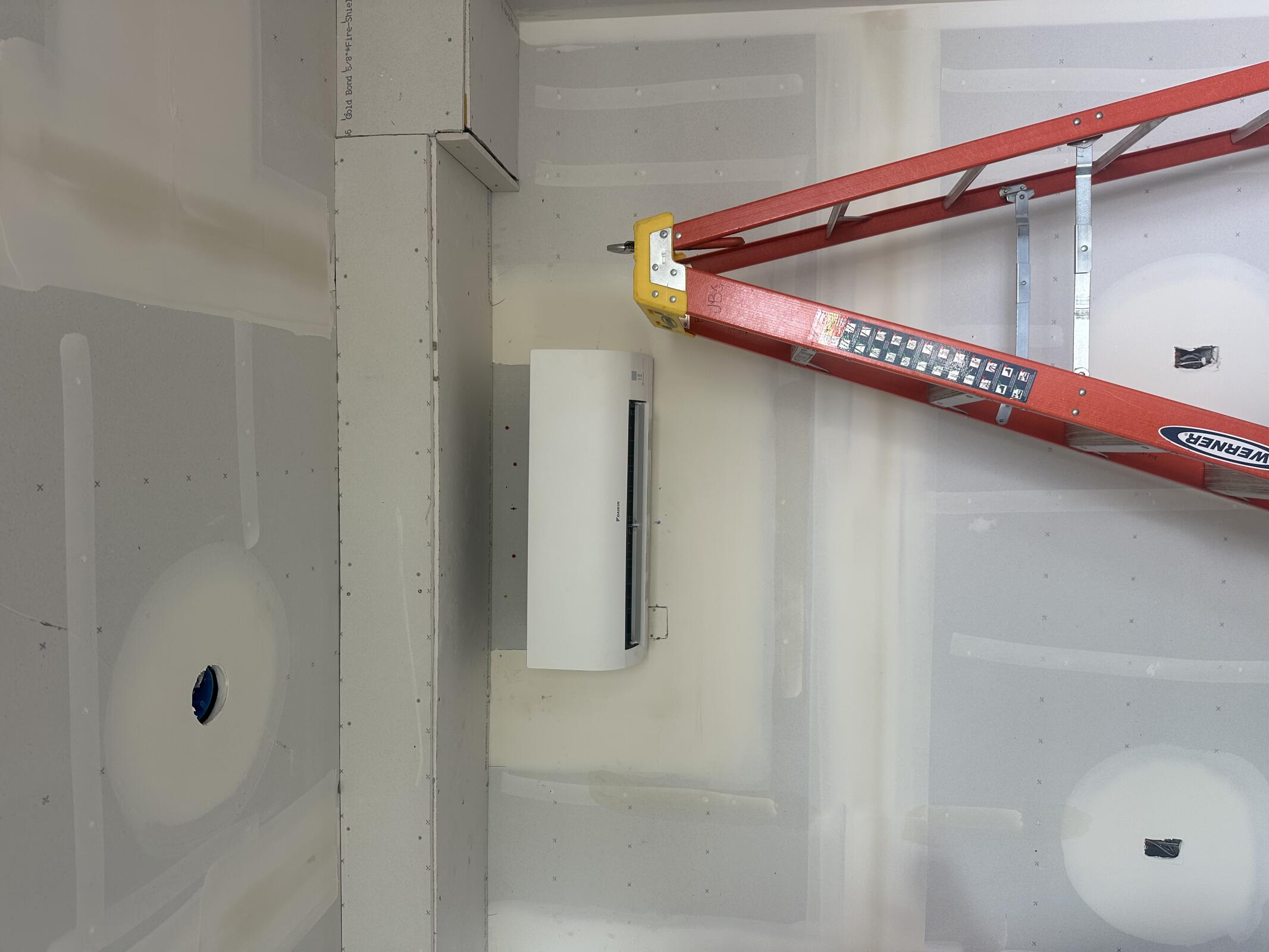

Clear HVAC lowering unit in Building C, Unit 1 to improve functionality of mini-split.
JB General working on stair clearance.

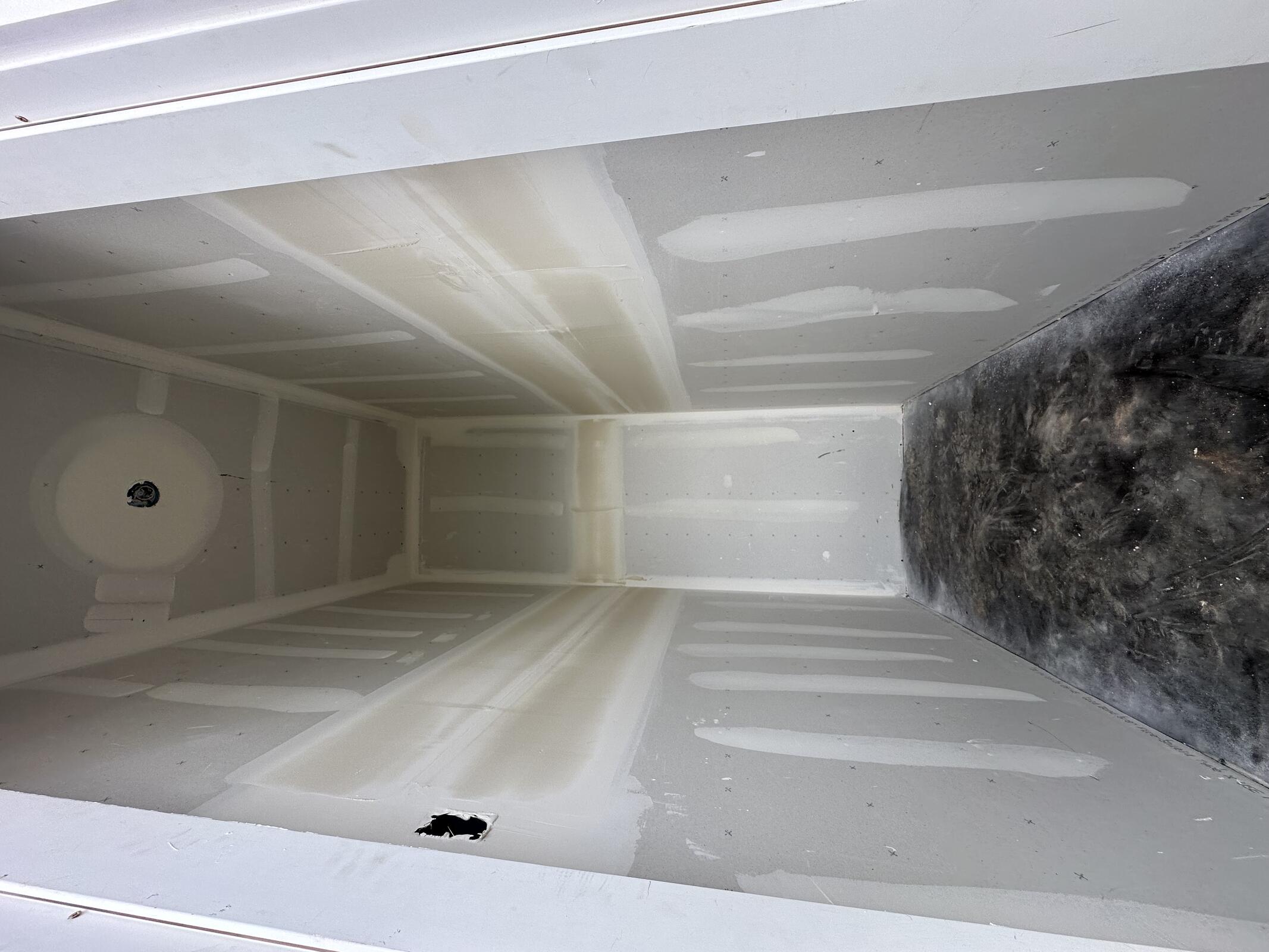

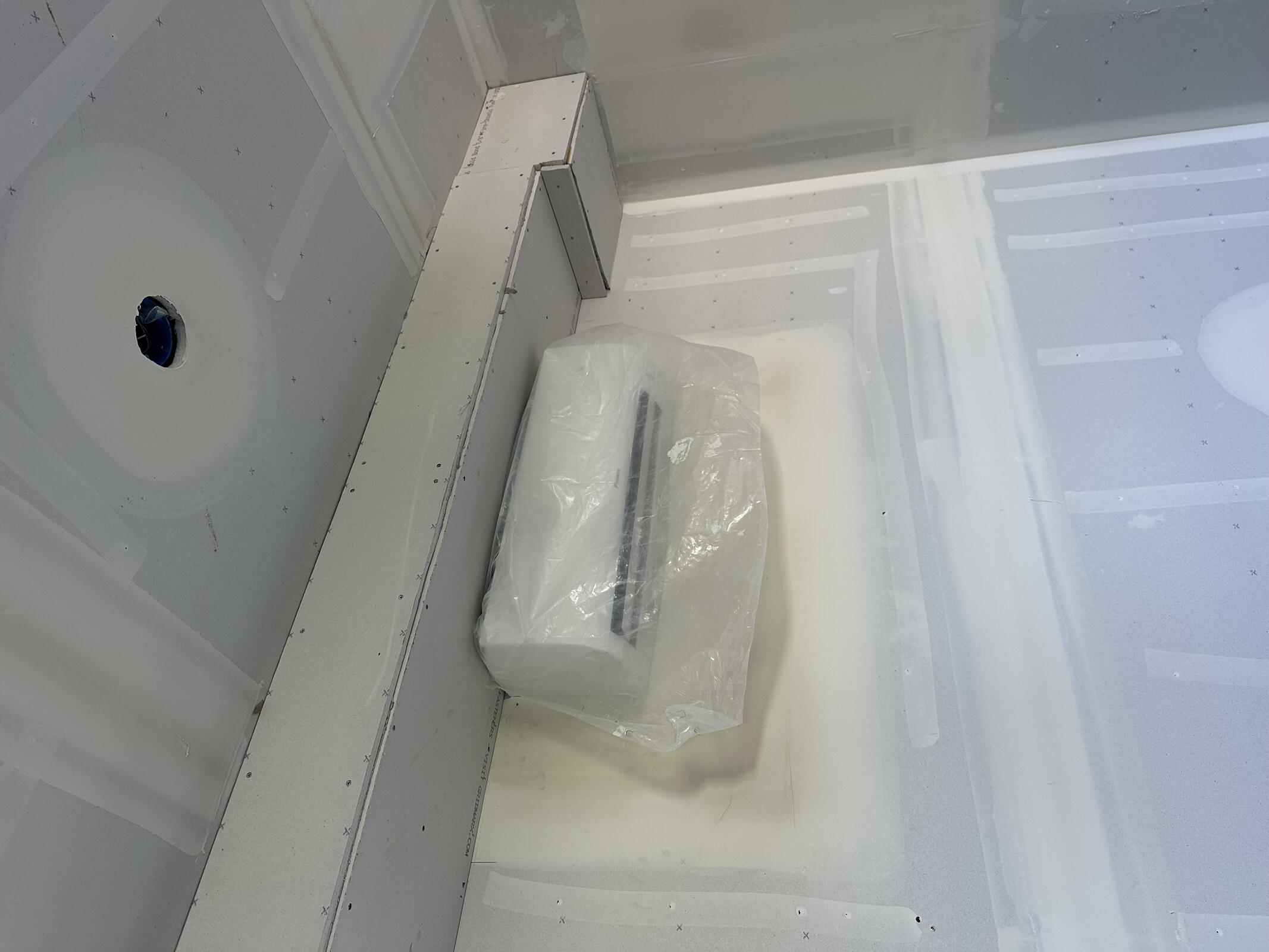

TDI sanding seams and texturing.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| CLEAR HVAC | 1 | 4 | 4 |
| JB GENERAL | 2 | 8 | 16 |
| TDI | 1 | 8 | 8 |
Inspection: N/A
