Week of May 04 — May 08, 2026
5 days on site. 78 photos. DFH, Delay, Drywall, Electric, Framing, HVAC, Inspection, Insulation, Plumbing, ROW, Roofing, Solar, Stucco.
Monday, May 04, 2026
Partially cloudy, 62°F

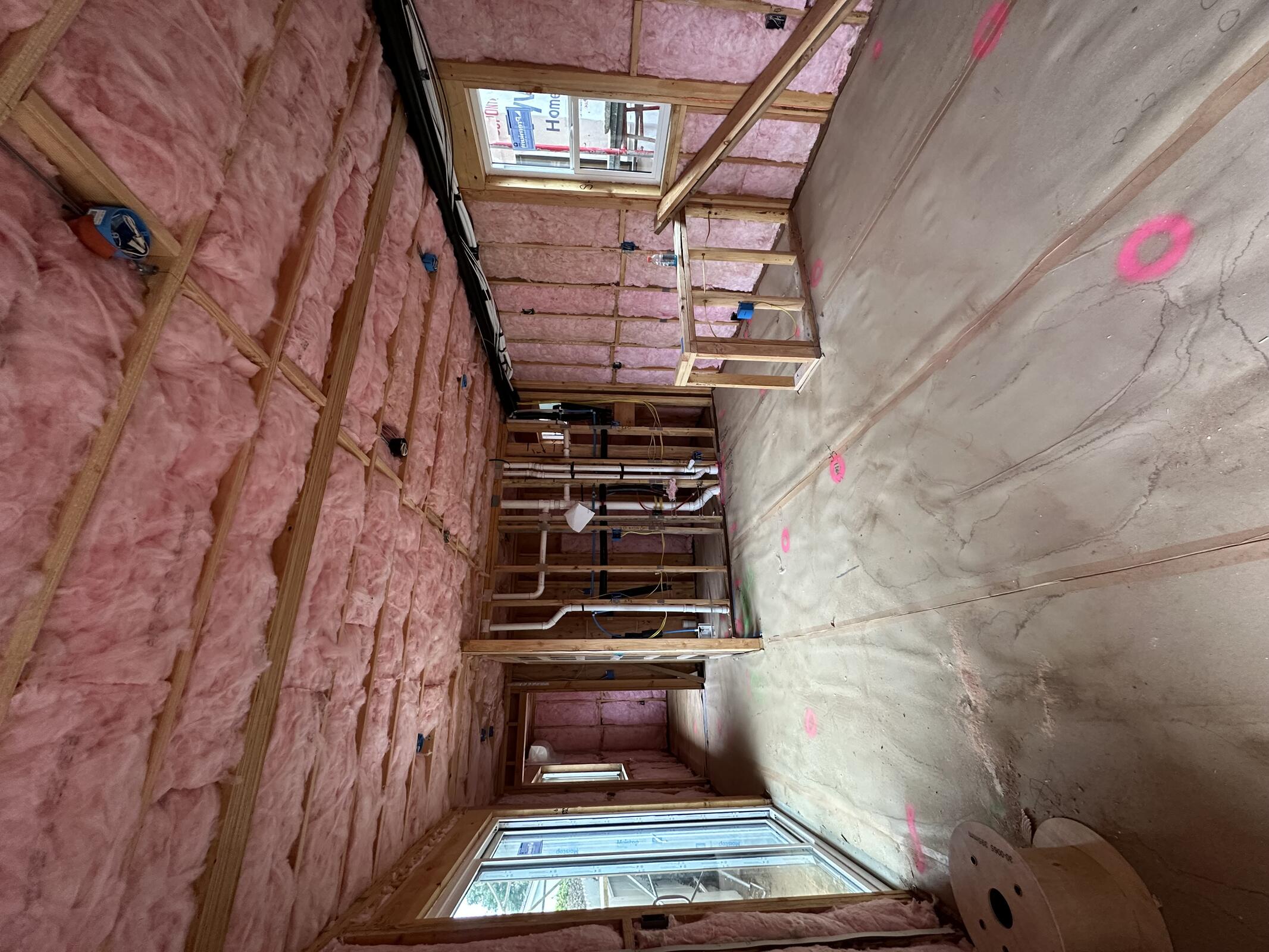

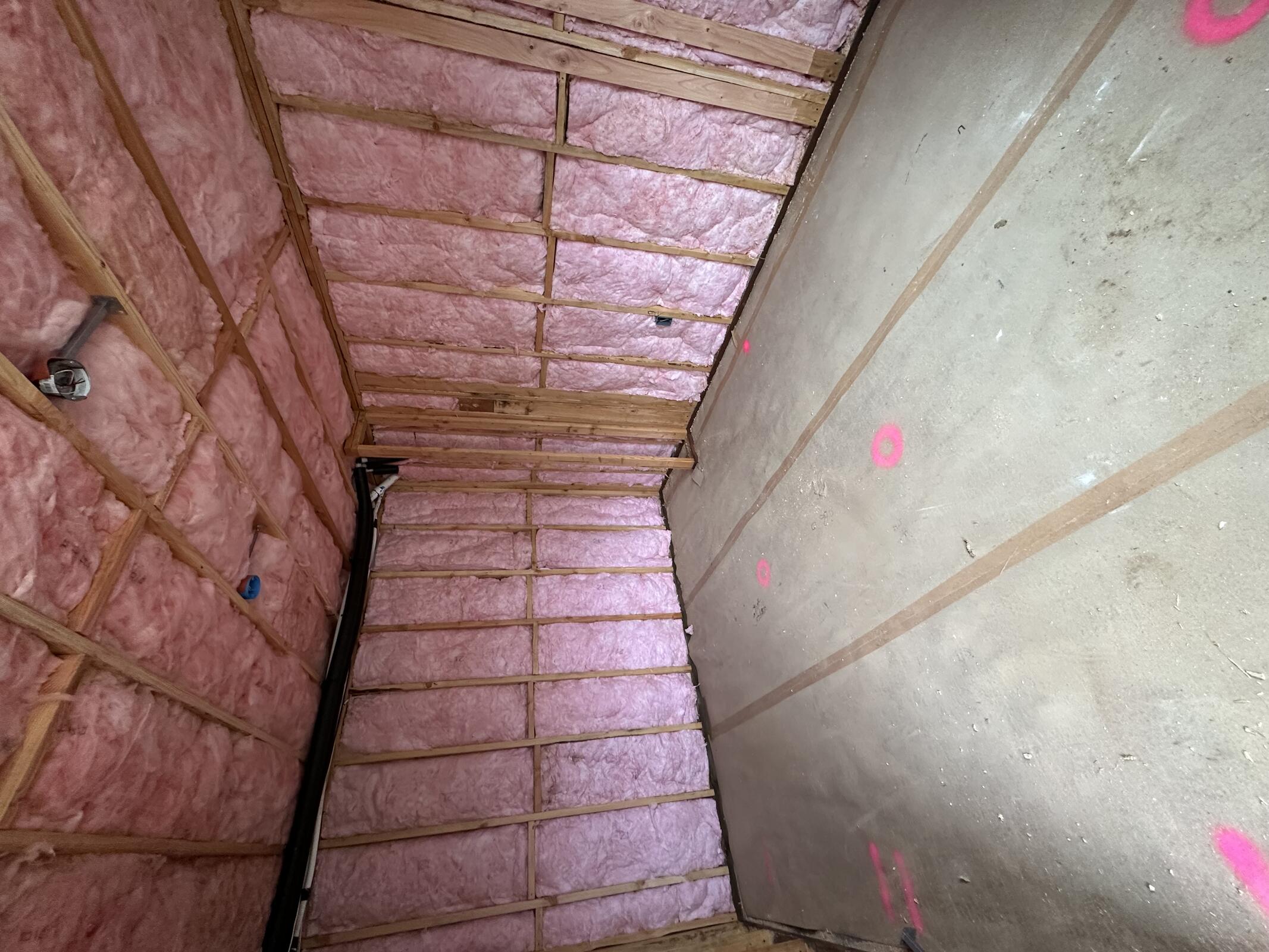

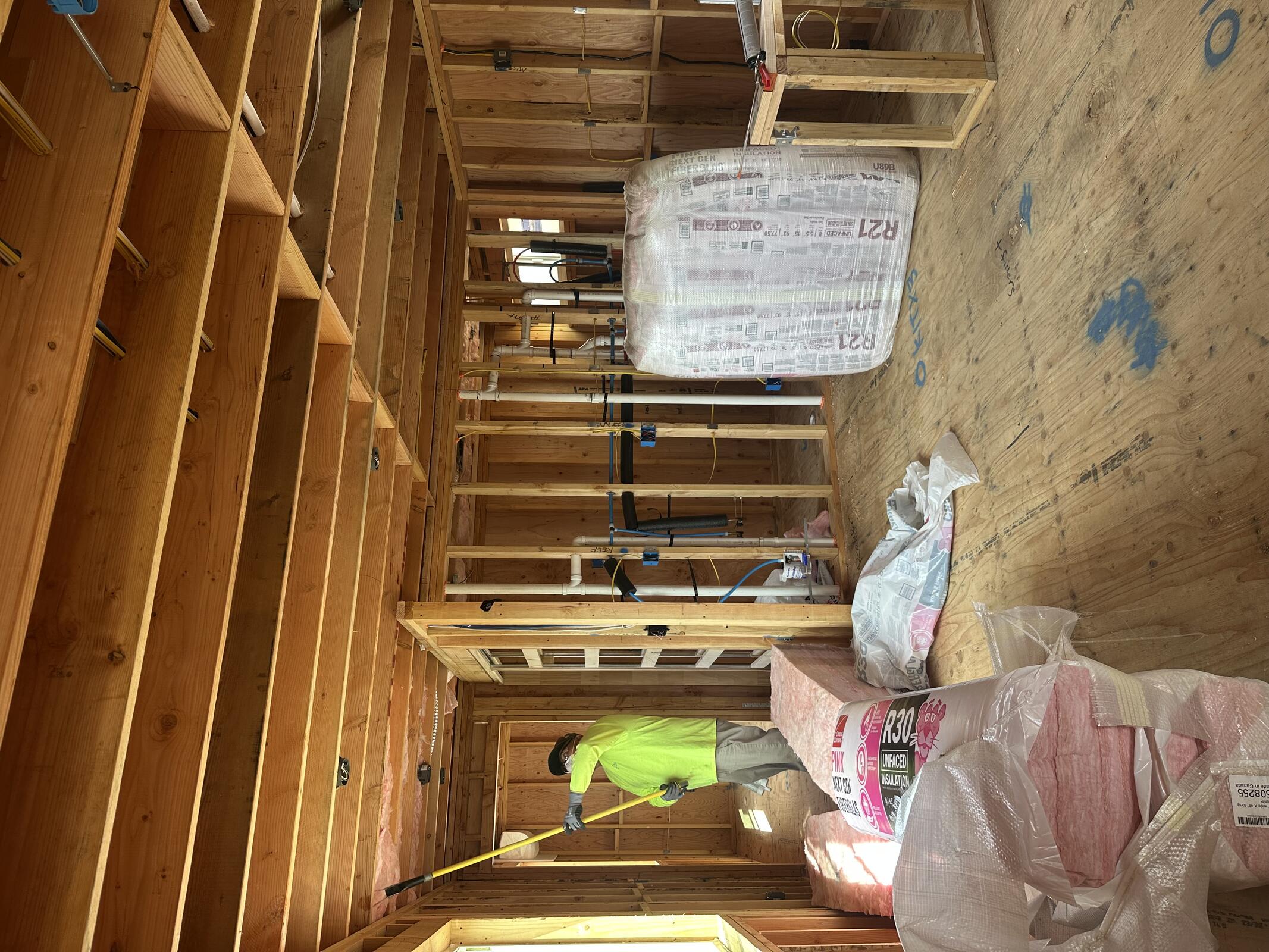

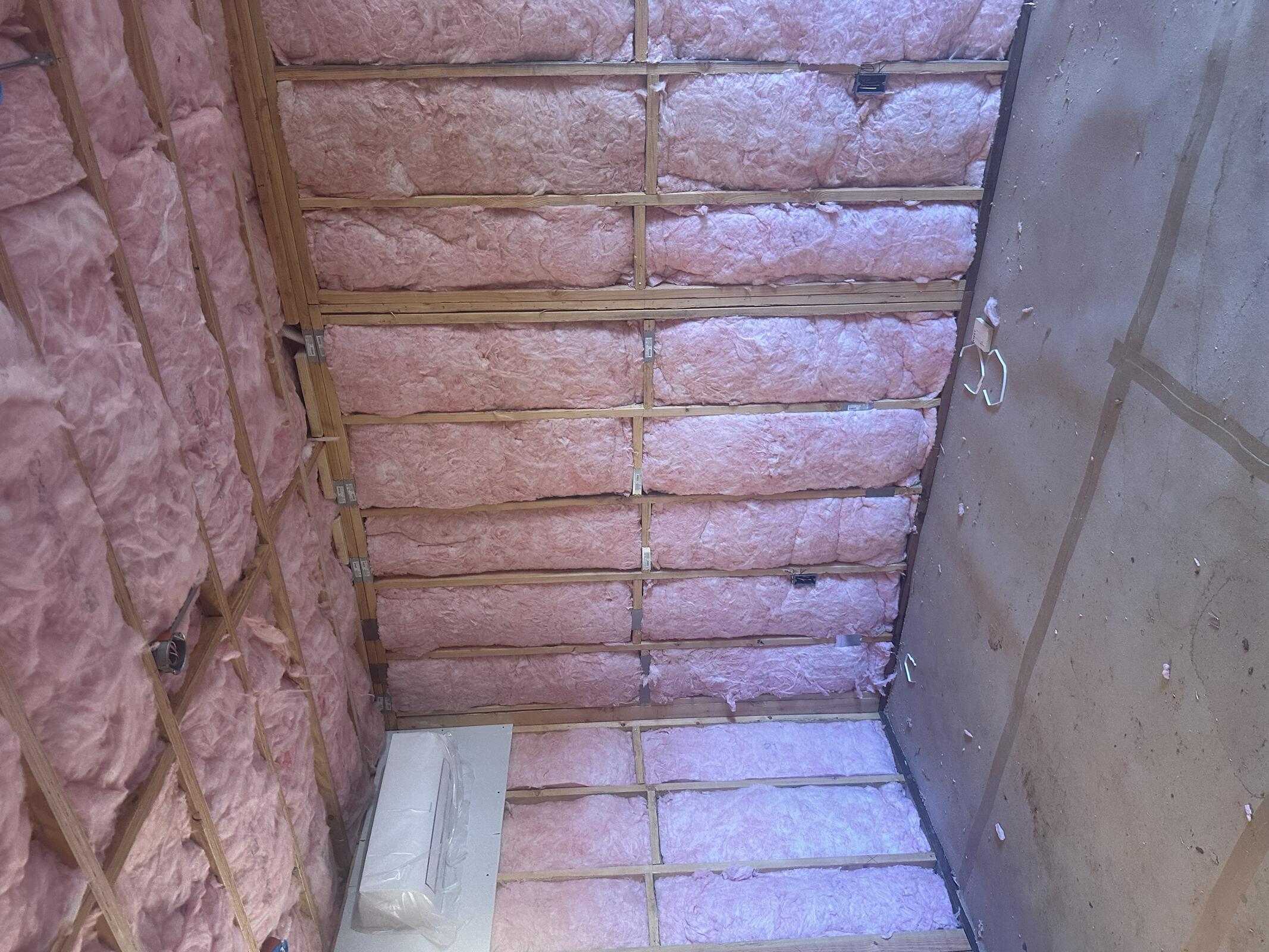

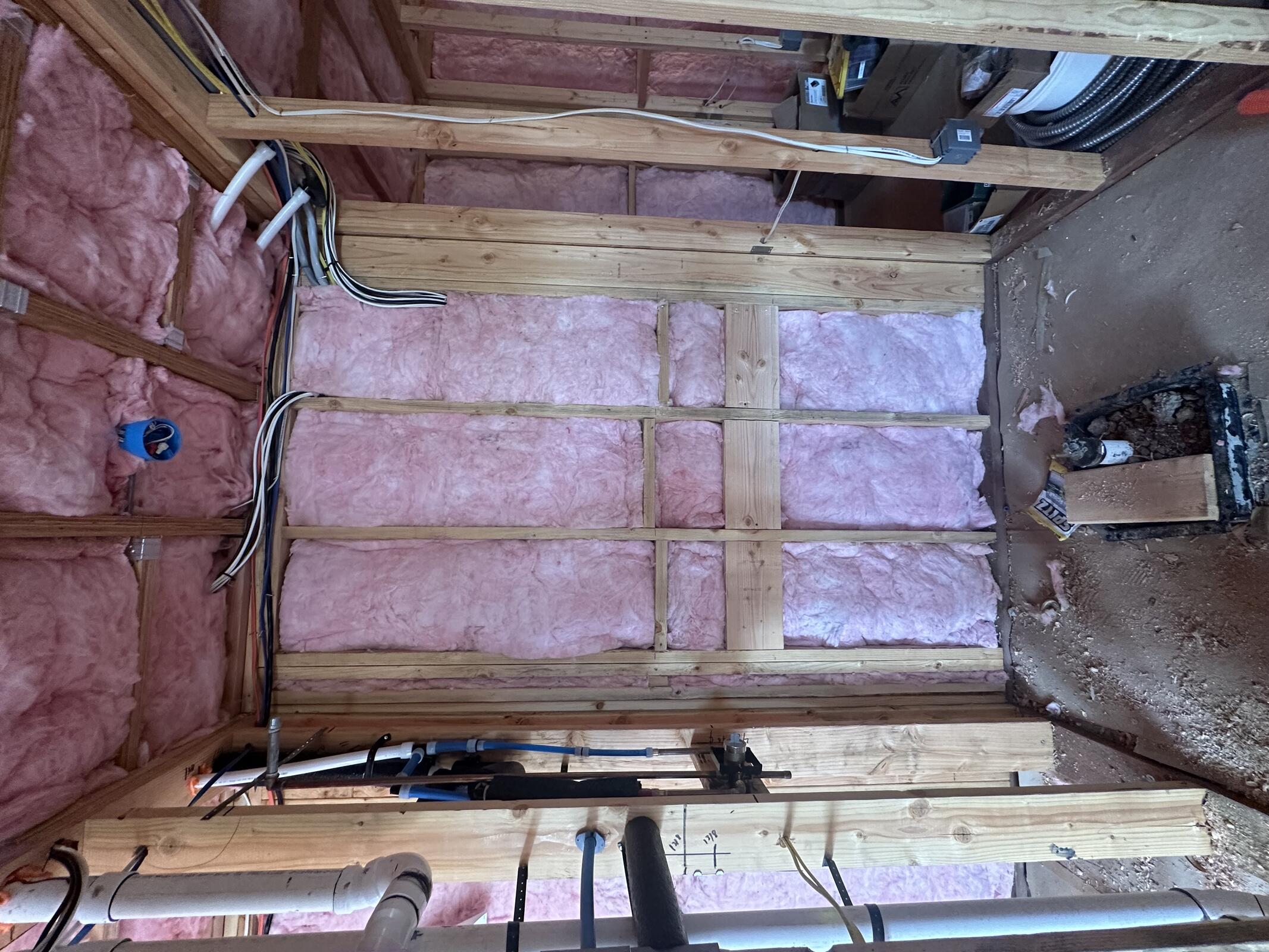

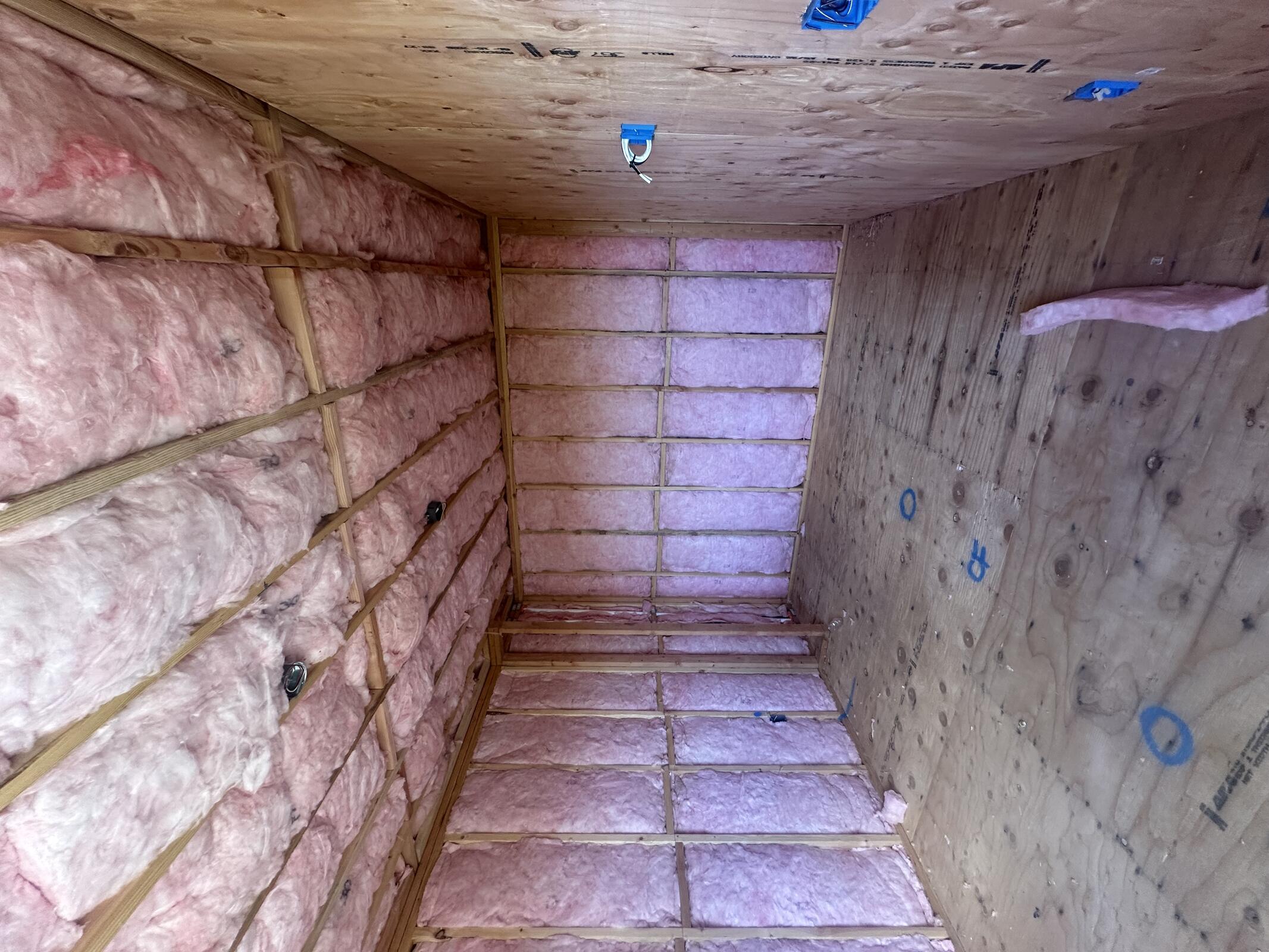

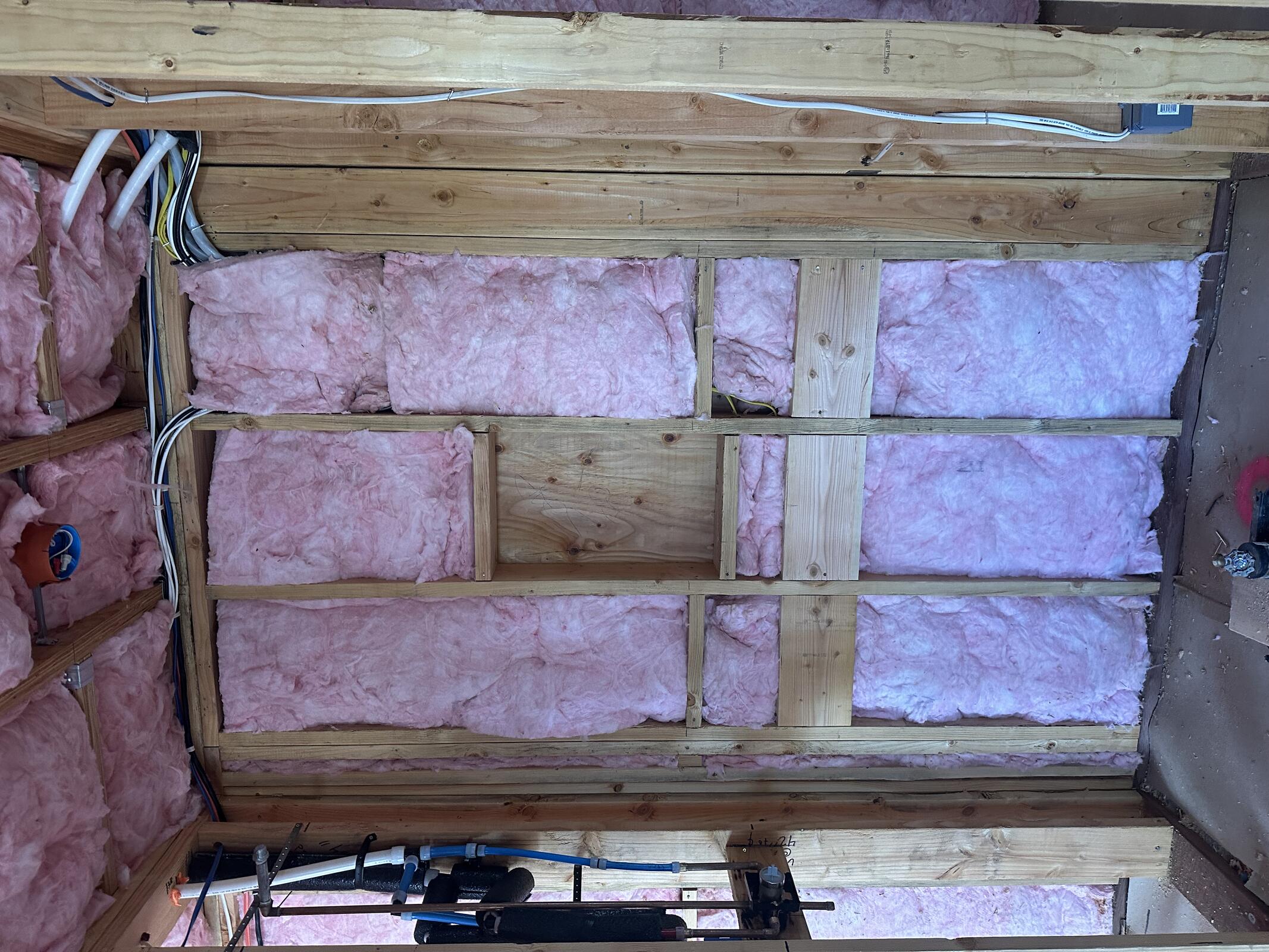

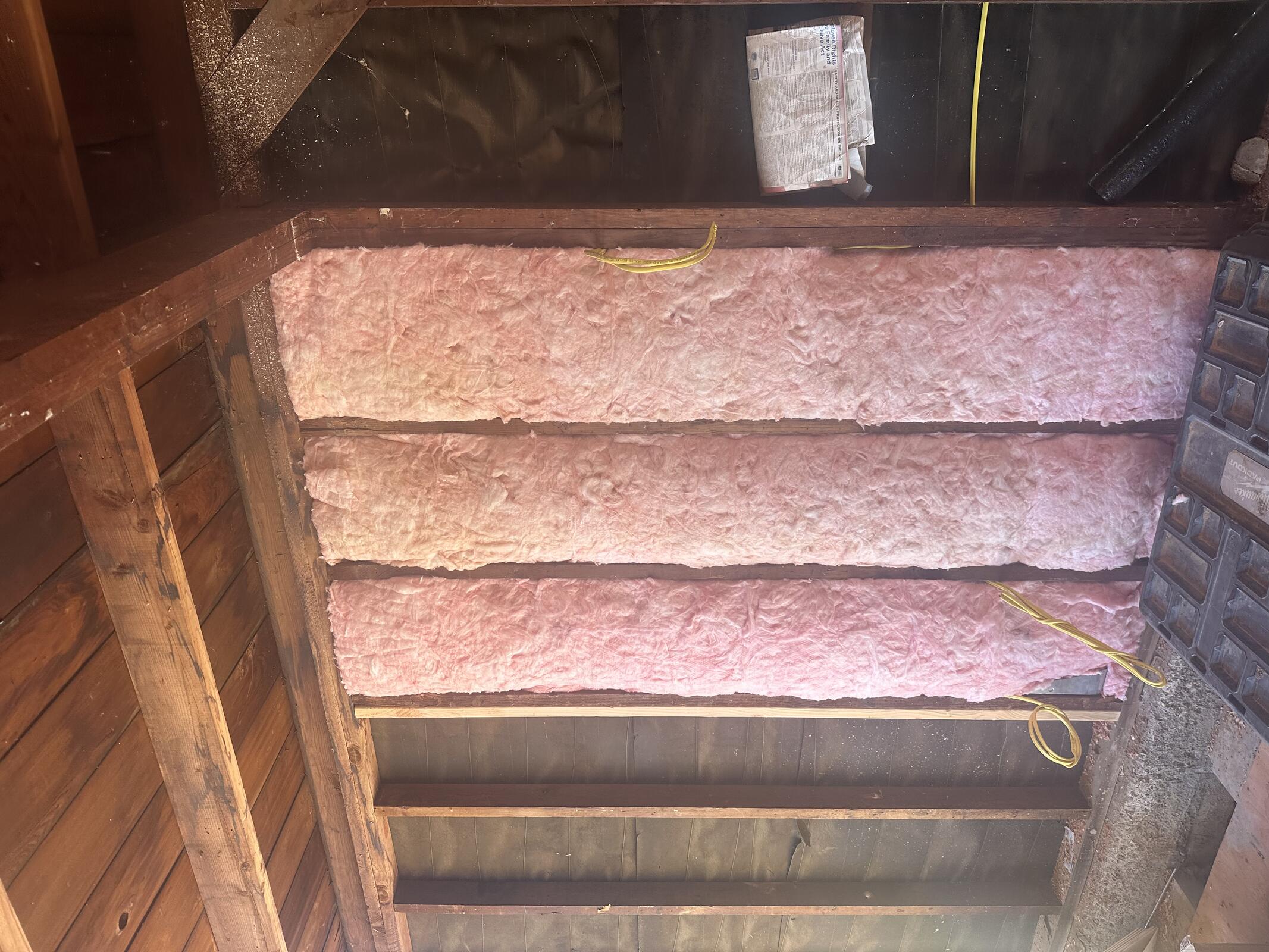

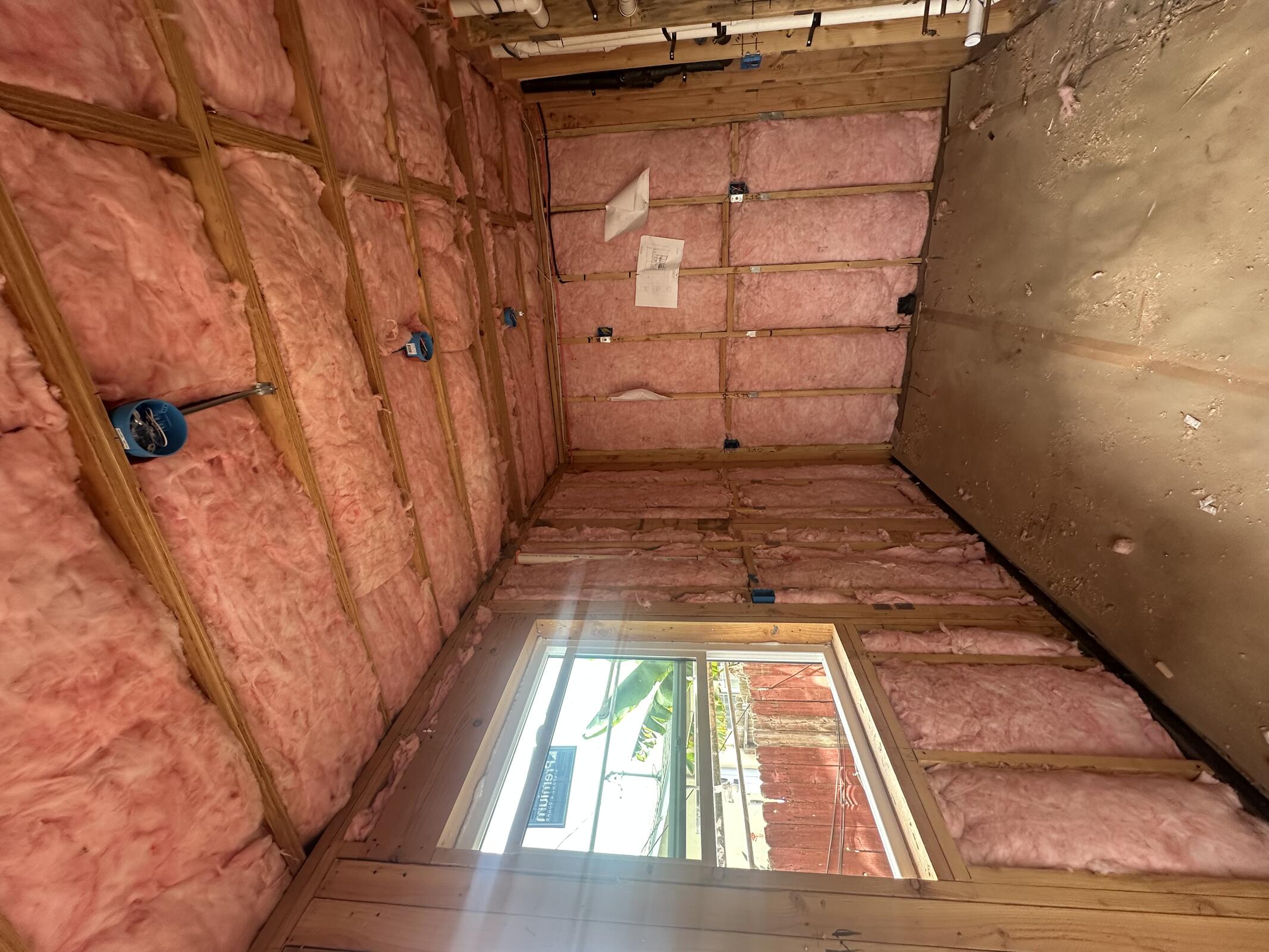

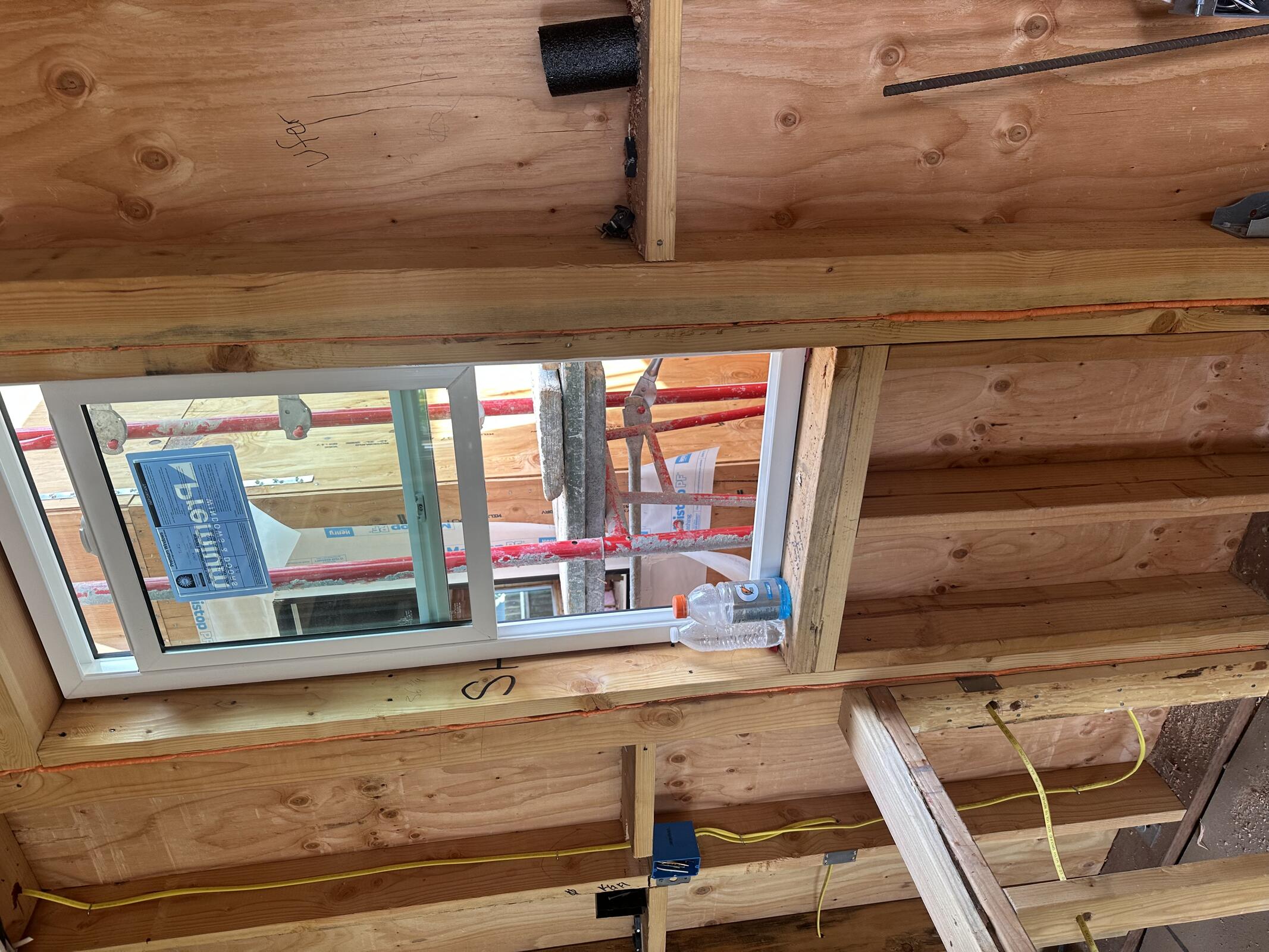

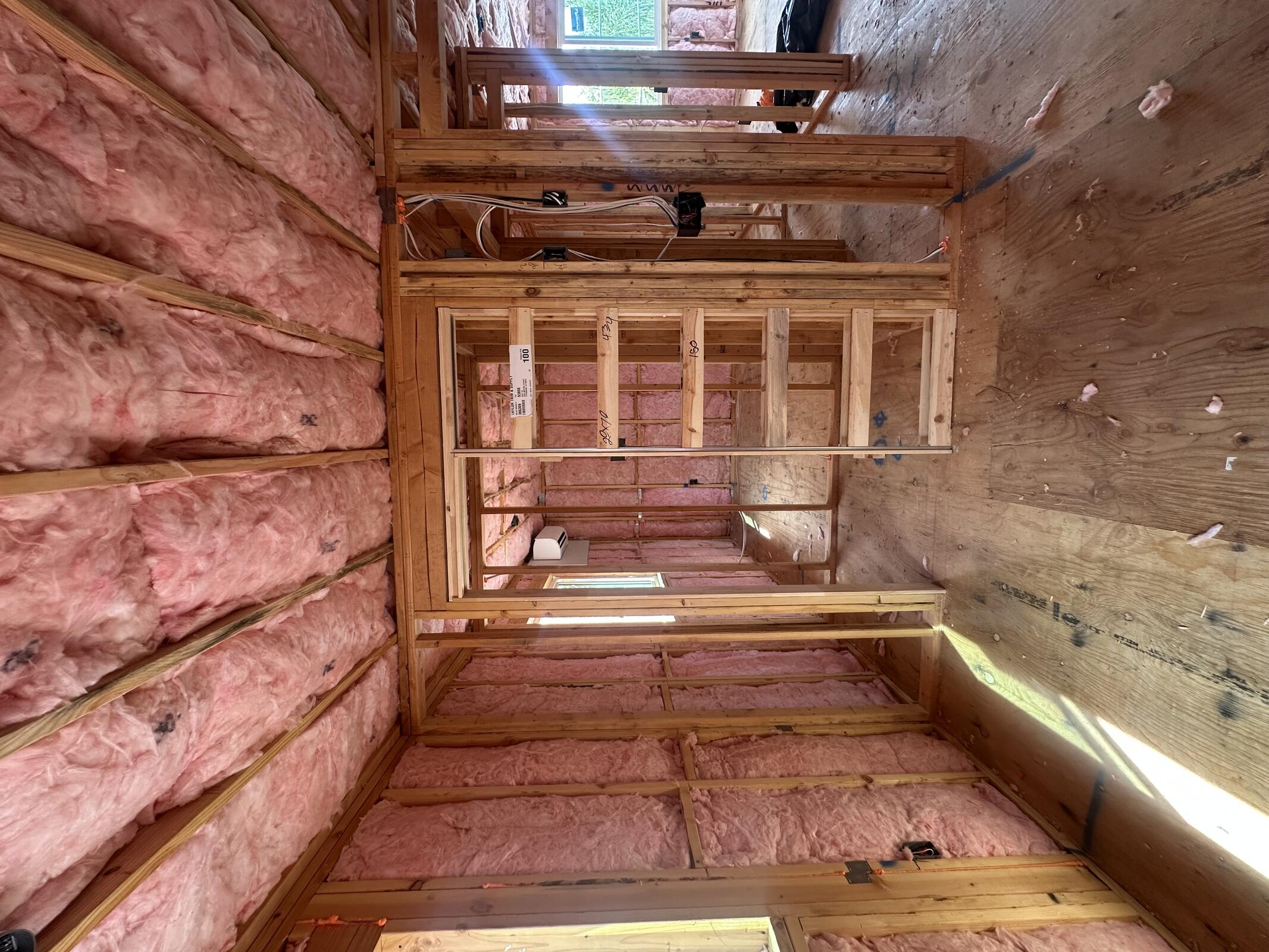

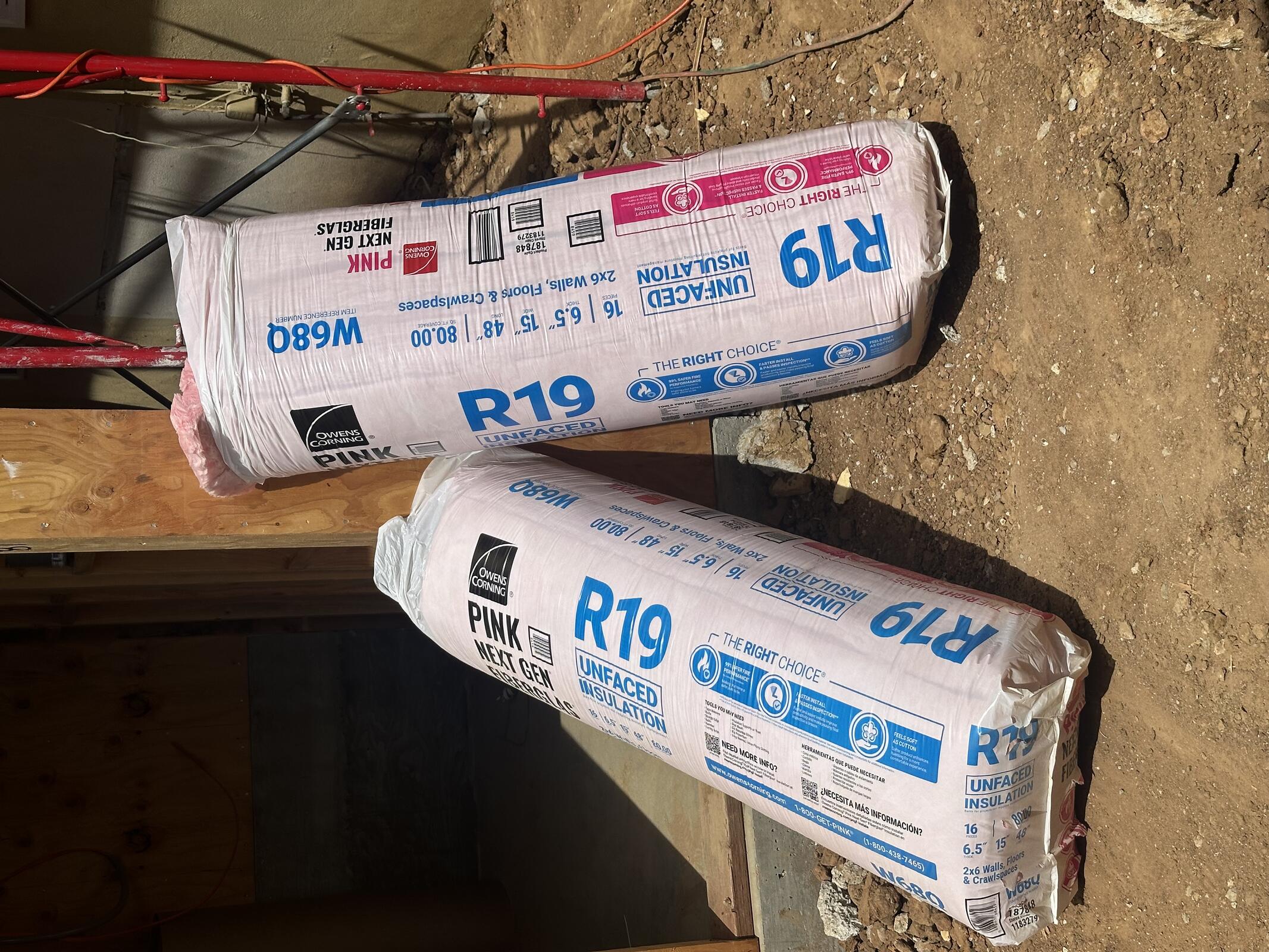

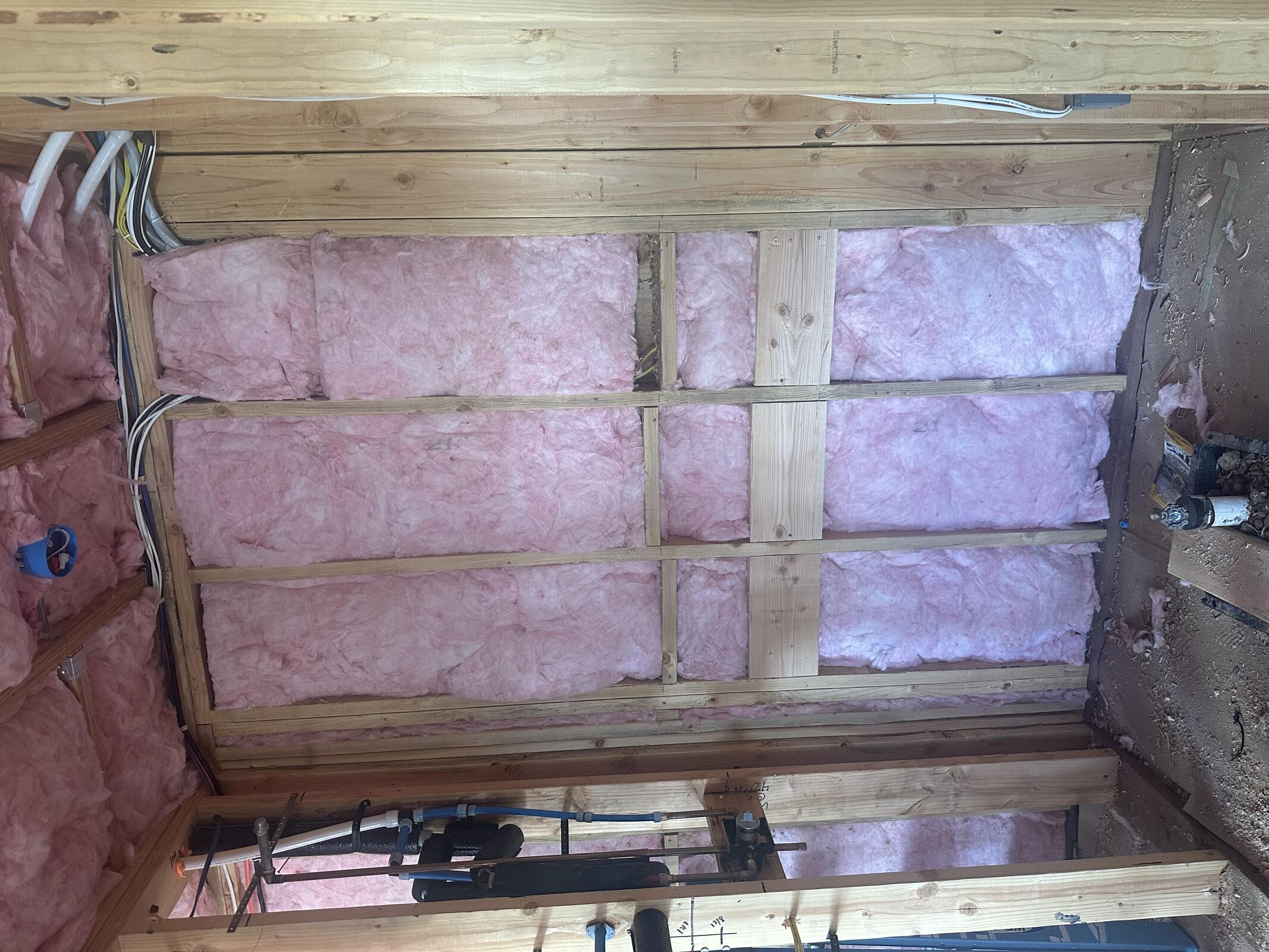

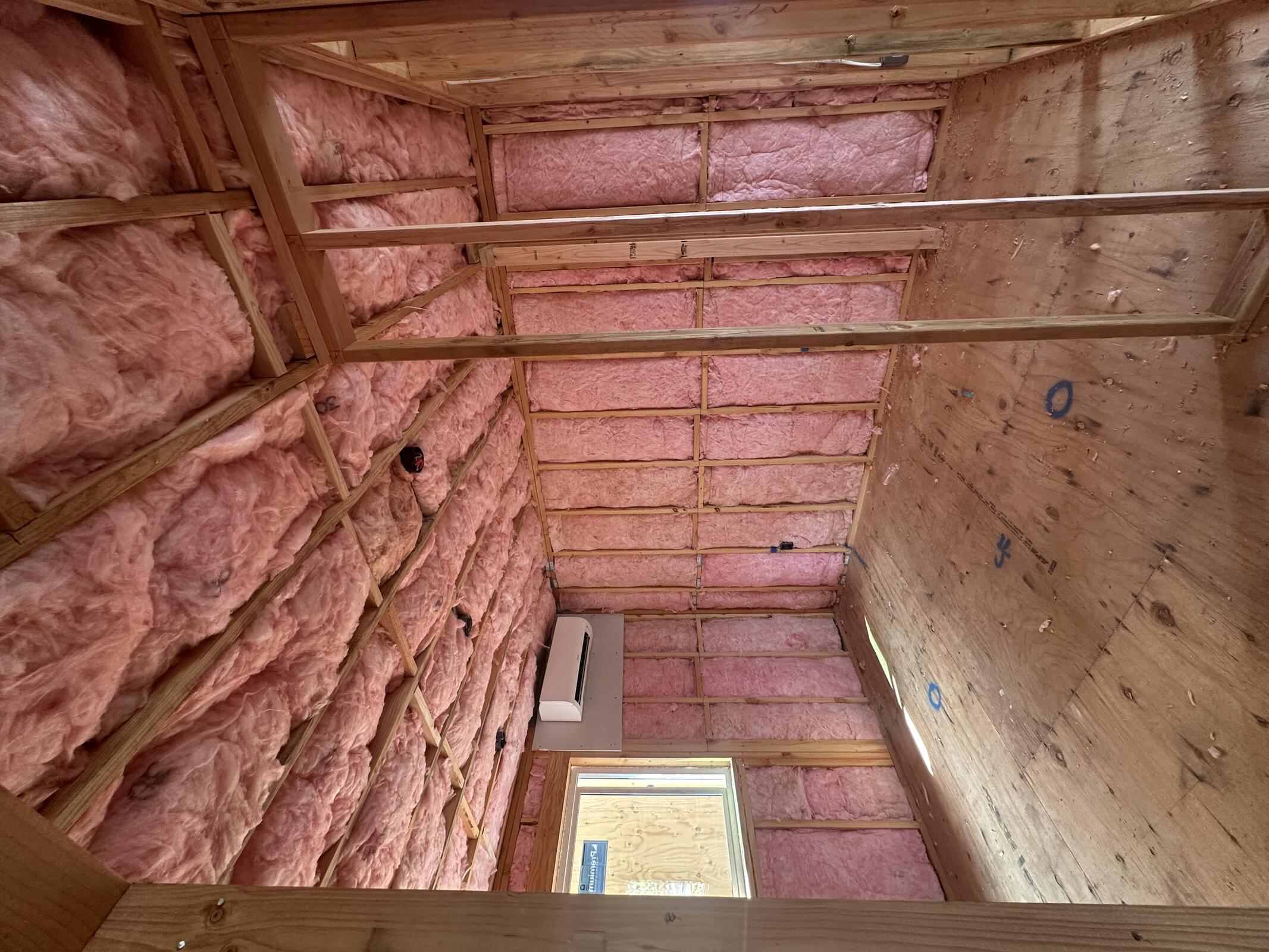

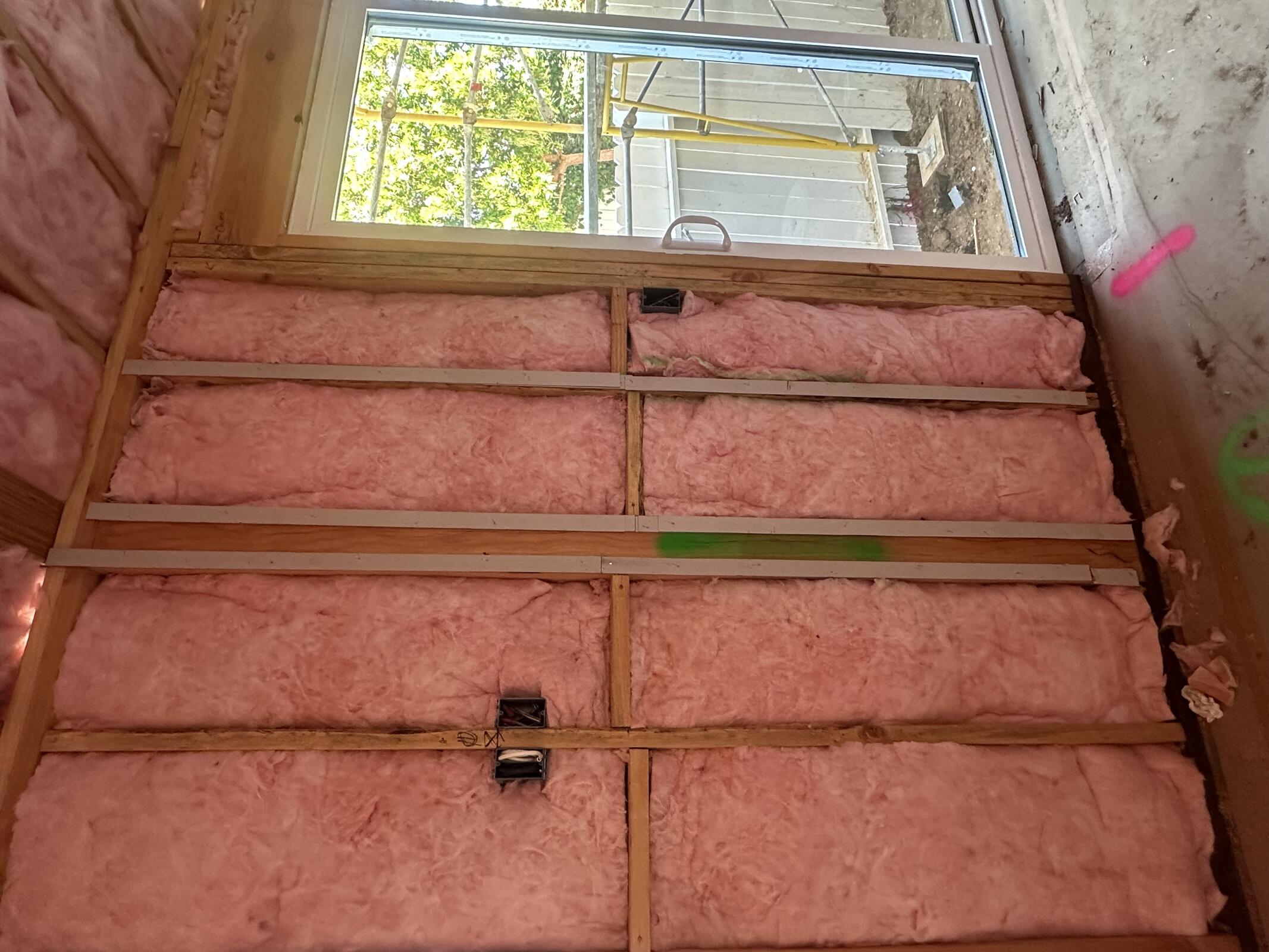

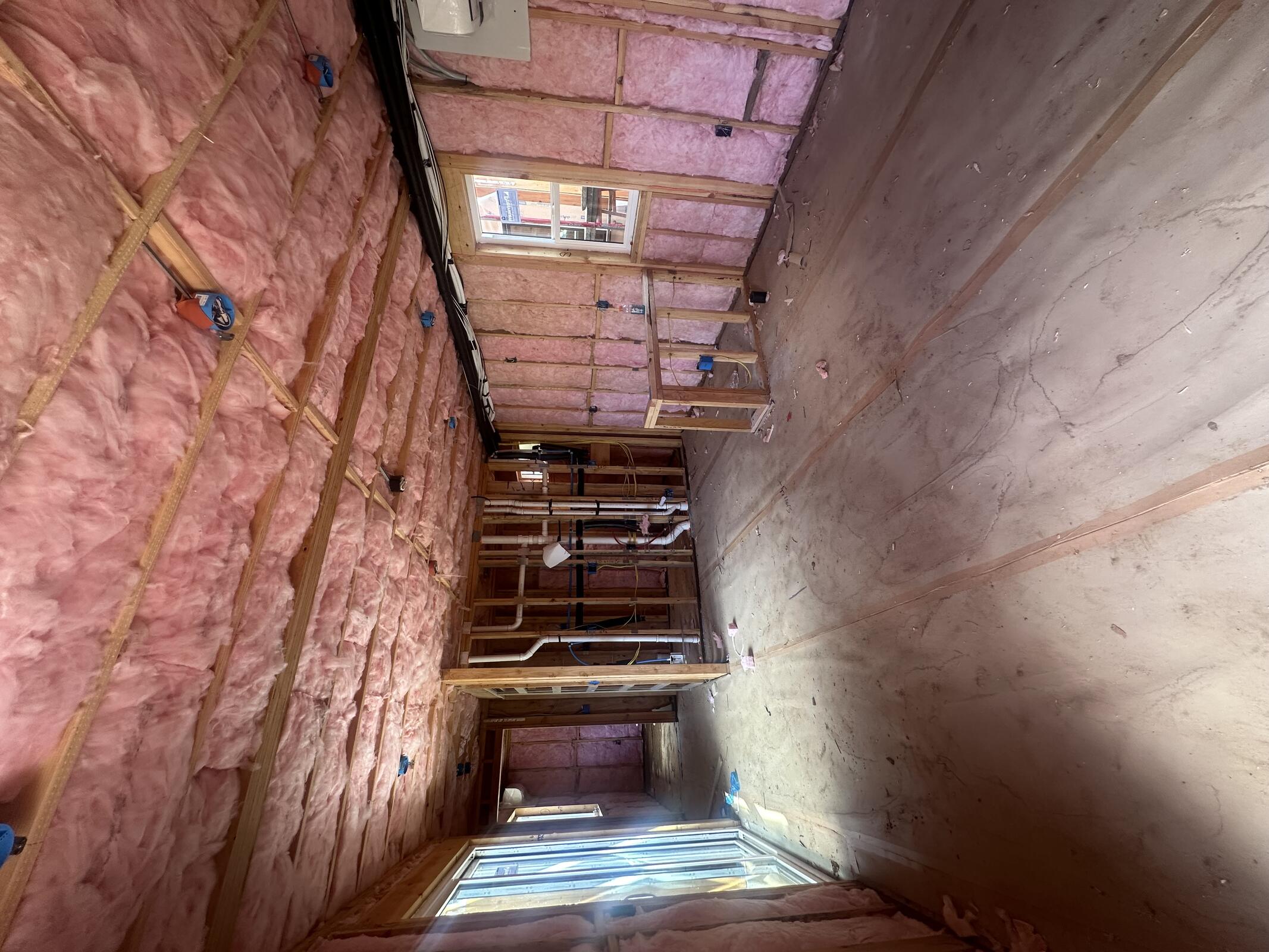

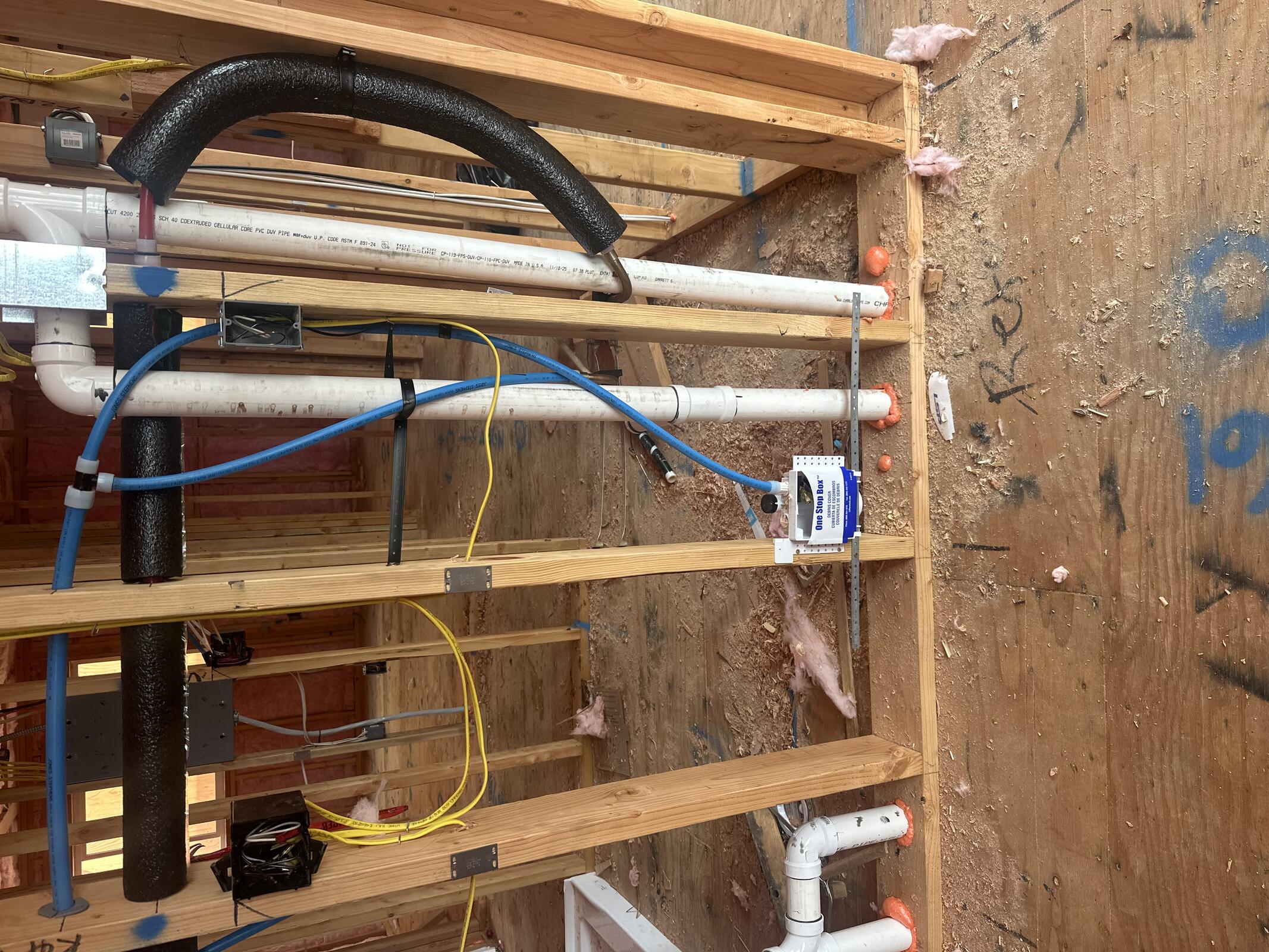

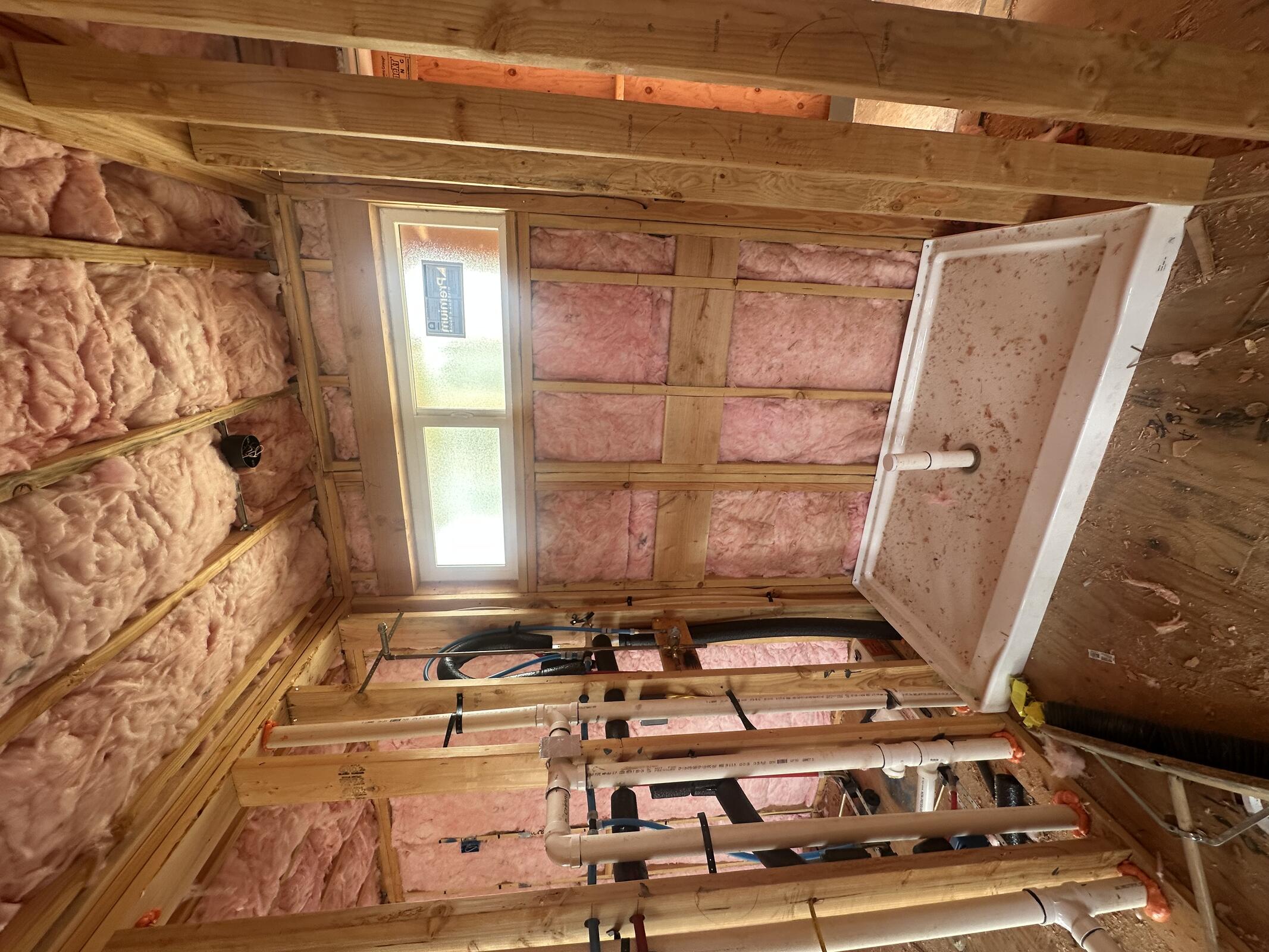

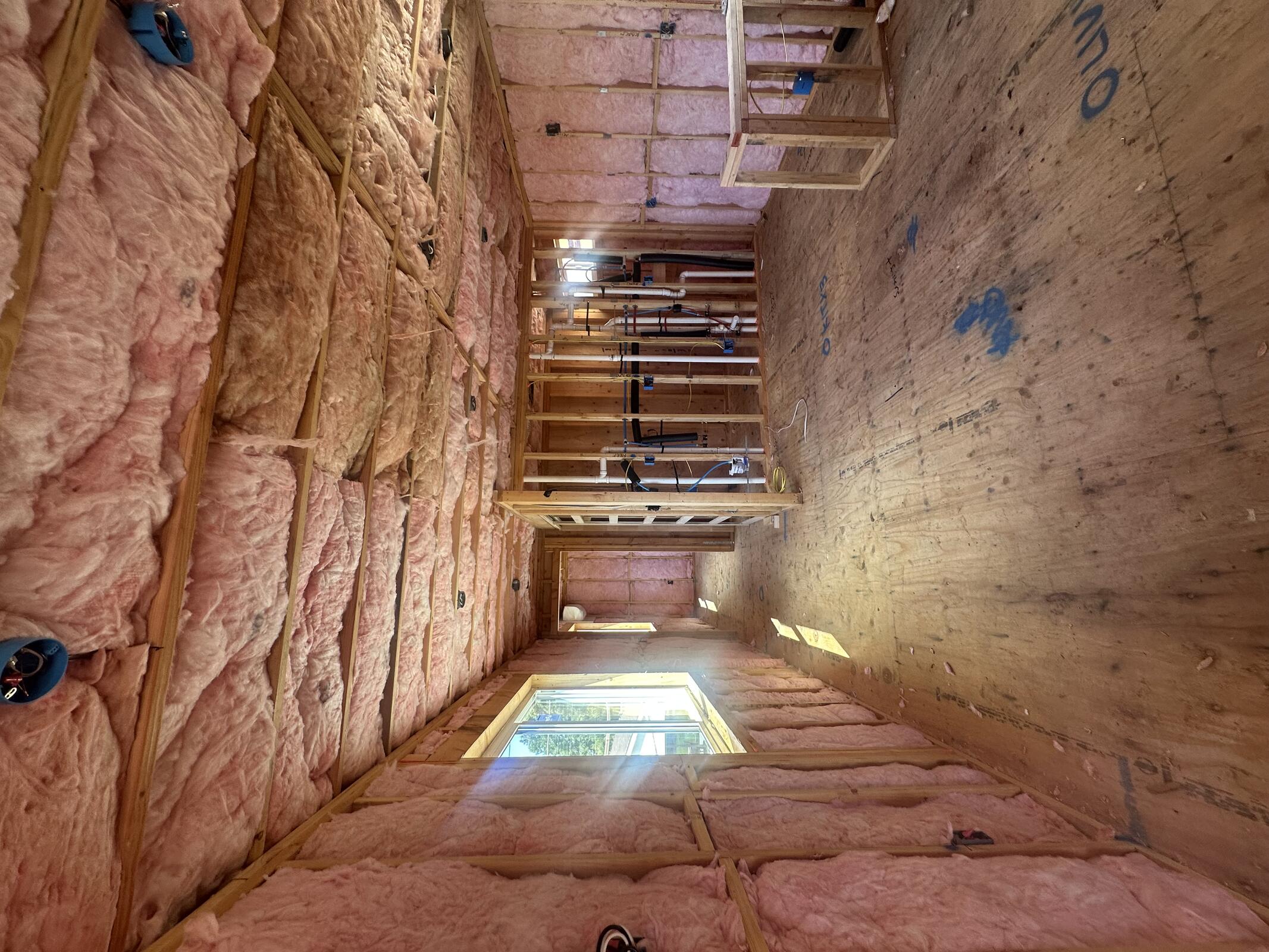

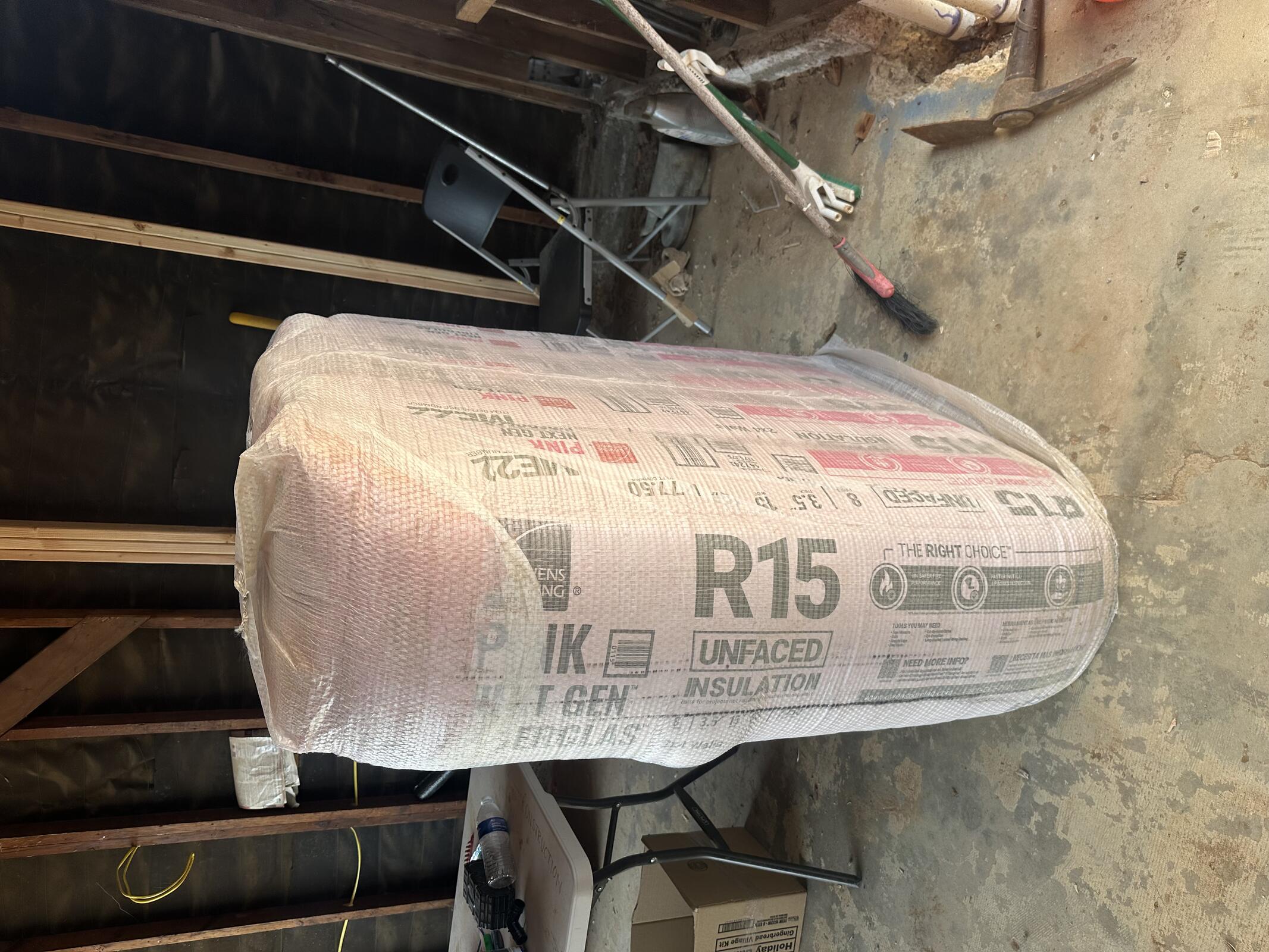

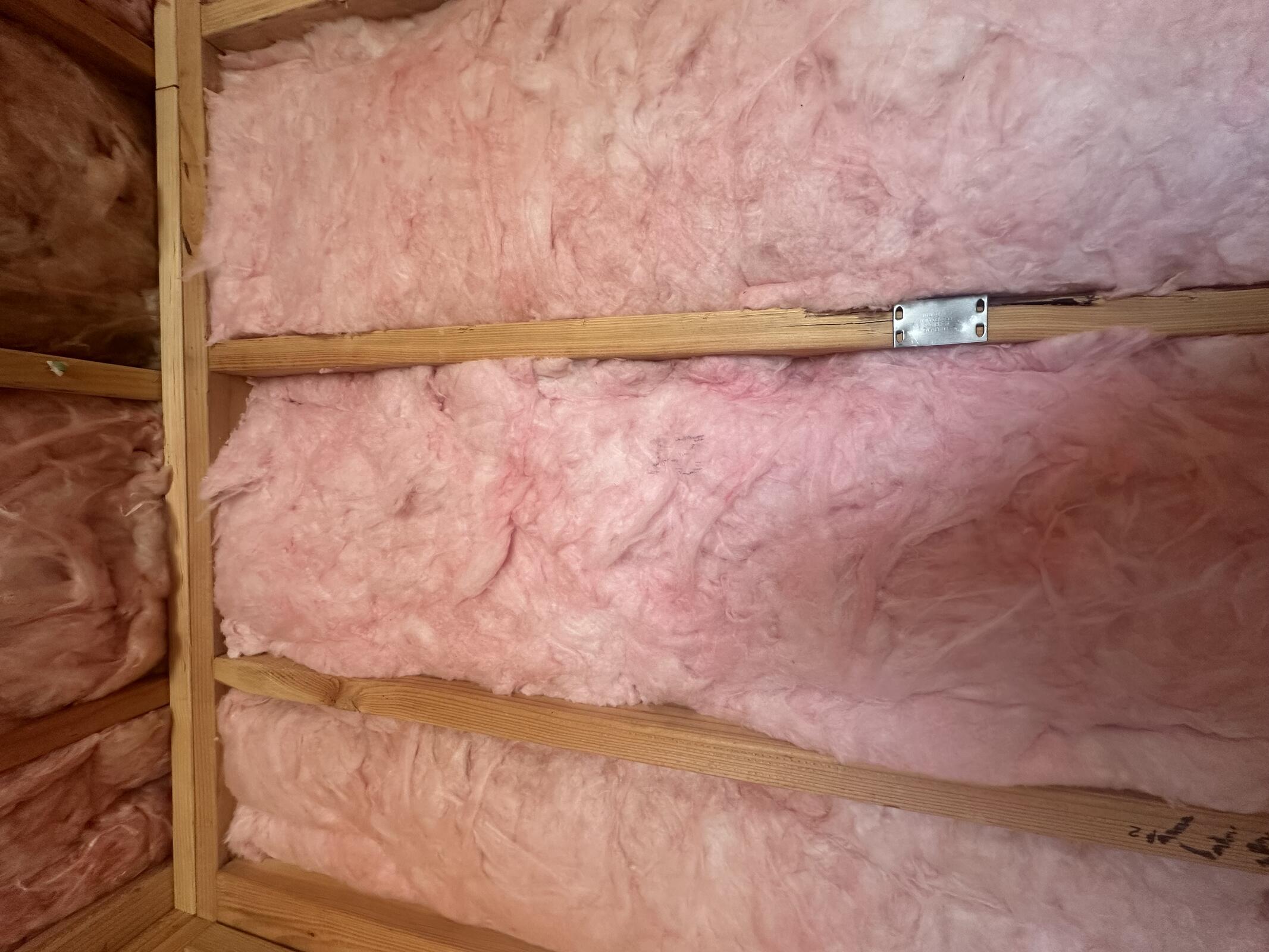

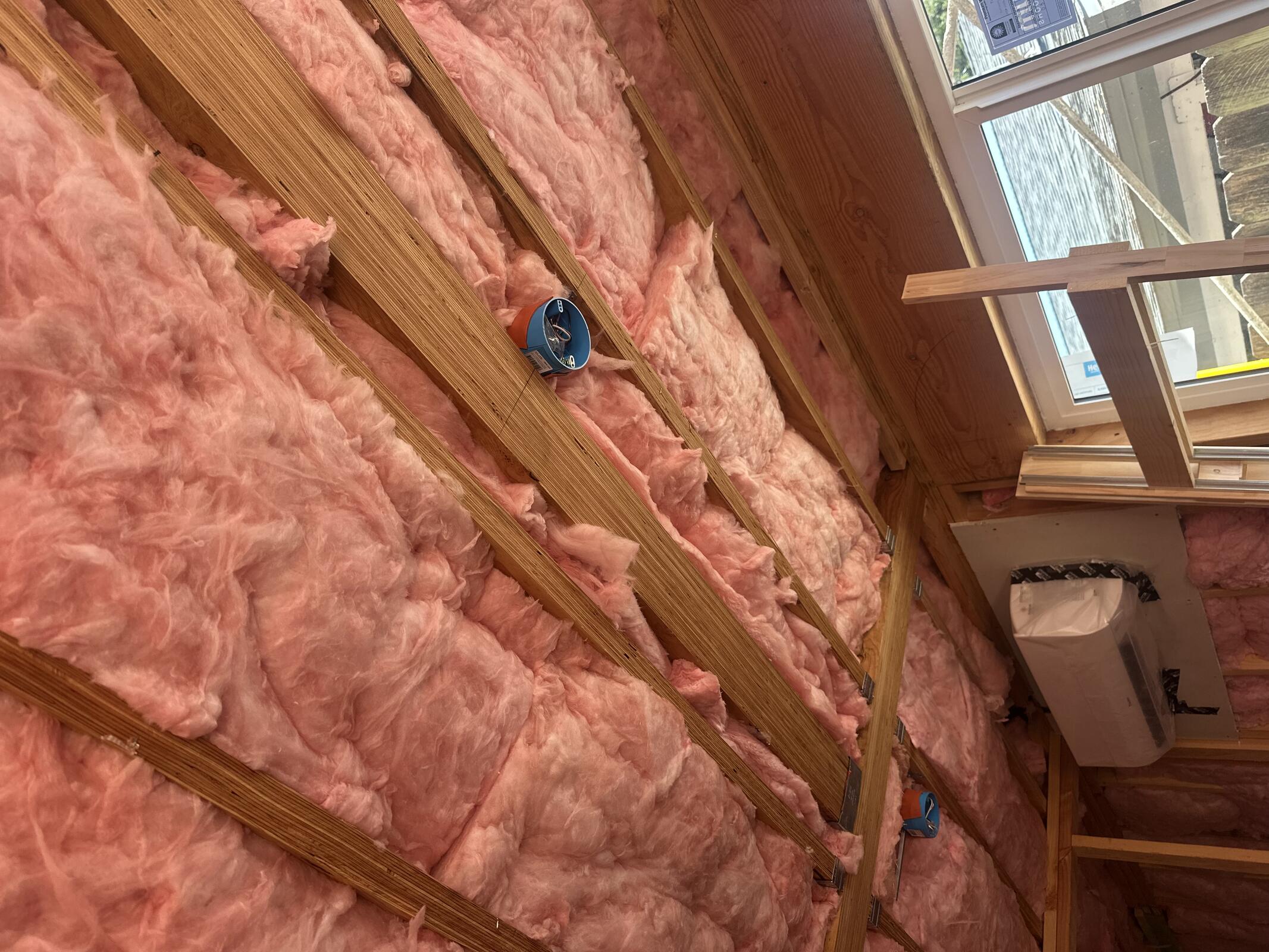

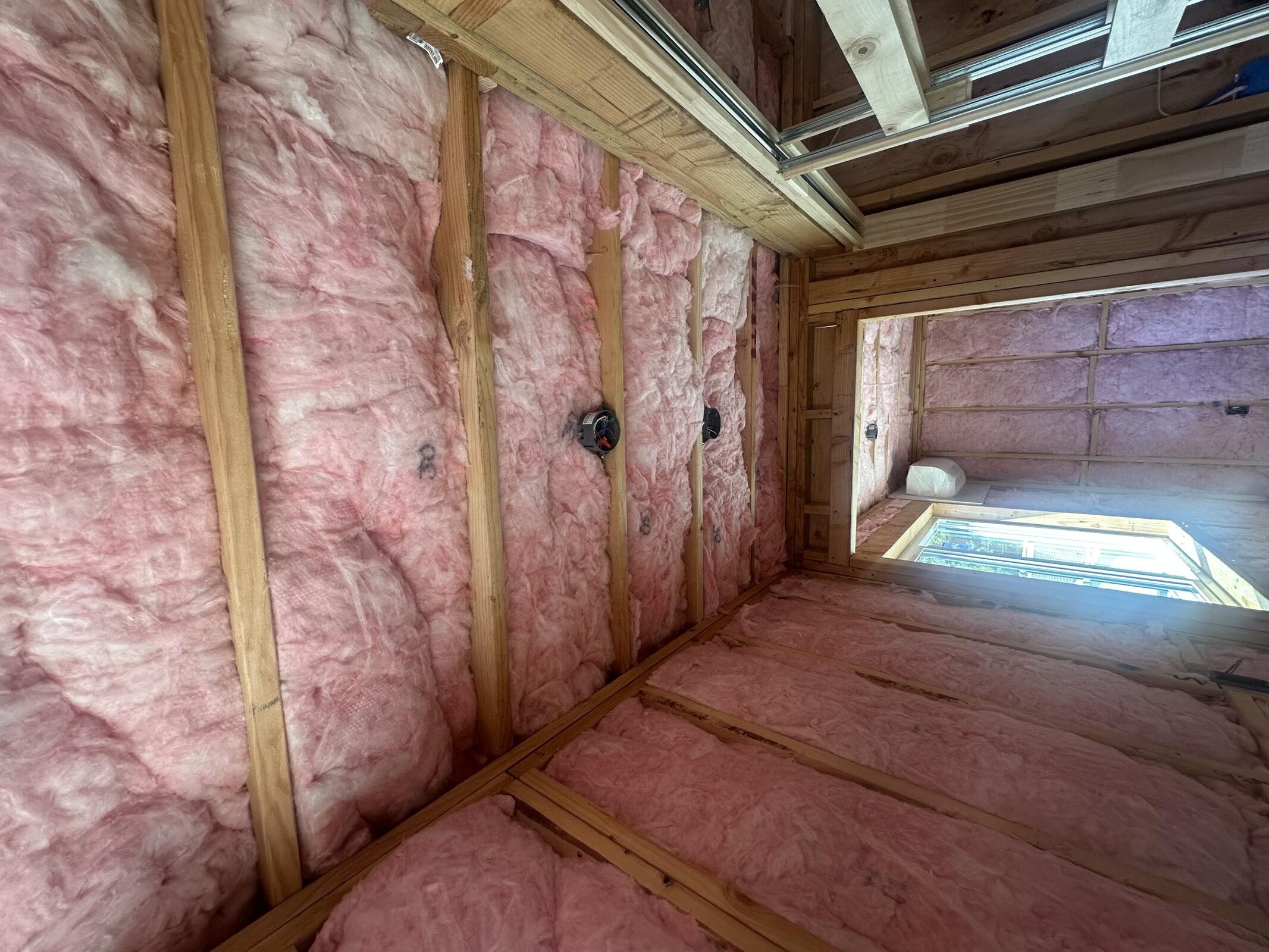

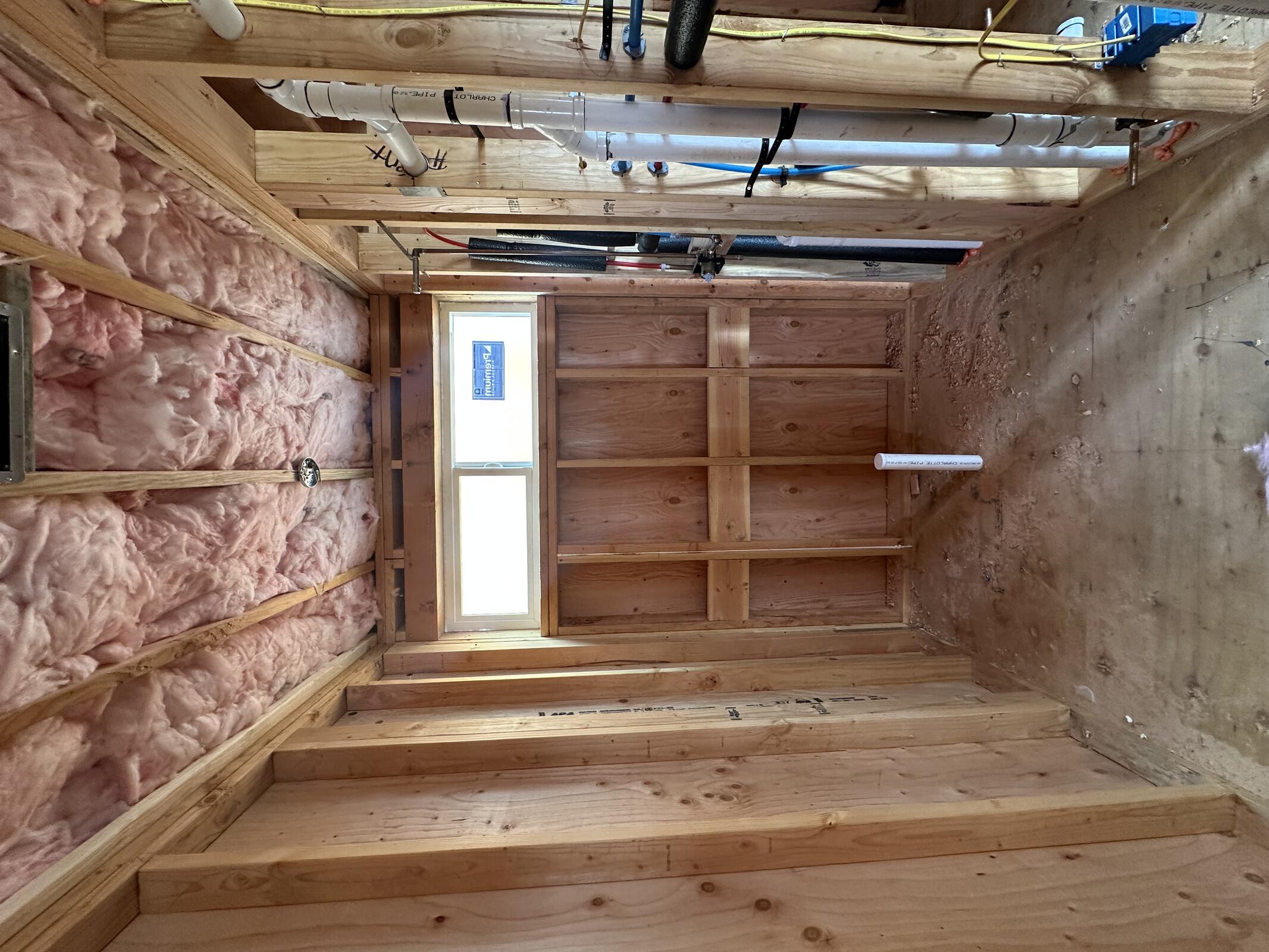

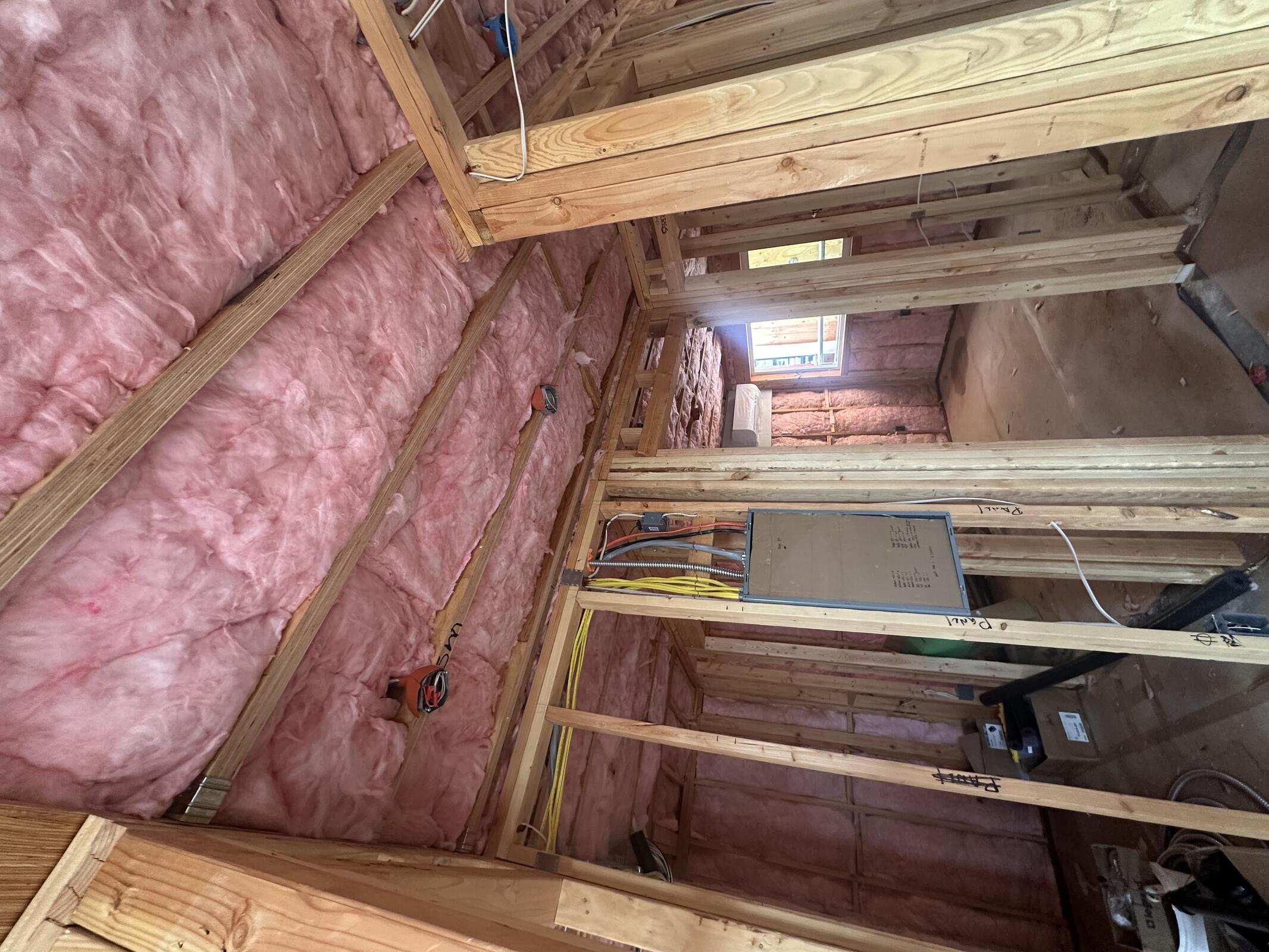

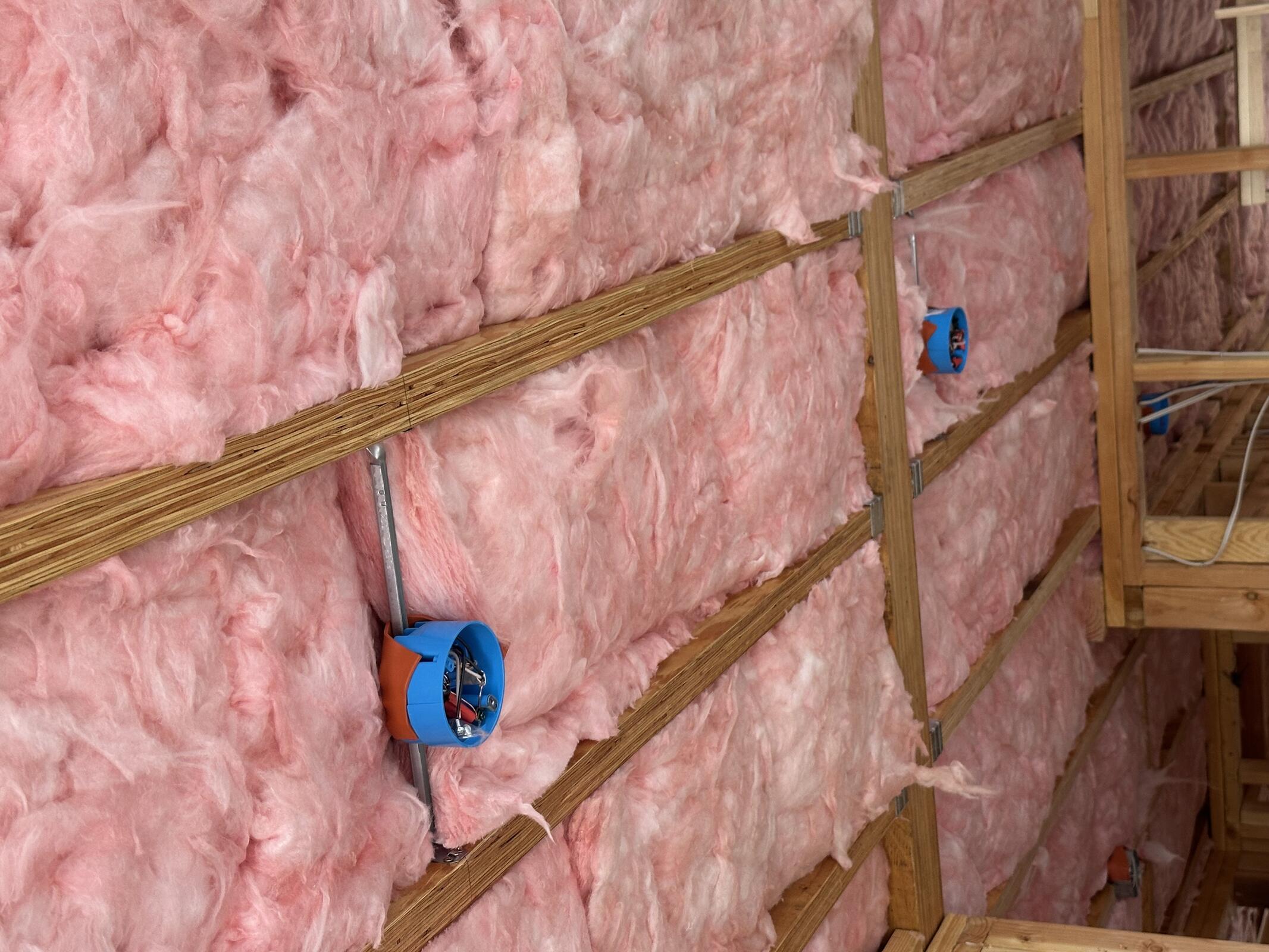

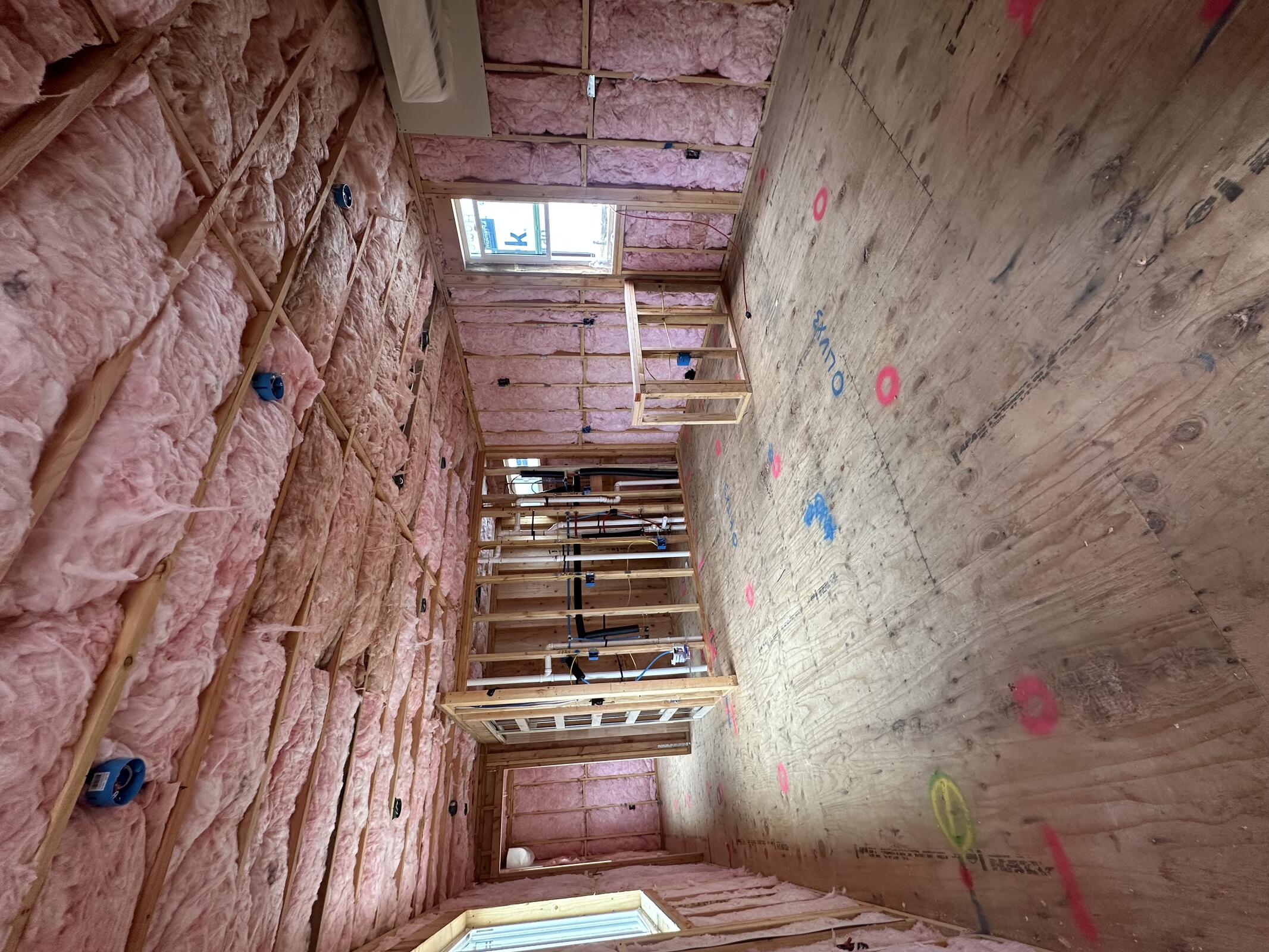

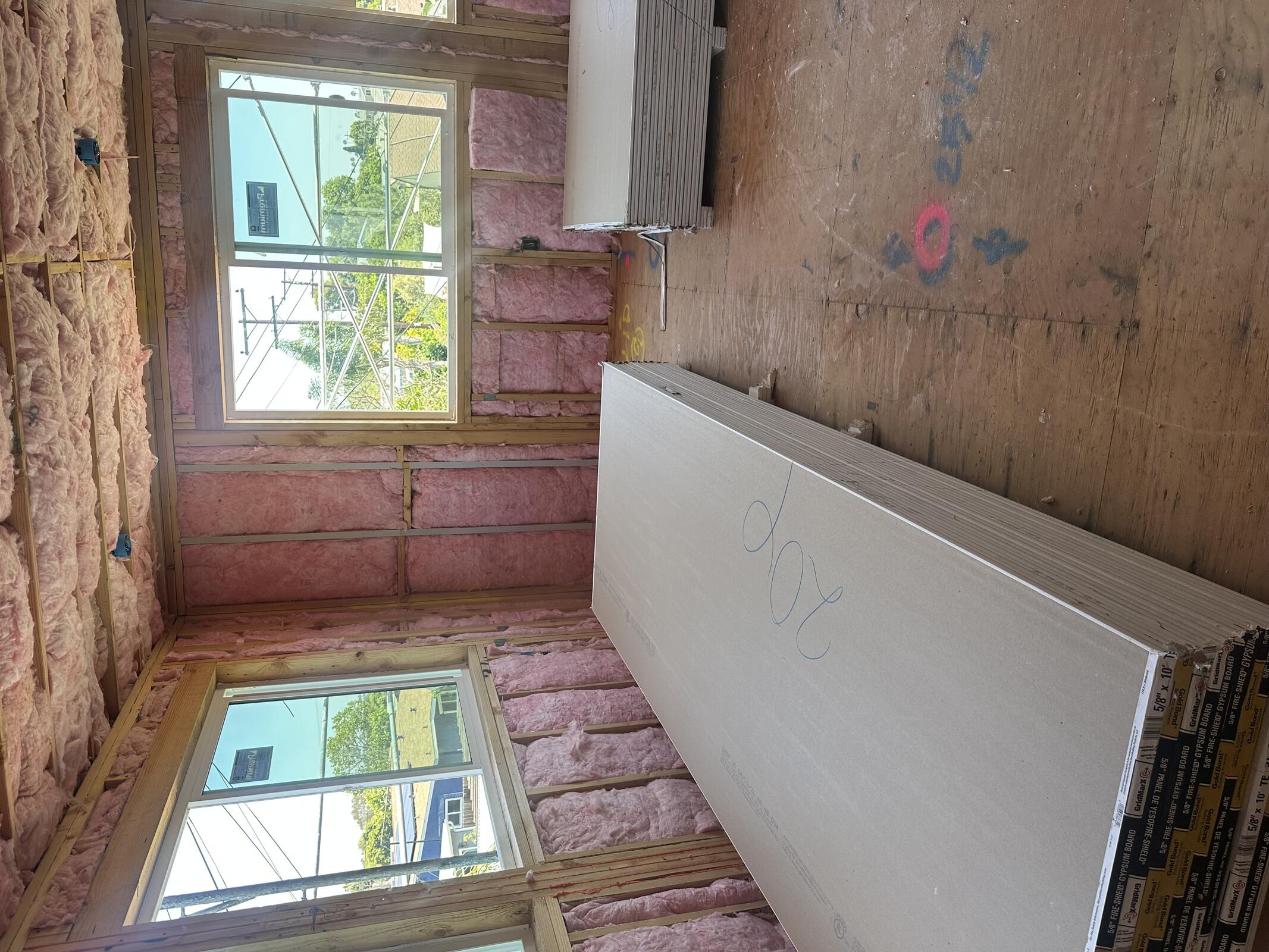

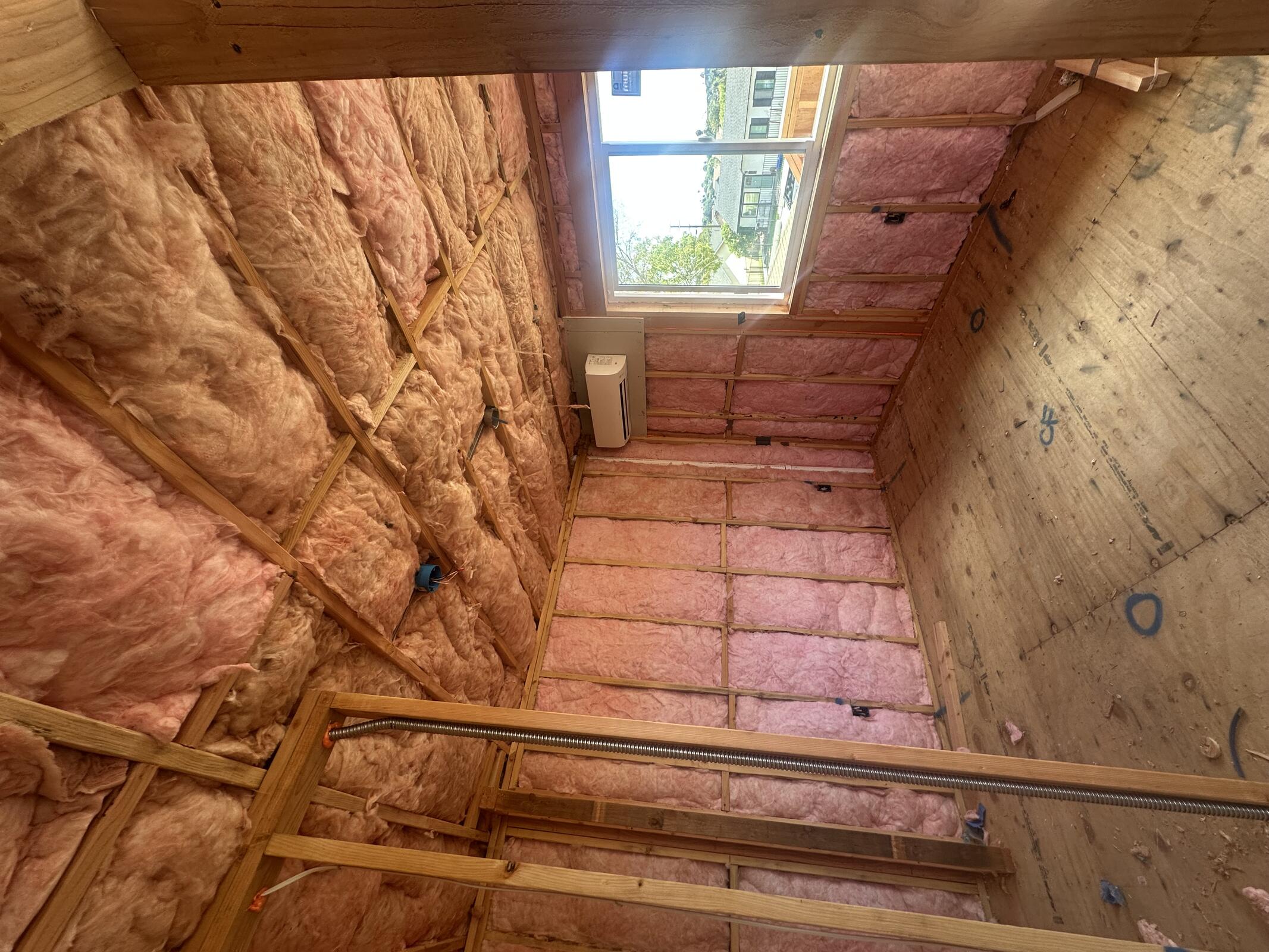

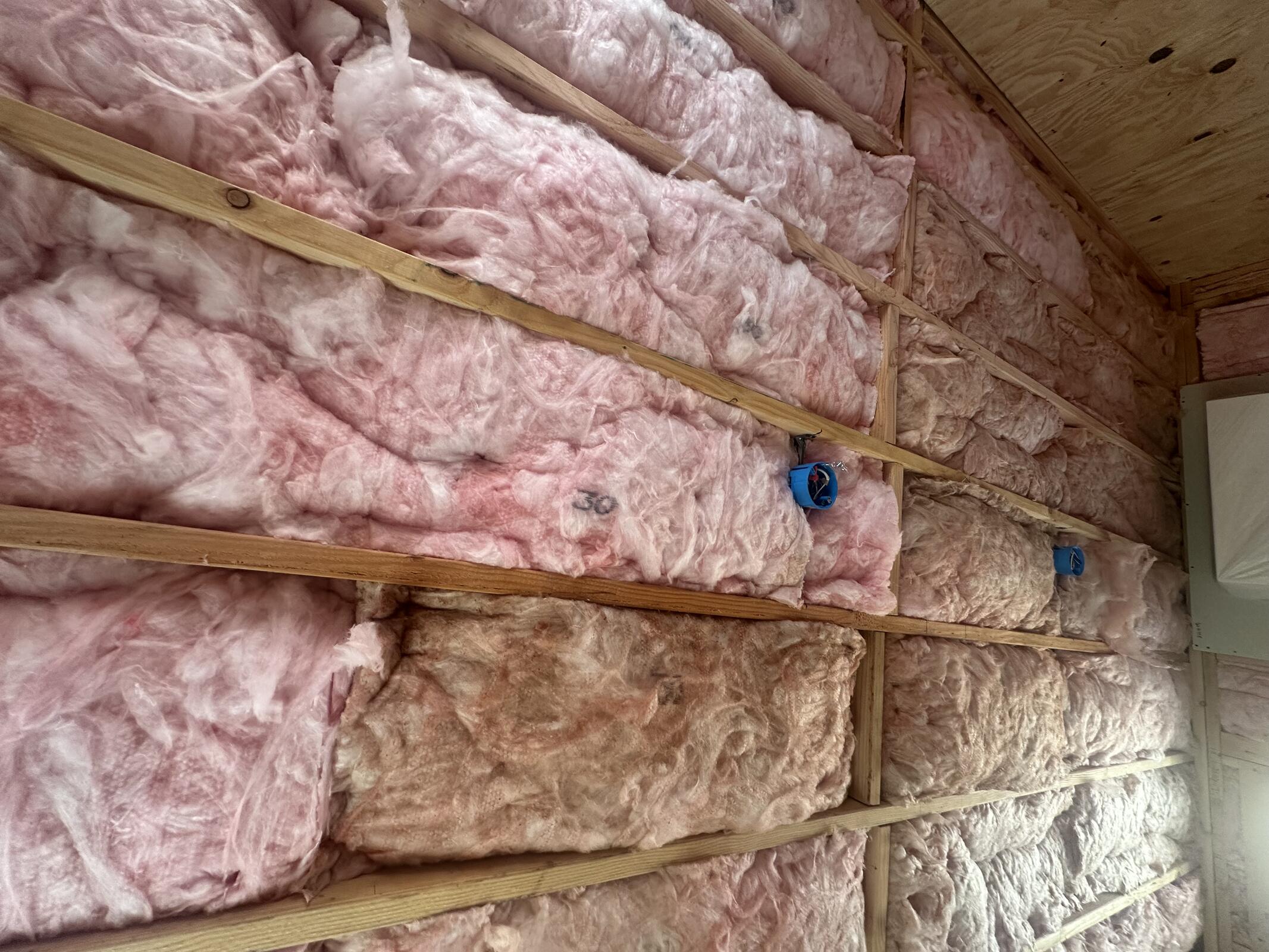

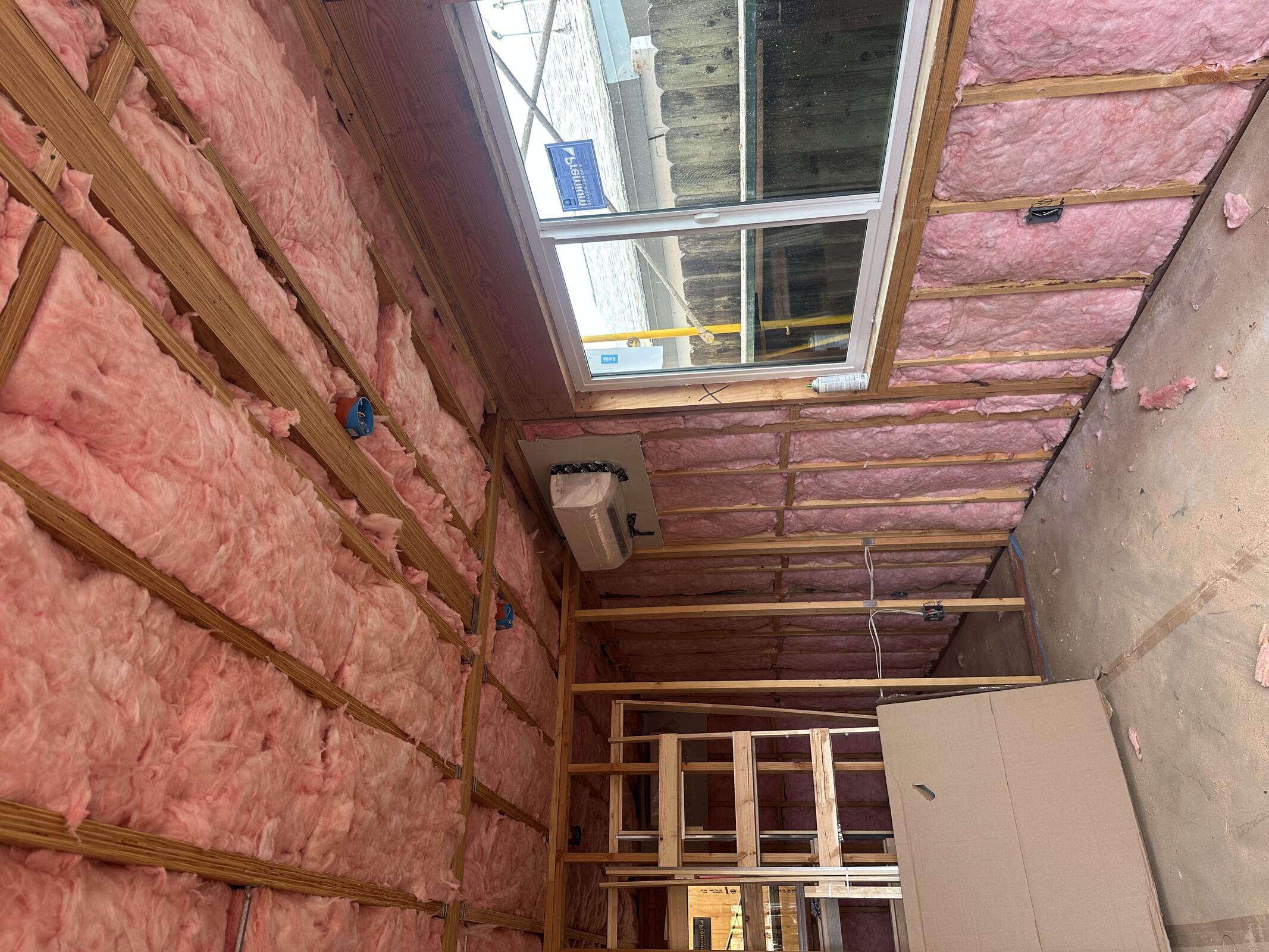

Insulation Labs on site, insulating Structure B and spraying foam around openings.

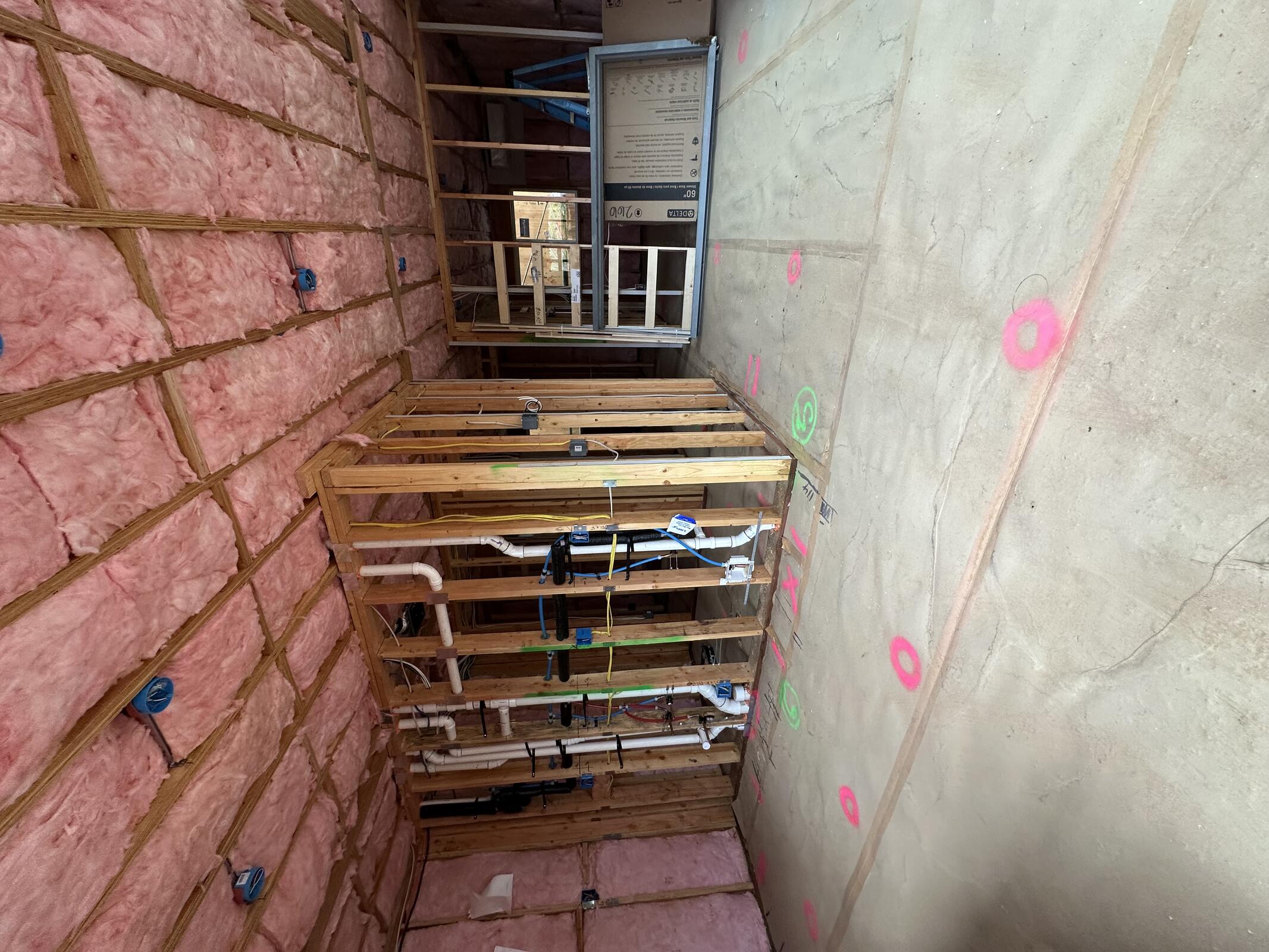

JB General added backing for future grab handles in bathrooms
Gold Coast (C3 Civil) doing final pave).
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| Insulation Labs | 2 | 8 | 16 |
| C3 Civil | 4 | 4 | 16 |
| JB General | 1 | 2 | 2 |
Inspection: N/A

















Tuesday, May 05, 2026
Partially cloudy, 64°F

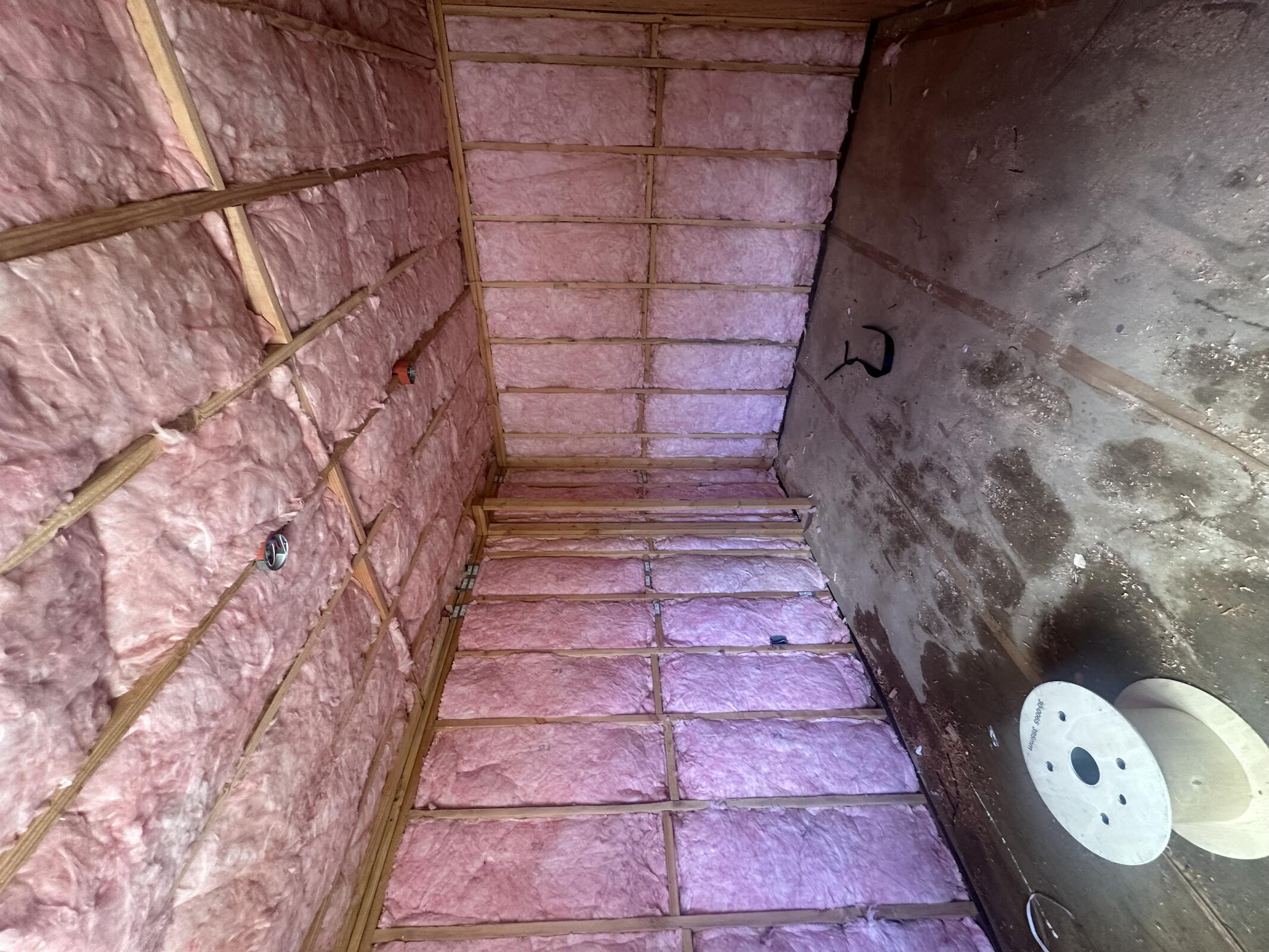

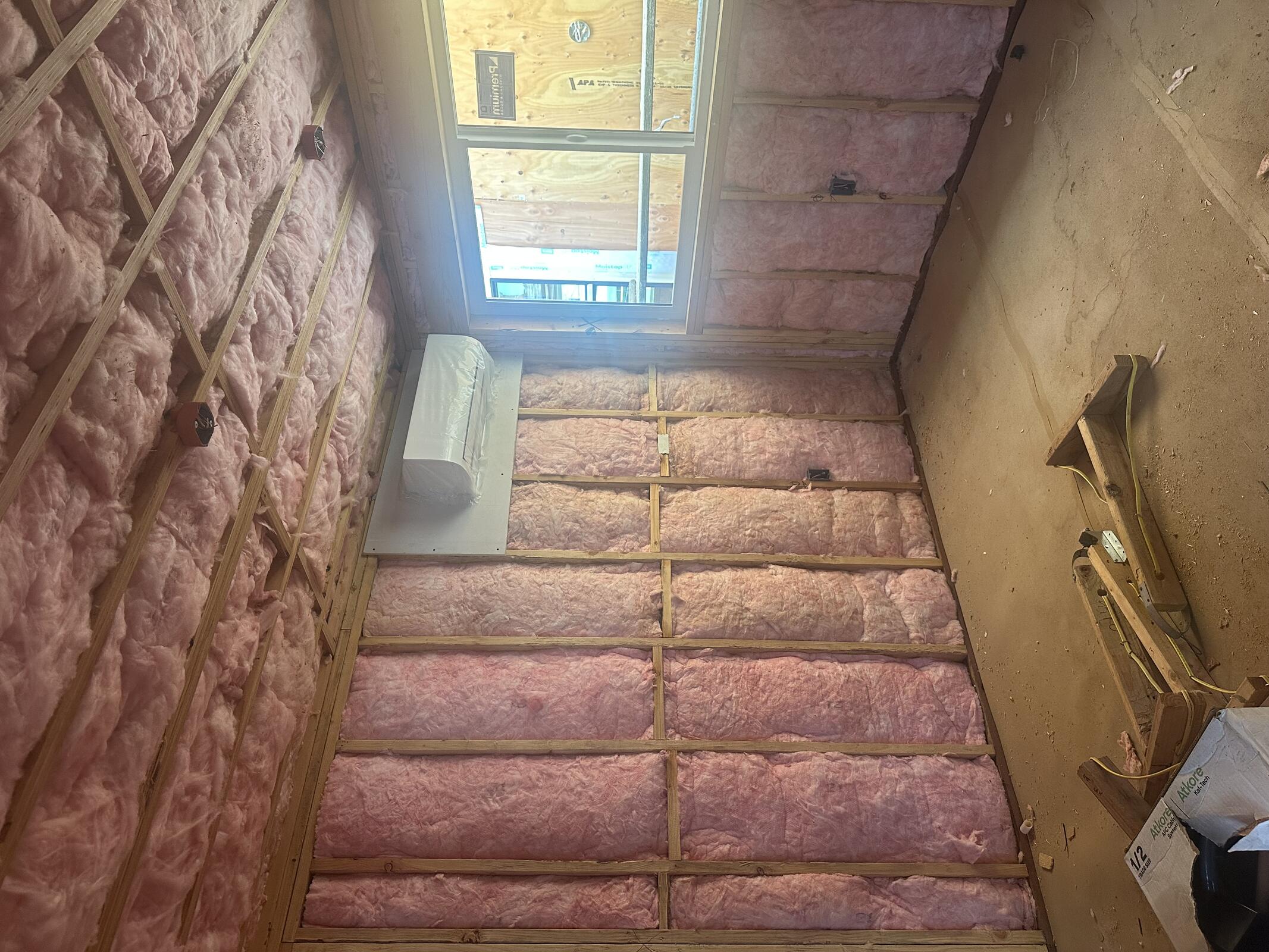

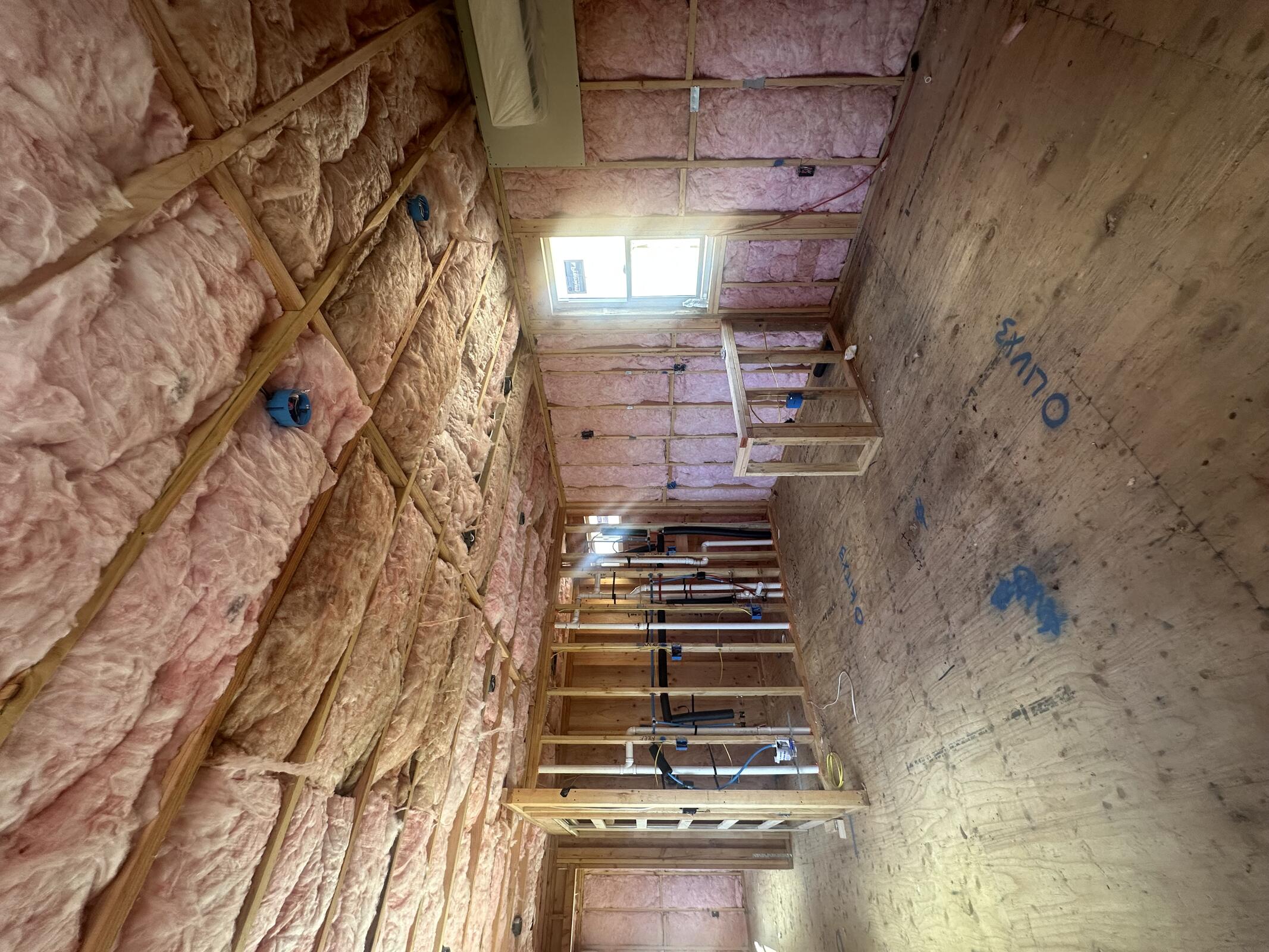

Insulation labs on site, finishing building B. Slight rain in the morning, but insulation was not affected.

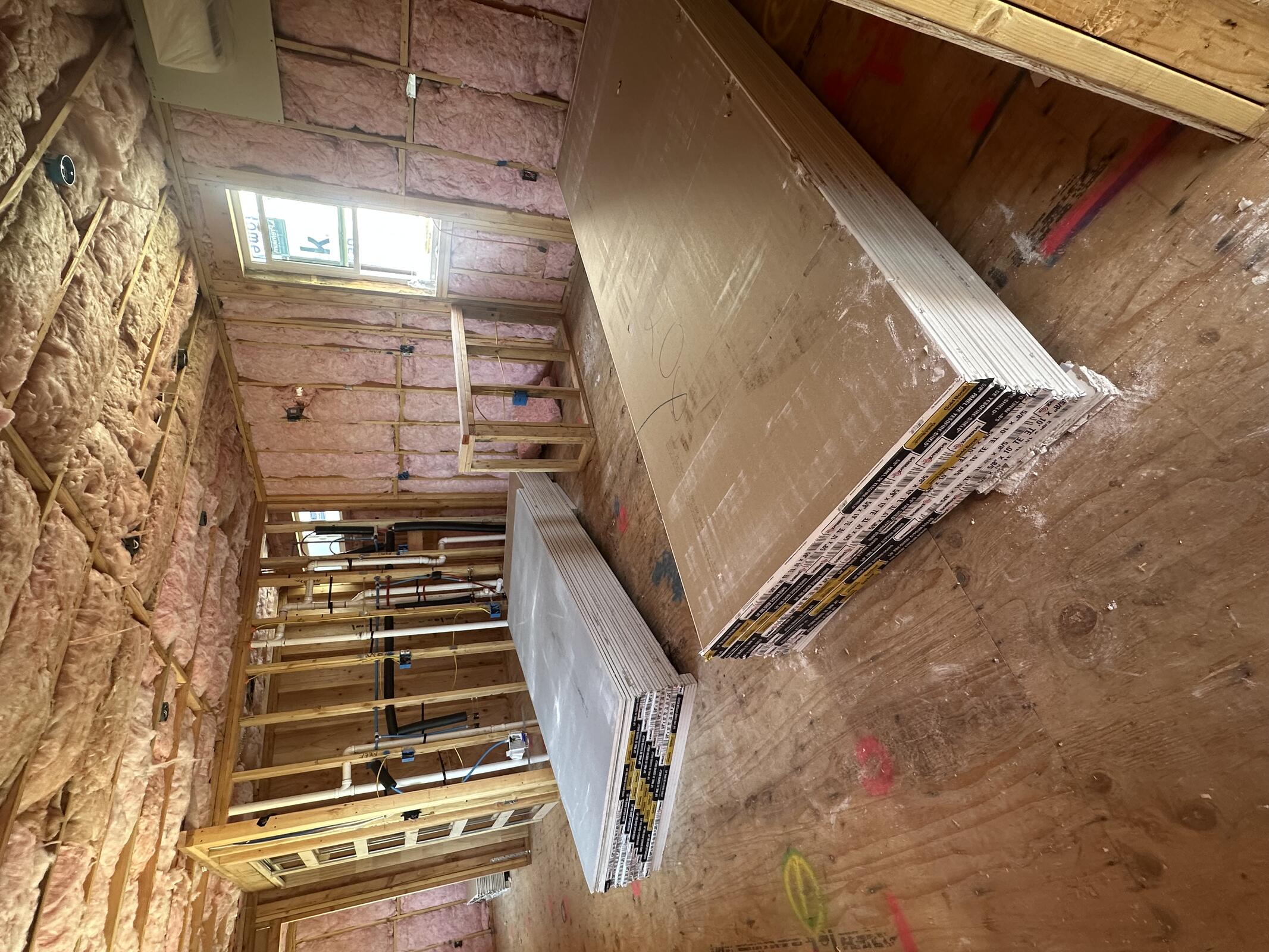

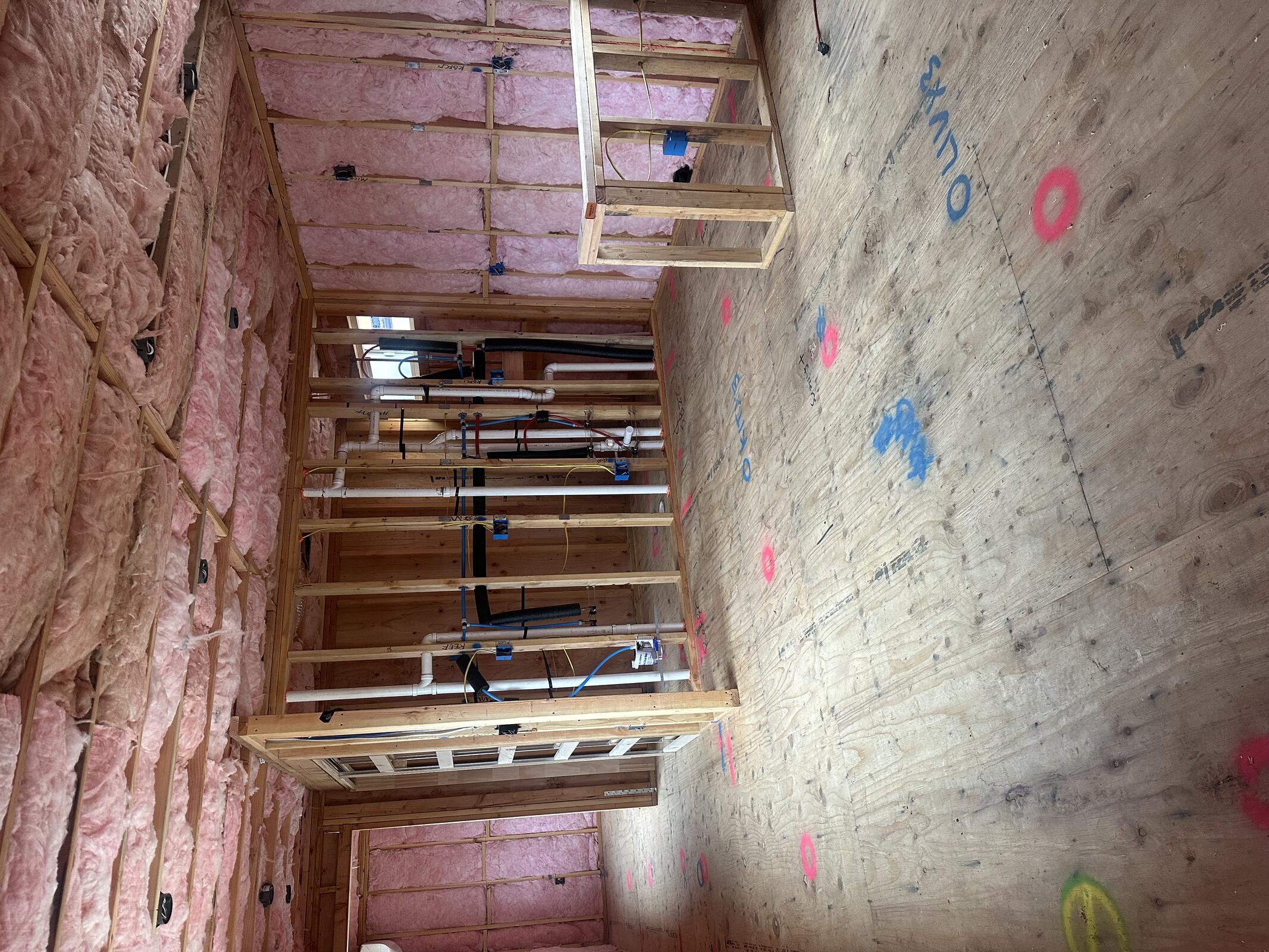

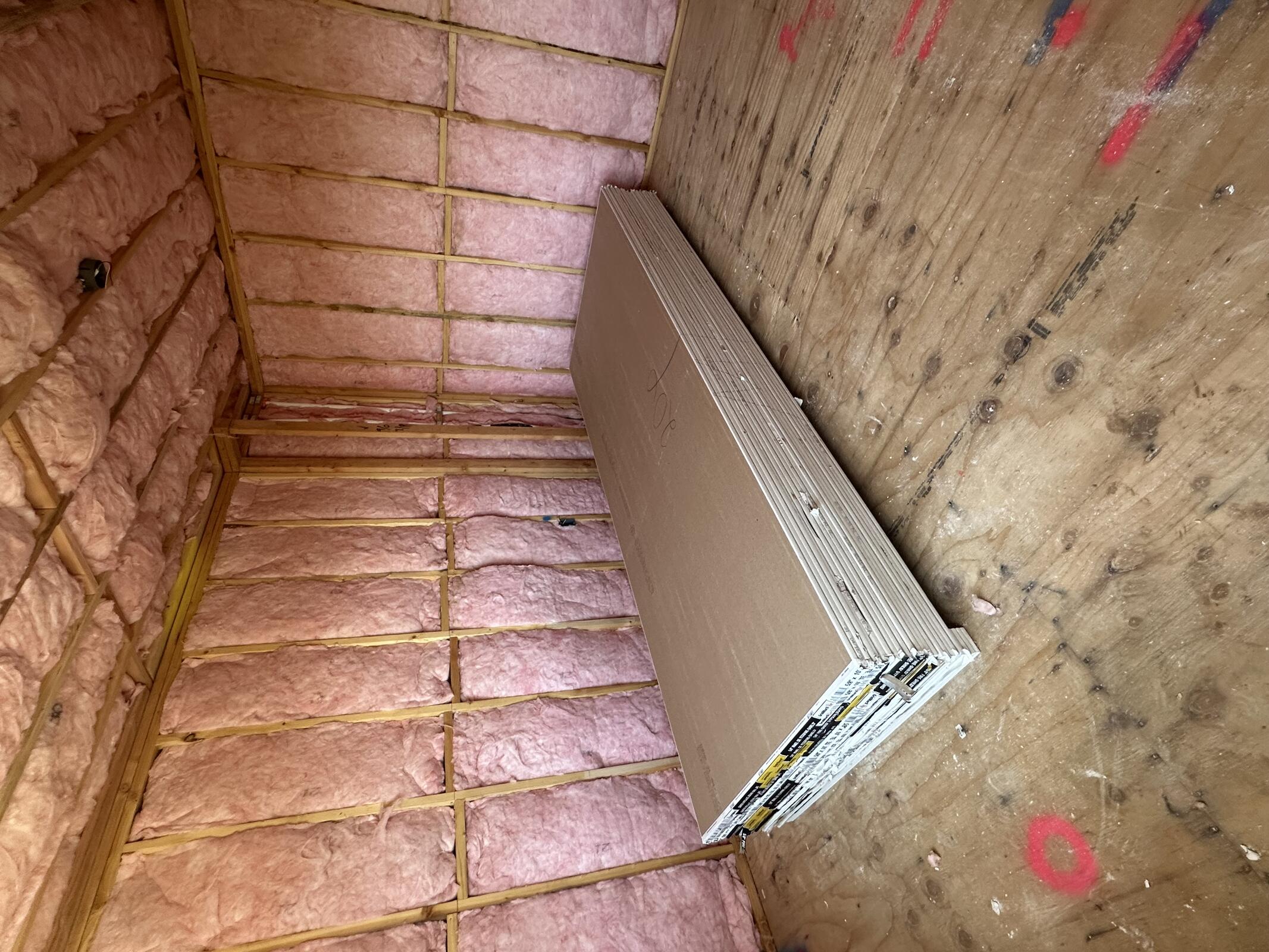

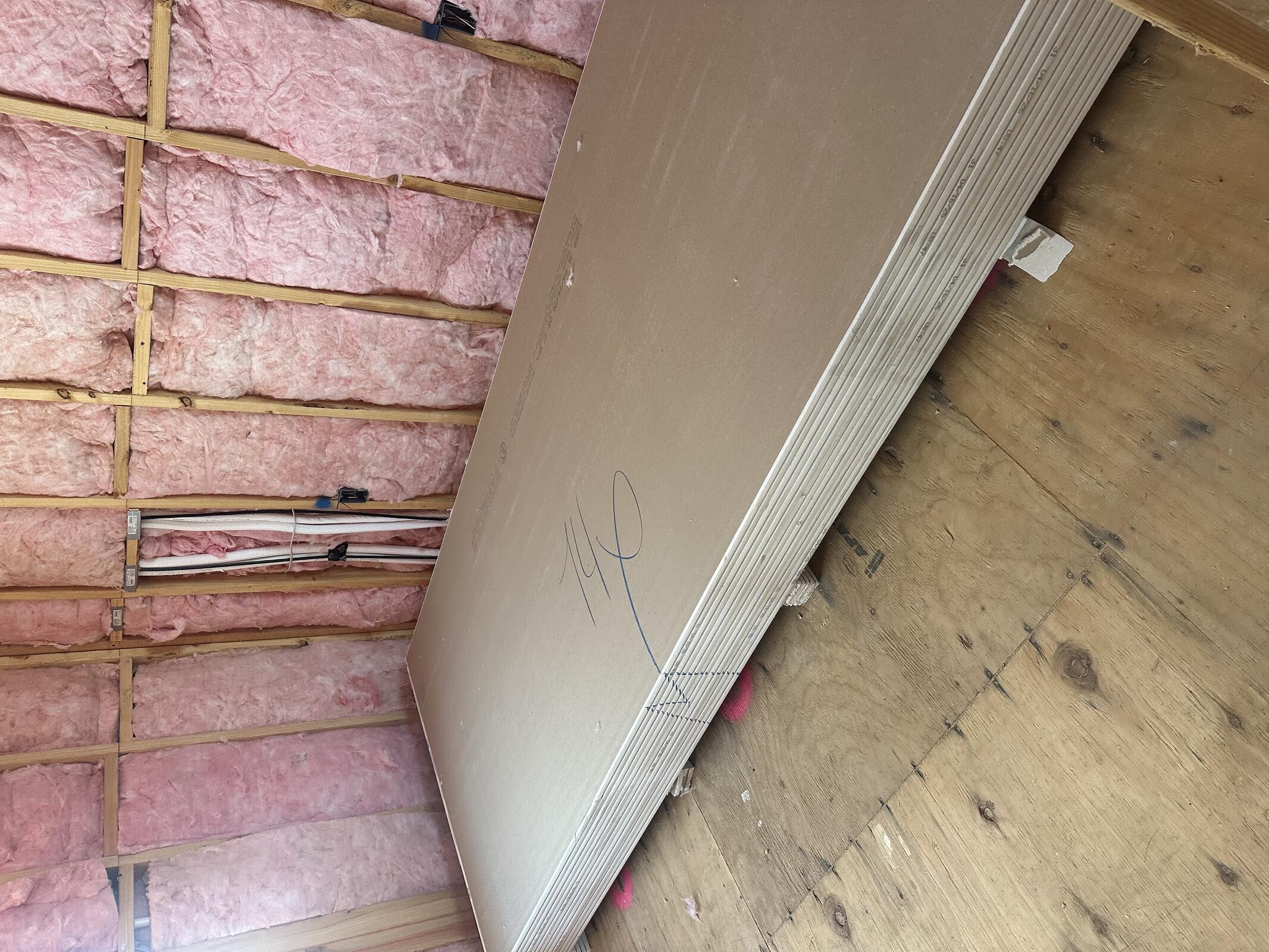

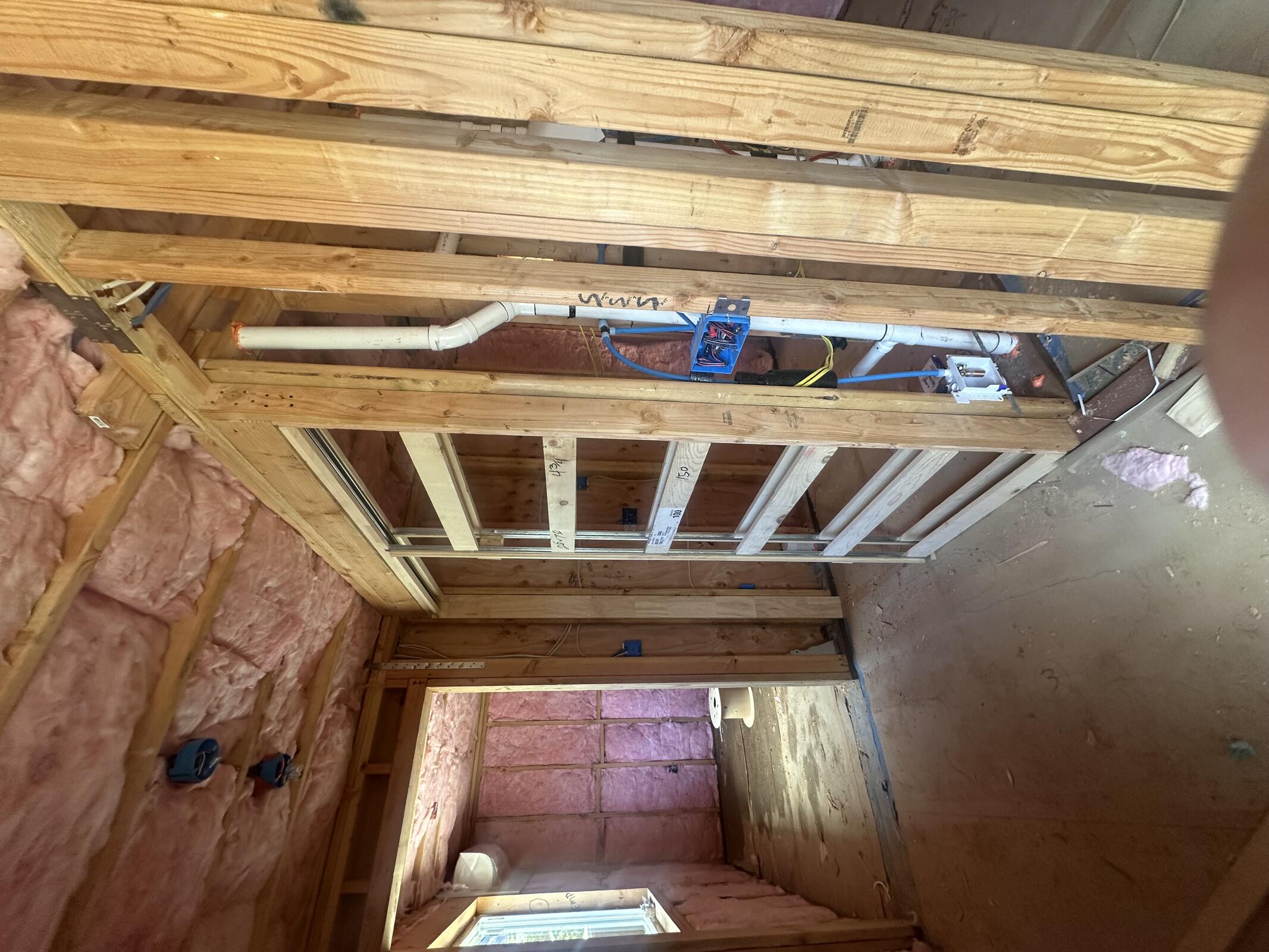

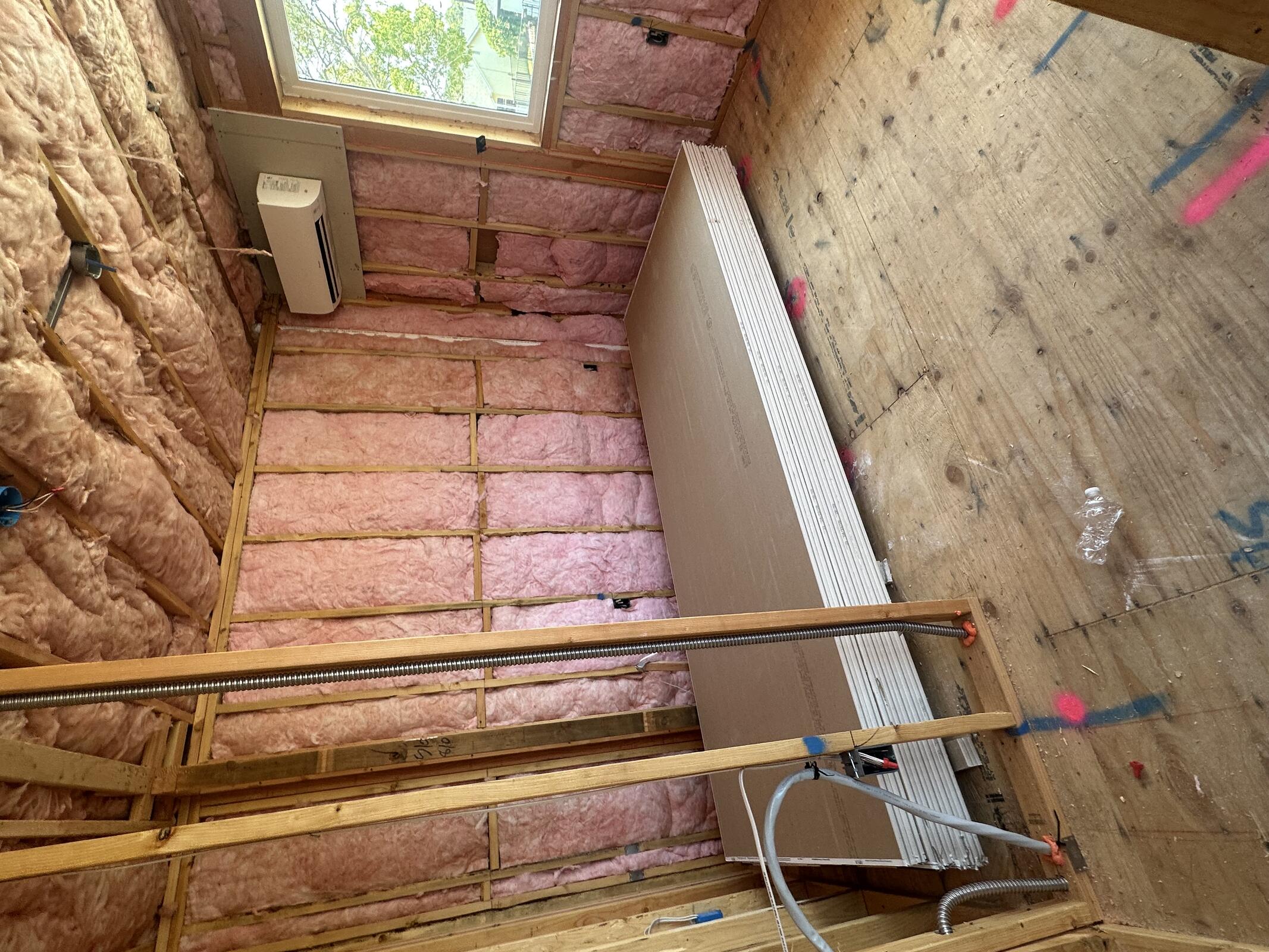

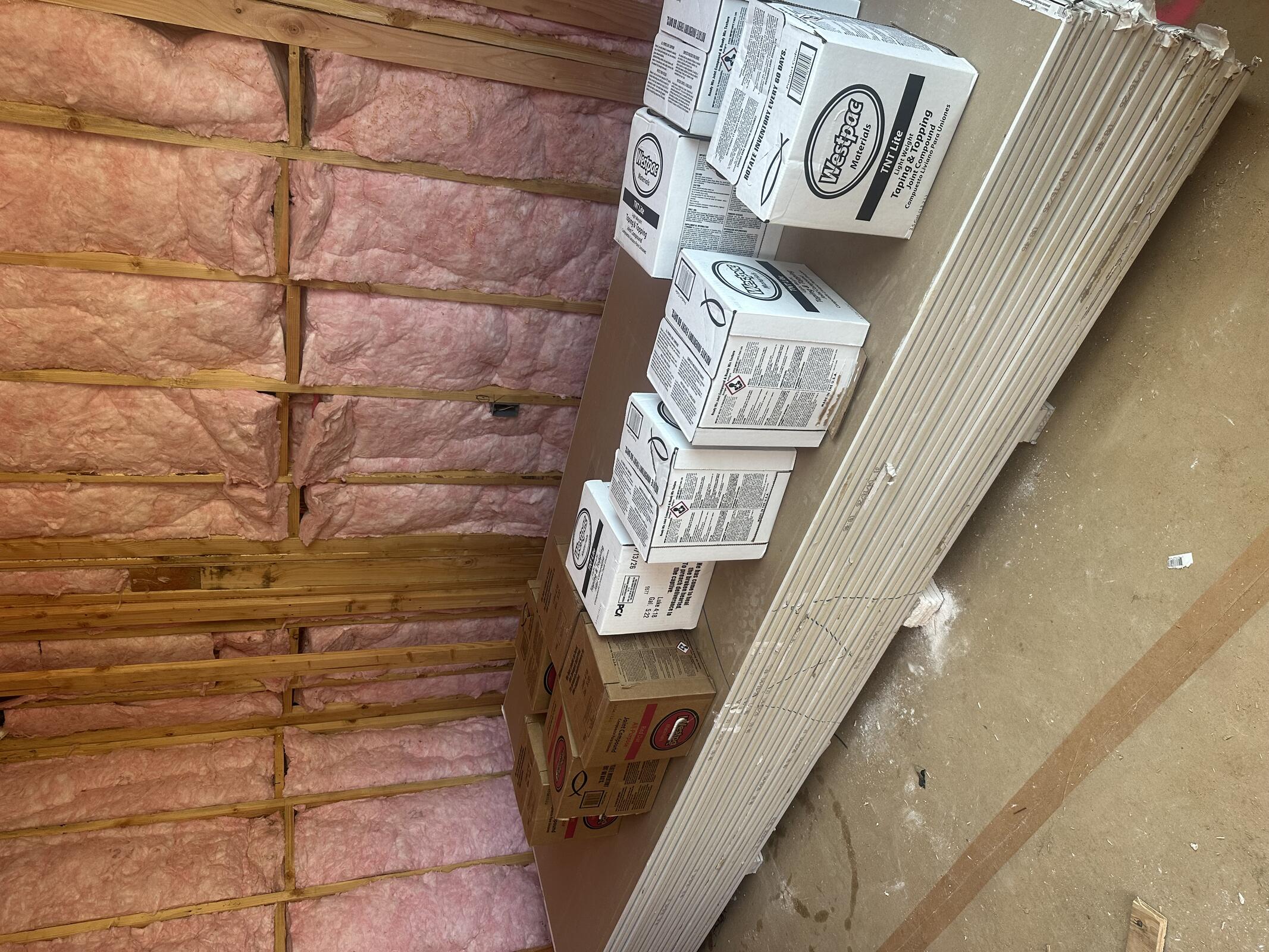

Traditions Drywall on site to prep for stocking and installation on Friday. Minor comments on Electrical and Plumbing Rough-in.

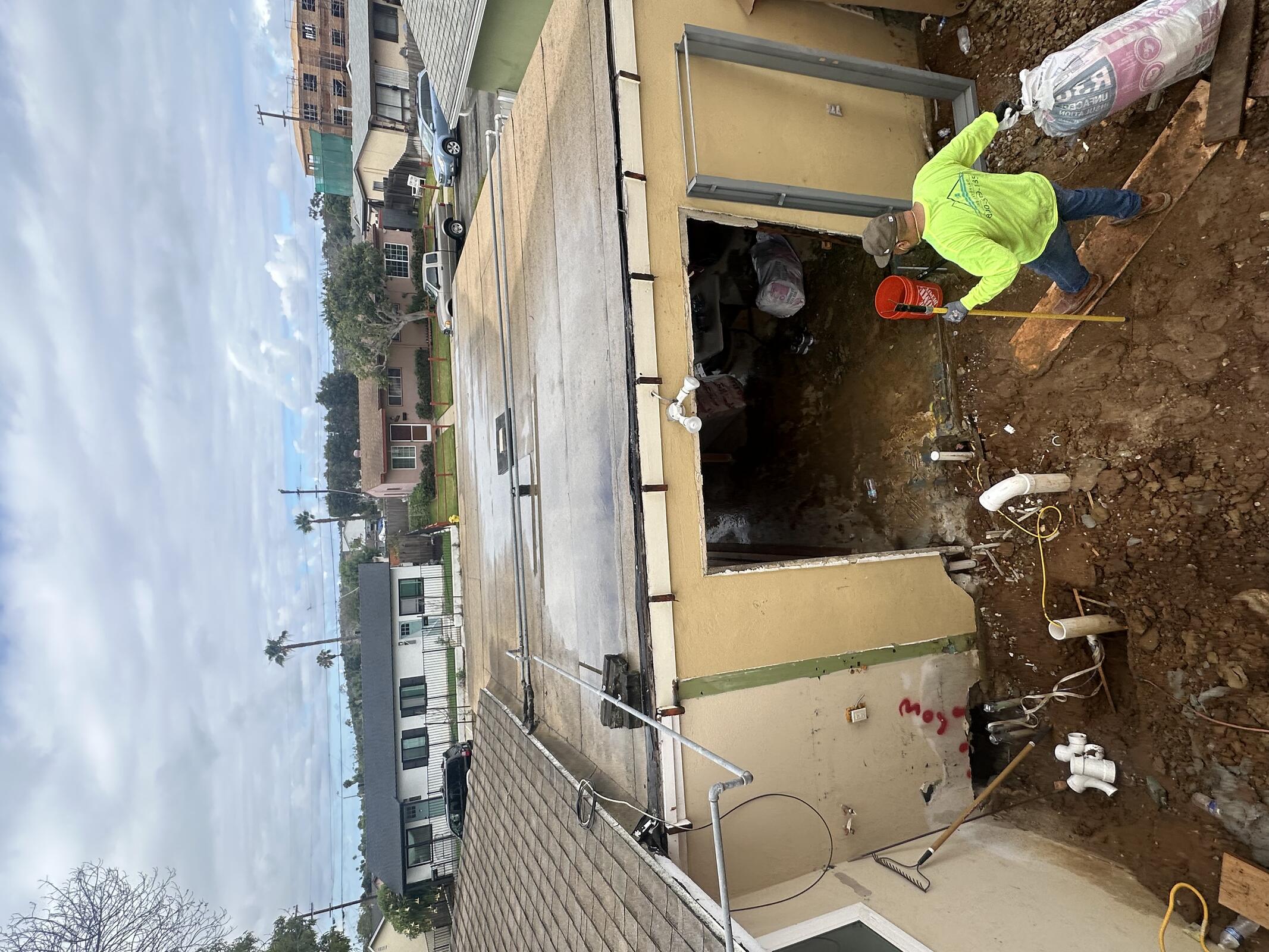

Scott from Primera on site to double check. Asked us to move water box to create more space between the sink and range in Building B units.

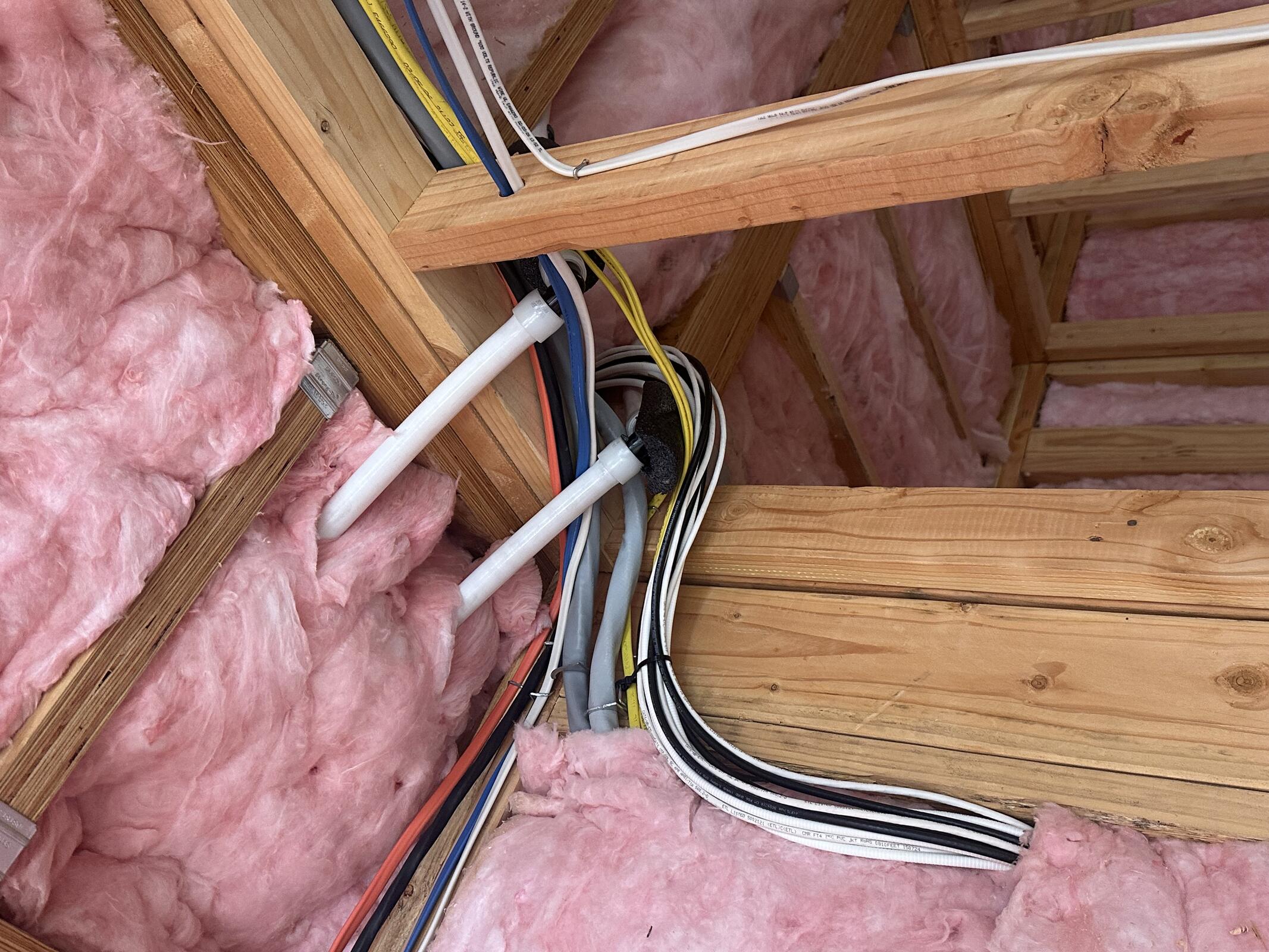

AC Electric on site, picking up minor changes and meeting with inspector for meter inspection. AC Electric met with ATT at 8 AM to discuss weatherhead location. ML to schedule meeting with ATT, SDGE and AC Electric.
ZSP on site, capping gas and removing lines from garage roof.

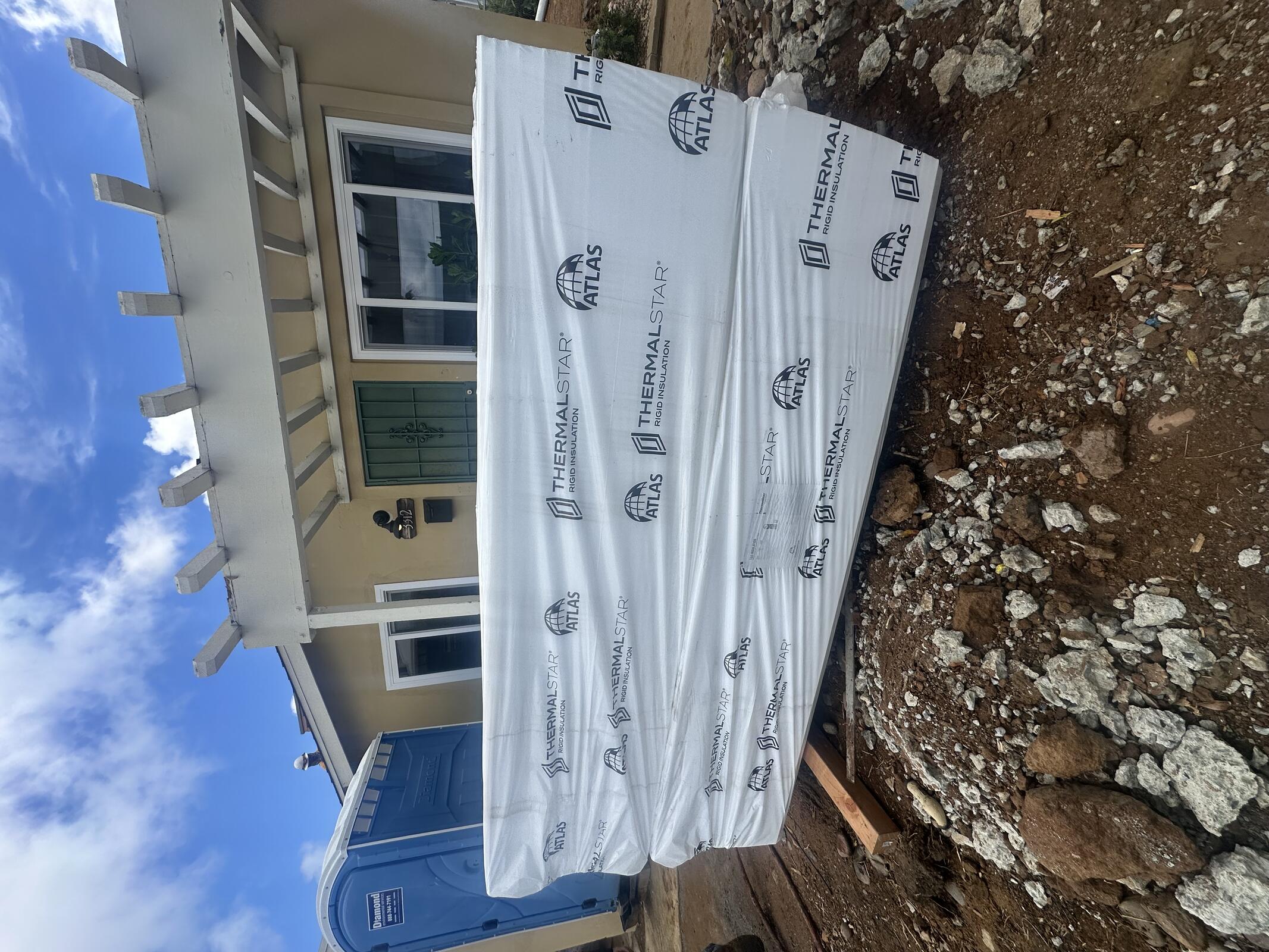

Rigid Insulation for Marq plastering delivered to site.
Taylor Trim installing remaining pocket door frames and strorage room door frame.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| Insulation Labs | 2 | 8 | 16 |
| ZSP | 1 | 4 | 4 |
| AC Electric | 1 | 4 | 4 |
| Taylor Trim | 1 | 6 | 6 |
Inspection: Dave Finney and Lee Weske on site at 2PM for Meter Inspection. Inspectors asked us to label meters, move fence stands off sidewalk, and improve BMPs.
ML to add silt fence this week. Fence corrected. AC Electric to add labels after DF confirms addressing.























Wednesday, May 06, 2026
Clear, 68°F
Sergio, TDI, on site to straight edge walls and ceilings and confirm soffit layout, and electrical rough-in.

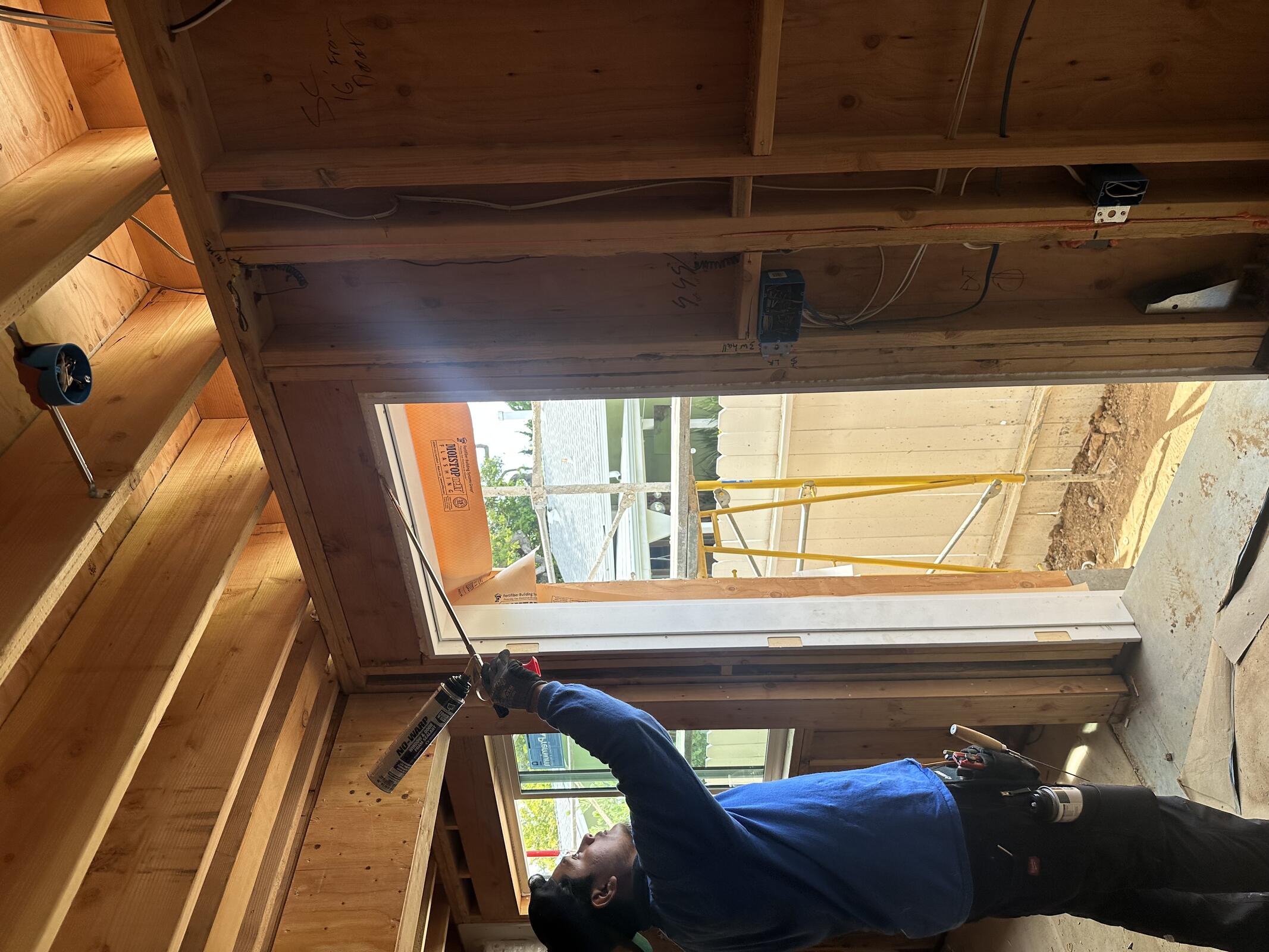

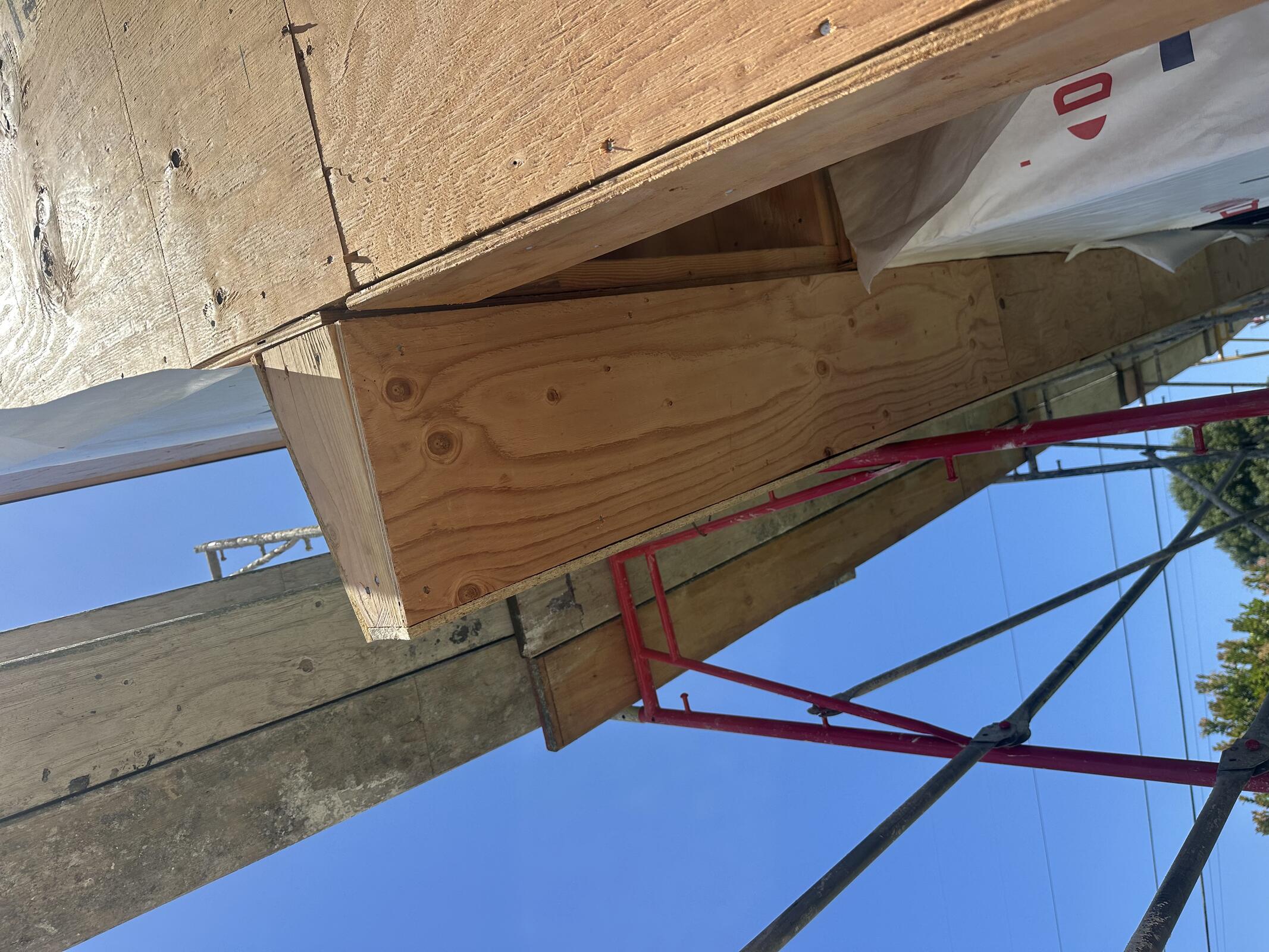

JB General on site, shimming to prepare for drywall. Adjusting one door header in Building C, Unit 1. Jeremy on site to do site concrete take-offs.

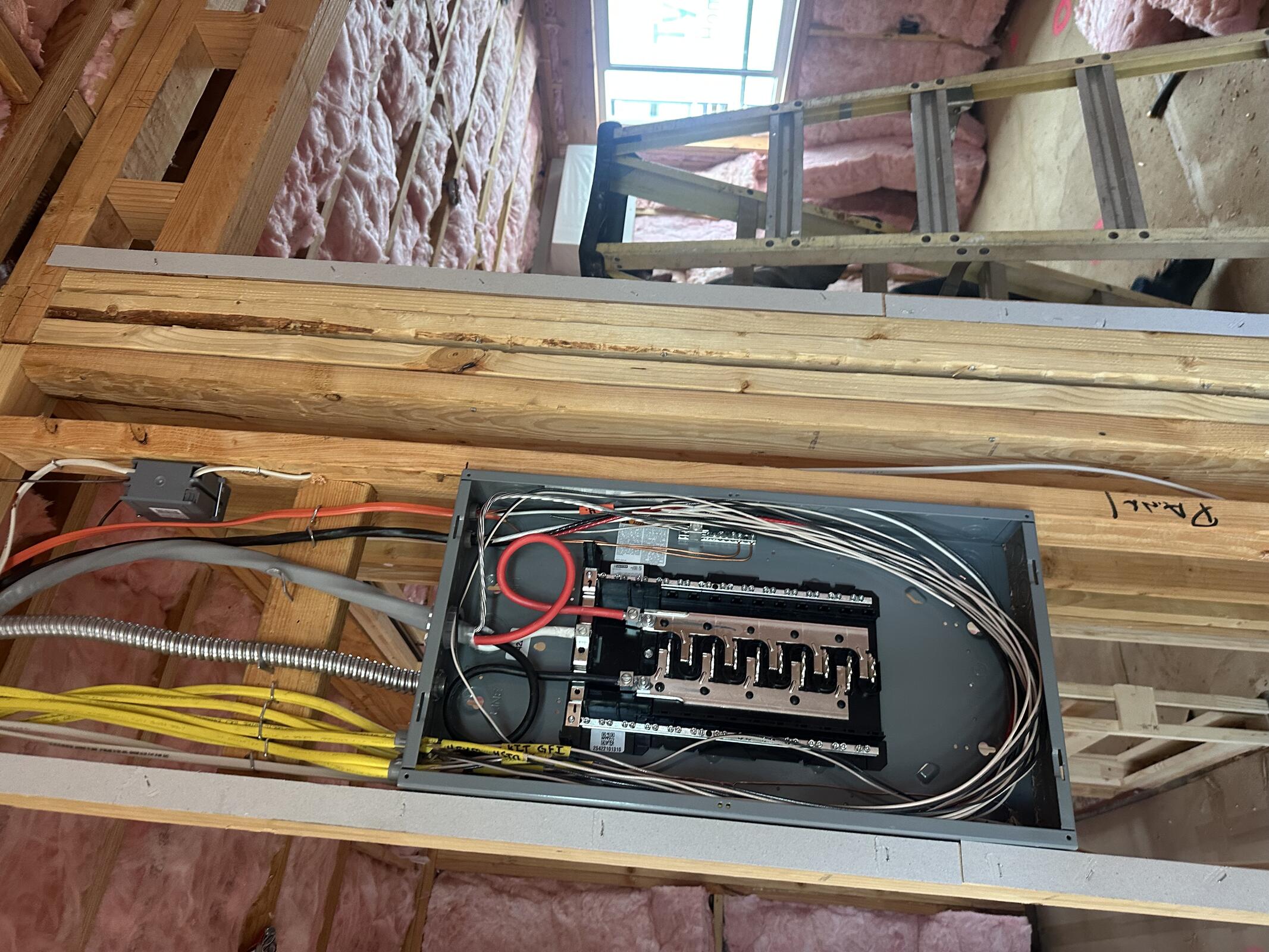

AC Electric tweaking fixture heights on first floor units.

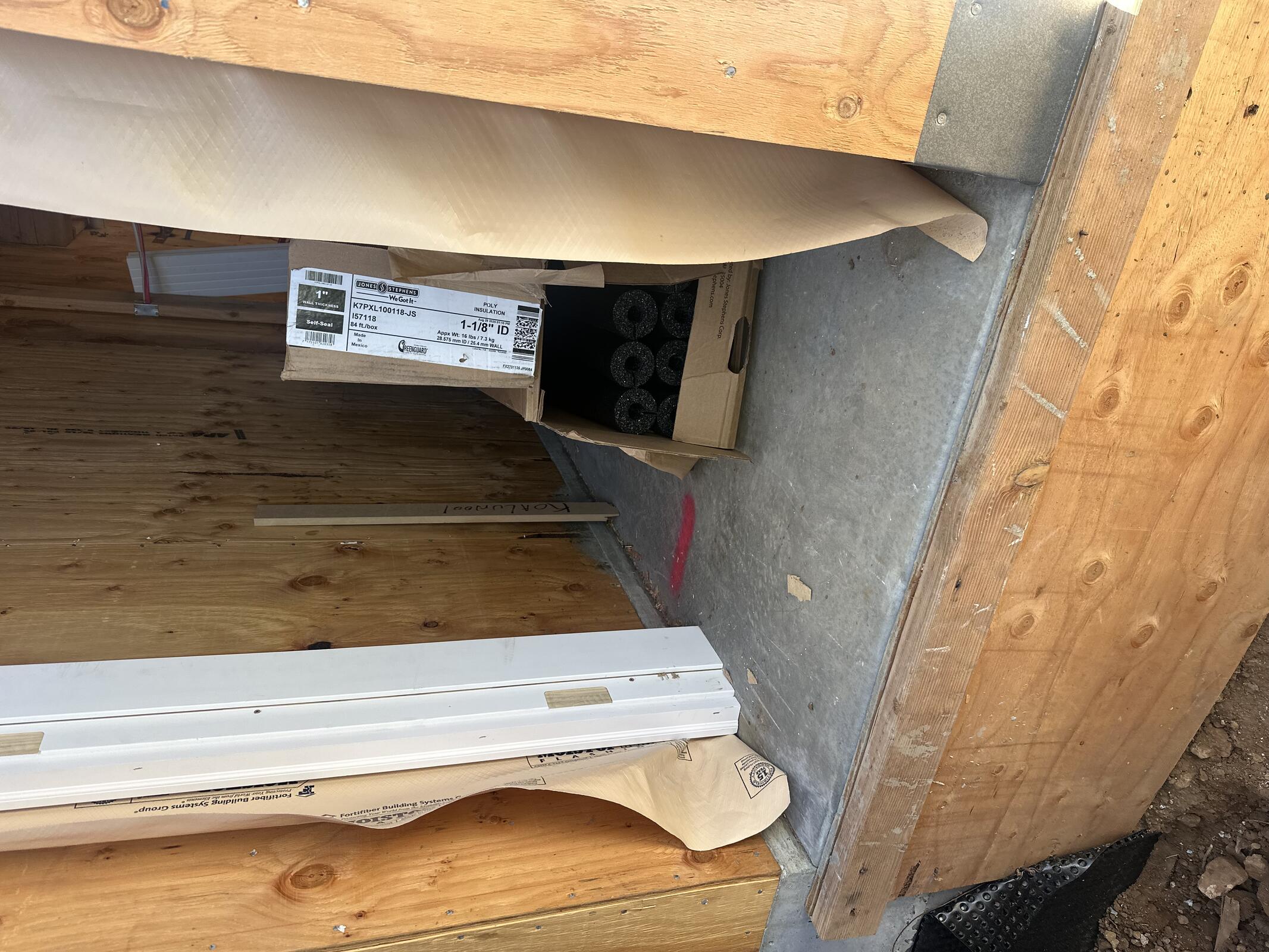

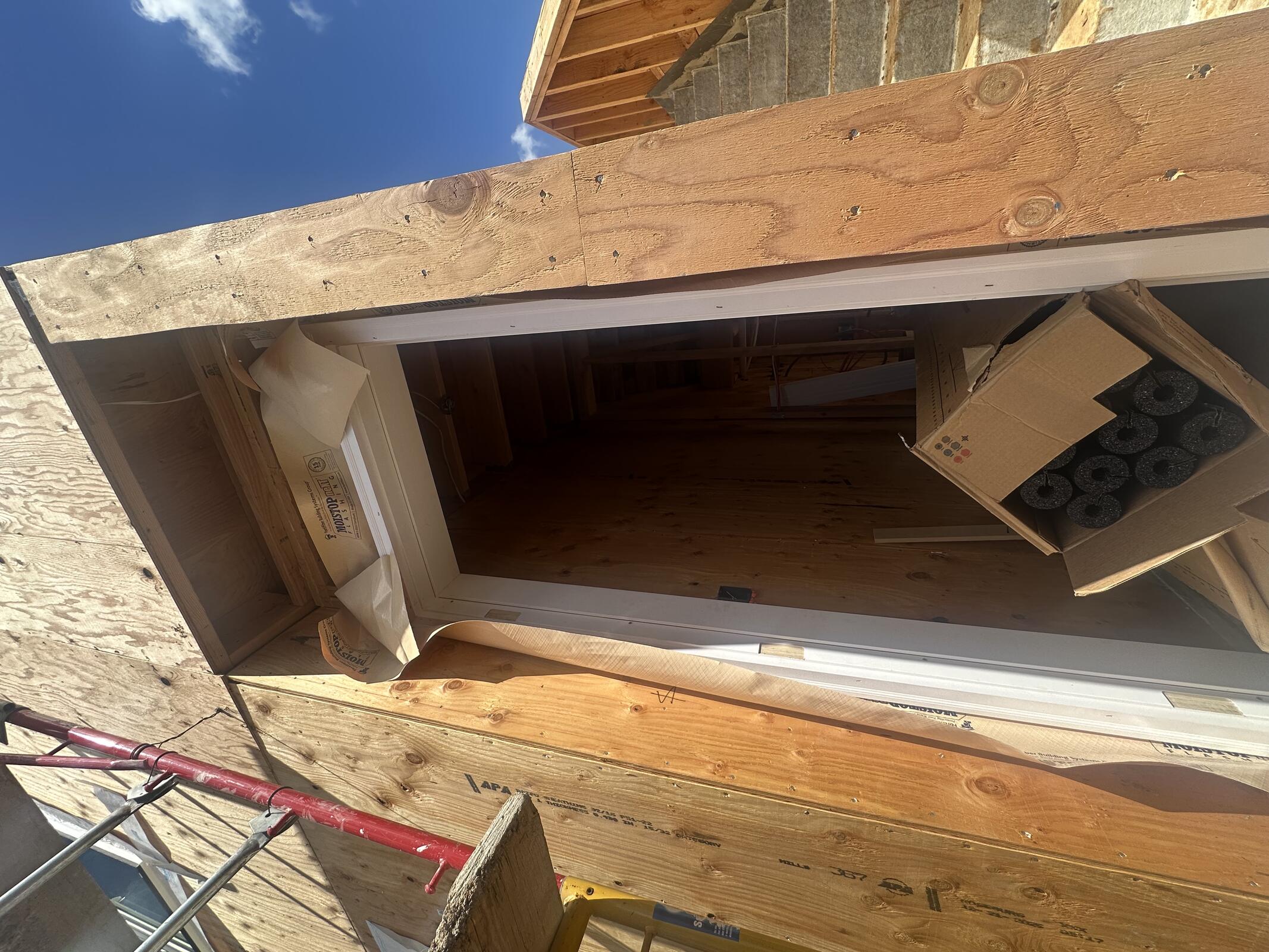

Fernando from Taylor Trim on site to measure interior door rough openings and prepare to order.
ML picking up trash around site.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| JB General | 2 | 6 | 12 |
| AC Electric | 1 | 4 | 4 |

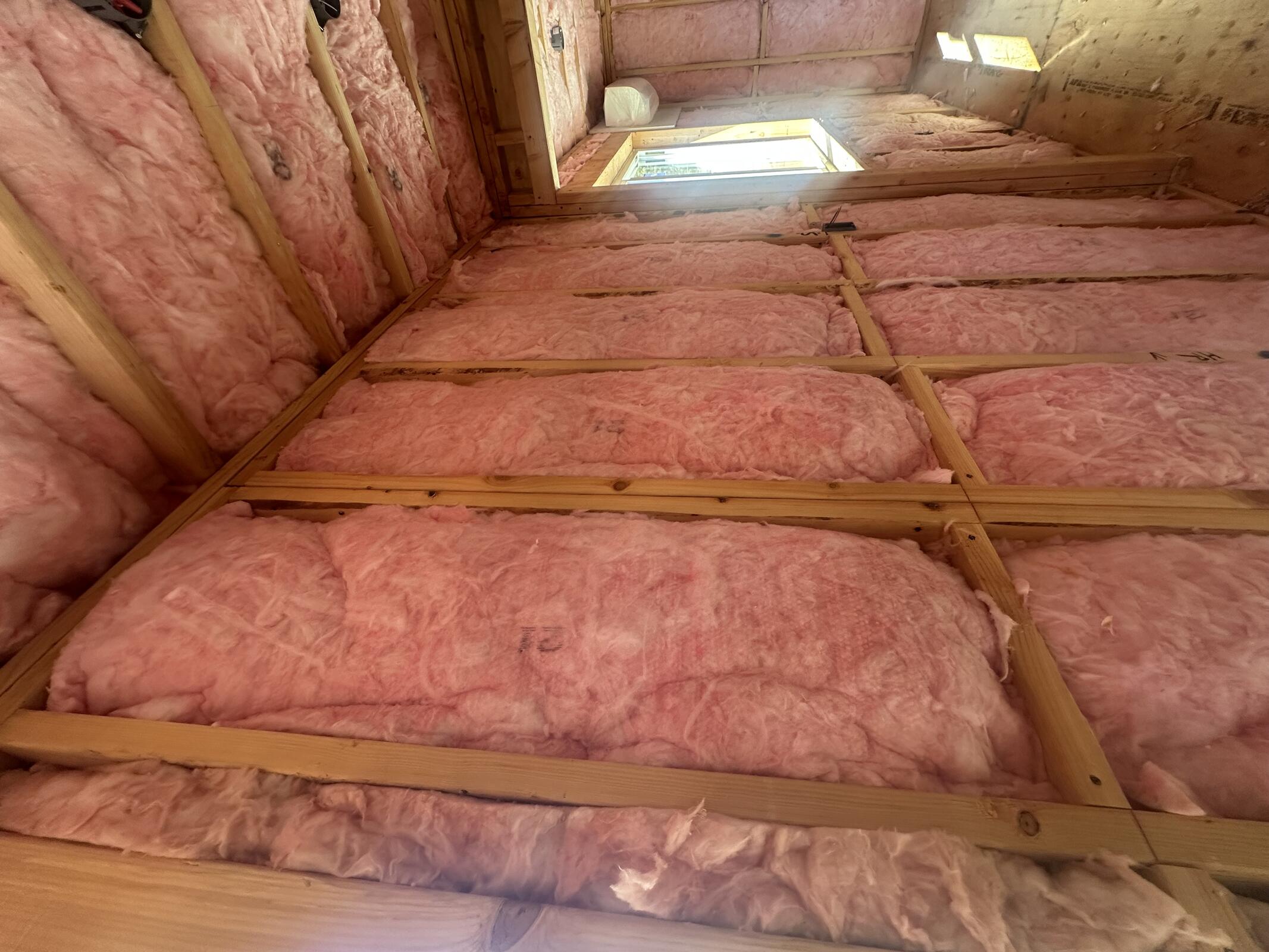

Inspection: Dave Finney on site at 11 AM for insulation inspection at Building B and C. Passed!




Thursday, May 07, 2026
Partially cloudy, 68°F

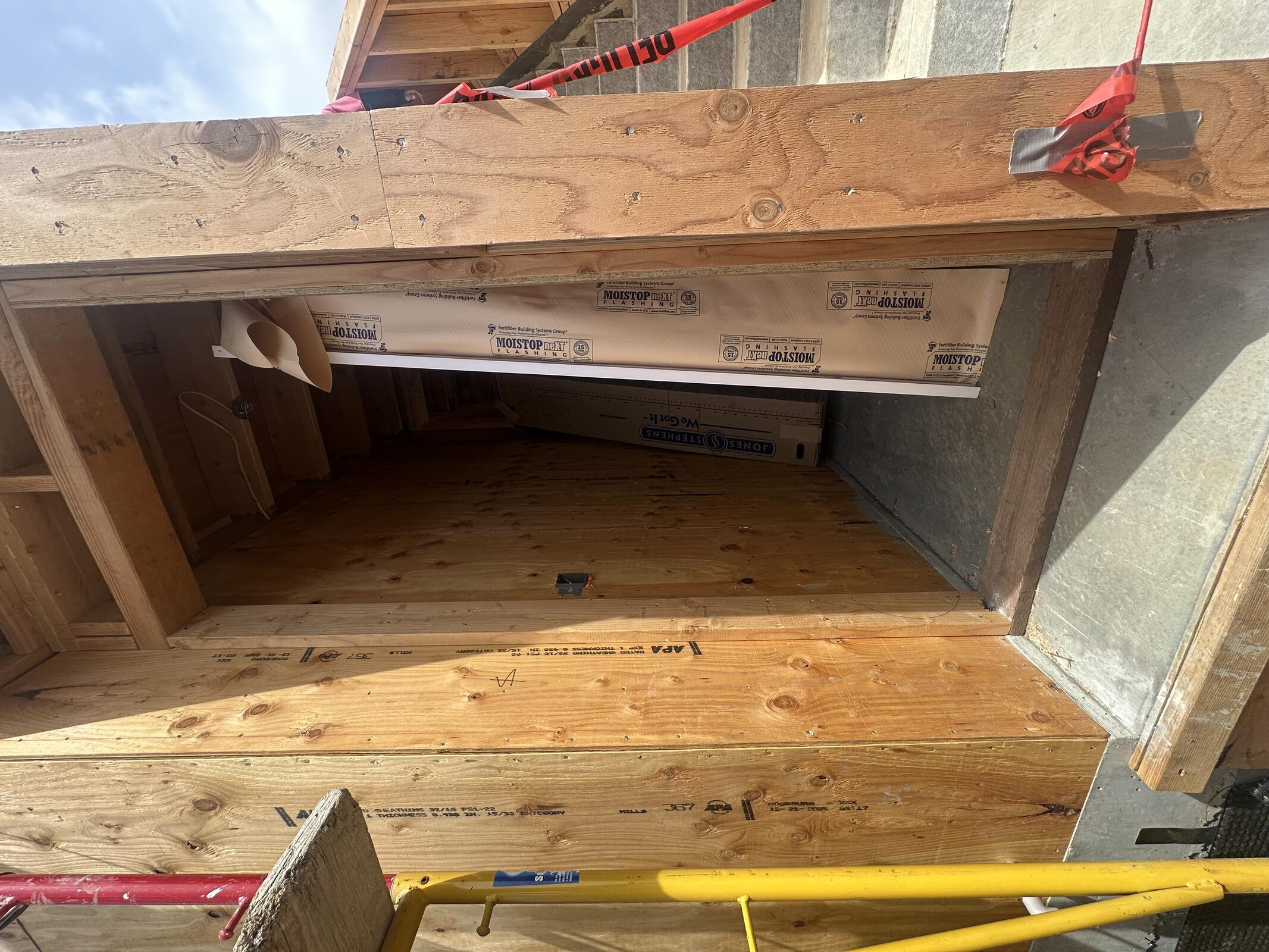

JB General making small adjustments for stucco crew. Niches added in C2 and B1. Overhang hung on building C.

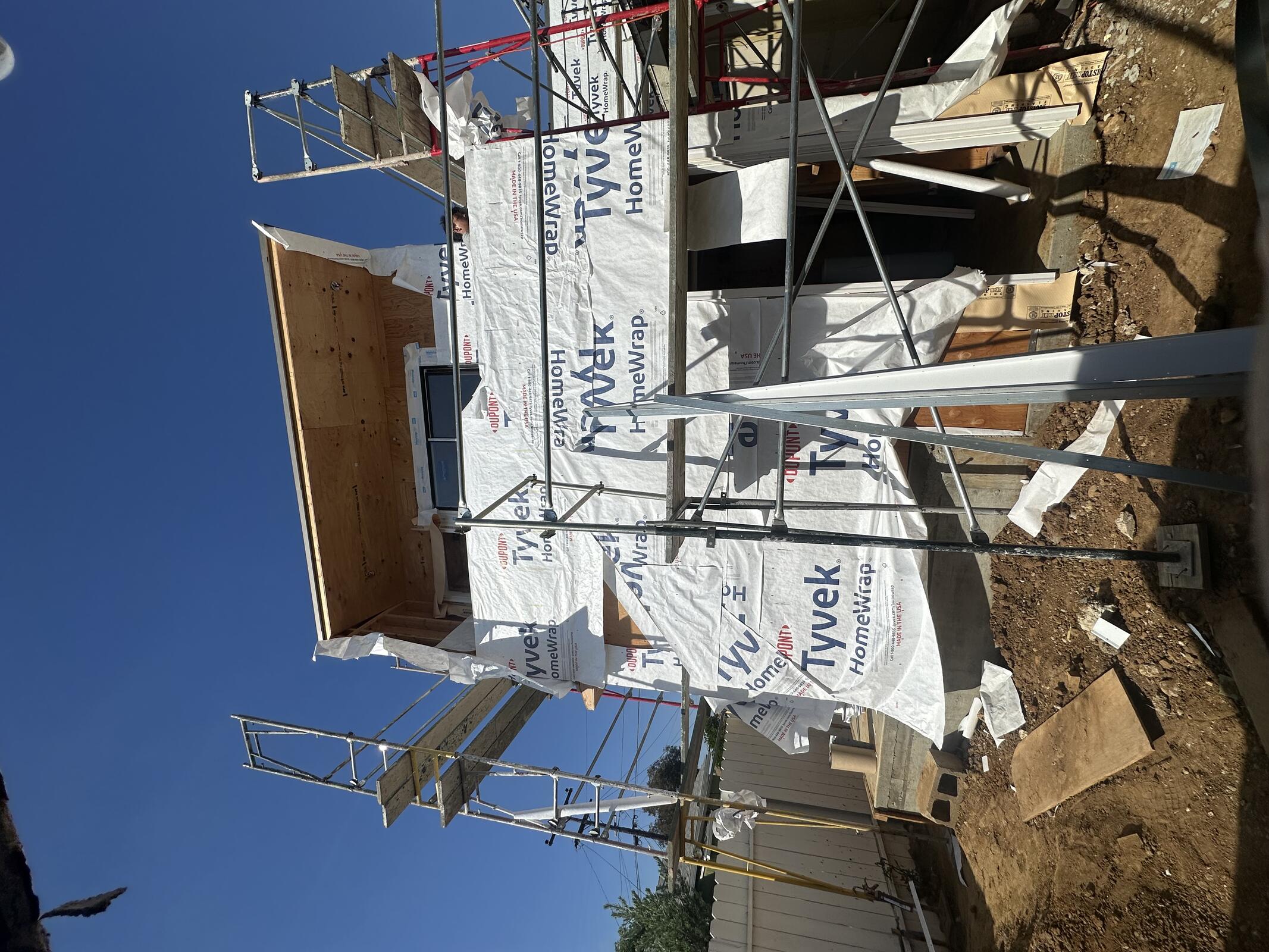

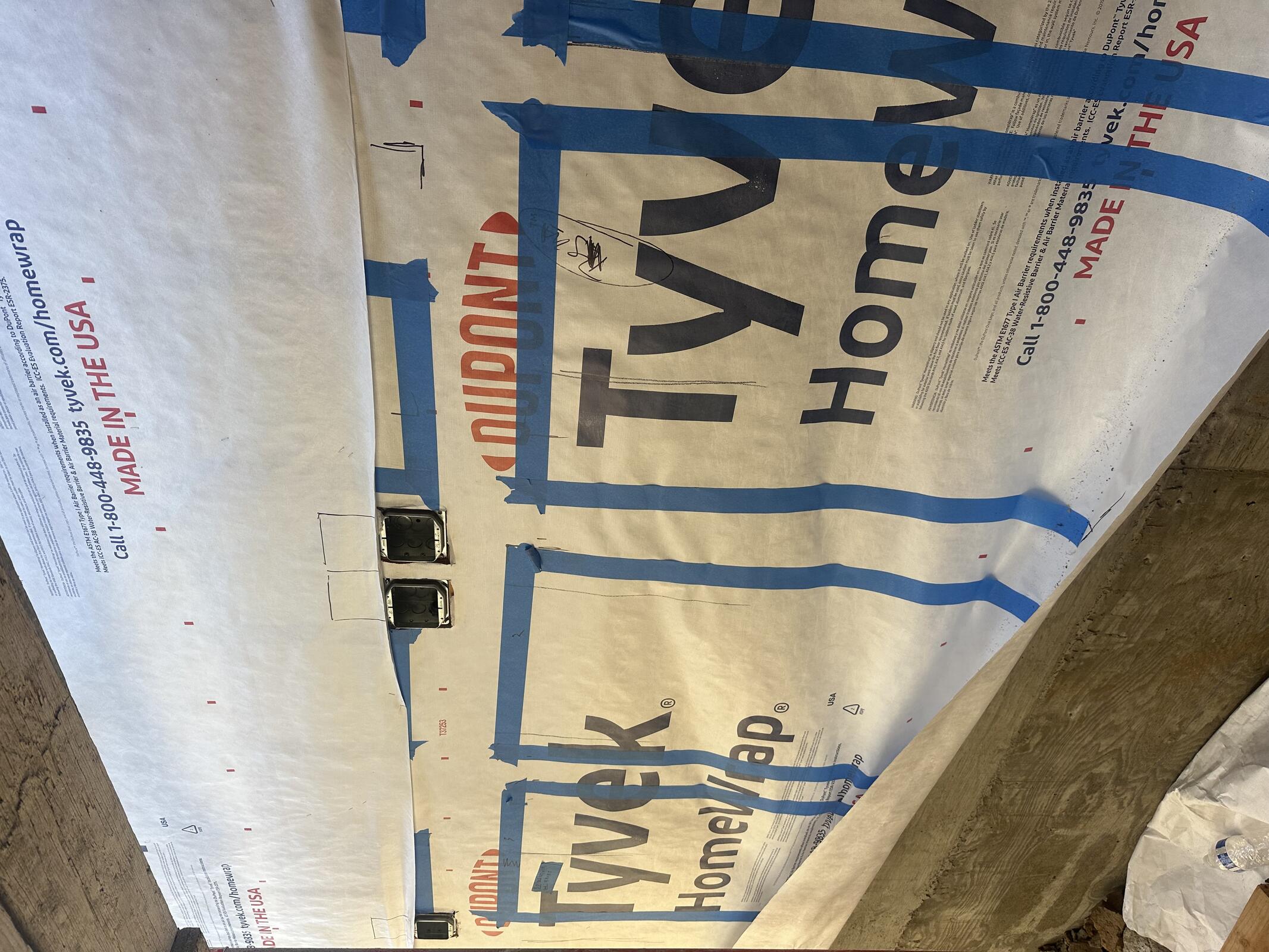

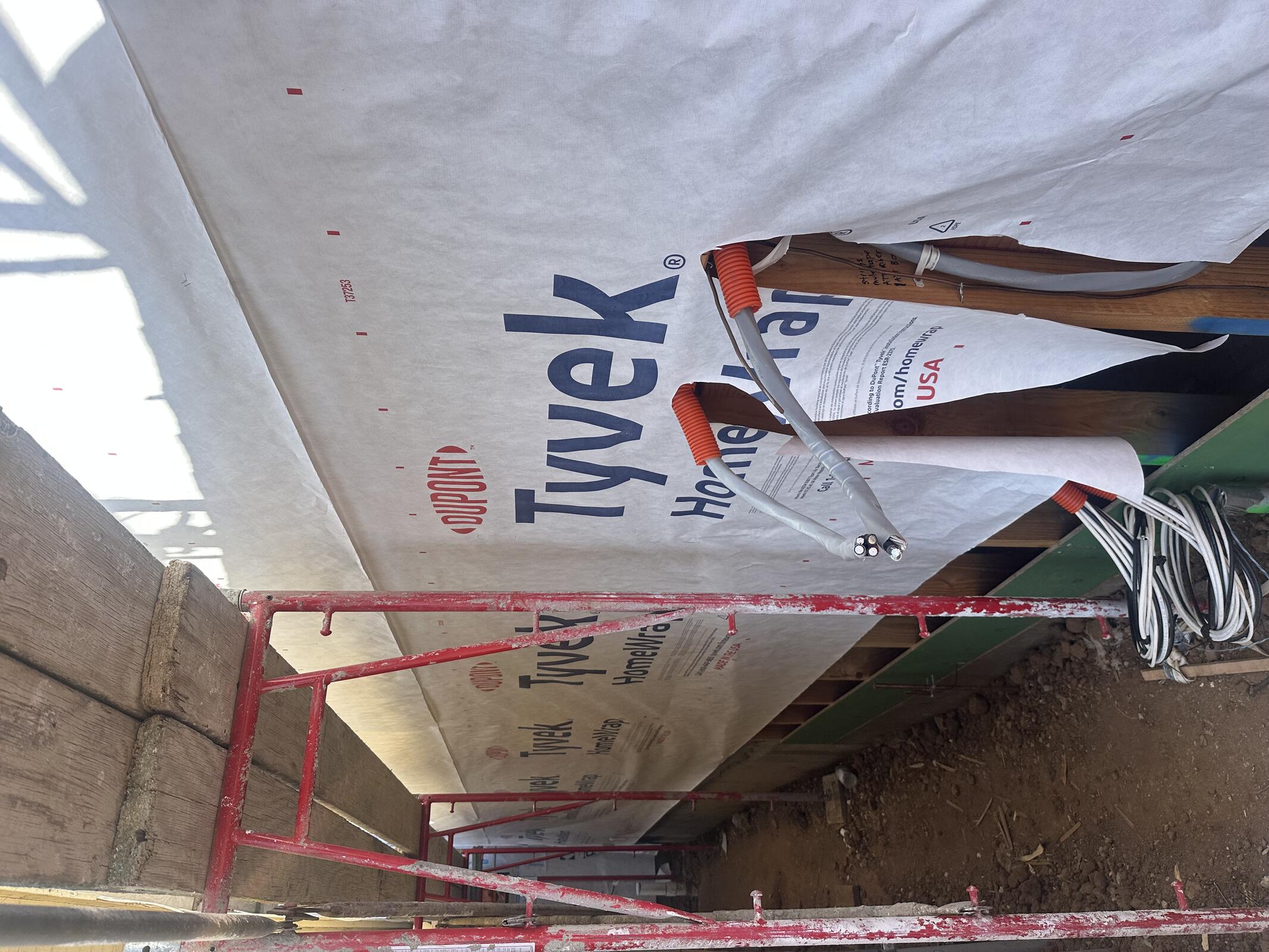

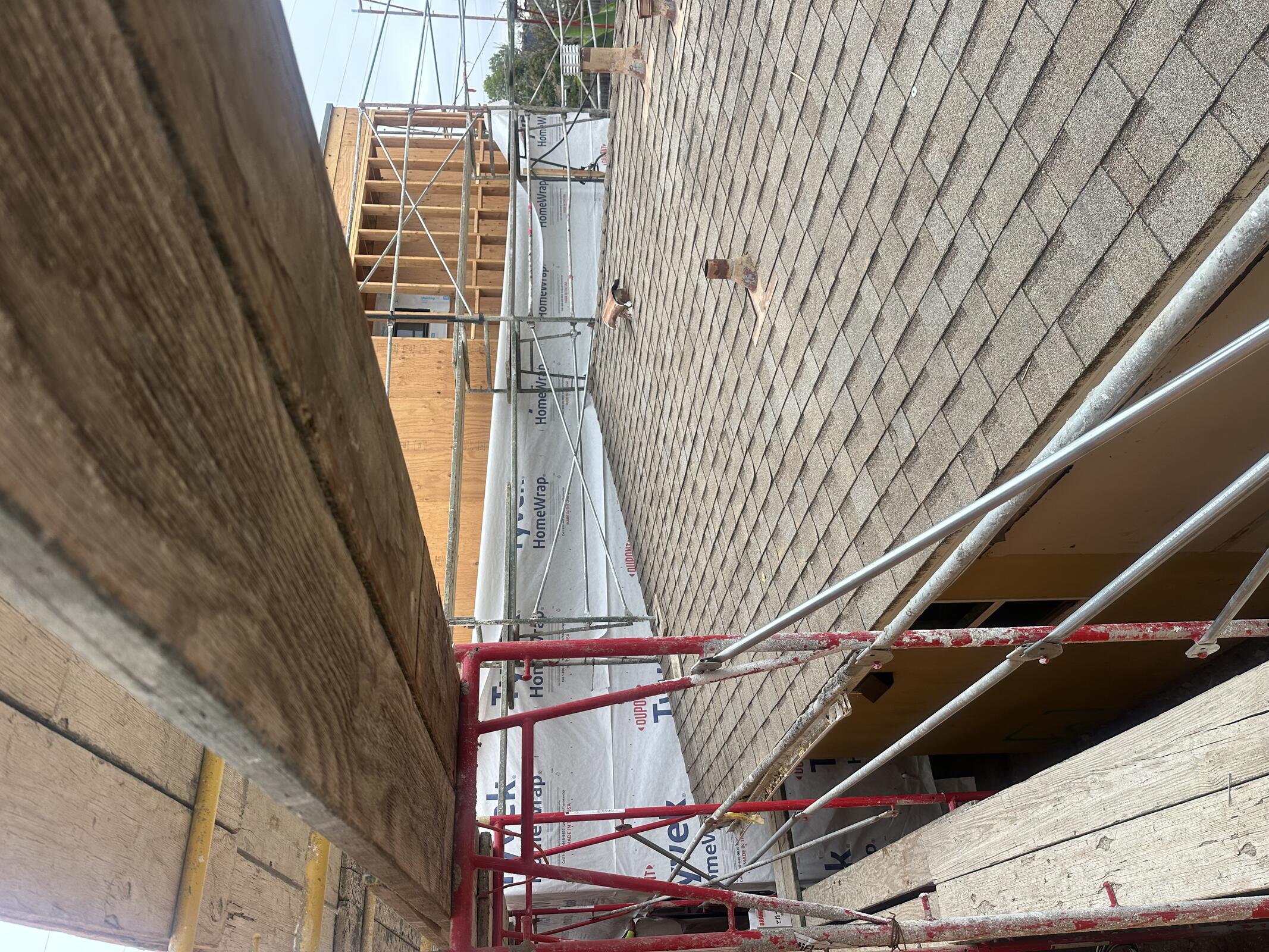

Marq on site wrapping Building B and C in Tyvek. ML and Ivan walked sure and reviewed weep screed heights.

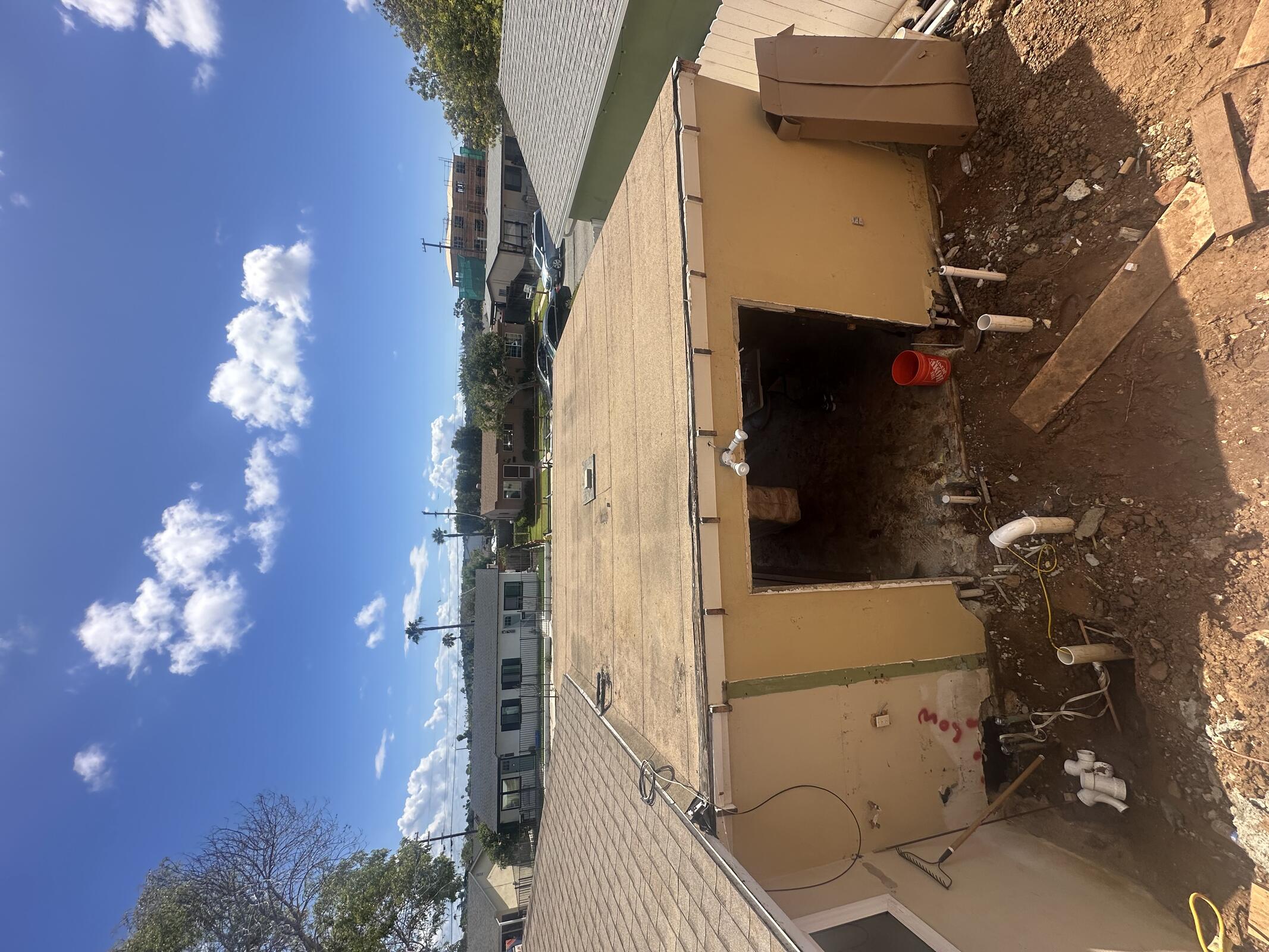

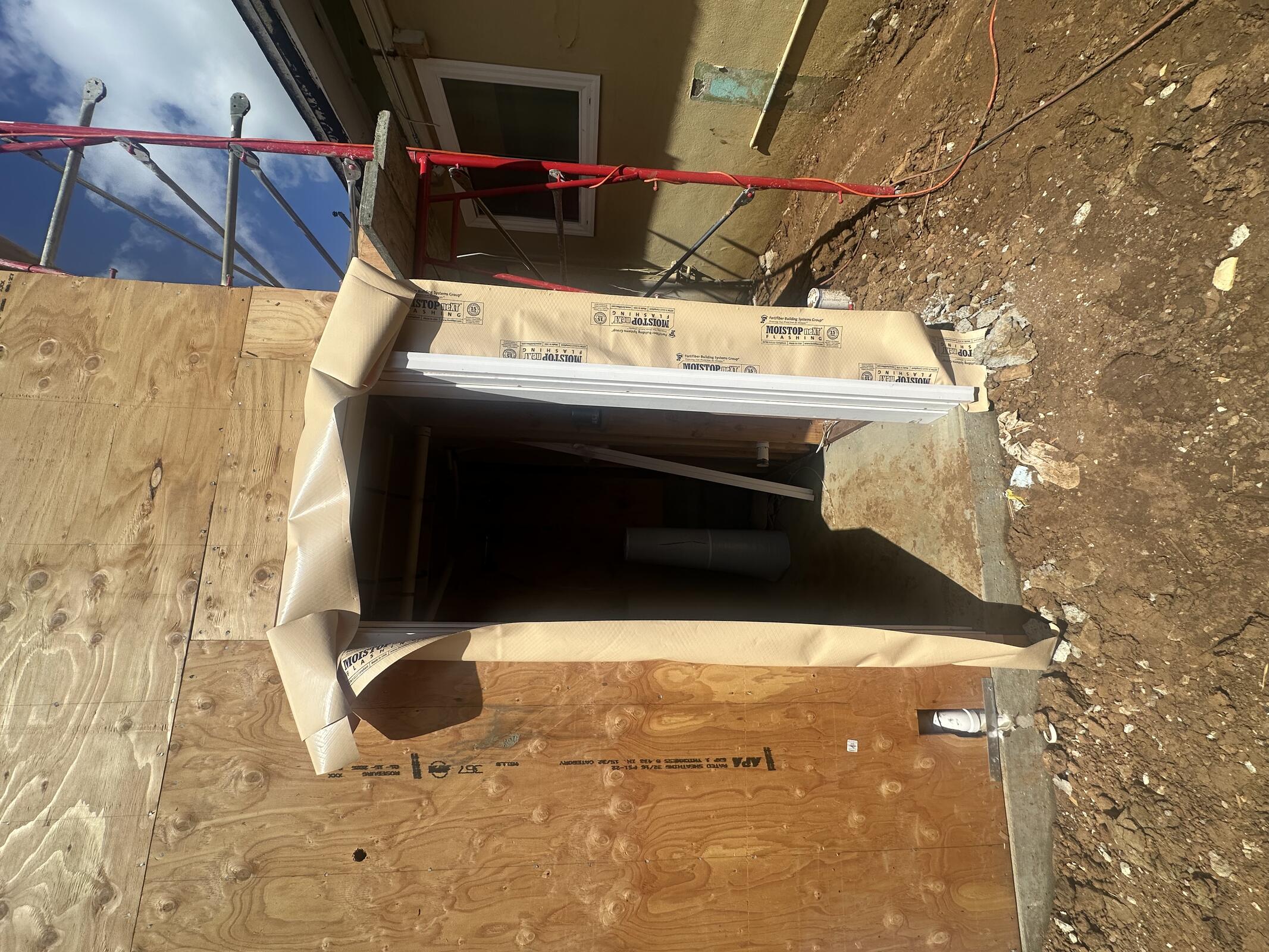

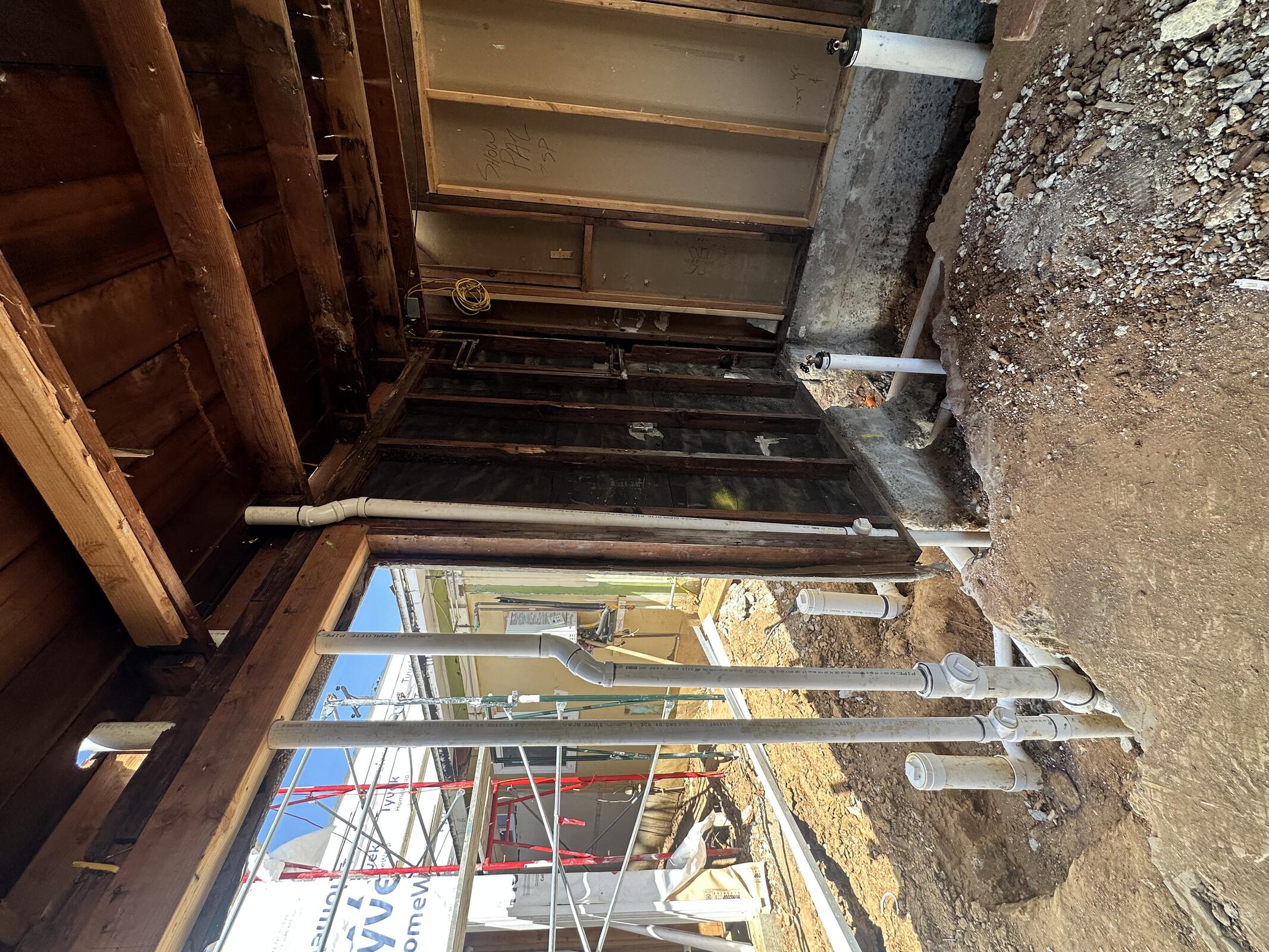

ZSP working on garage conversion underground.
Clear HVAC pressure testing equipment.
Response to RFI 007 received. See attached.
Senior Inspector, Lee, called and let us know that we would be sent a correction notice to submit electrical plans for review. This is a new requirement that the city is unrolling for projects with 3+ meters. 1070 looped in. See attached.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| Clear HVAC | 1 | 8 | 8 |
| JB General | 1 | 8 | 8 |
| ZSP | 1 | 8 | 8 |
| Marq | 2 | 8 | 16 |
Inspection: N/A
















Friday, May 08, 2026
Overcast, 65°F

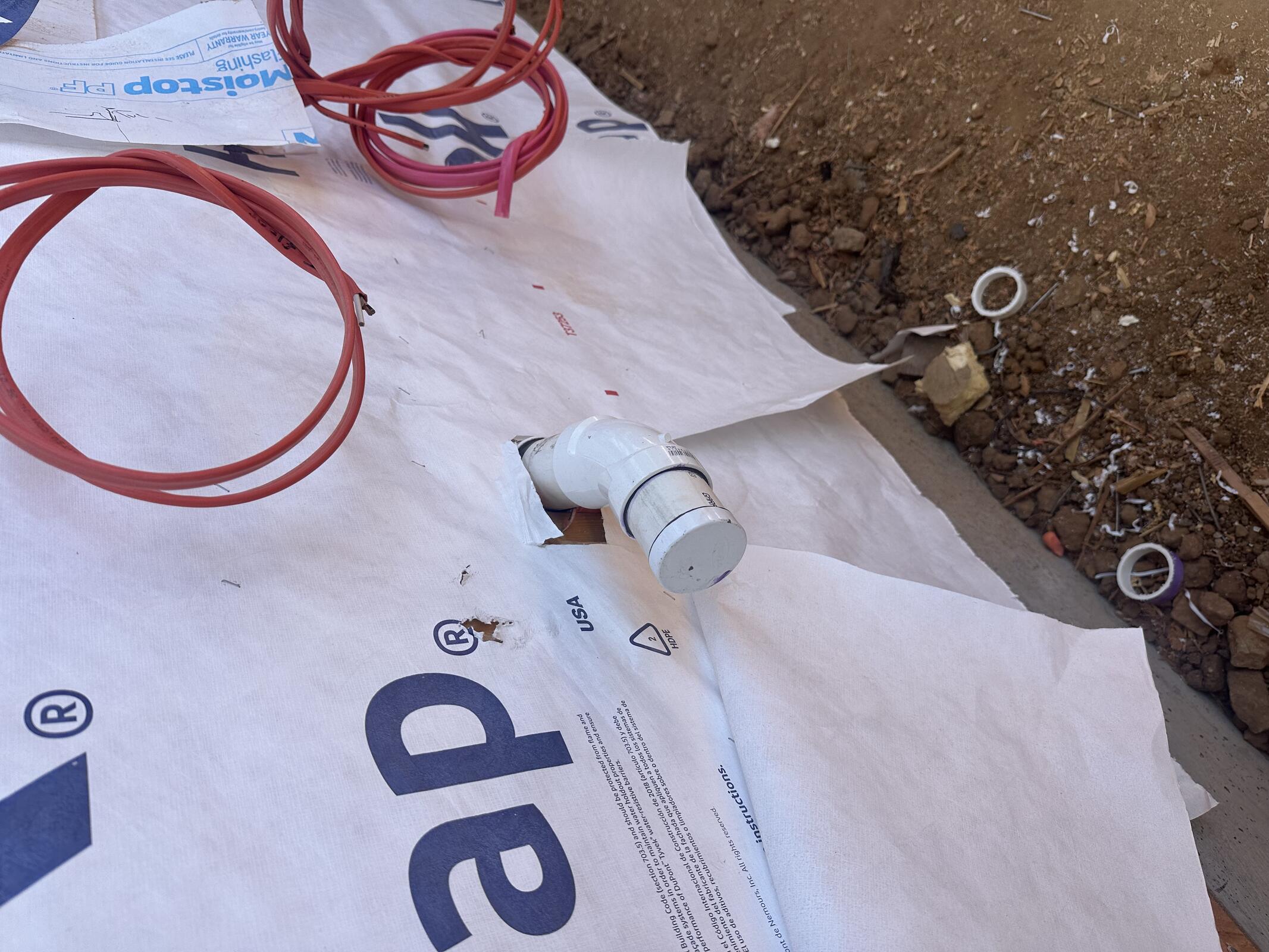

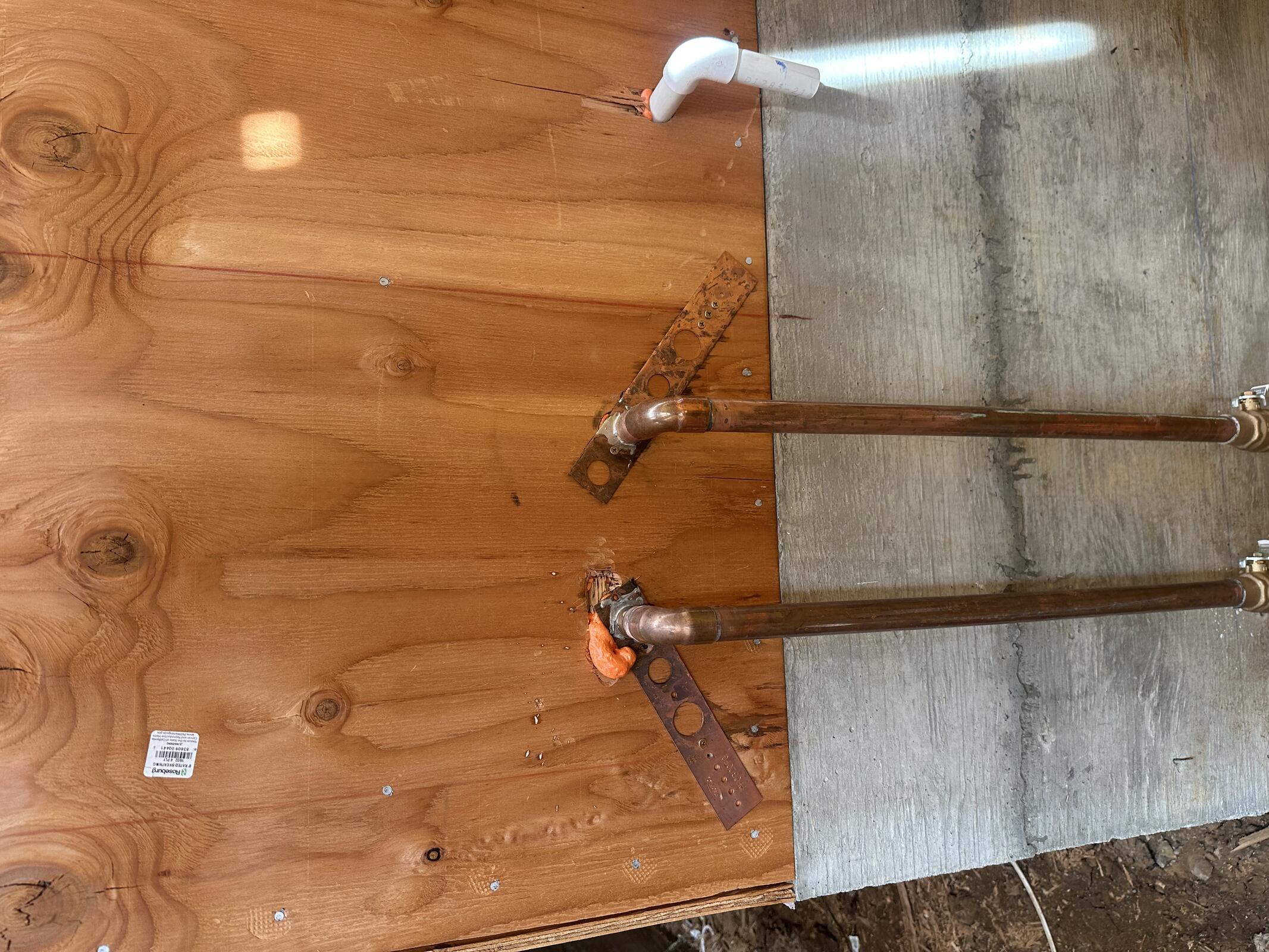

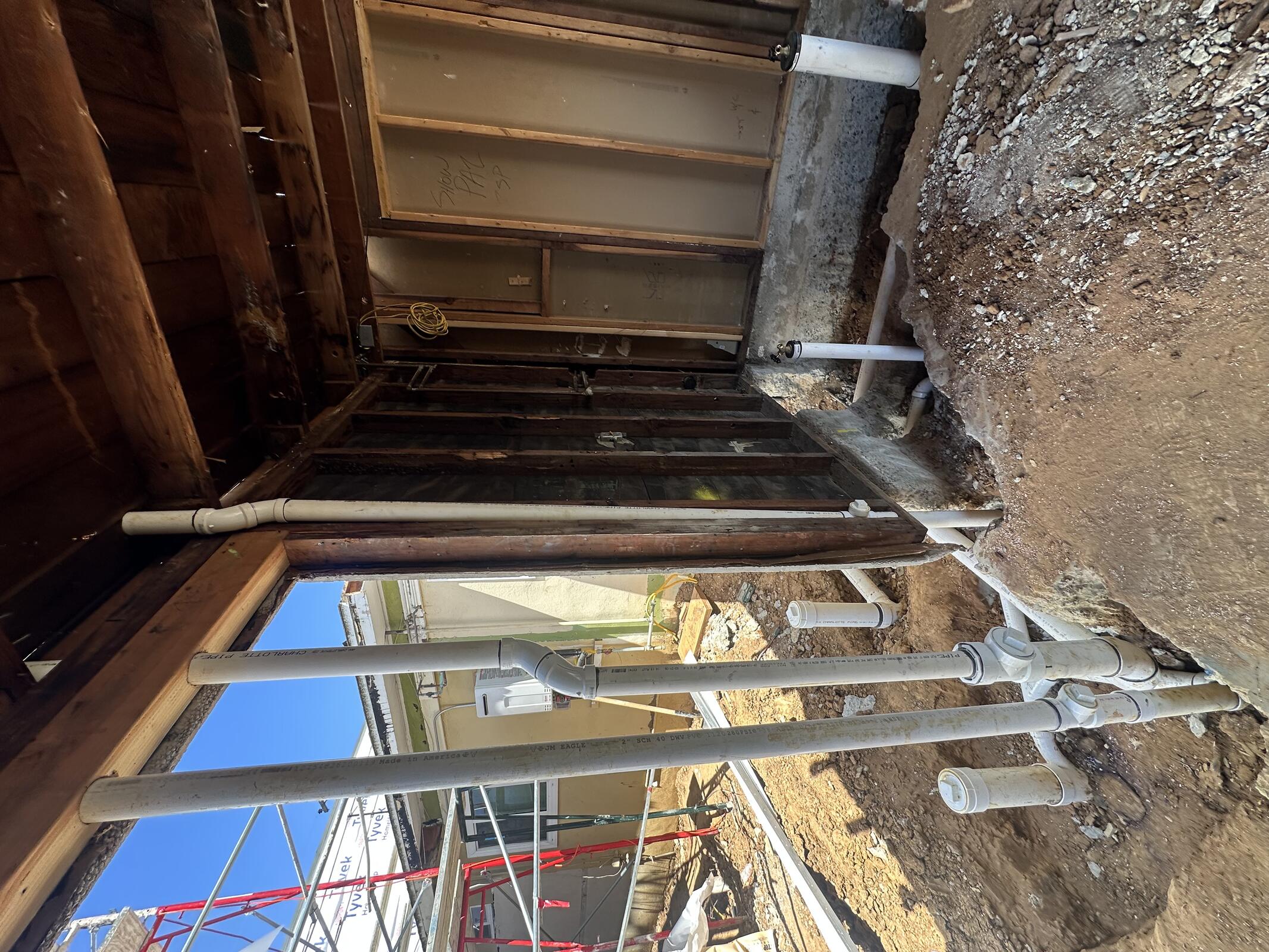

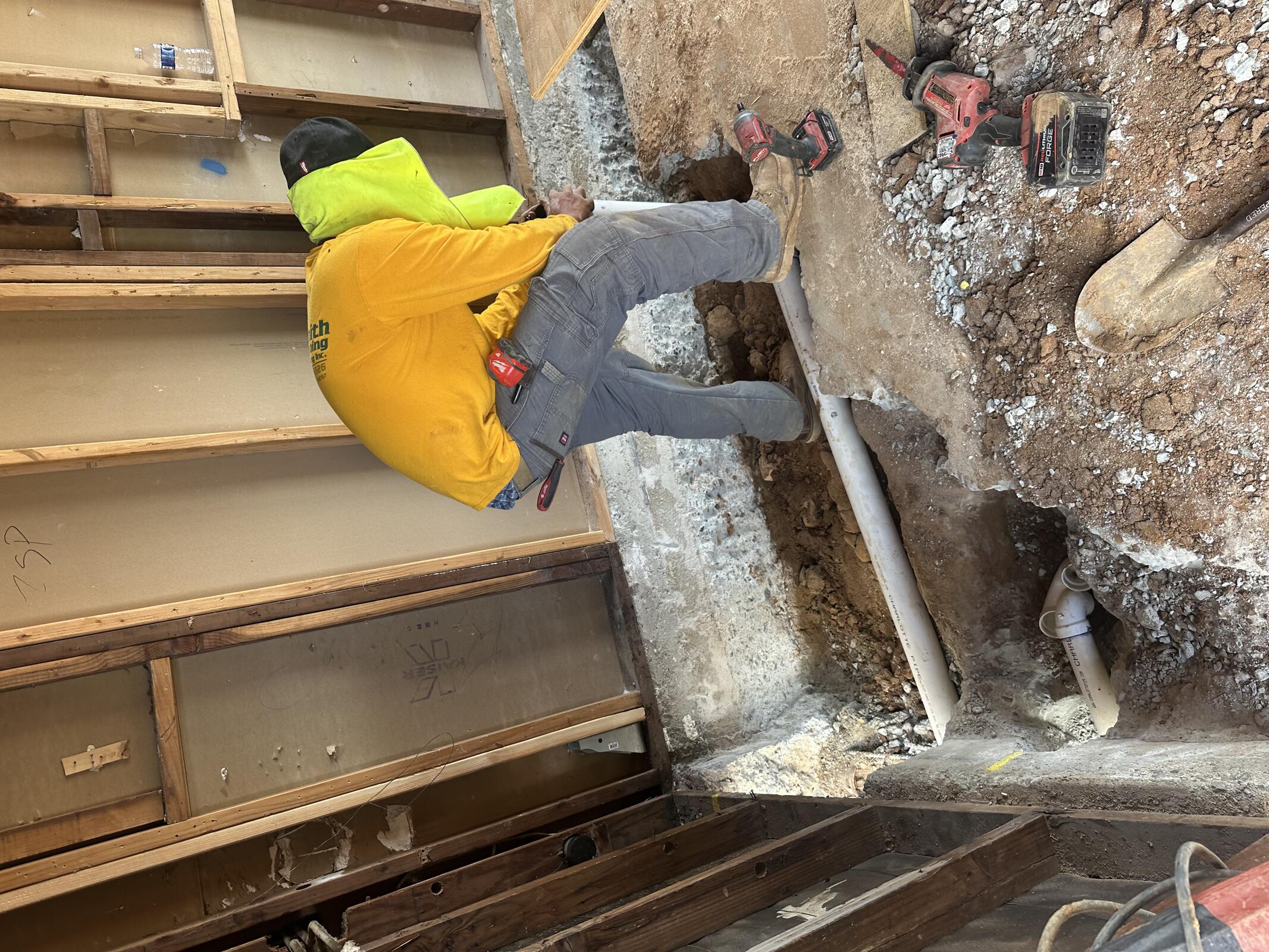

Zack Smith finishing Garage Conversion underground Plumbing.

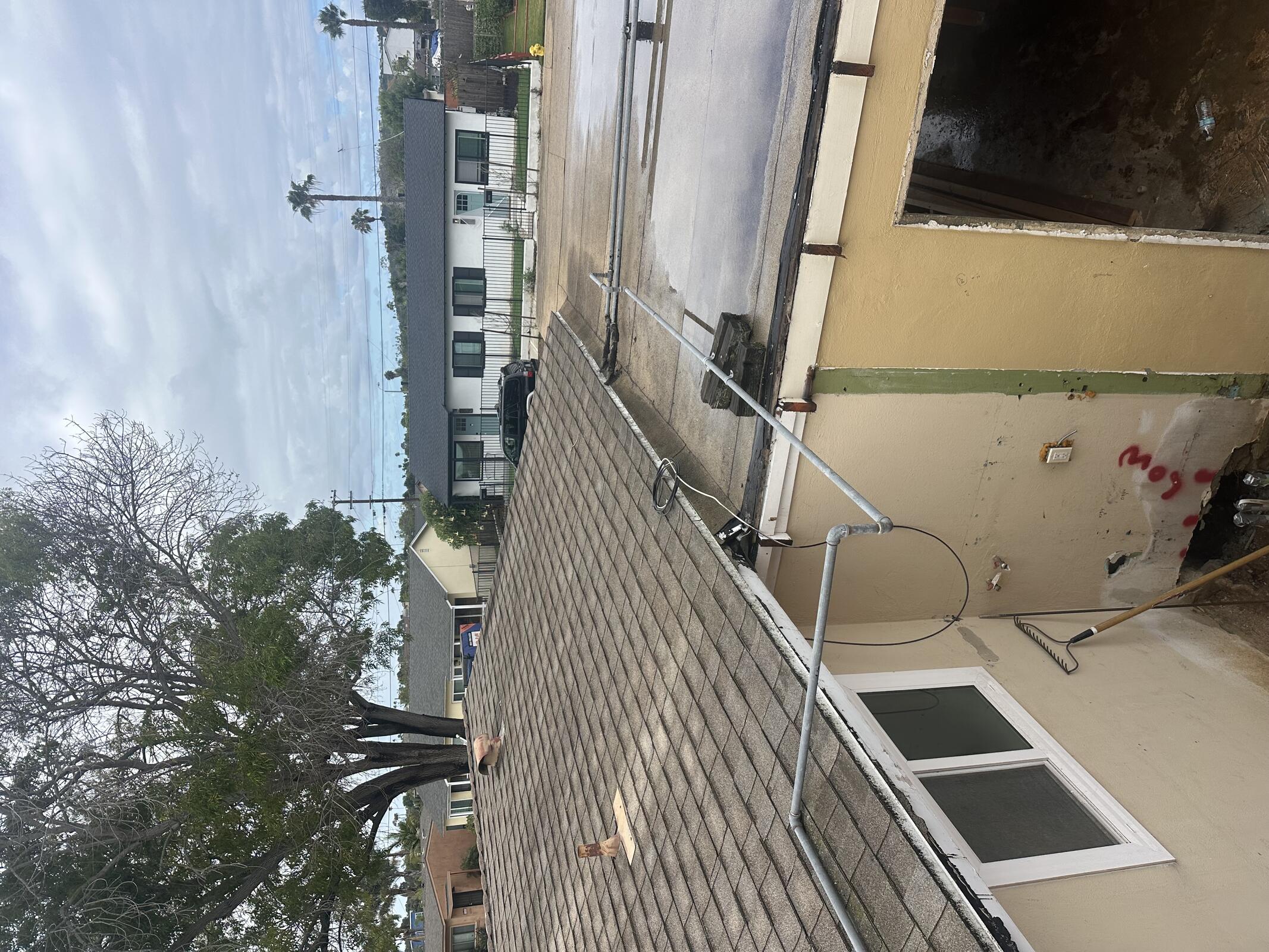

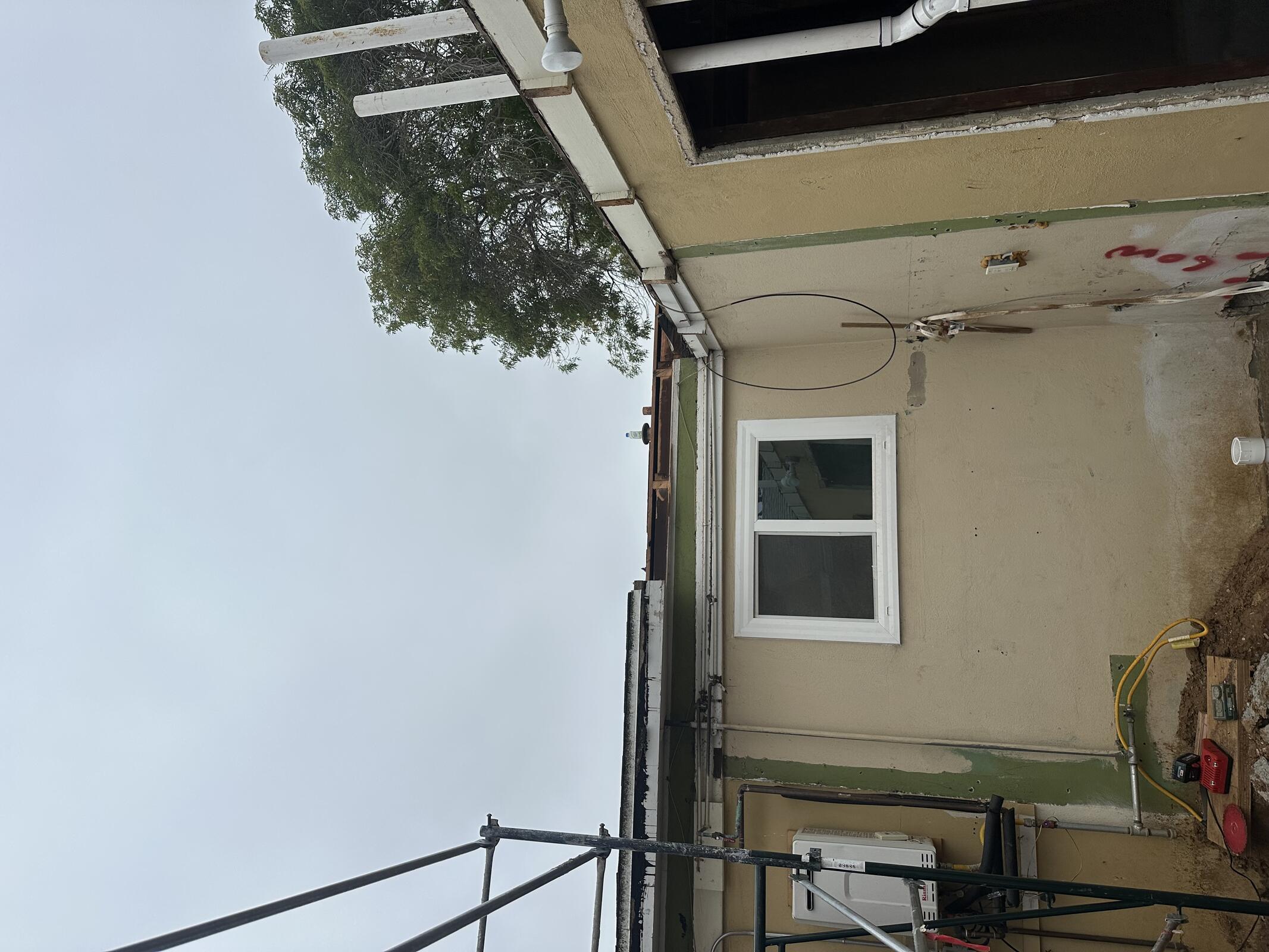

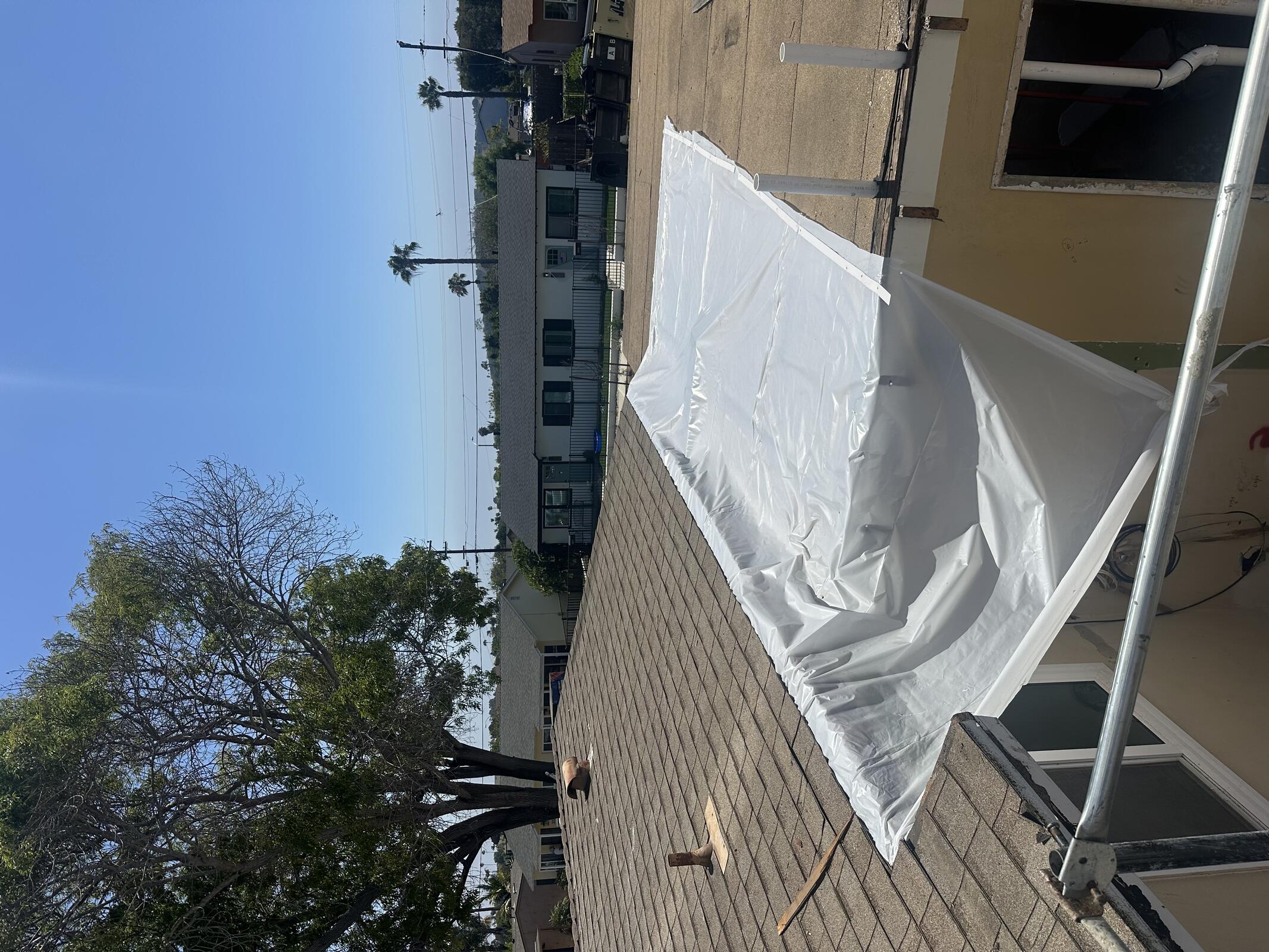

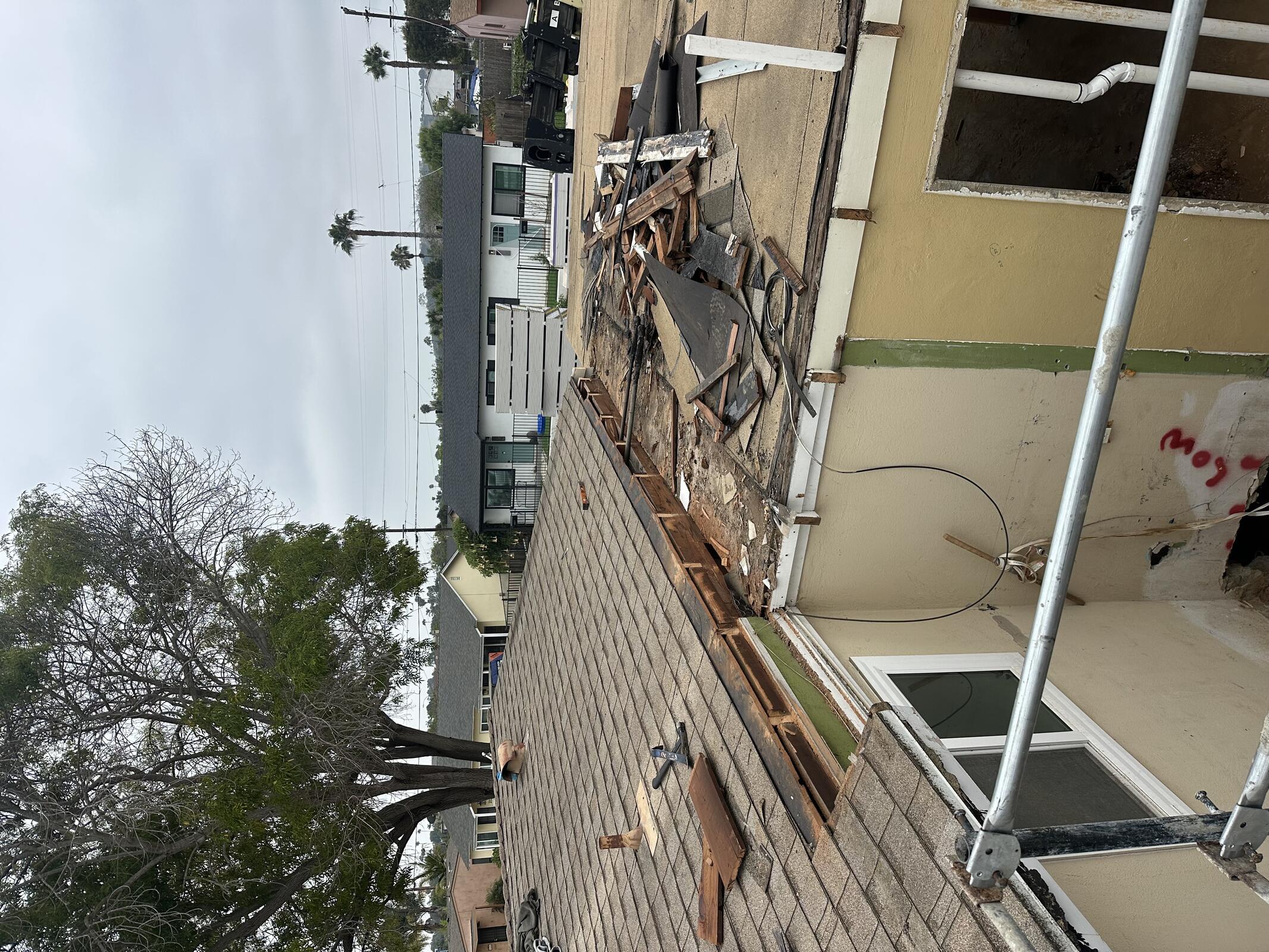

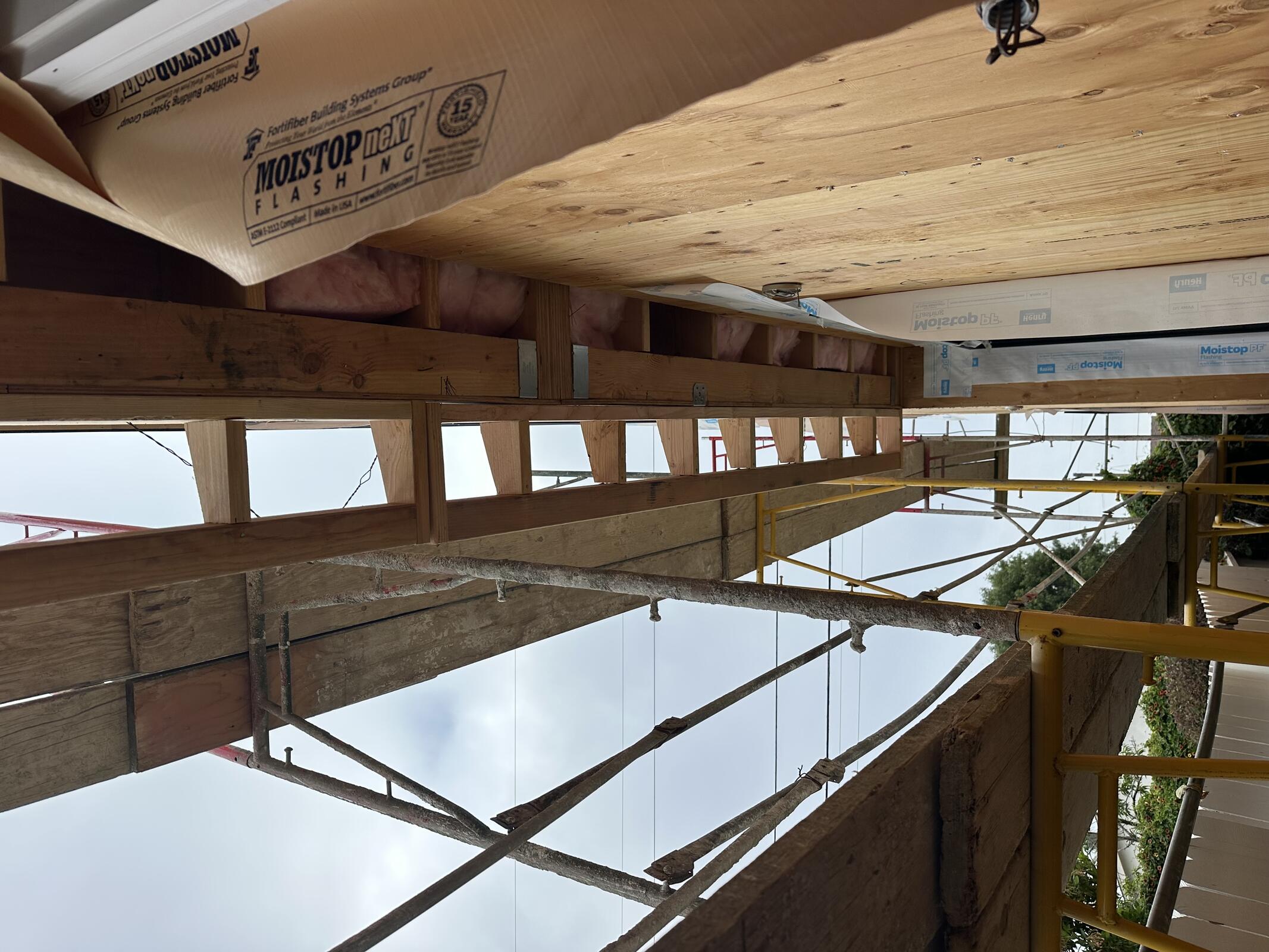

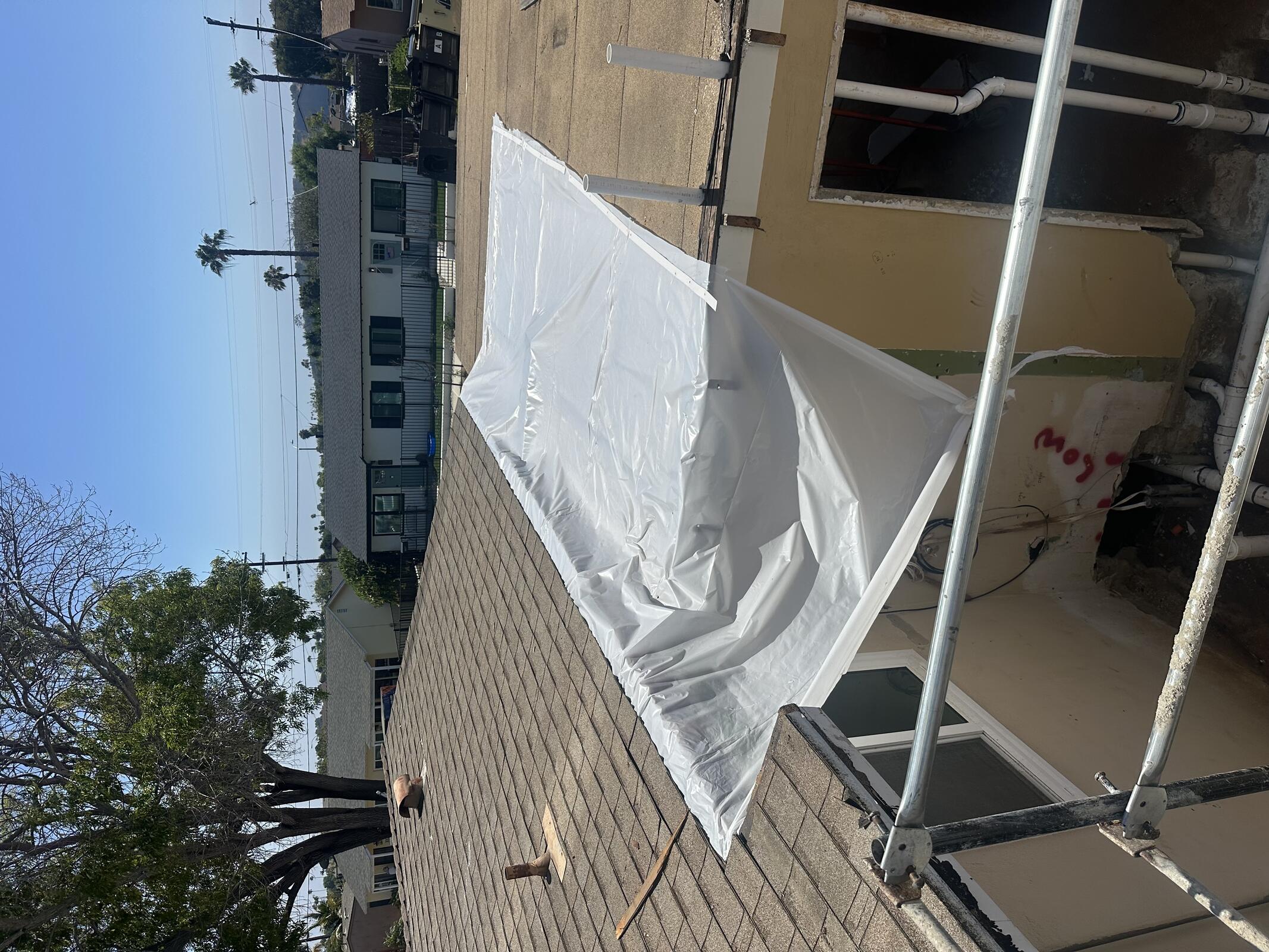

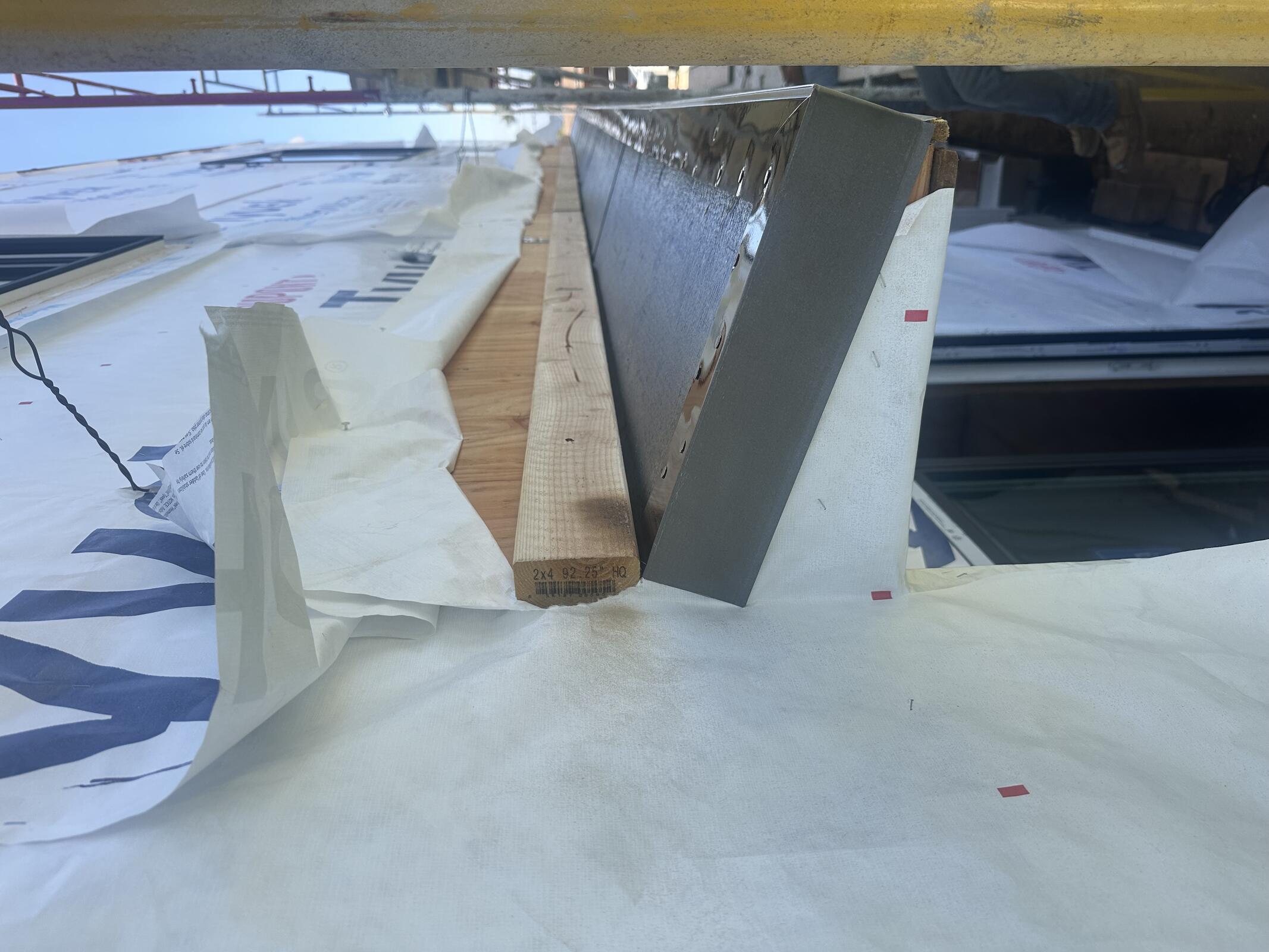

ACCI cutting back rafter where existing duplex roof intersects with garage conversion. Area wrapped in plastic for temporary water prevention. Also applying roofing to overhang at building C.

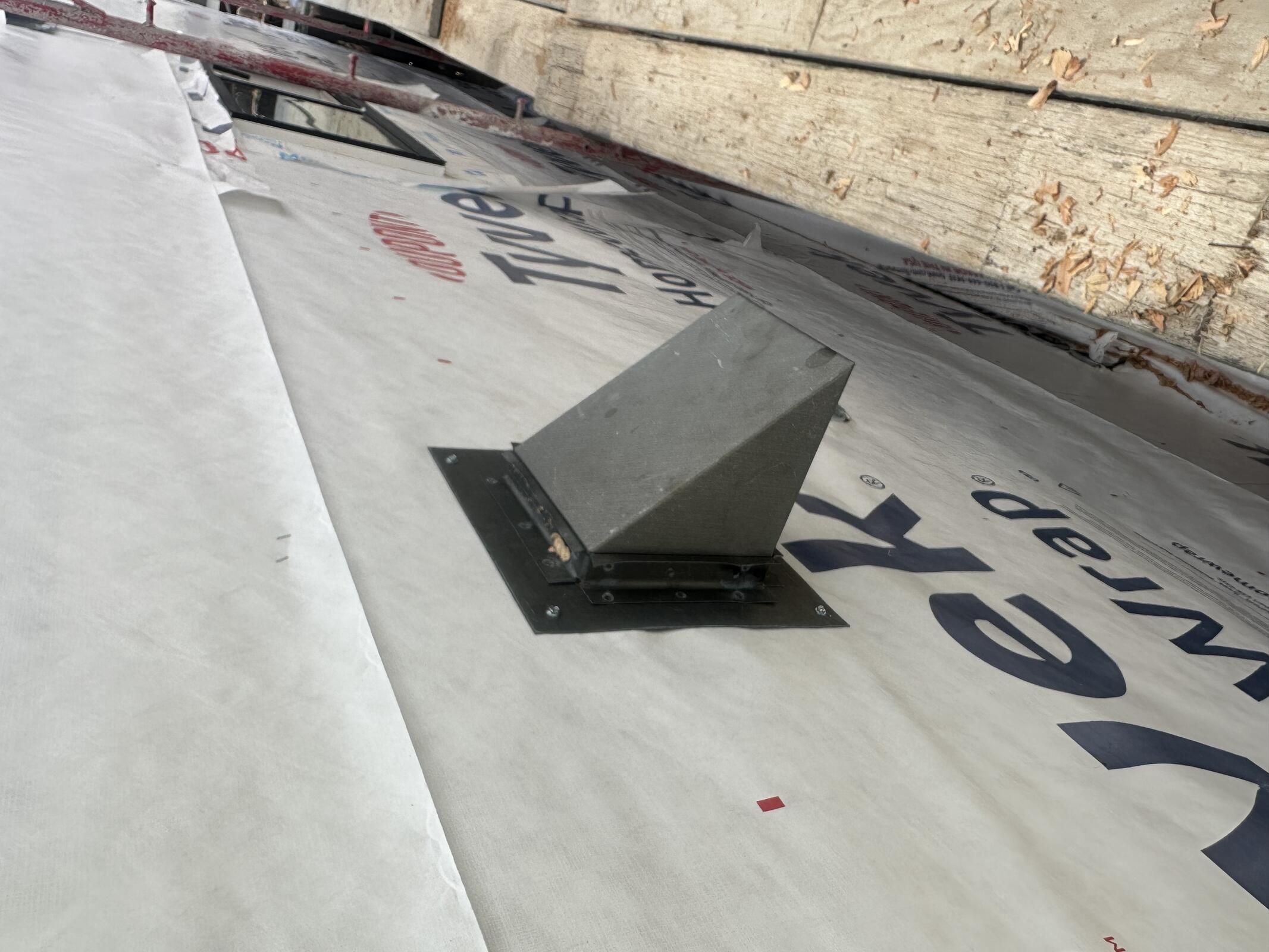

Clear HVAC installing microwave vent penetrations and flashing.
TDI handloading material into units.

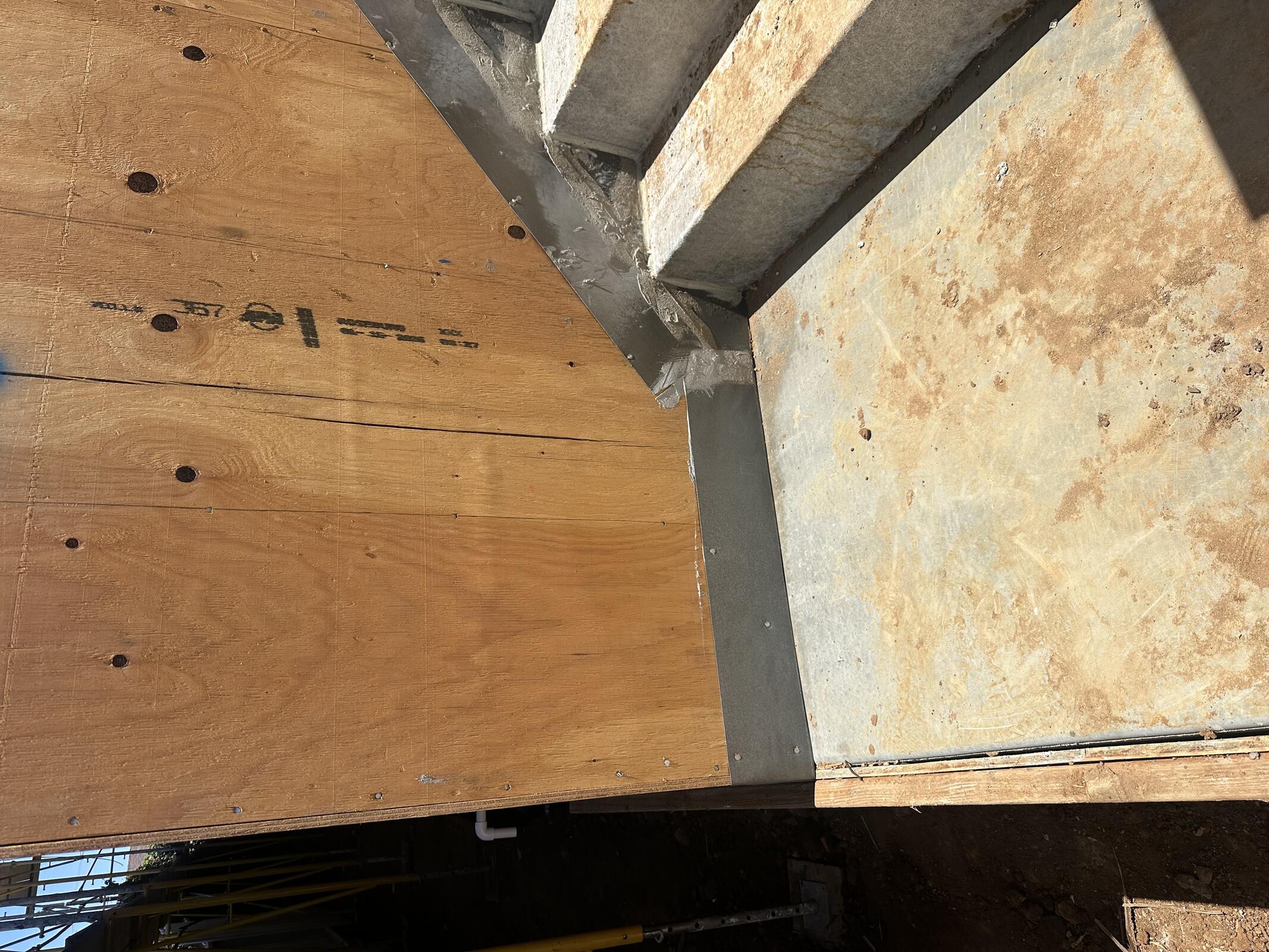

Marq plastering continuing to install weep screed and paper at B and C.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| ACCI | 2 | 8 | 16 |
| Traditions Drywall | 6 | 8 | 48 |
| ZSP | 1 | 8 | 8 |
| Clear HVAC | 1 | 2 | 2 |
| Marq | 2 | 3 | 6 |
Inspection: N/A
Delay: Sauder is changing their manufacturing process for slab style doors. Delivery window increased from 6 weeks to 7-8 weeks.
