Week of April 27 — May 01, 2026
4 days on site. 54 photos. DFH, Electric, Framing, HVAC, Inspection, Plumbing, Roofing, Scaffolding, Traffic Coating.
Monday, April 27, 2026
Partially cloudy, 64°F

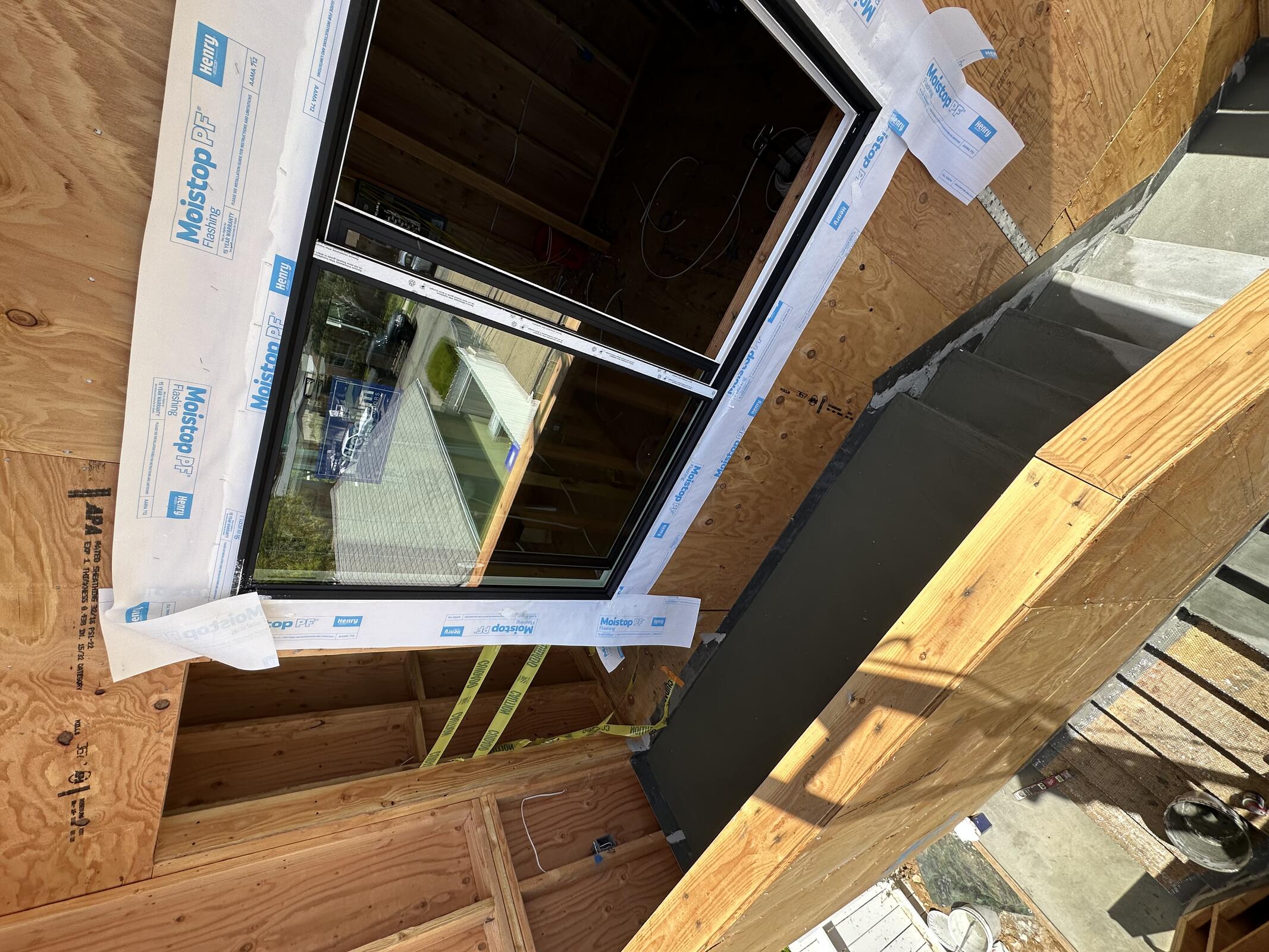

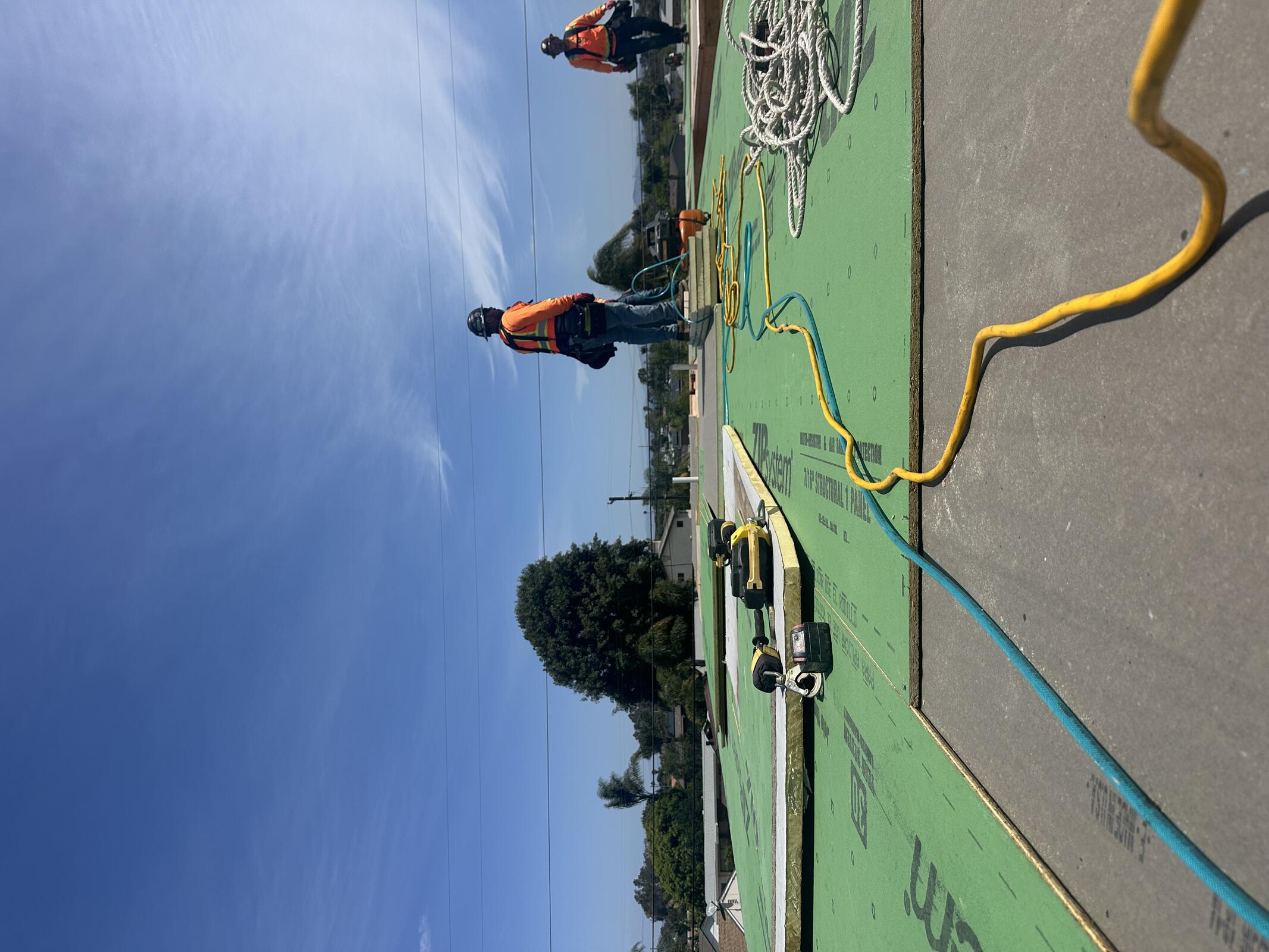

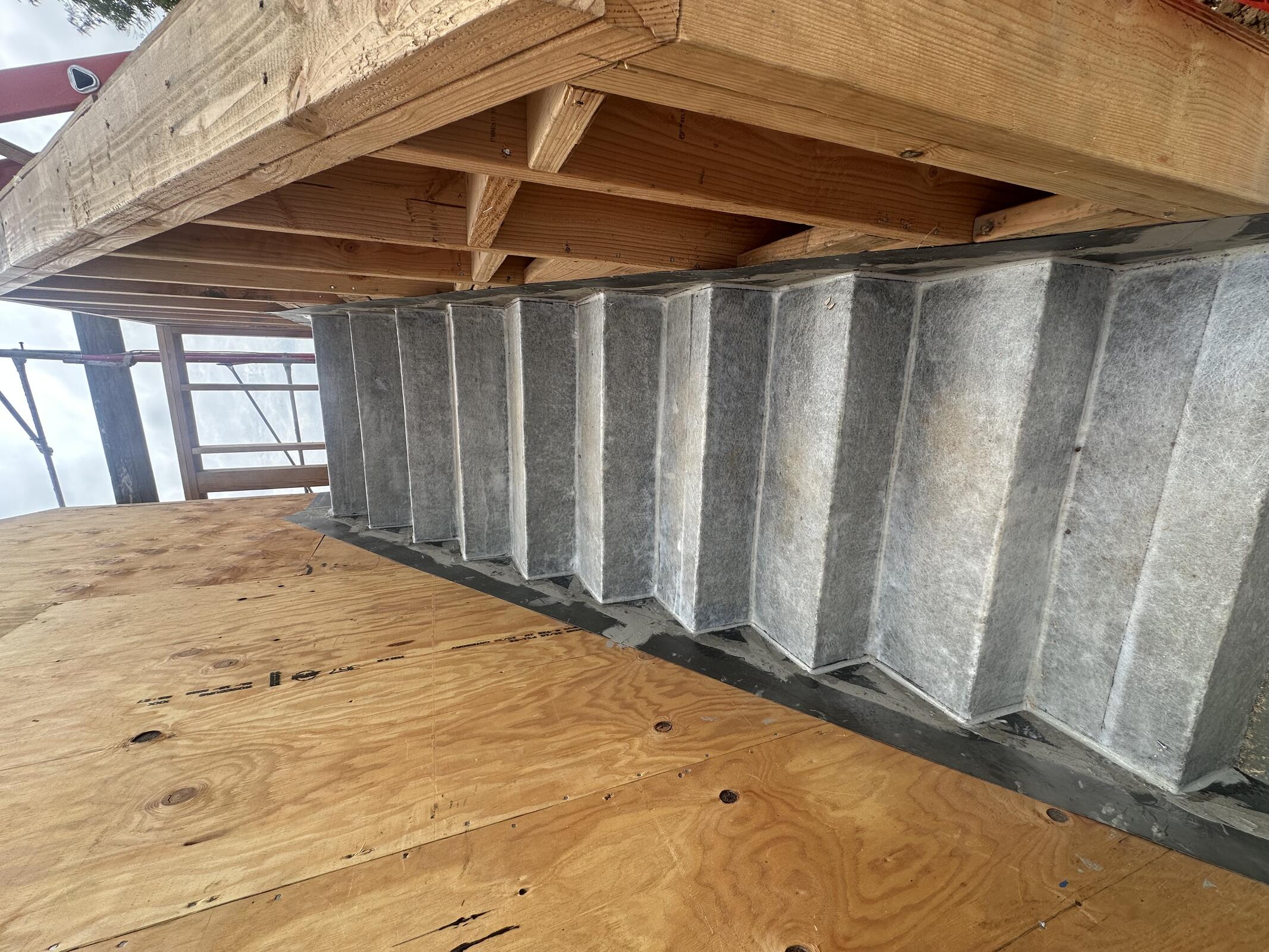

Rete's on site, sloping stair landings at Building C and prepping for traffic coating installation.

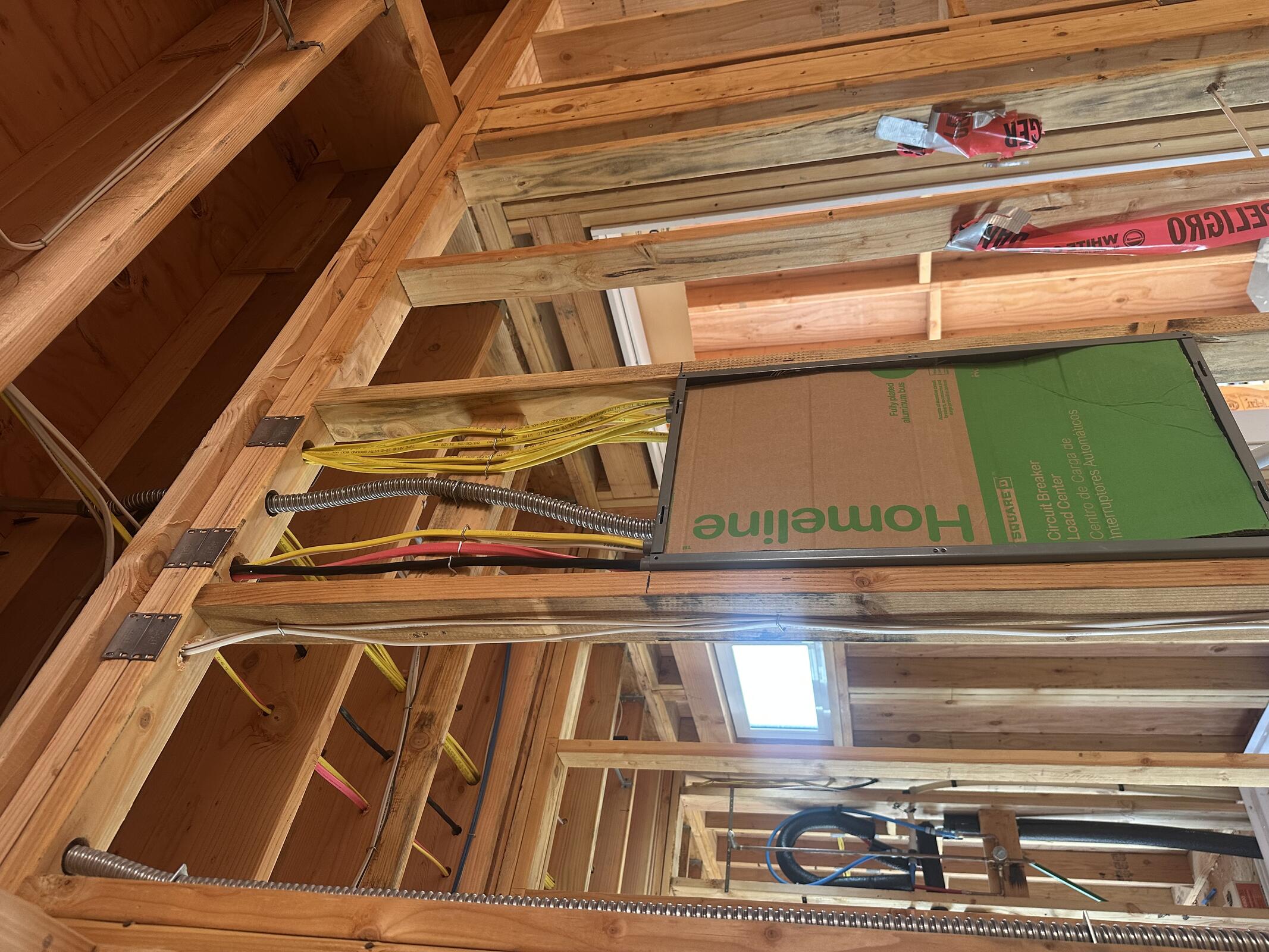

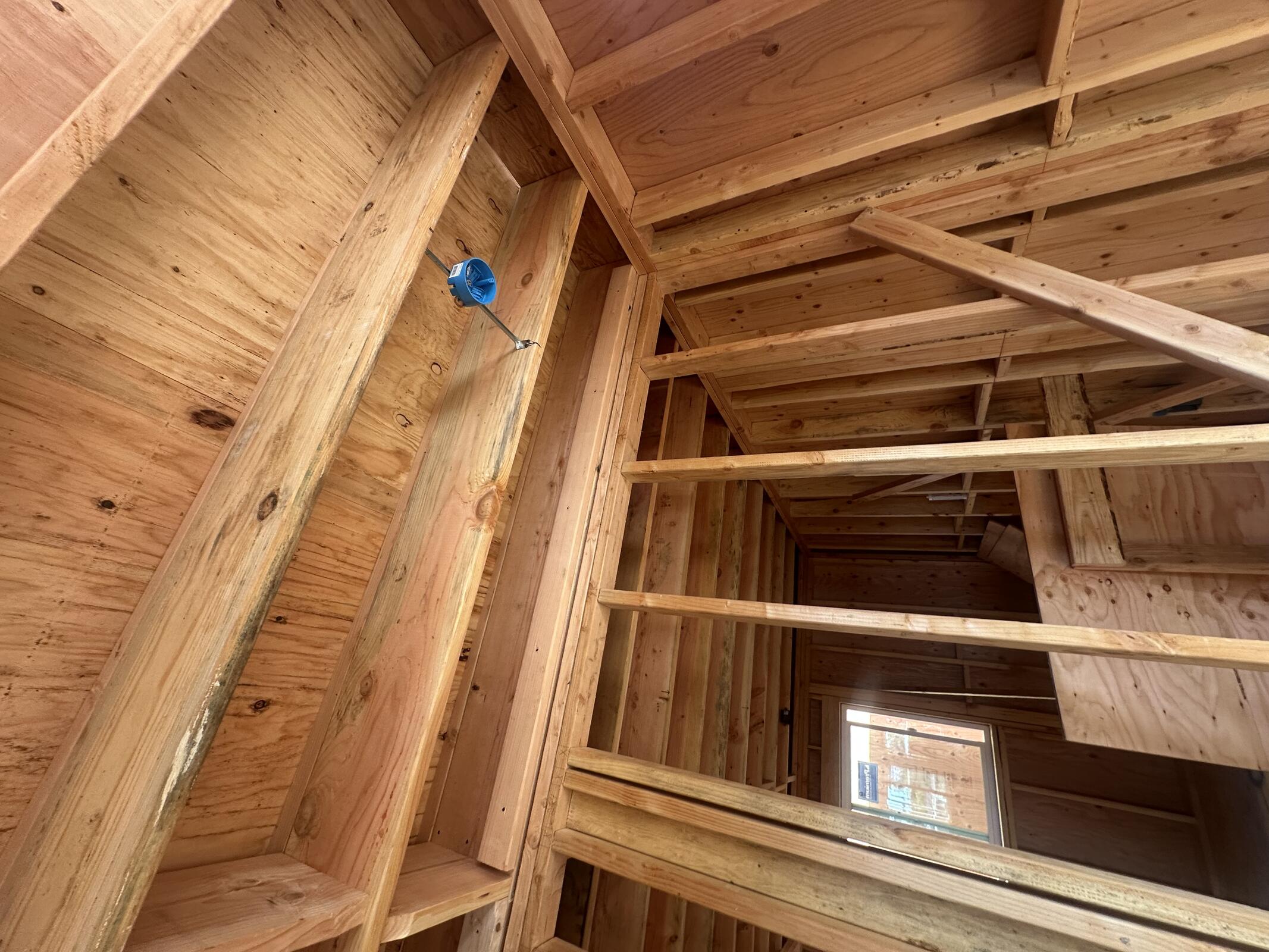

AC Electric on site, finishing Building C.

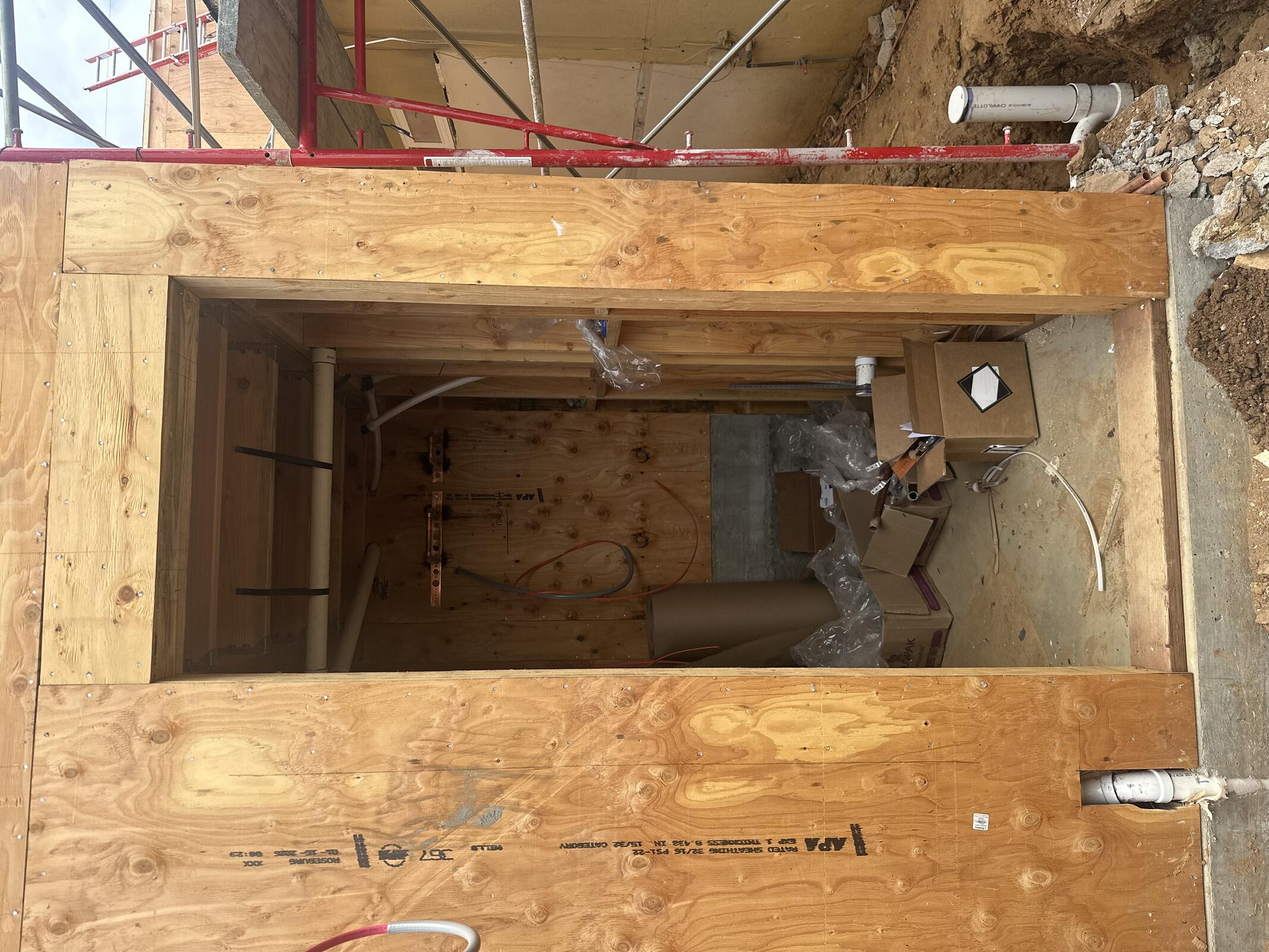

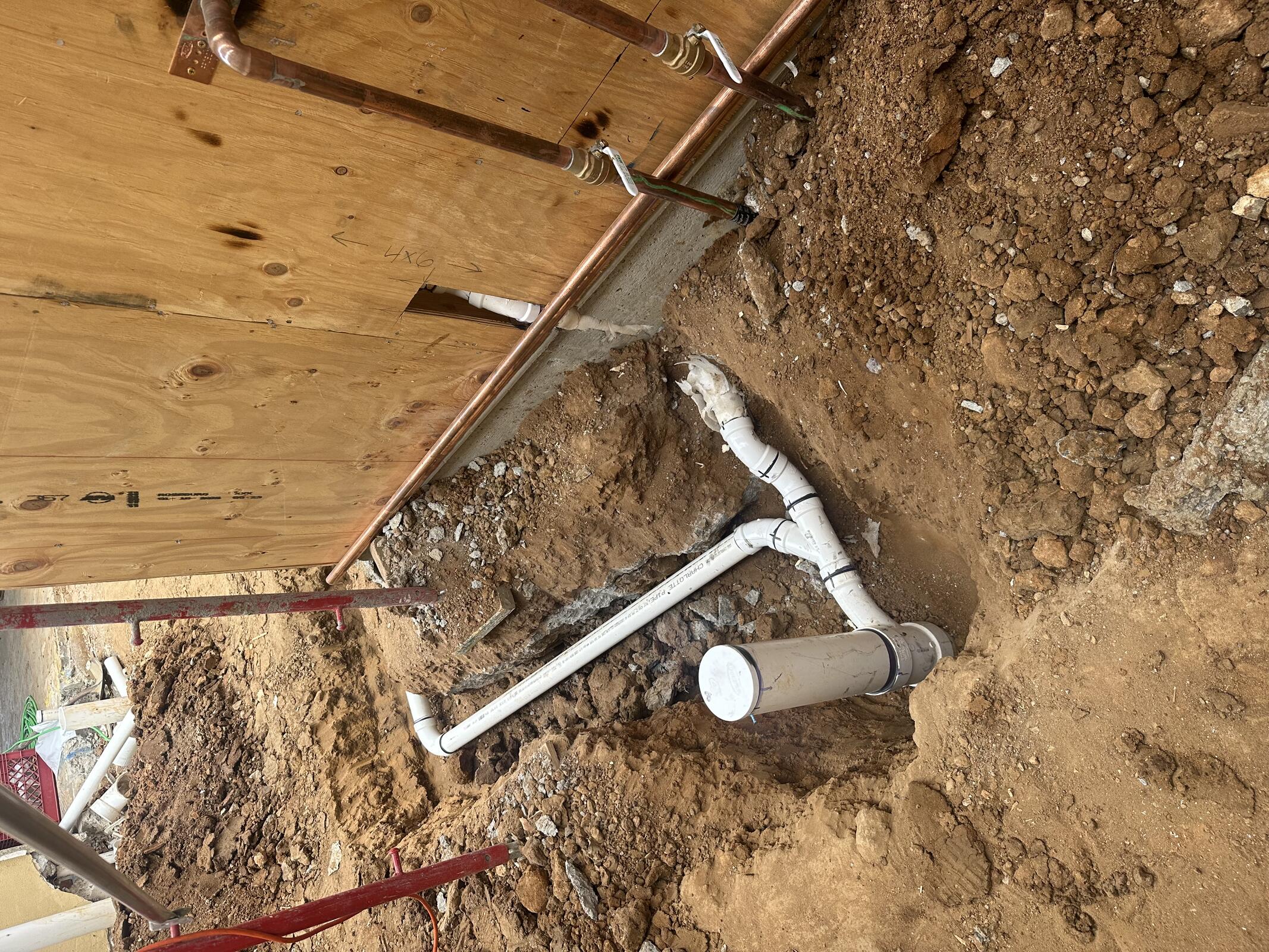

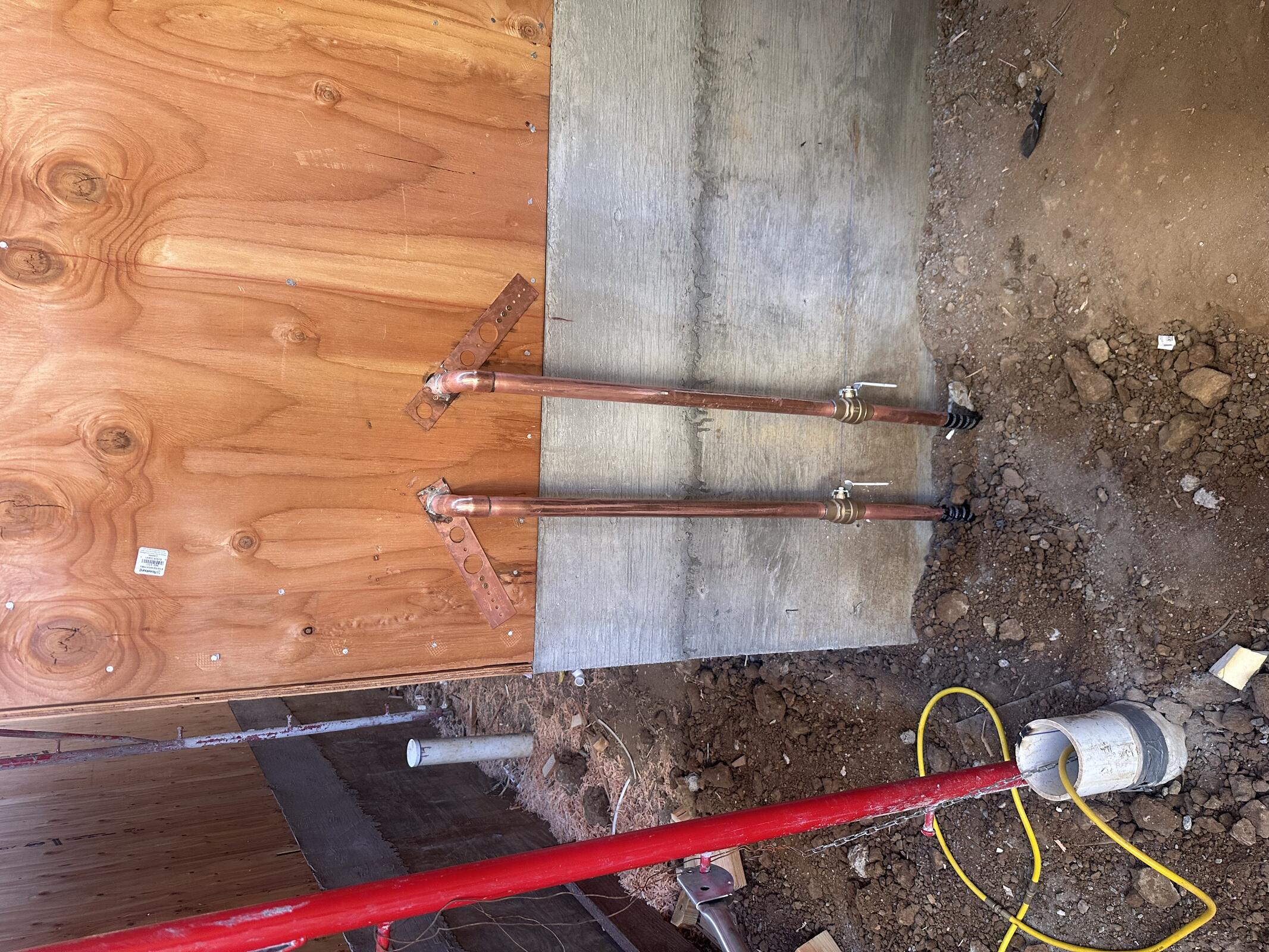

ZSP on site working on water connection to Building B.

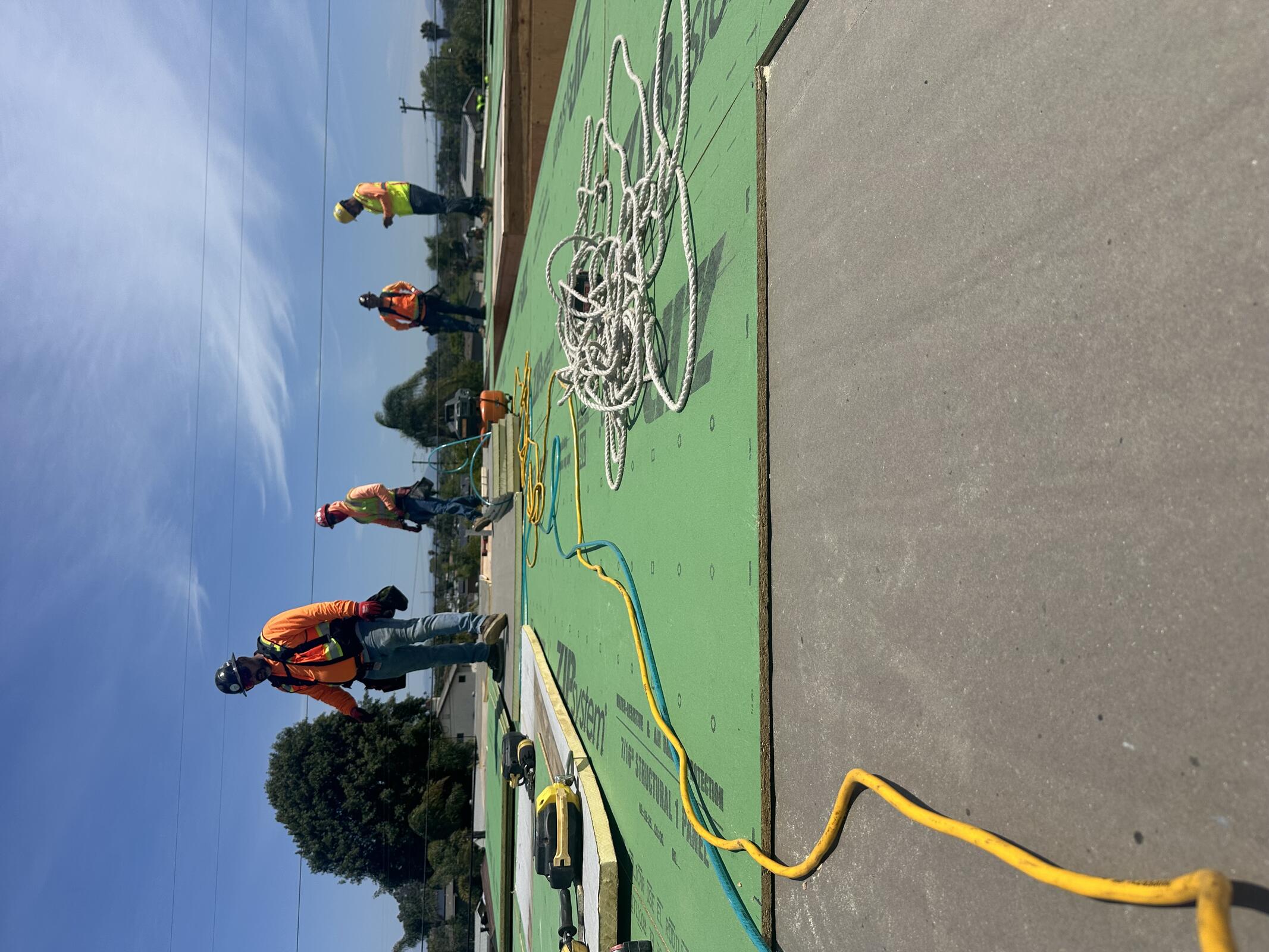

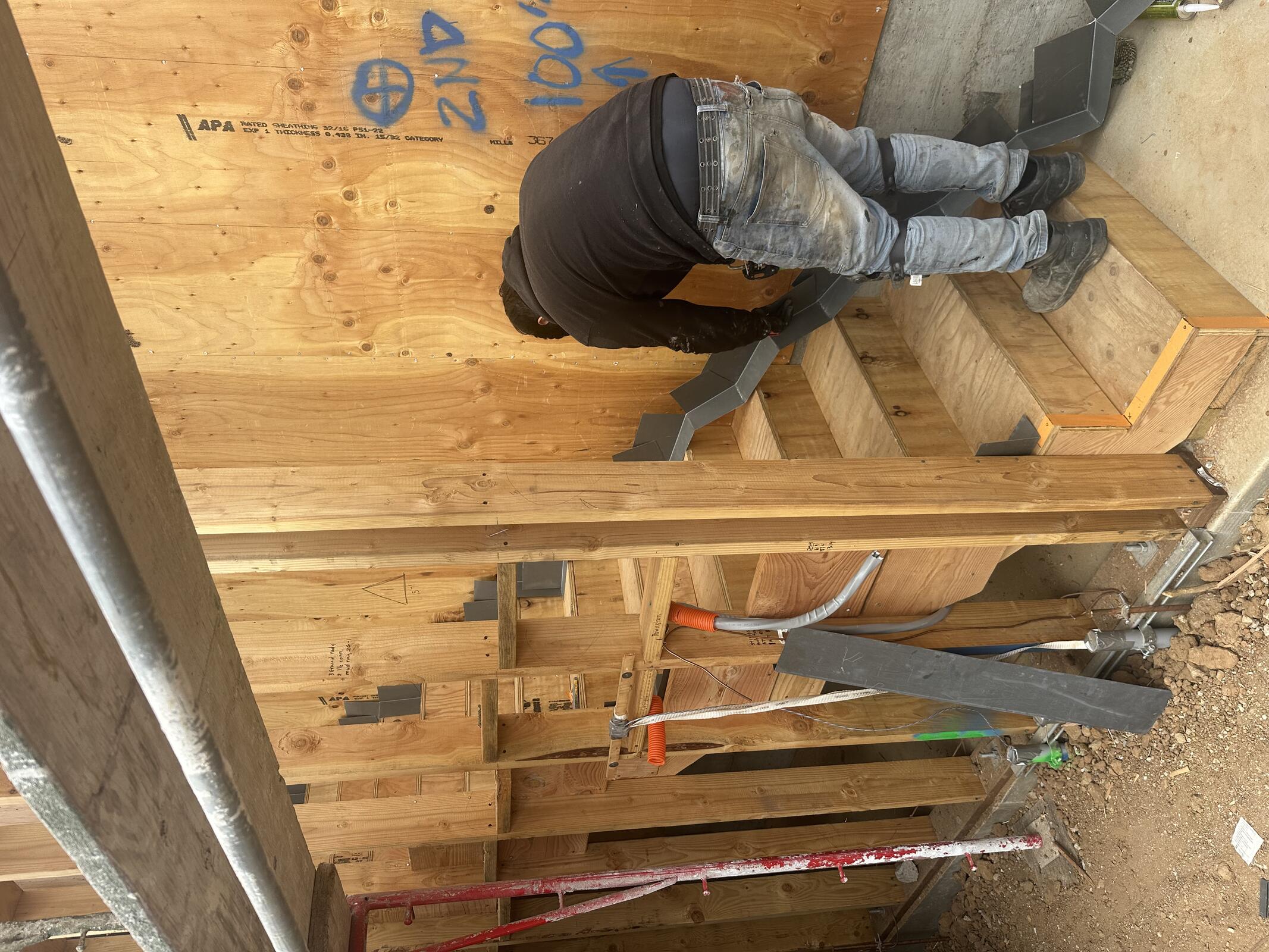

Remaining scaffolding being erected.

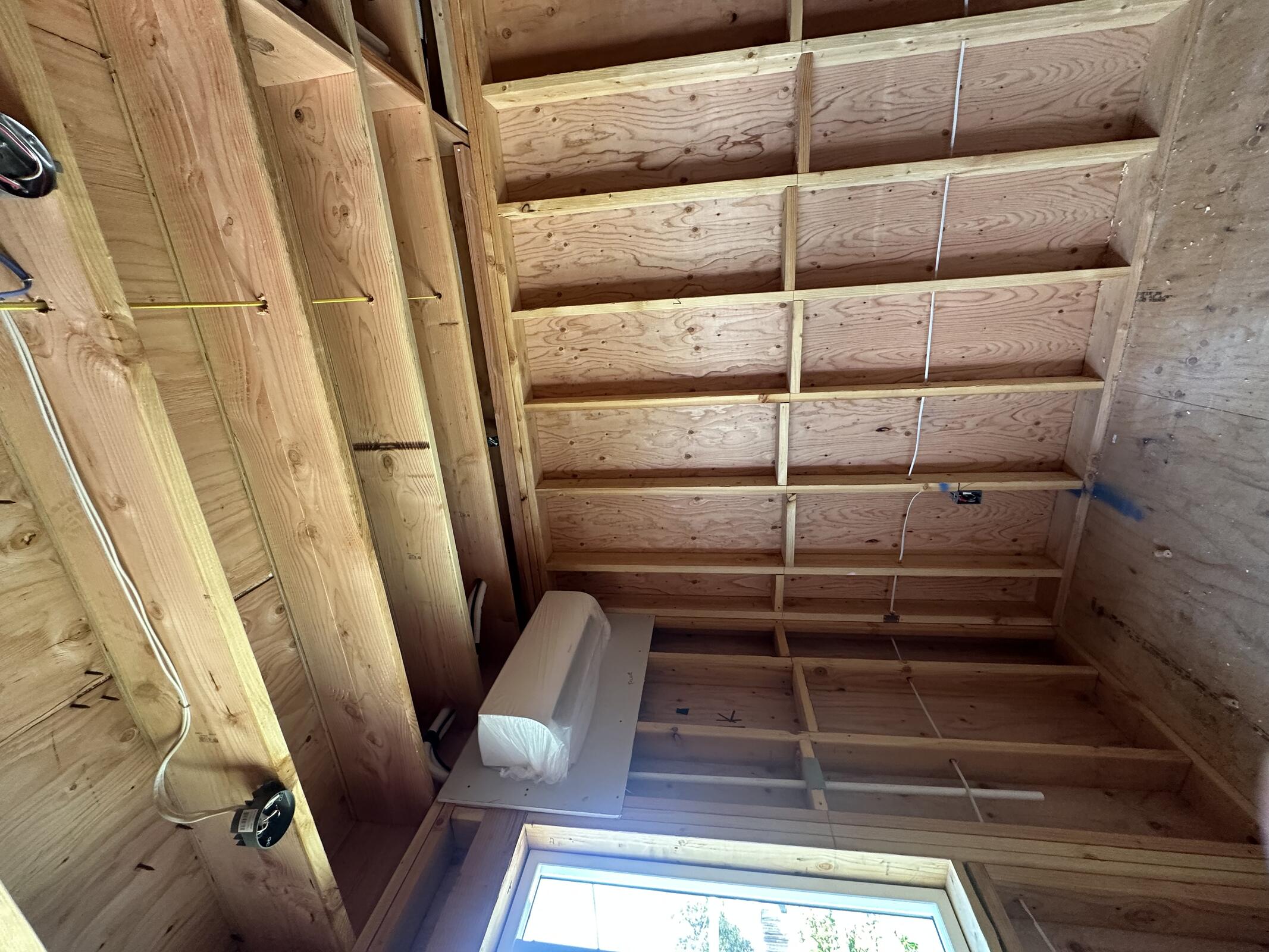

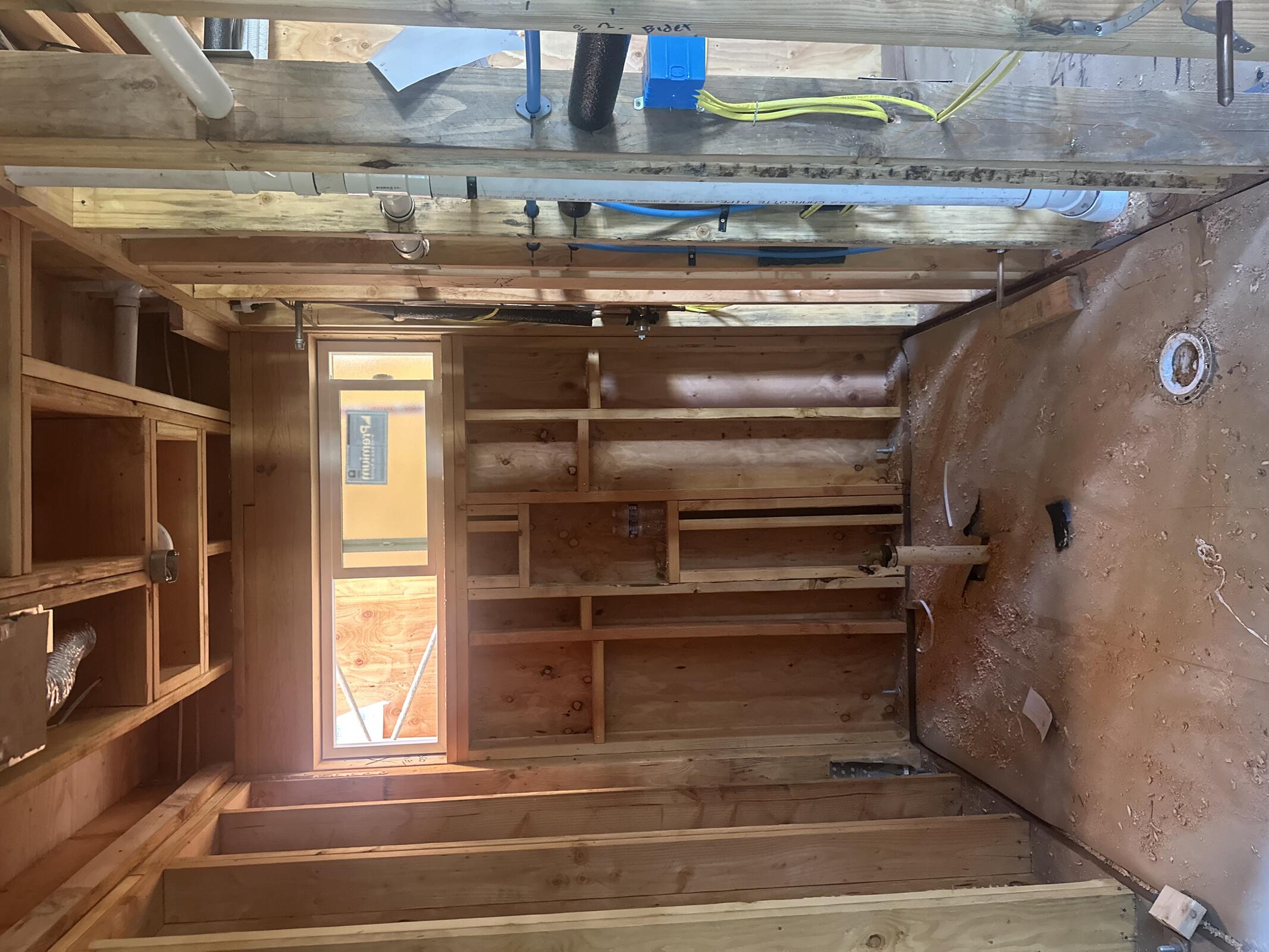

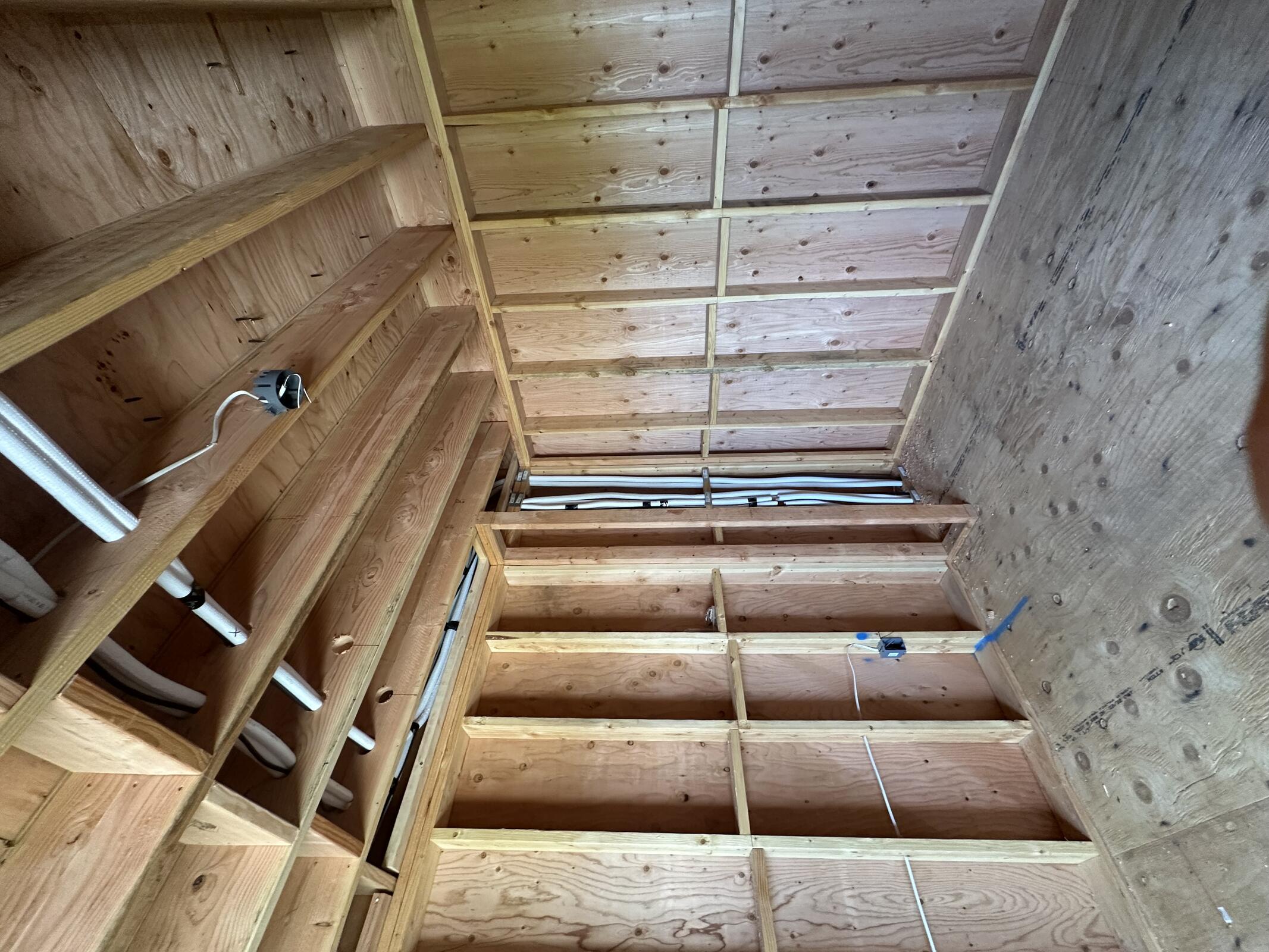

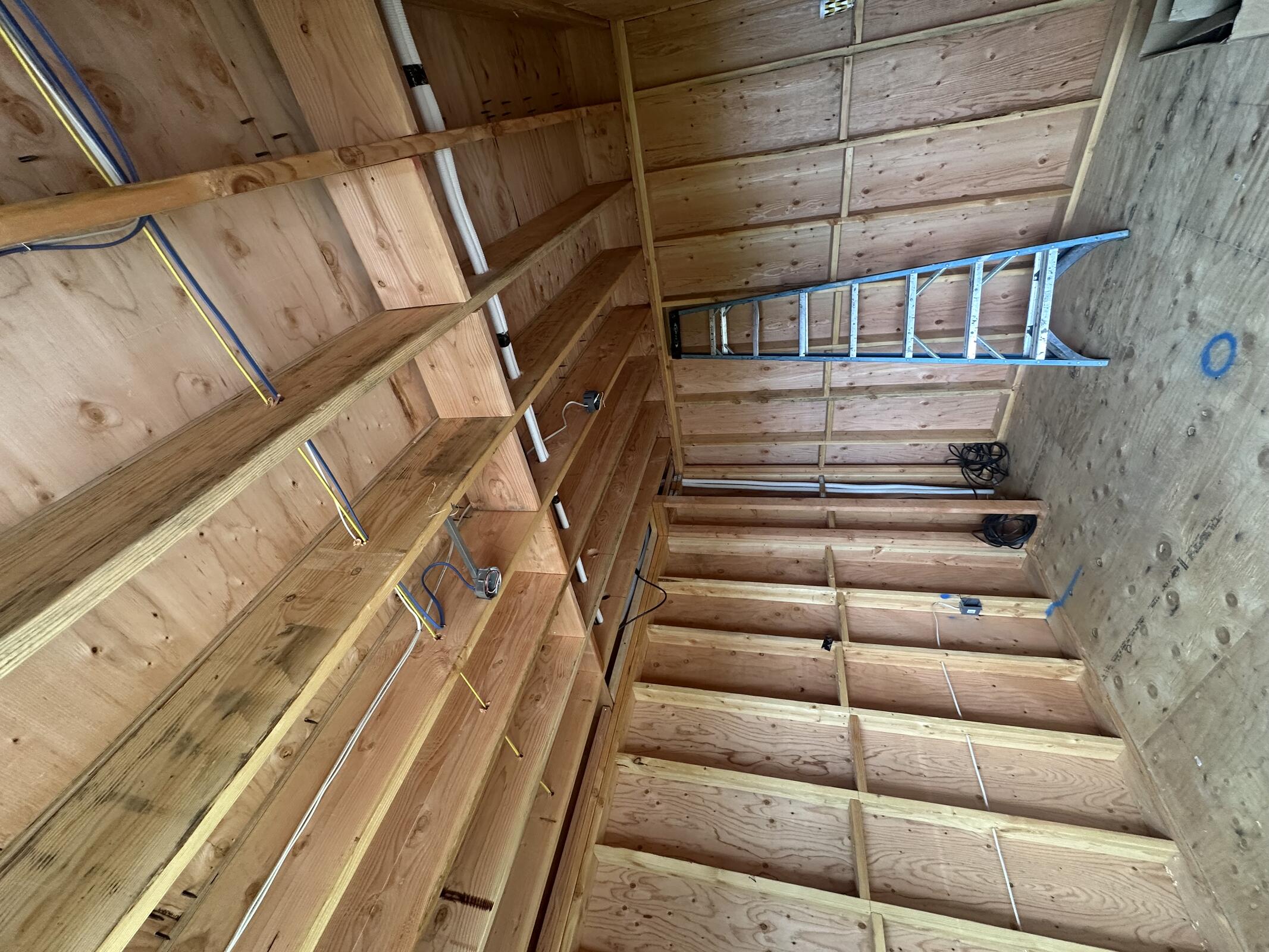

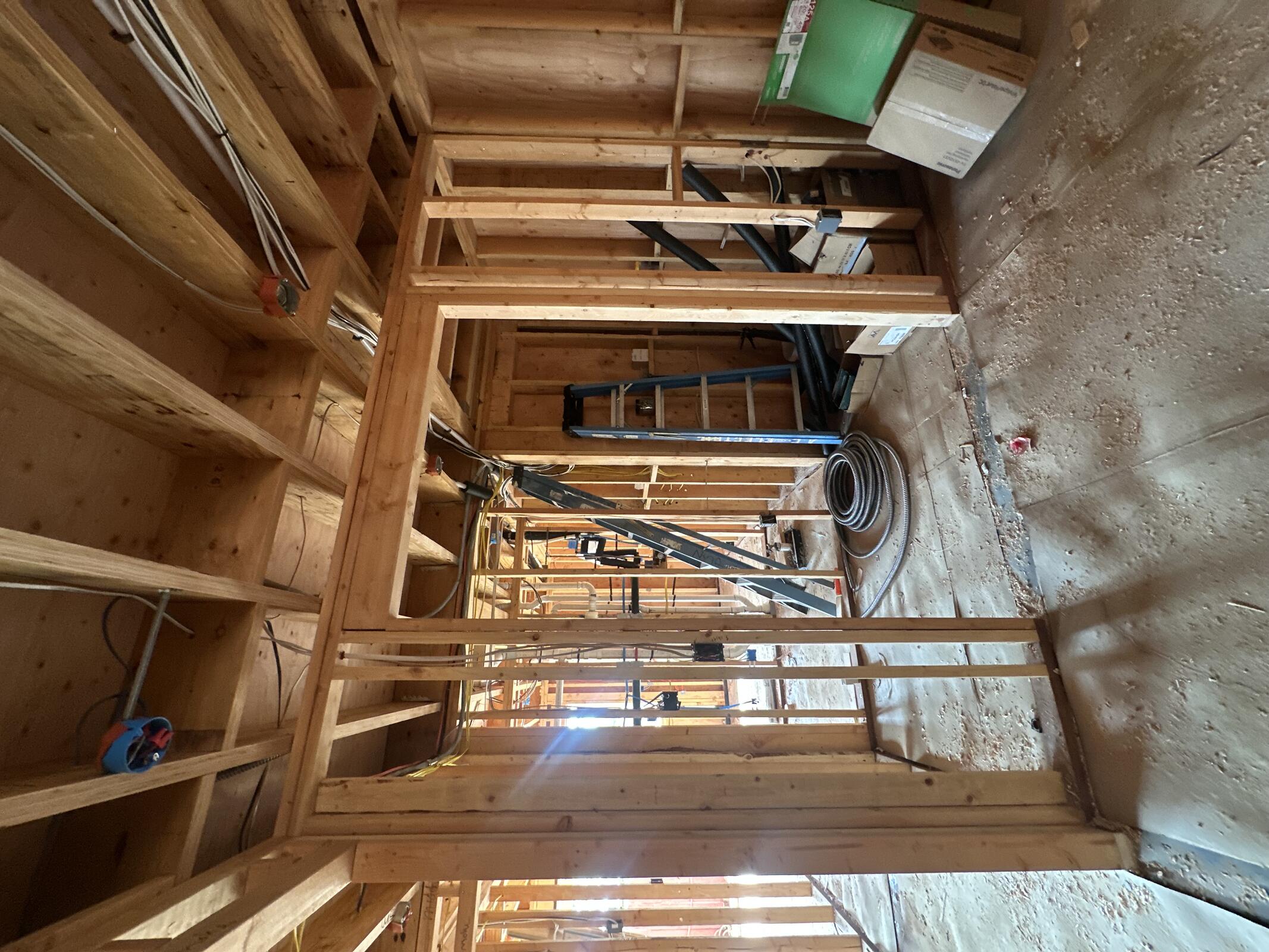

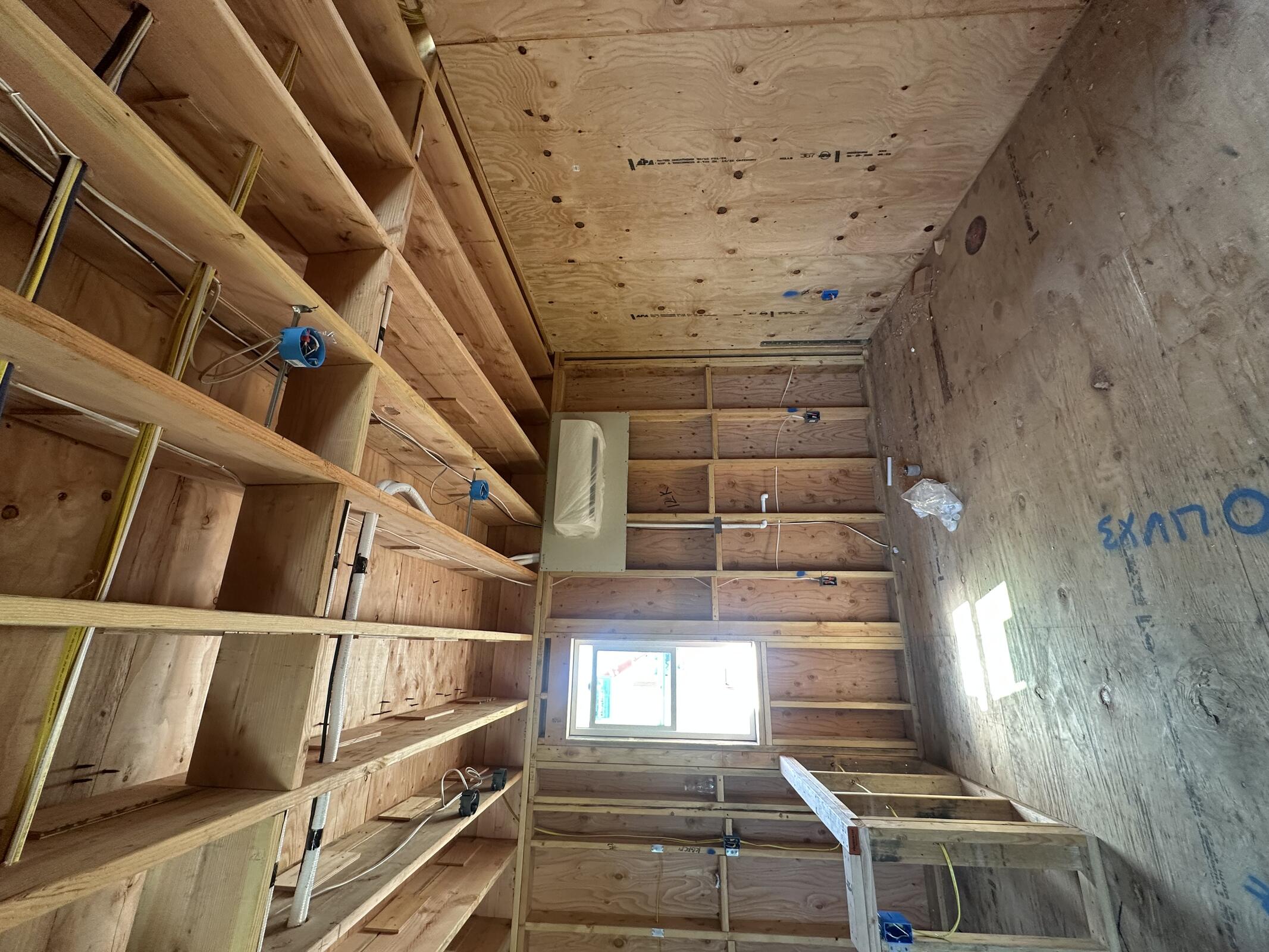

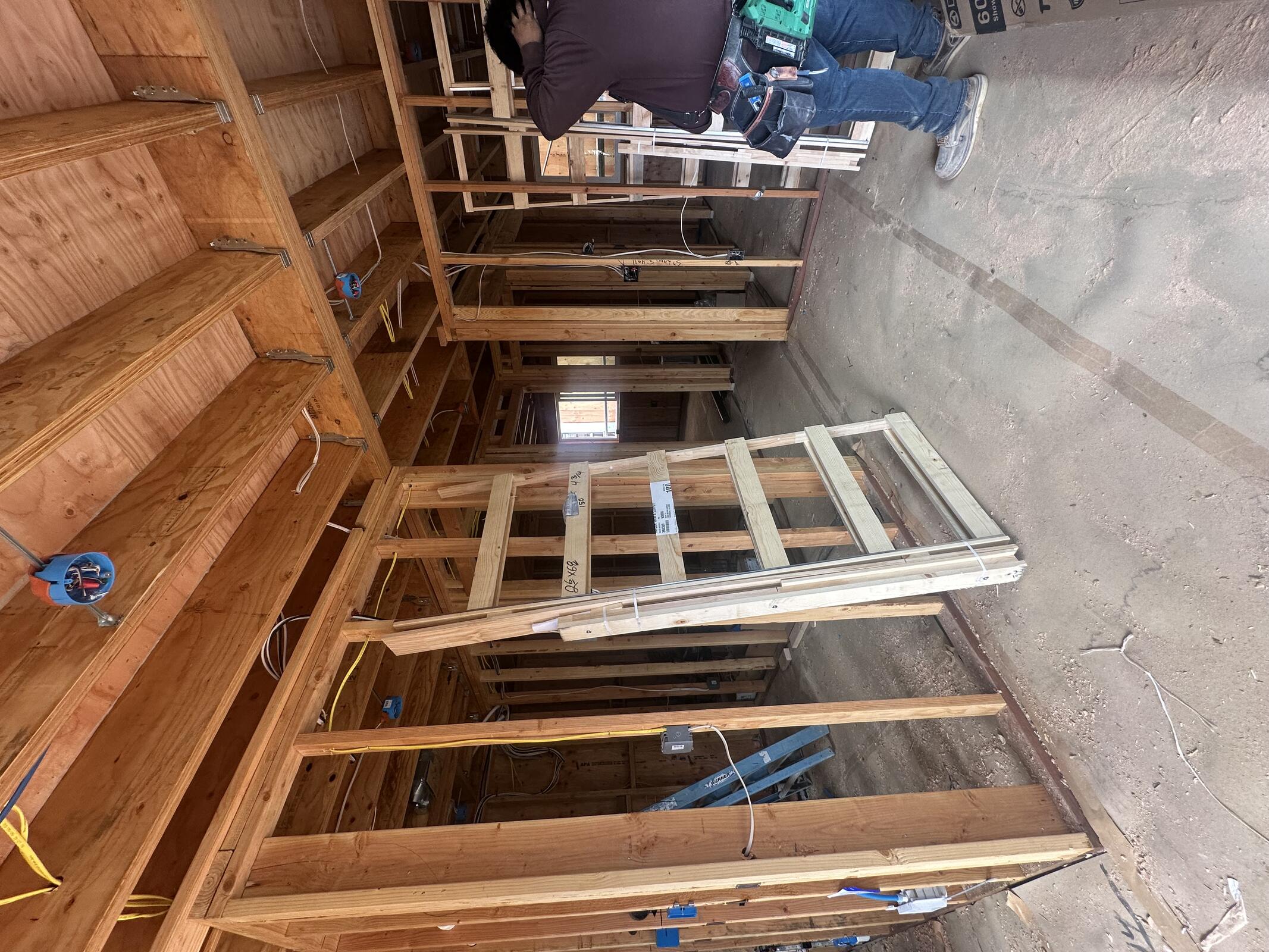

JB General on site doing clean up, hardware pickup and blocking at Buildings B and C.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| JB General | 4 | 8 | 32 |
| ZSP | 2 | 8 | 16 |
| AC Electric | 3 | 8 | 25 |
| Rete's | 3 | 8 | 24 |
Inspection: Danny on site at 3:00 PM to inspect Building B roof nailing and shear. Passed.










Tuesday, April 28, 2026
Clear, 65°F

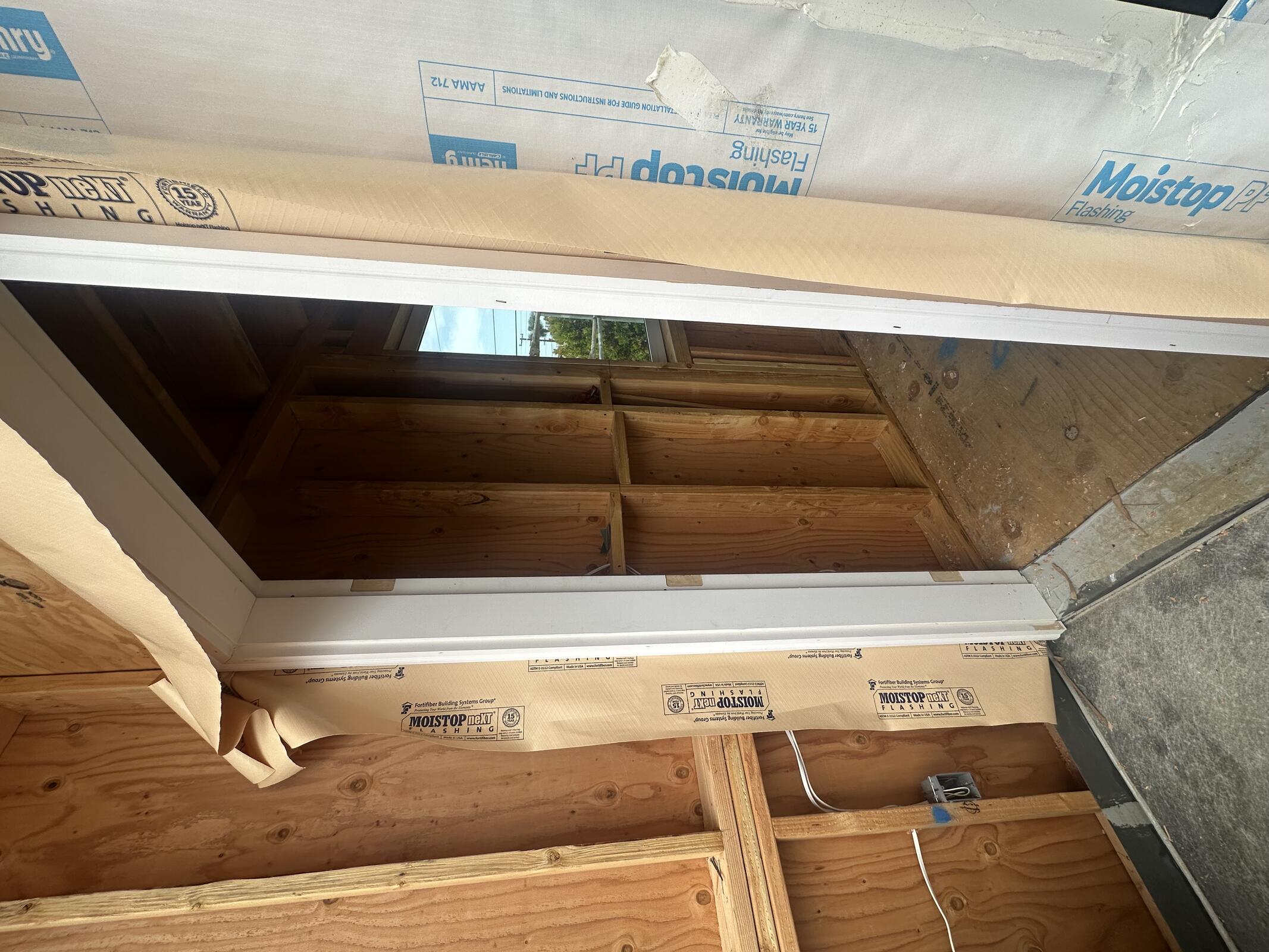

ACCI on site, installing 1.5" rigid insulation and OSB.

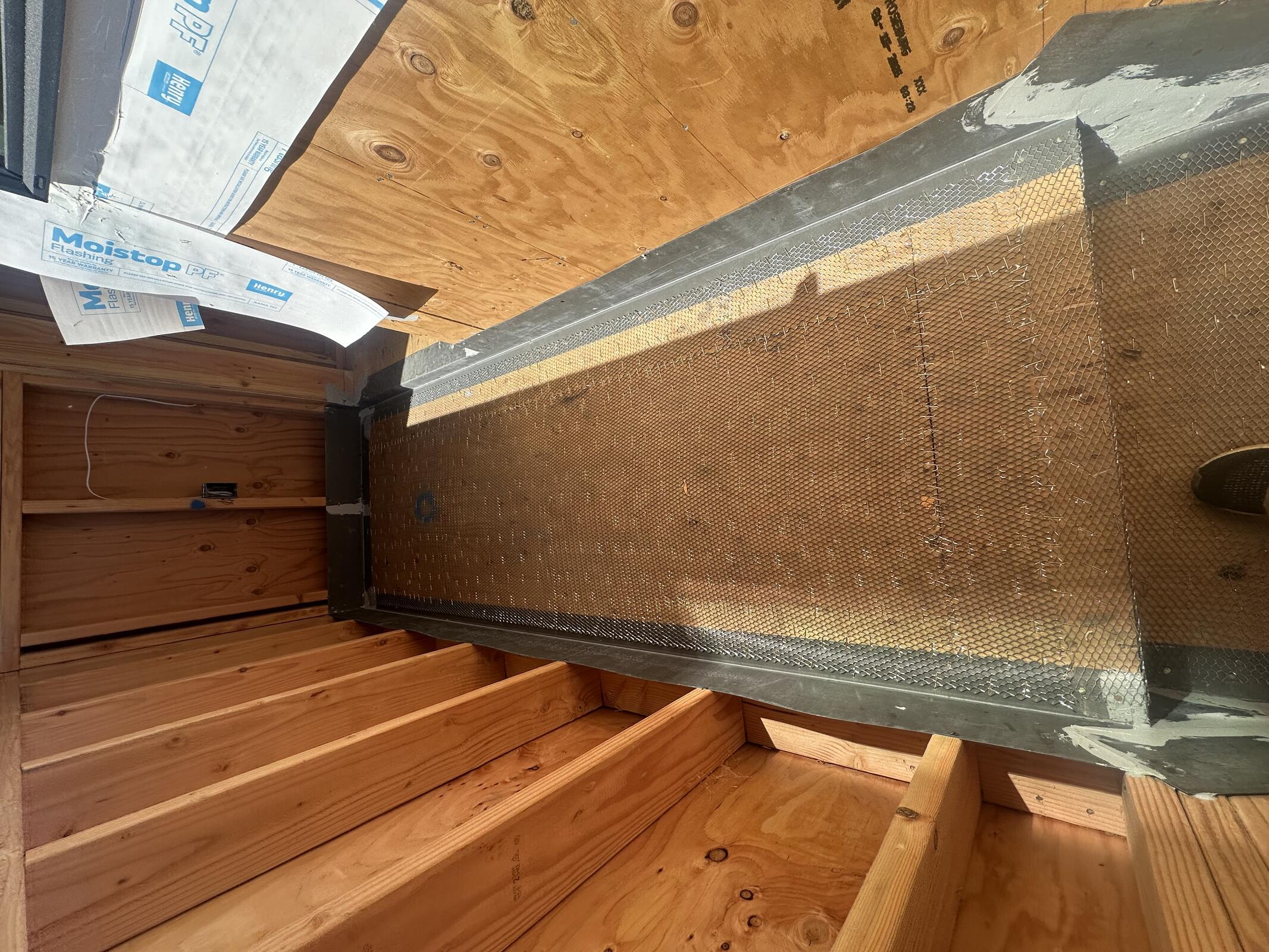

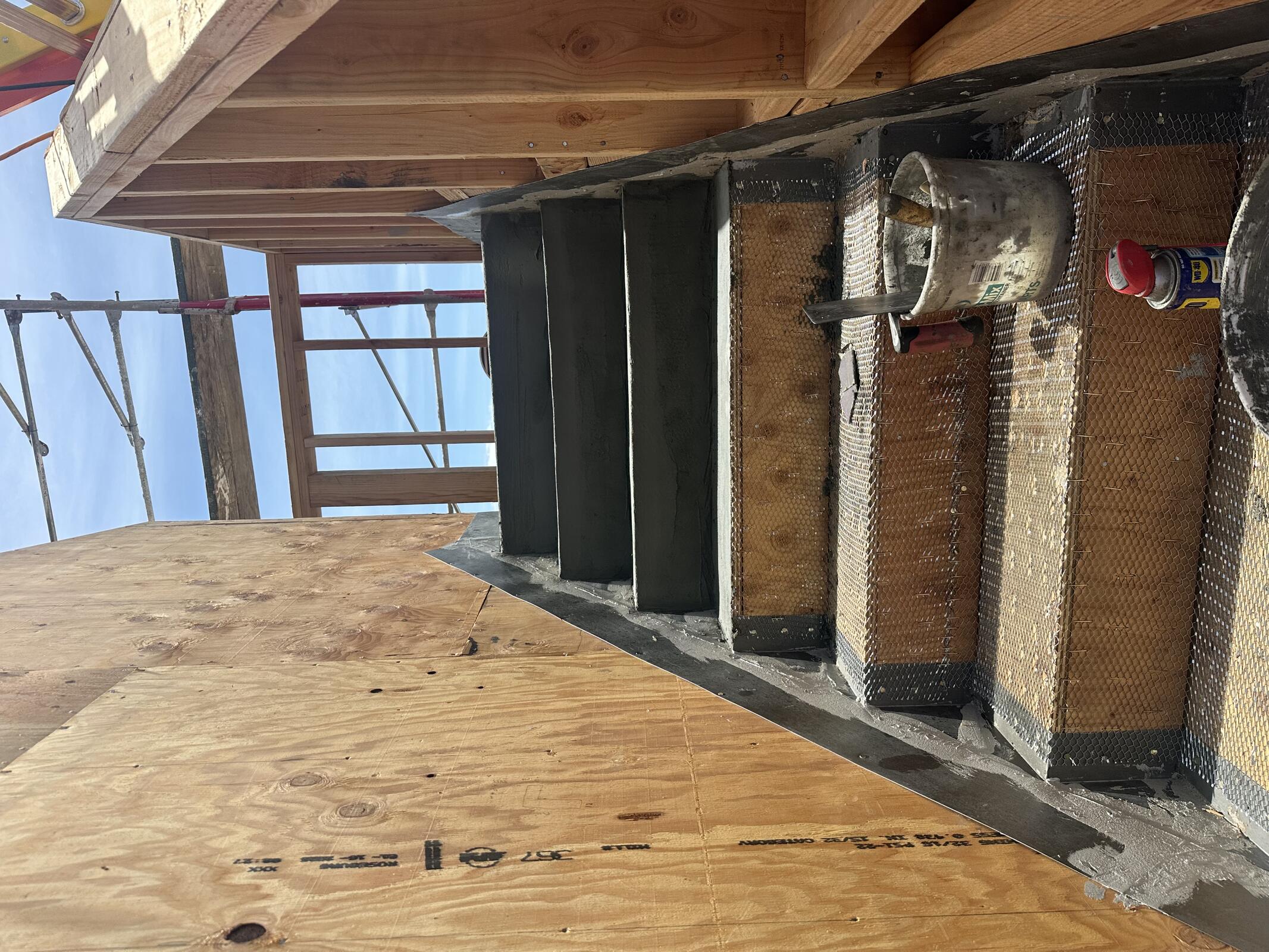

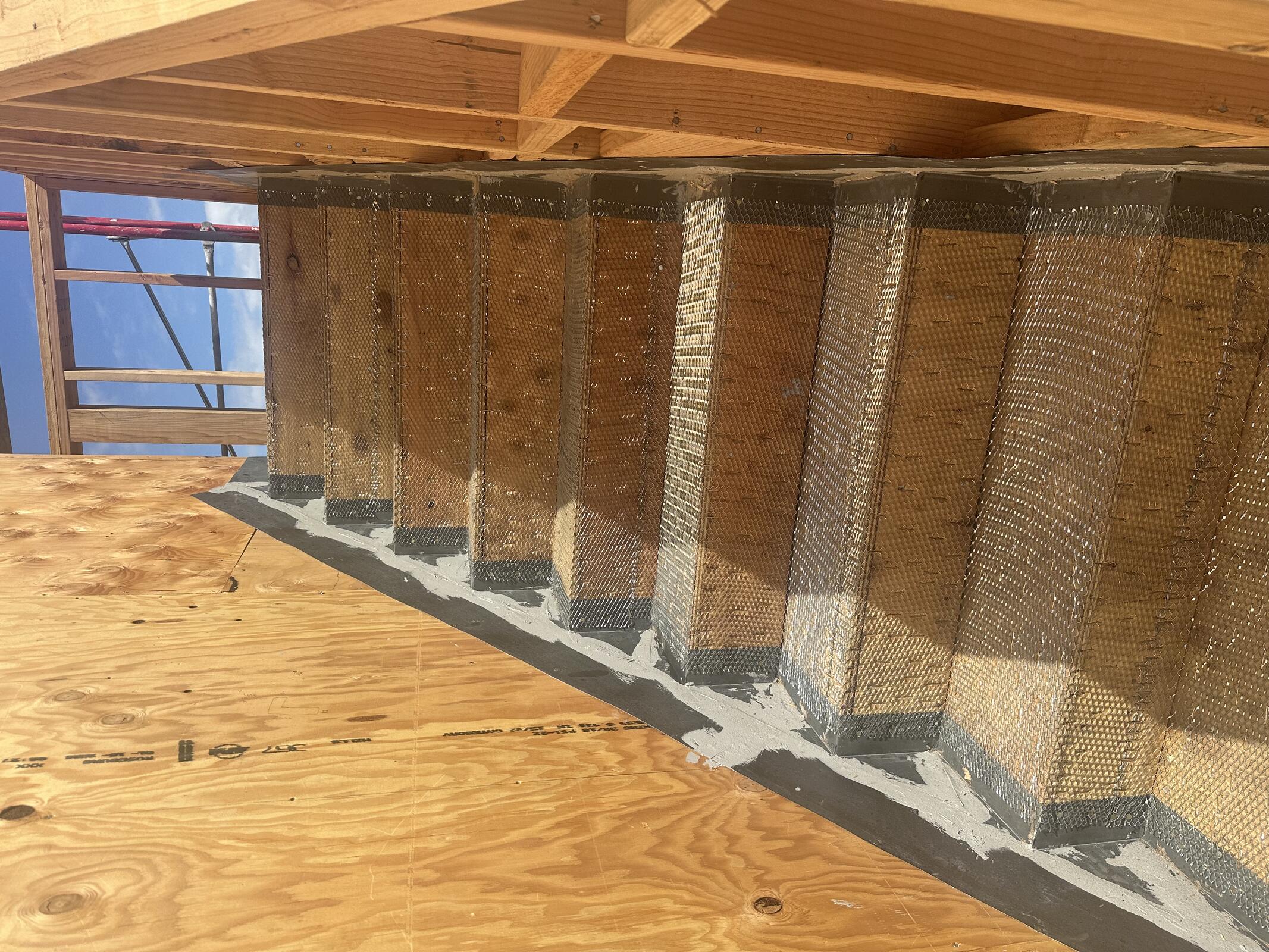

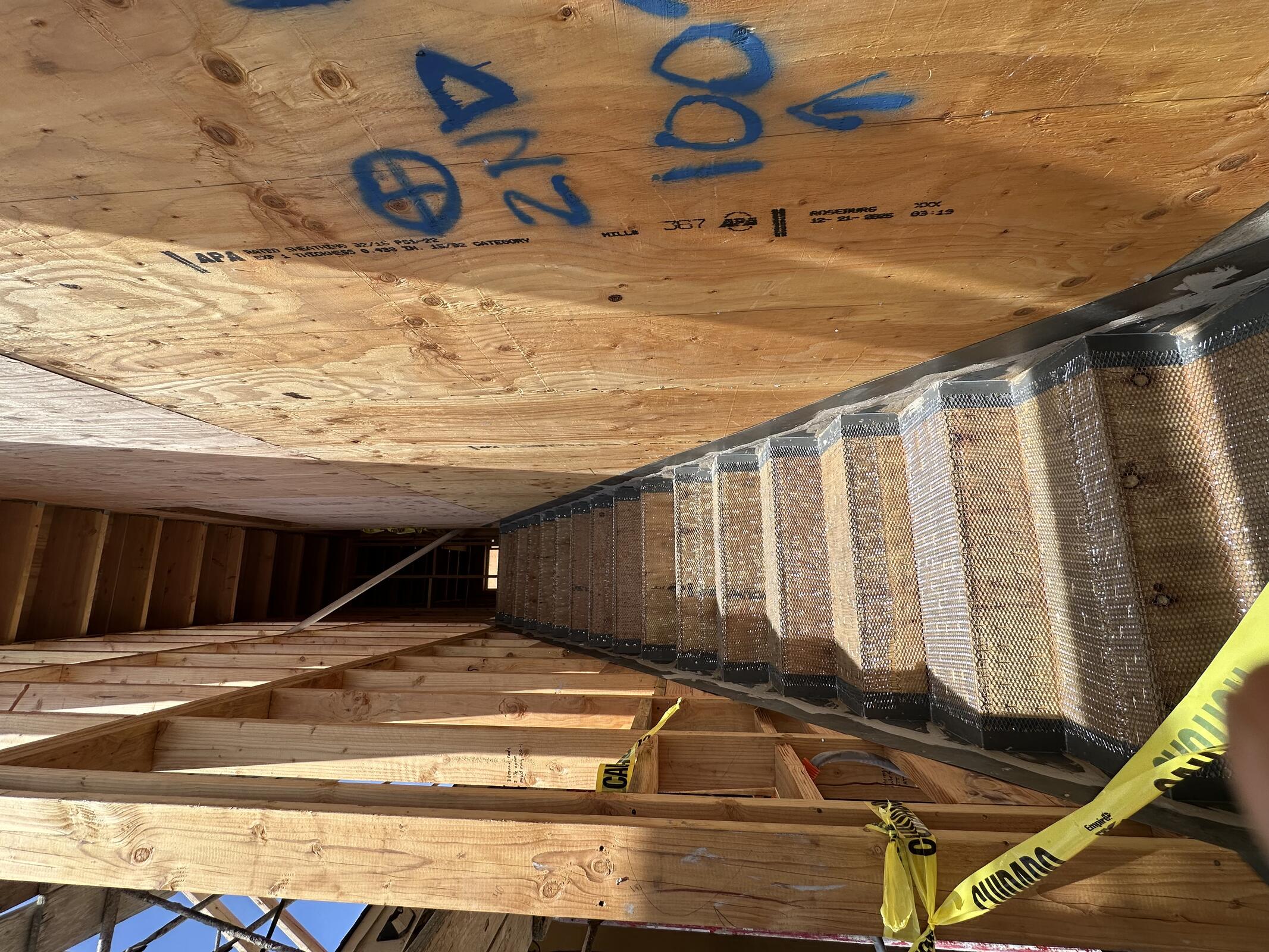

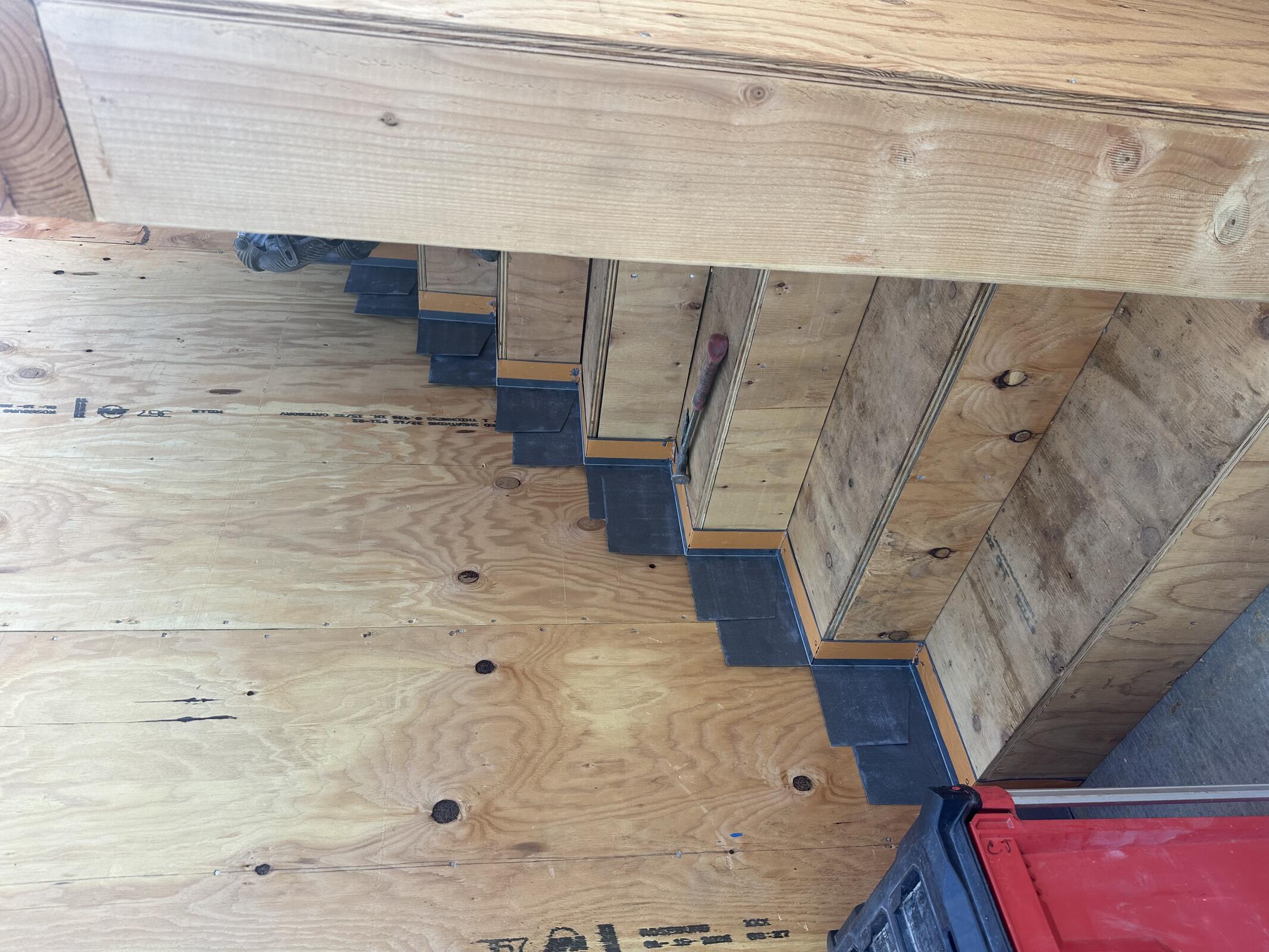

Rete's continuing to lath stairs at Building B. Pouring cementious material to slope stair landings at Building C.

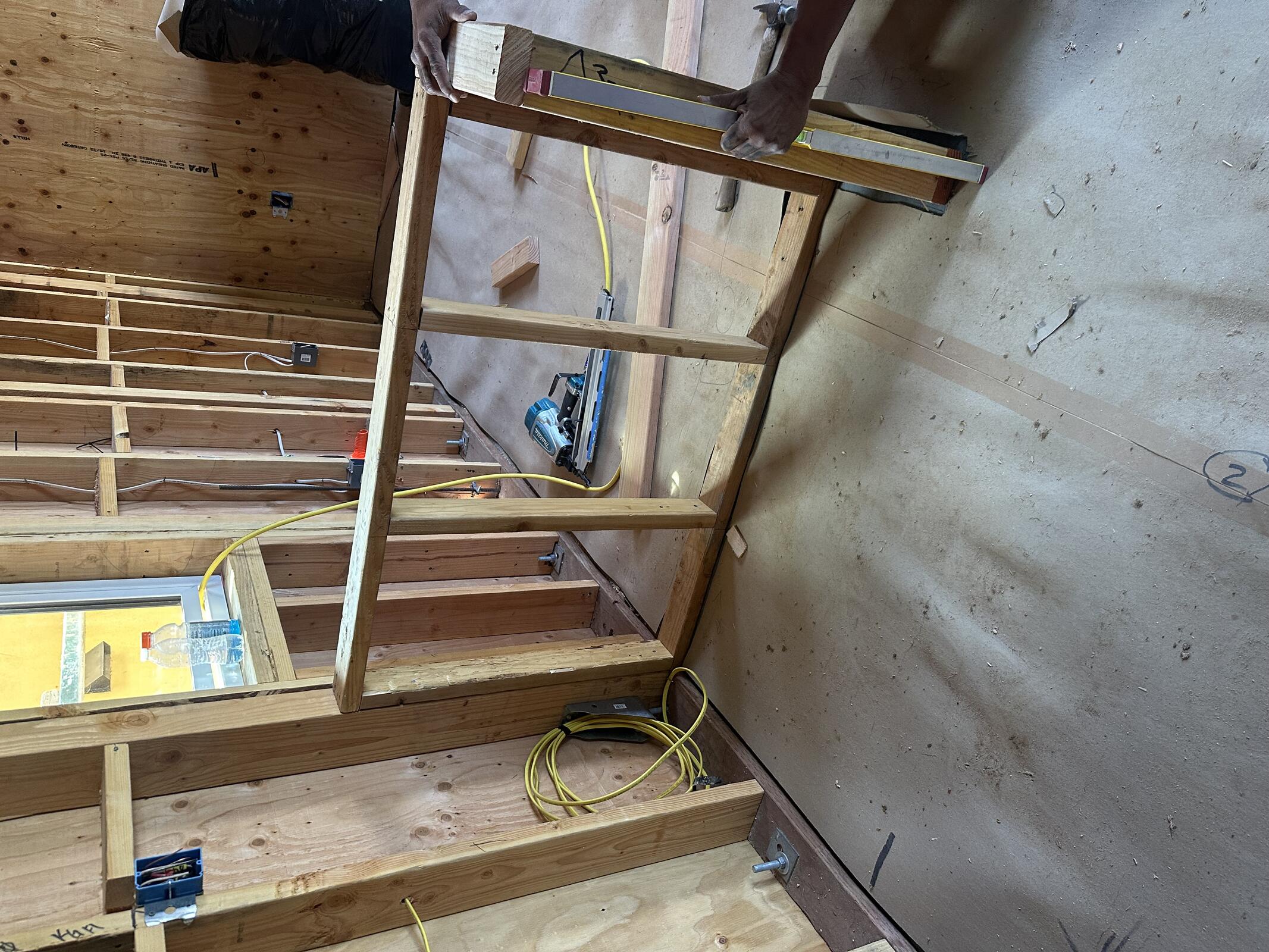

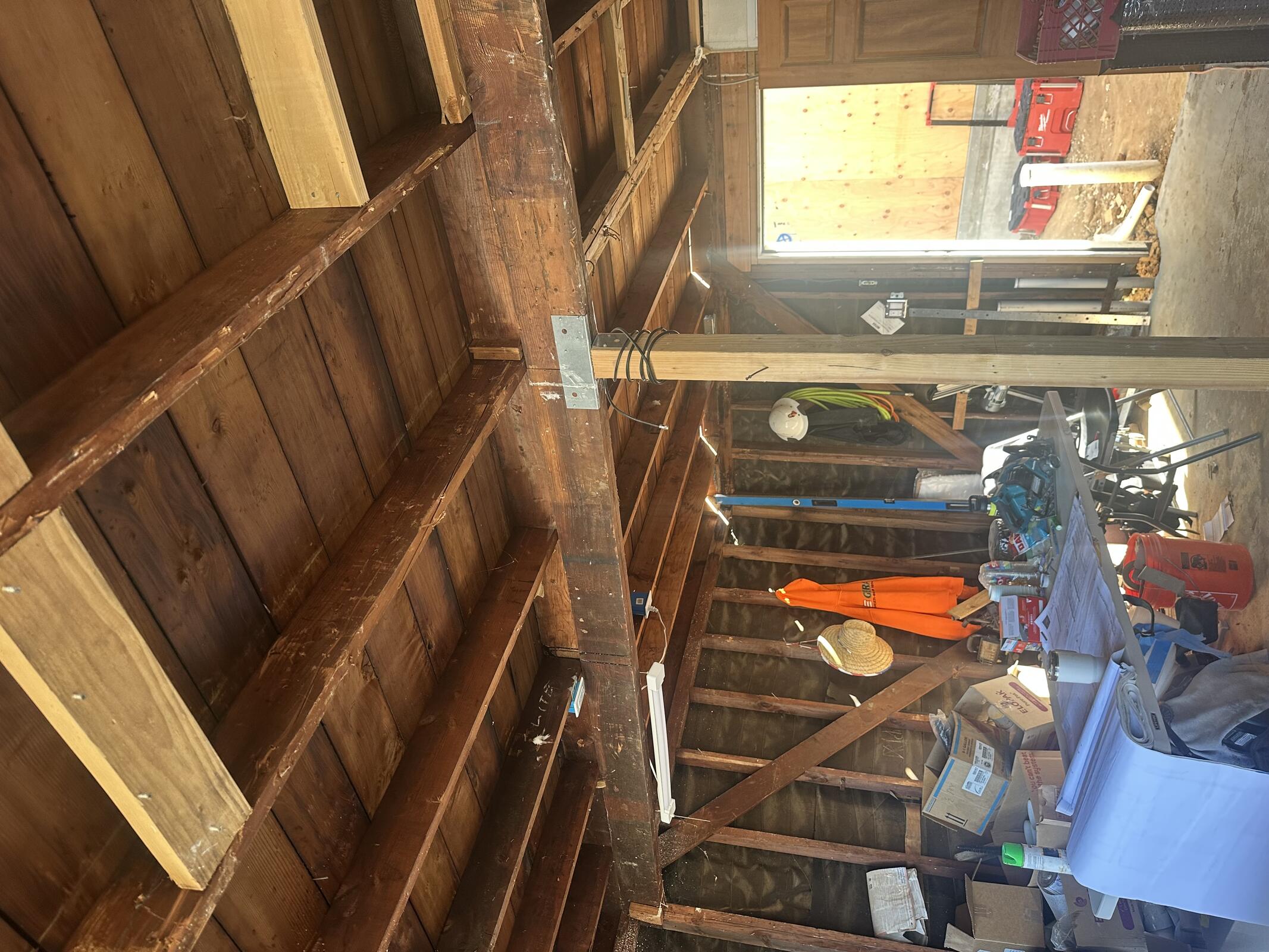

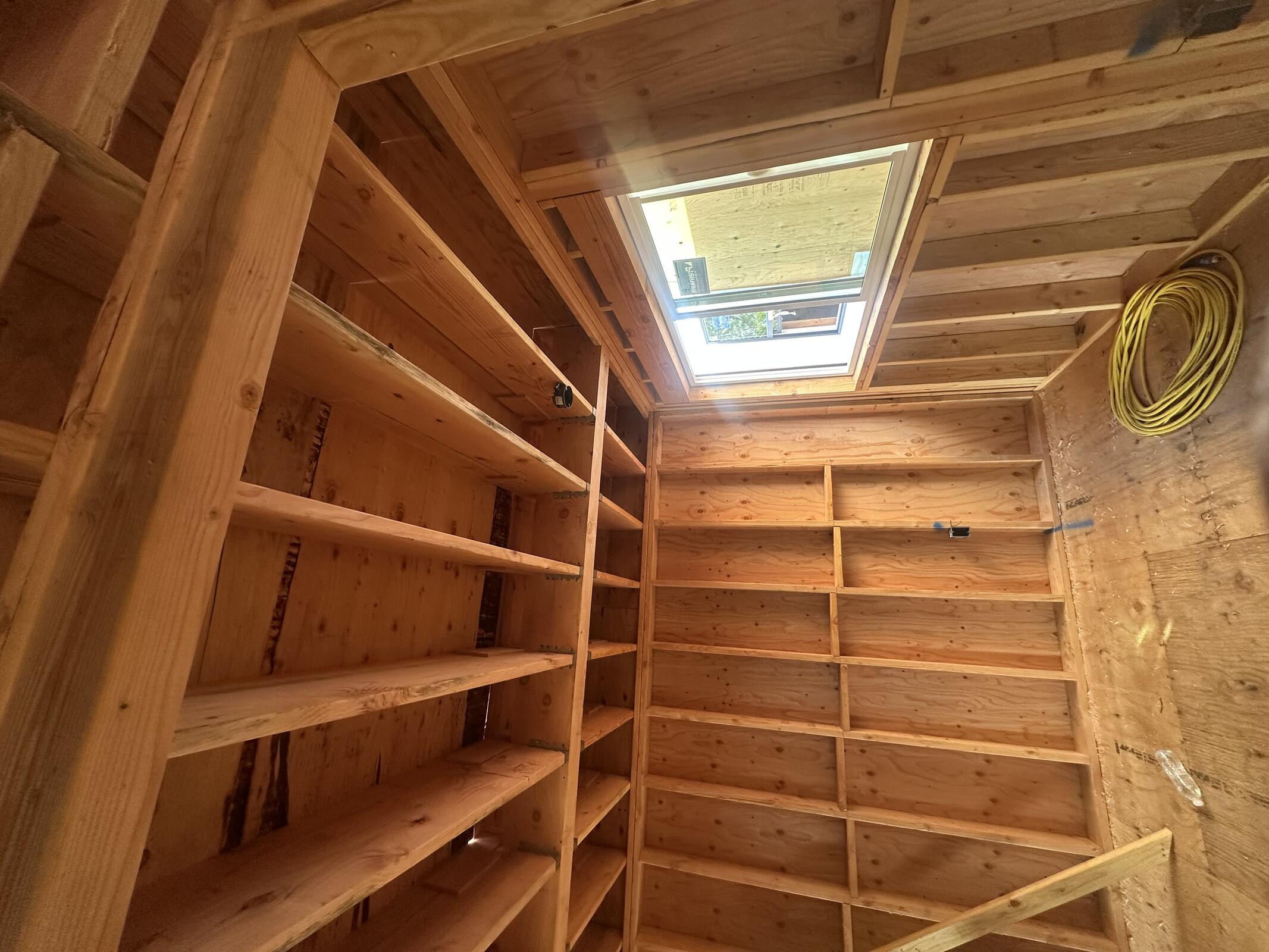

JB General contuninuing hardware pick-ups and blocking at Building B. Pony walls for penninsulas going in at Building C. Garage layout in progress. Informal RFI submitted to 1070 regarding existing conditions. See attachment.

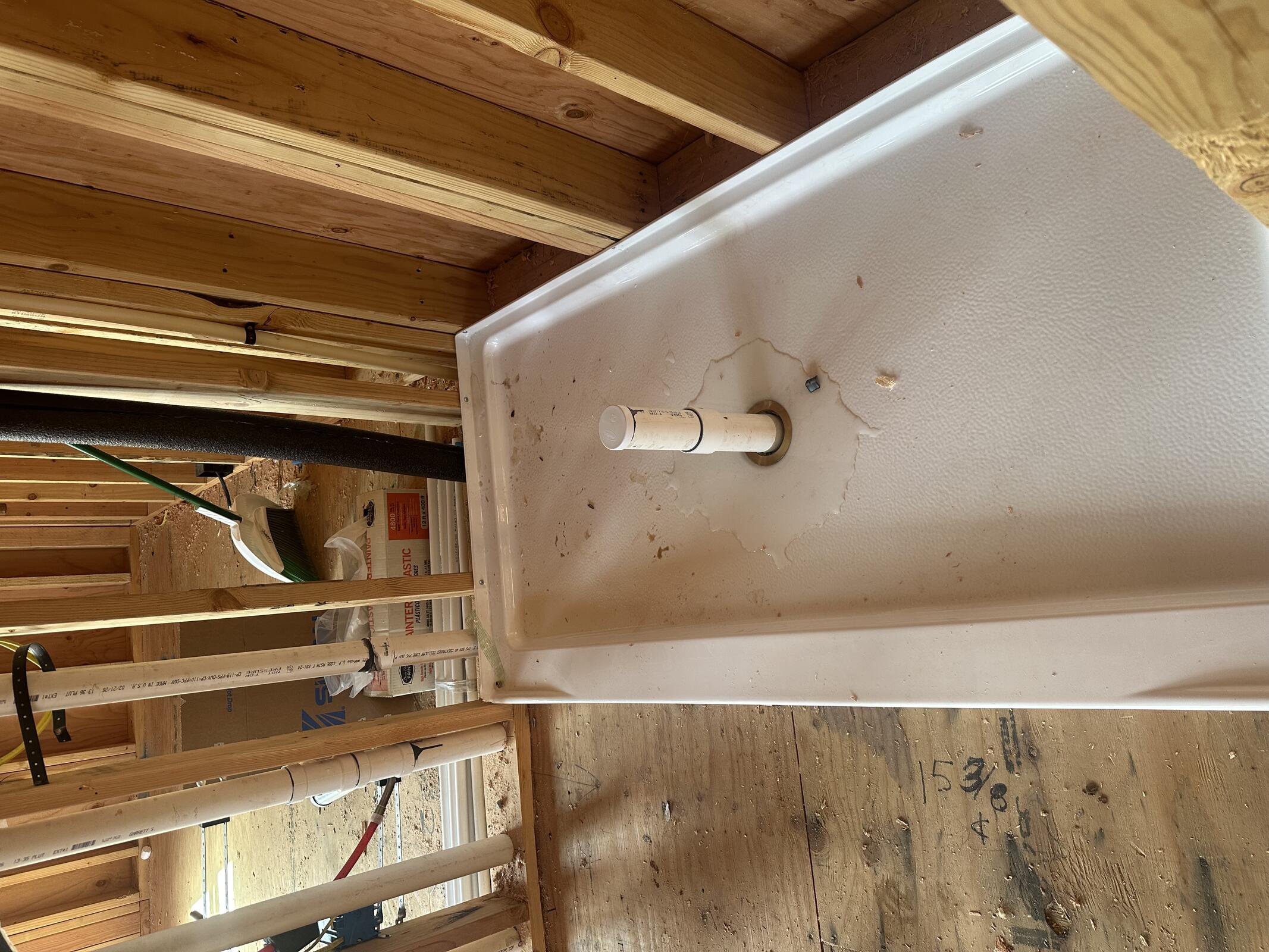

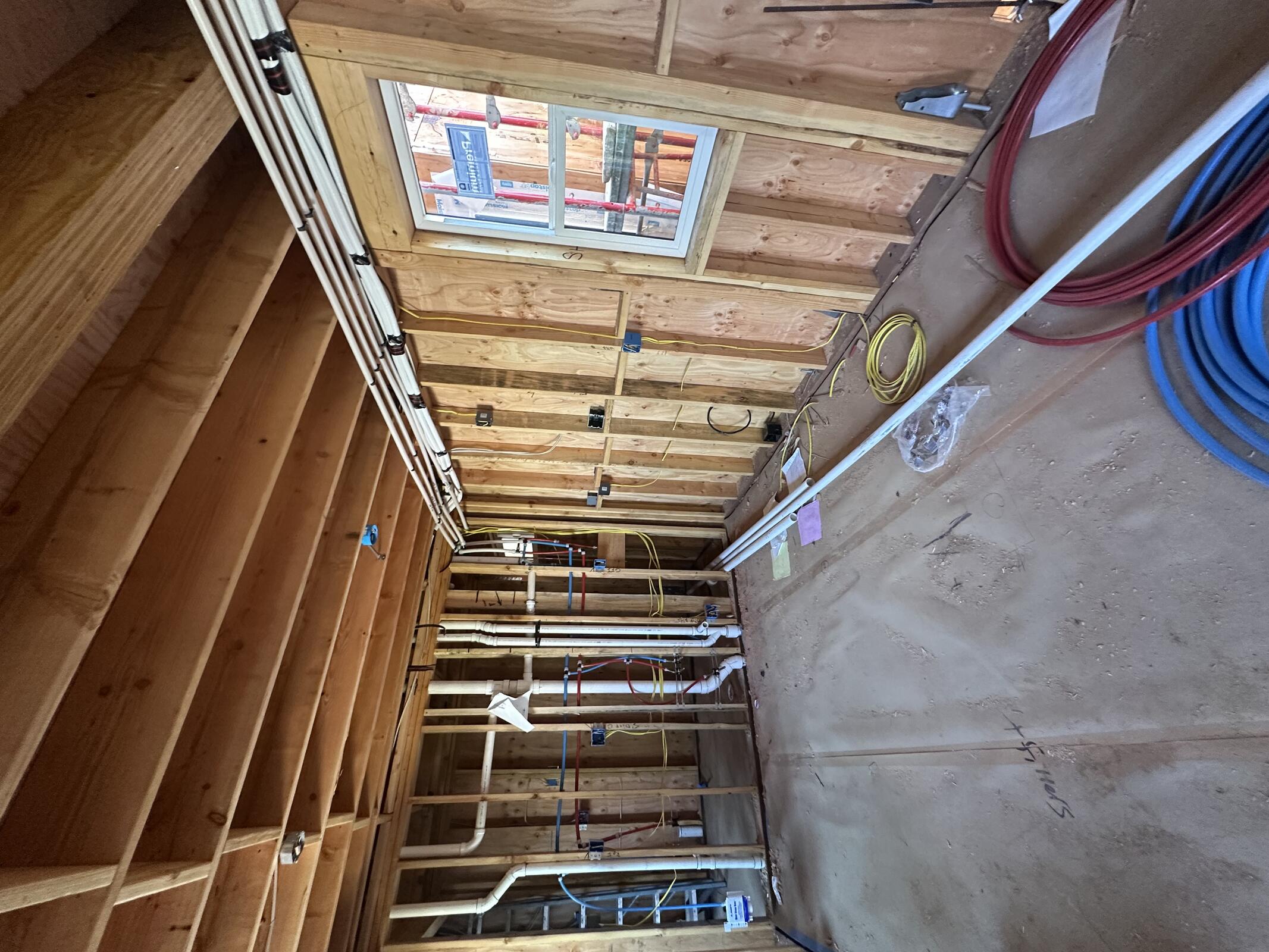

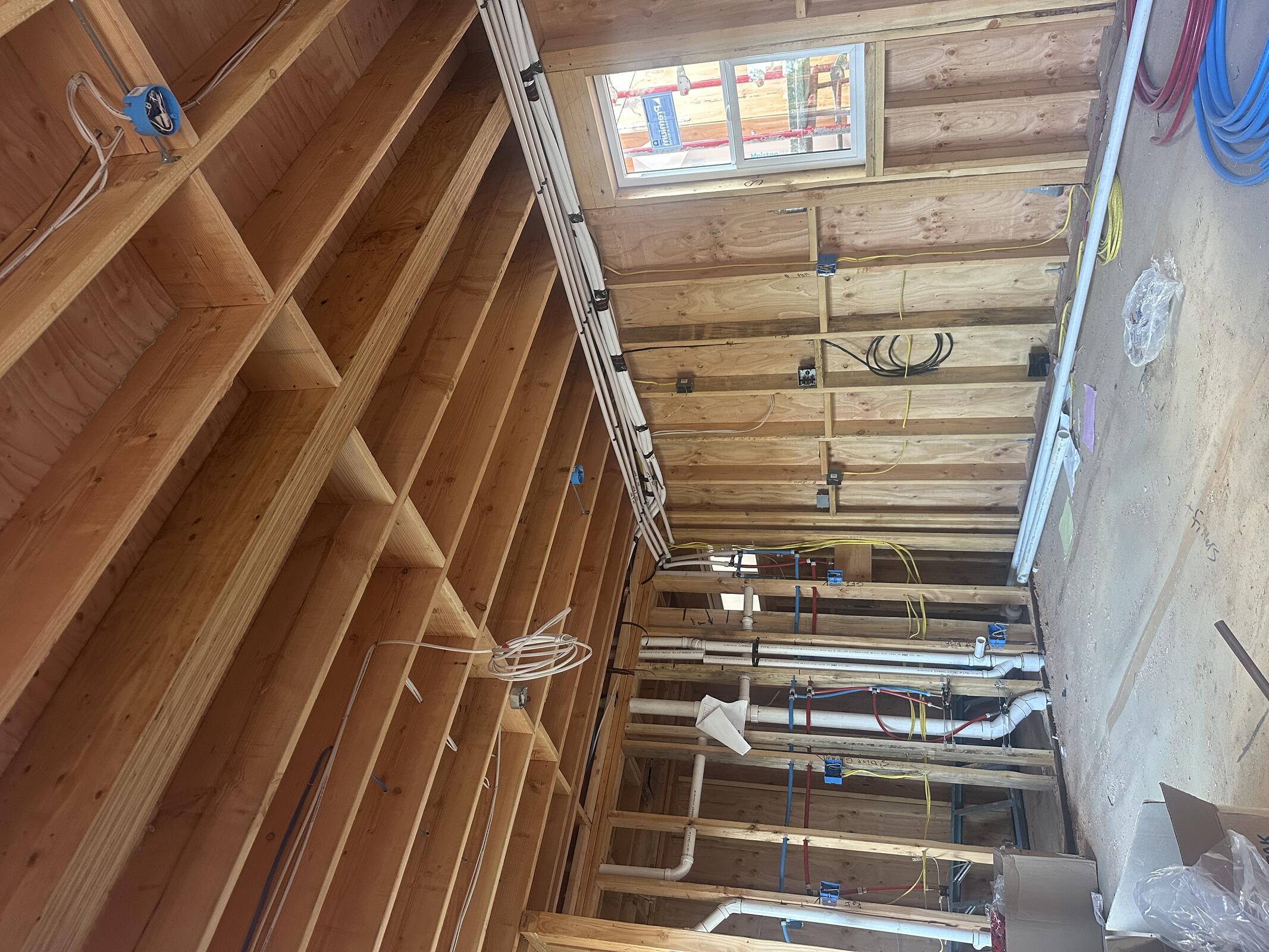

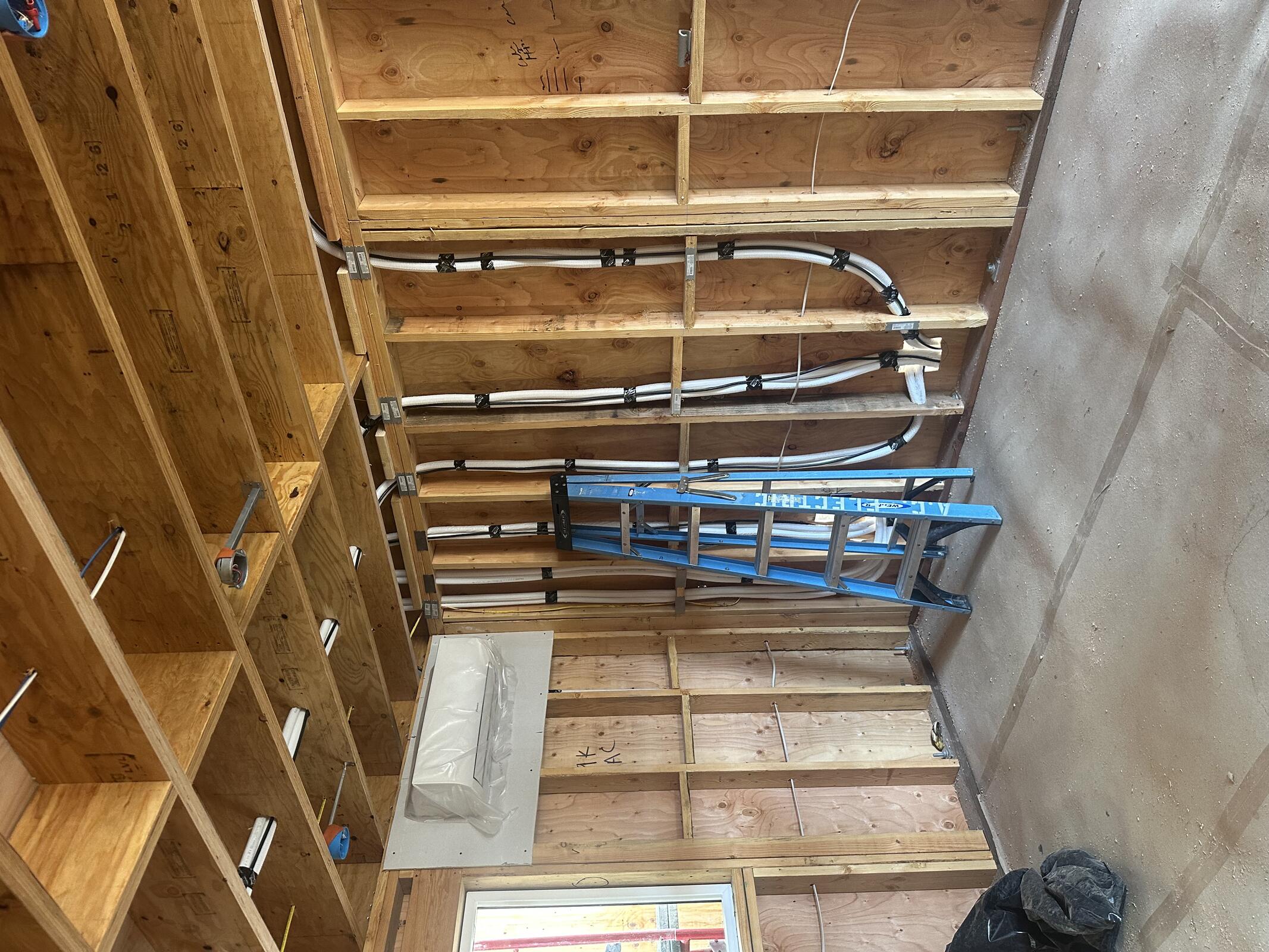

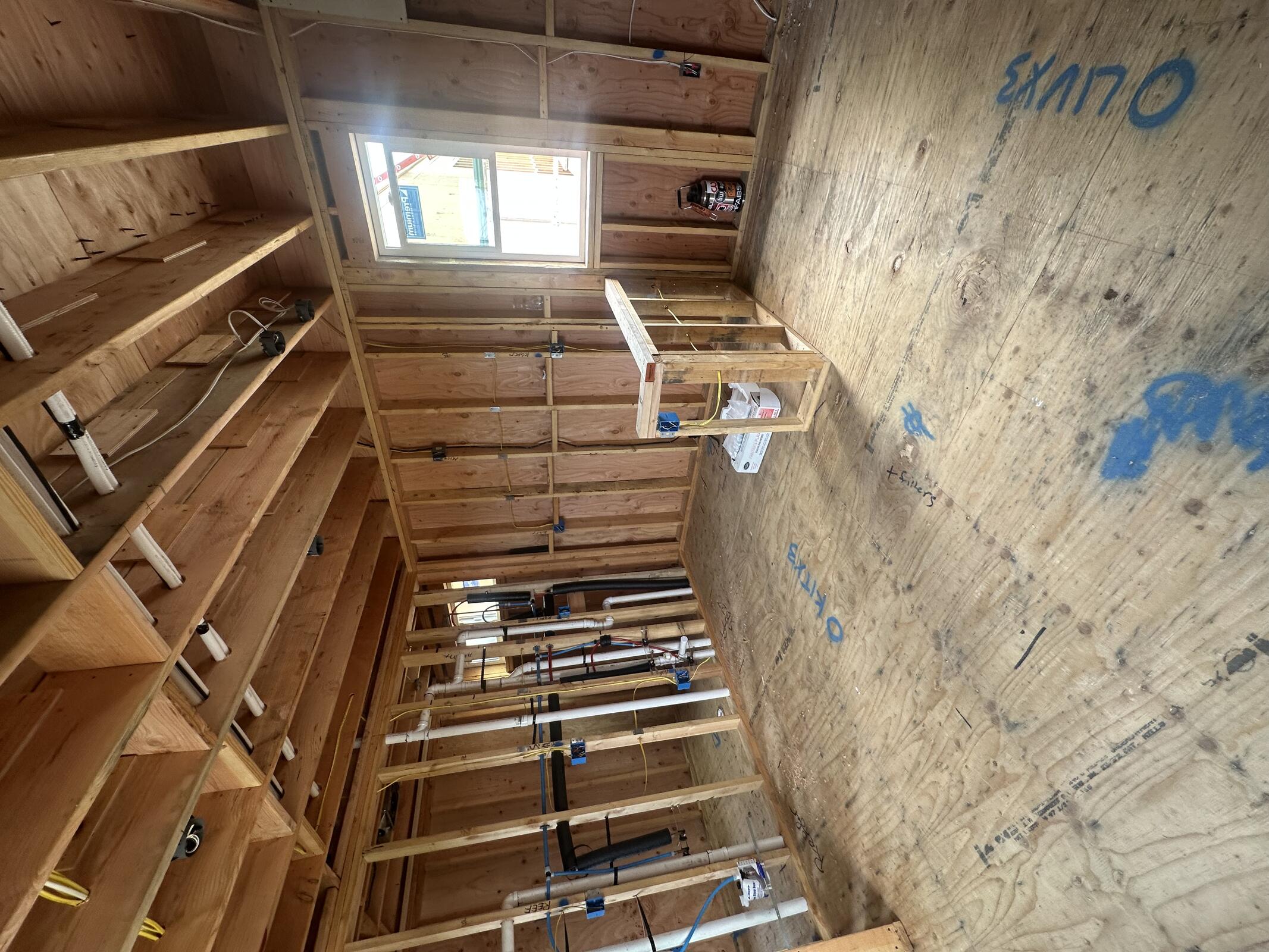

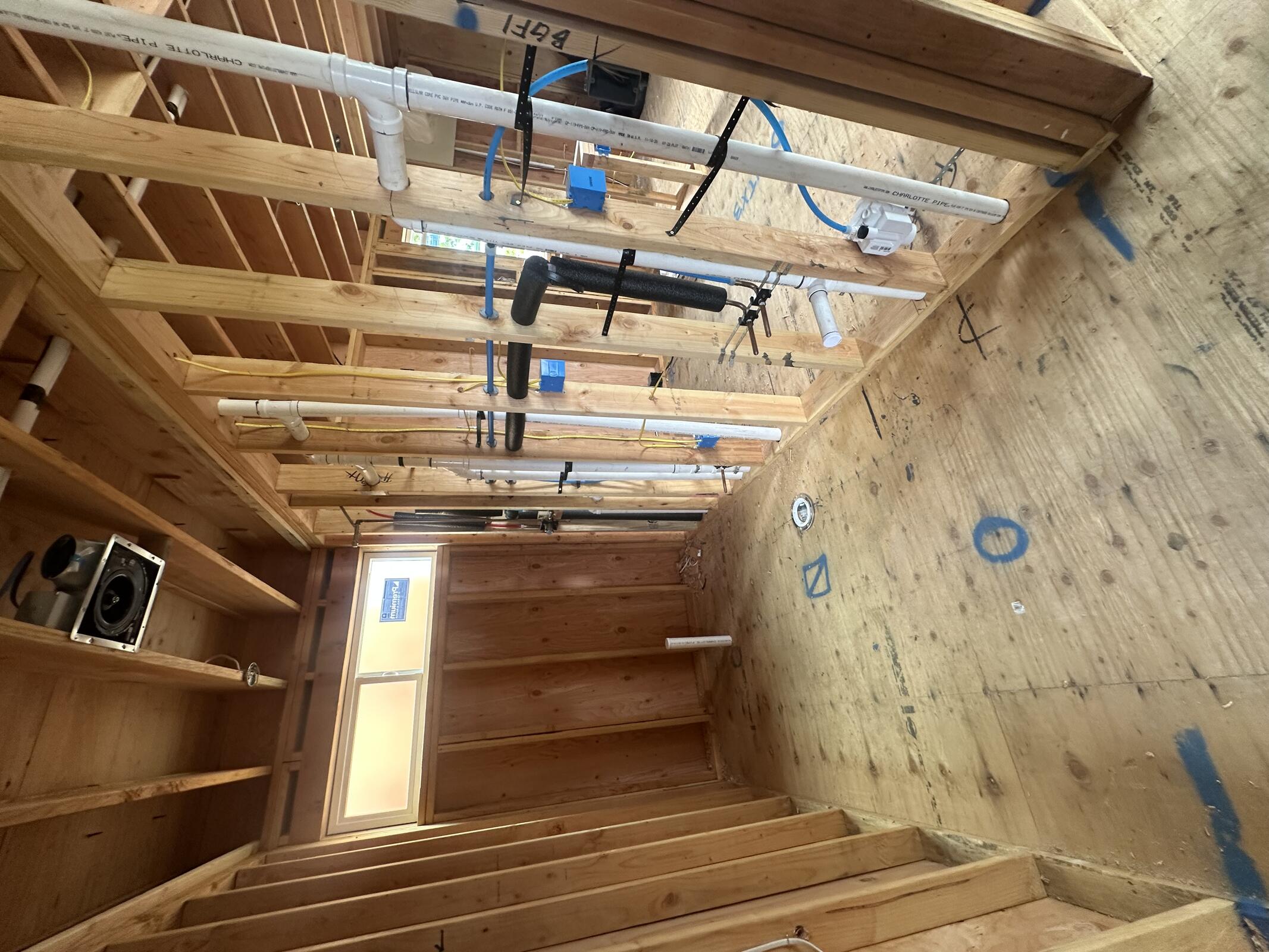

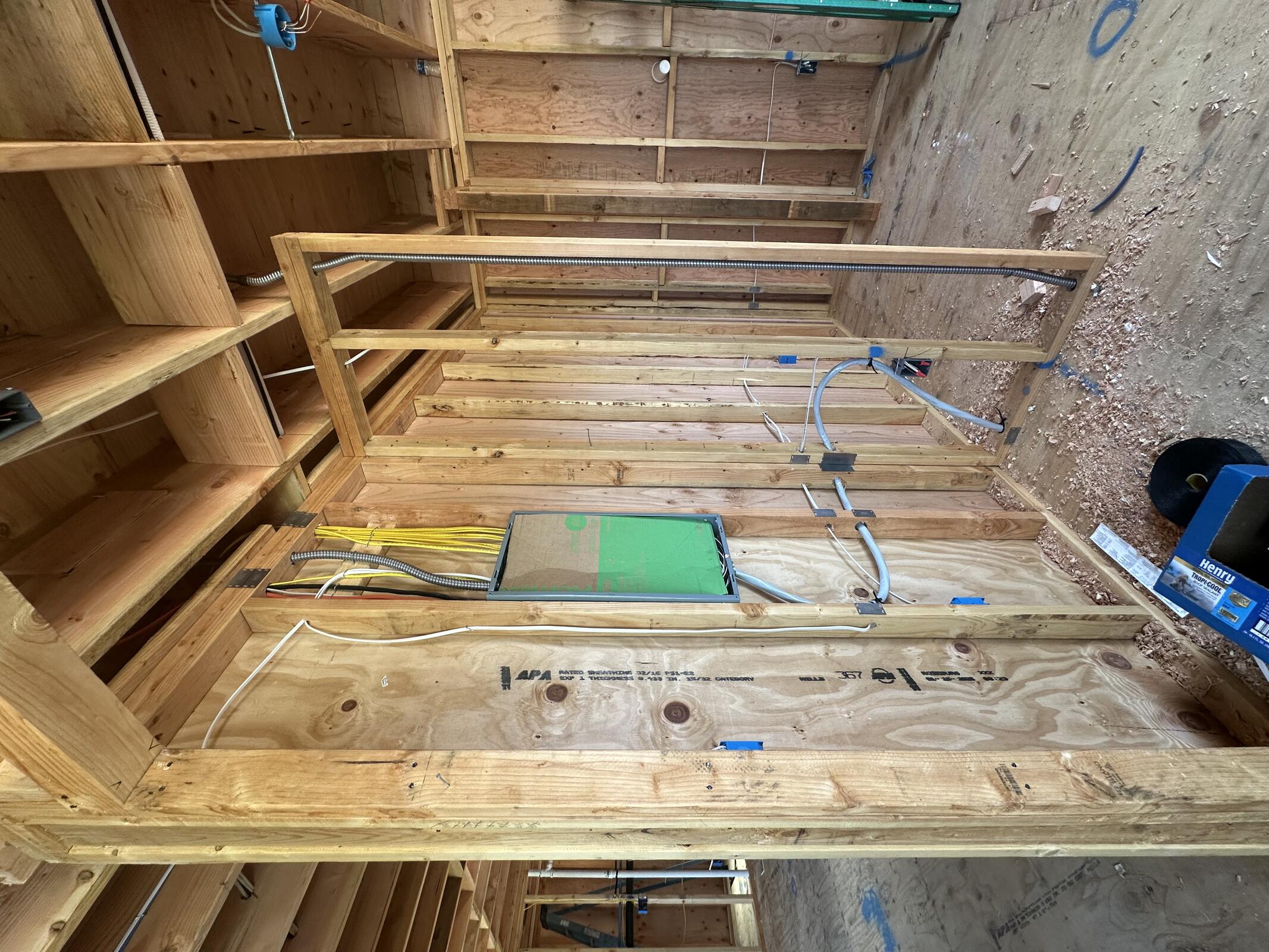

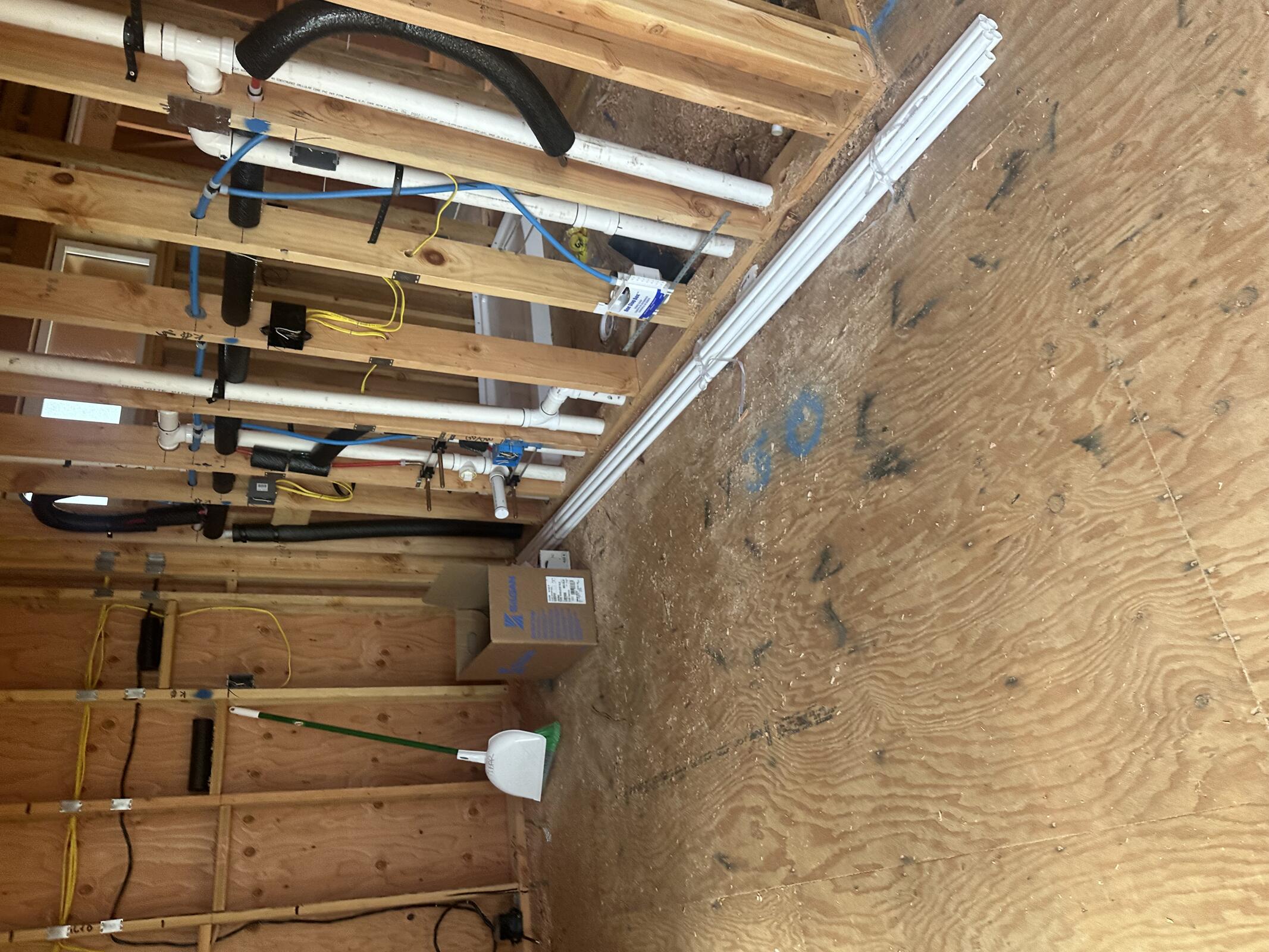

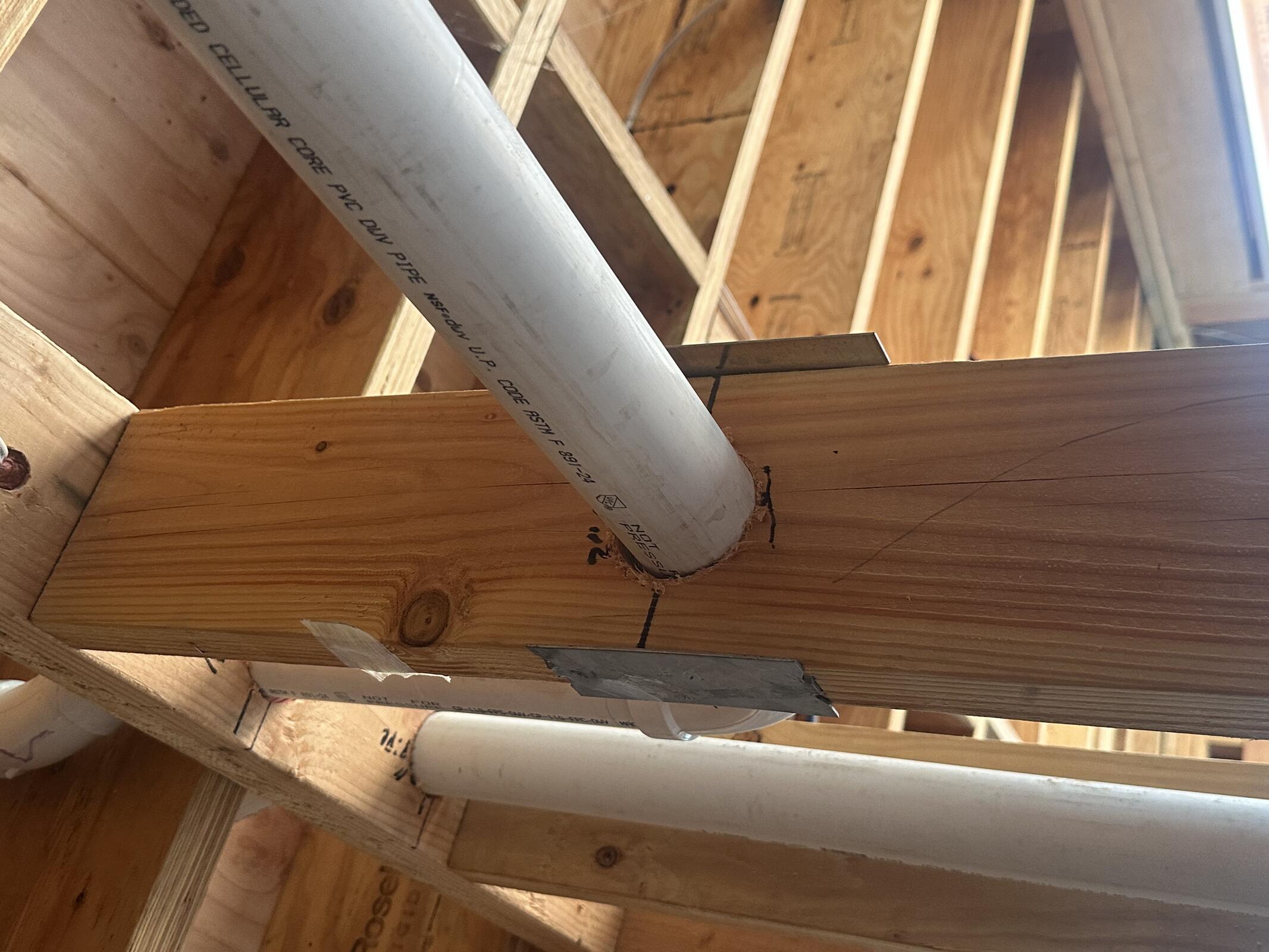

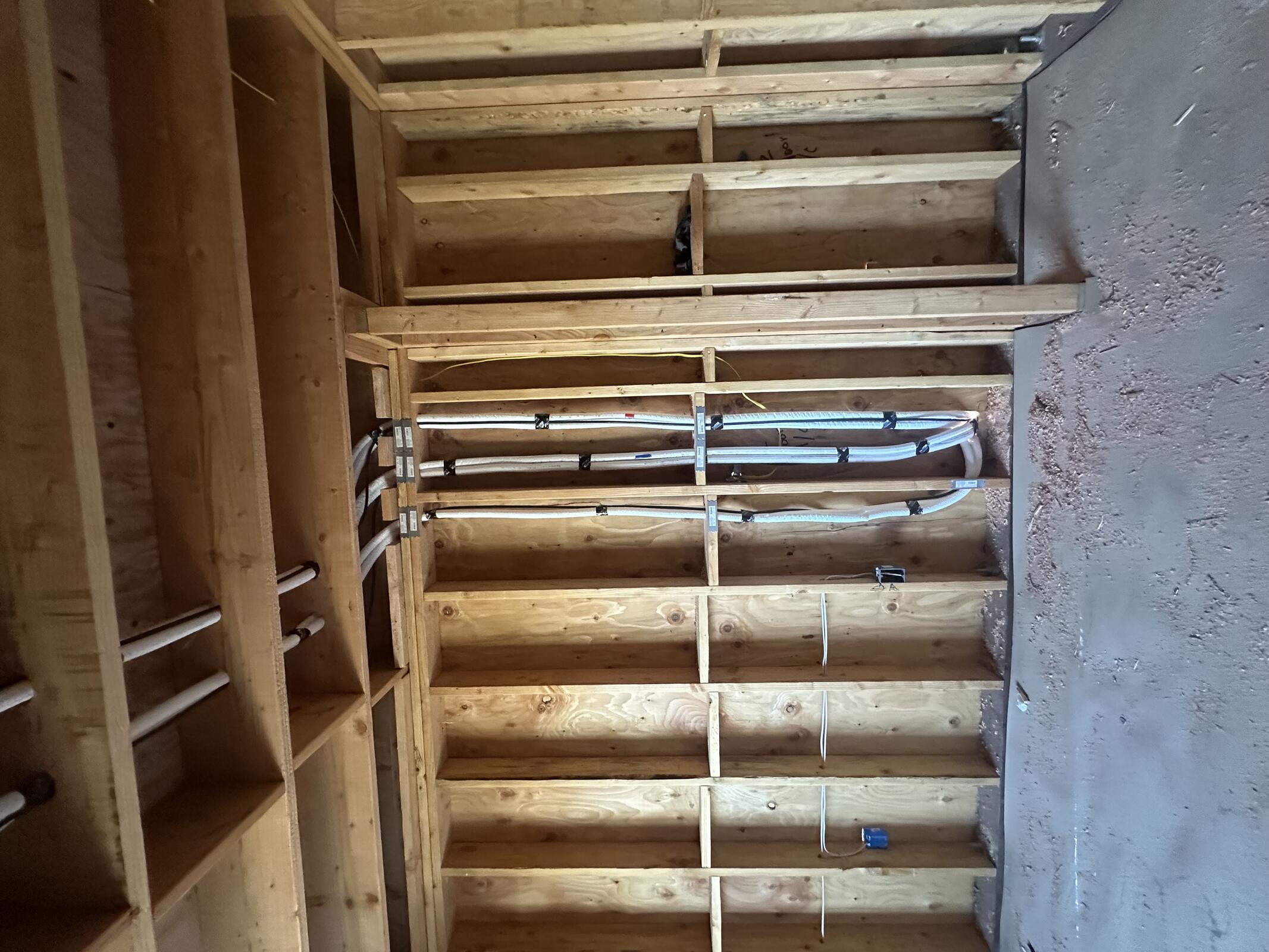

Zack Smith Plumbing and AC Electric continuing rough-in at B and C. ZSP starting layout at D.
General site clean up and trash haul off in progress.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| ACCI | 4 | 8 | 32 |
| Rete's | 3 | 8 | 24 |
| ZSP | 4 | 8 | 32 |
| JB General | 5 | 8 | 40 |
| AC Electric | 2 | 8 | 16 |
Inspection: N/A













Thursday, April 30, 2026
Partially cloudy, 68°F

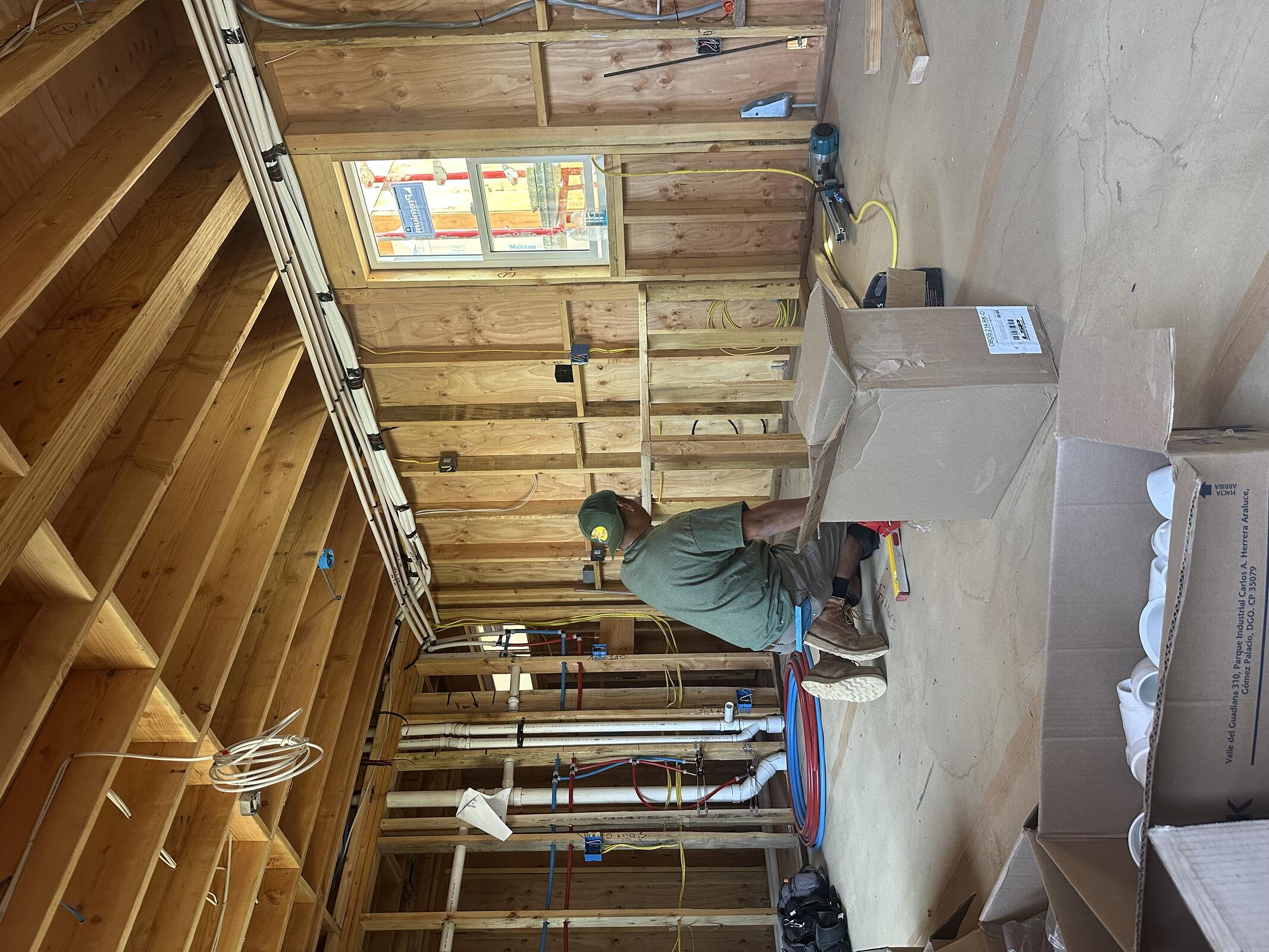

Zack Smith Plumbing and AC Electric prepping for inspection.
Taylor Trim installing remaining exterior door frames and pocket door frames.

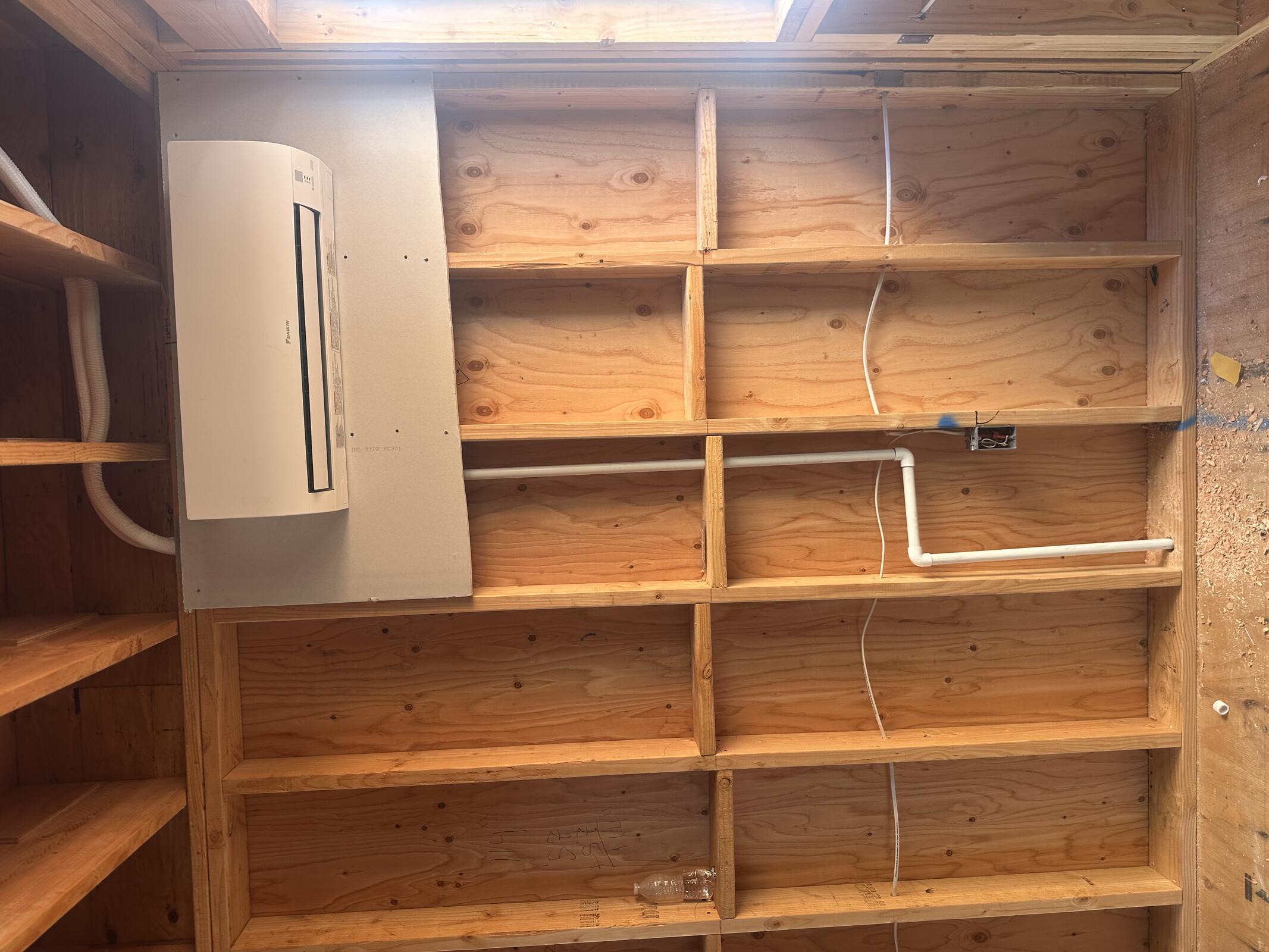

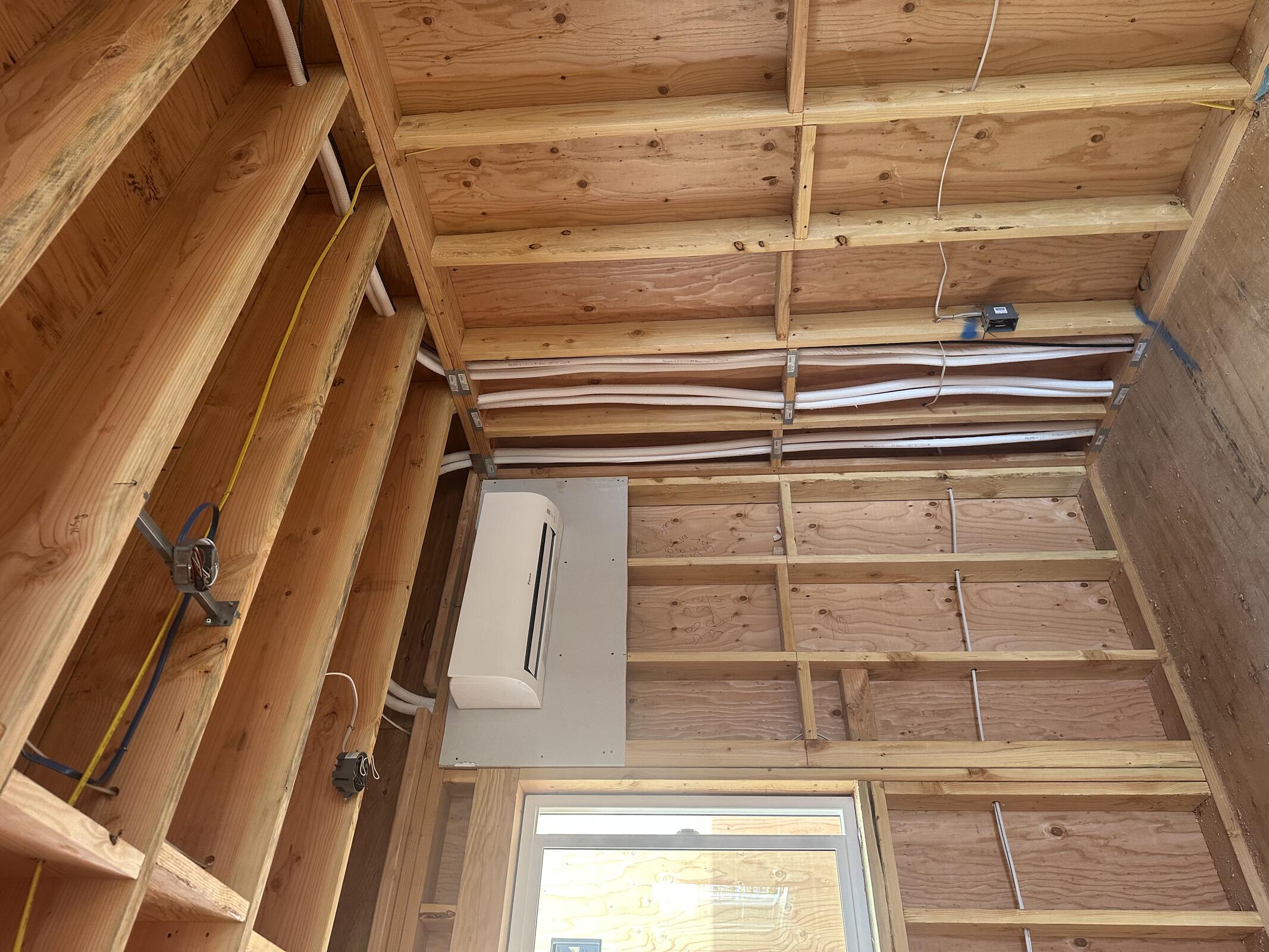

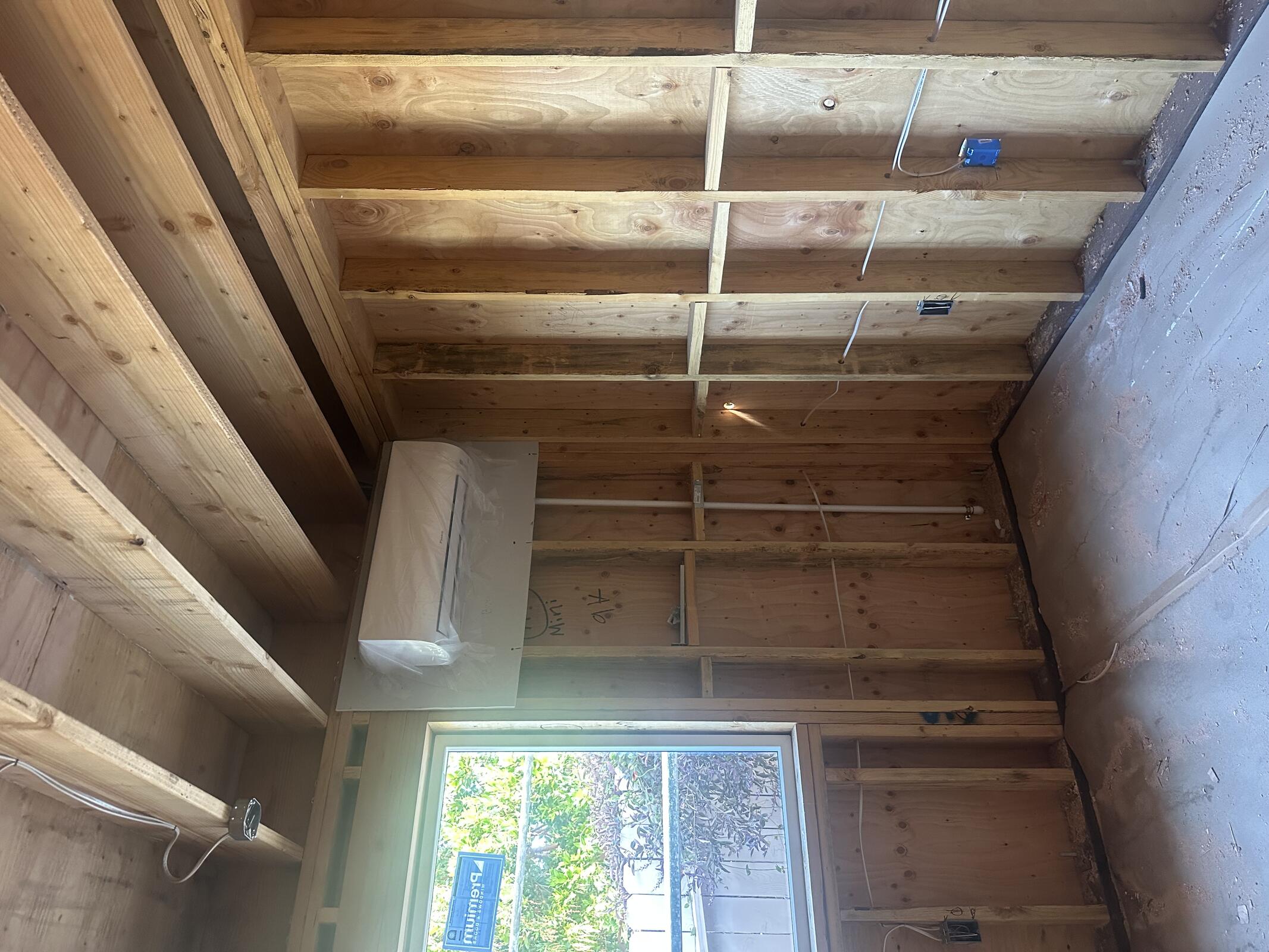

Clear HVAC installing second floor units at Building B.

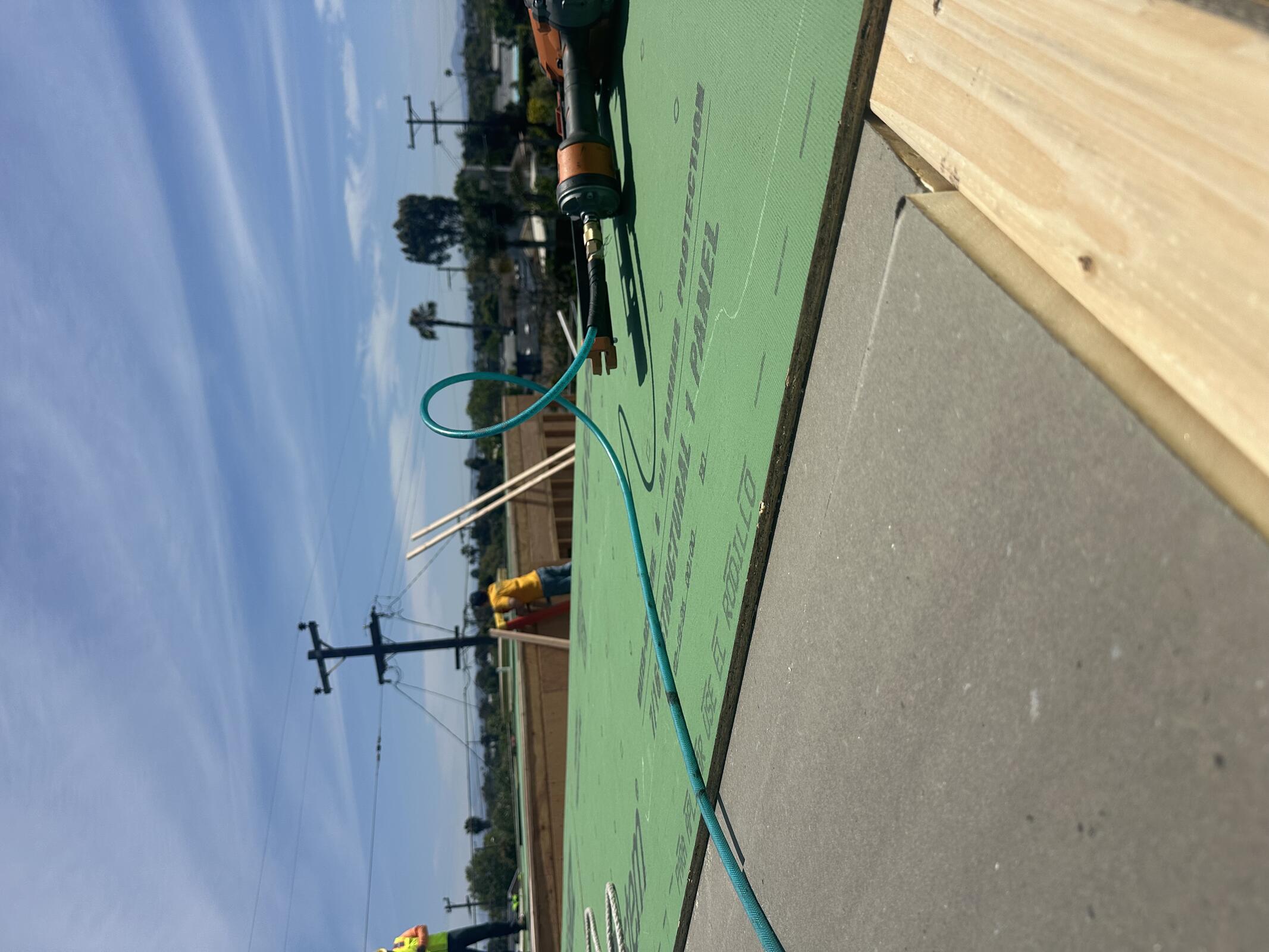

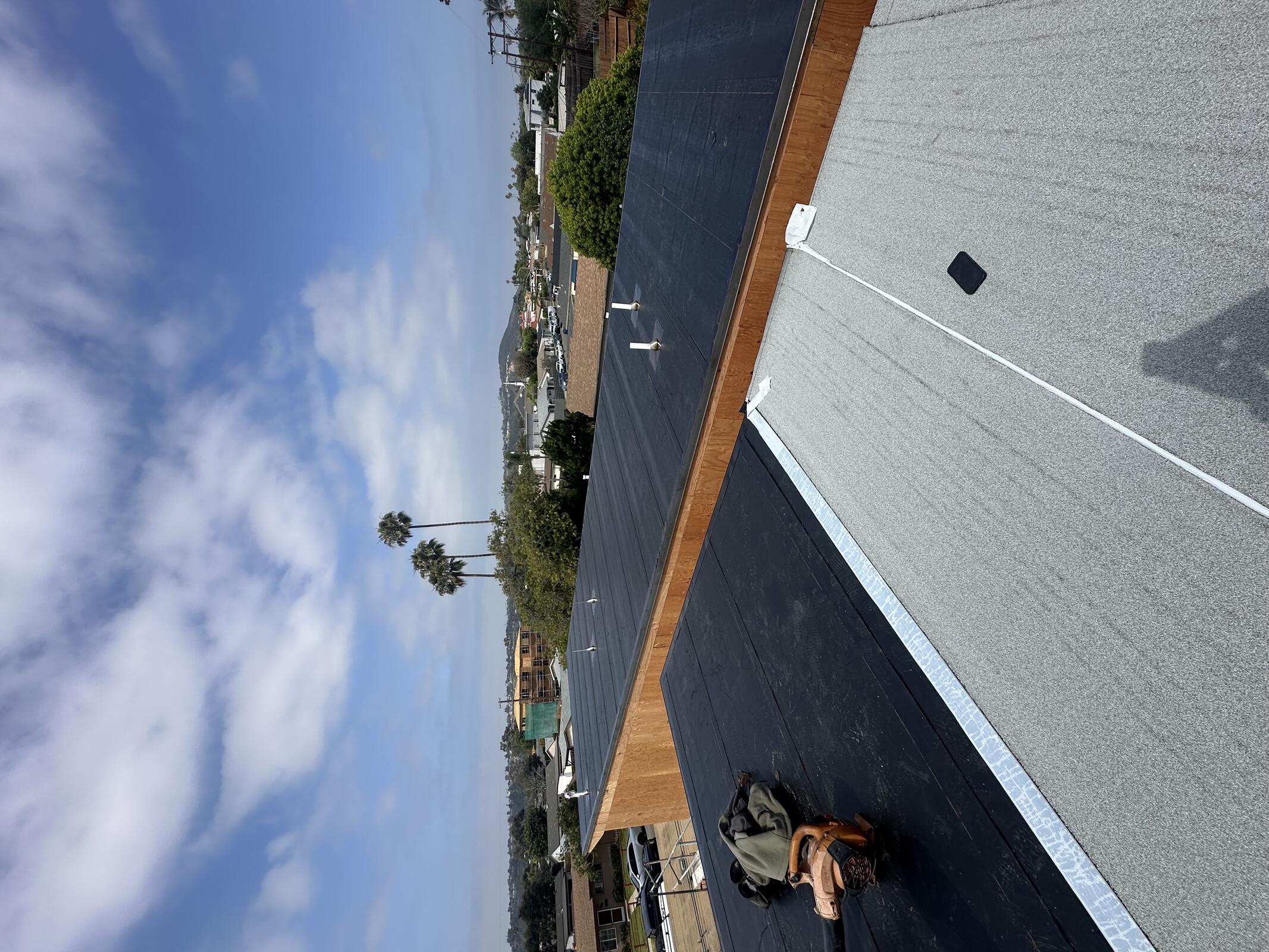

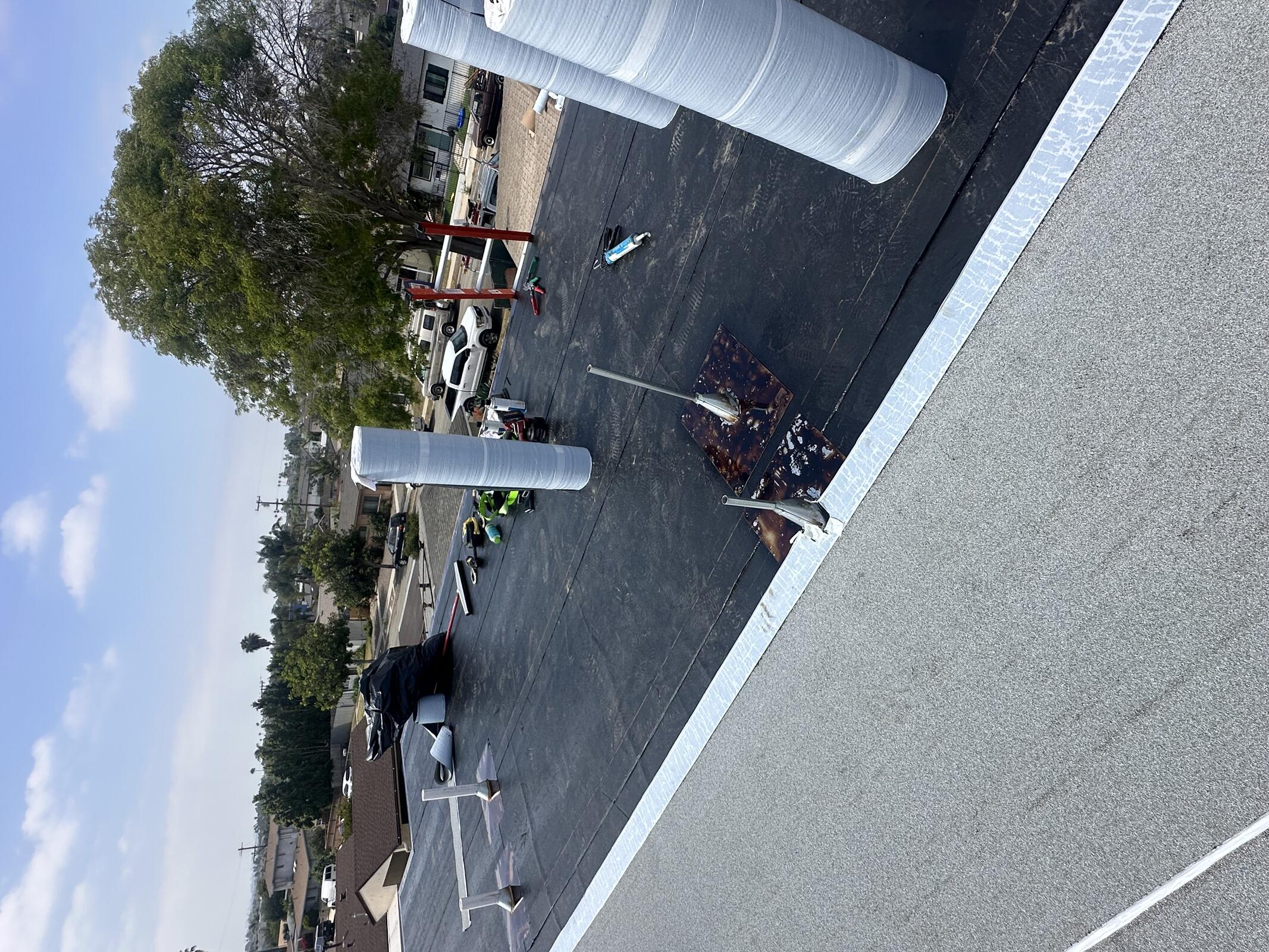

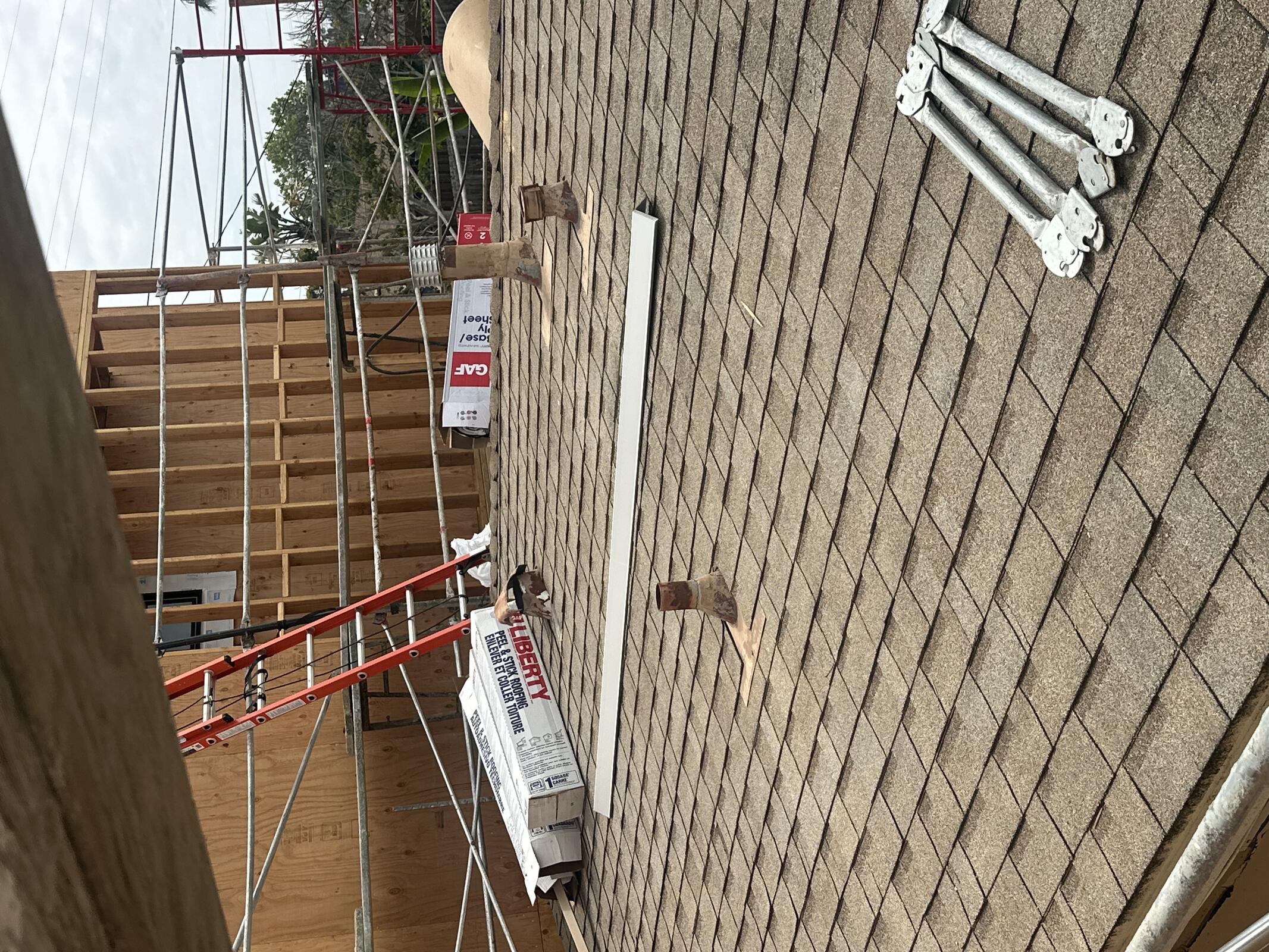

ACCI installing GAF Liberty SBS Self-Adhering Roofing System and bonderized drip edge.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| AC Electric | 2 | 8 | 16 |
| ZSP | 3 | 8 | 24 |
| ACCI | 4 | 8 | 32 |
| Clear HVAC | 4 | 8 | 32 |
Inspection: N/A
Delay: Work on garage paused until RFI repsonse received.











Friday, May 01, 2026
Clear, 70°F

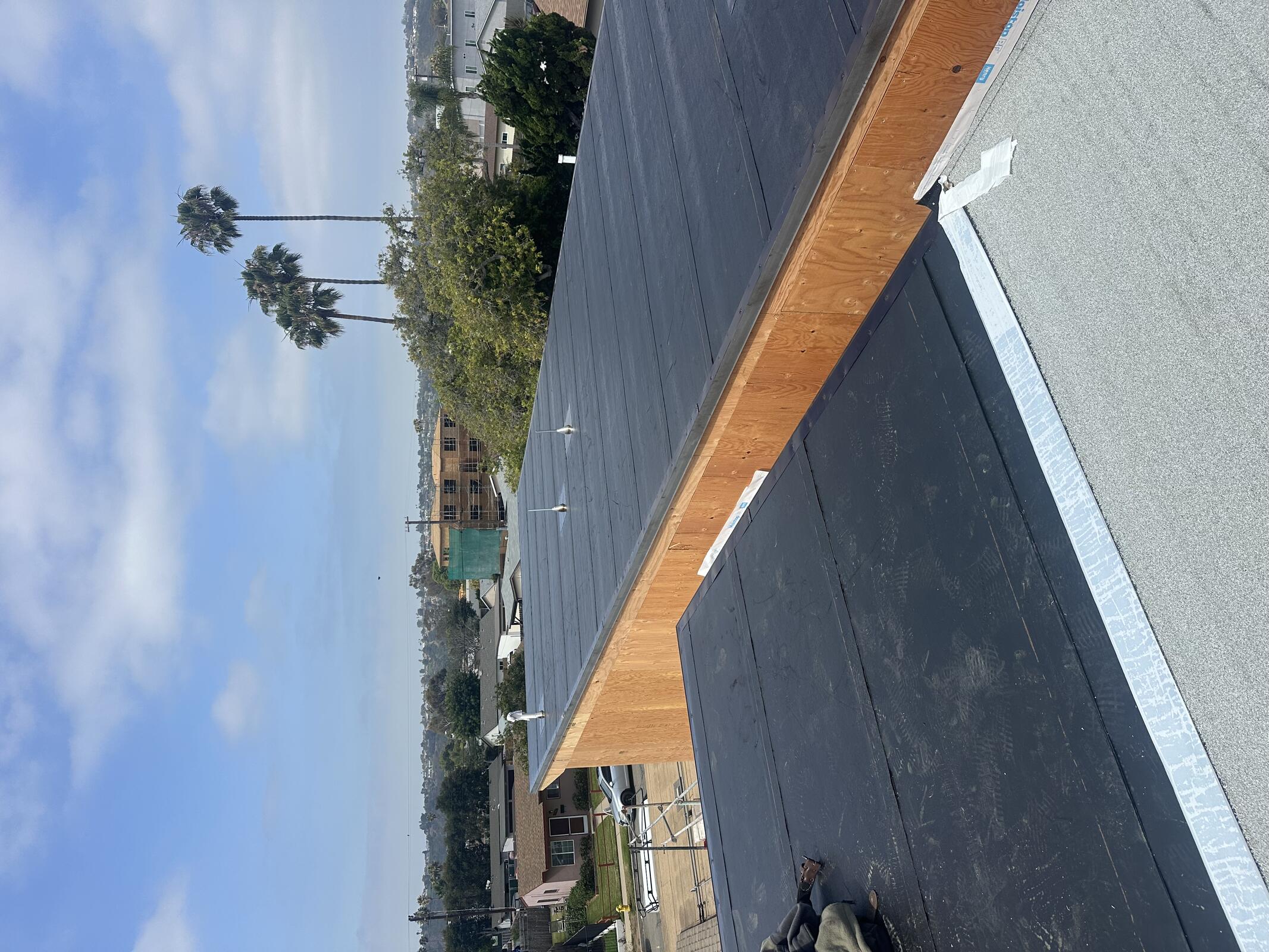

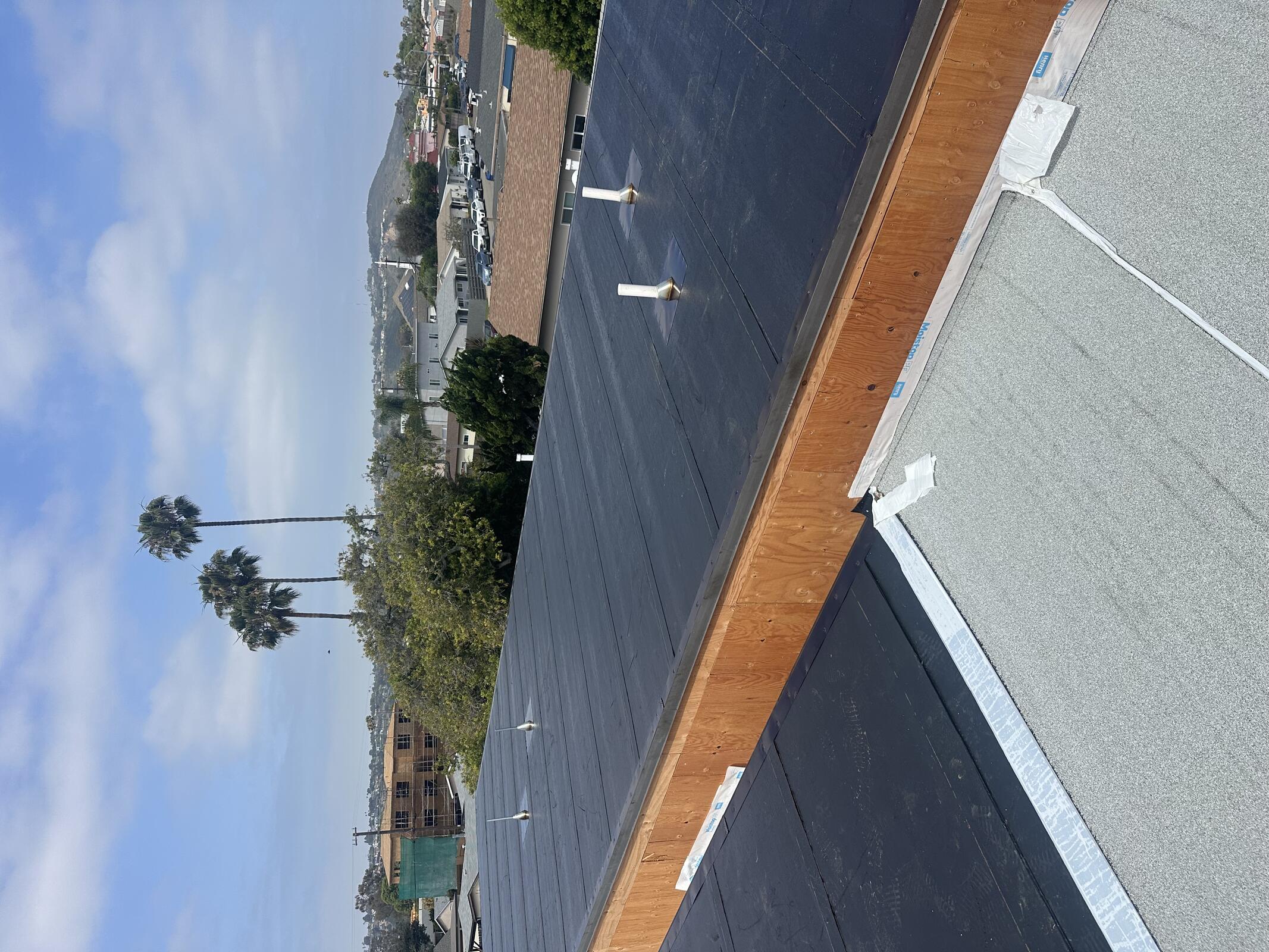

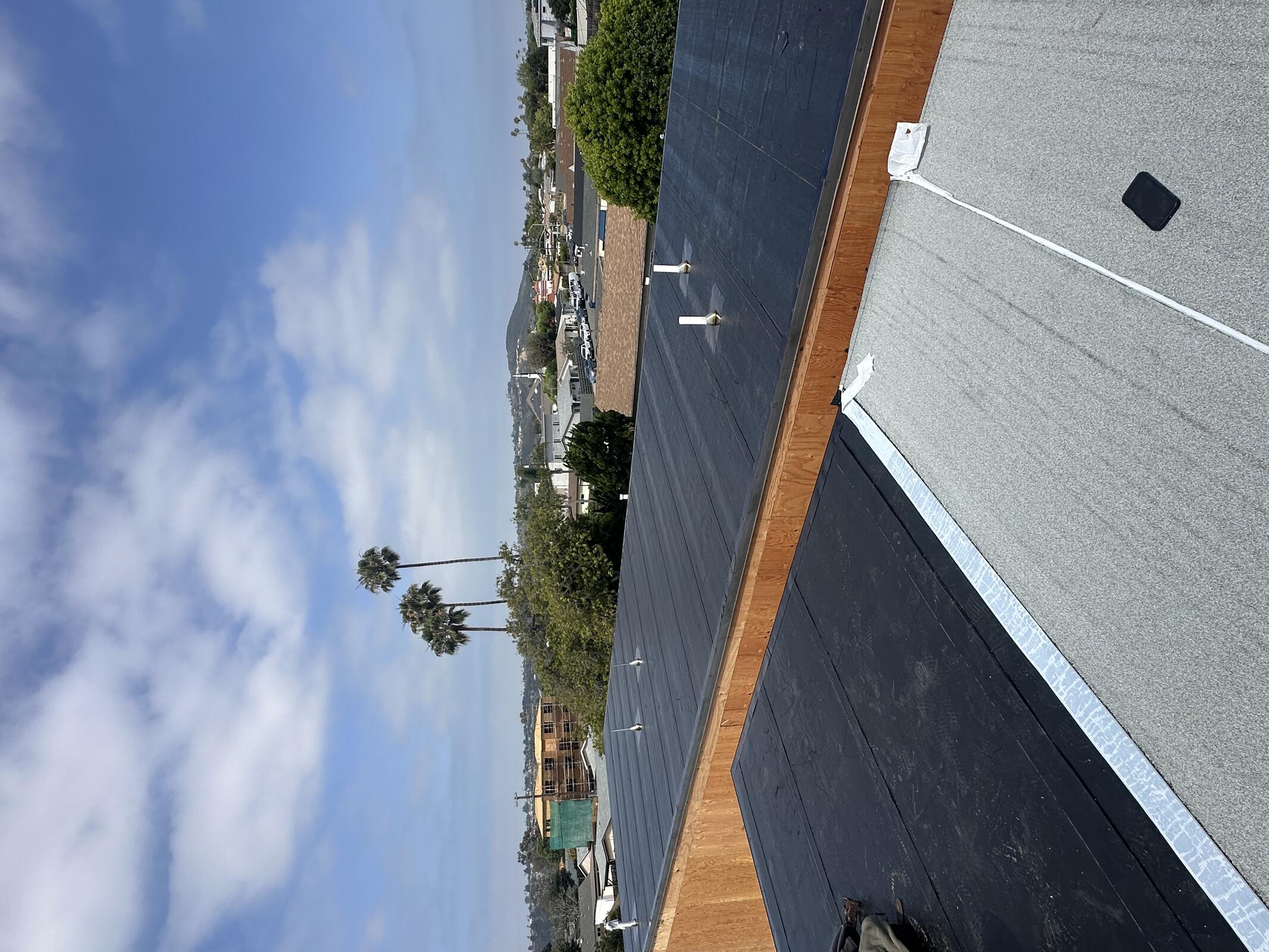

ACCI on site, finishing roofing at Structure B and C.
Clear HVAC installing ducts for fart fans.

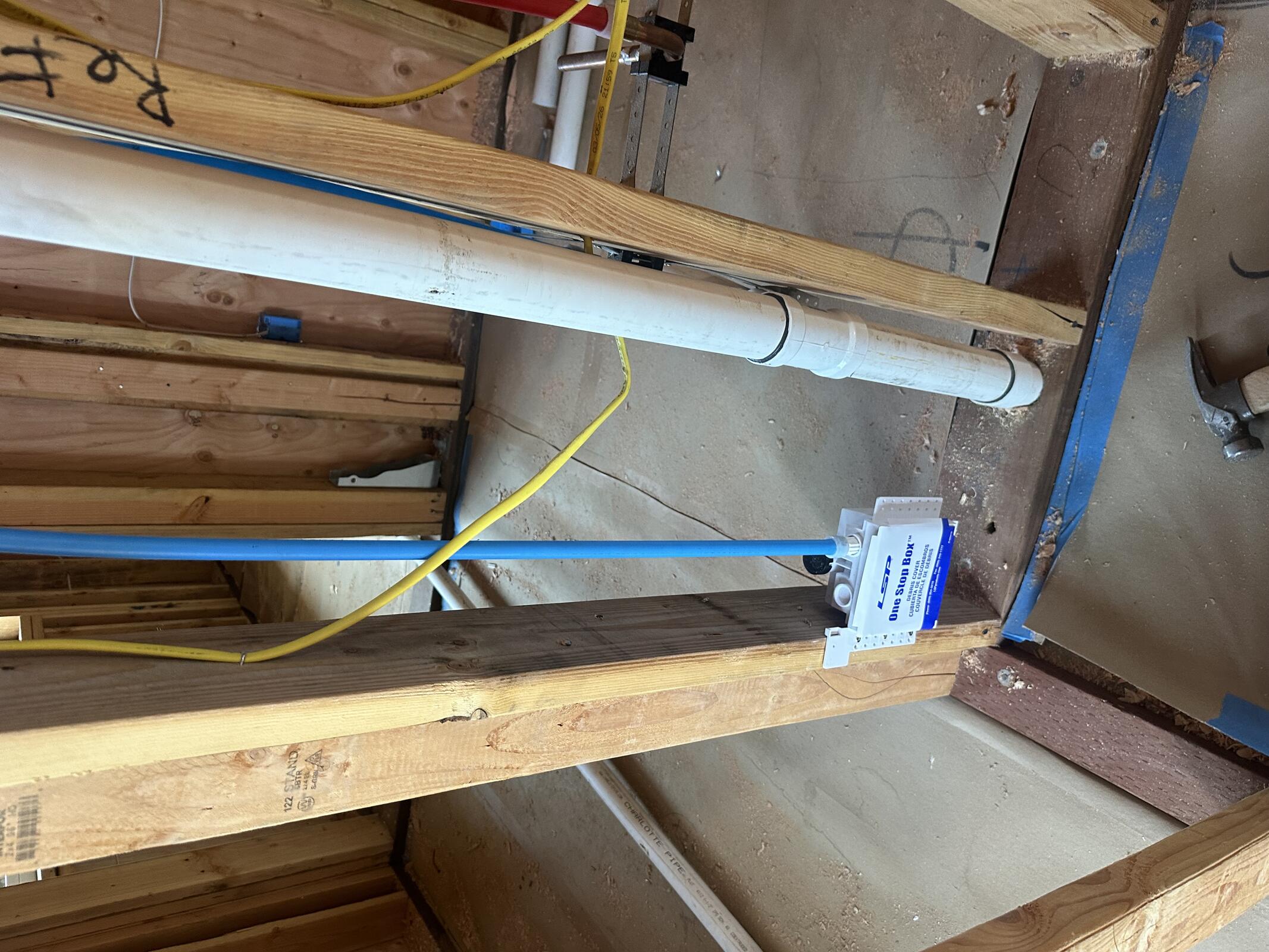

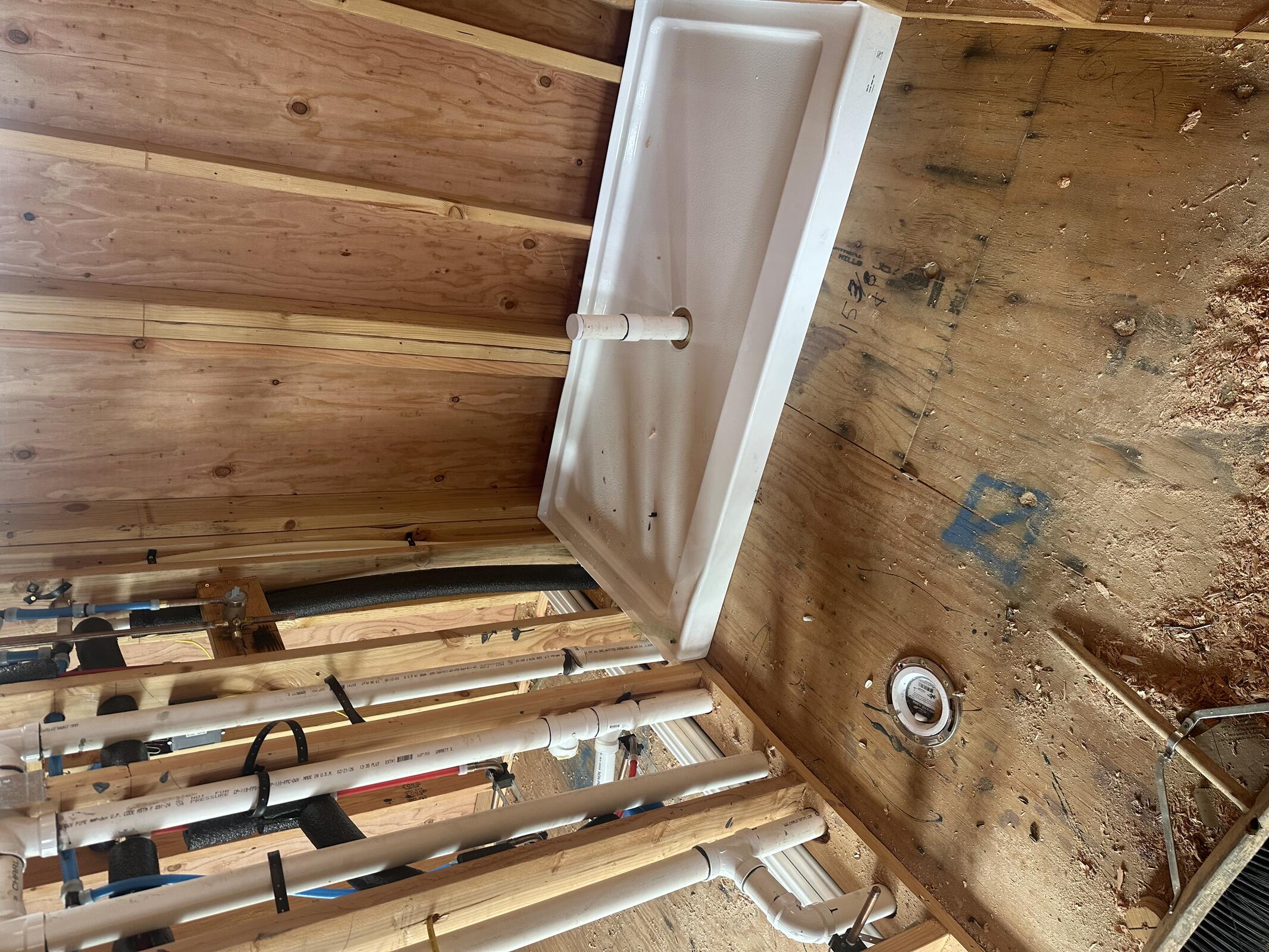

ZSP filling lines and checking for leaks.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| ACCI | 4 | 8 | 32 |
| ZSP | 3 | 4 | 12 |
| Clear HVAC | 2 | 8 | 16 |
Inspection: Dave Finney on site at 11:30 AM to complete Building B shear wall inspecing for Wall Type 1, and MEP Rough-in. Asked for bushings at subpanels at metal openingings and addtional nail plates and plumbing penetrations. Passed both B and C.
