Week of April 20 — April 23, 2026
4 days on site. 82 photos. Electric, Framing, Plumbing, SDGE, Survey.
Monday, April 20, 2026
Clear, 71°F

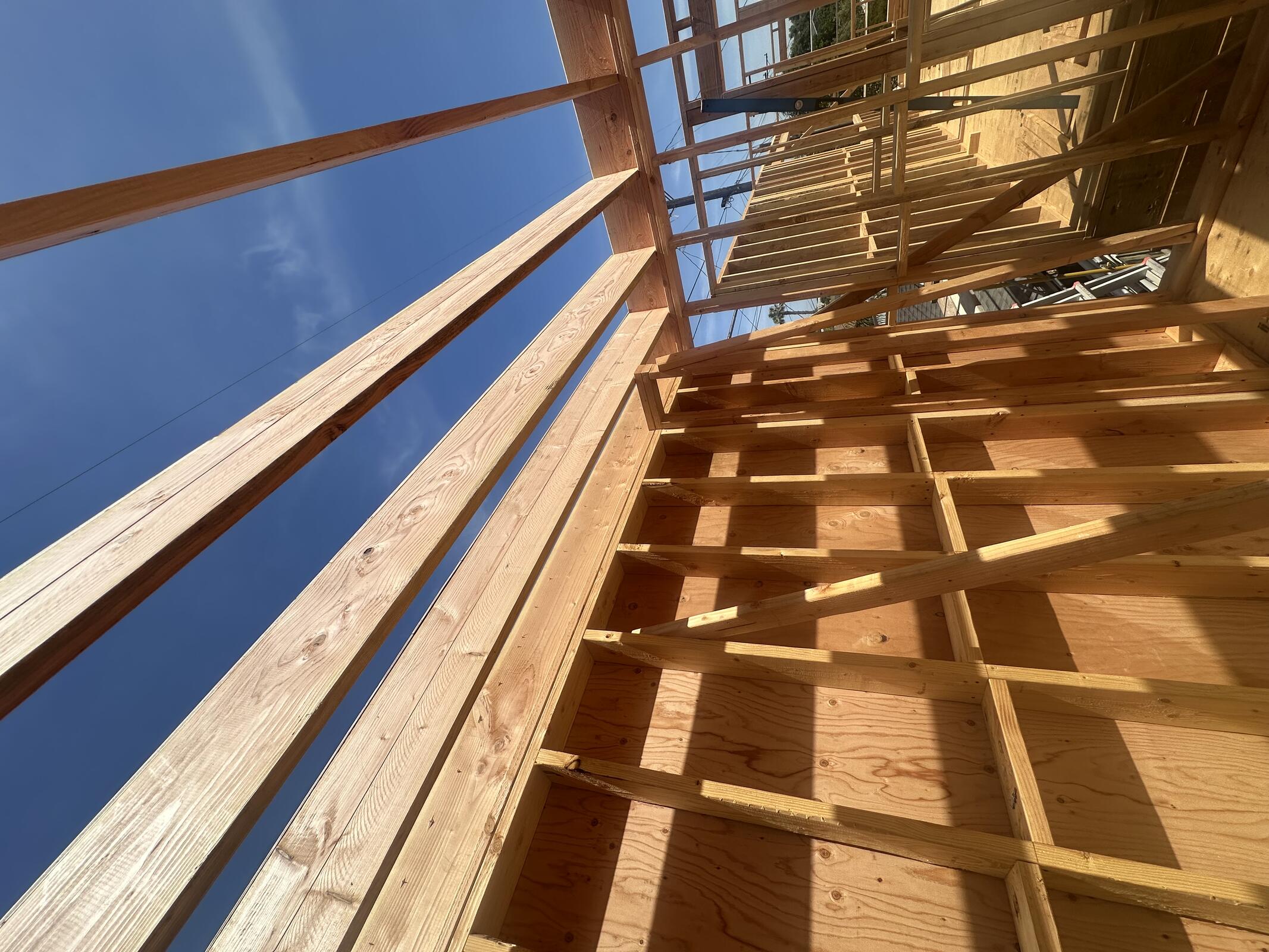

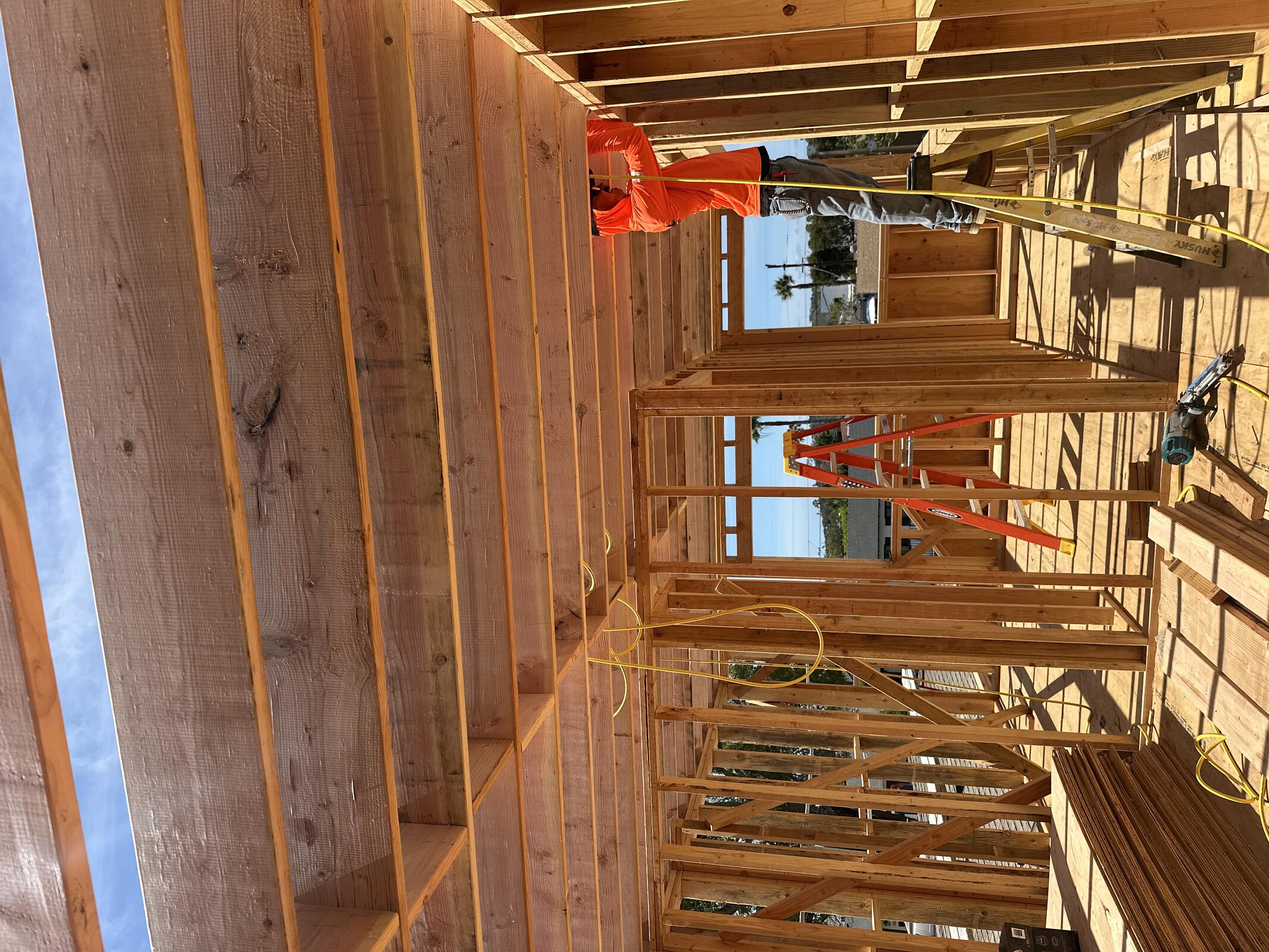

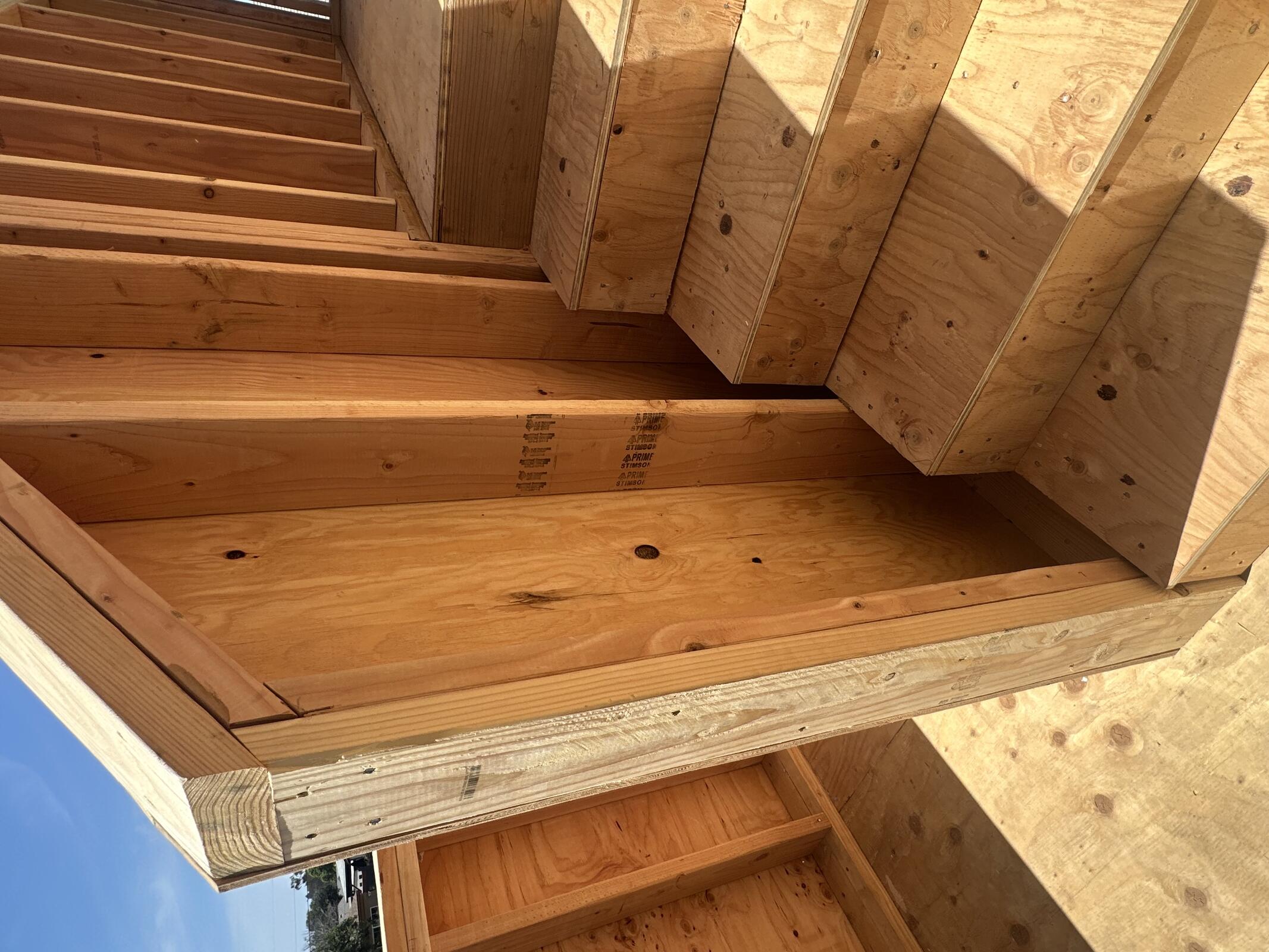

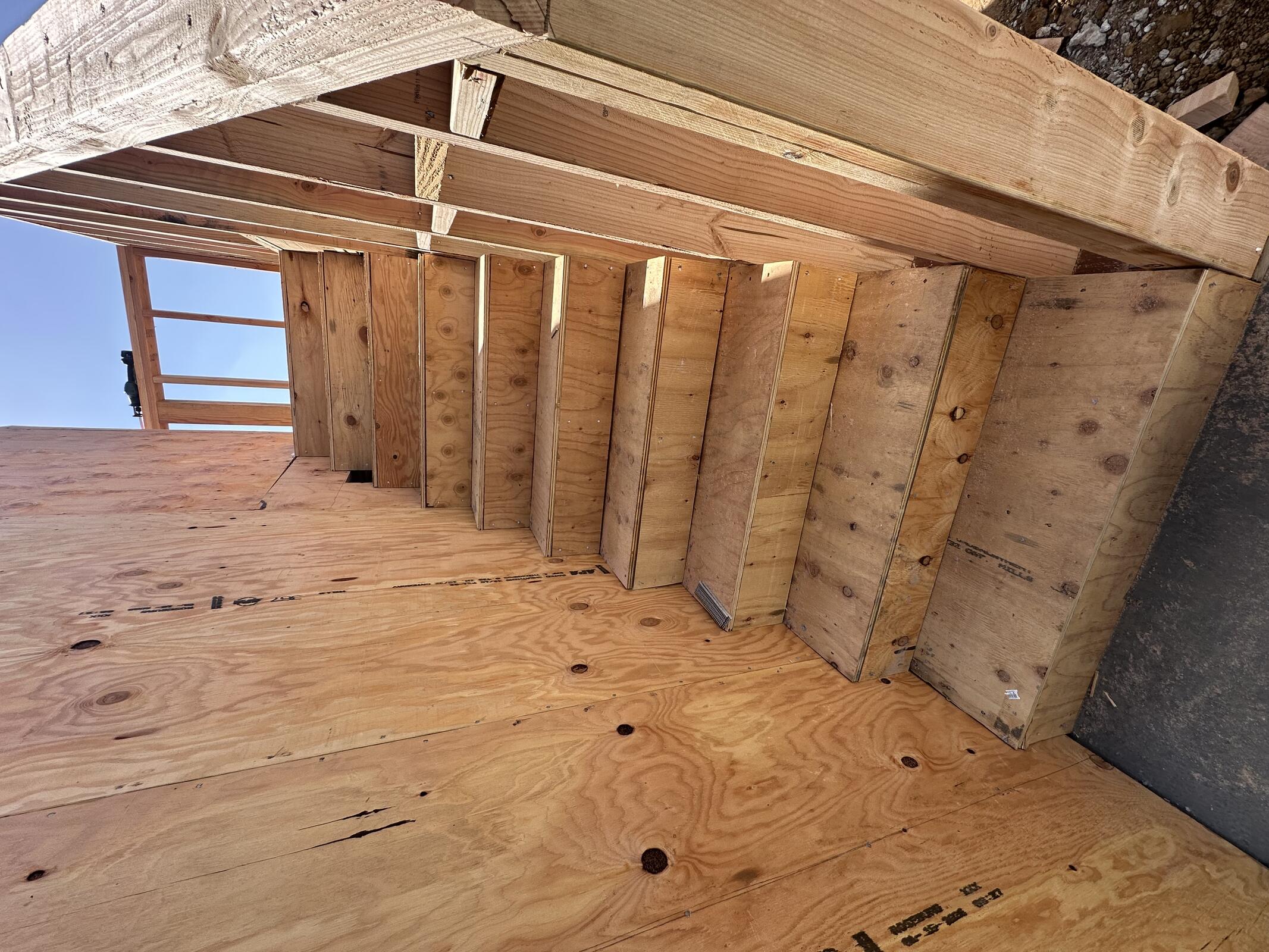

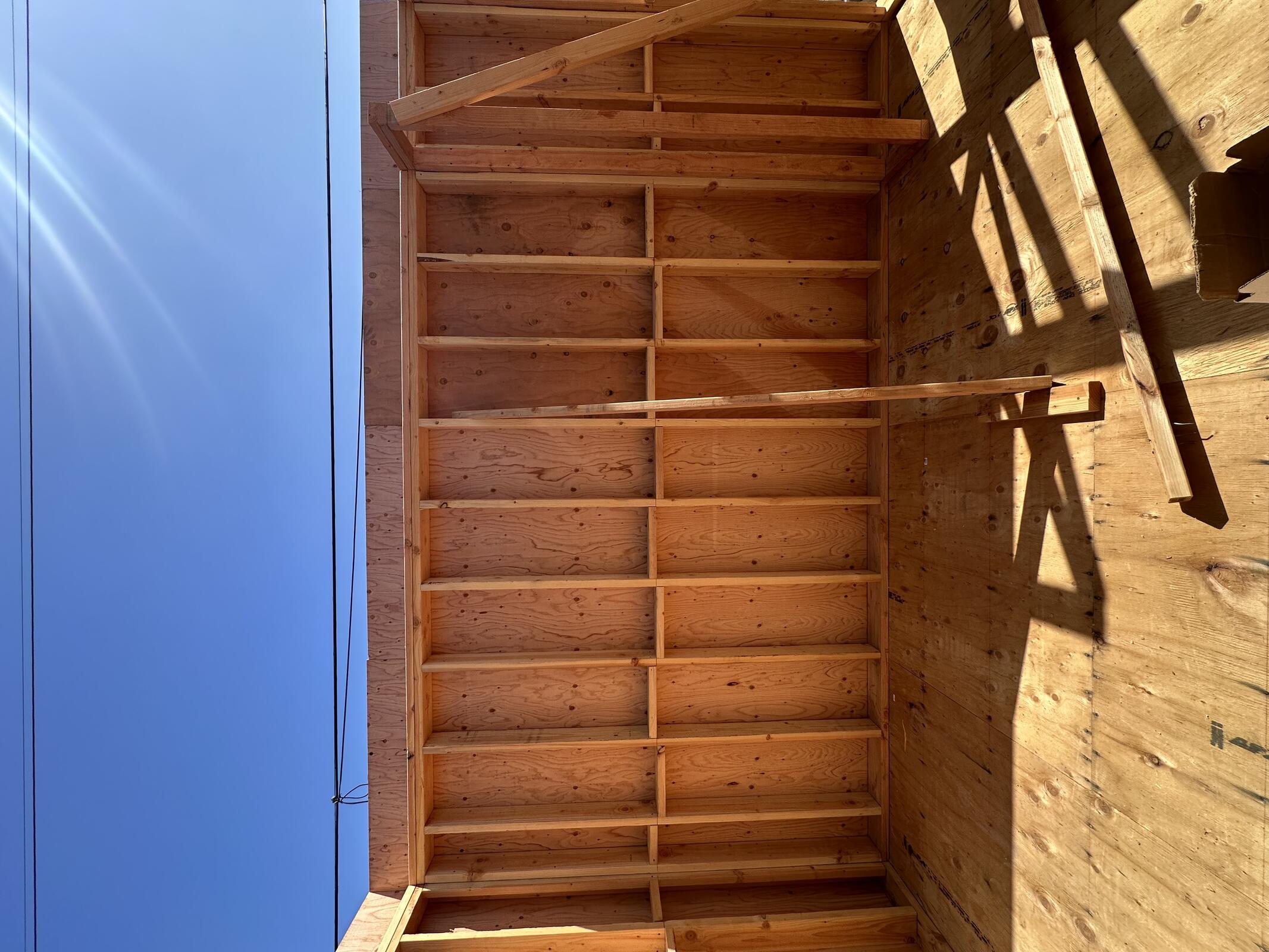

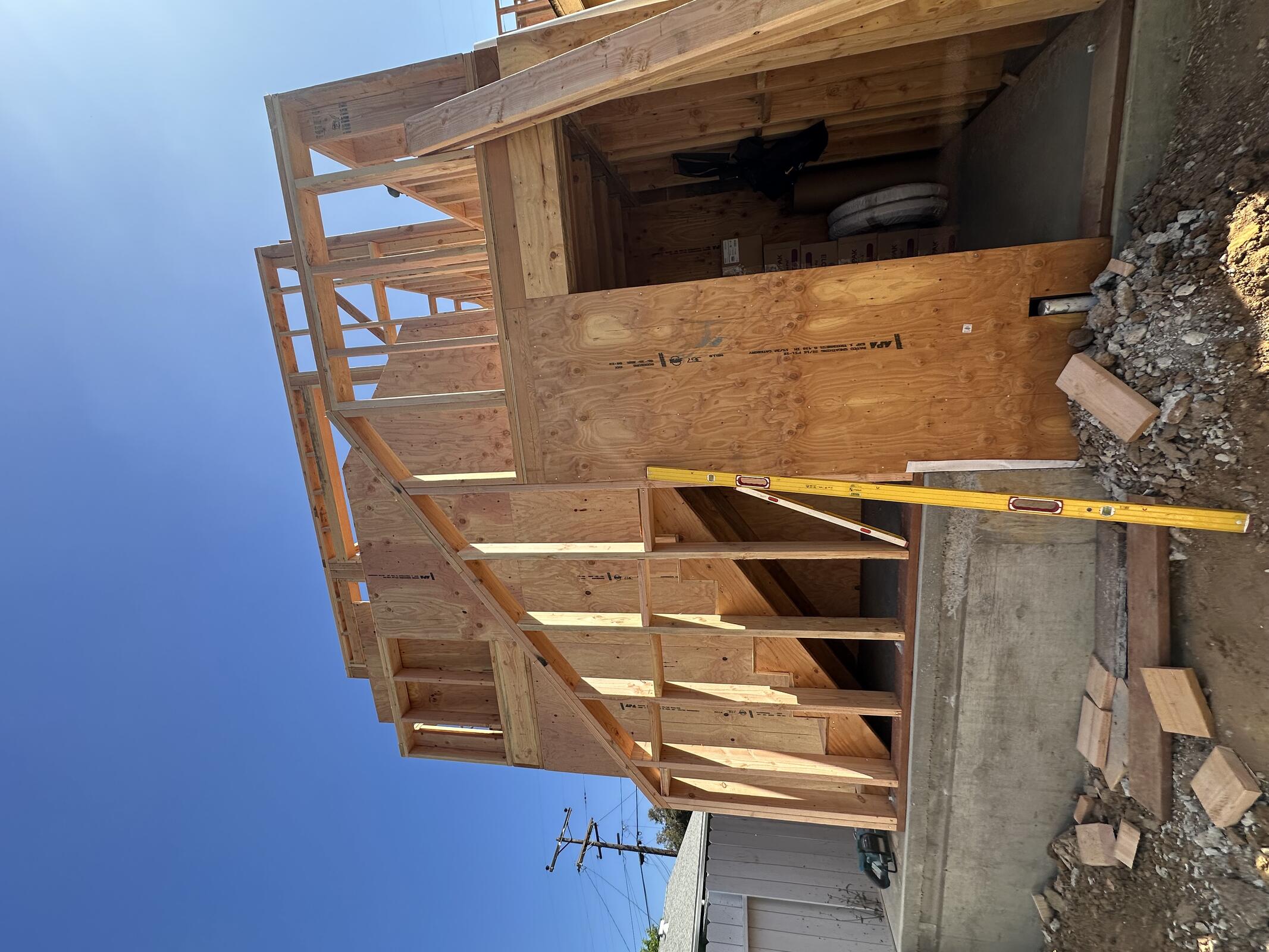

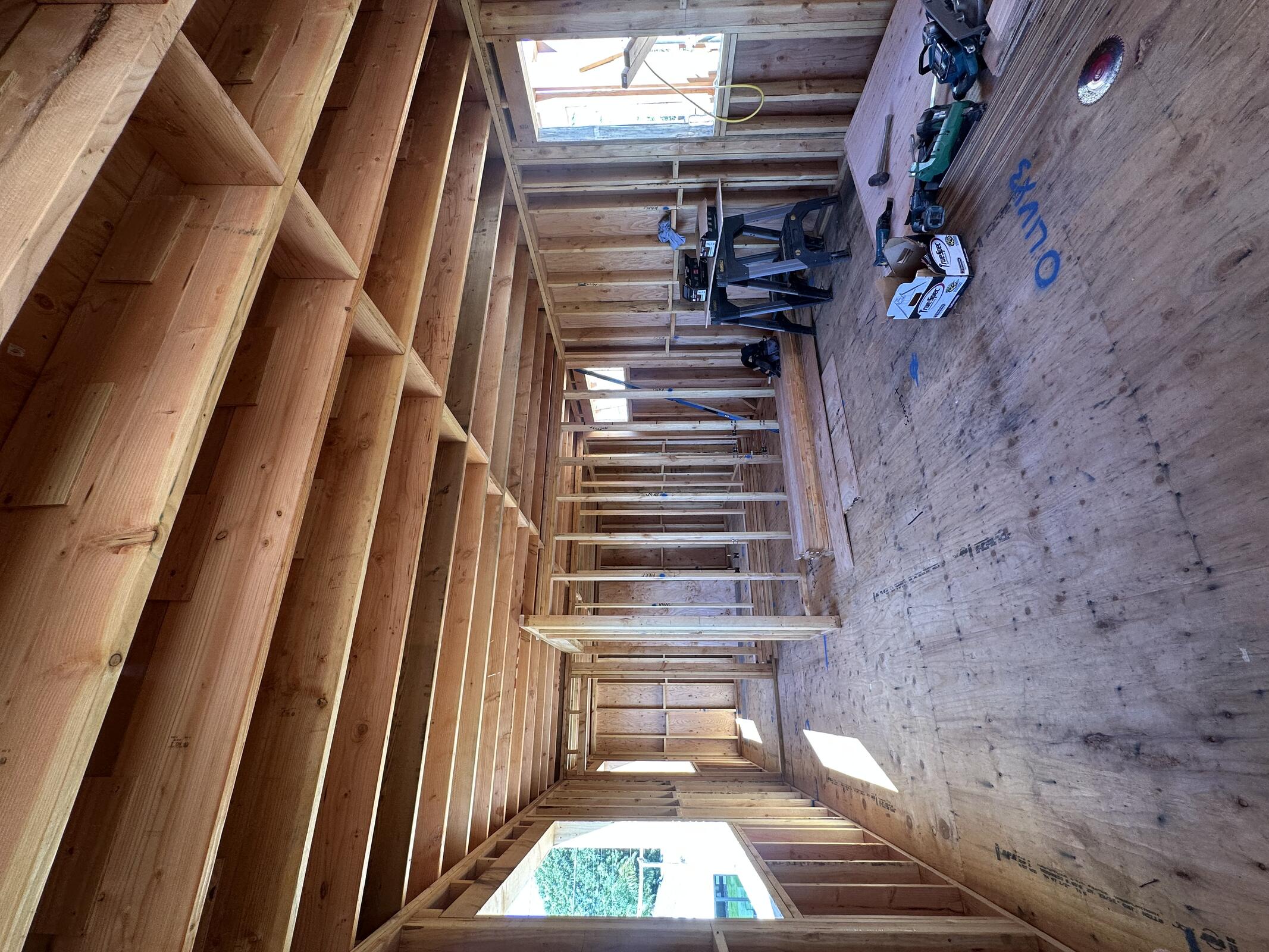

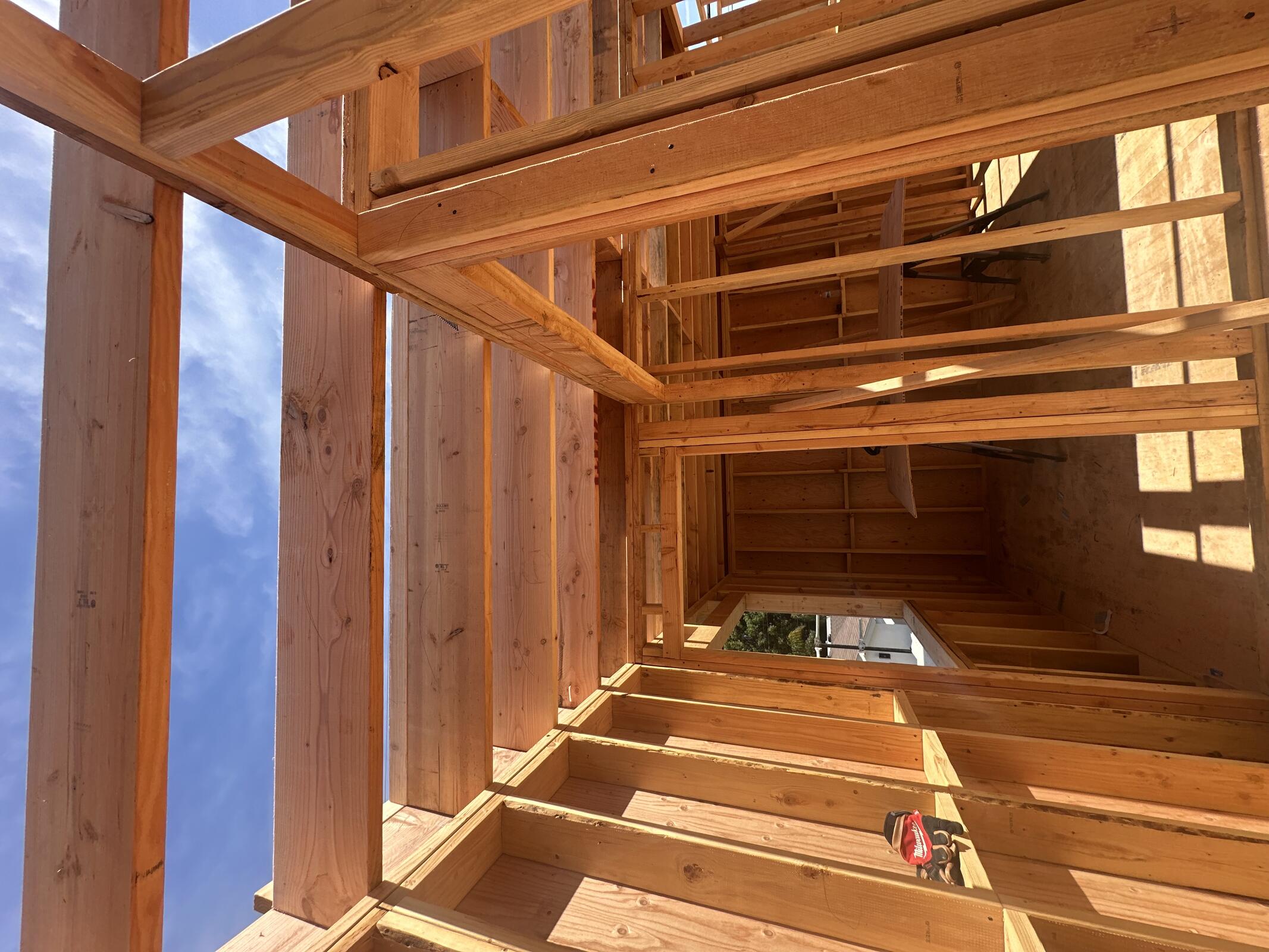

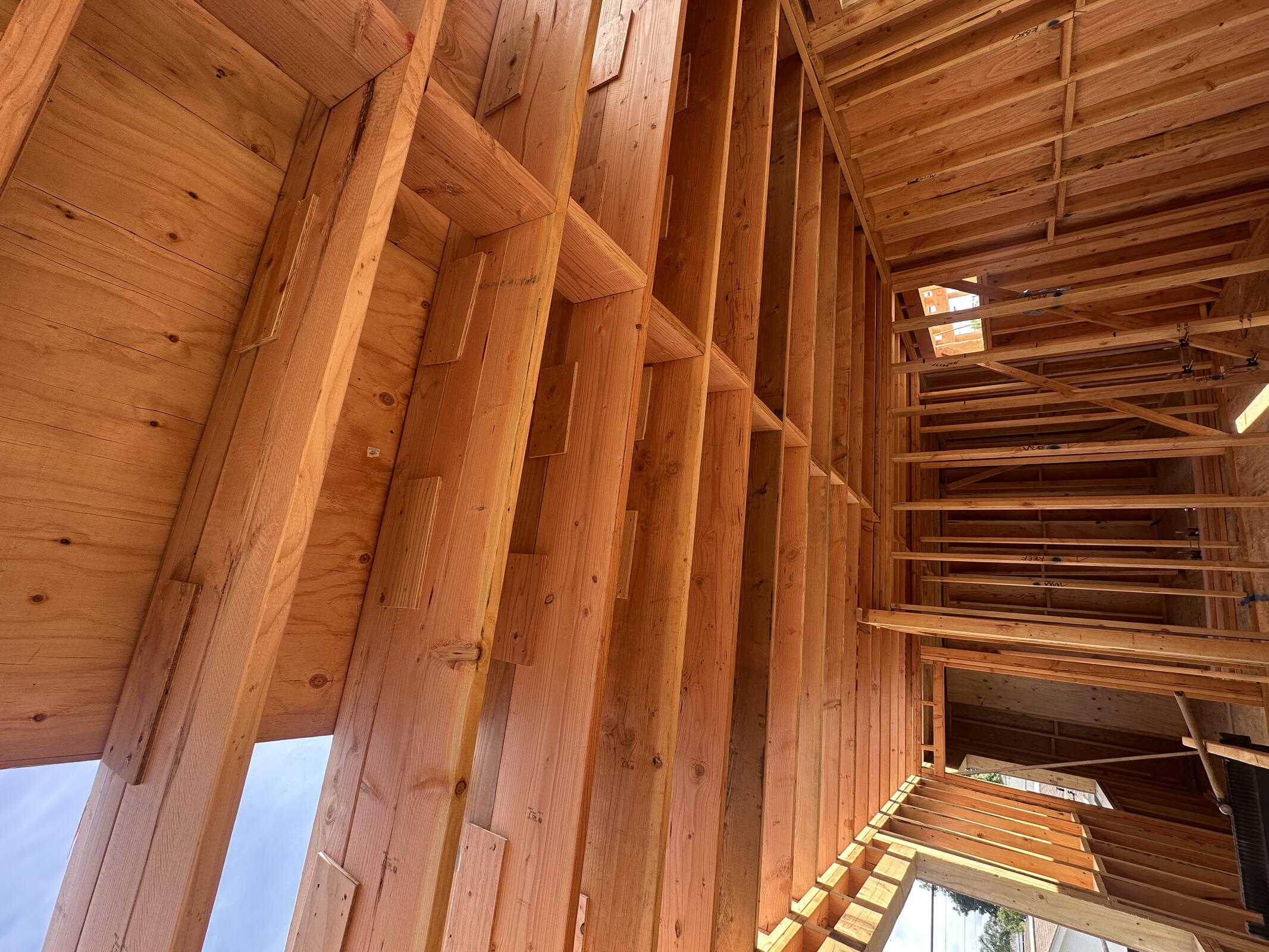

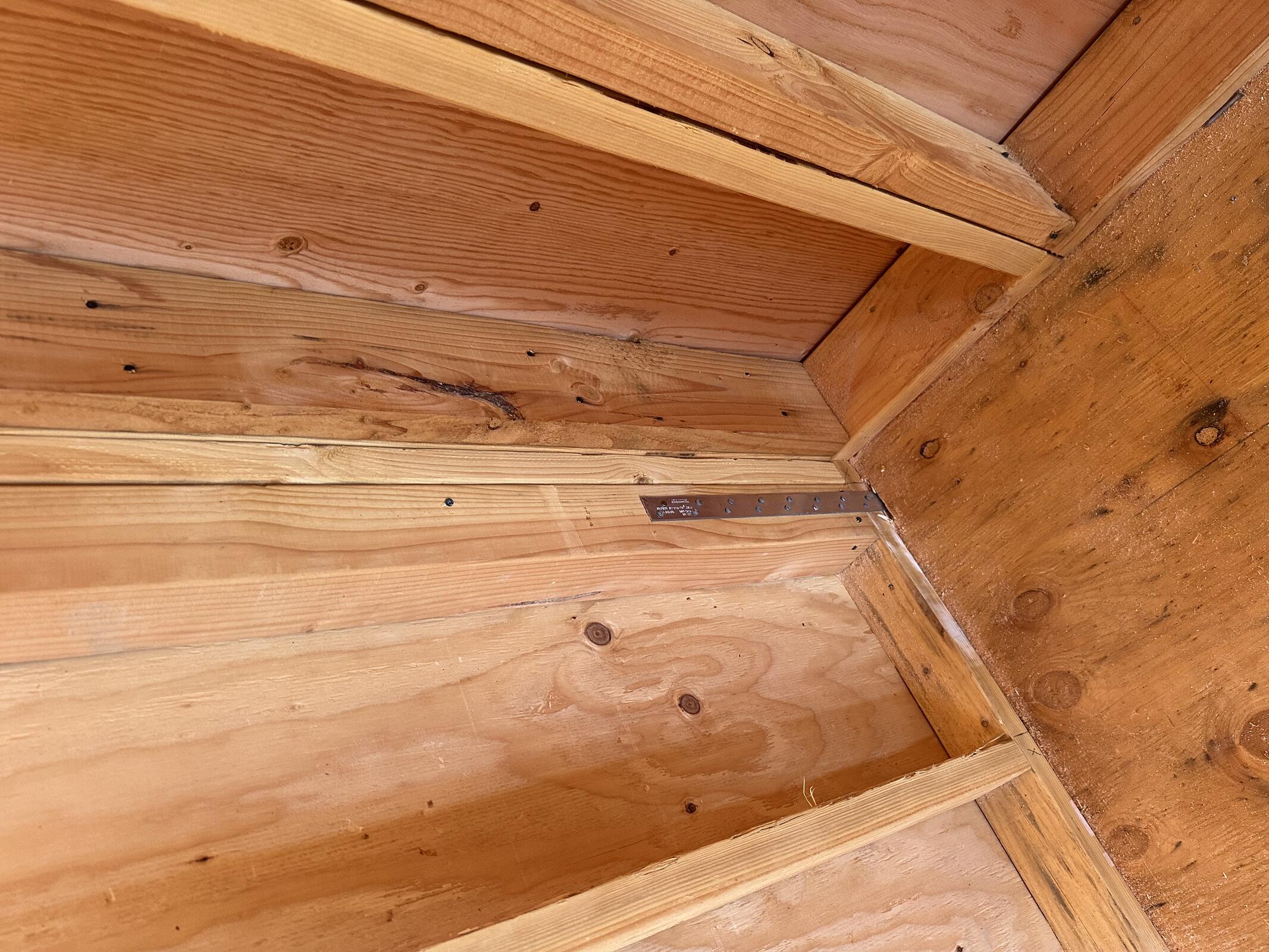

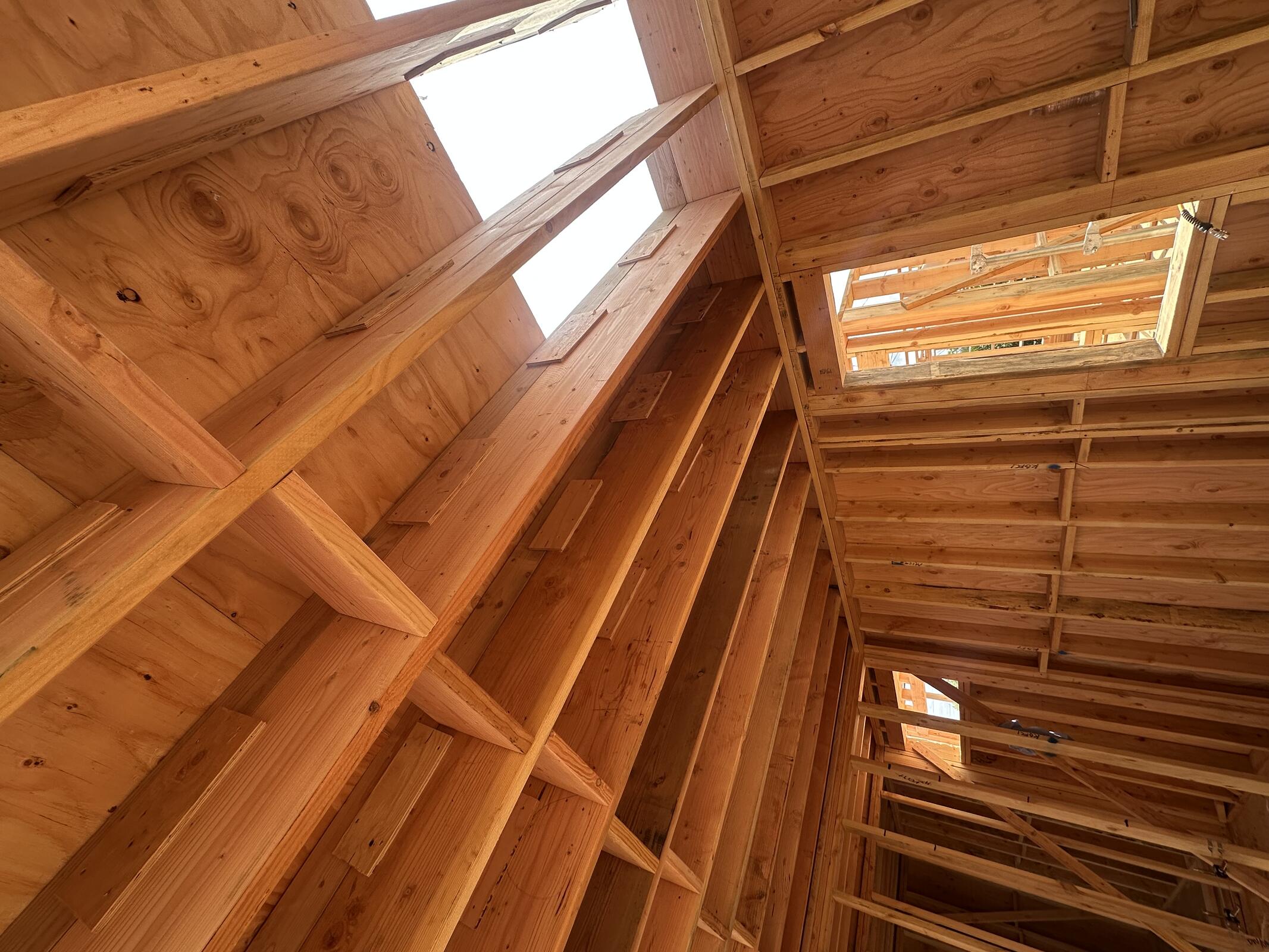

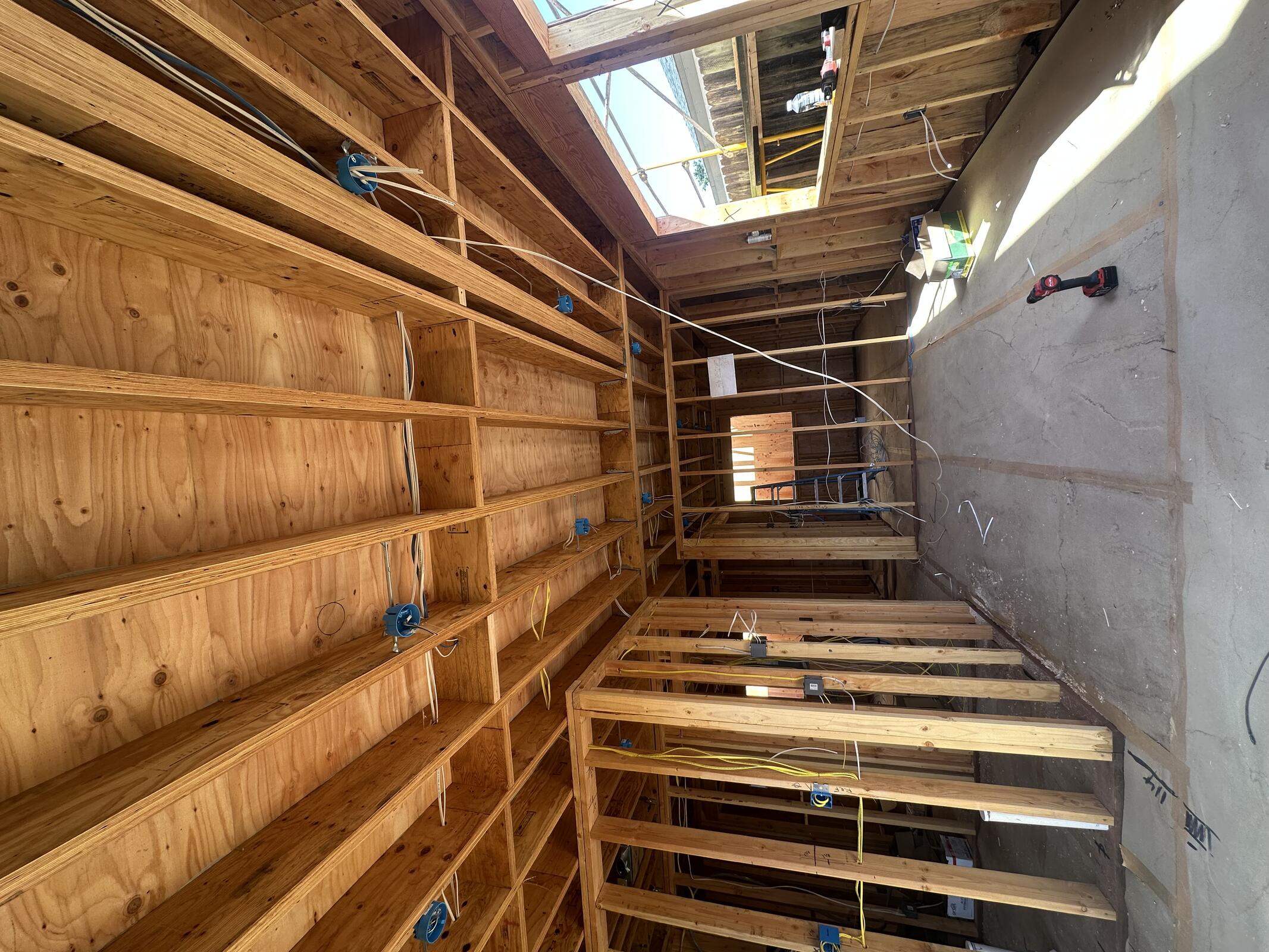

JB General on site, shearing building C and setting joists. Interior walls at Building B second floor unit complete.

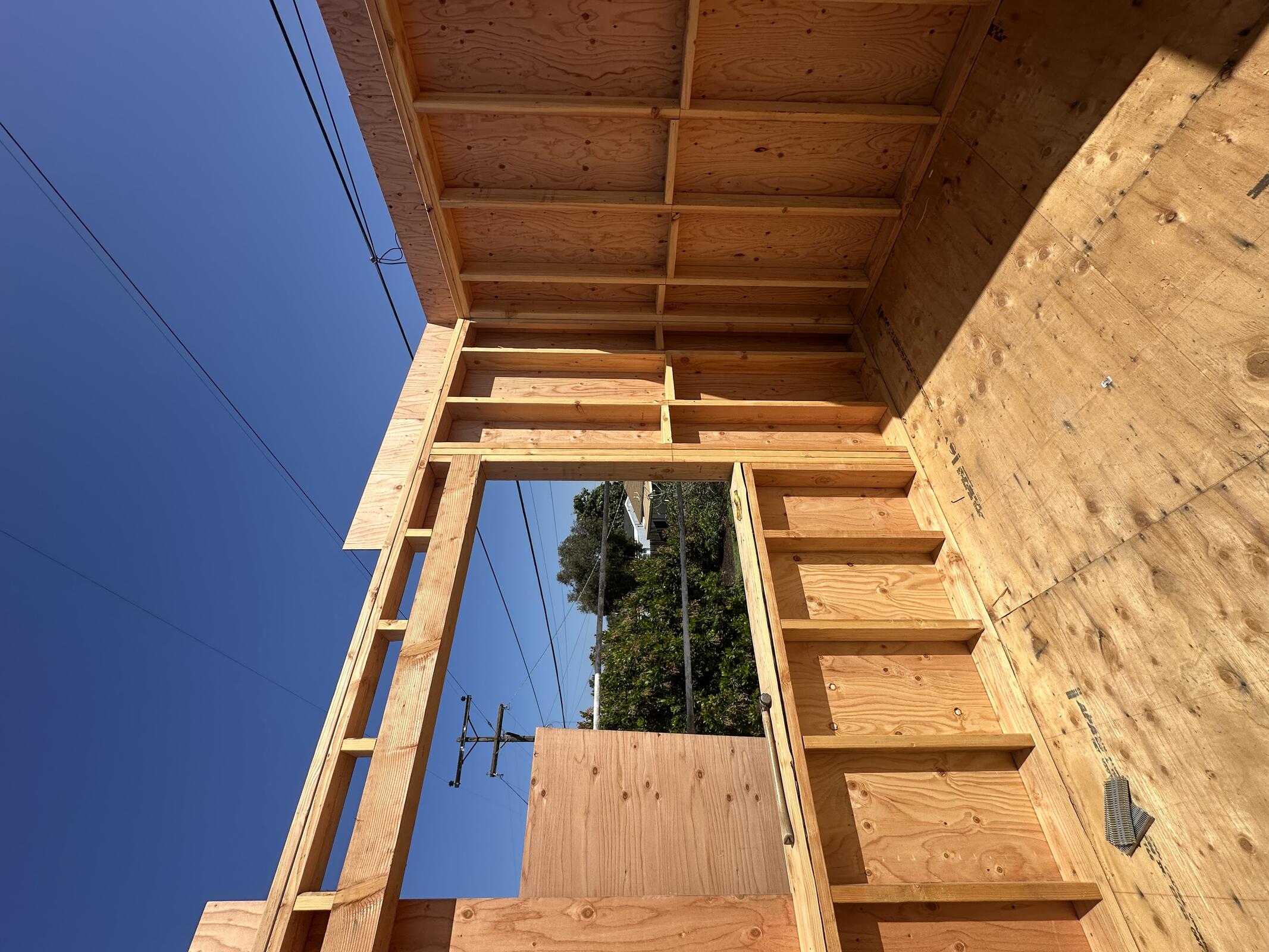

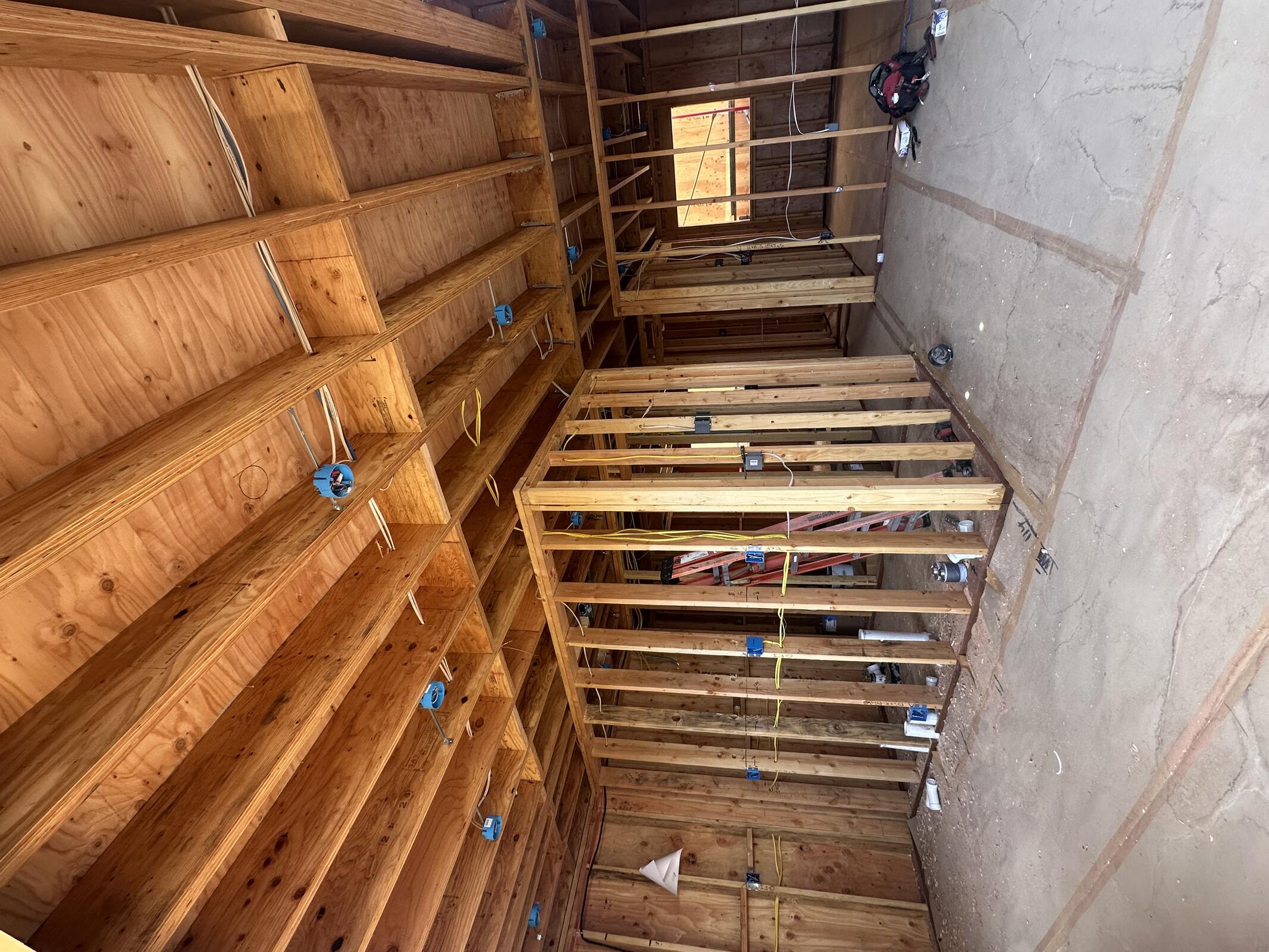

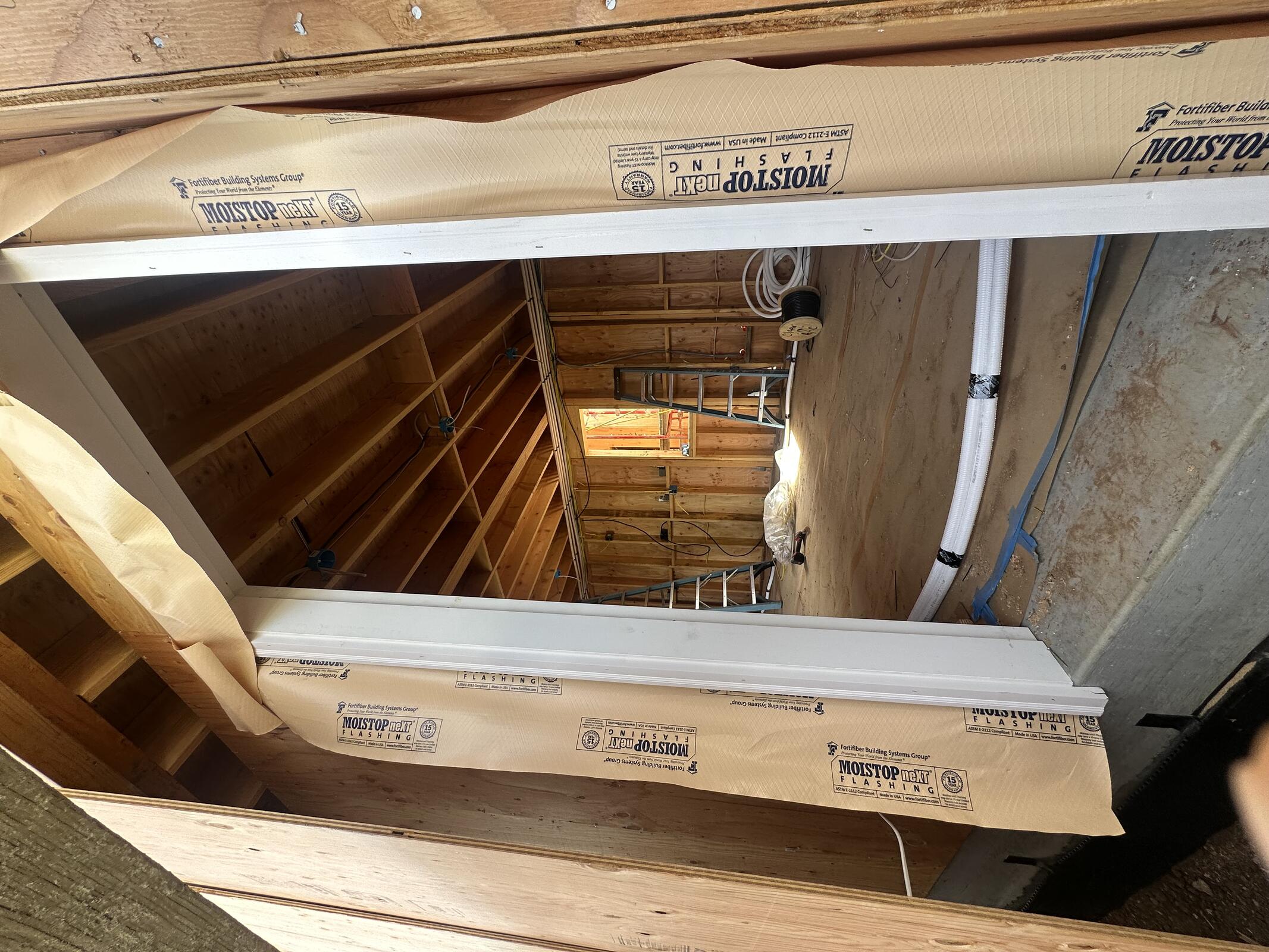

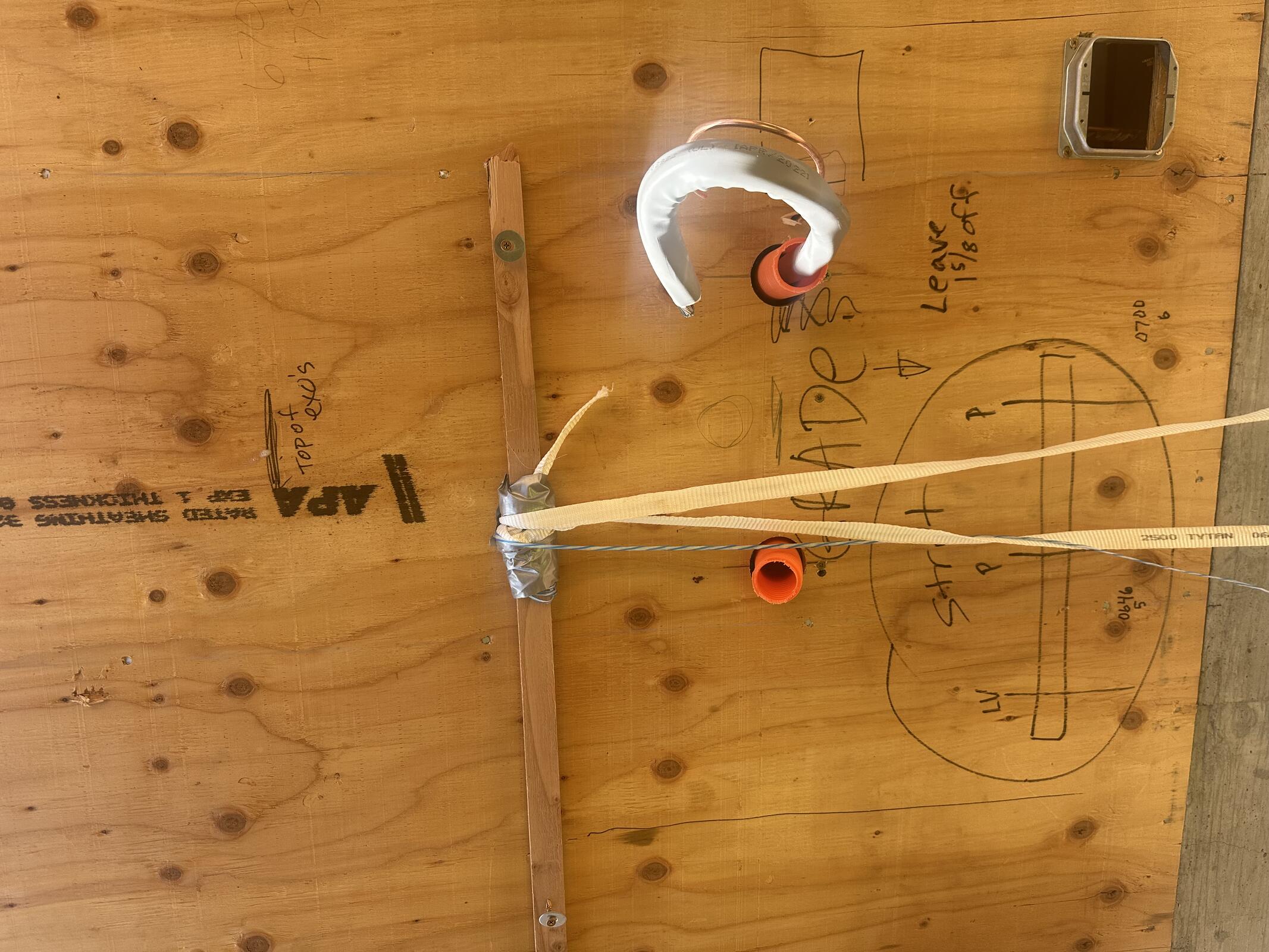

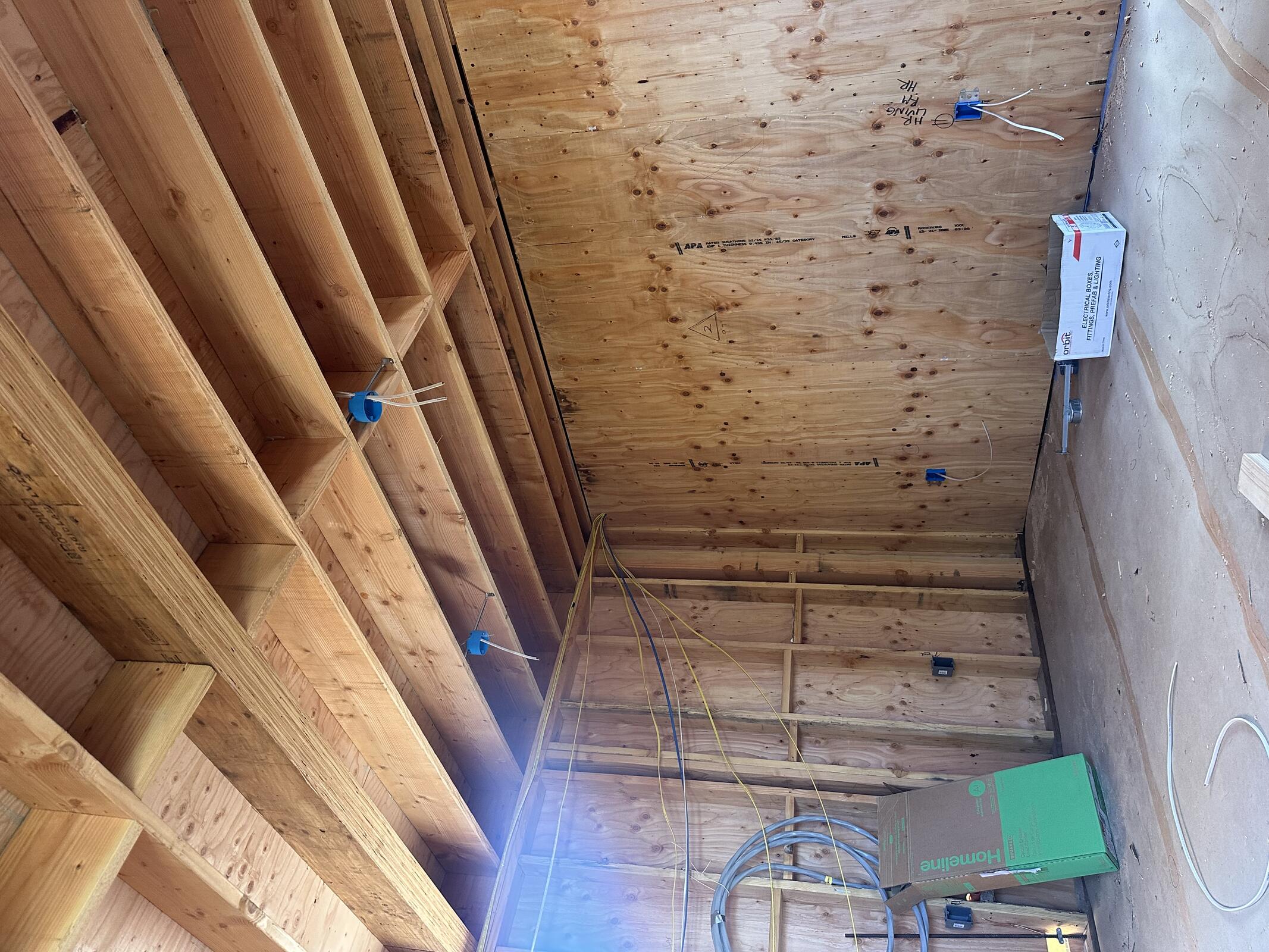

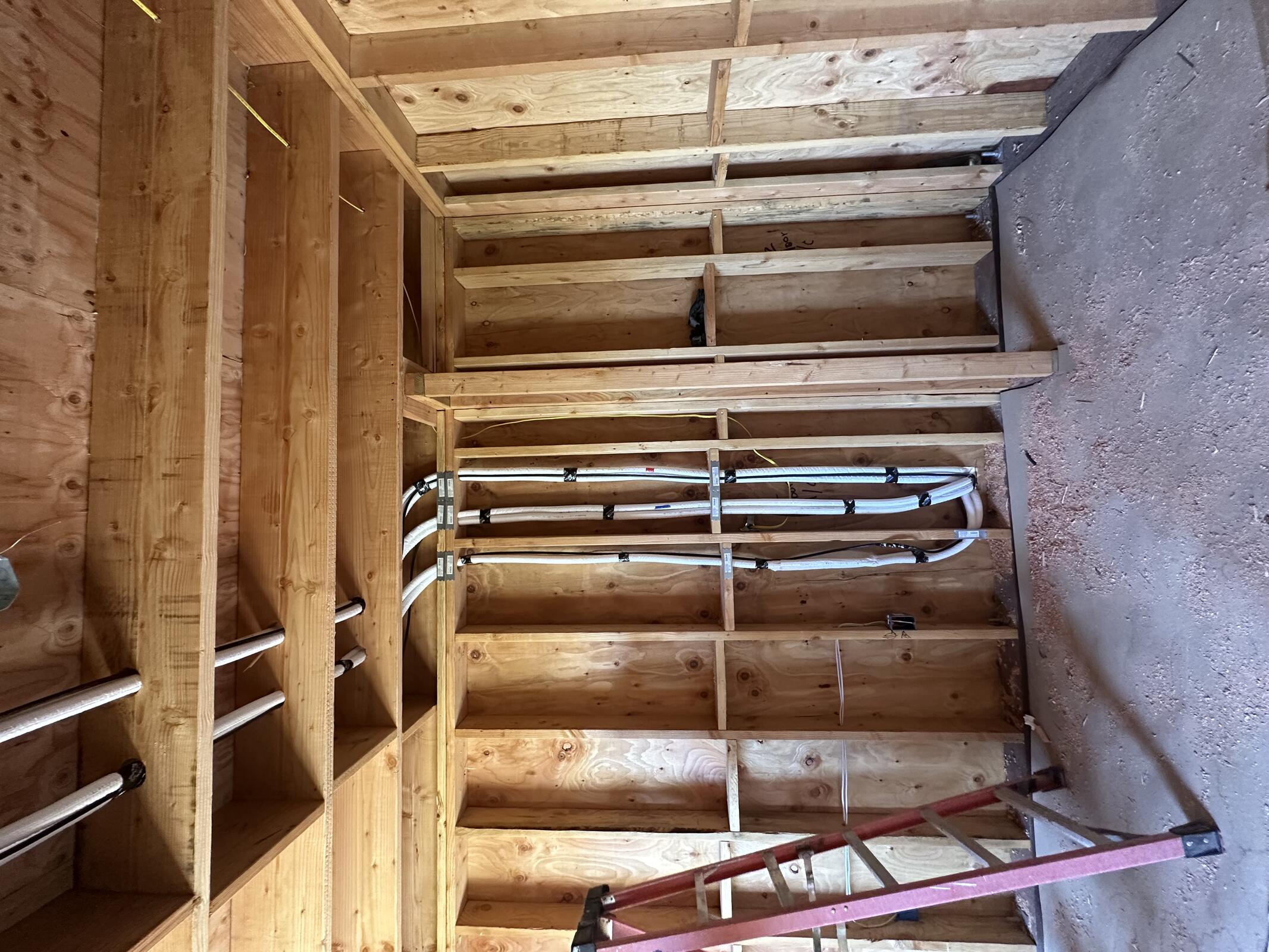

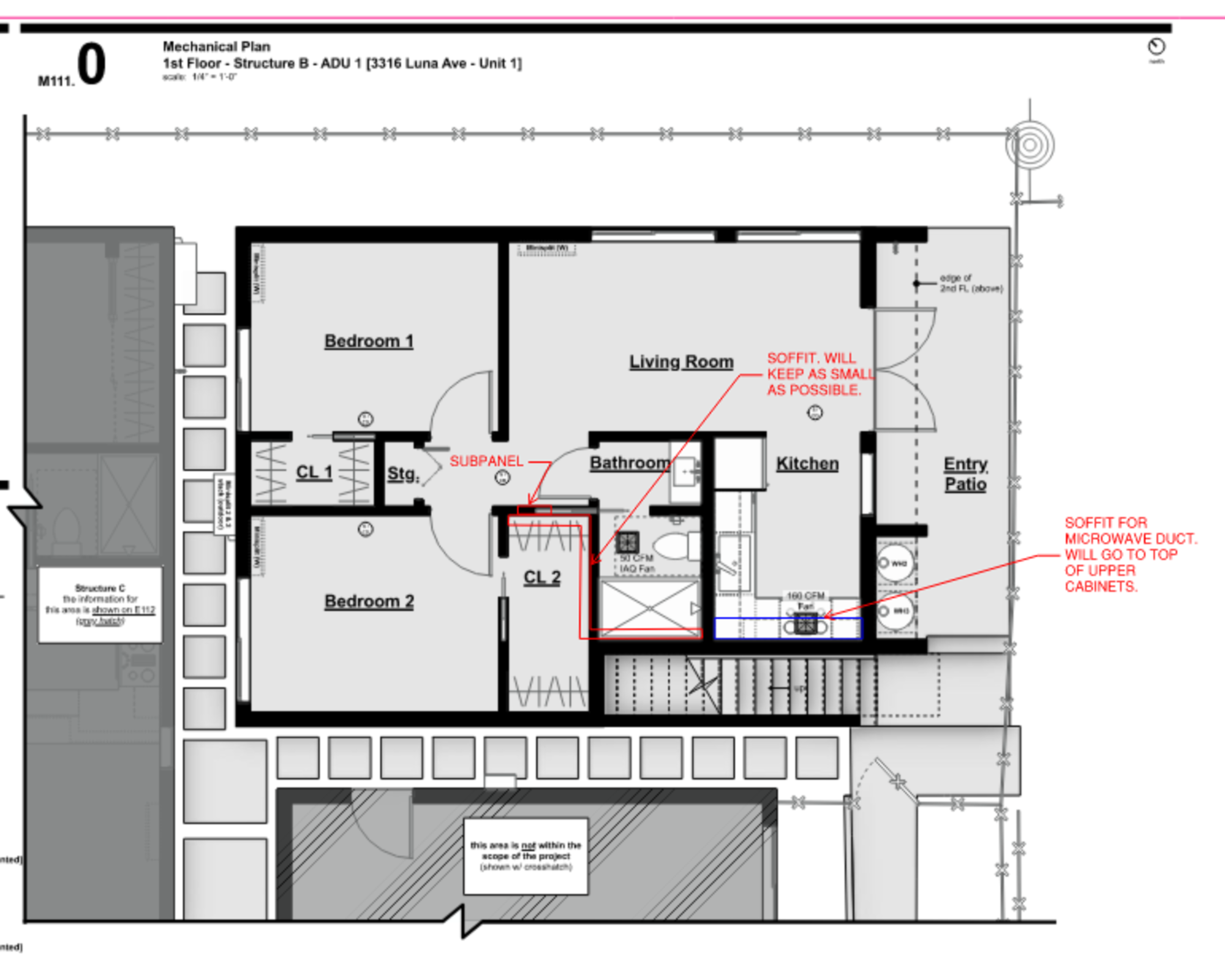

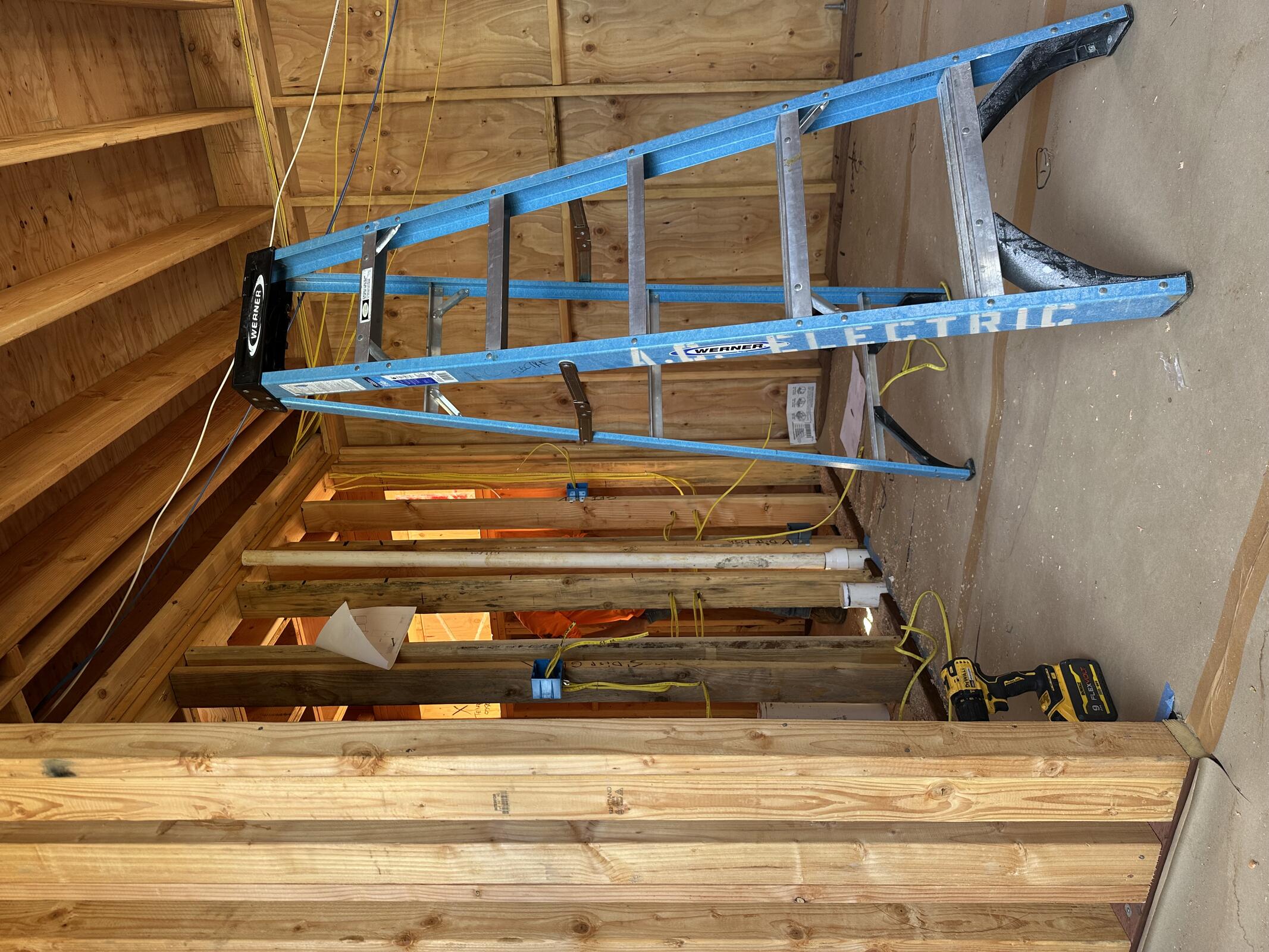

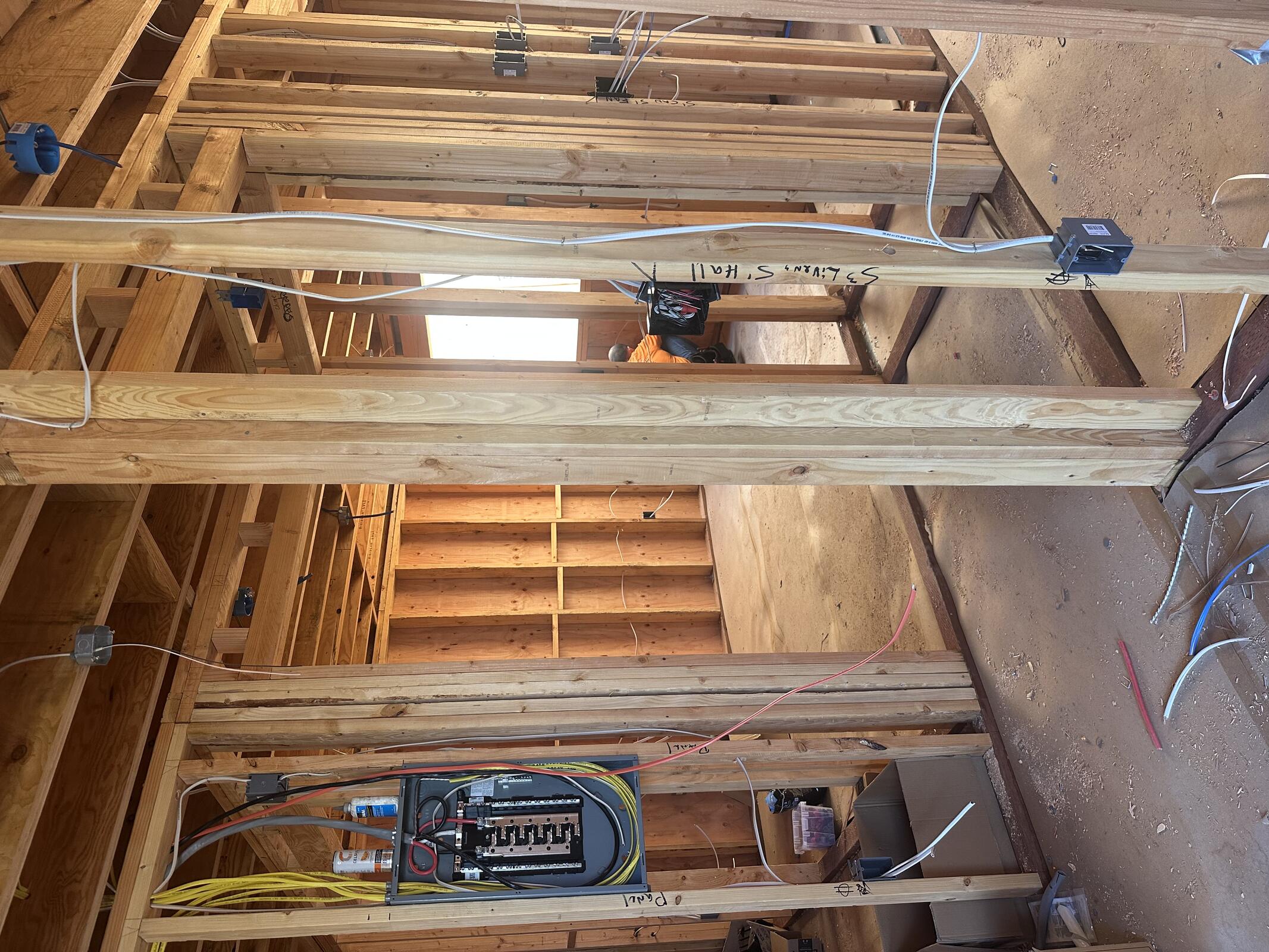

AC Electric almost done with first floor wiring at building B. Soffit will be needed do to drilling limitations through LVL beams.

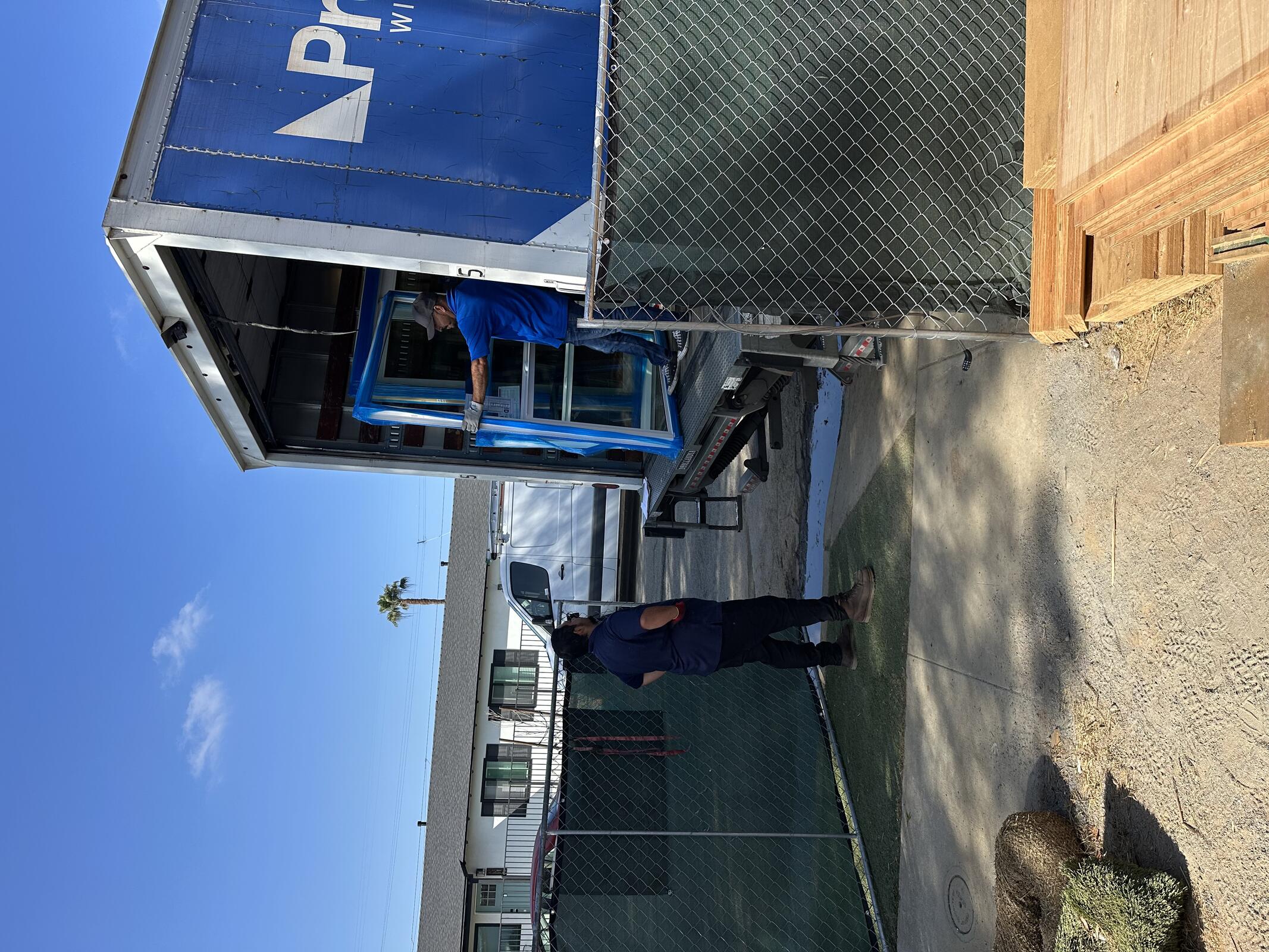

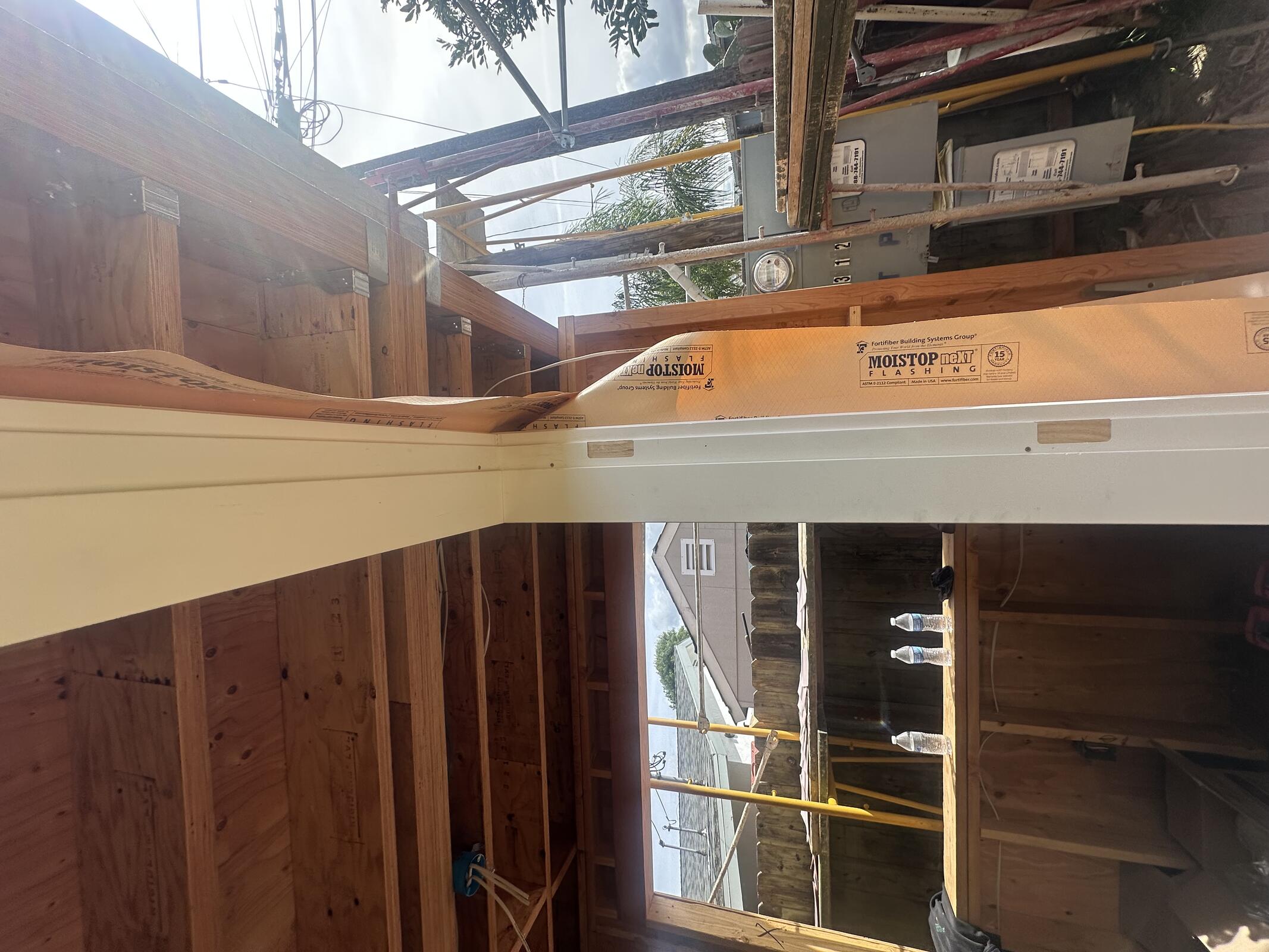

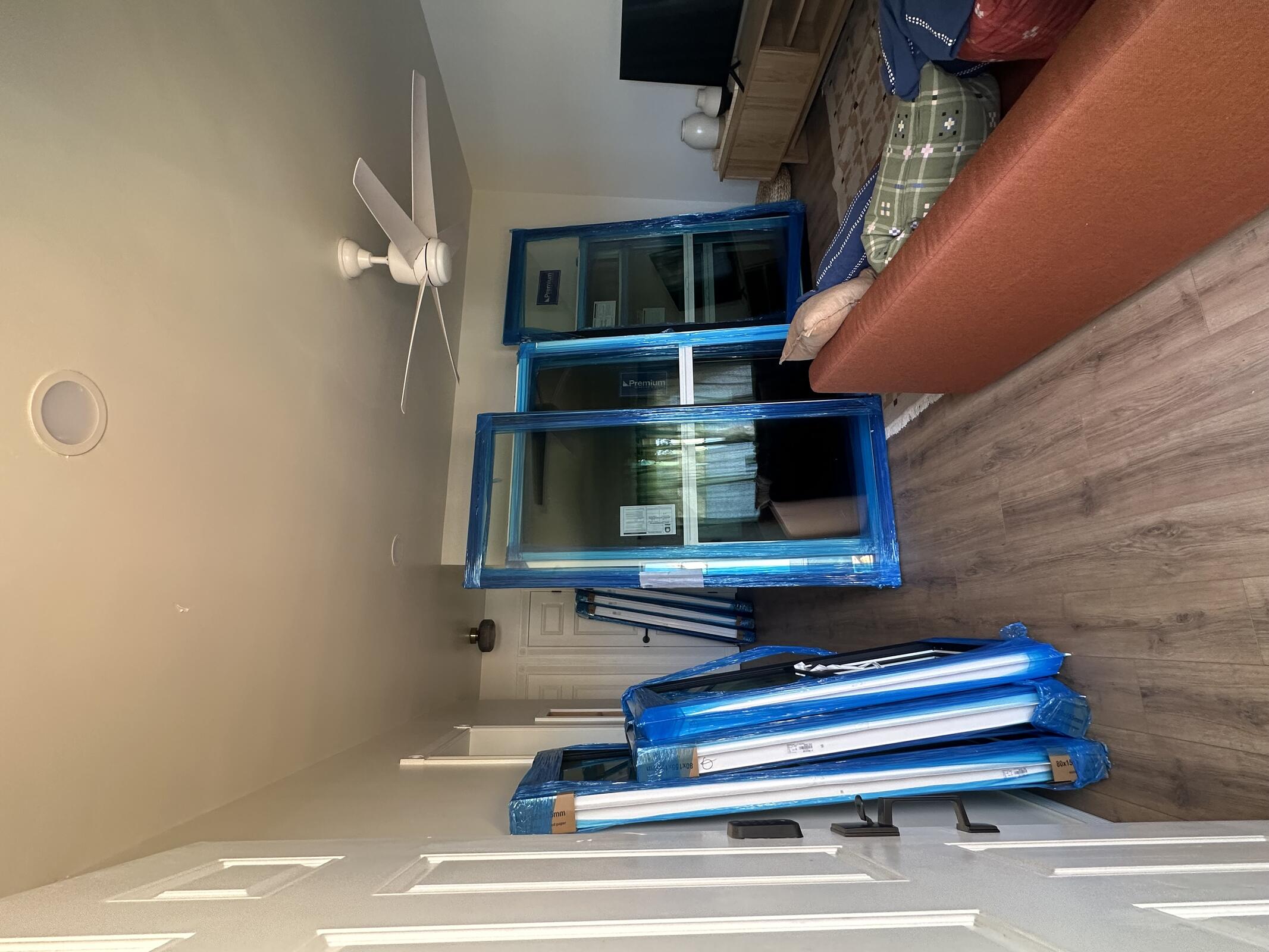

Windows and sliding glass door delivered at 9:30 AM and stored in existing front unit. Dennis (Window Solutions) on site to verify order.
Chad (Primera) on site to take field measurements for Cabinets.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| JB General | 5 | 8 | 40 |
| AC Electric | 3 | 8 | 24 |
Inspection: N/A























Tuesday, April 21, 2026
Clear, 68°F

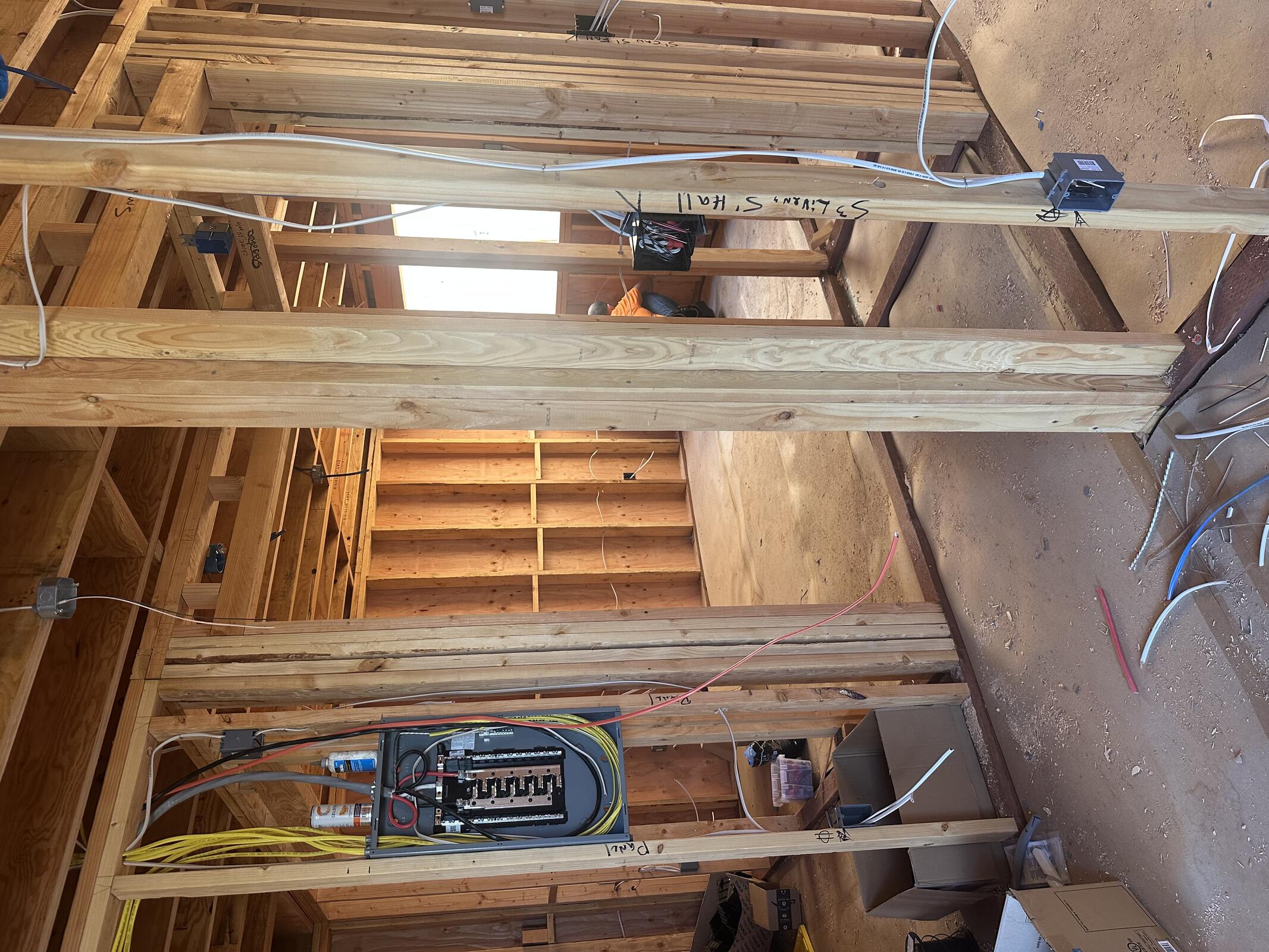

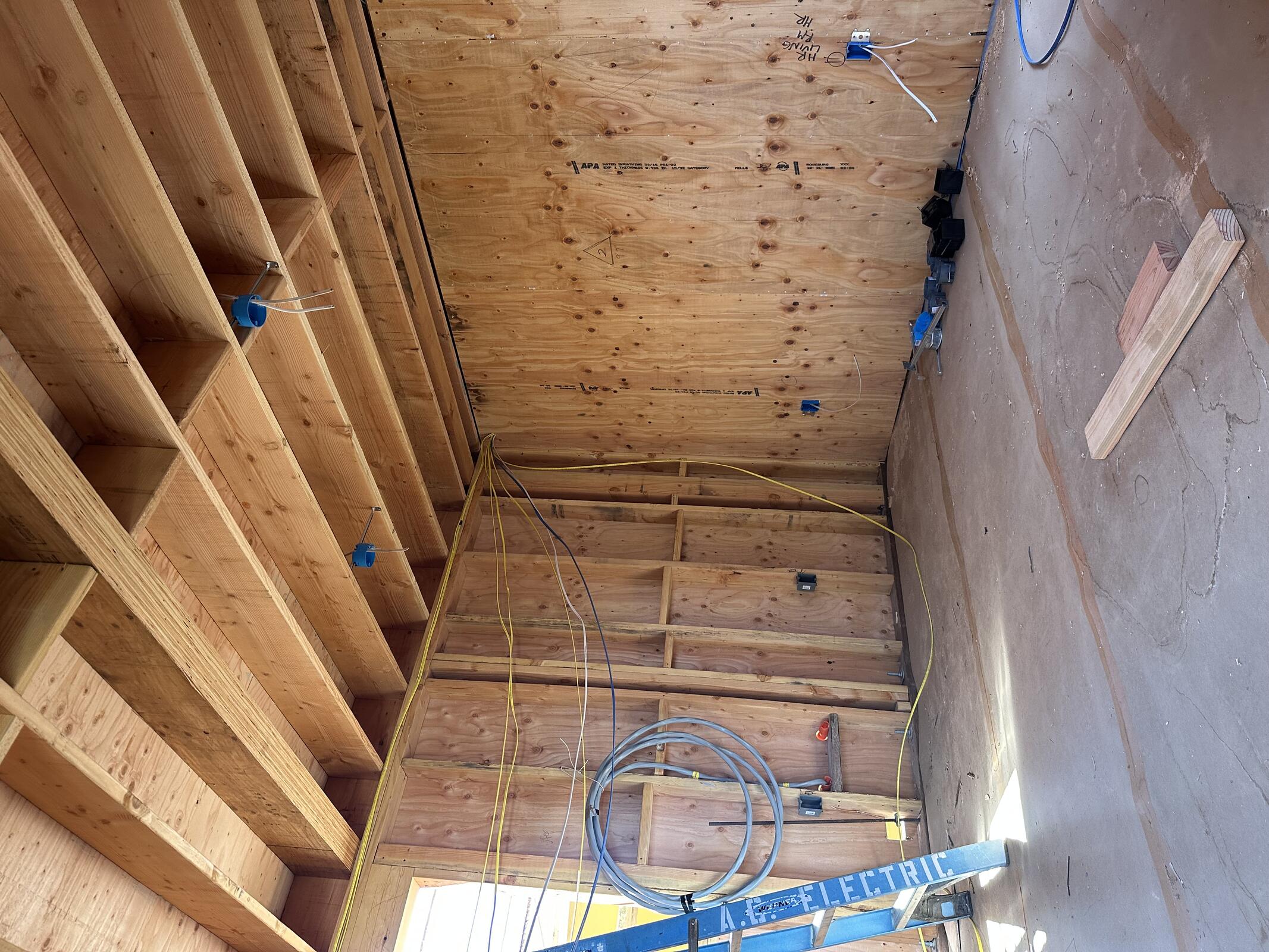

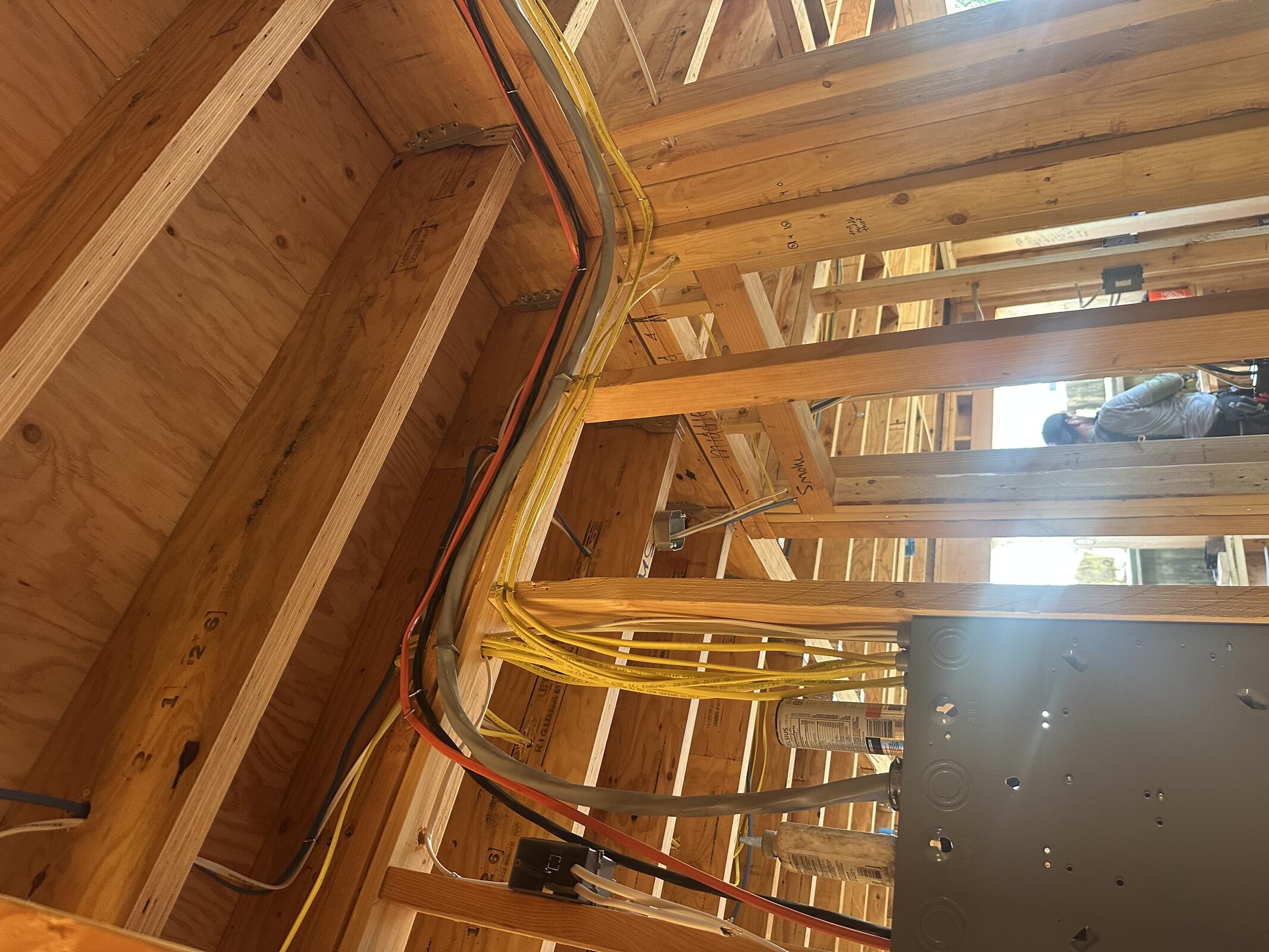

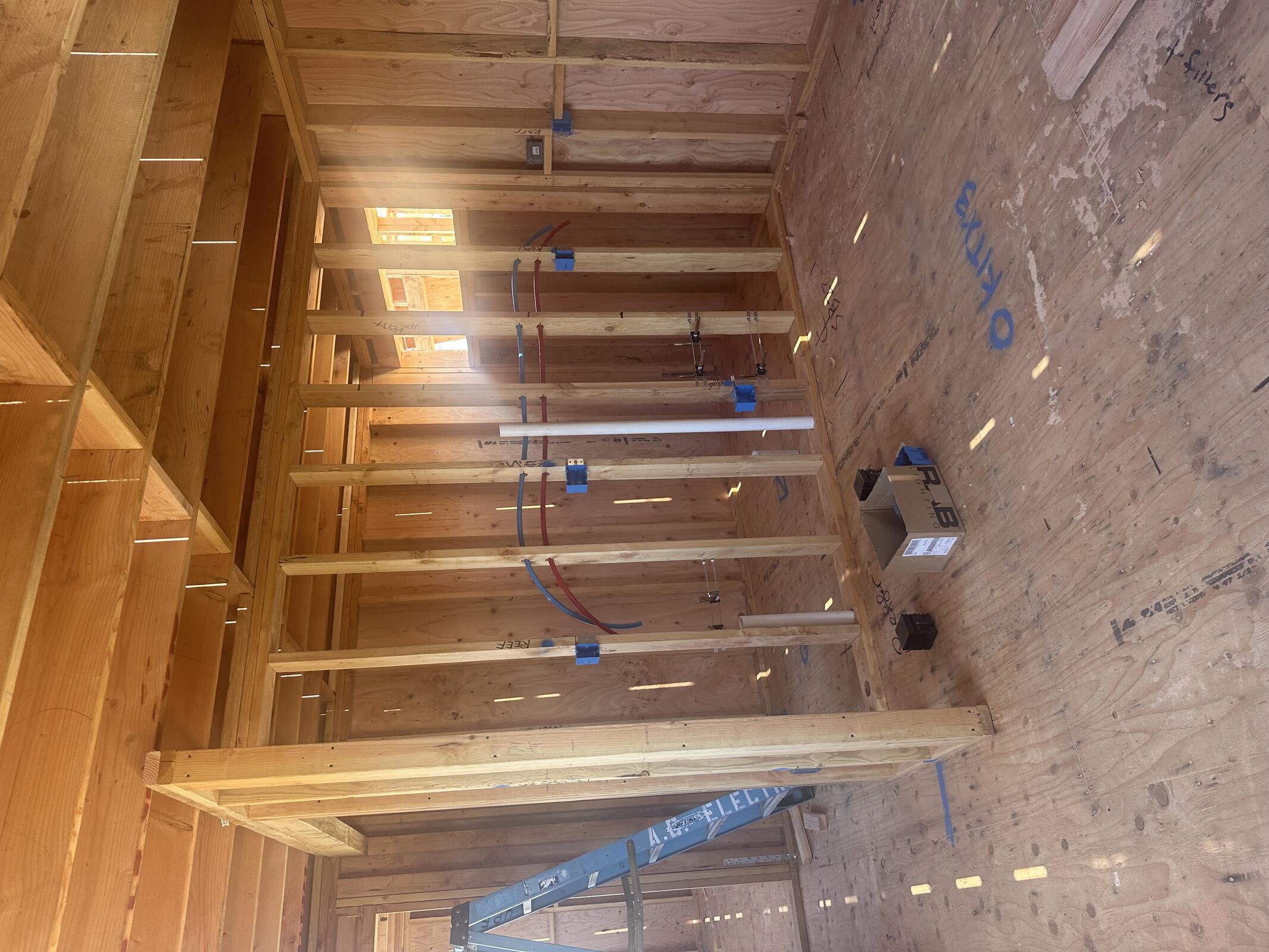

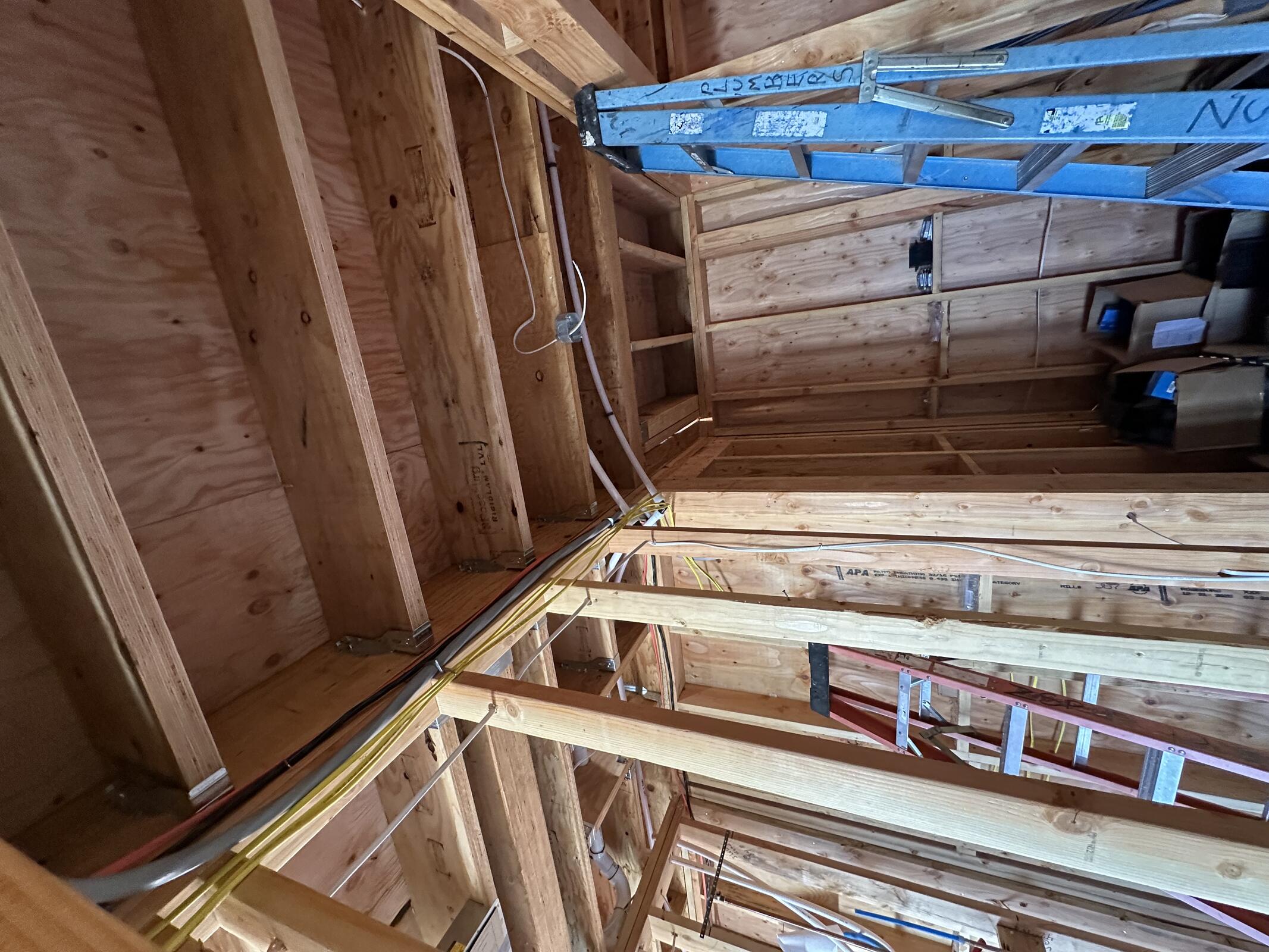

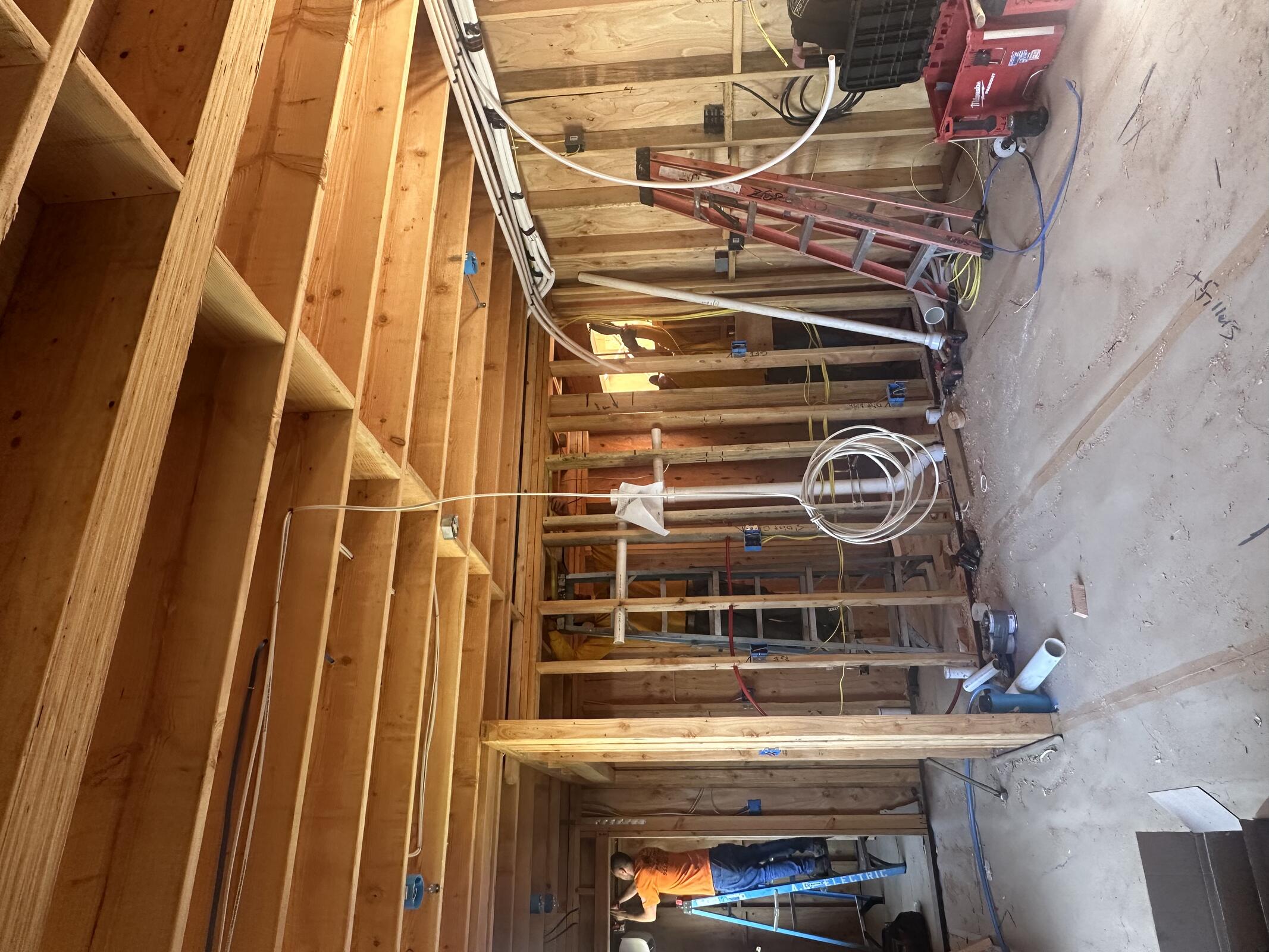

AC Electric wiring in Building C, Unit 1.

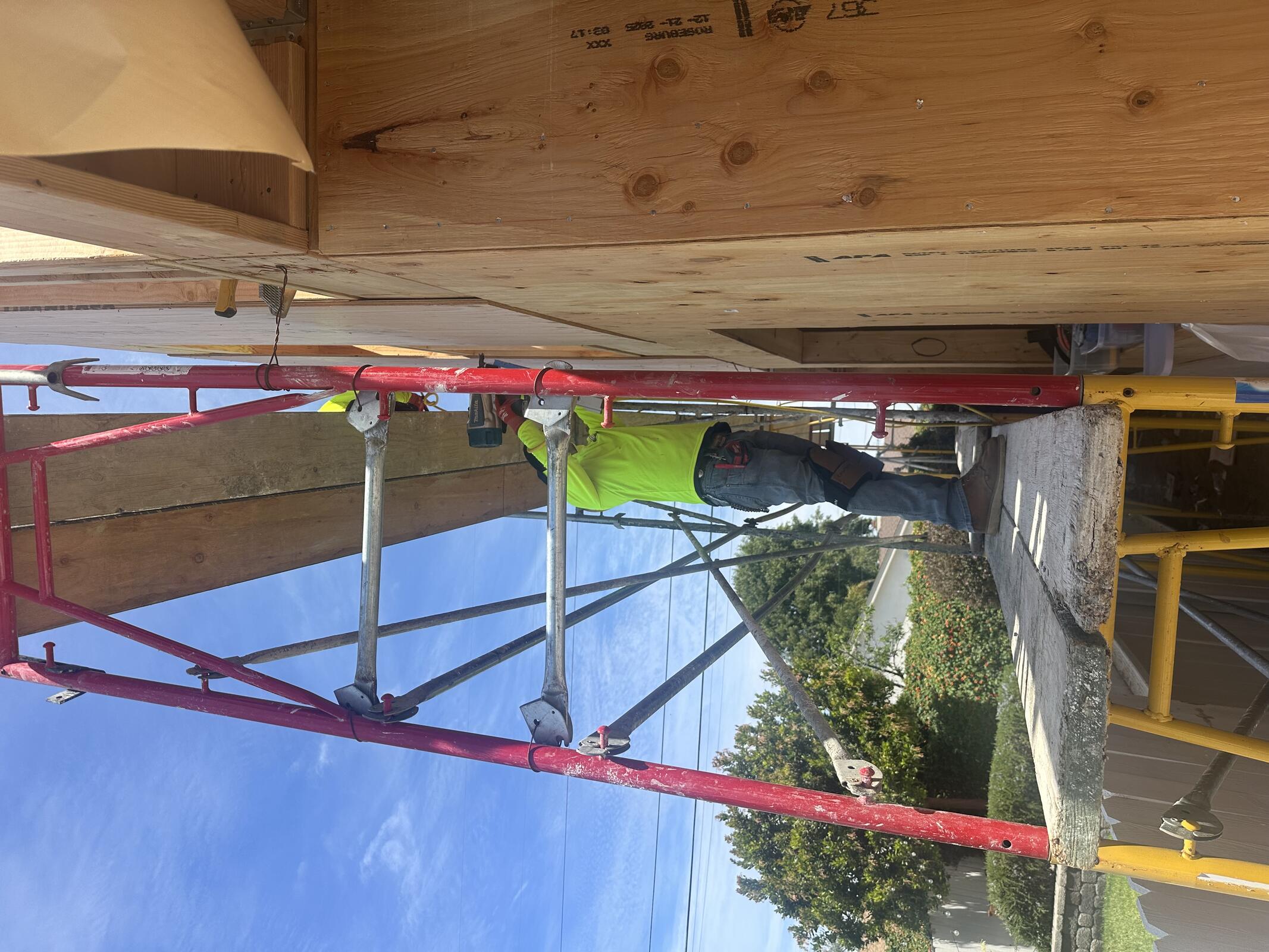

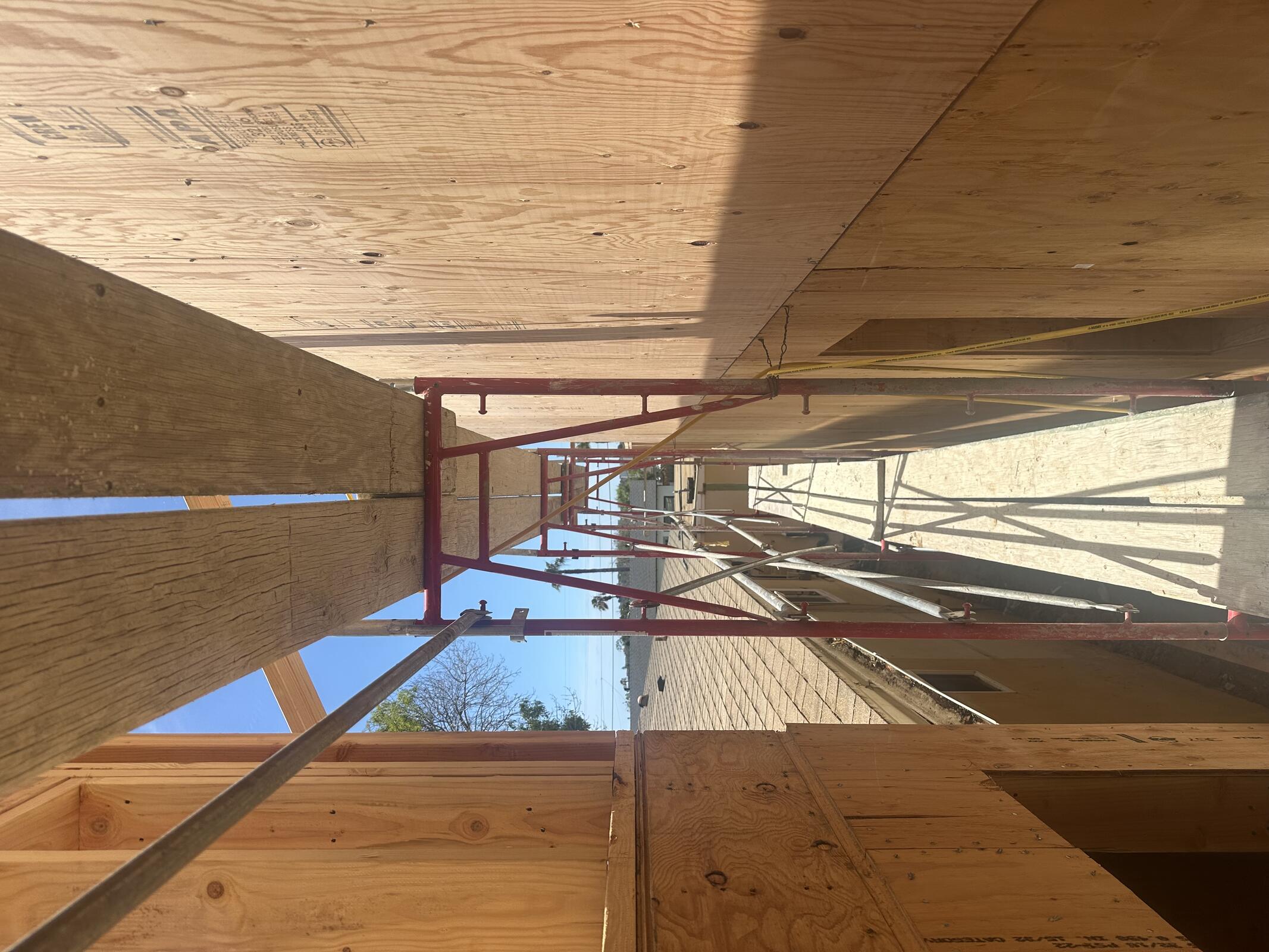

Scaffolding erected between Buildings B and C.

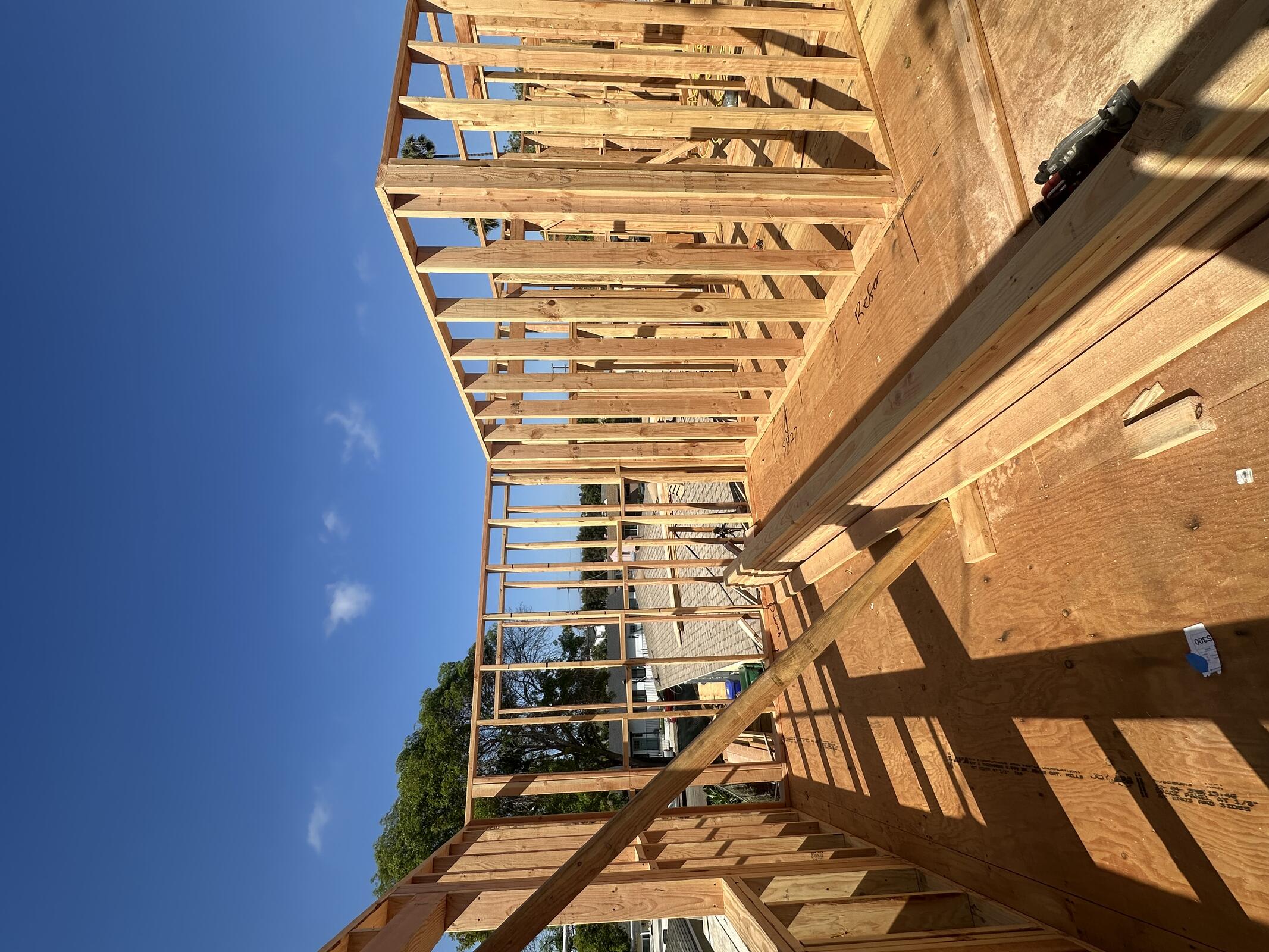

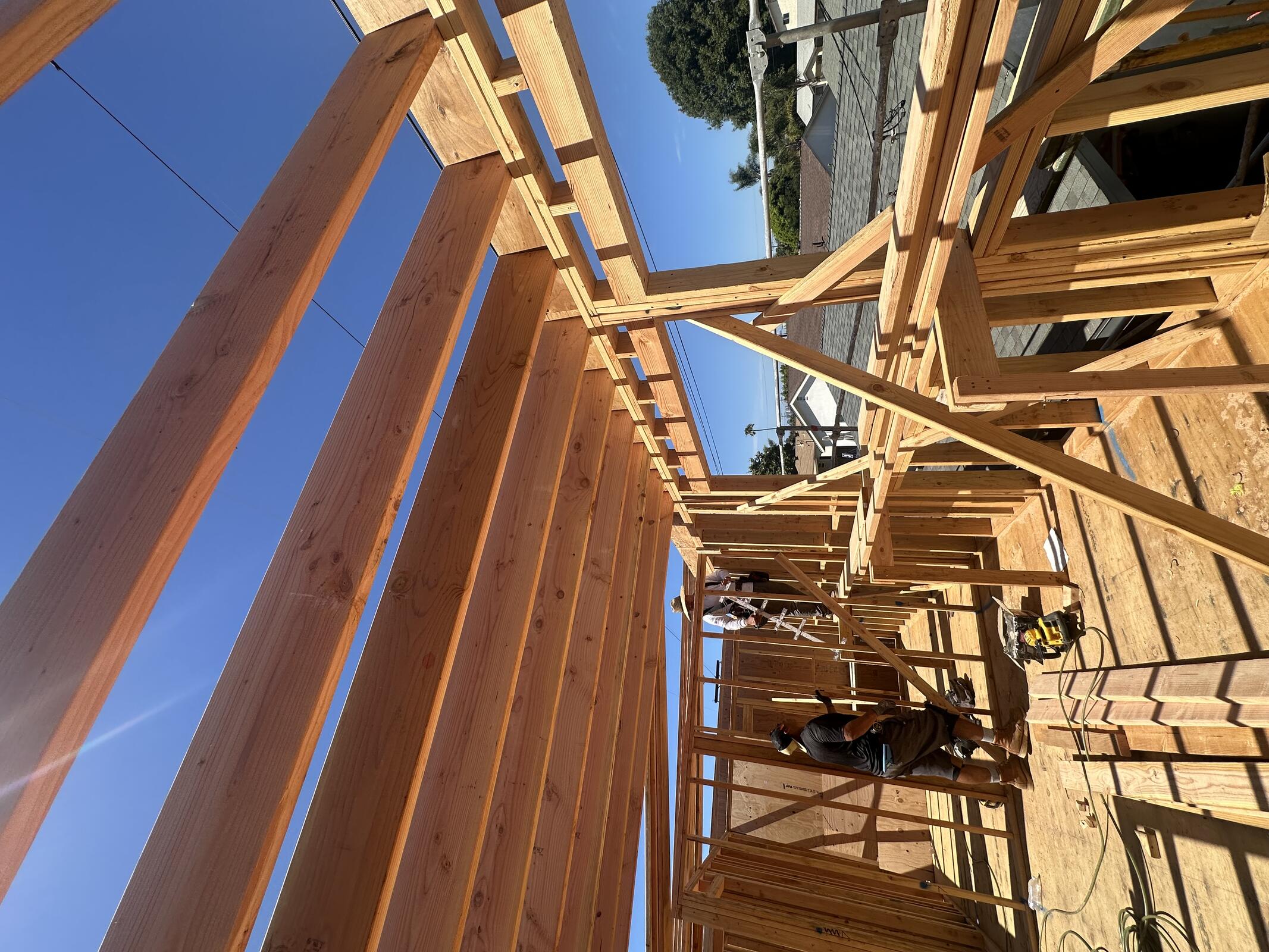

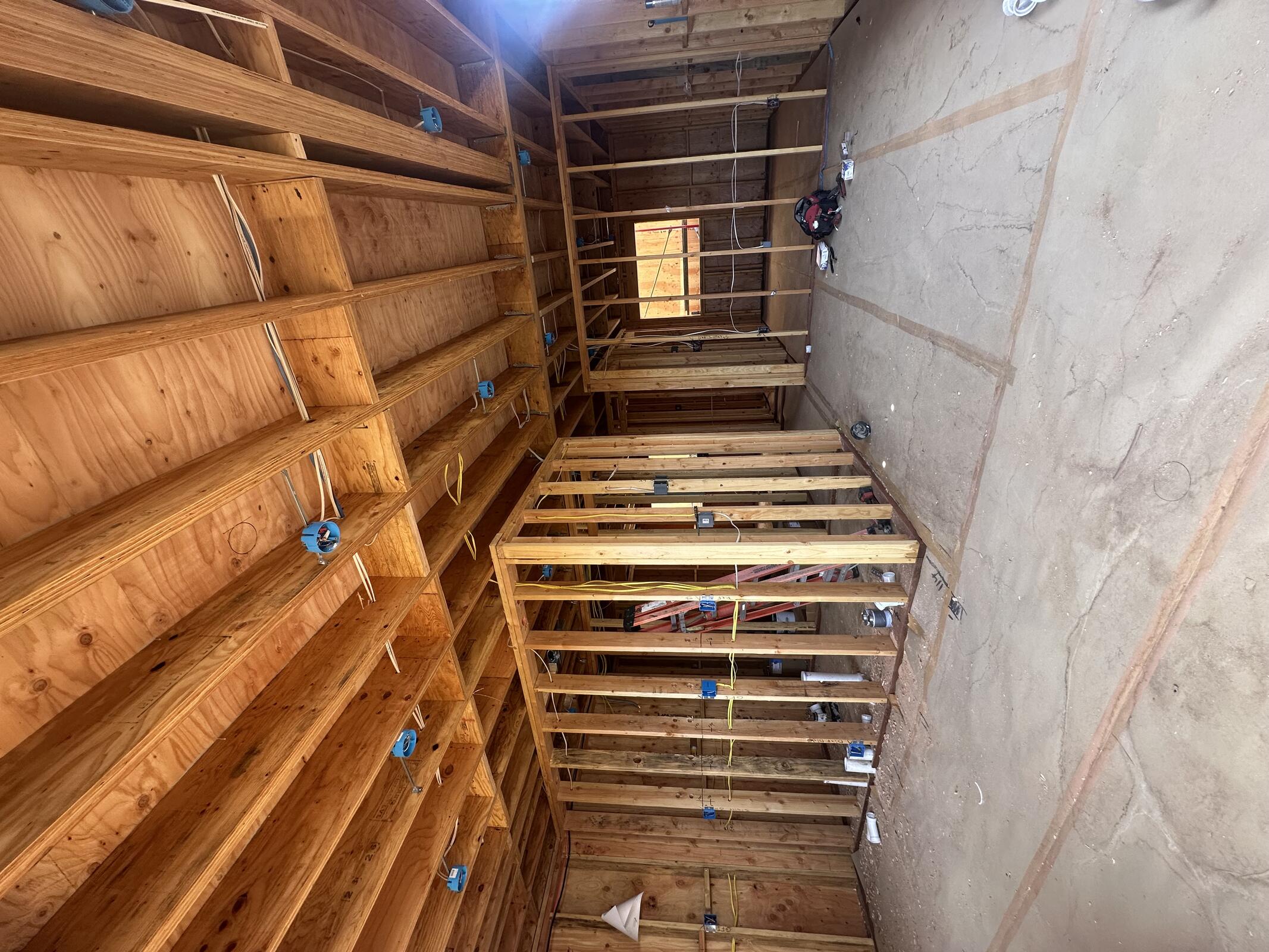

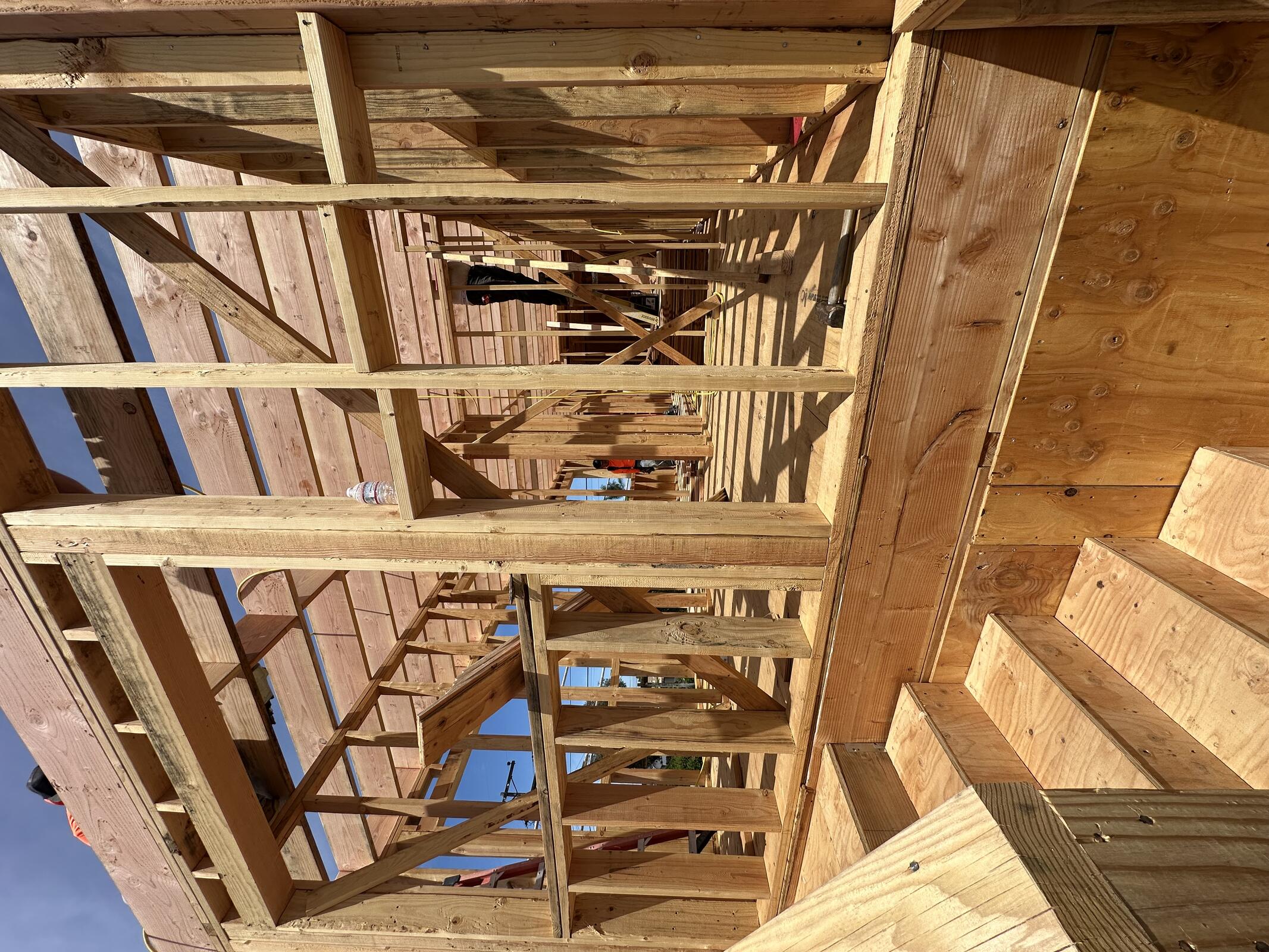

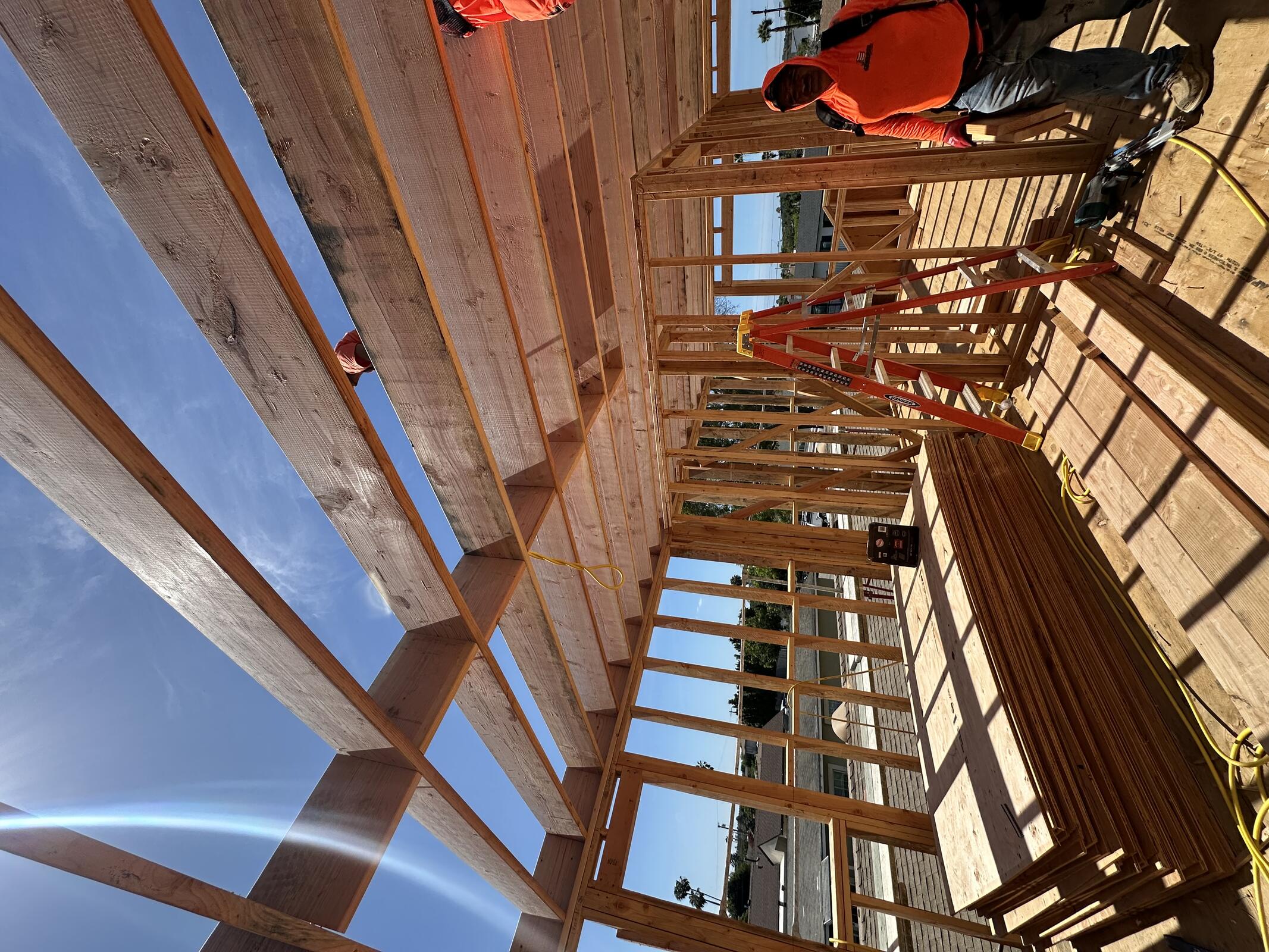

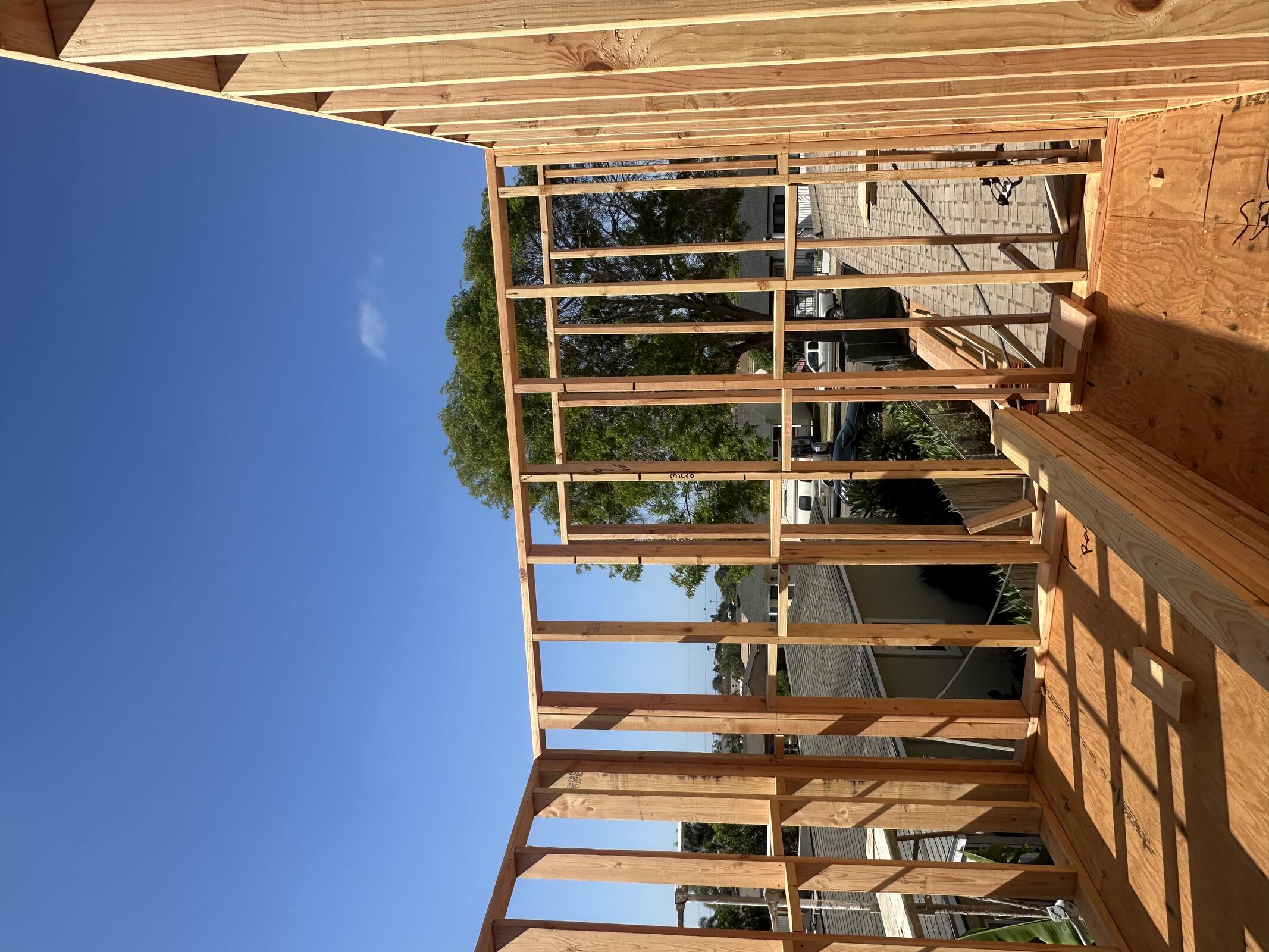

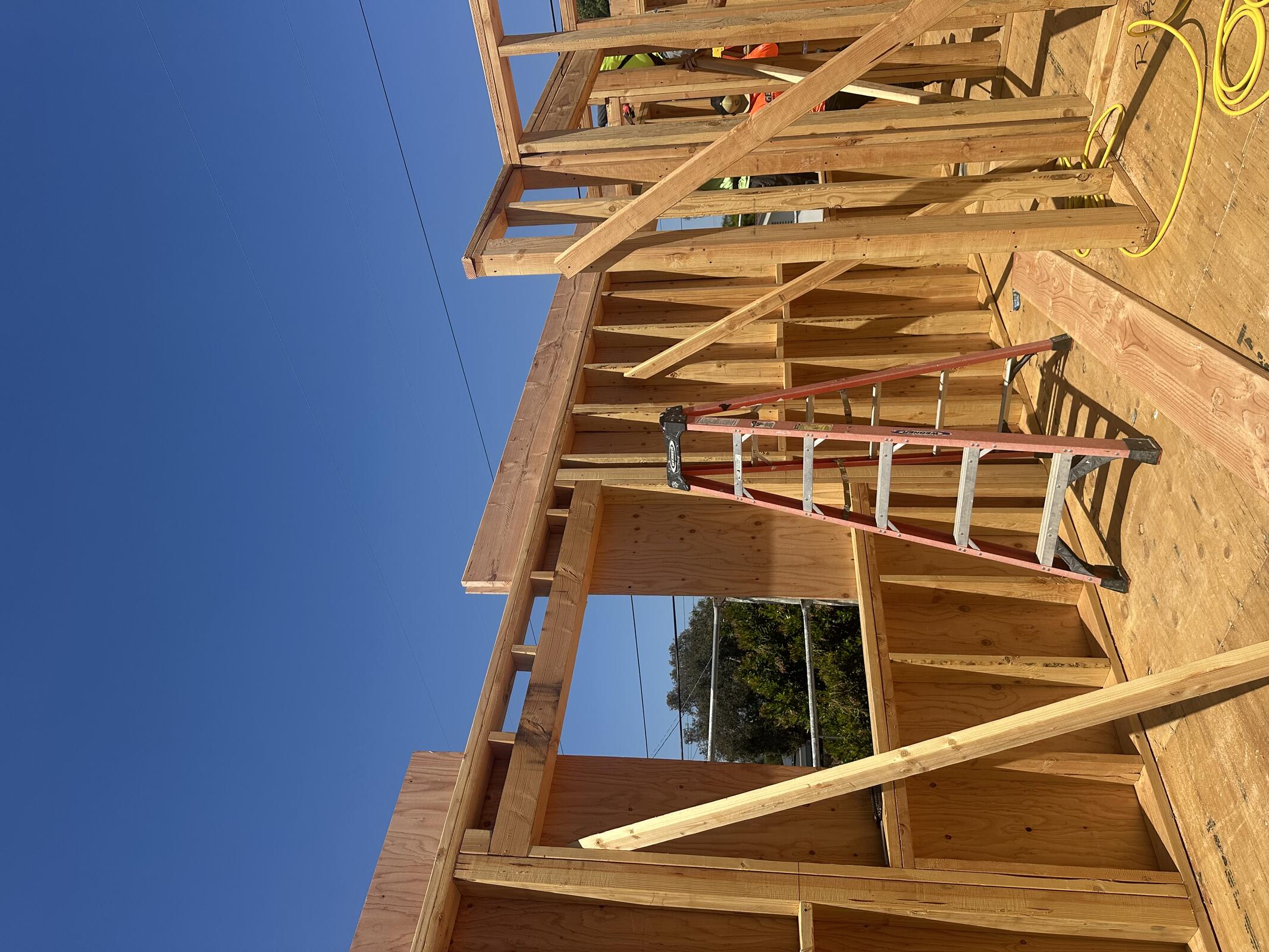

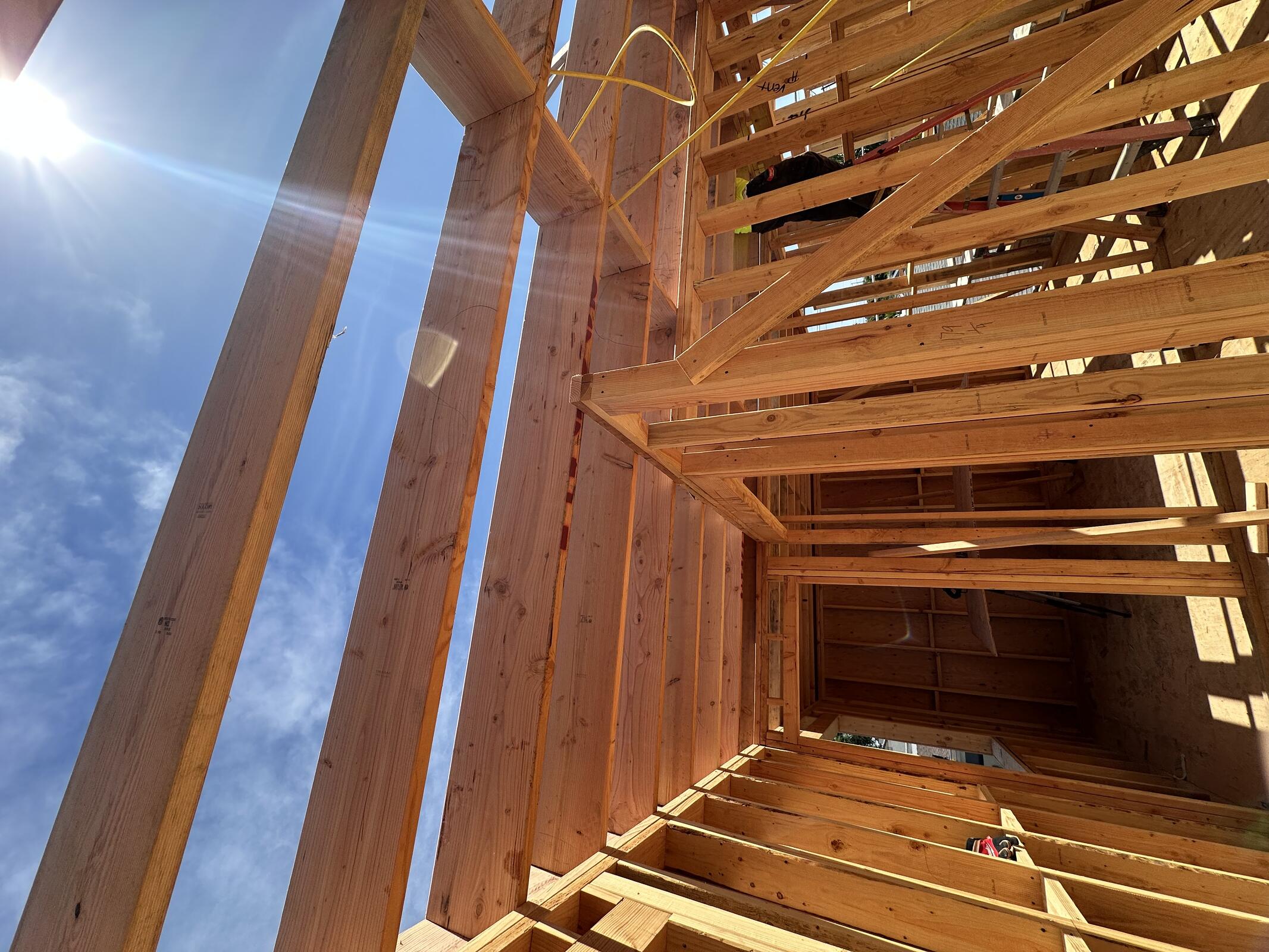

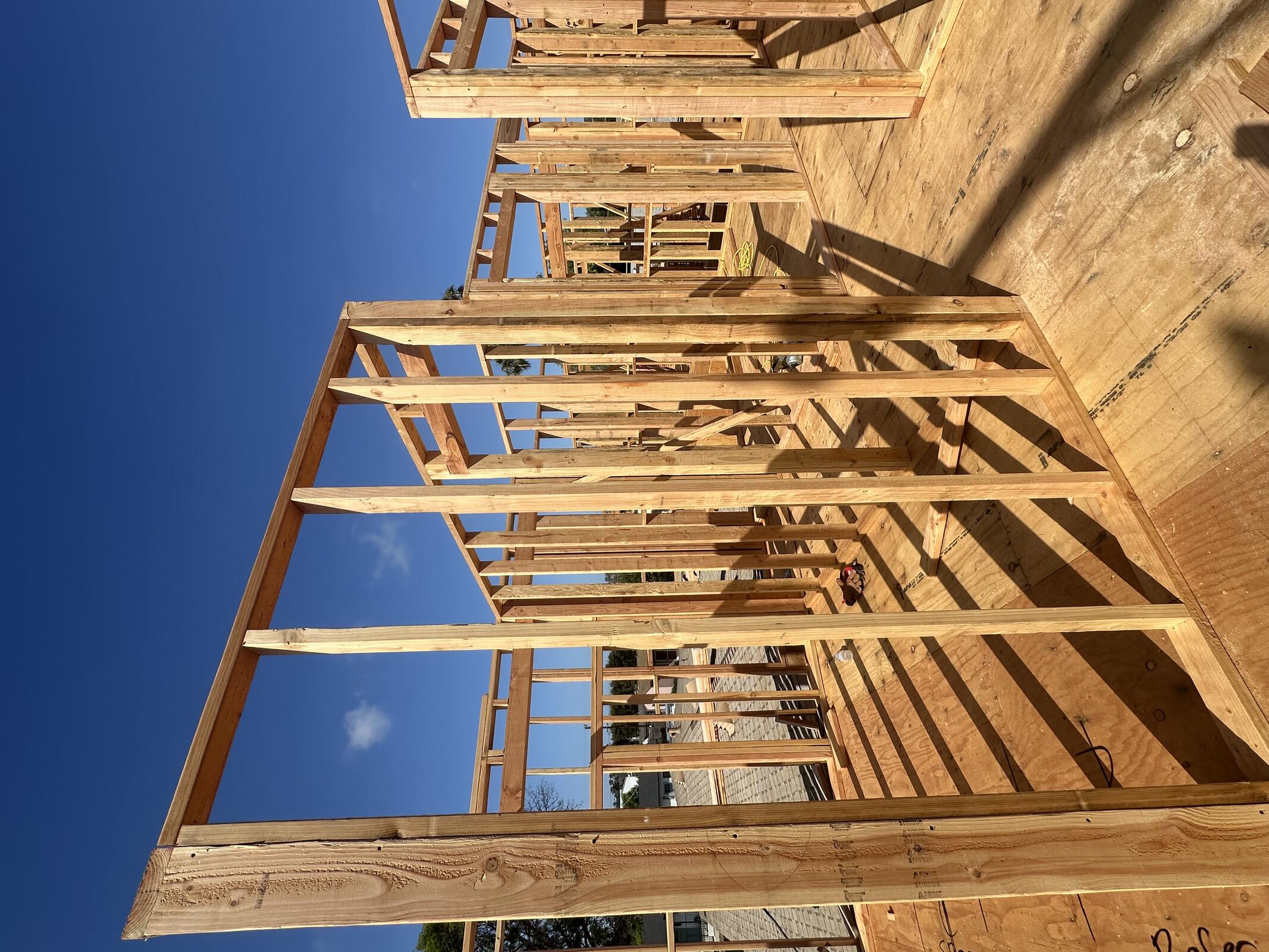

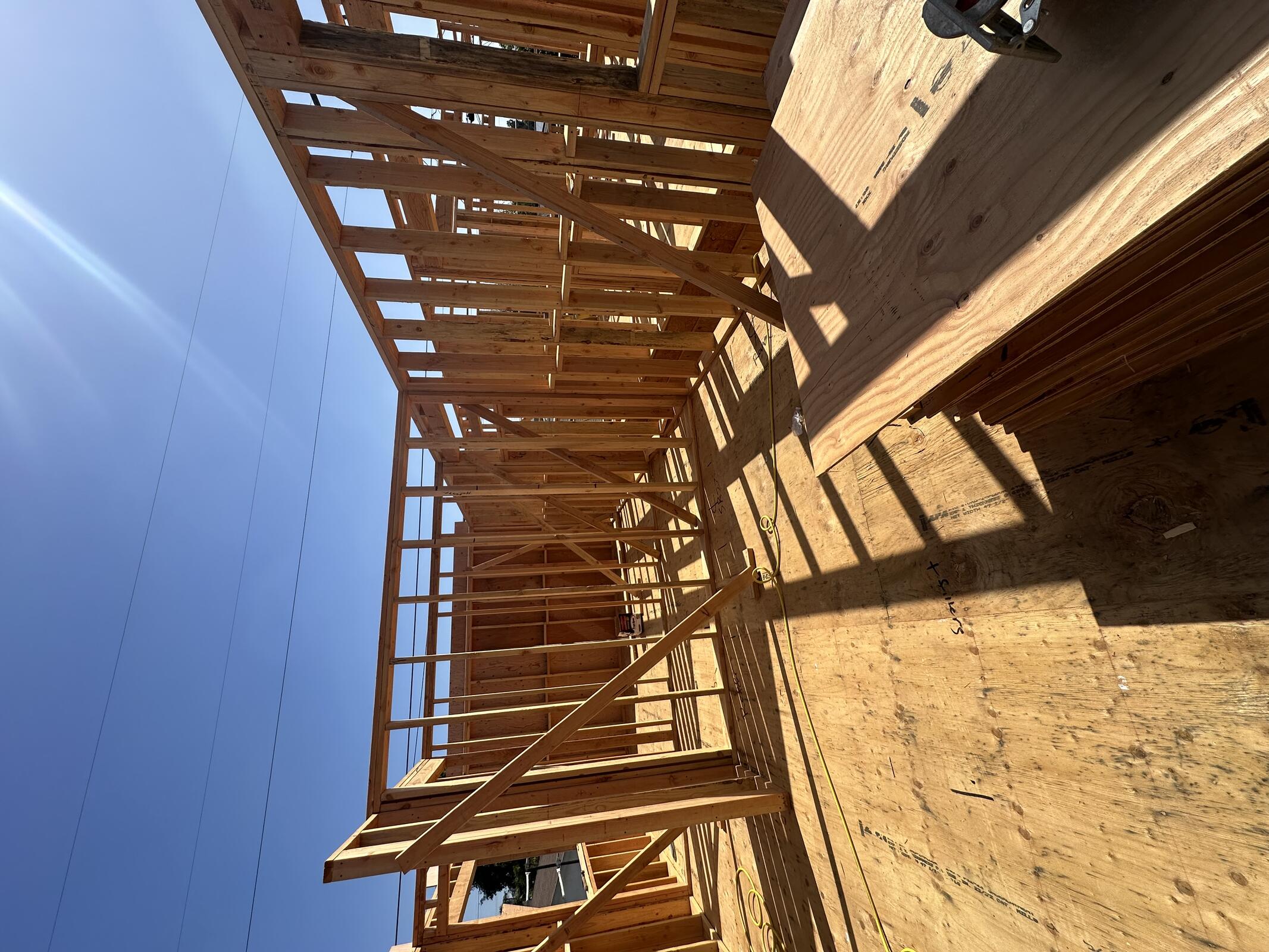

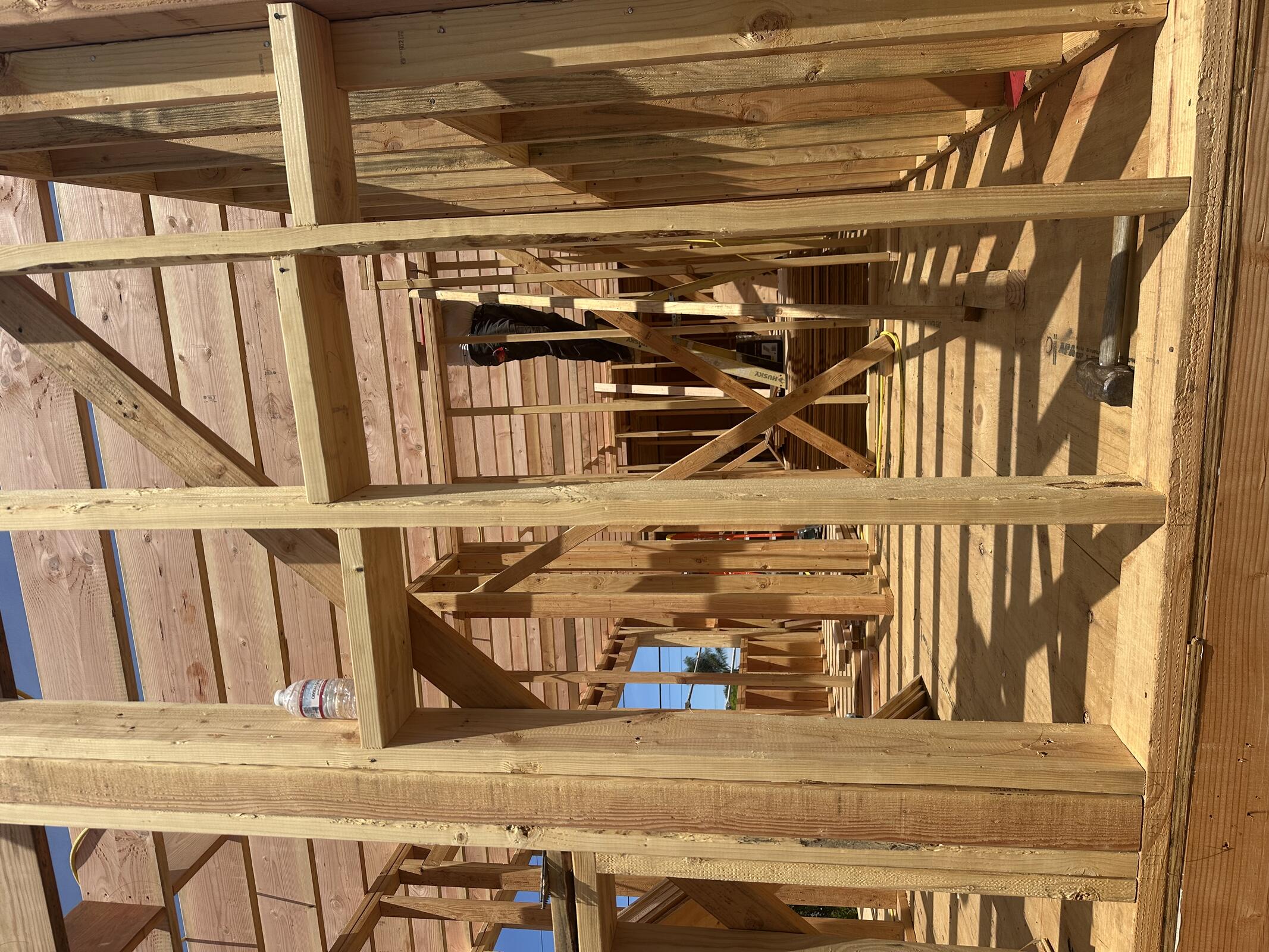

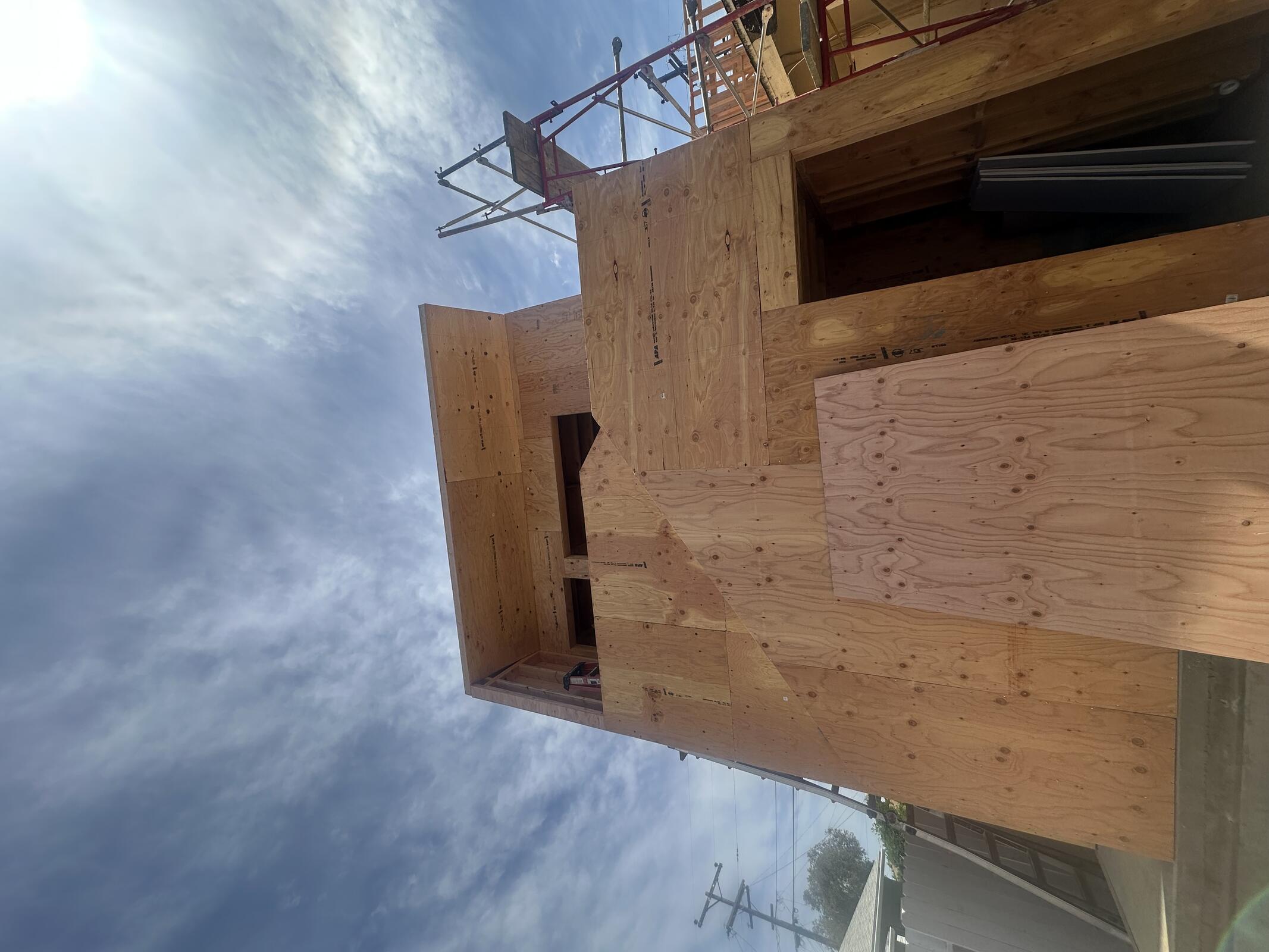

JB General joisting and shearing Building C roof.
Zack Smith working on Building B, Unit 1.

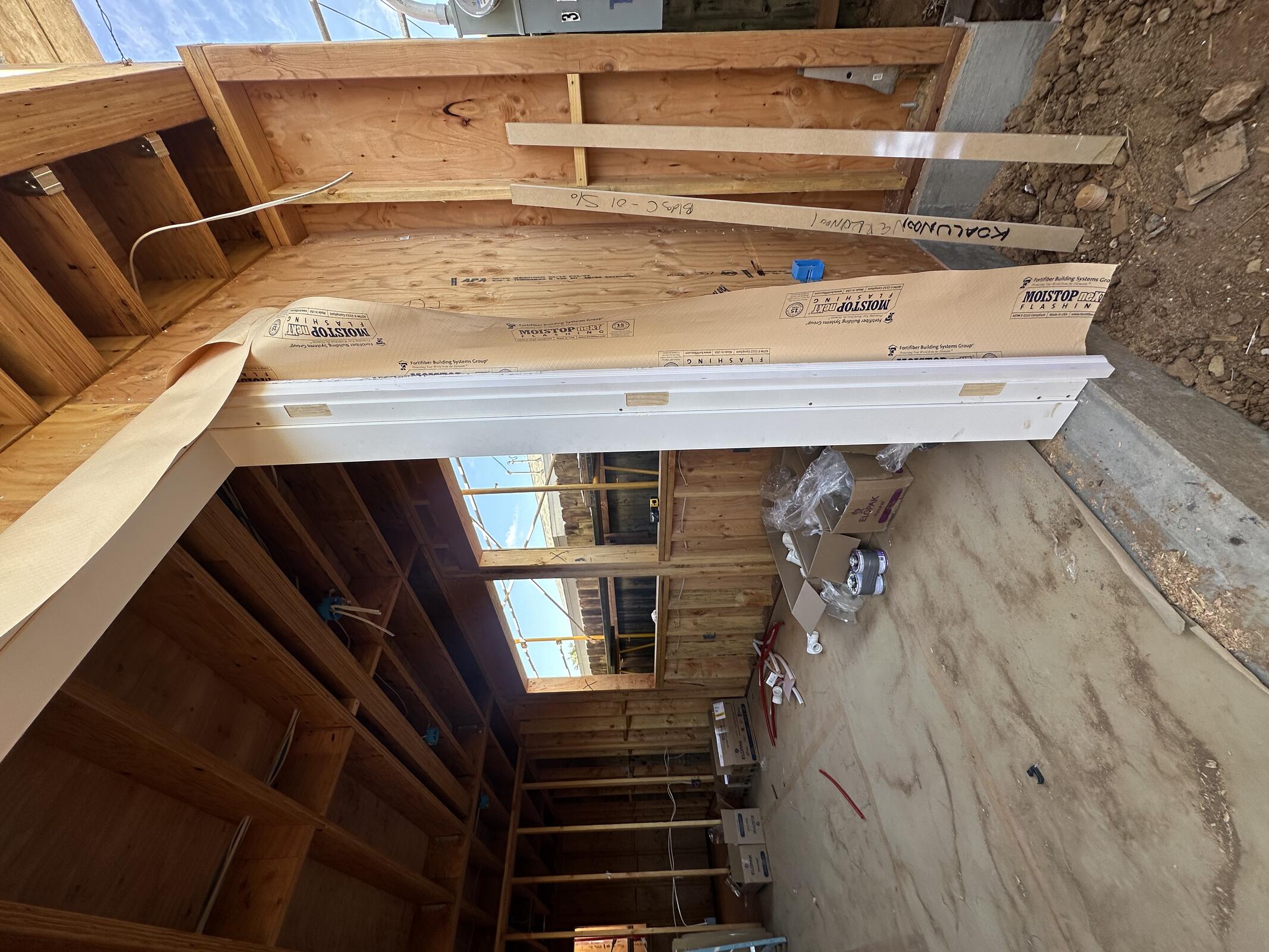

Exterior Door frames delivered
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| JB General | 7 | 8 | 56 |
| AC Electric | 2 | 8 | 16 |
| ZSP | 2 | 8 | 16 |
Inspection: N/A














Wednesday, April 22, 2026
Partially cloudy, 67°F

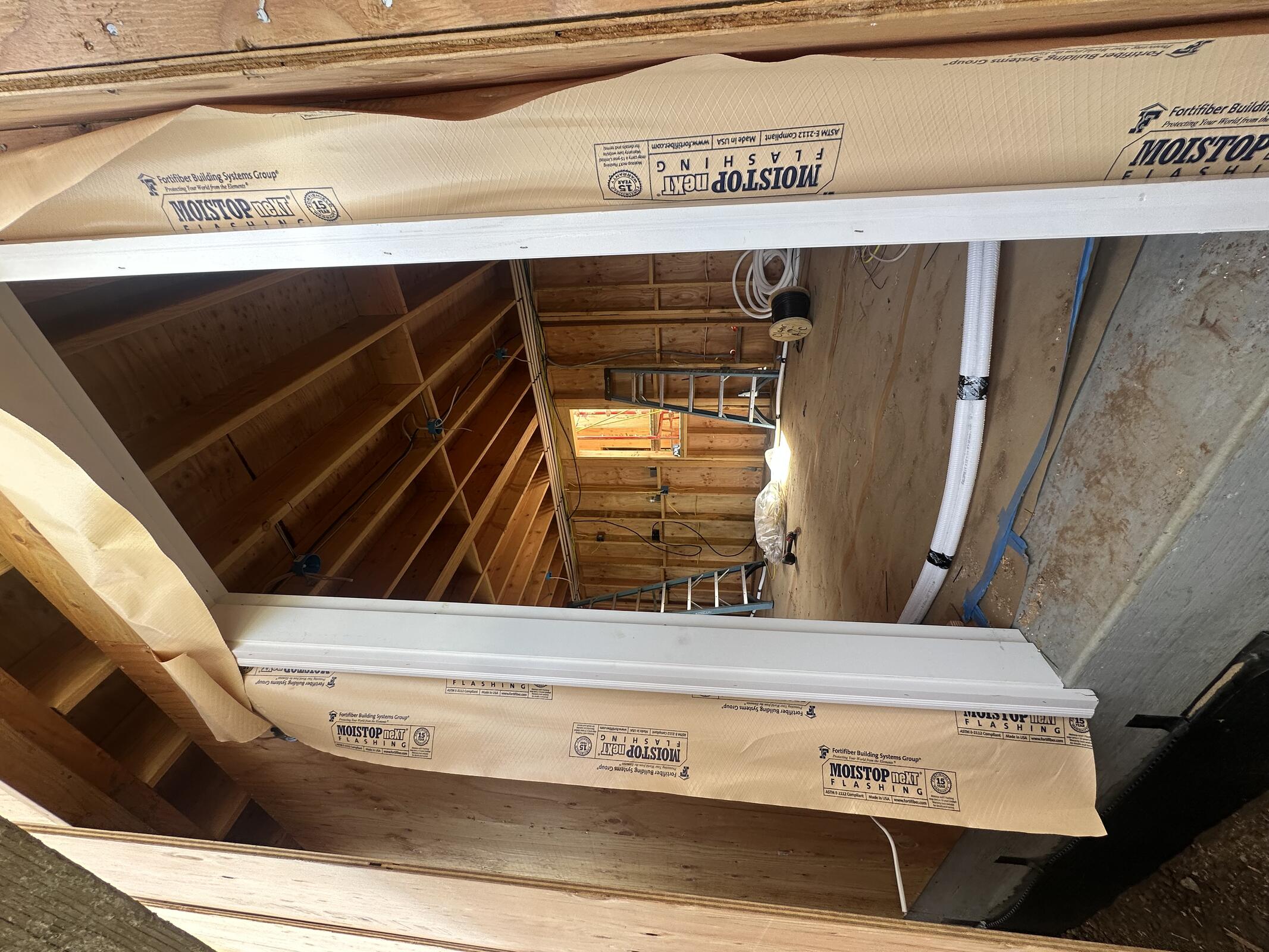

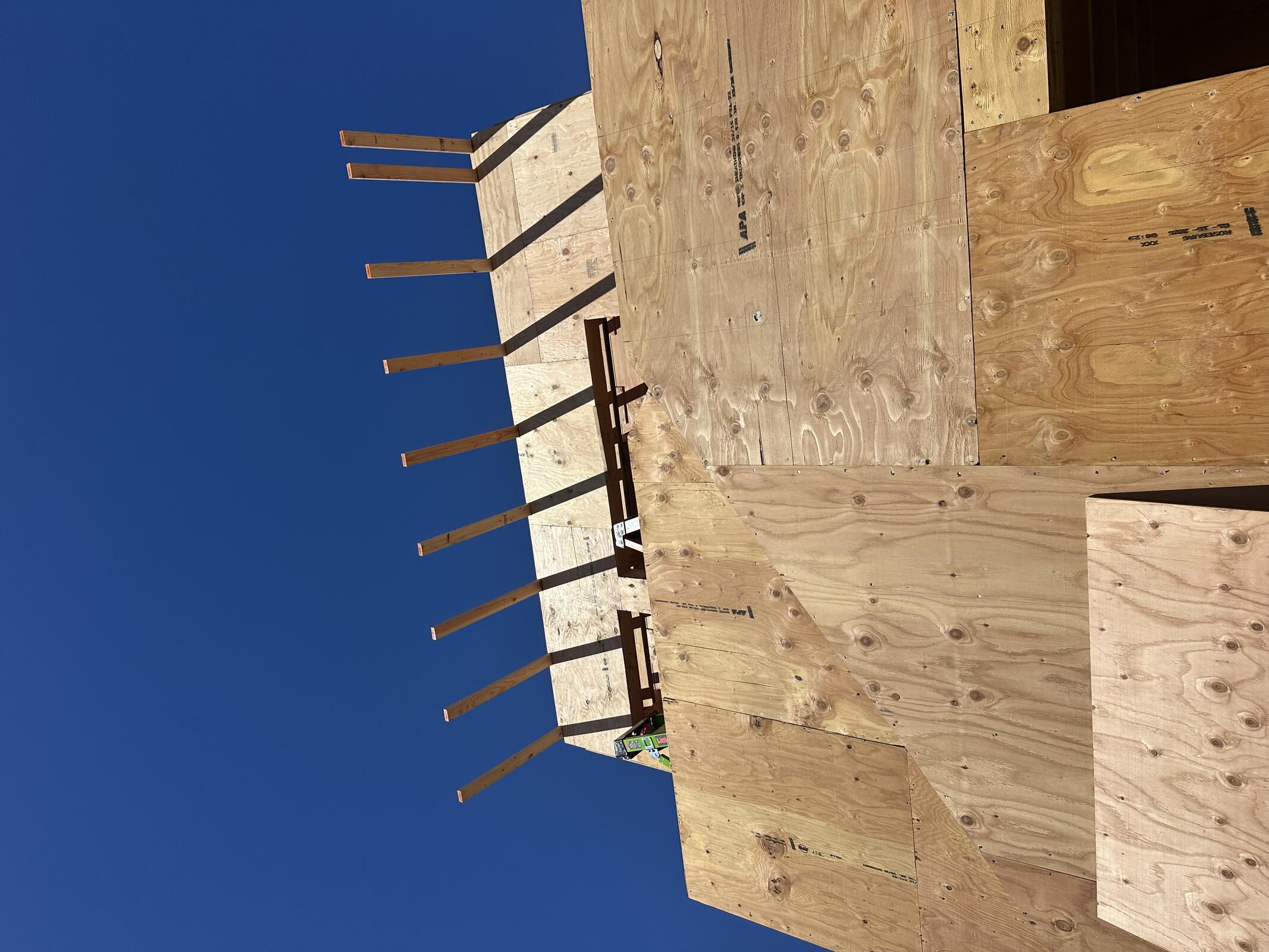

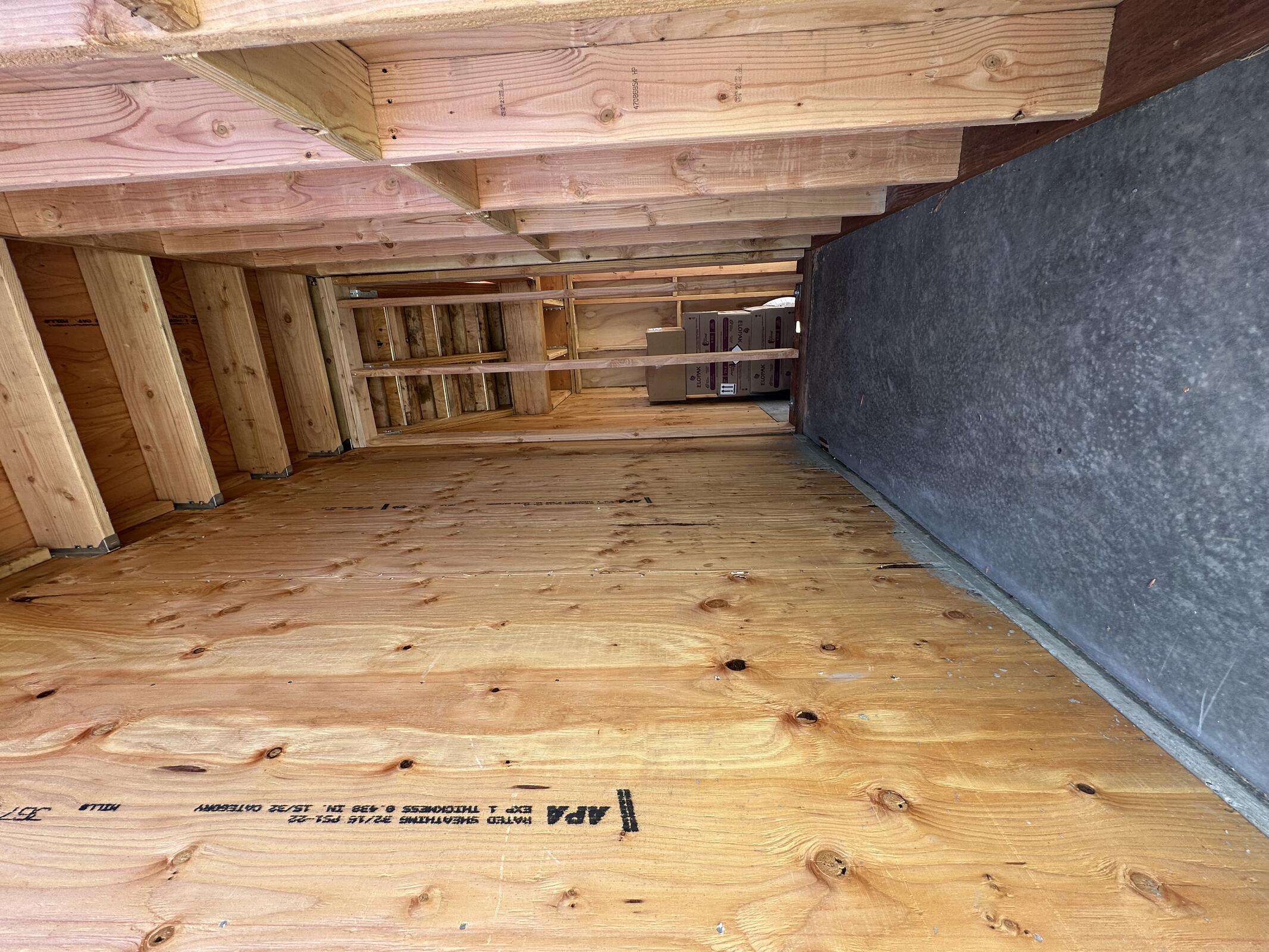

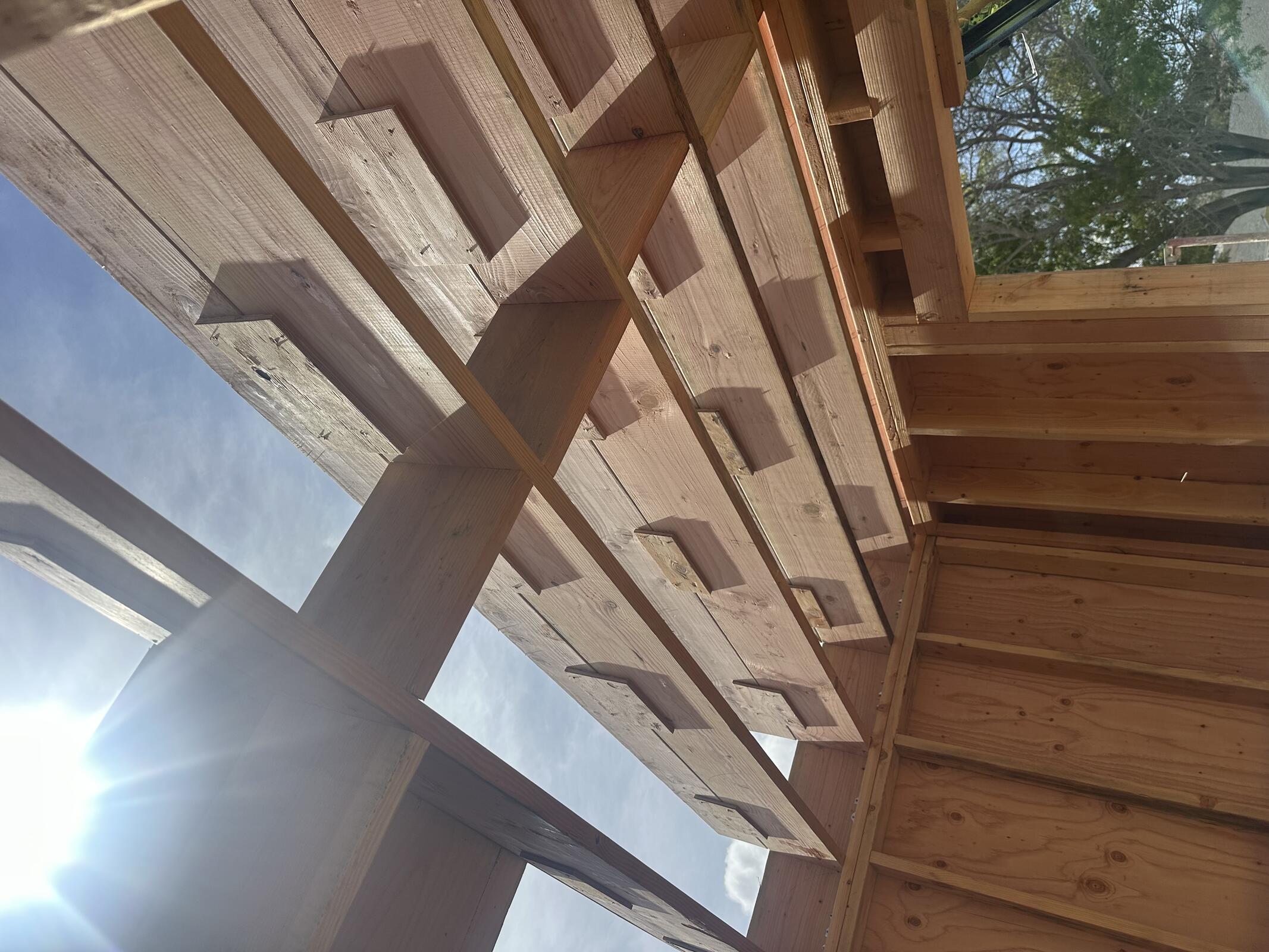

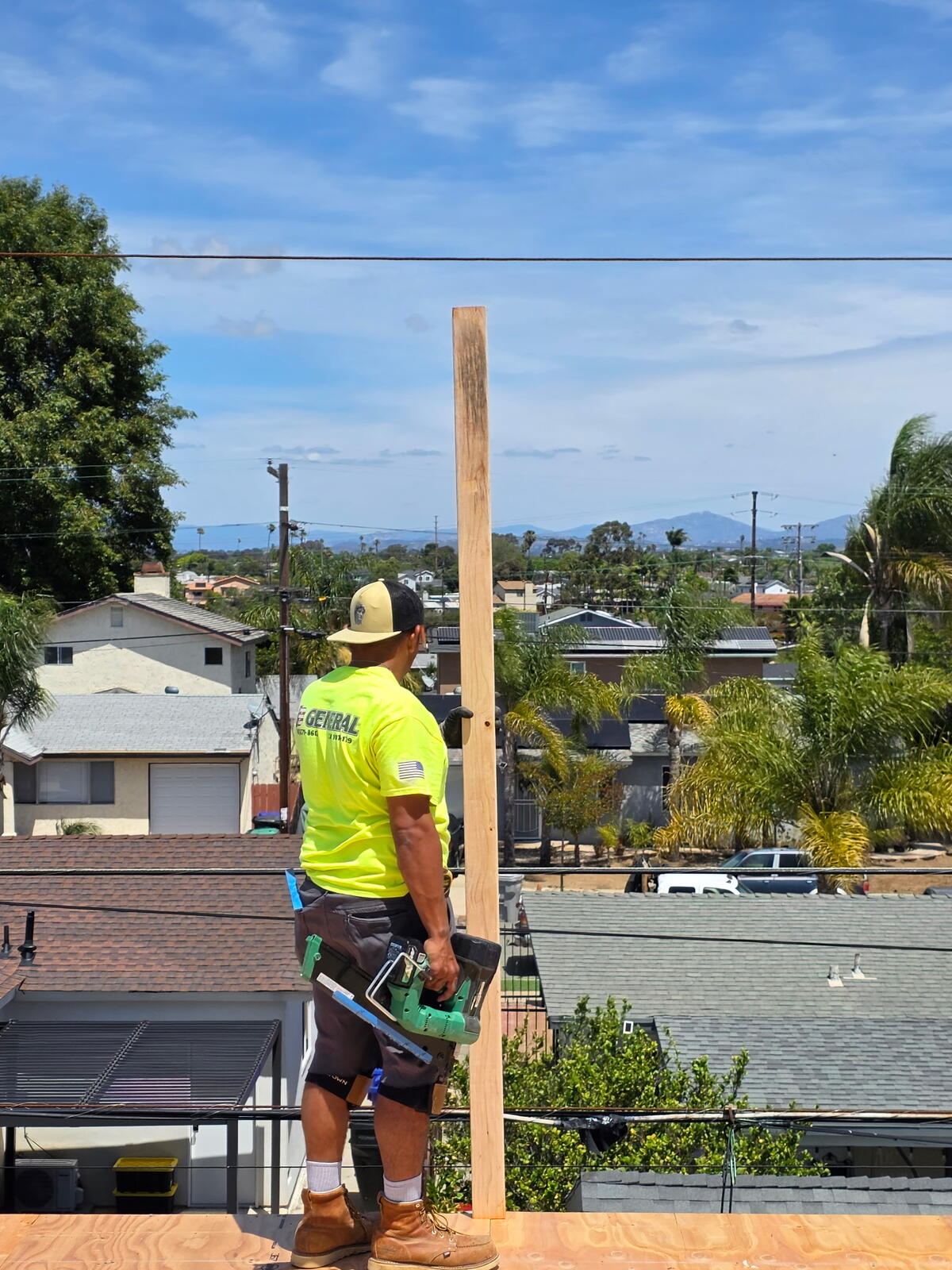

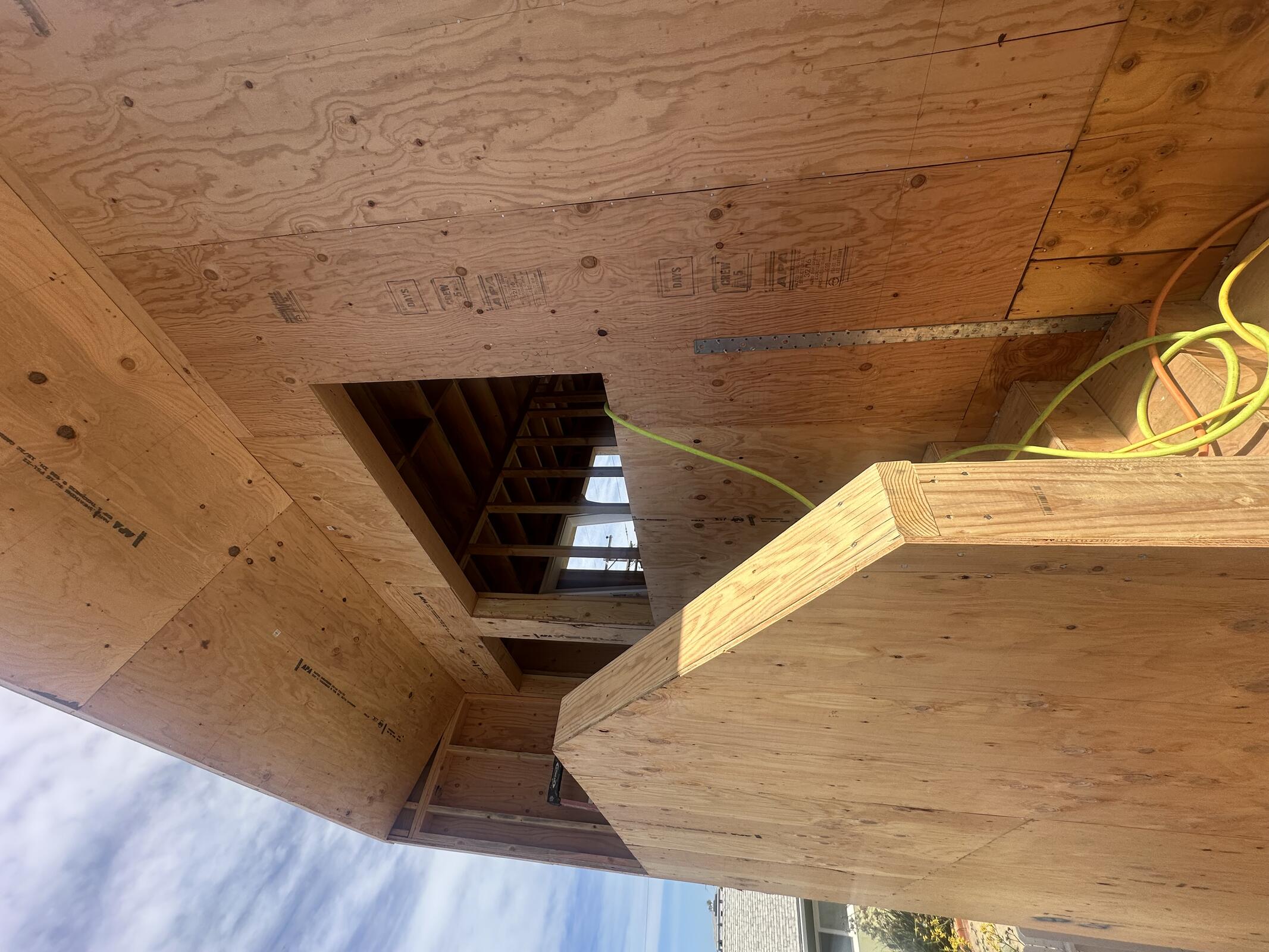

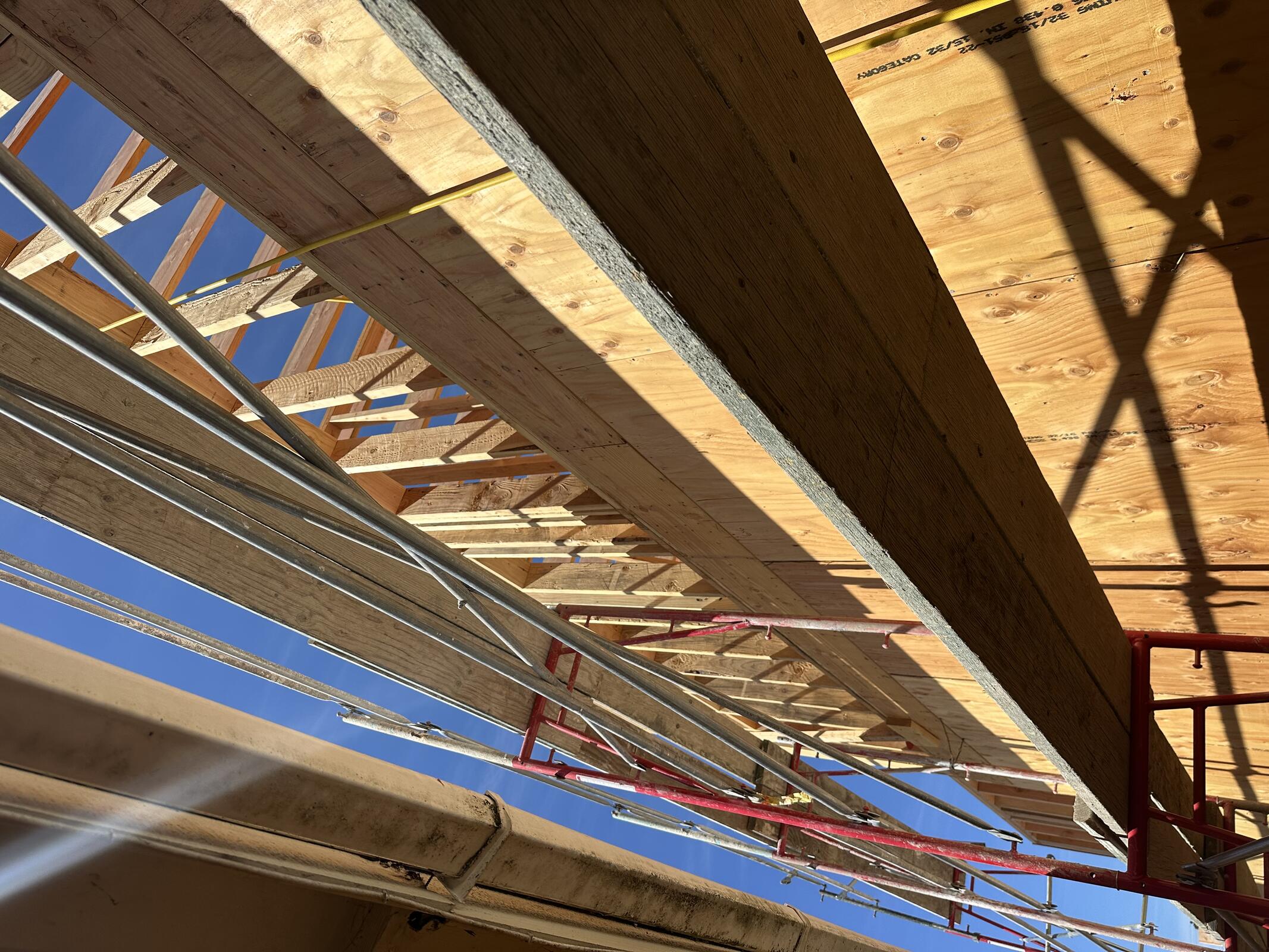

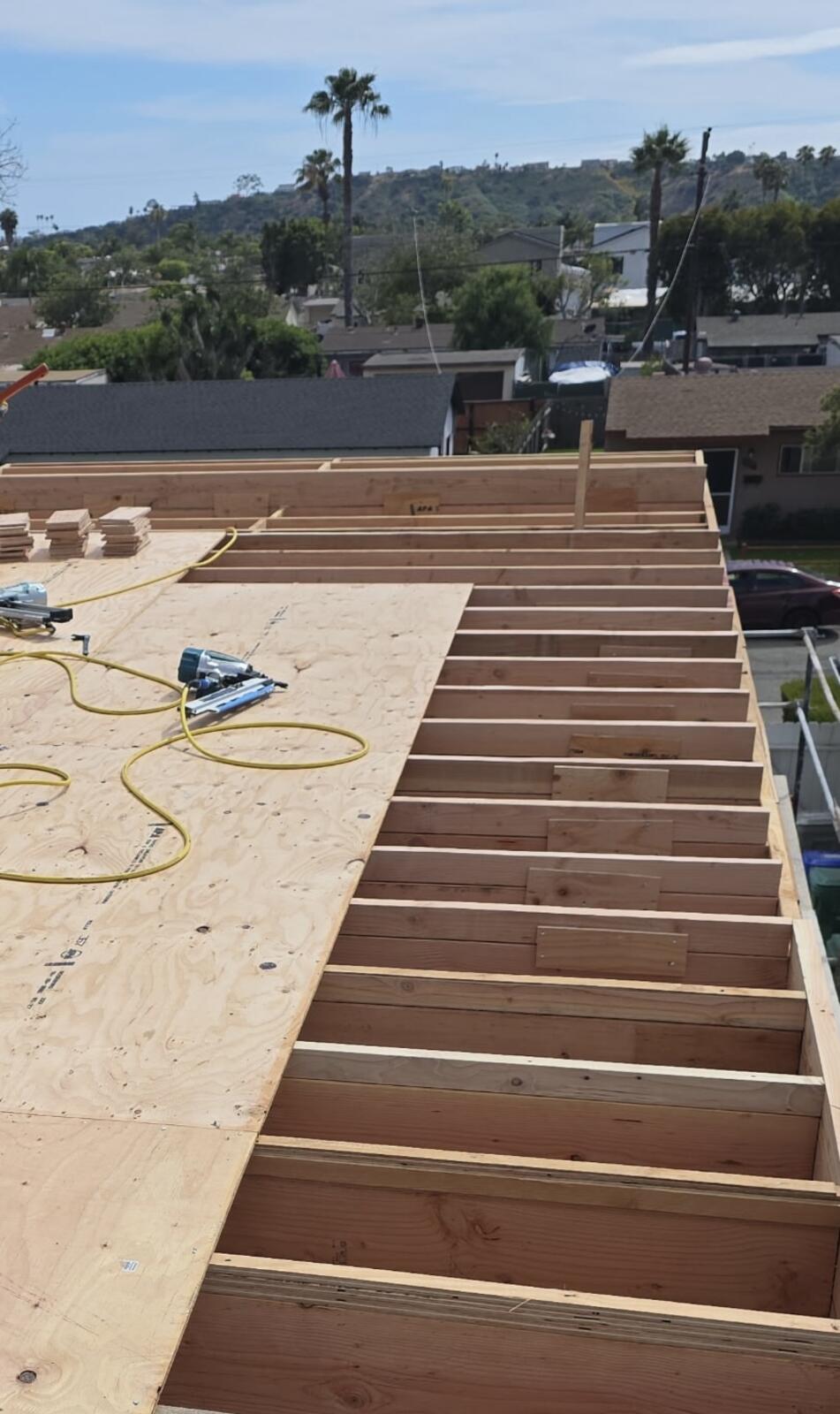

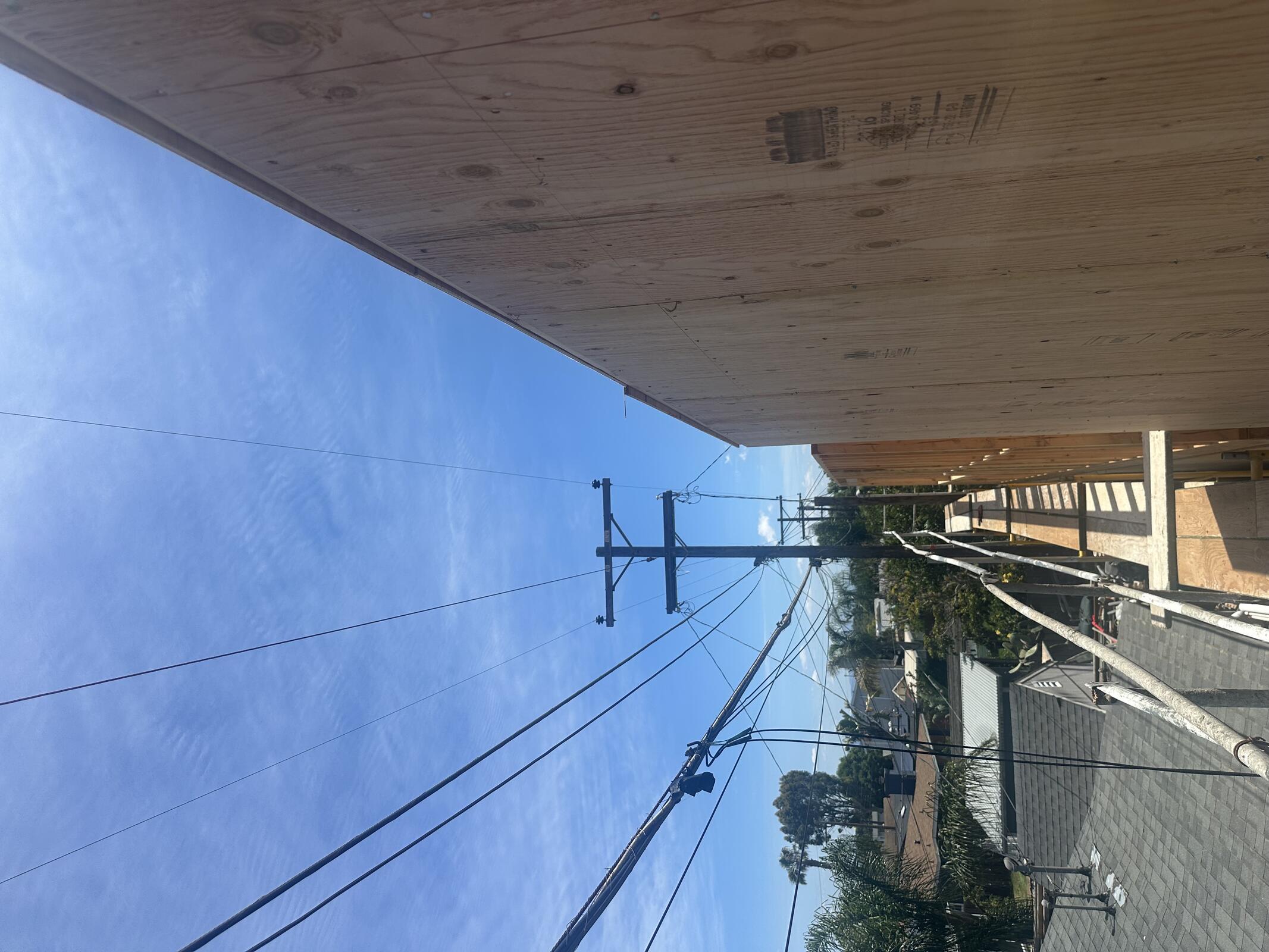

JB General on site, finishing up shear and roof plywood on Structure C. See attached exhibit showing clearance from lower OH power lines.

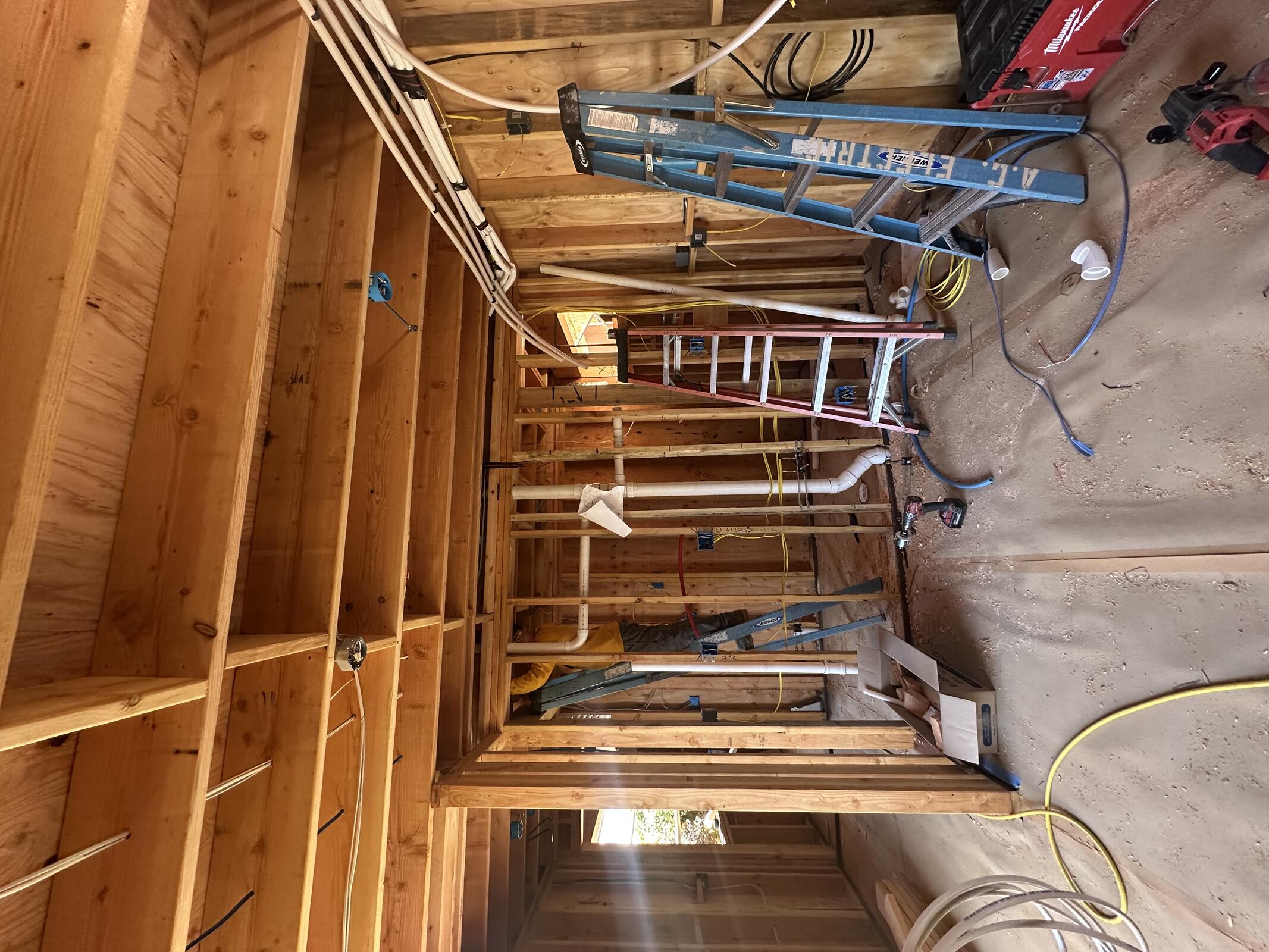

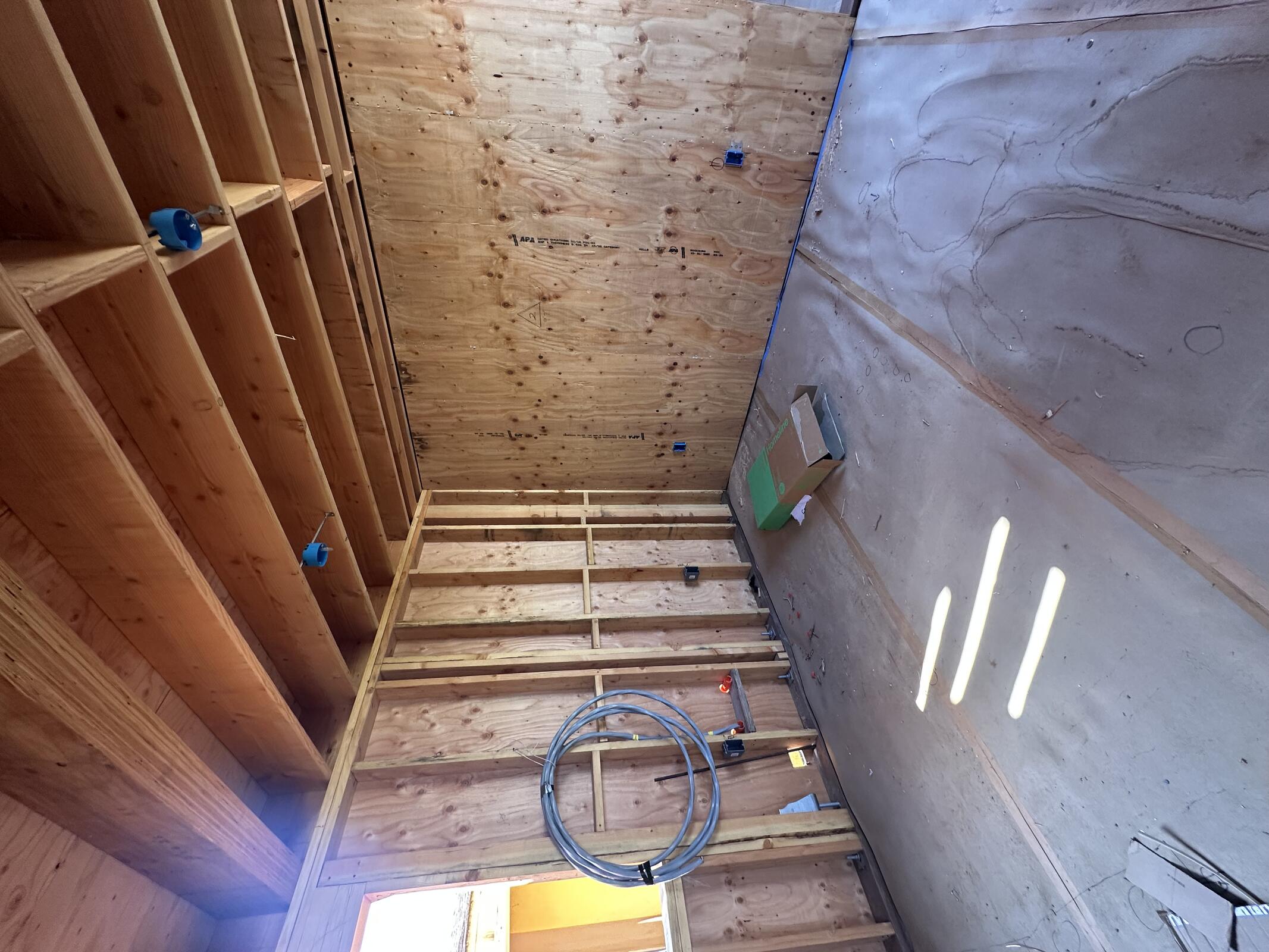

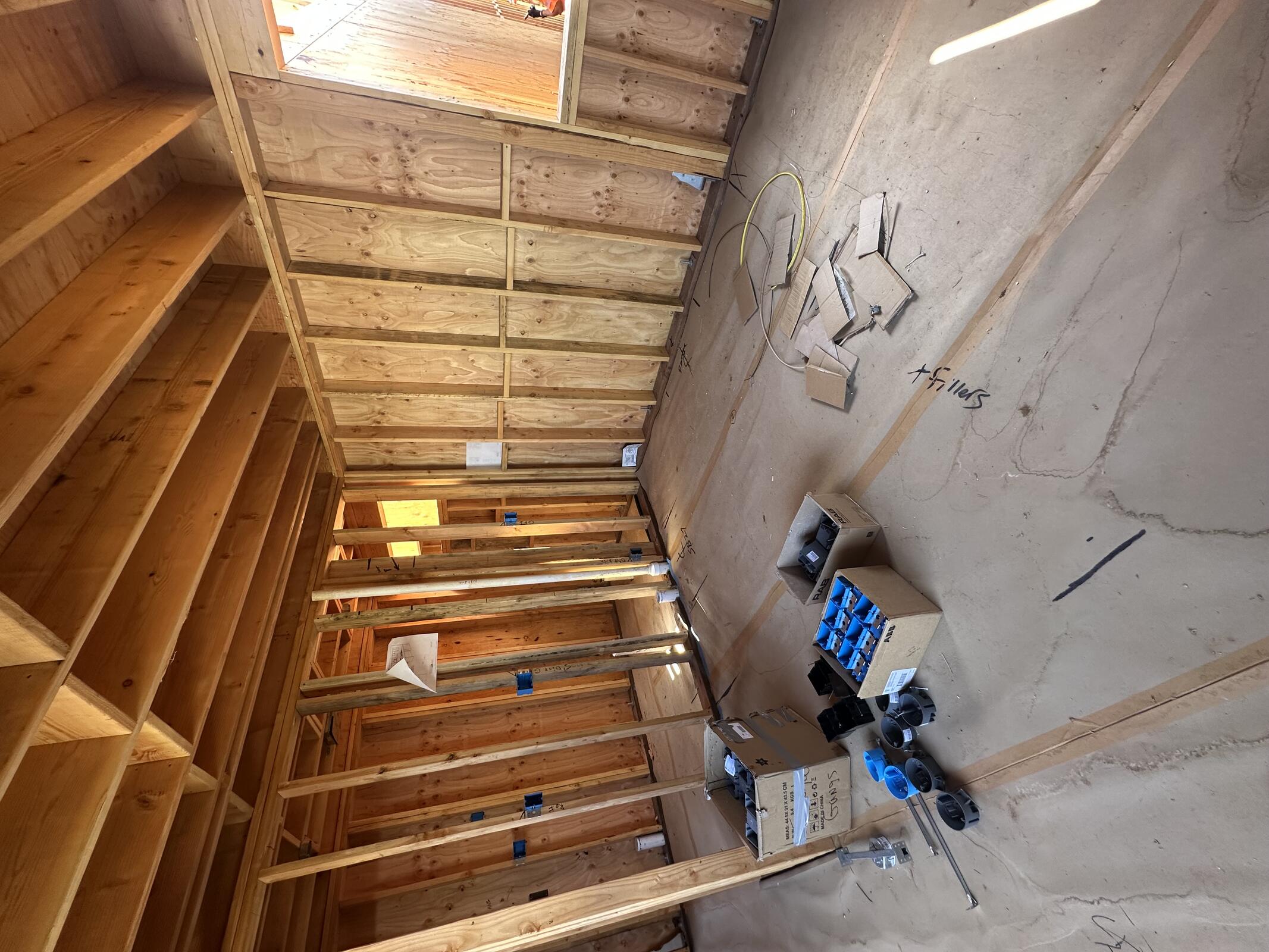

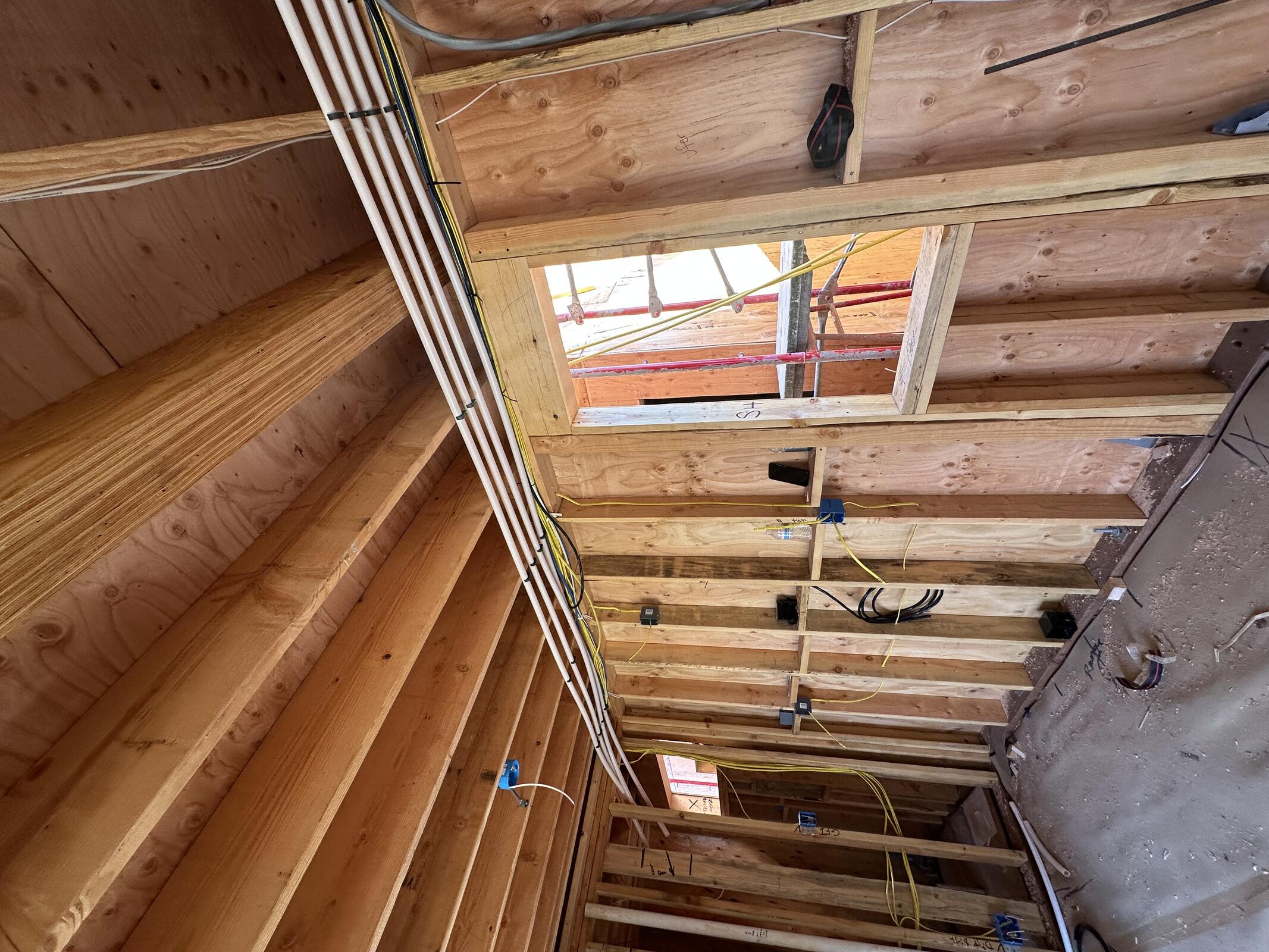

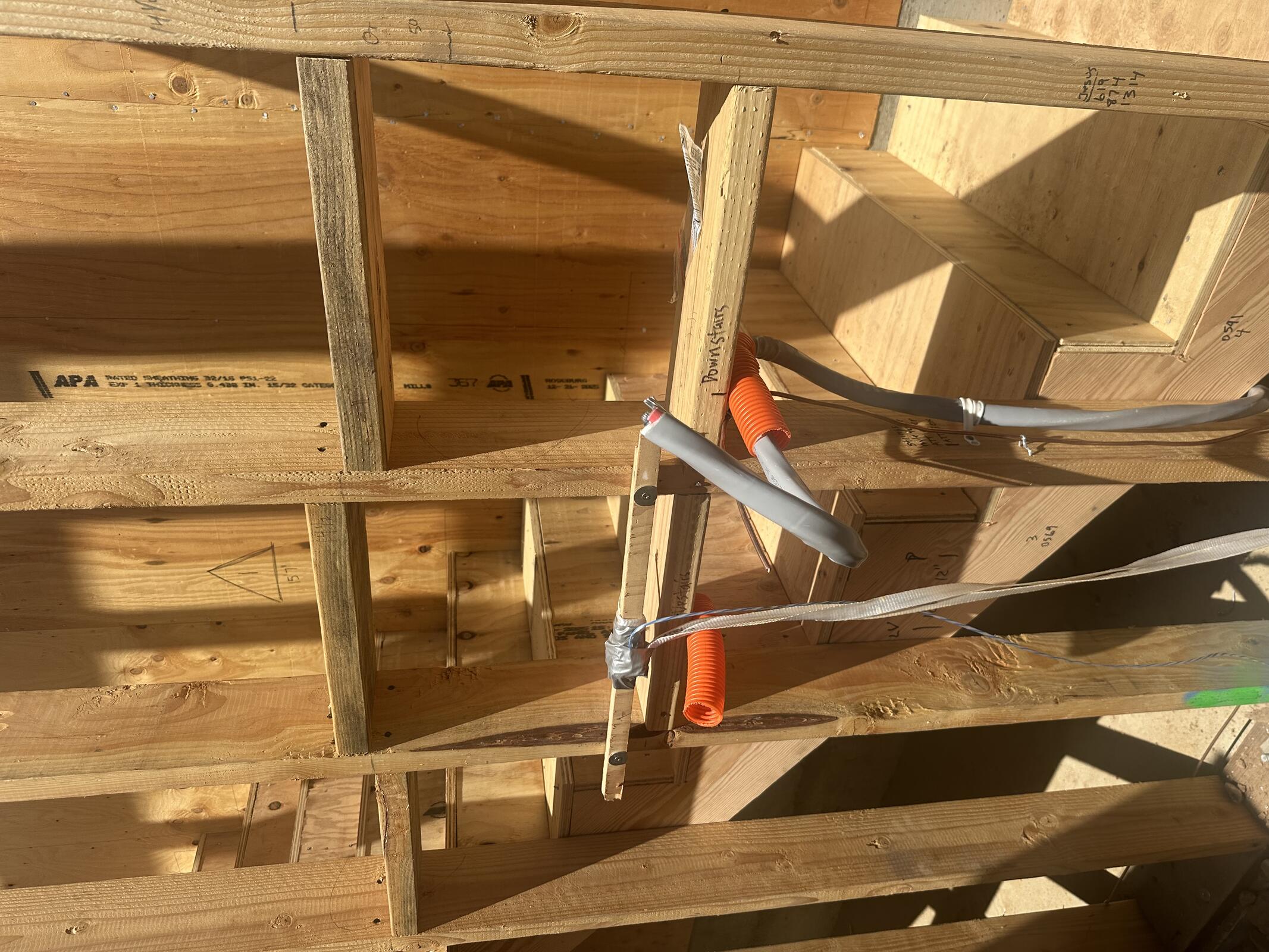

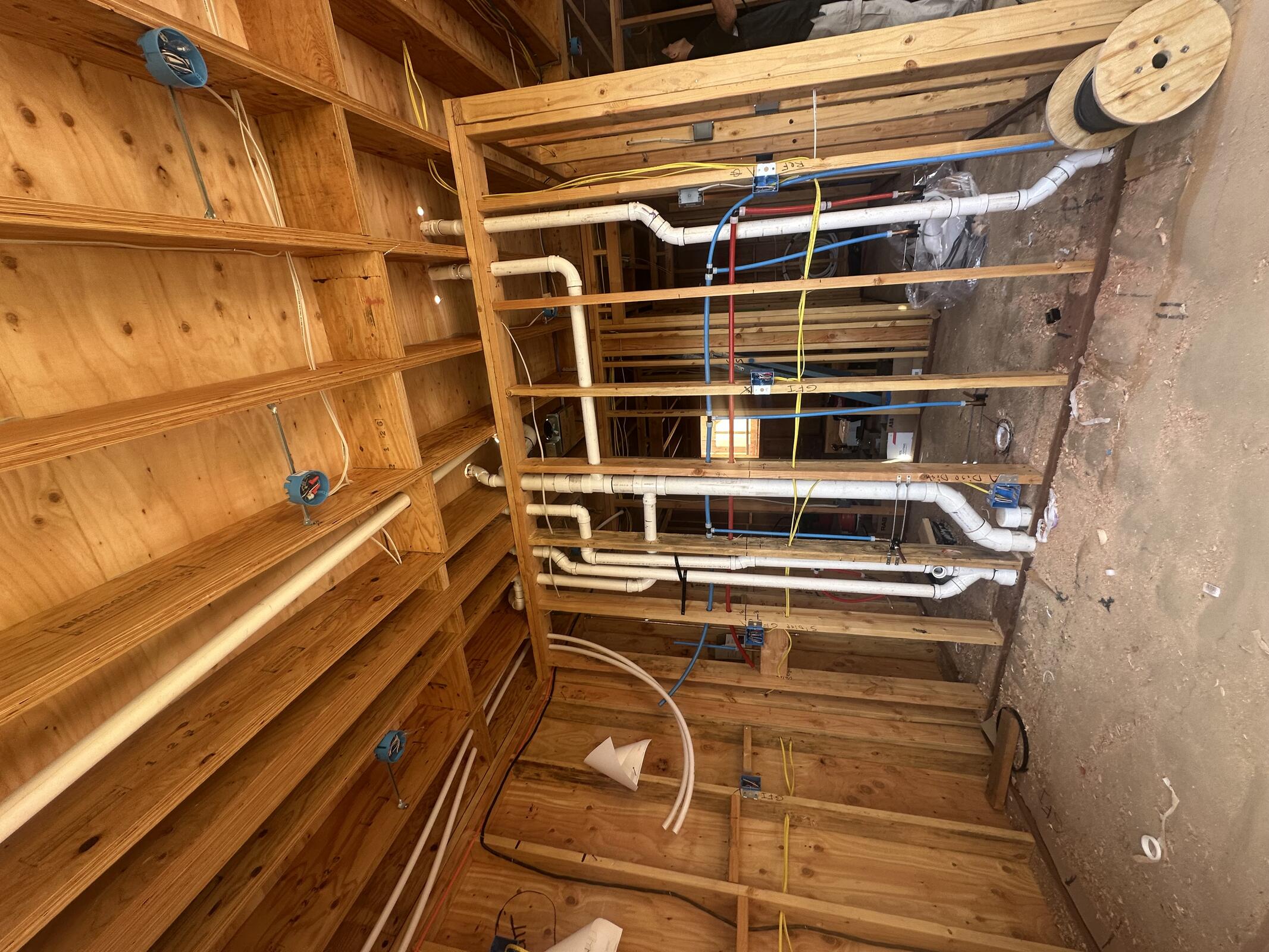

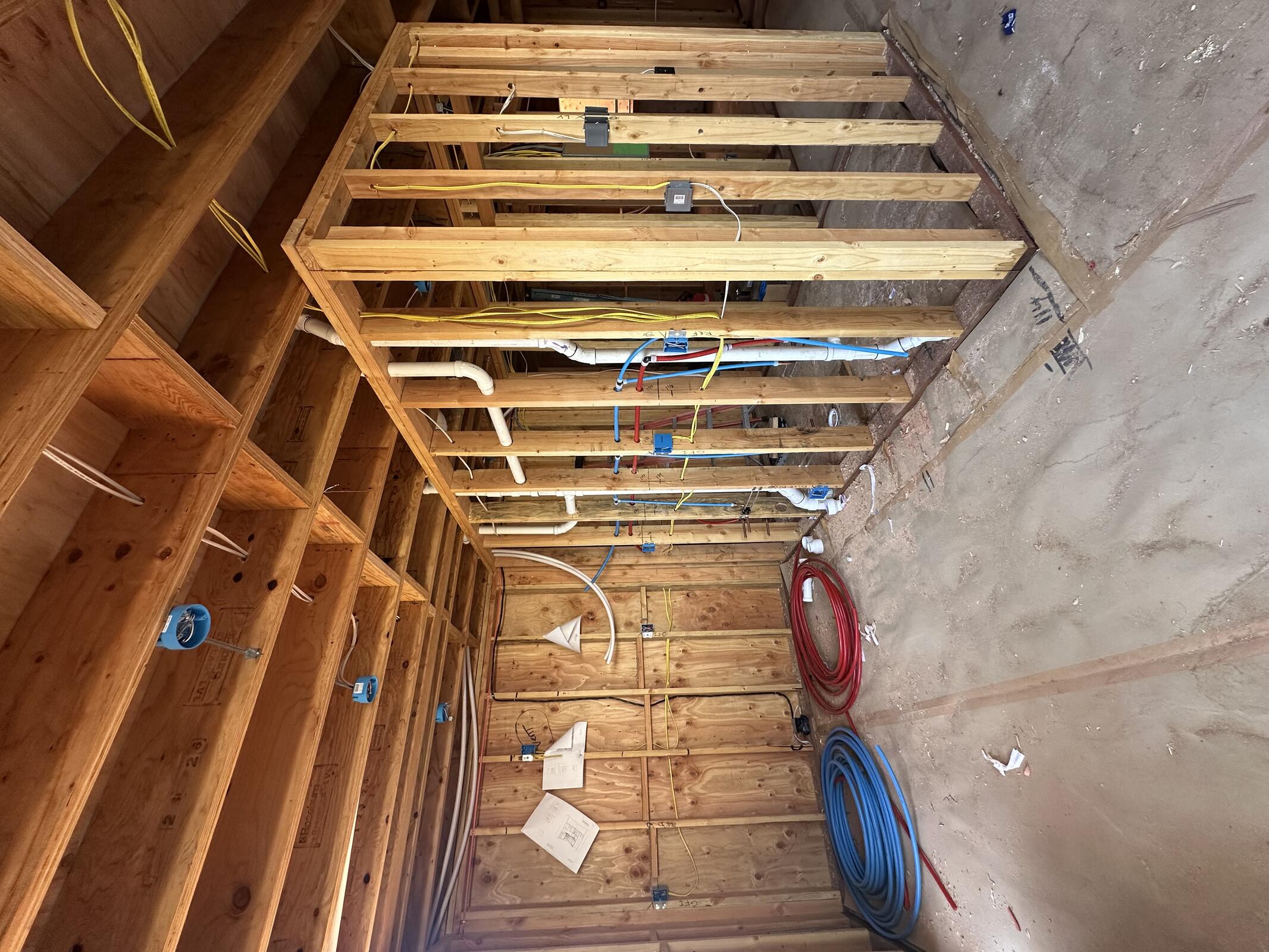

AC Electric finishing first floor rough-in at Building B and C. Javier and Nilo on site to confirm layout.

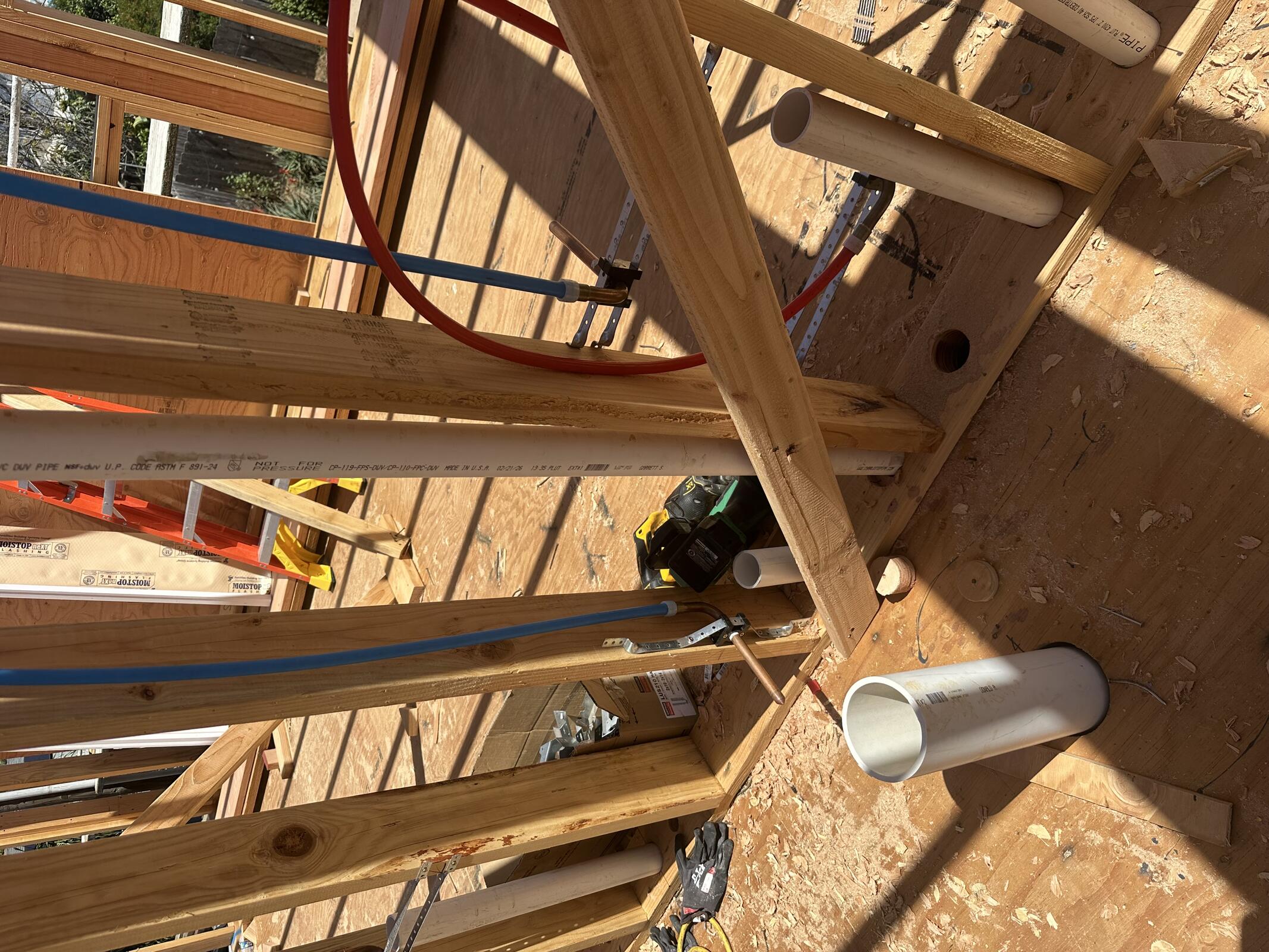

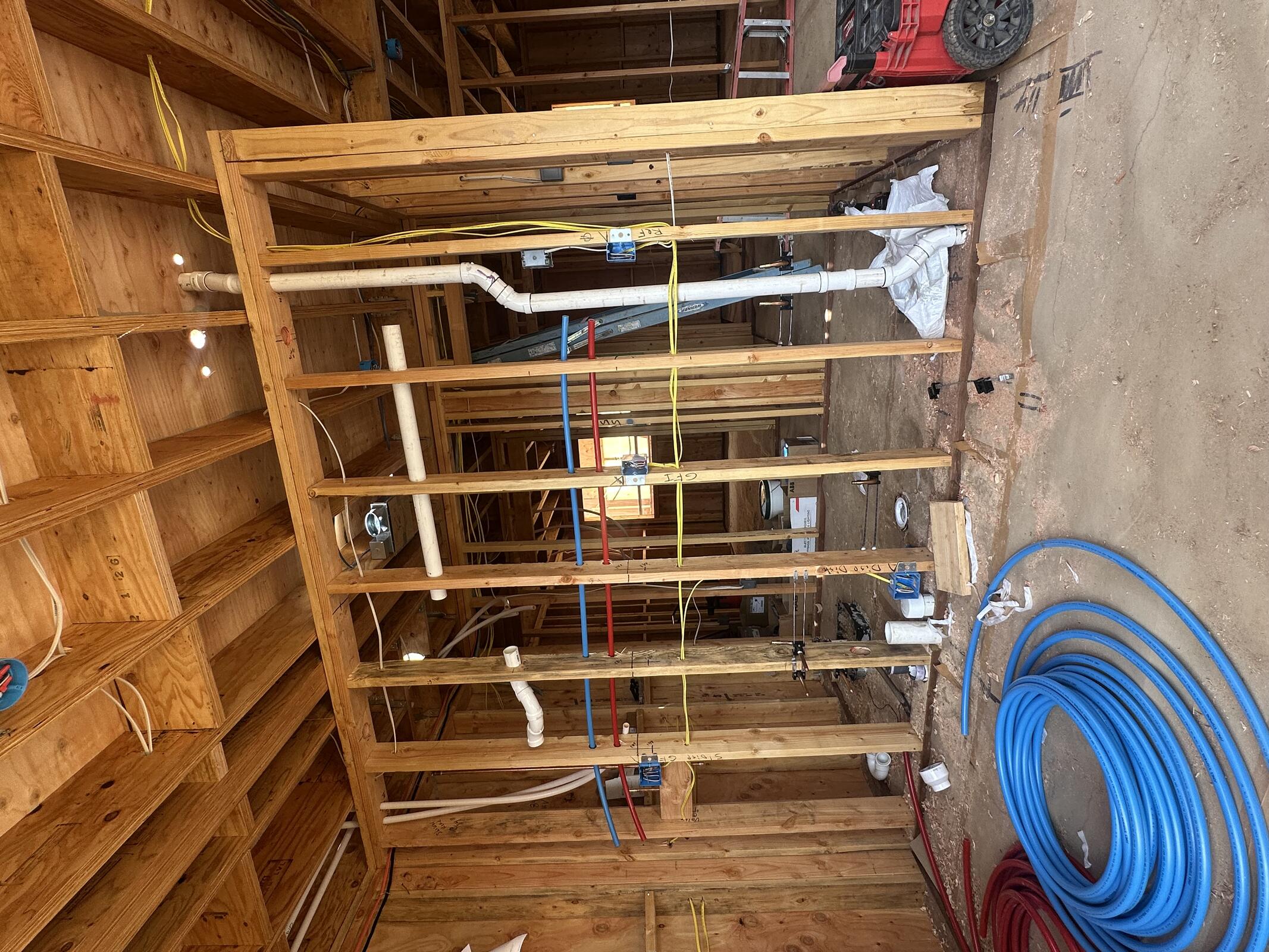

Zack Smith Plumbing on site, roughing-in Building B.

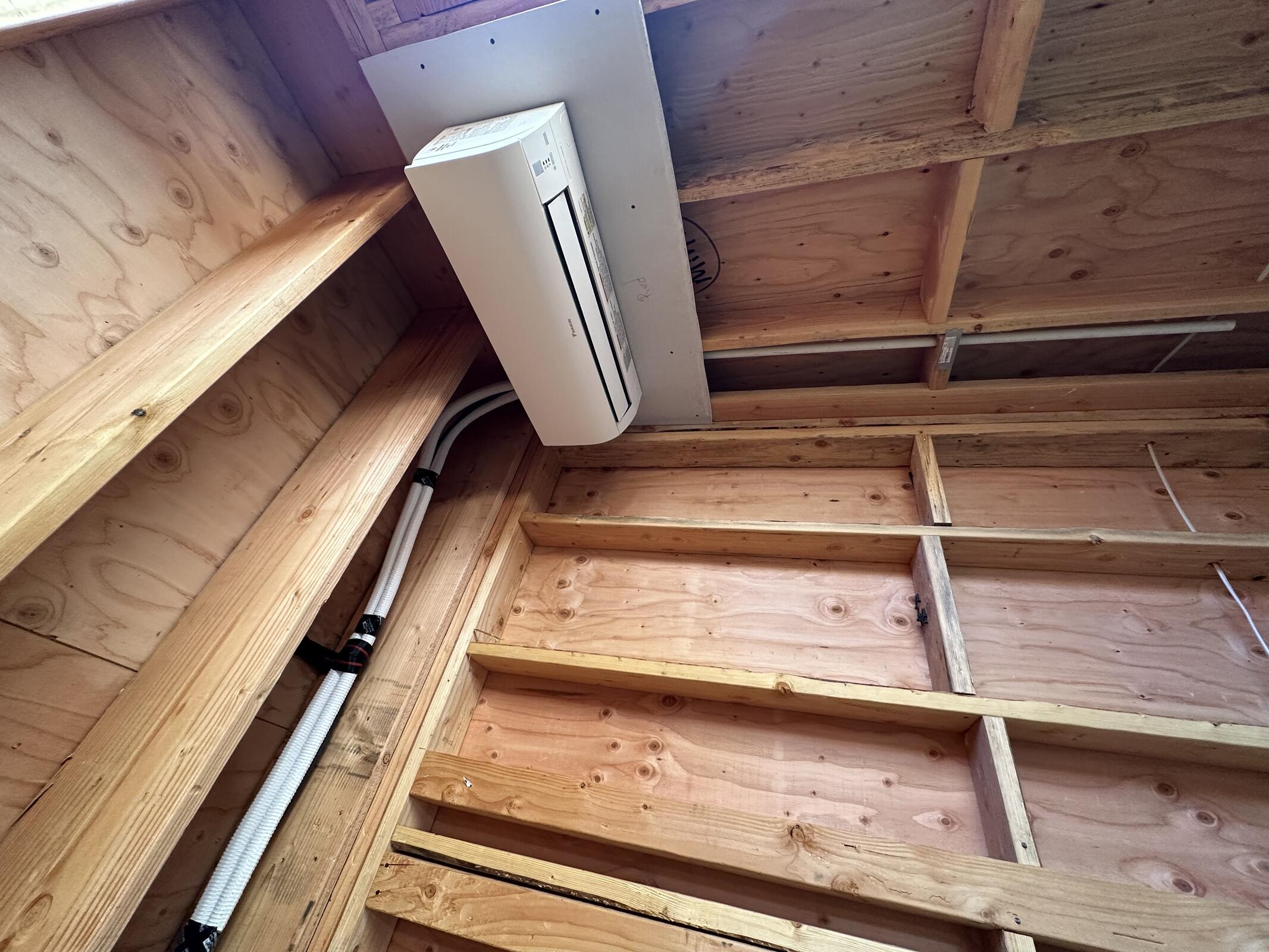

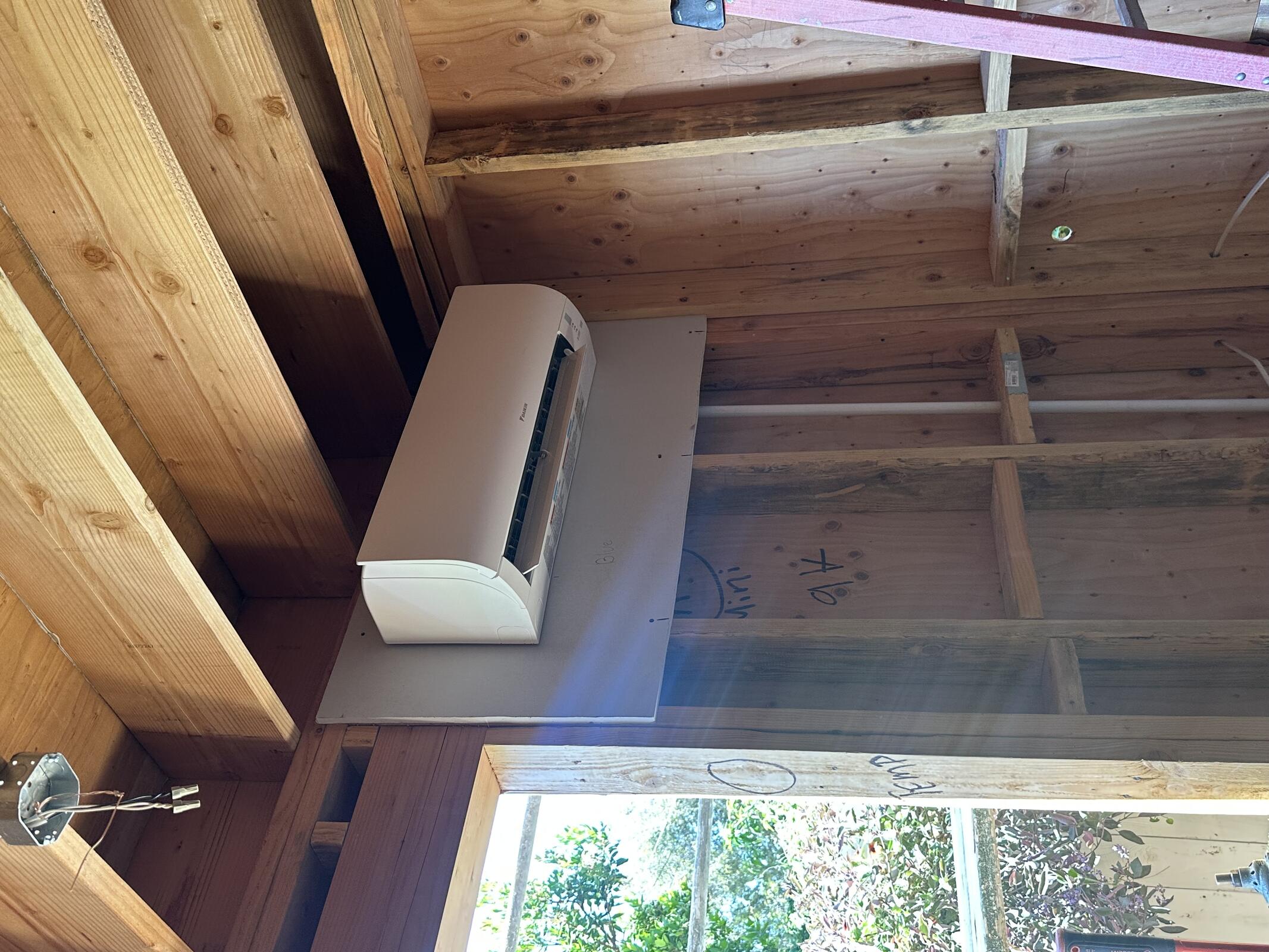

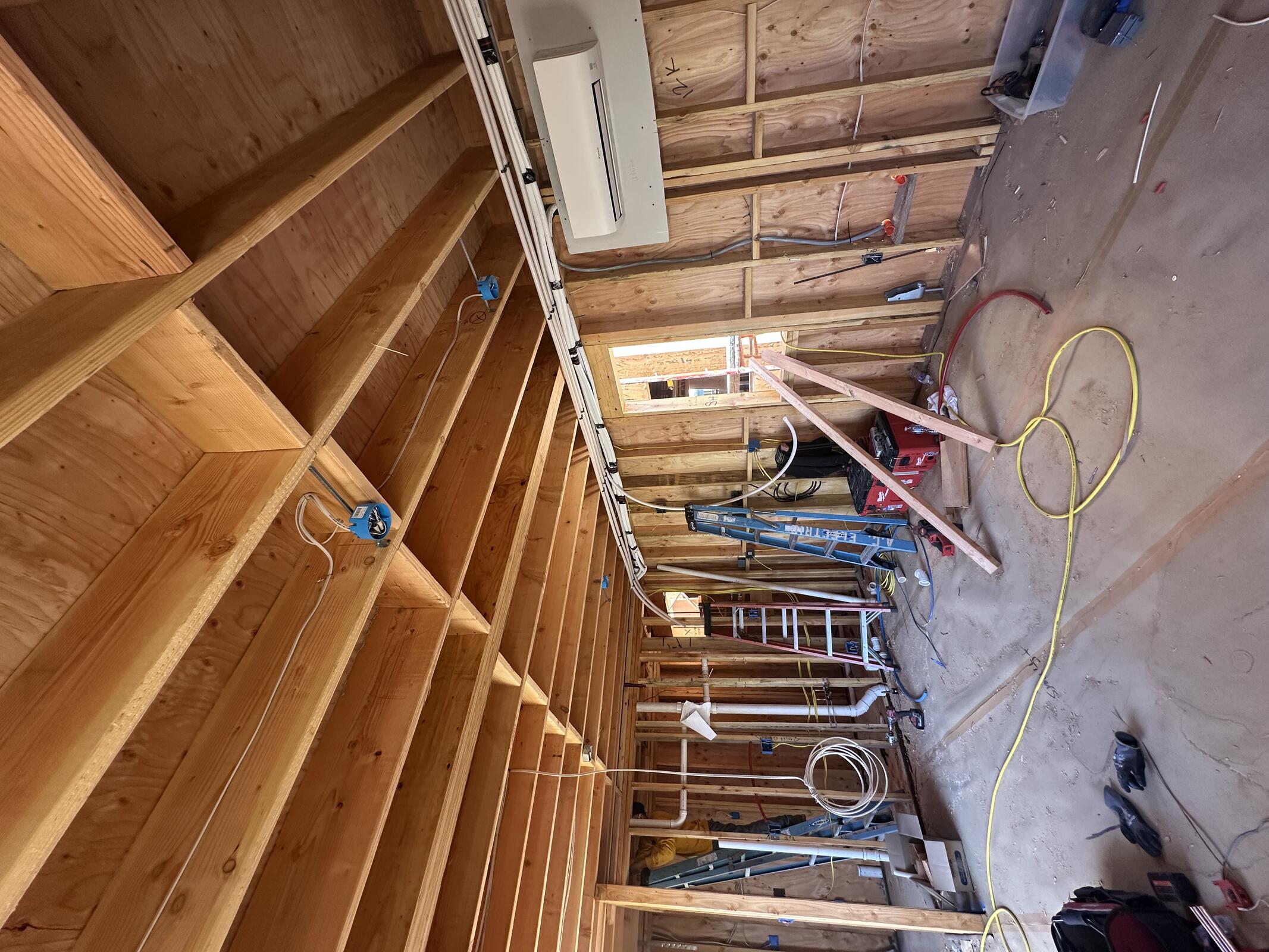

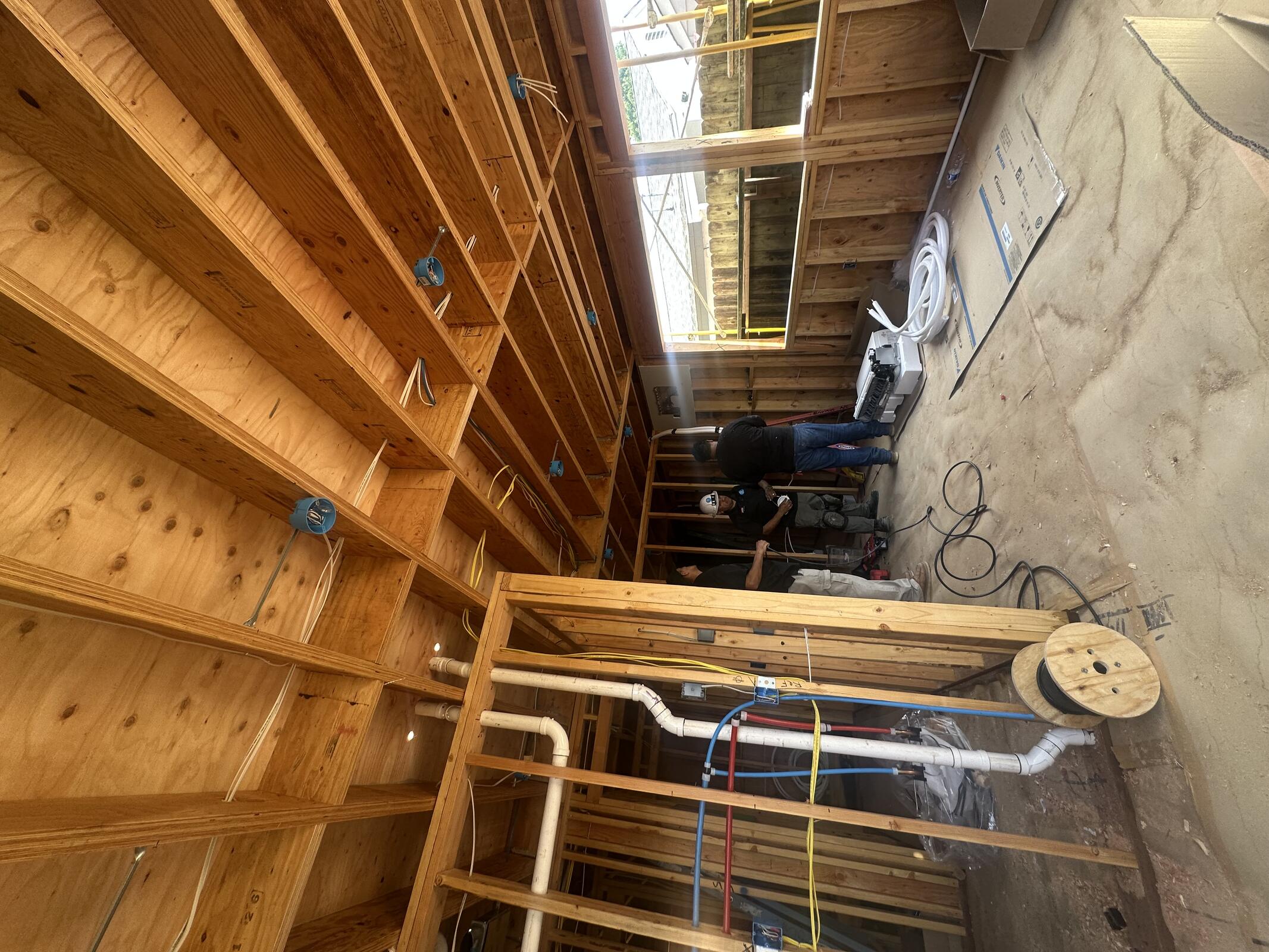

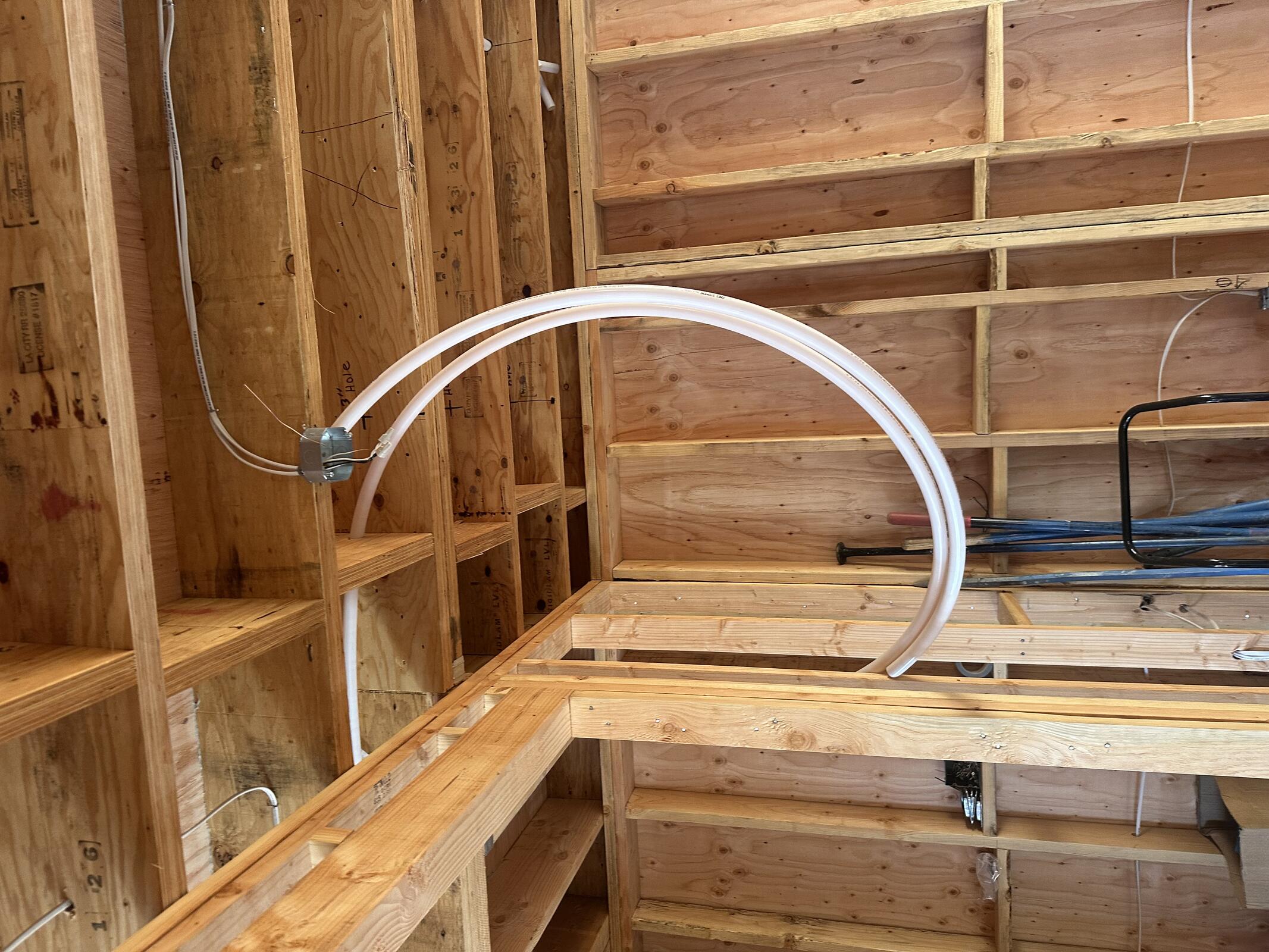

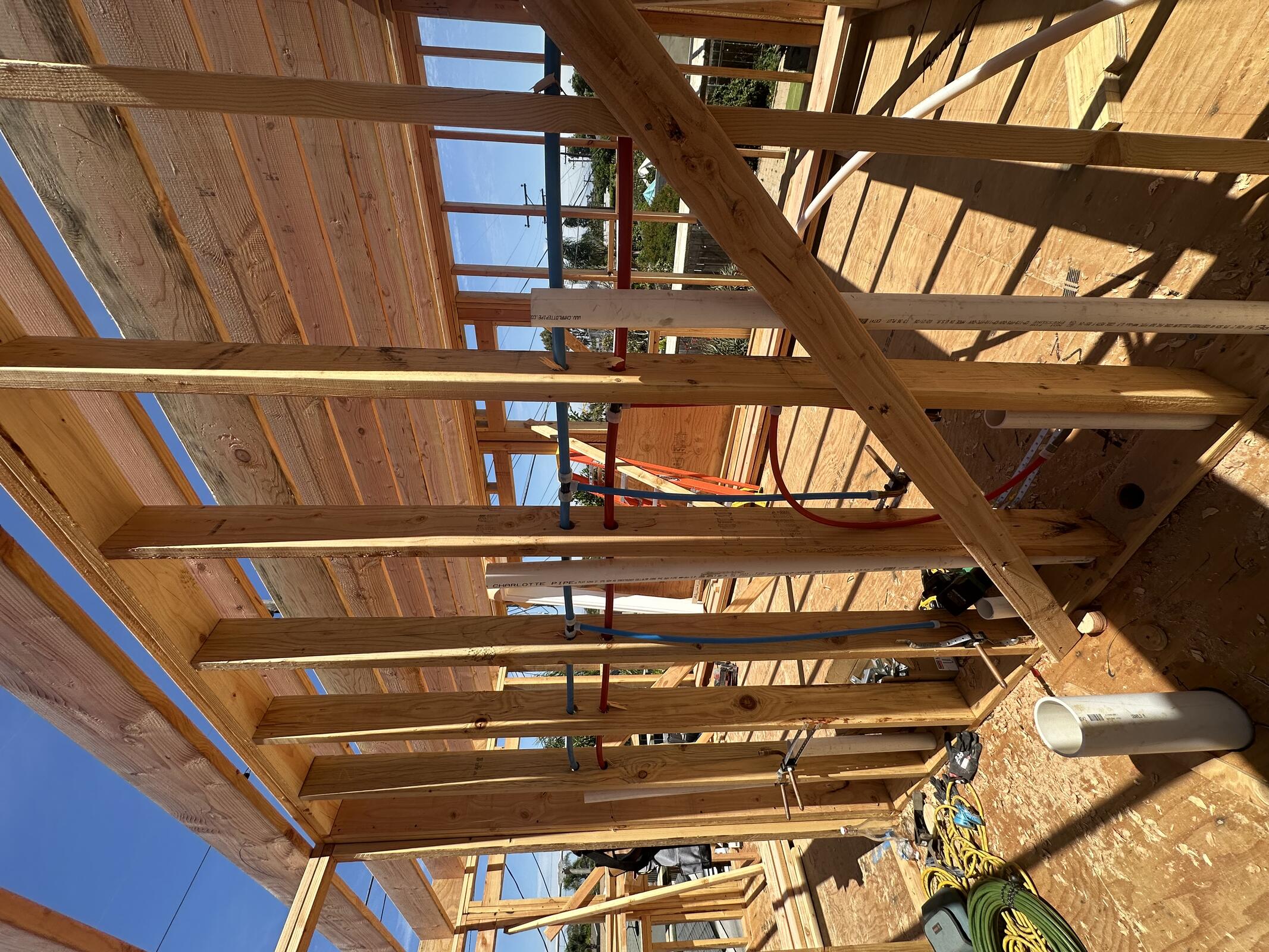

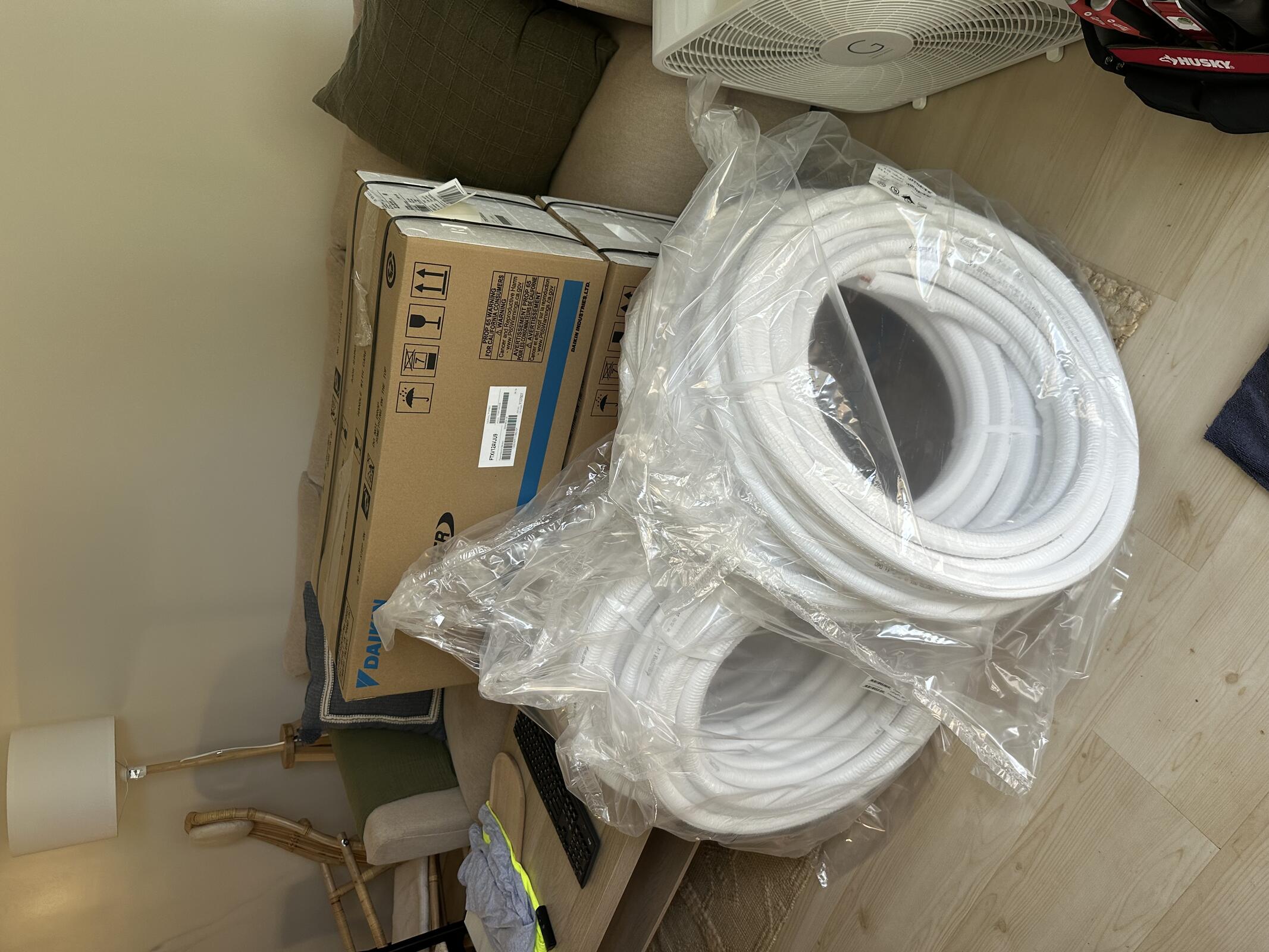

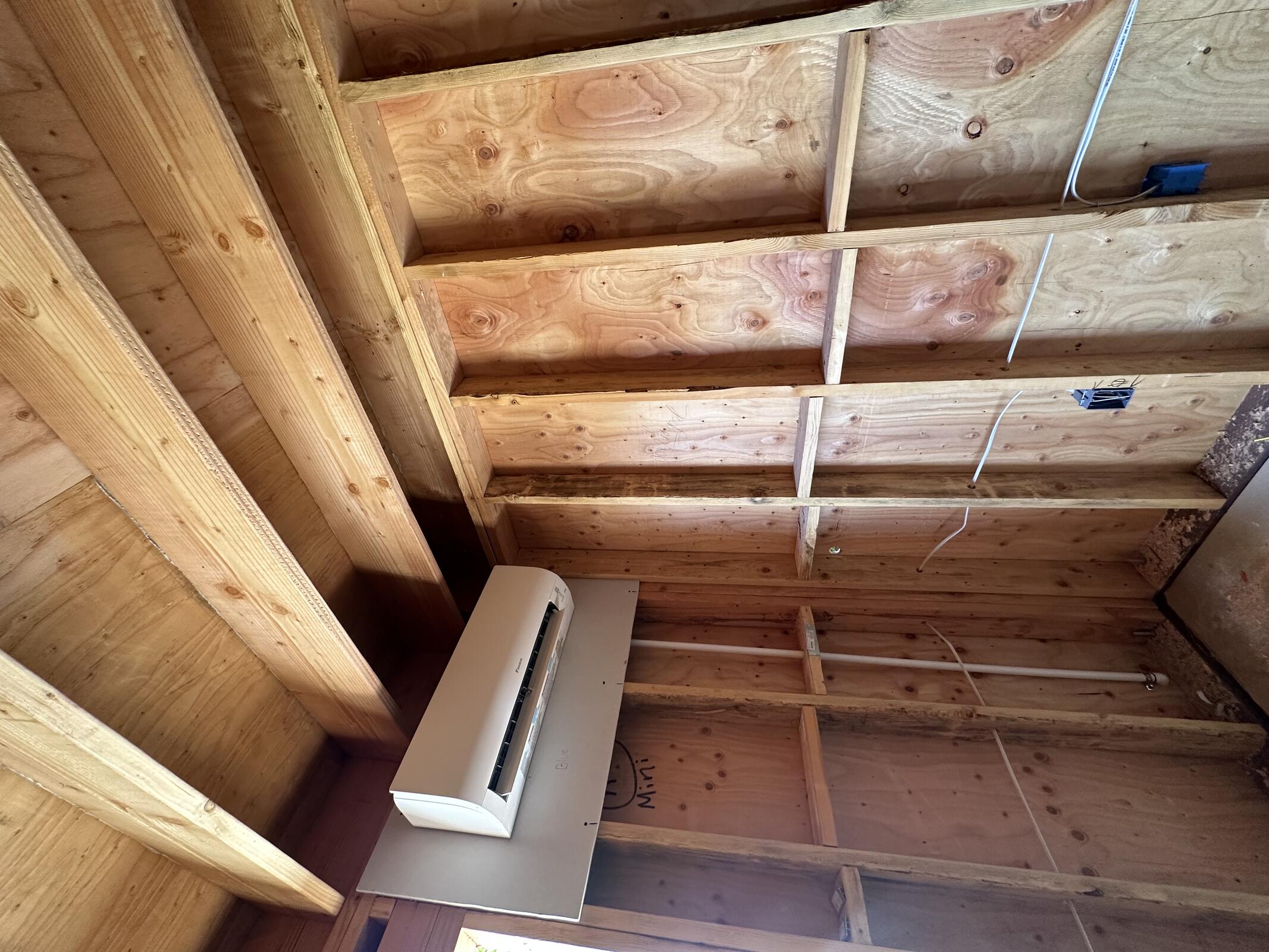

Clear HVAC, roughing in Building C and first floor Building B. All indoor units on site. Reuven and Javier on site to confirm layout.
Taylor Trim installed first floor entry doors.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| JB General | 6 | 8 | 48 |
| AC Electric | 1 | 8 | 8 |
| Zack Smith Plumbing | 3 | 8 | 24 |
| Clear HVAC | 4 | 8 | 32 |
| Taylor Trim | 1 | 2 | 2 |
Inspection: N/A
























Thursday, April 23, 2026
Partially cloudy, 69°F
AC Electric Wiring in First Floor Building C. ZSP Plumbing both buildings, both floors. Clear HVAC working on Building B First floor rough-in.

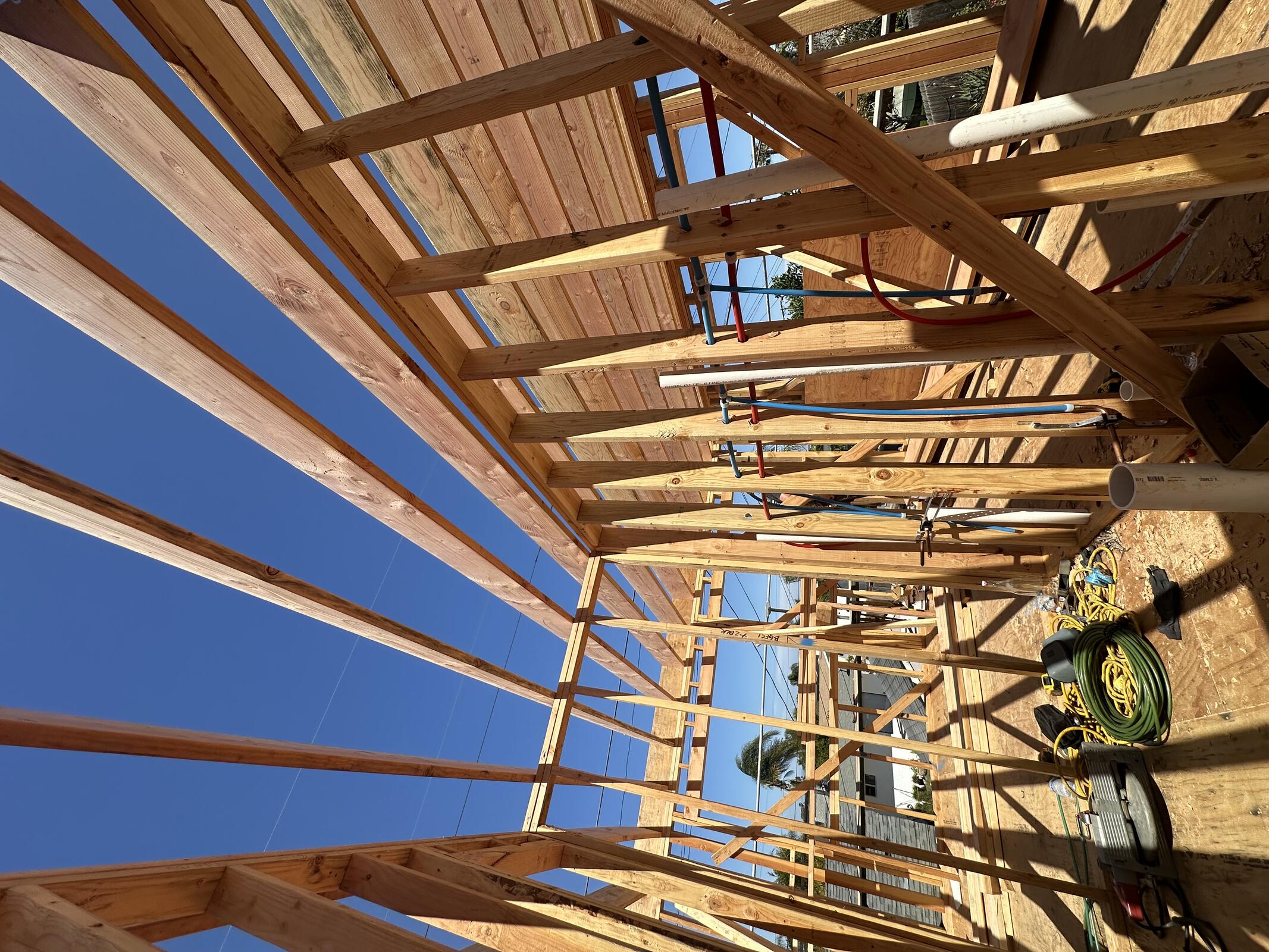

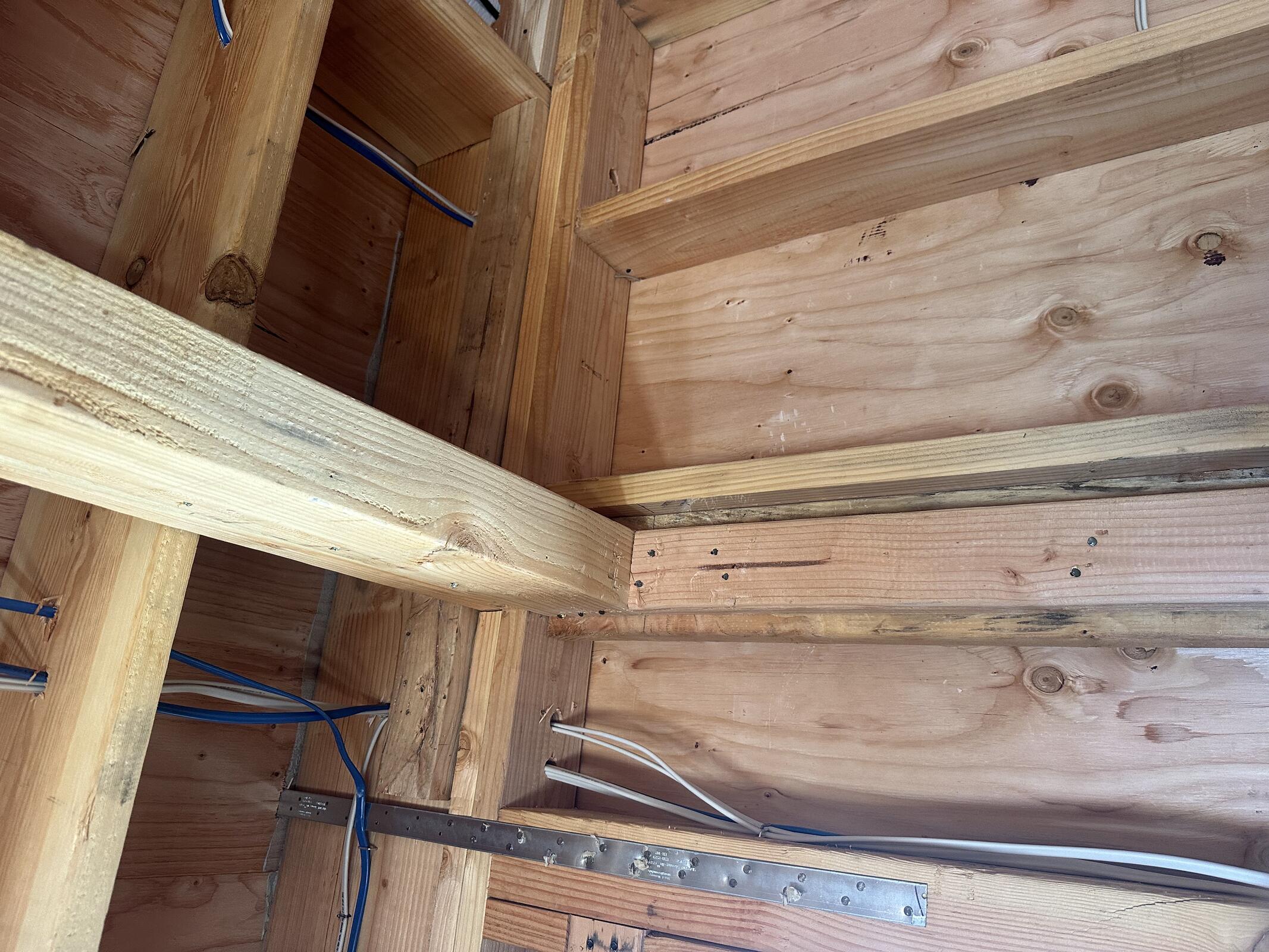

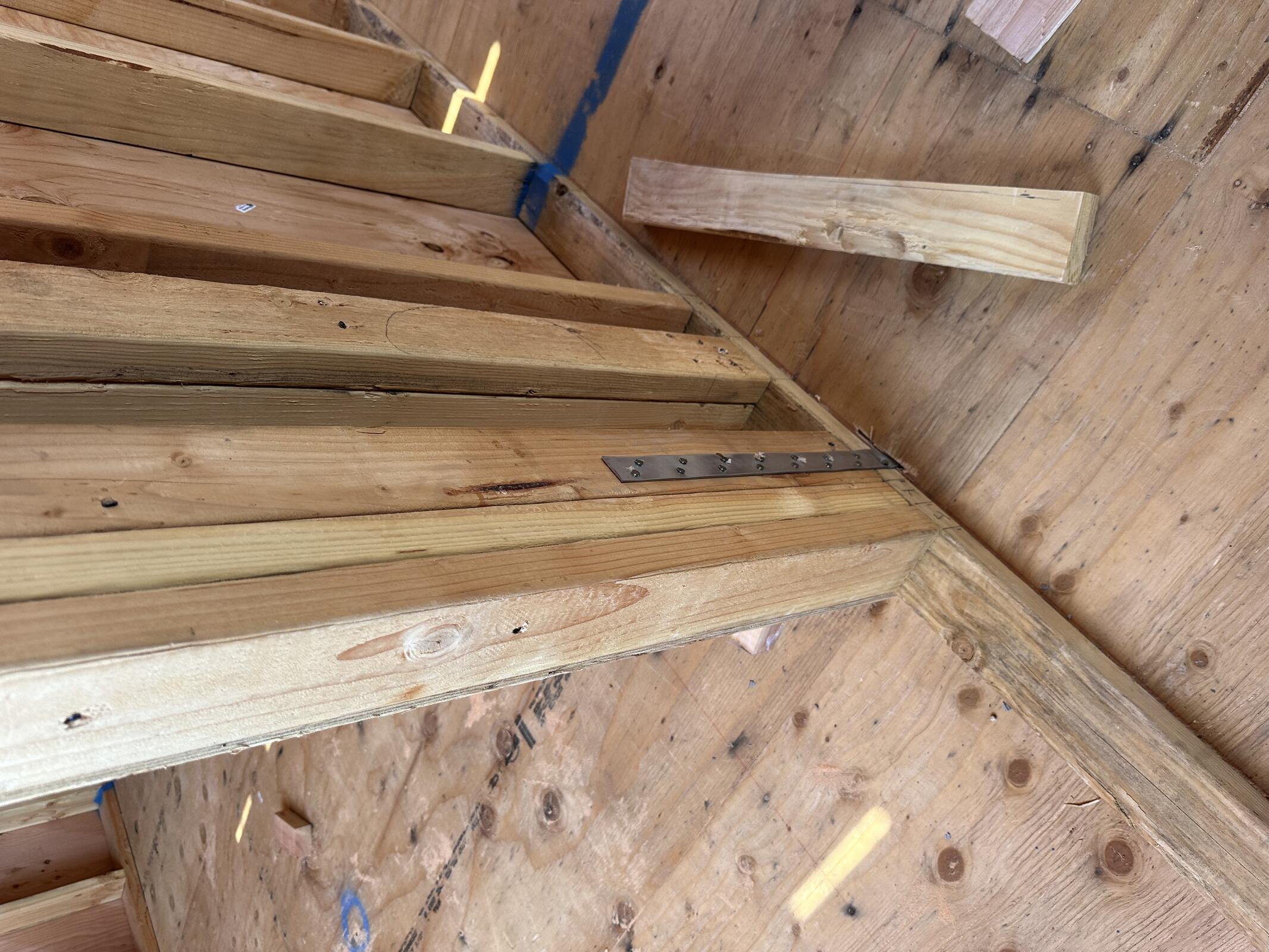

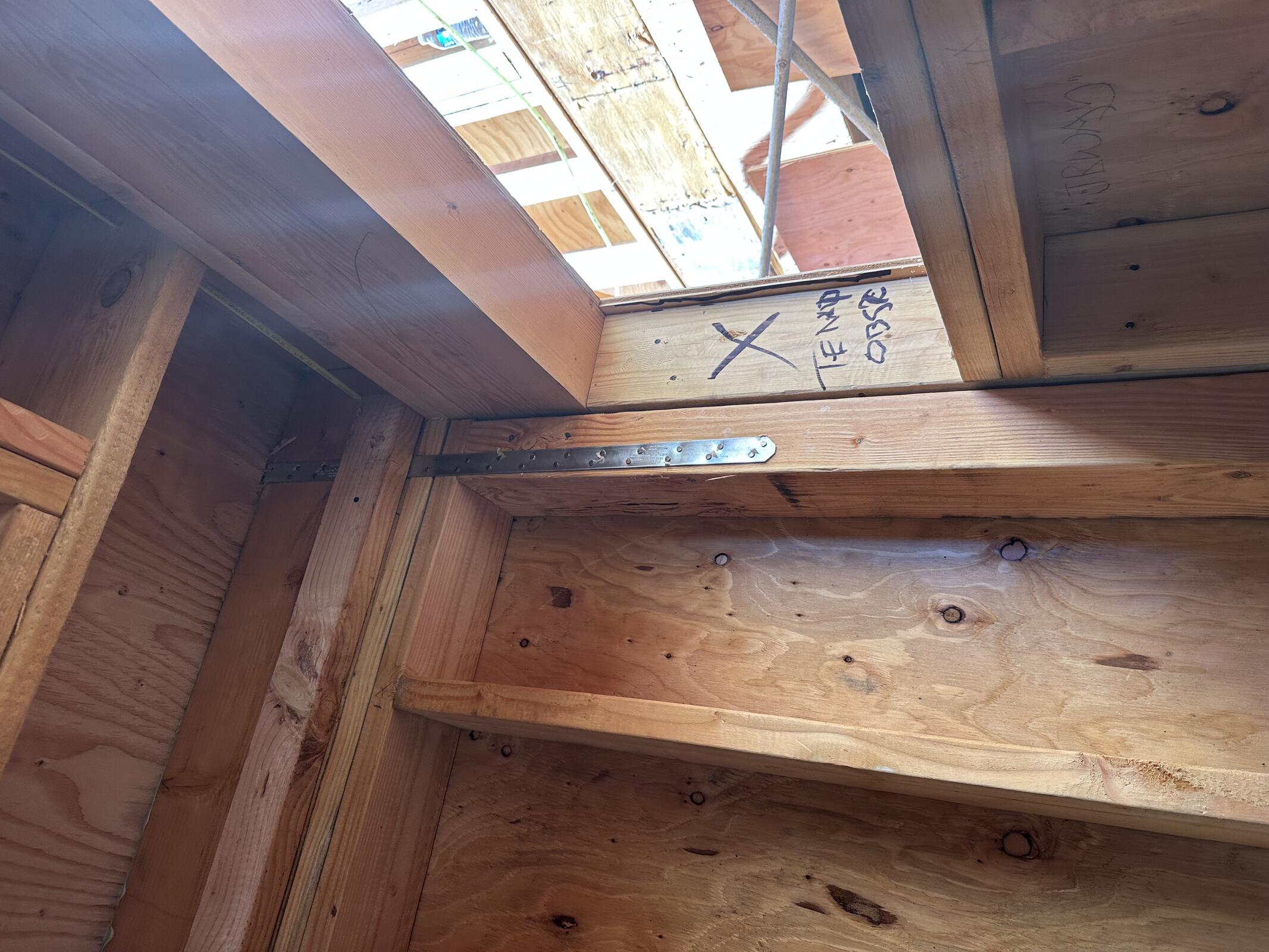

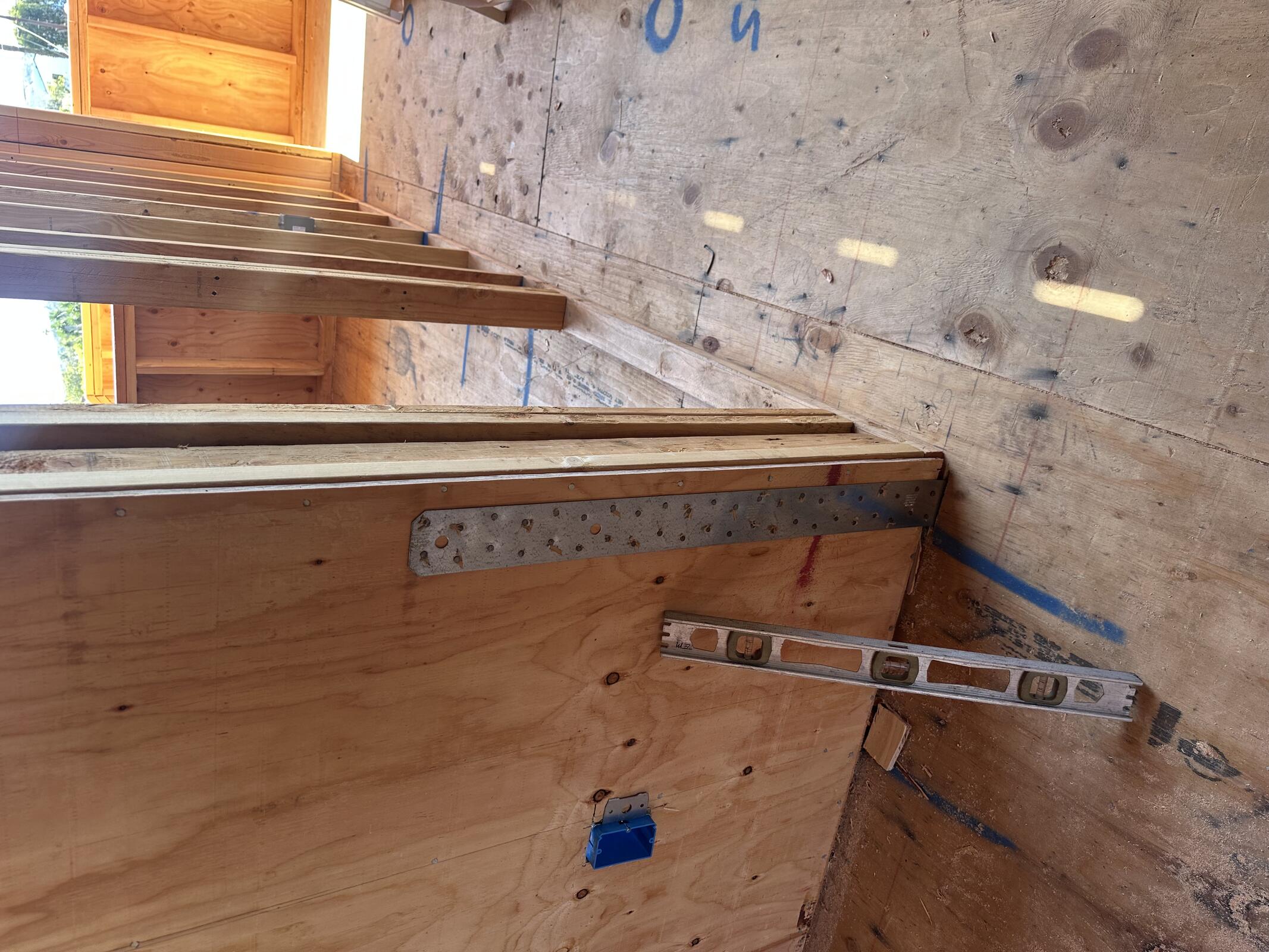

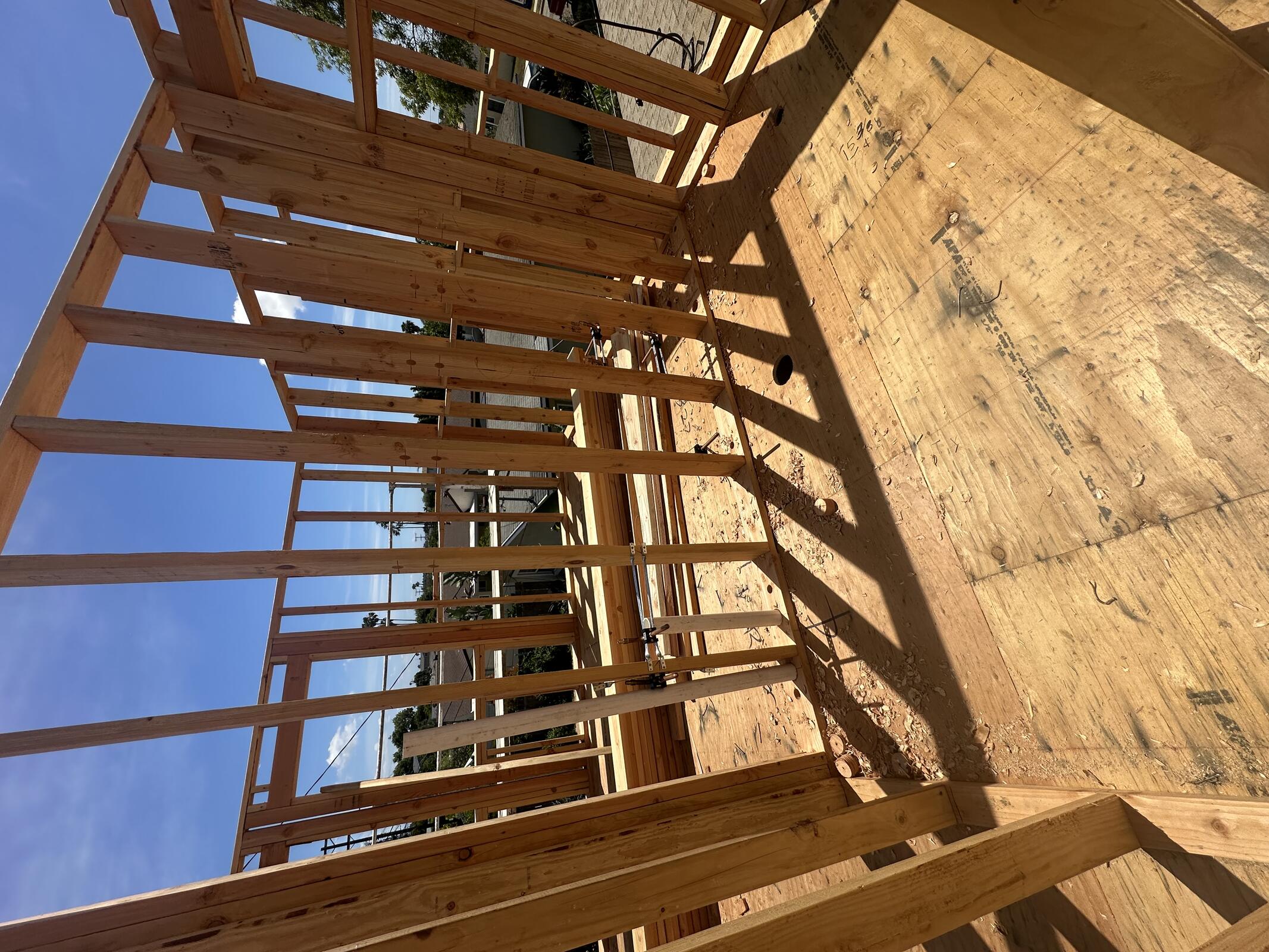

JB General joisting Building B and Shearing. Installing hardware and other pick-ups at Building C.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| JB General | 8 | 8 | 64 |
| AC Electric | 1 | 8 | 8 |
| Clear HVAC | 4 | 8 | 32 |
| ZSP | 2 | 8 | 12 |
Inspection: N/A
