Week of March 30 — April 03, 2026
4 days on site. 34 photos. Electric, Foundations, Framing, Inspection.
Monday, March 30, 2026
Partially cloudy, 73°F

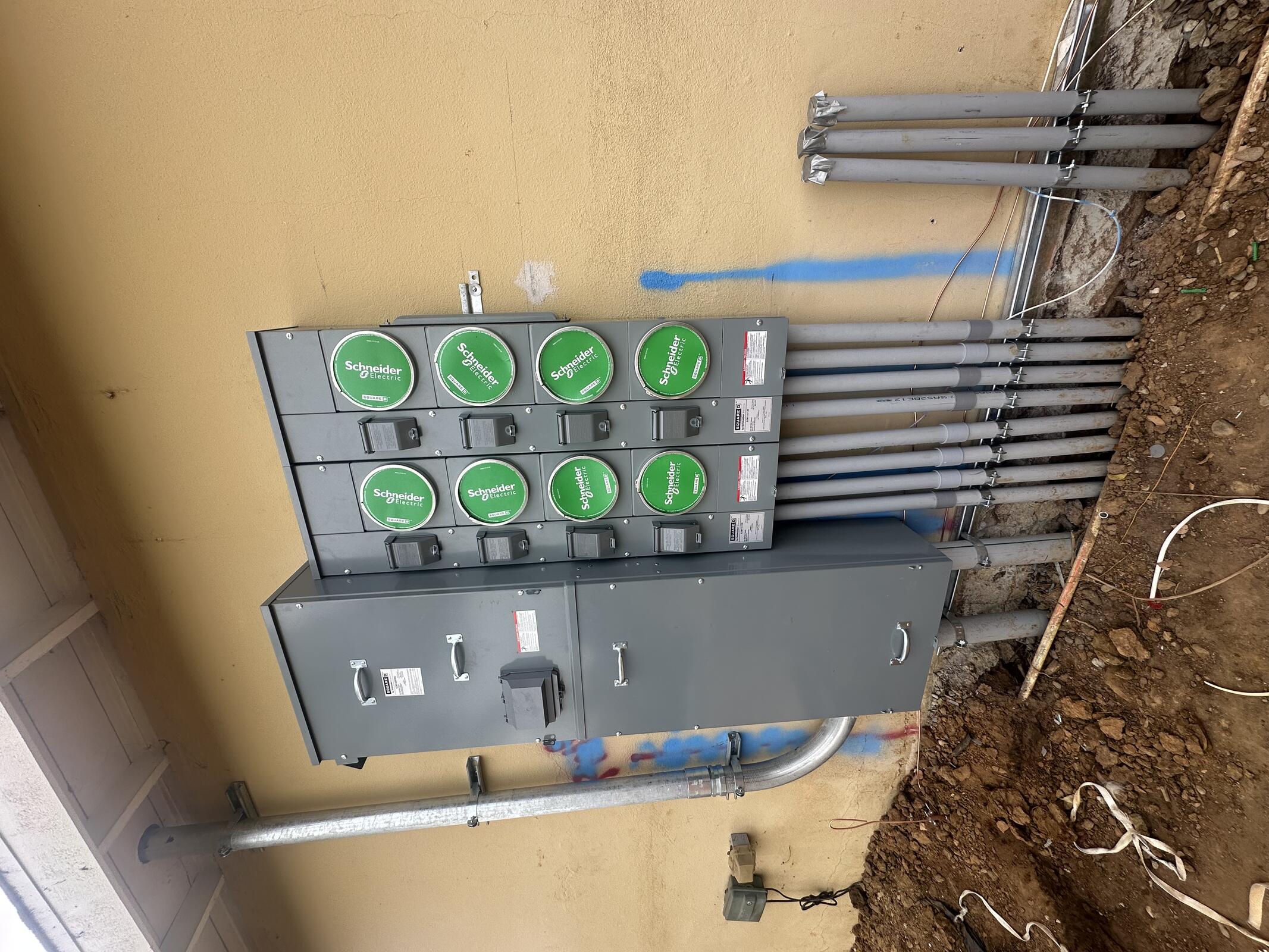

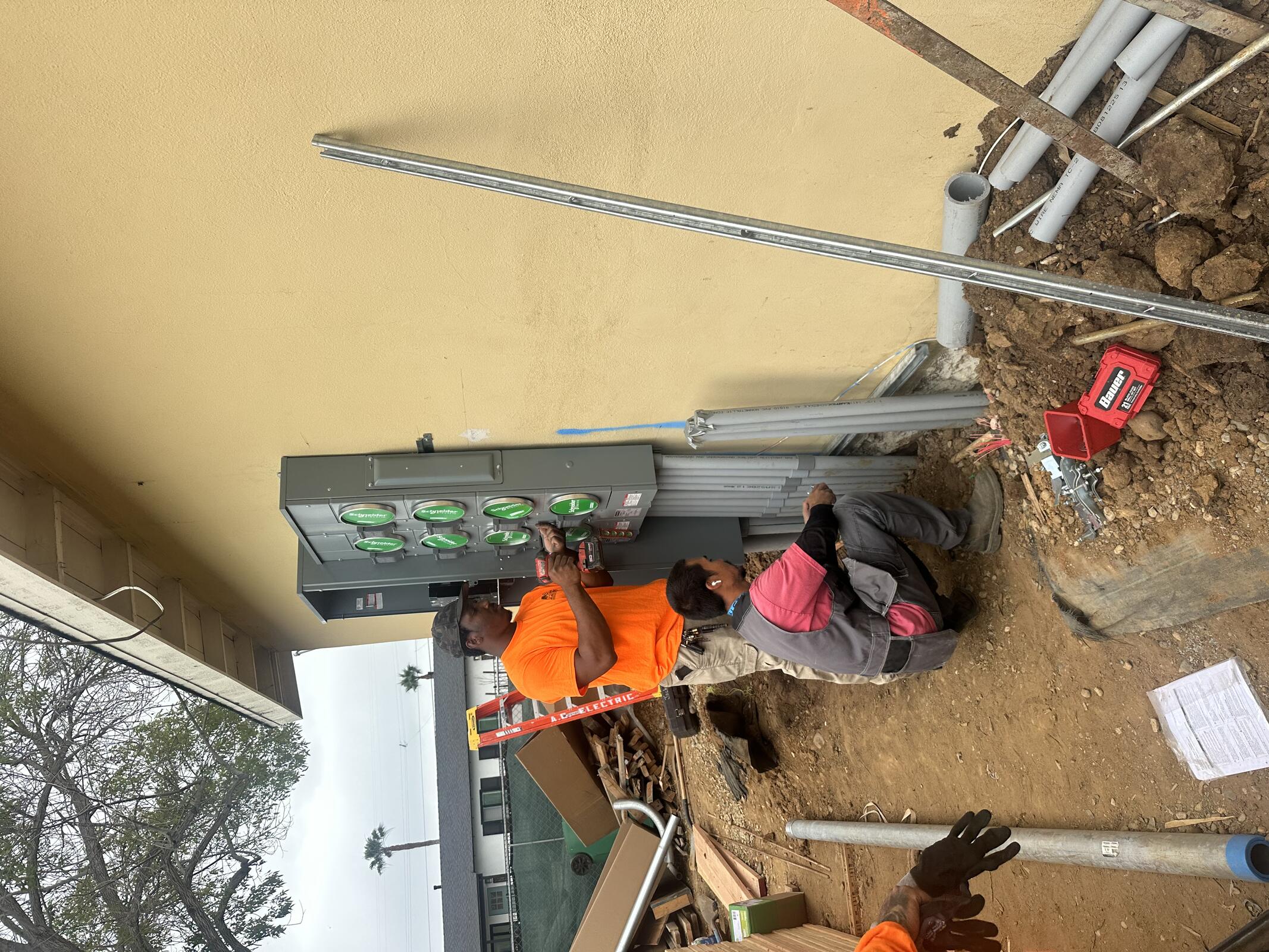

AC Electric installing switch gear, rigid riser and grounding rod at existing house.

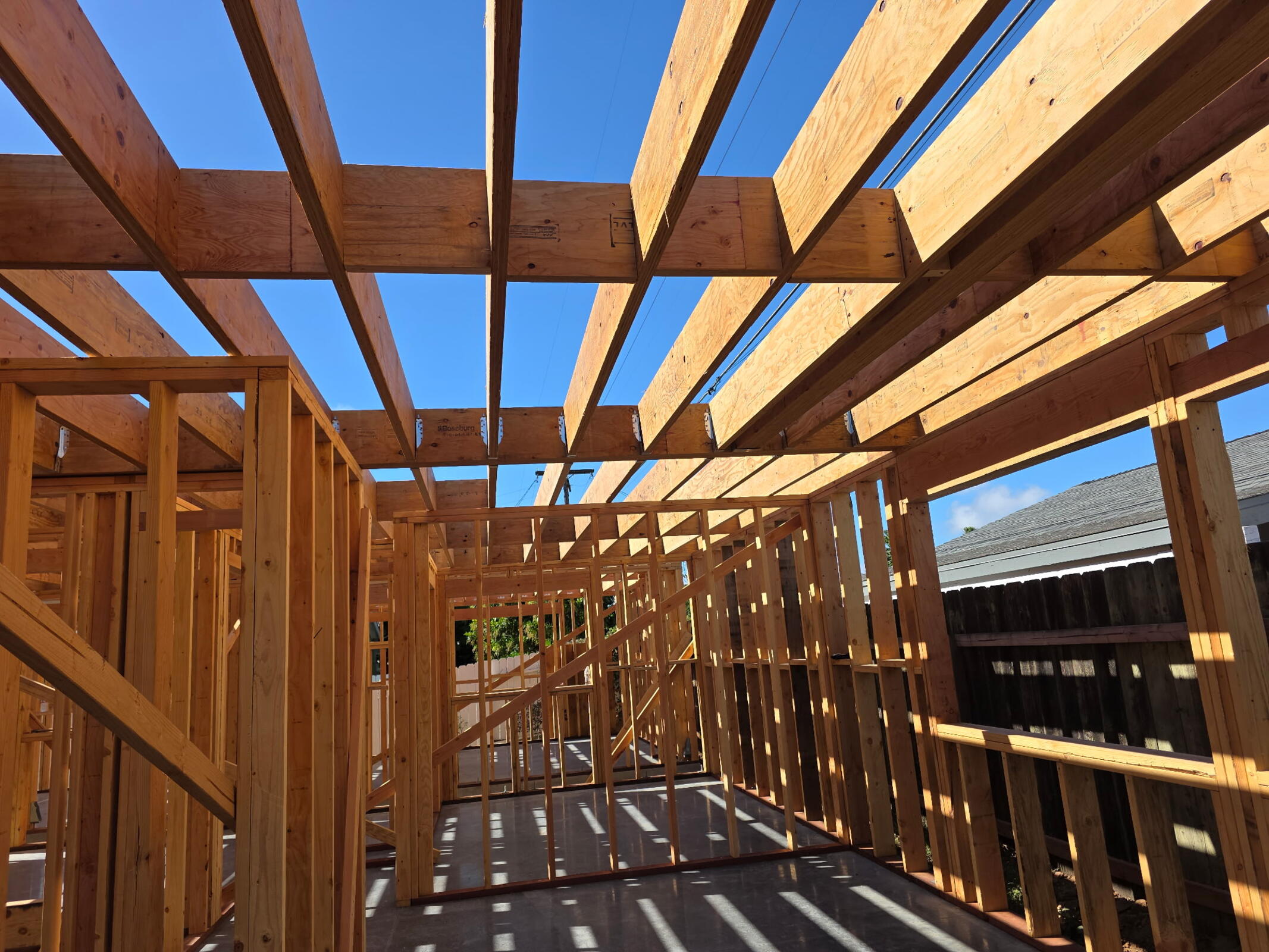

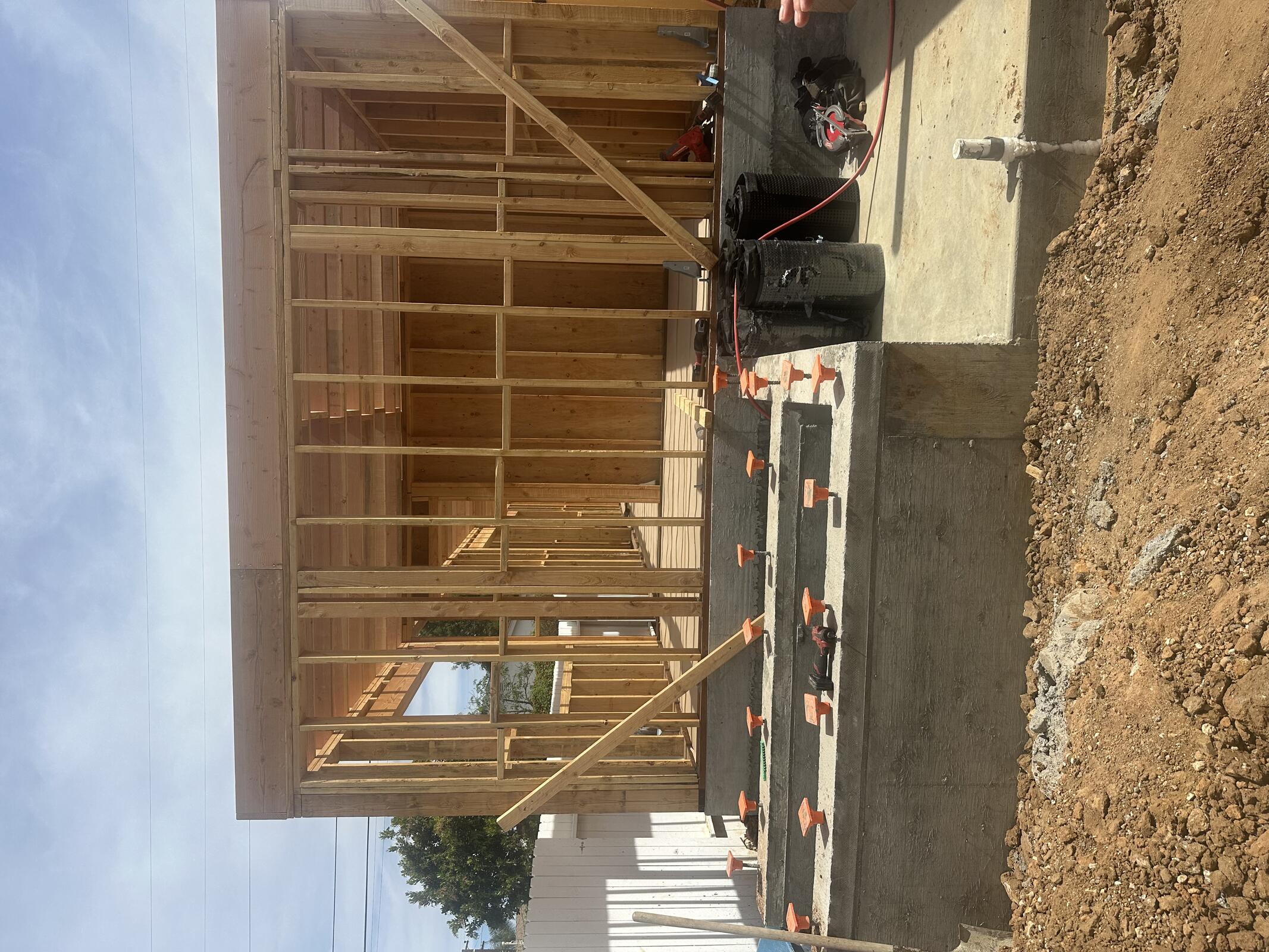

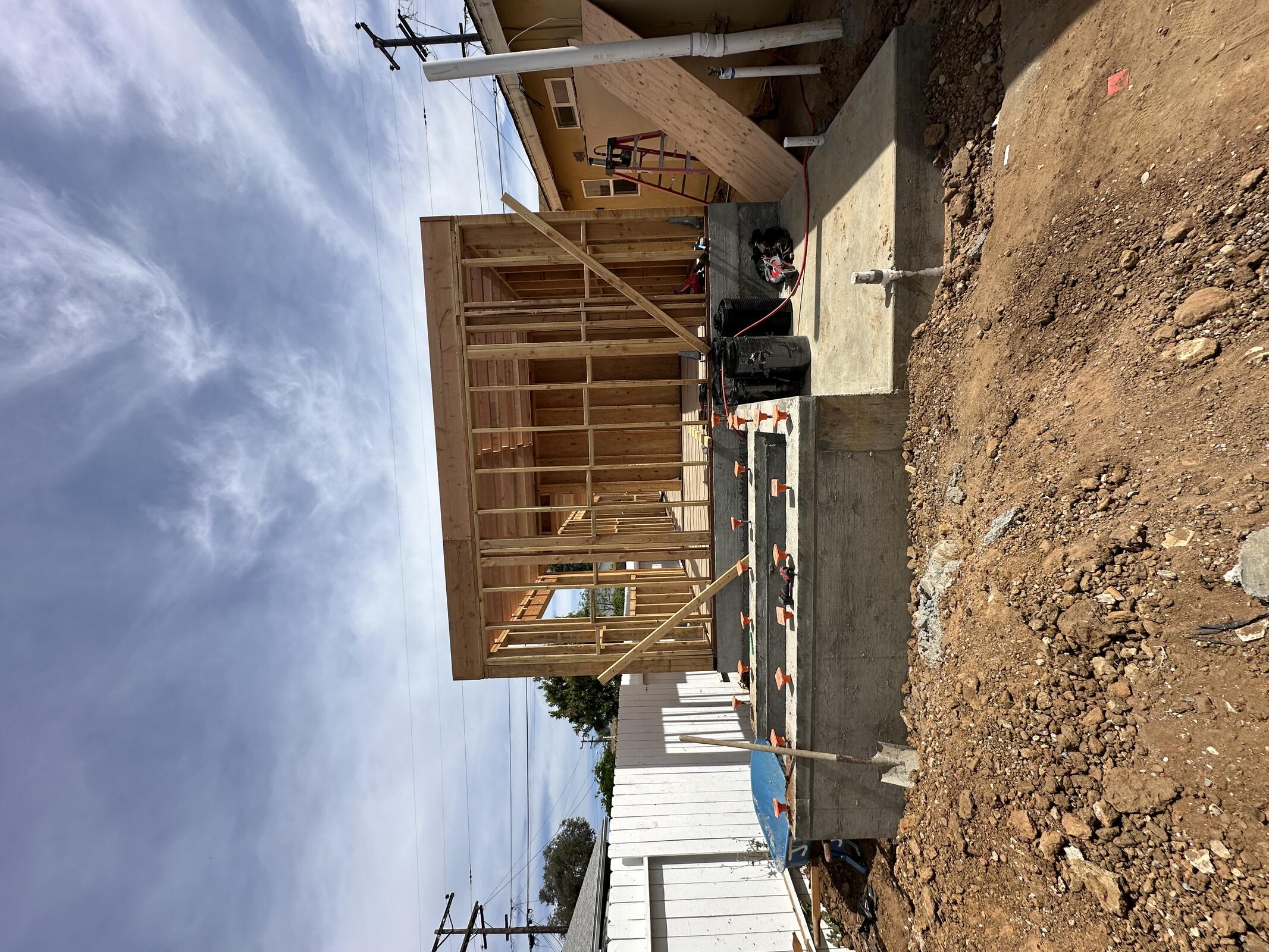

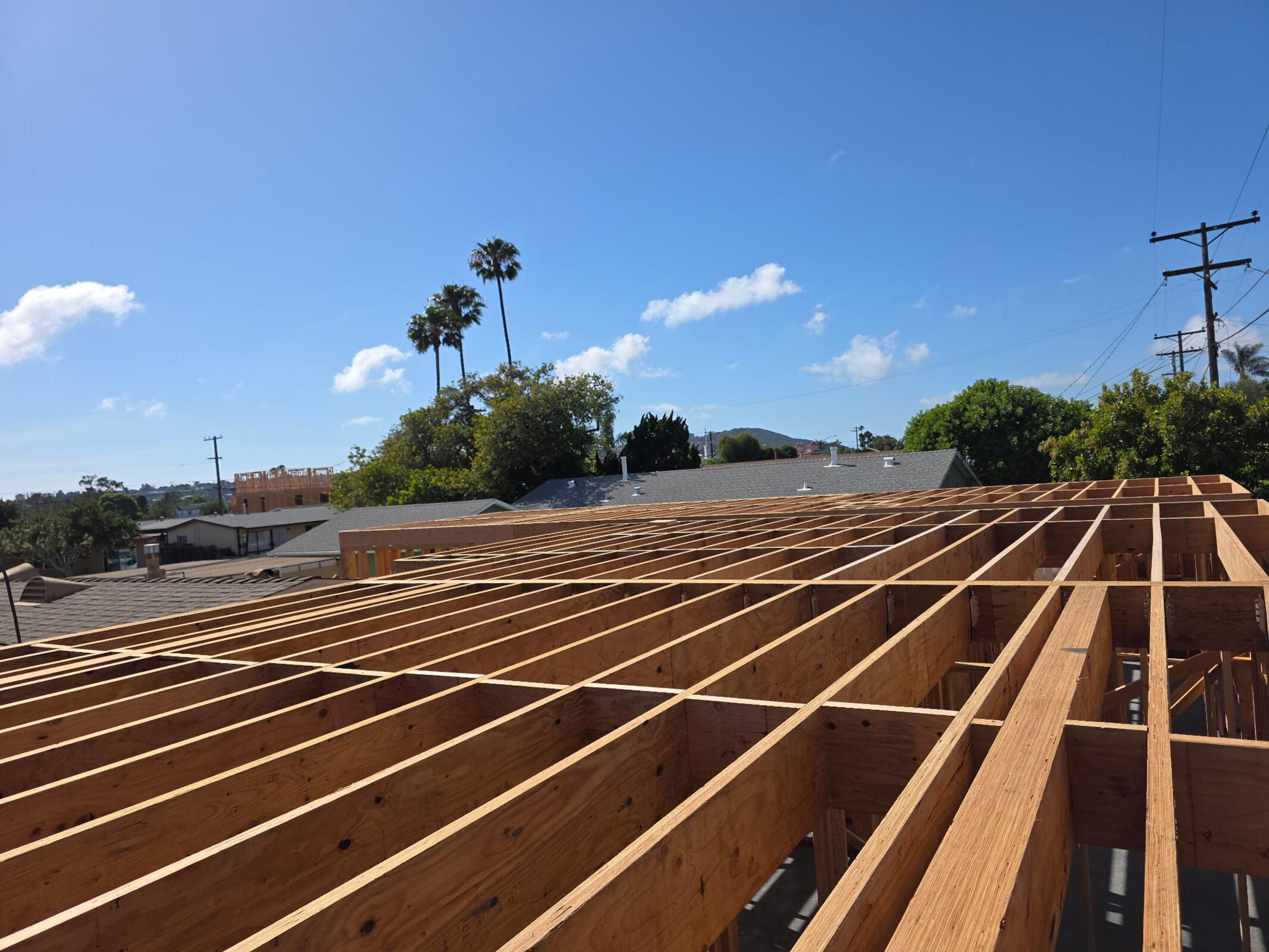

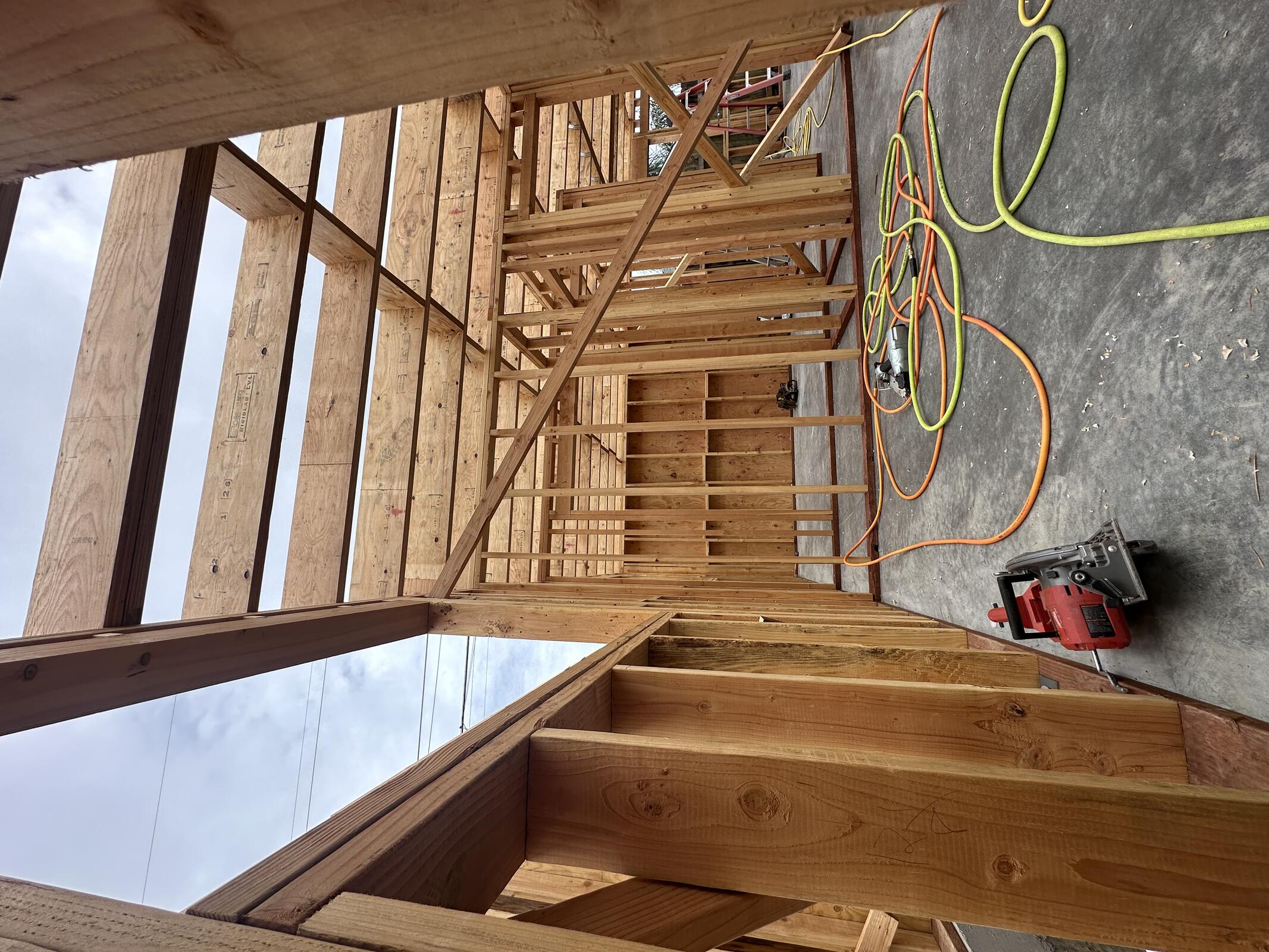

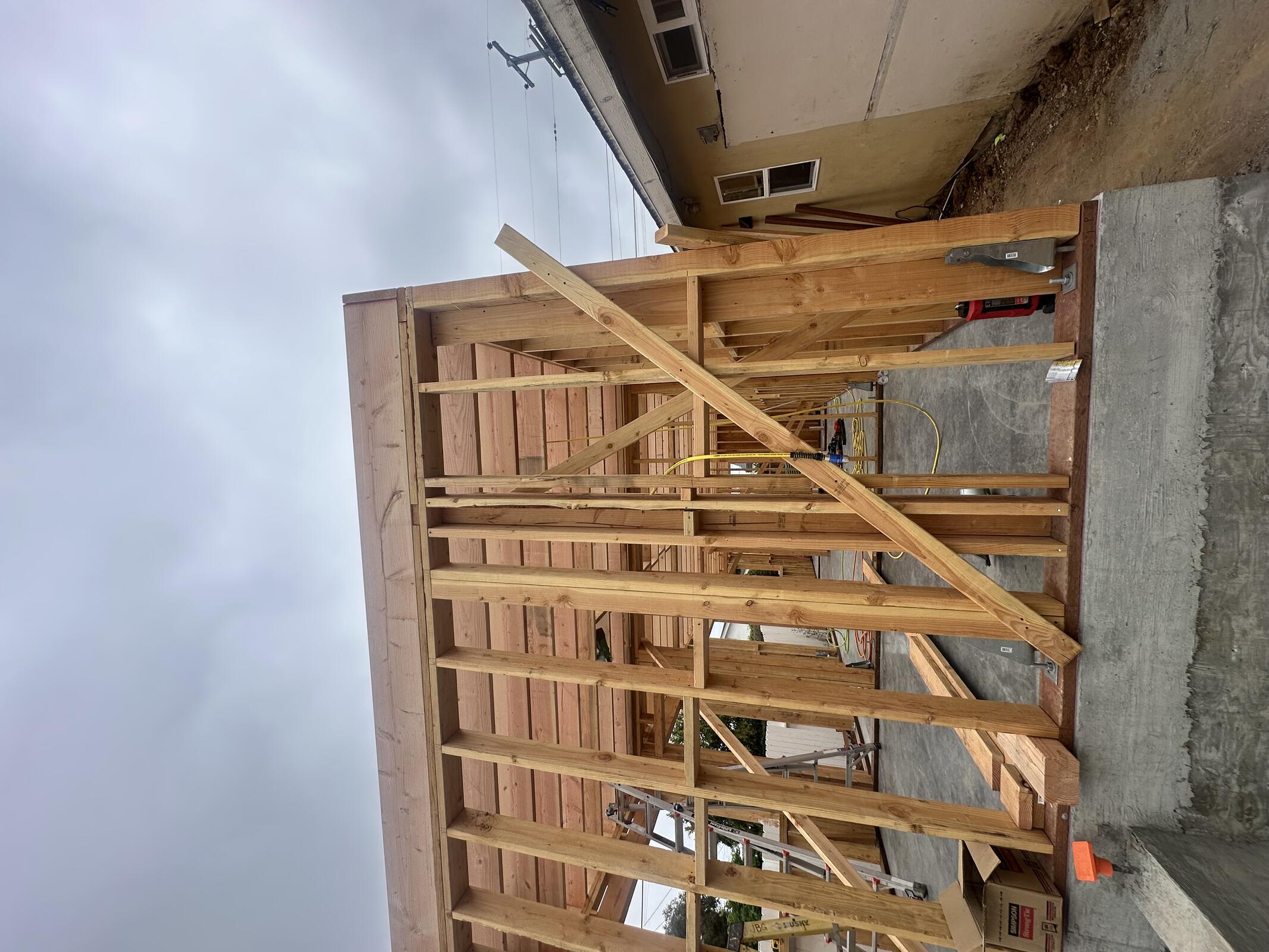

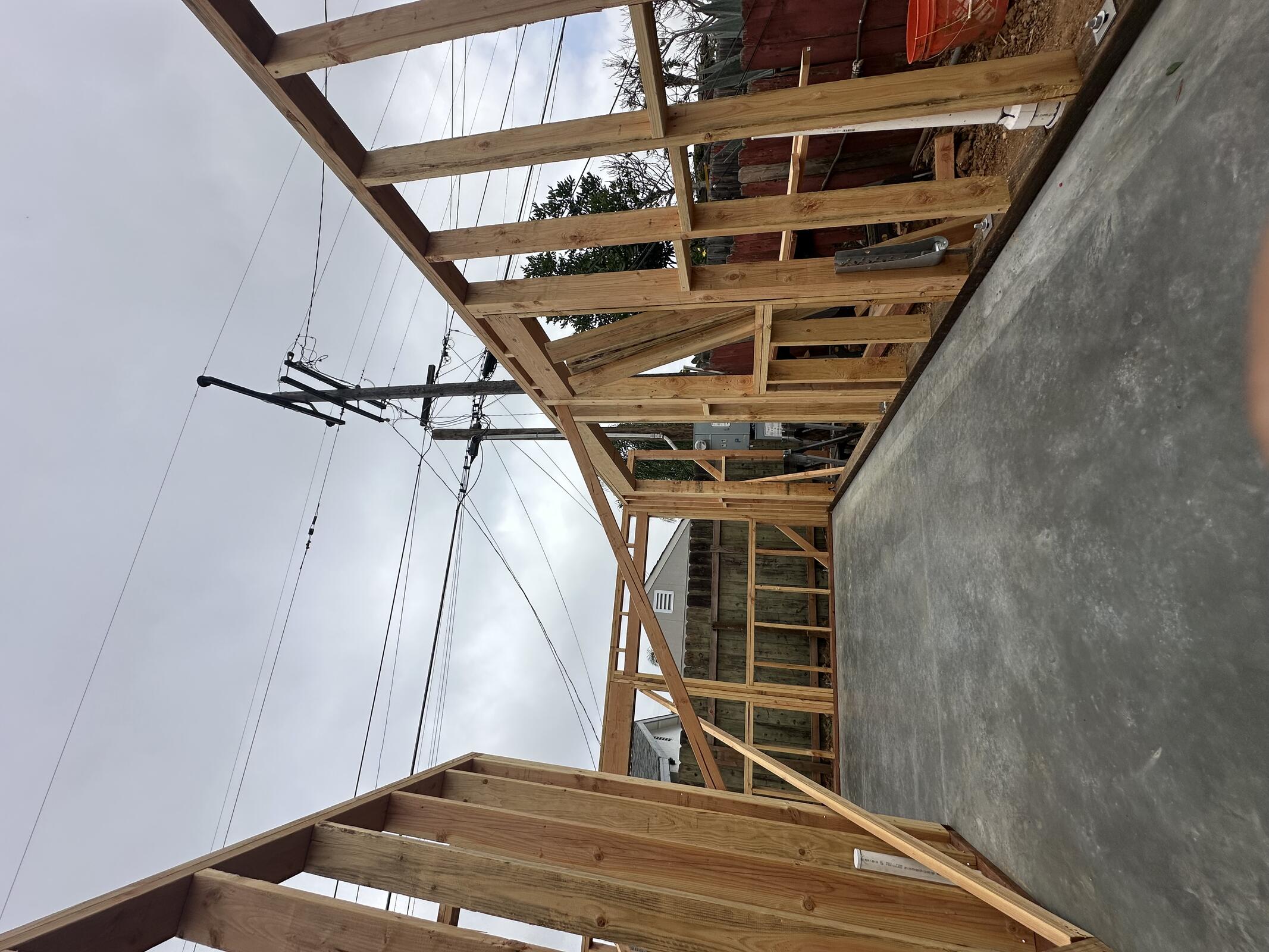

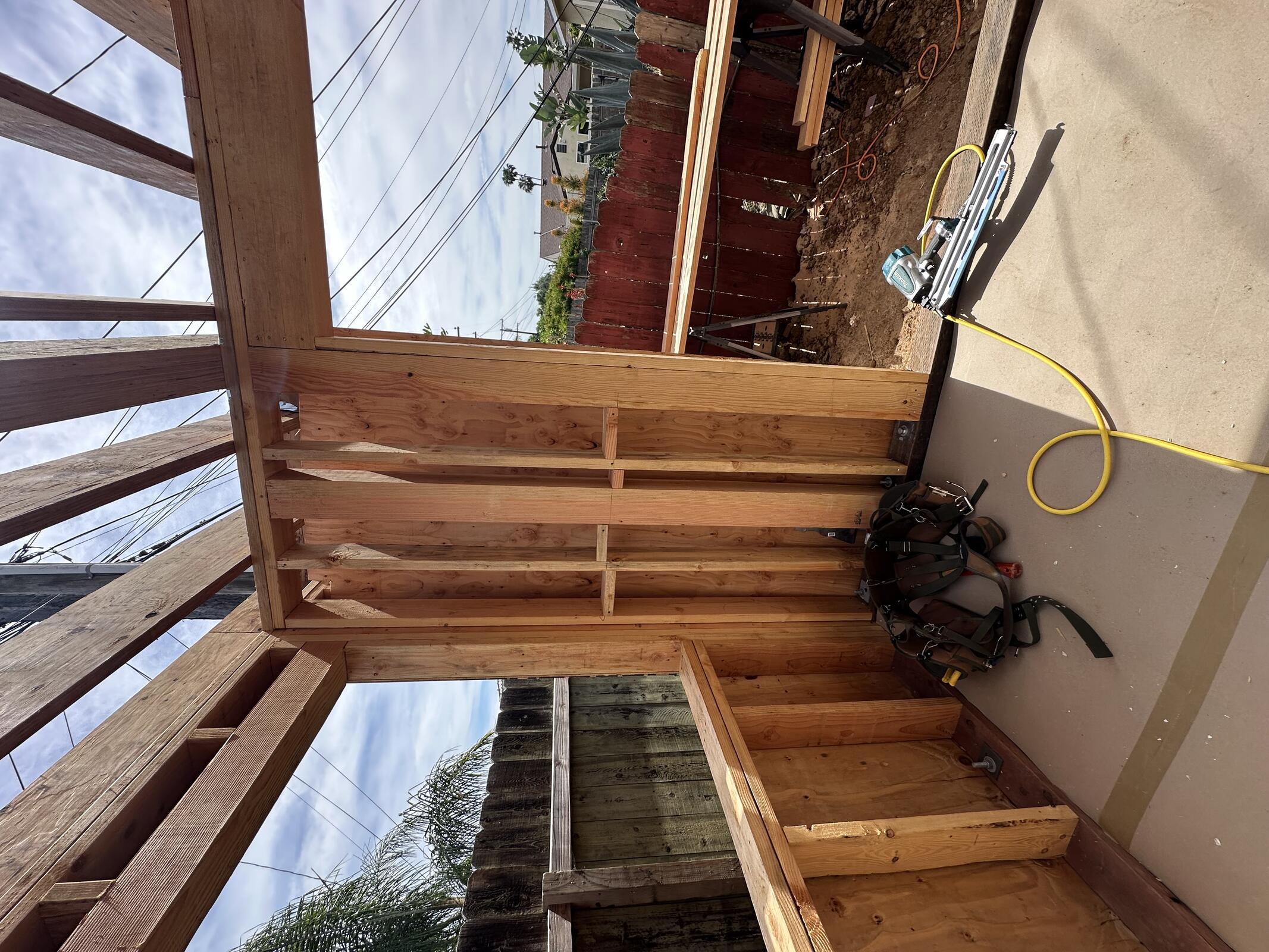

JB General completed floor joists at Structure C and started joists at Structure B.
Inspection of sticks/hold downs scheduled for Wednesday. Floor sheathing to start tomorrow.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| JB General | 5 | 8 | 40 |
| AC Electric | 3 | 8 | 24 |
Inspection: N/A

Wednesday, April 01, 2026
Partially cloudy, 65°F

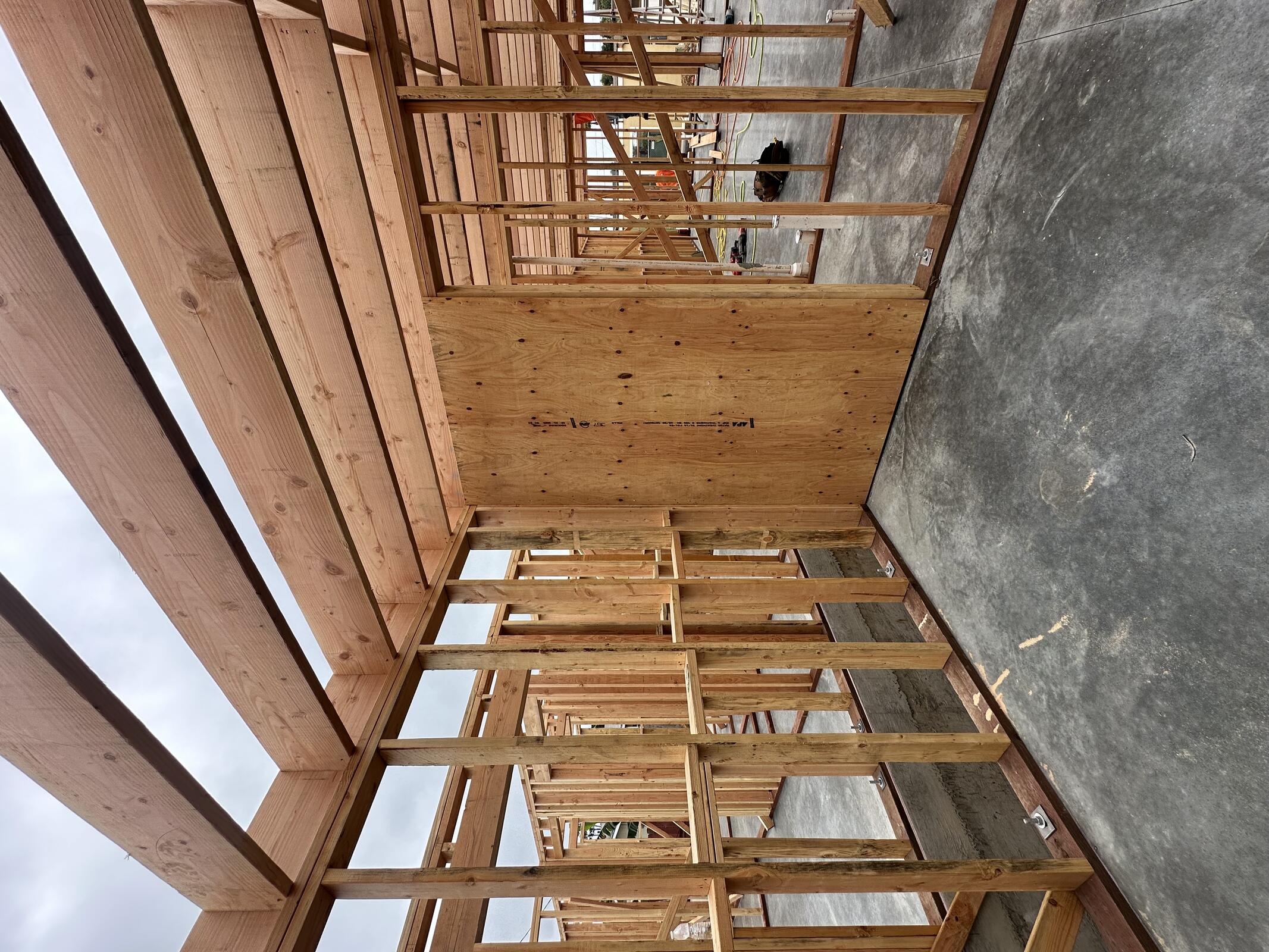

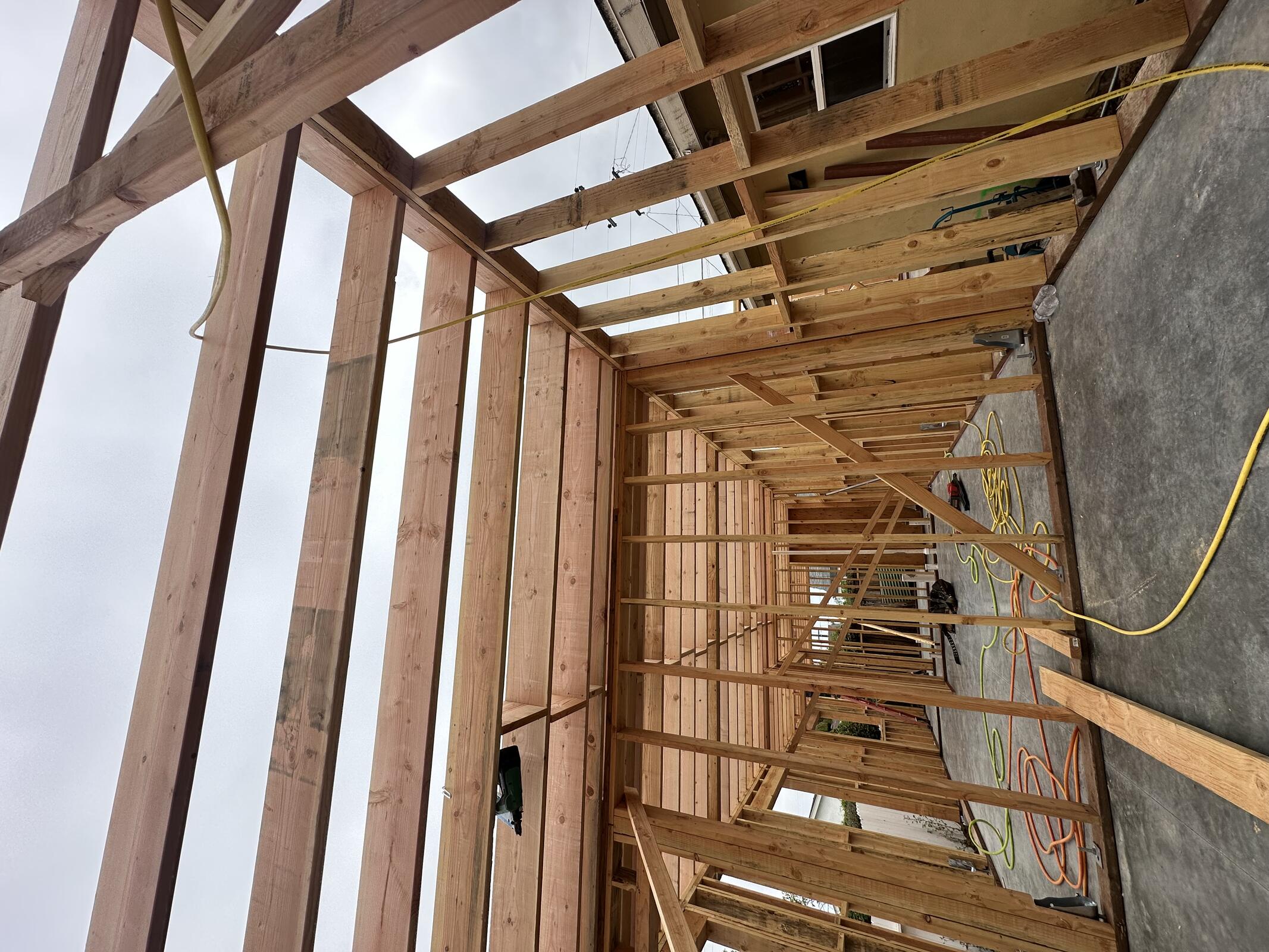

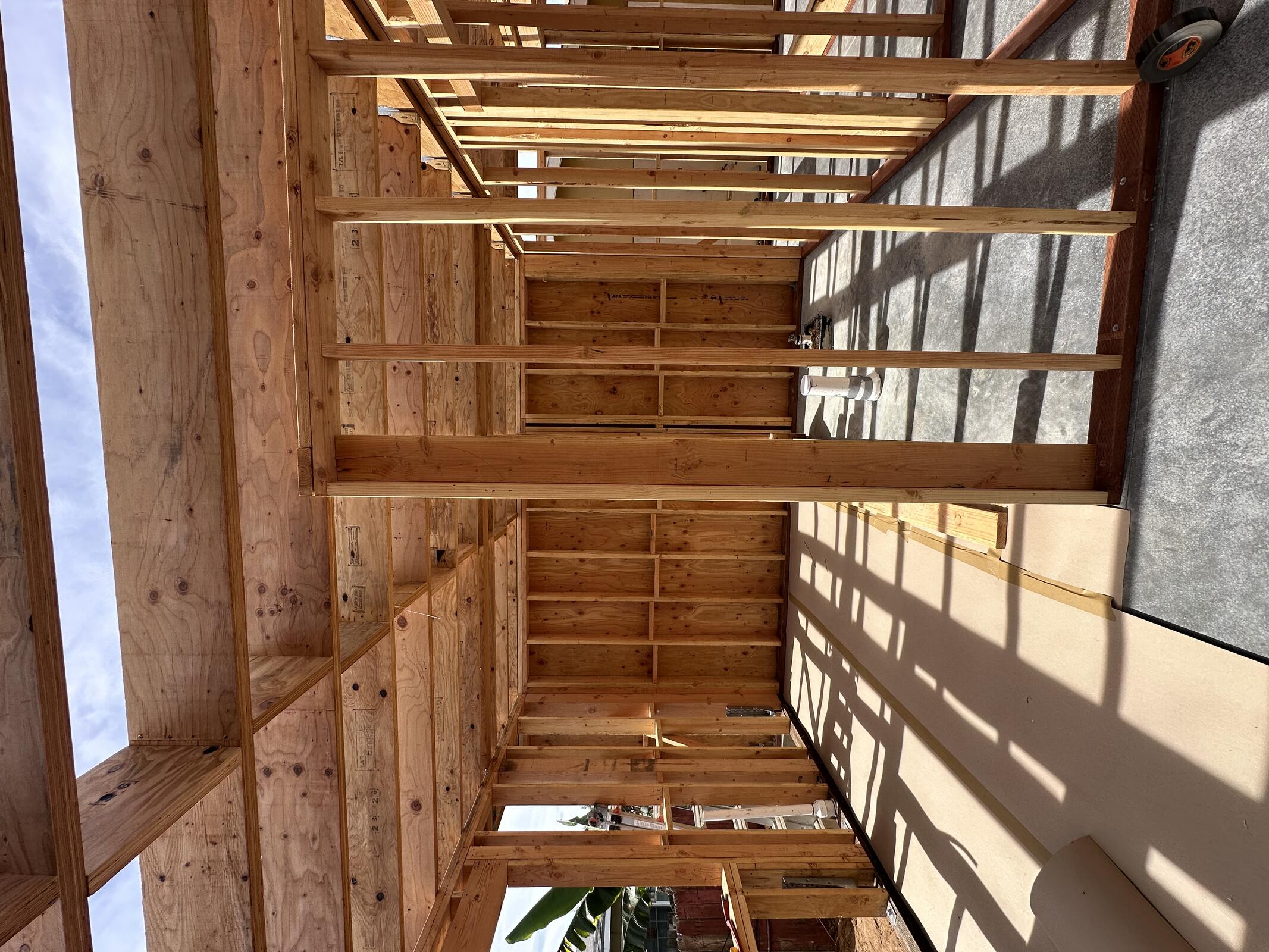

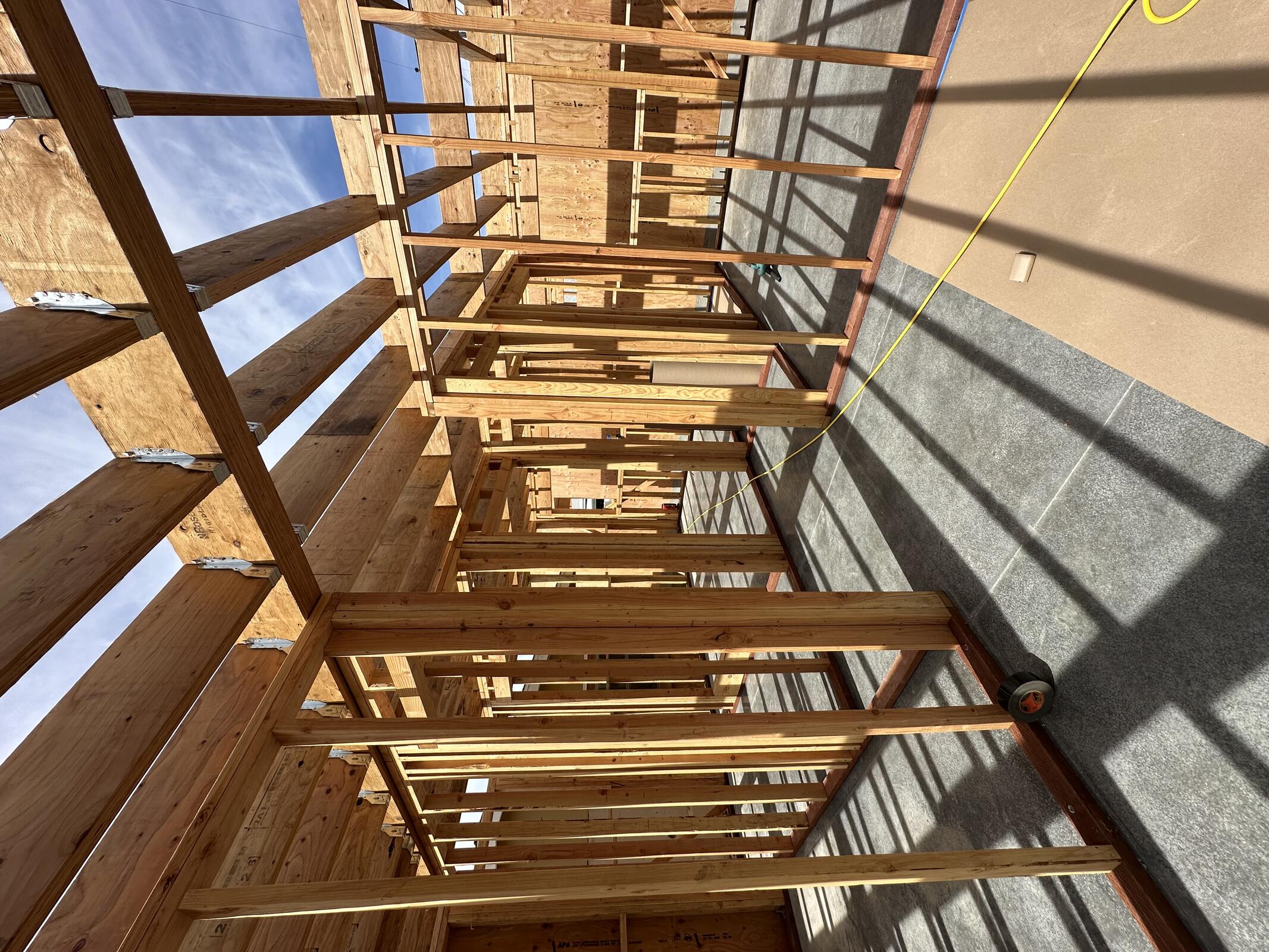

JB General finishing floor joists at Structure B.
Dave Finney came for inspection and gave a partial pass for sticks and holddowns.

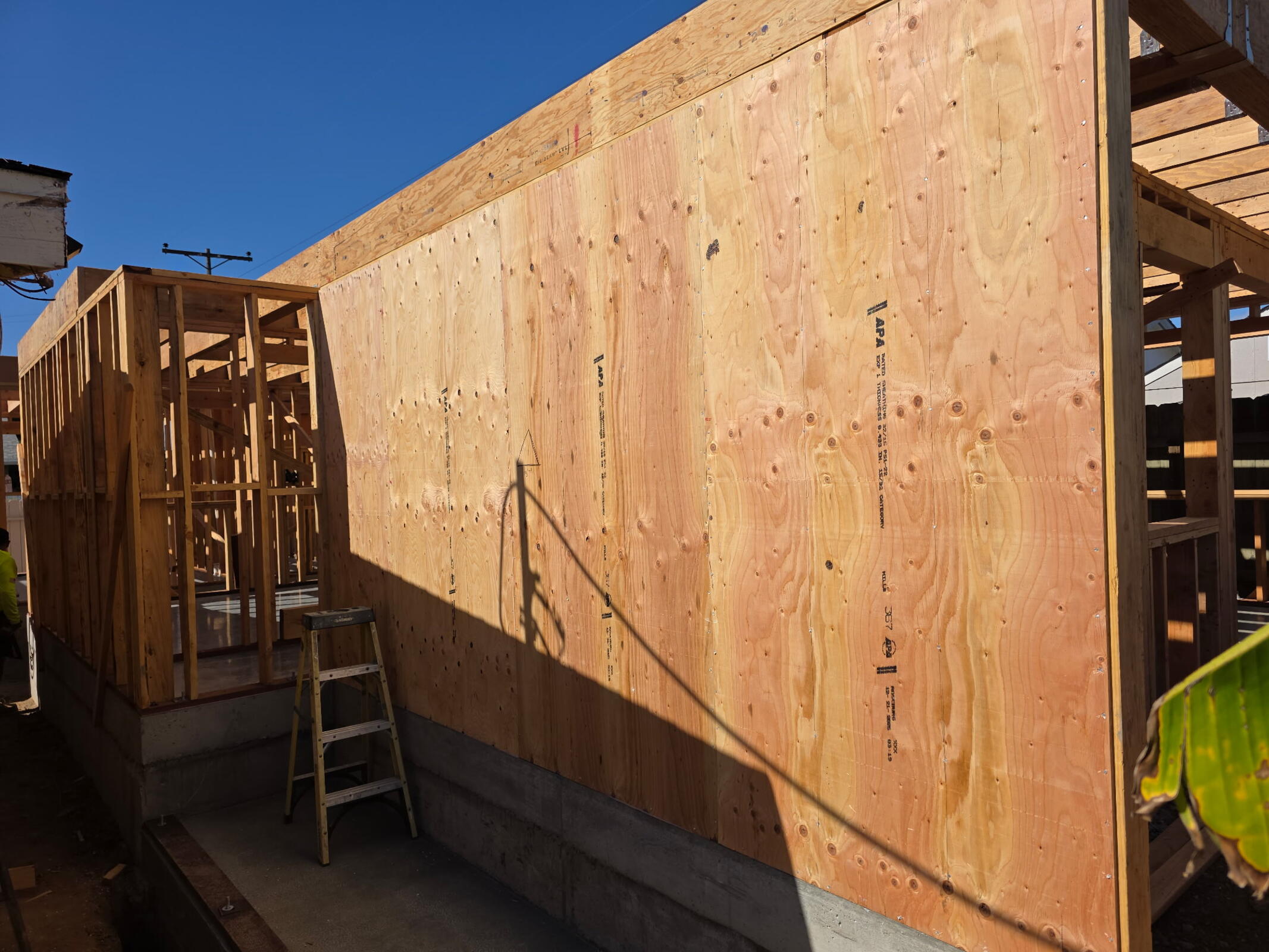

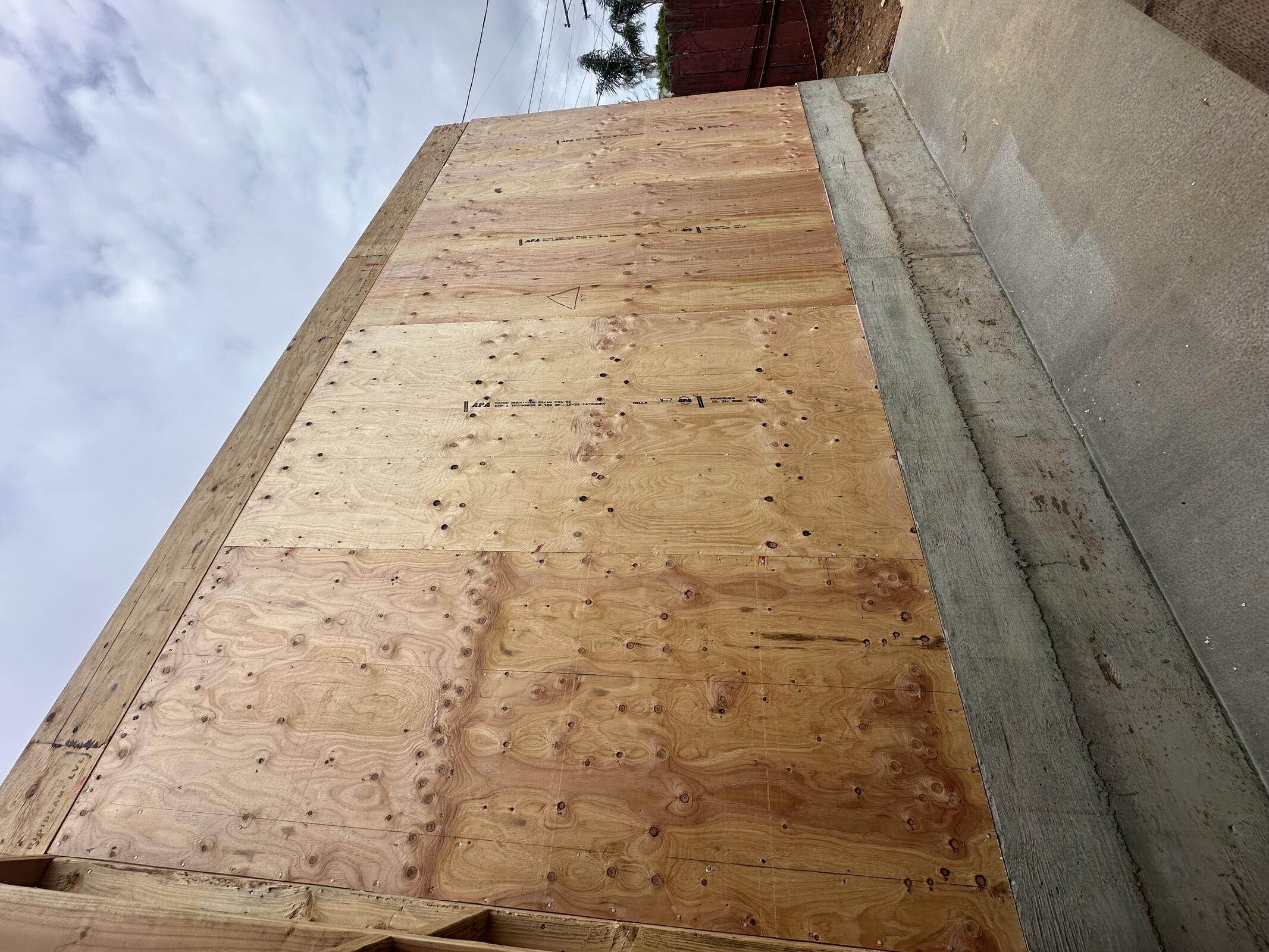

JB General to proceed with Sheathing.
Scaffolding scheduled for Monday. AC Electric to start rough-in on Friday.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| JB General | 5 | 8 | 40 |
Inspection: Partial framing inspection for Buildings B and C.
Delay: Pending answer to RFI006, regarding plumbing penetration. 1070 says it will take a week to get a response, pushing back plumbing rough-in.

Thursday, April 02, 2026
Overcast, 67°F

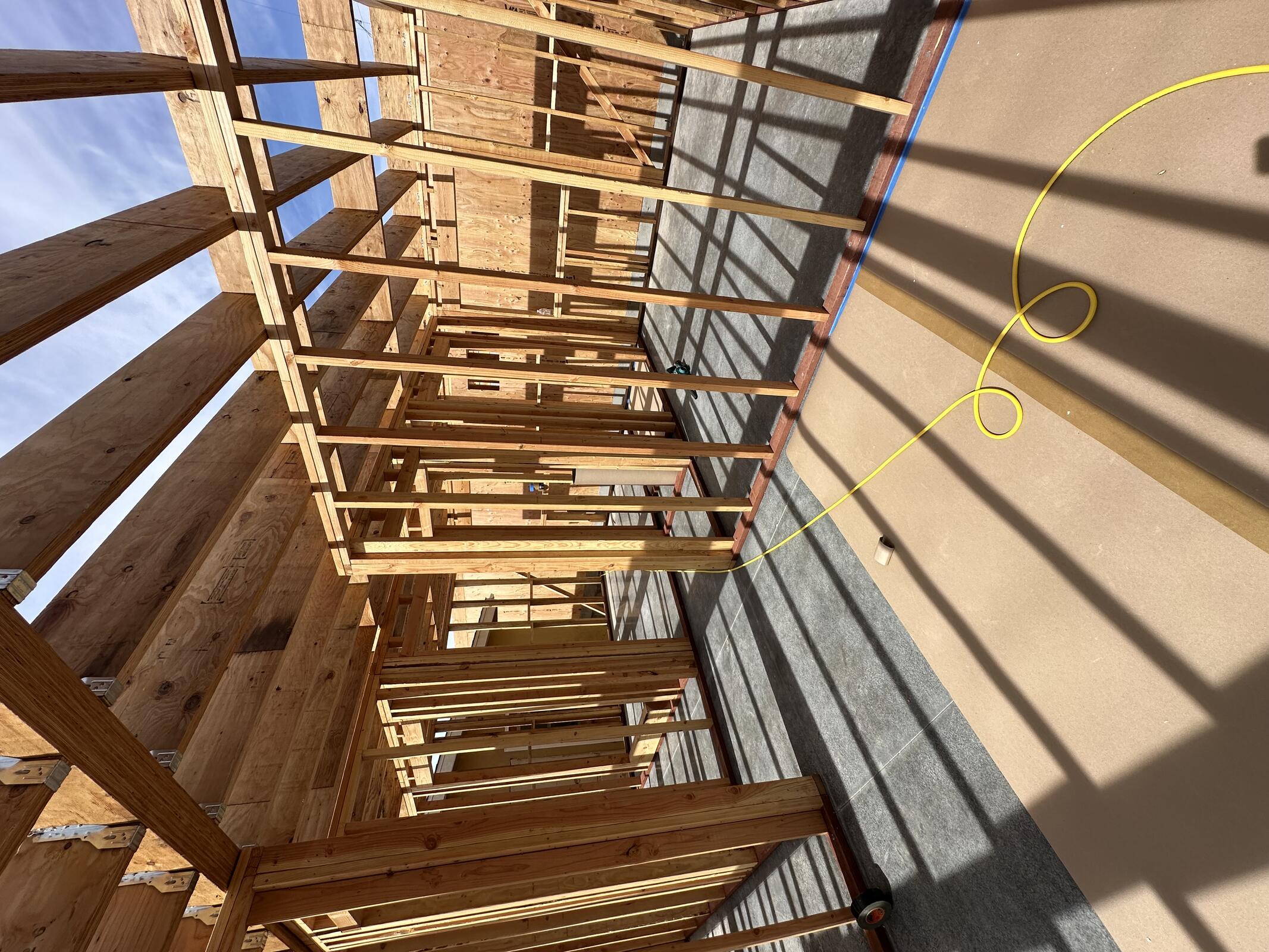

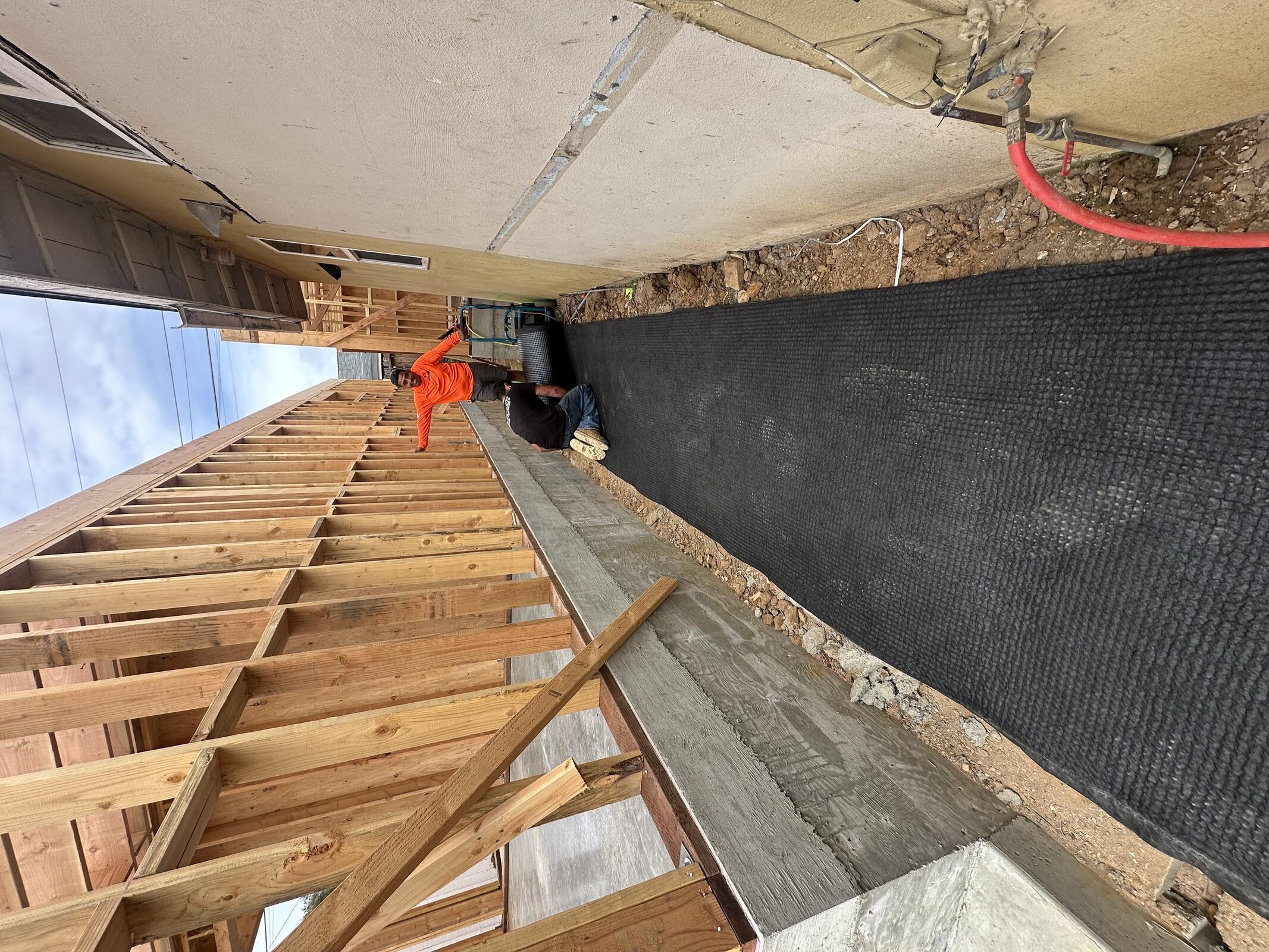

JB General on site, working on sheathing and foundation drains.
Prepping for scaffolding install and MEP rough-in next week.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| JB General | 5 | 8 | 40 |
Inspection: N/A

Friday, April 03, 2026
Partially cloudy, 69°F

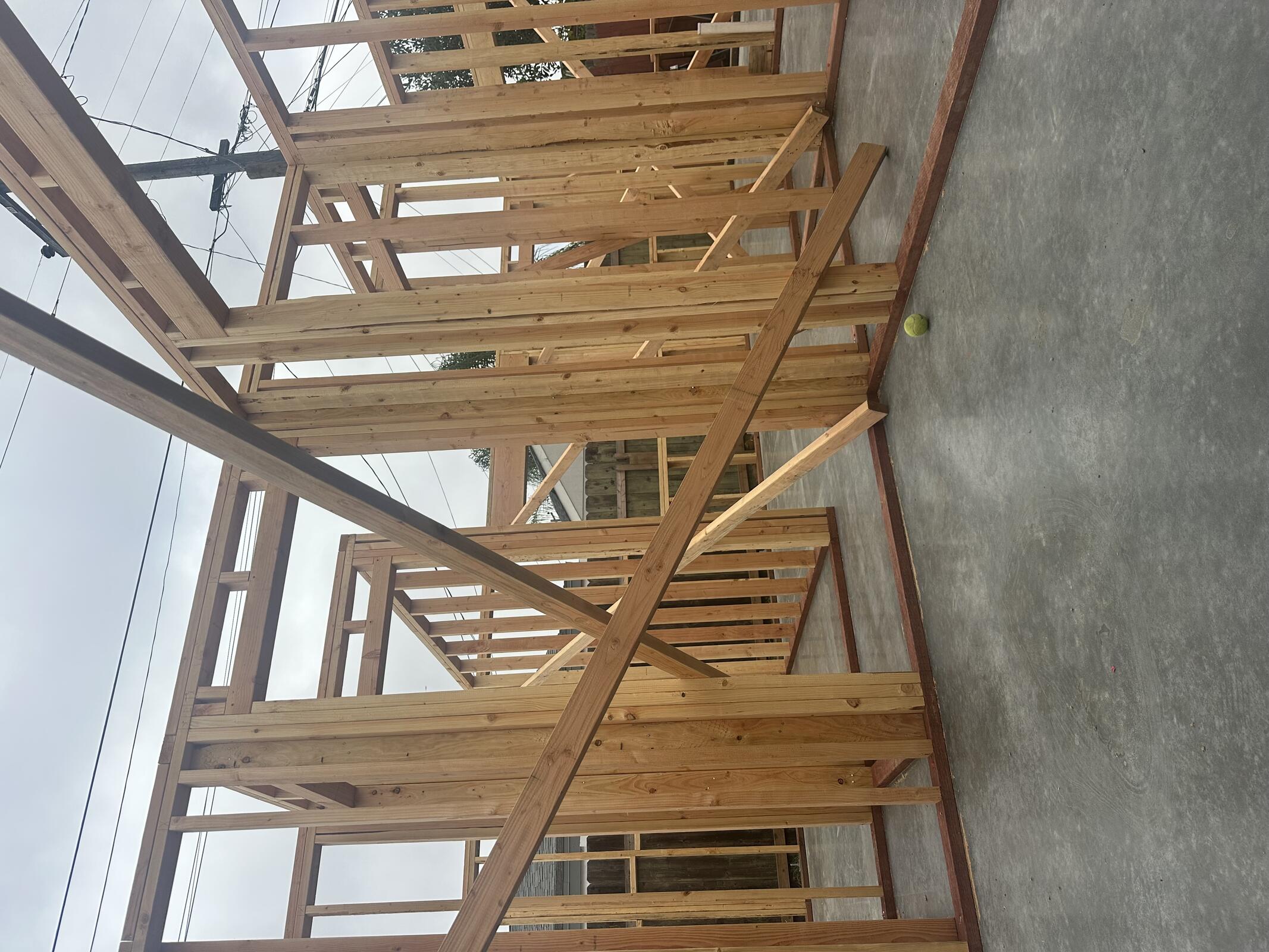

JB General continuing to sheath both buildings. Drainage mats and drains installed along back property line and walls backfilled to prepare for scaffolding installation.
First floor scaffolding to be installed tomorrow (4/3/26).
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| JB General | 5 | 8 | 40 |
Inspection: N/A
