Week of March 23 — March 27, 2026
5 days on site. 51 photos. Foundations, Framing, ROW.
Monday, March 23, 2026
Clear, 72°F

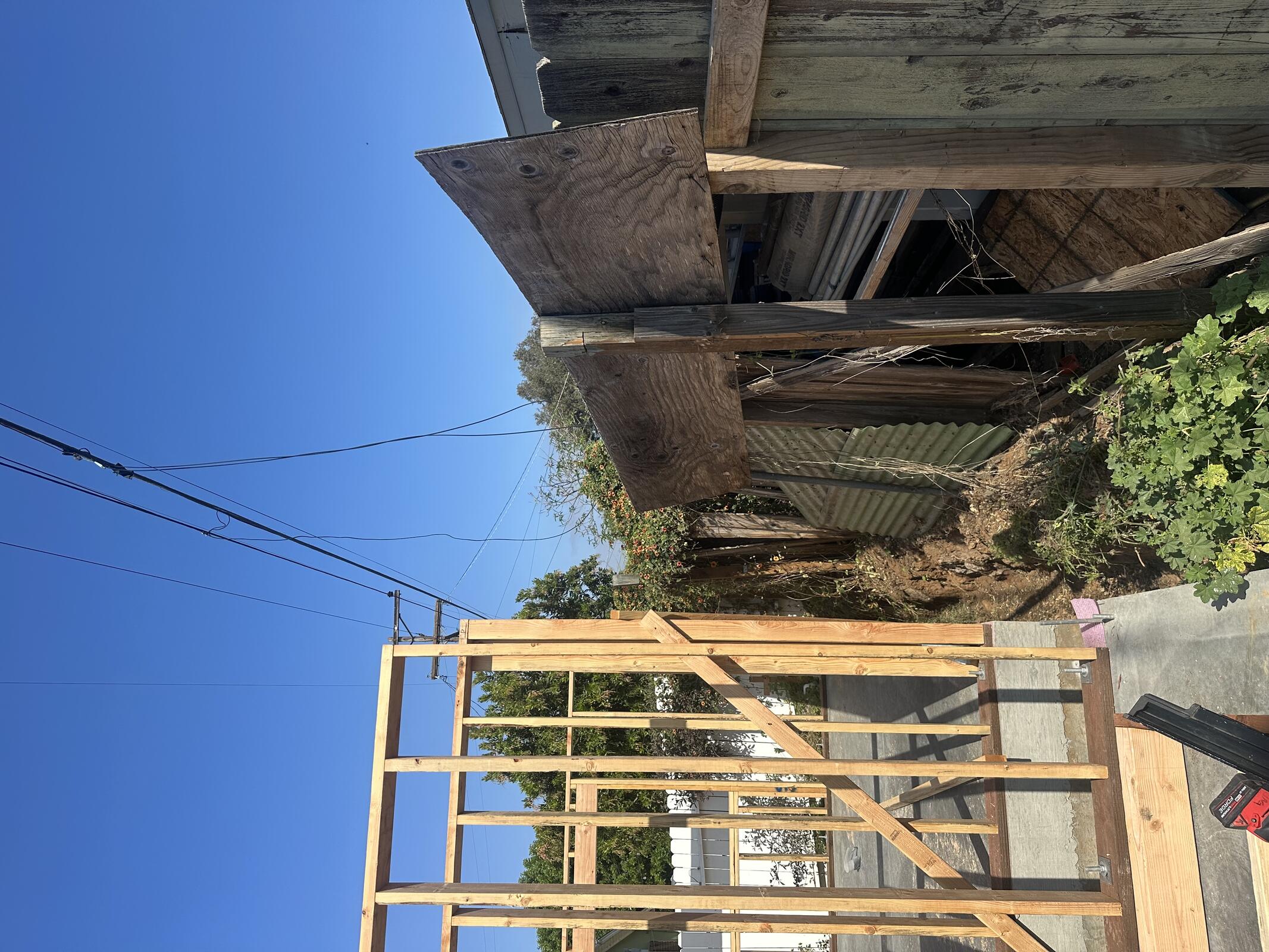

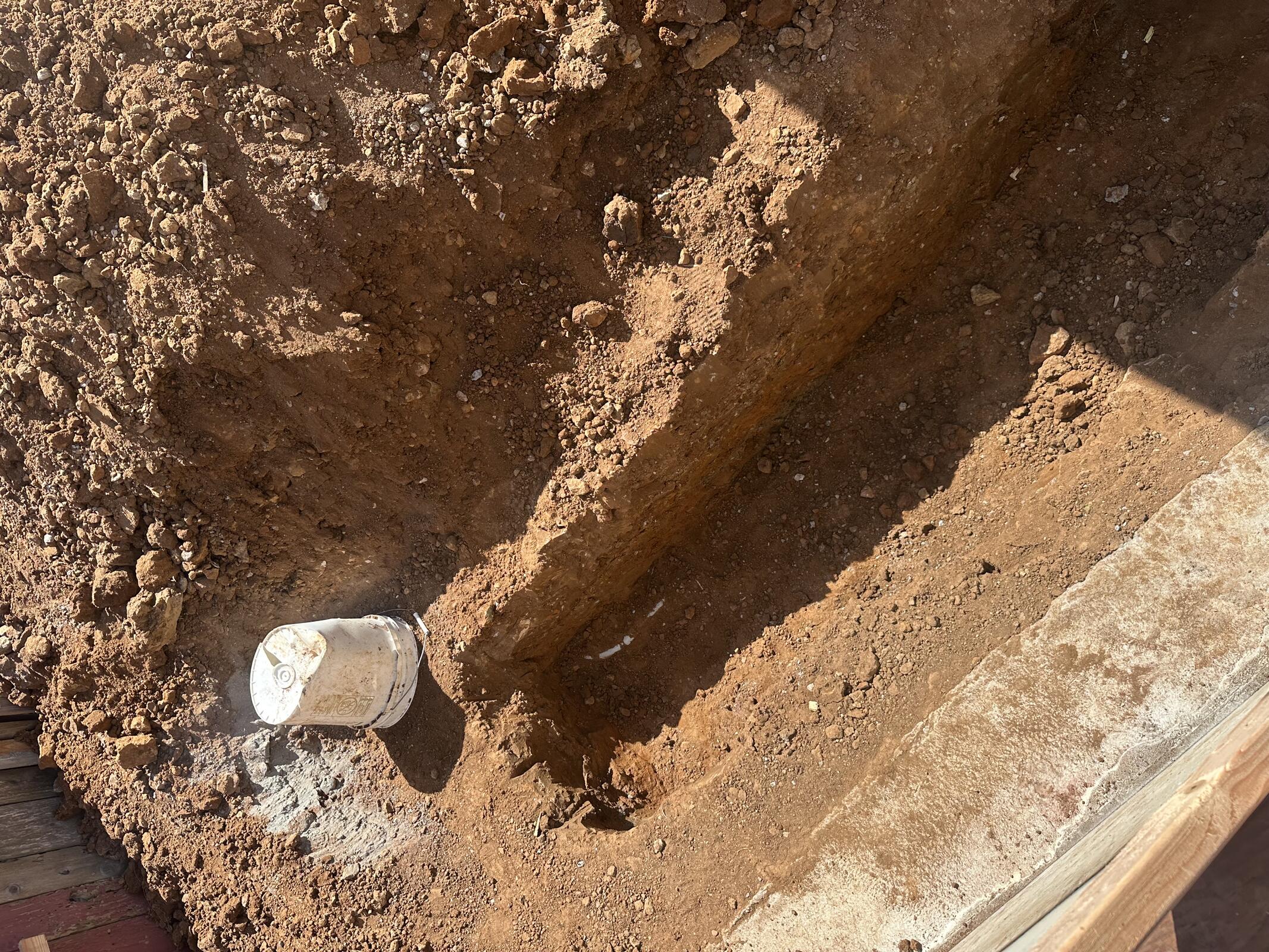

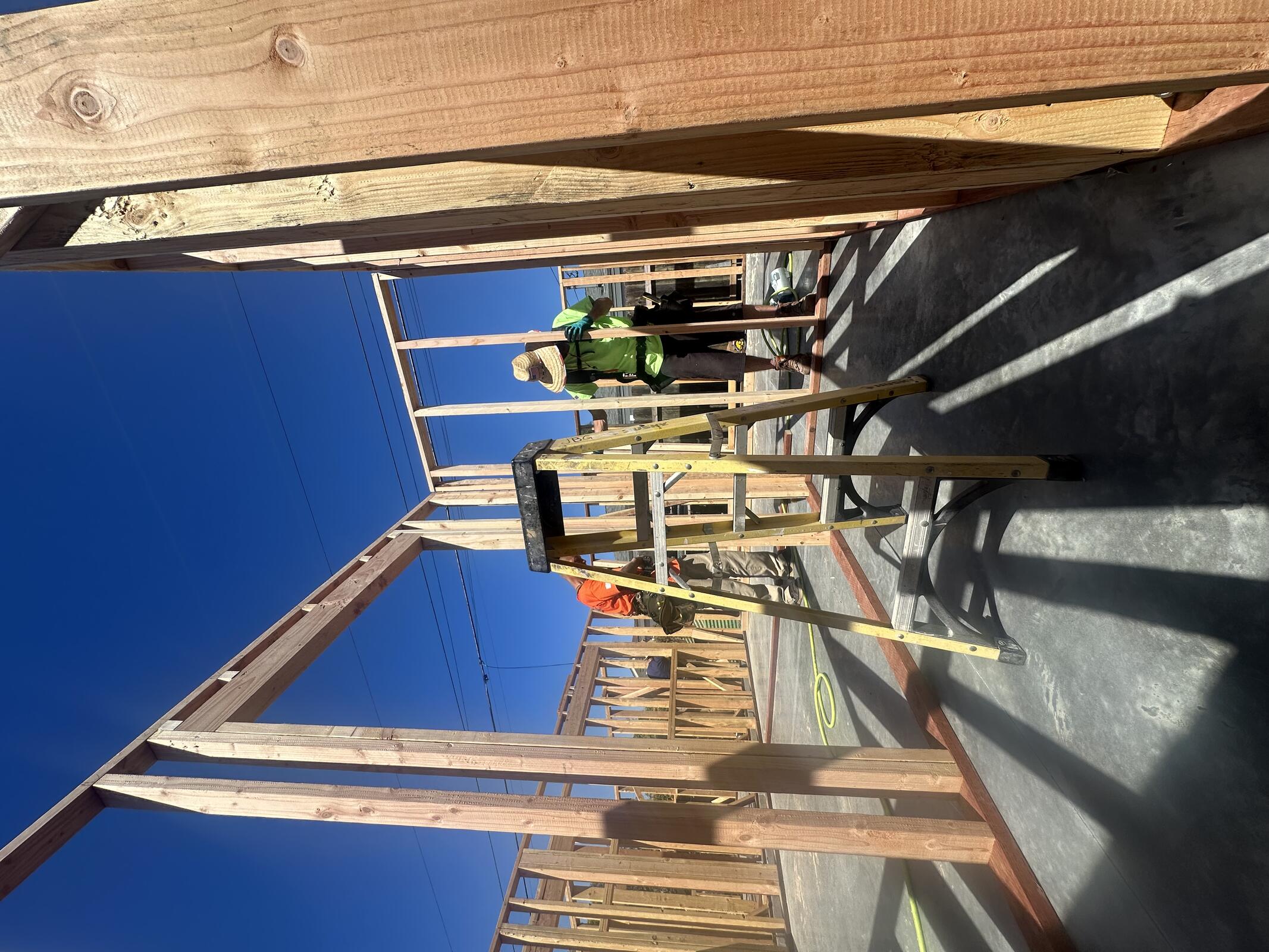

JB General on site. Walls for Structure C stair landing formed and templated. Footings for Structure B Stairs and WH enclosure hand dug. First floor framing still in progress.

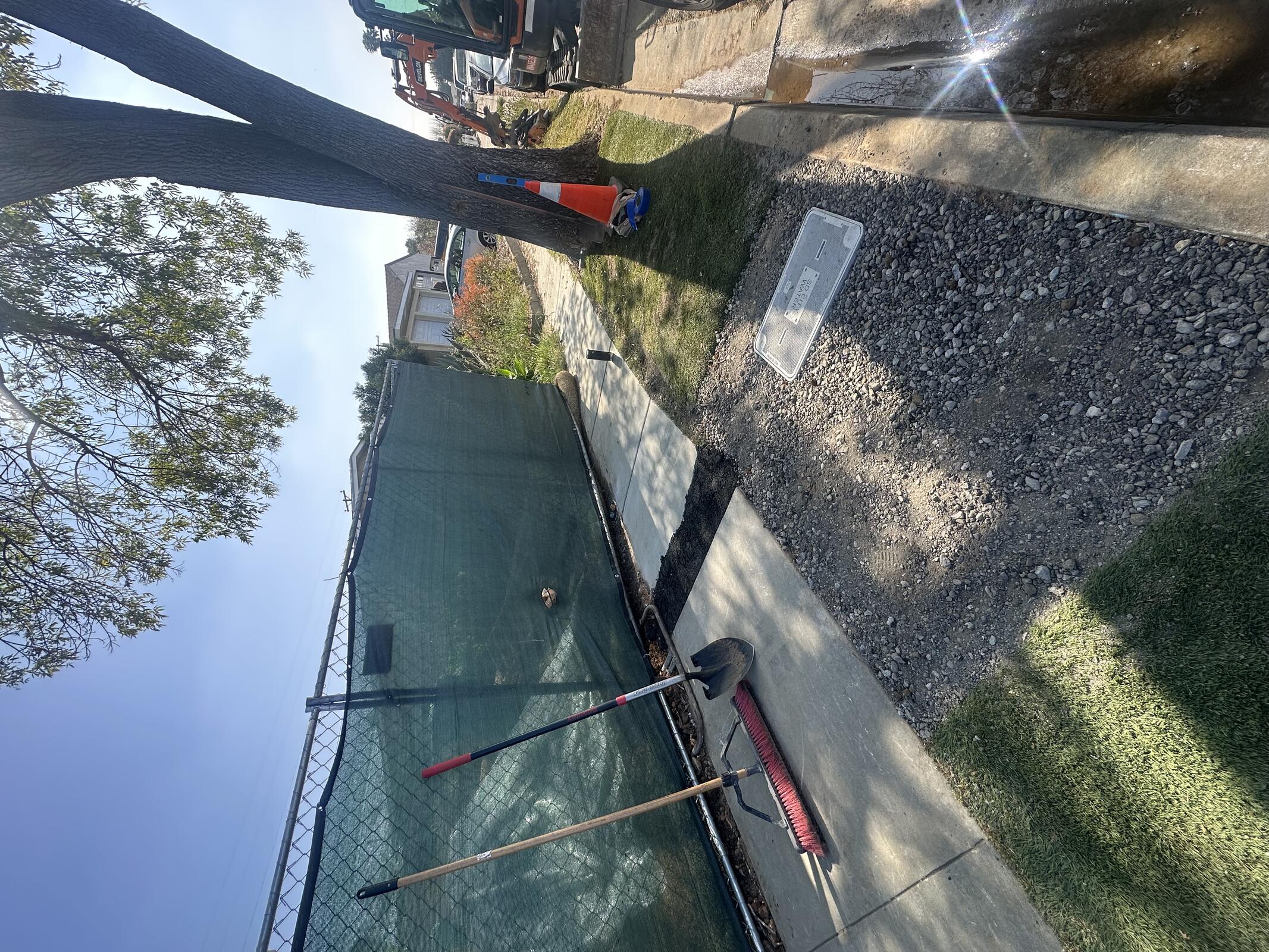

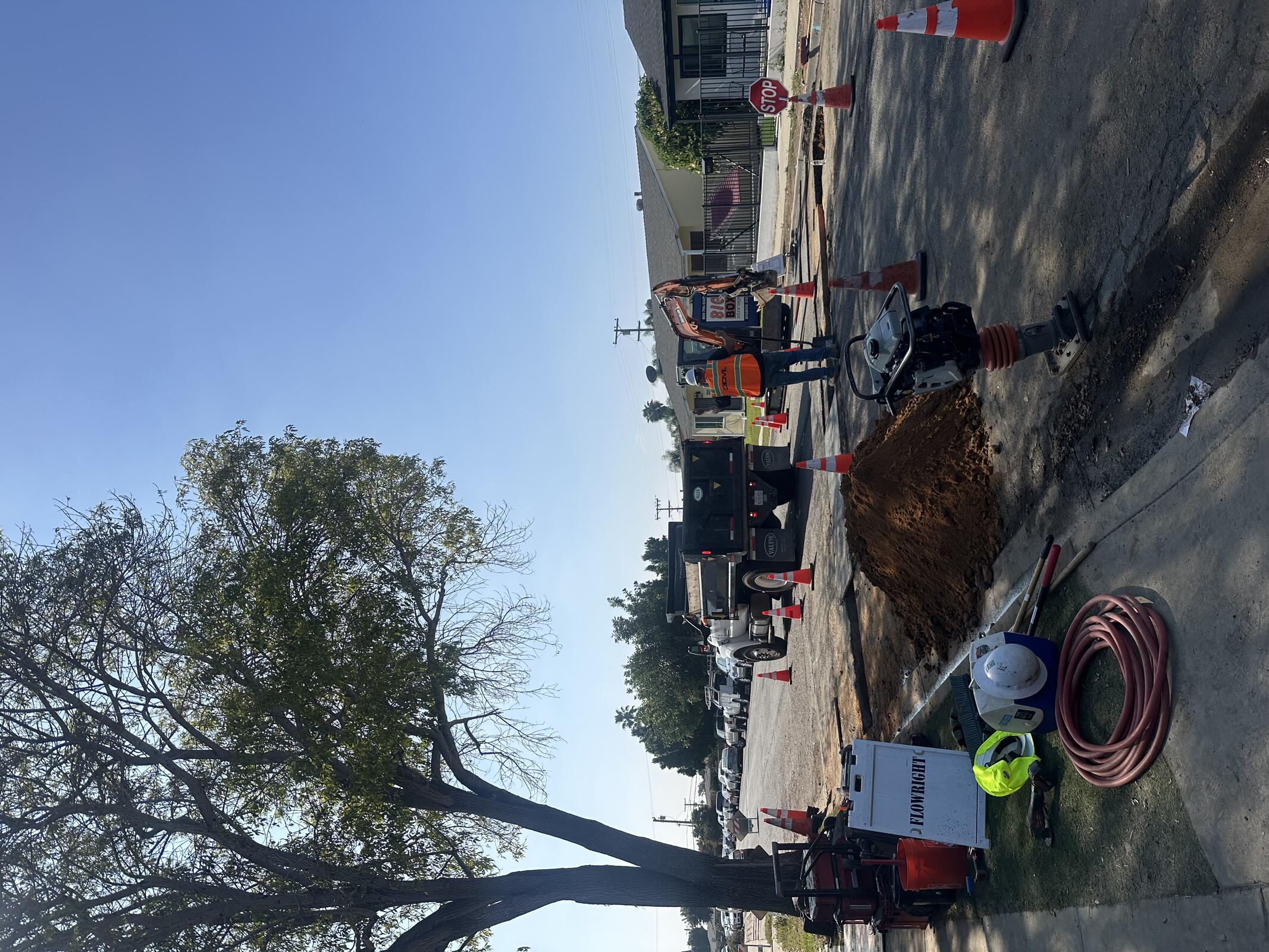

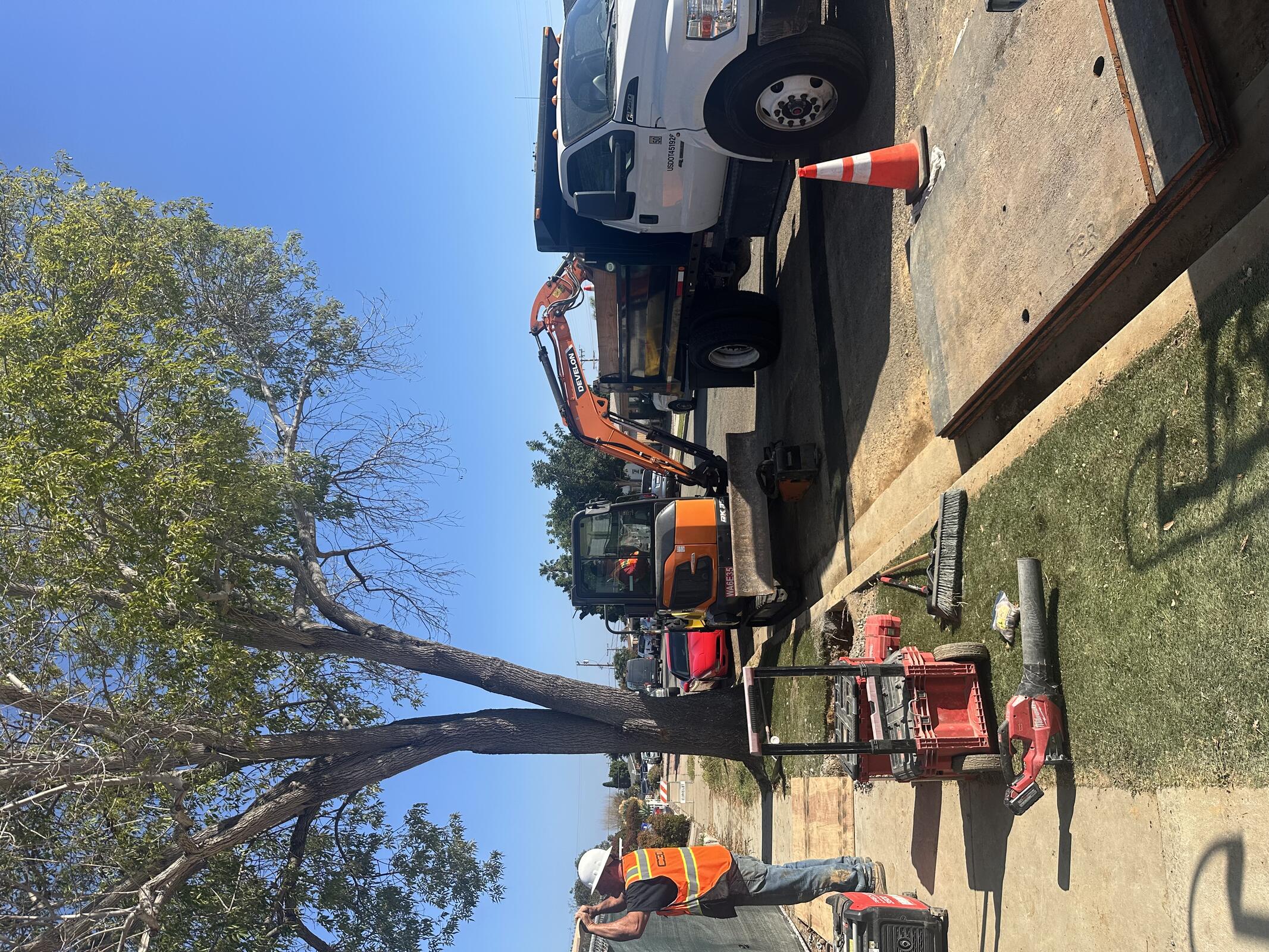

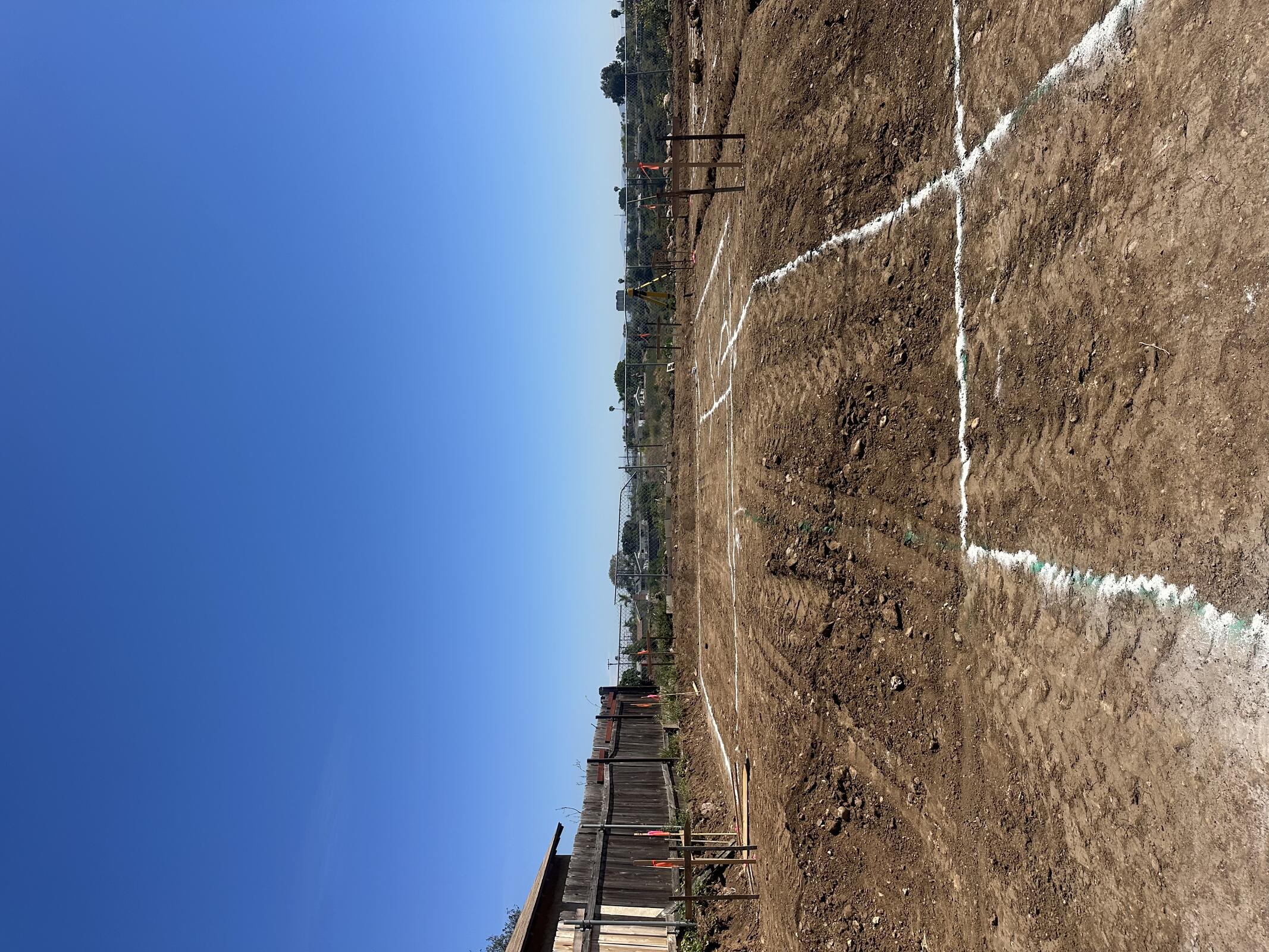

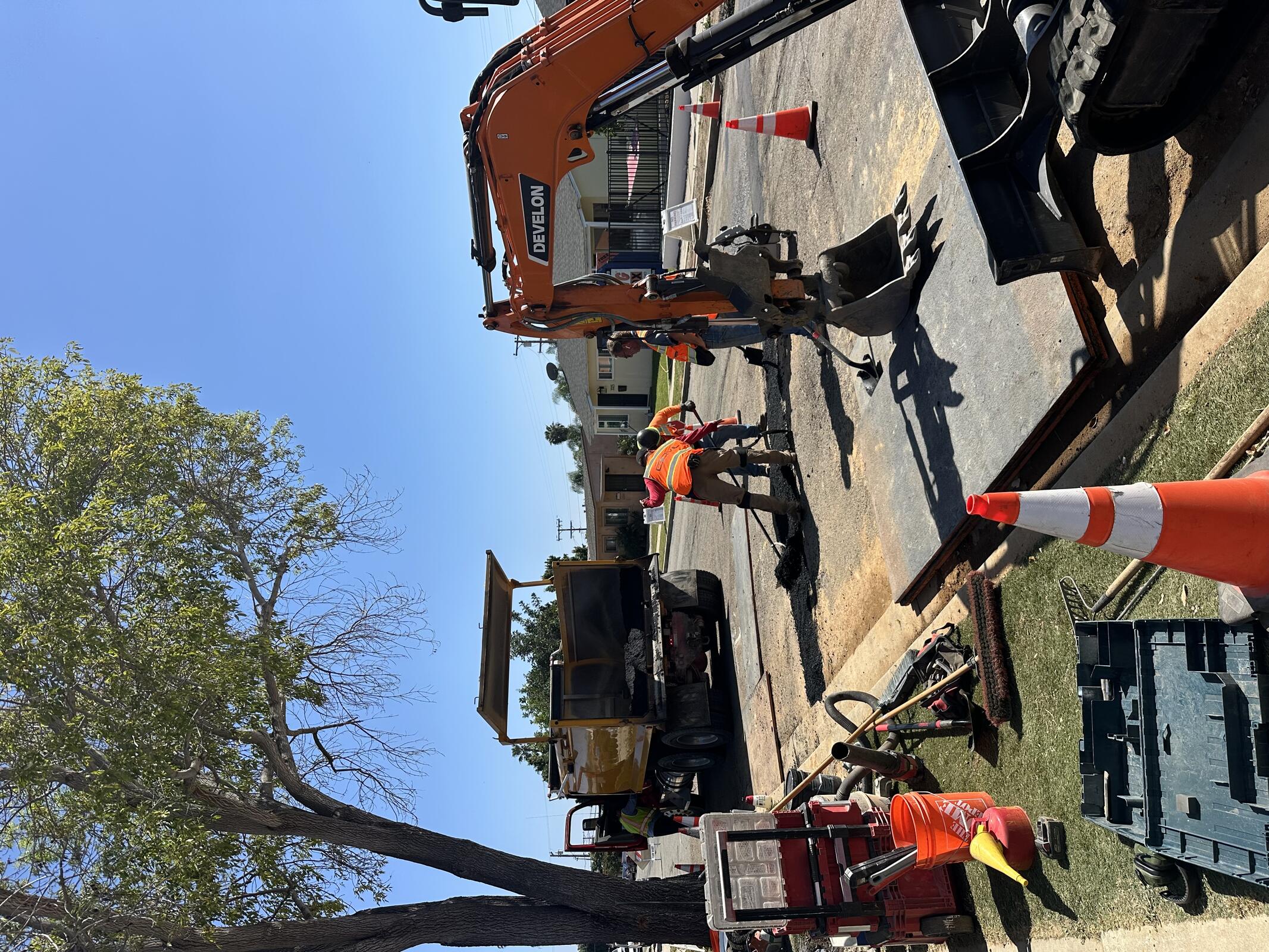

C3, continuing to dig trench for new water service. Base pave complete.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| C3 | 4 | 8 | 32 |
| JB General | 9 | 8 | 72 |
Inspection: N/A

Tuesday, March 24, 2026
Clear, 74°F

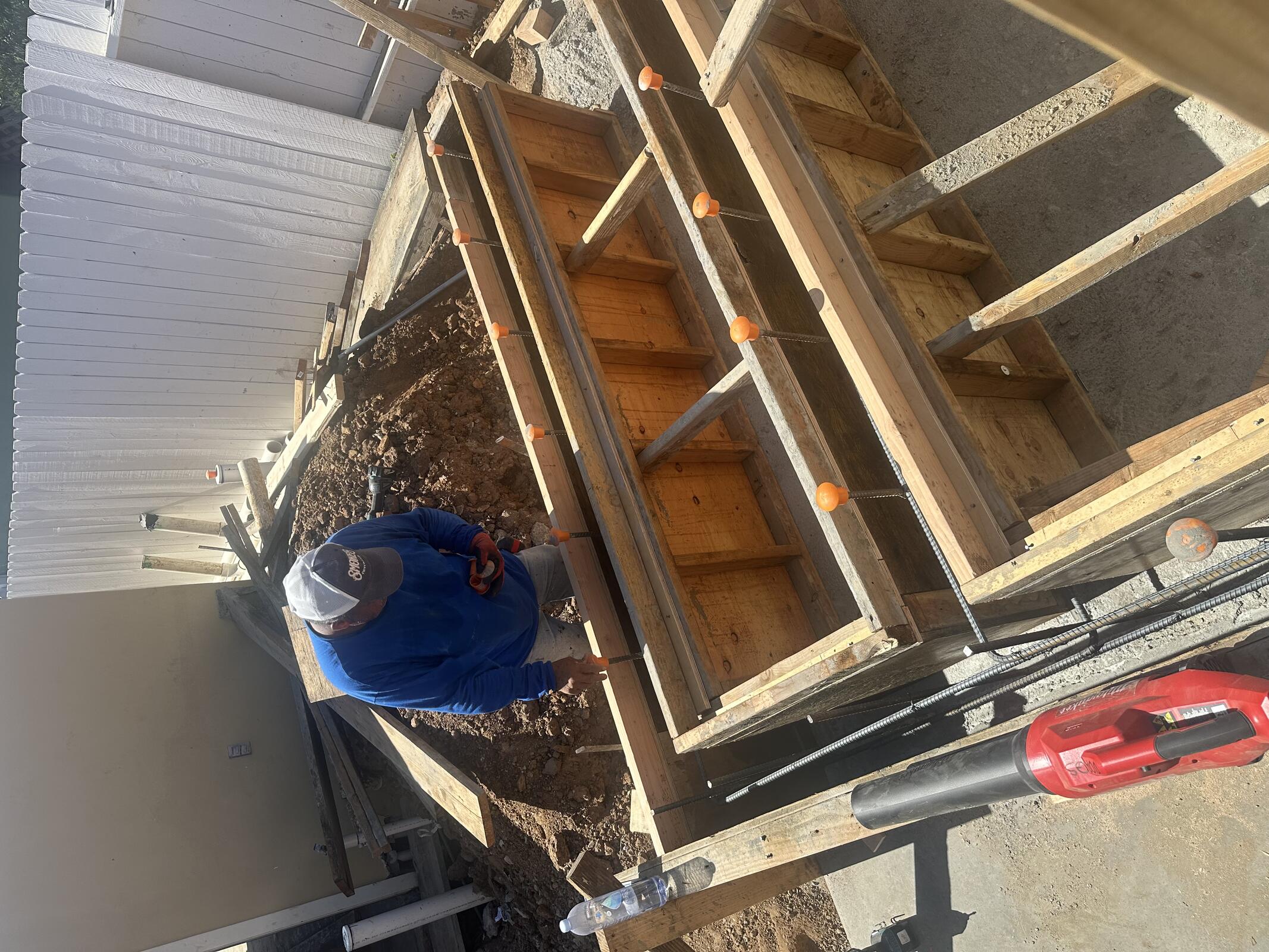

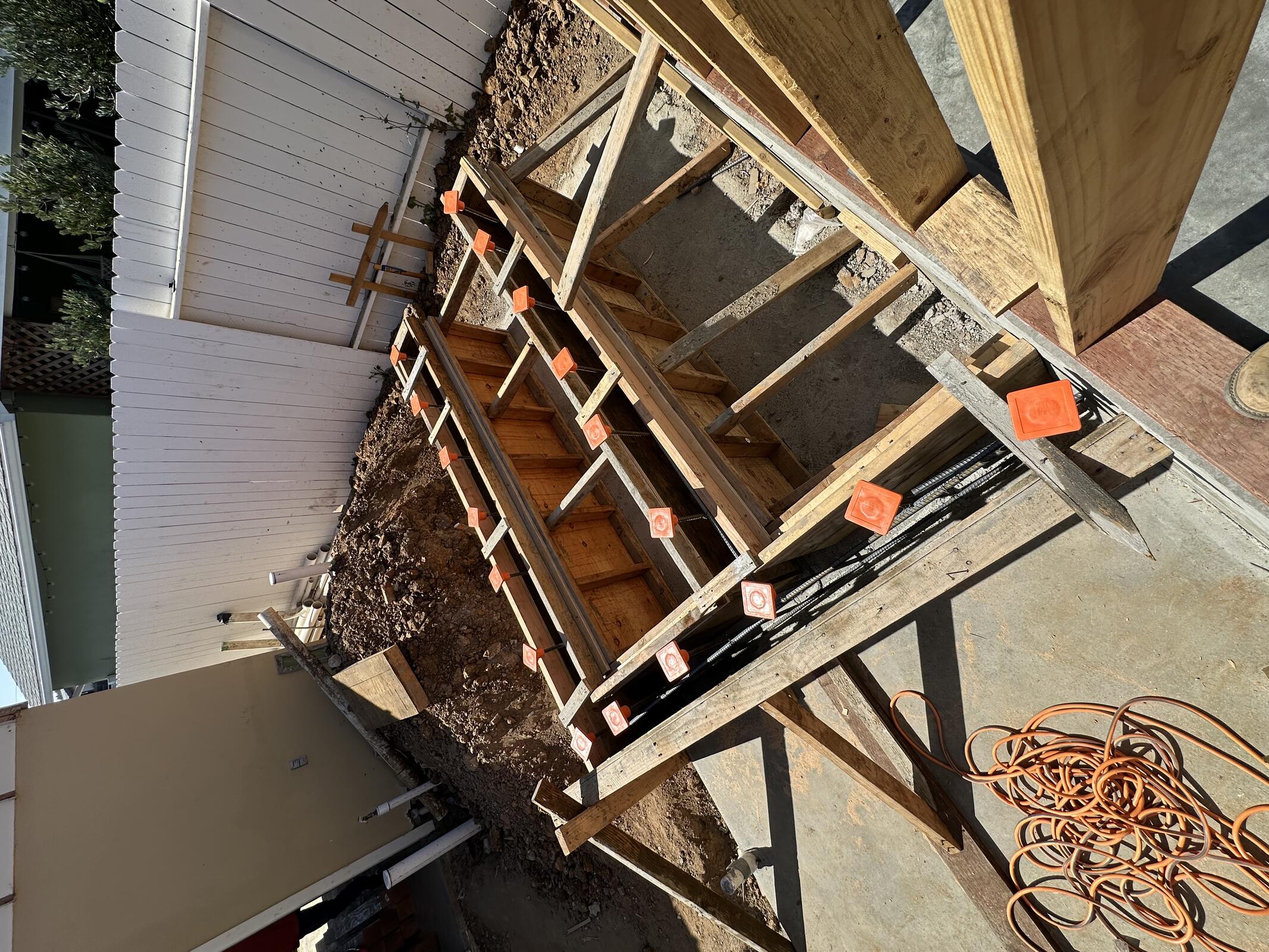

JB General added rebar and forms for Structure B stair footing.

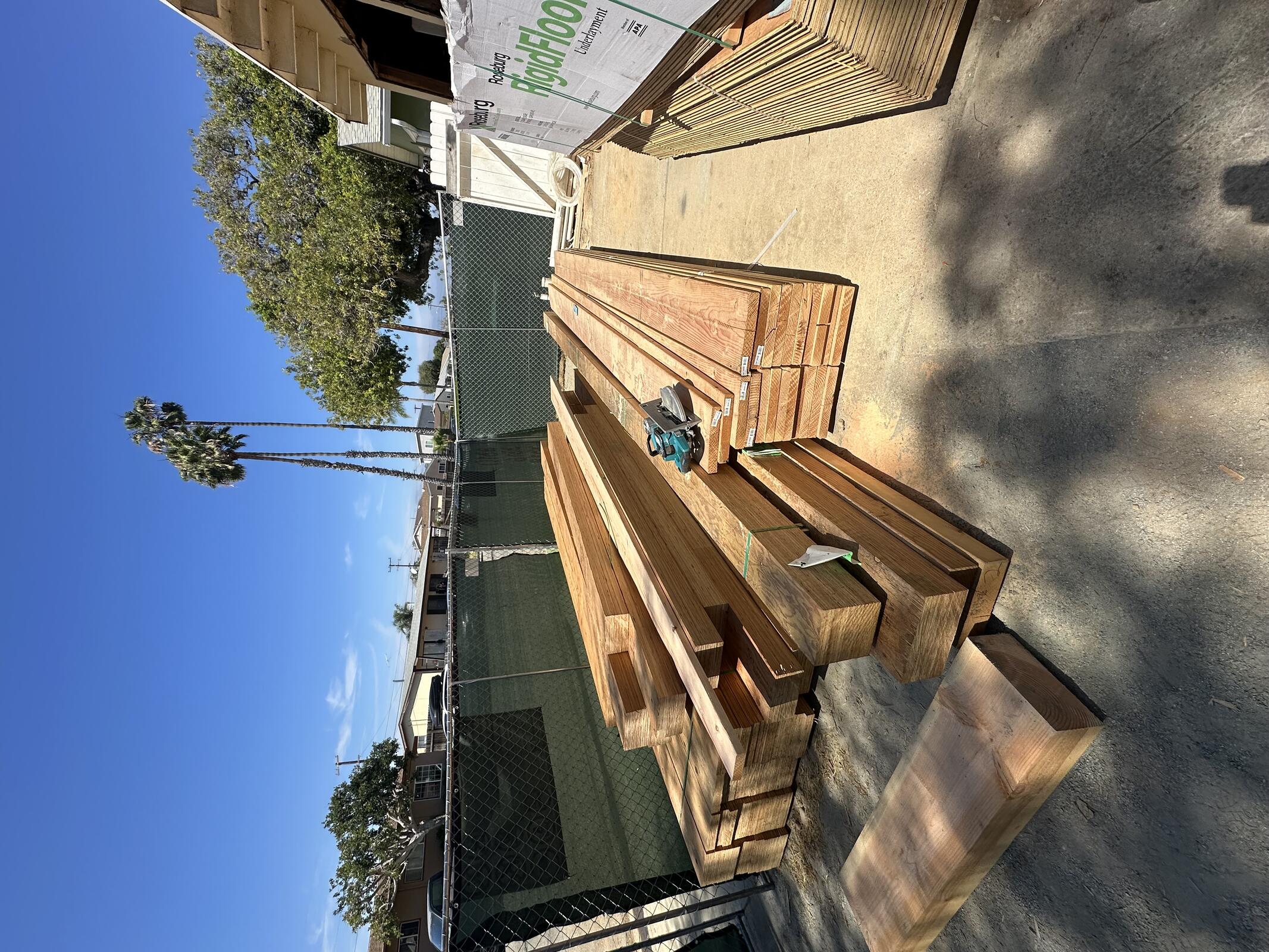

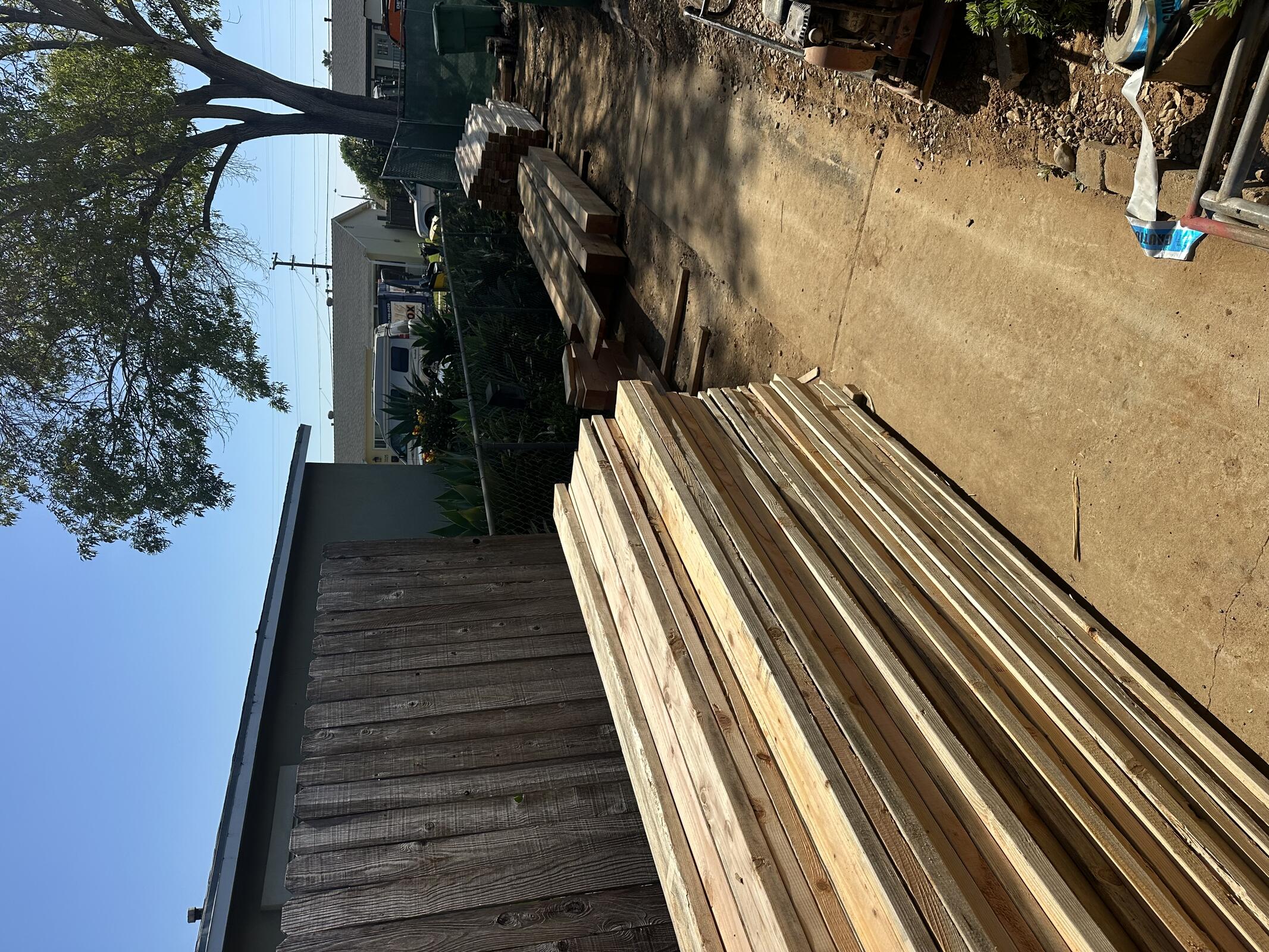

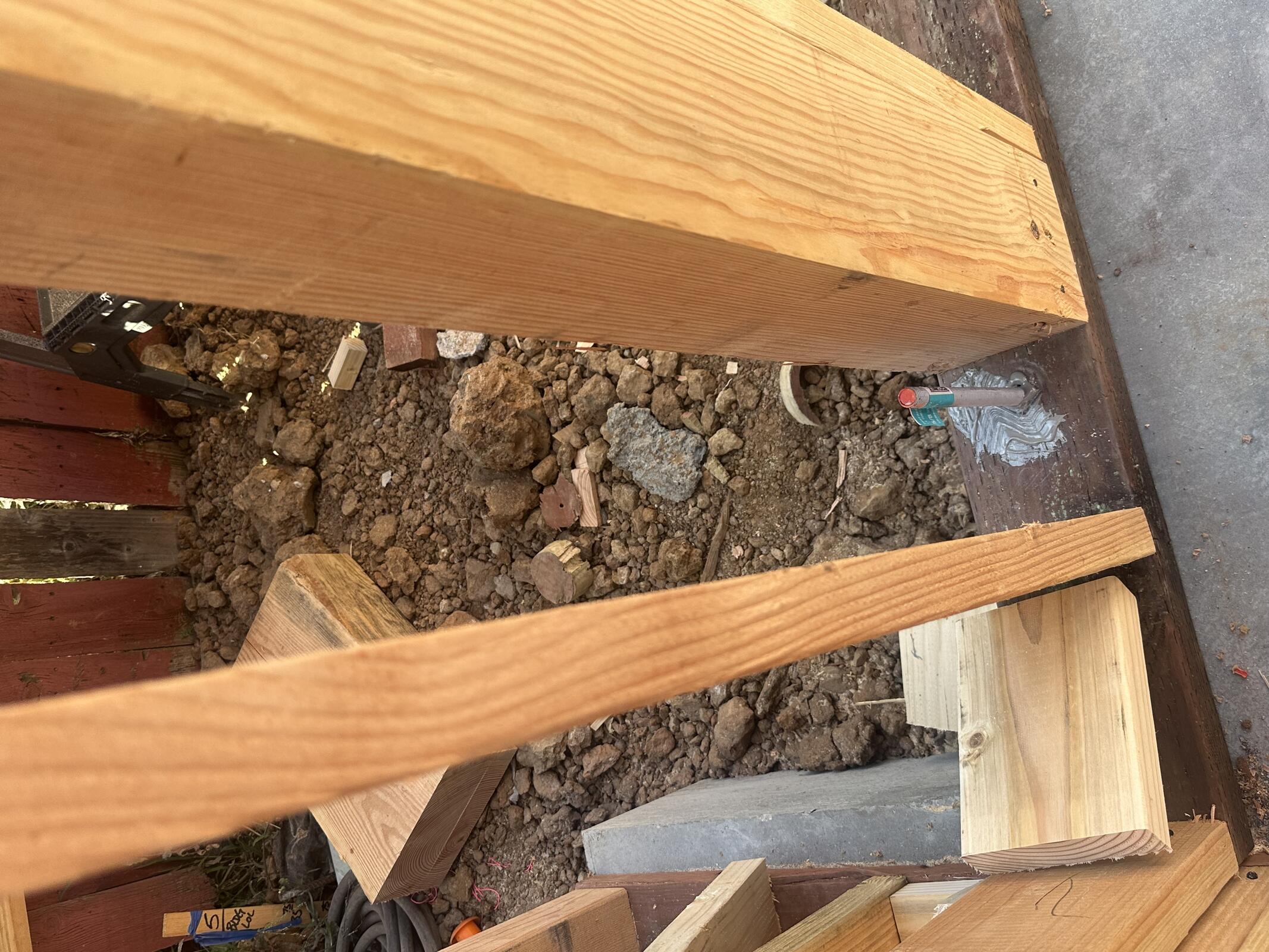

Debris from fence demo, scrap pieces of wood, and other trash hauled off. More lumber delivered.

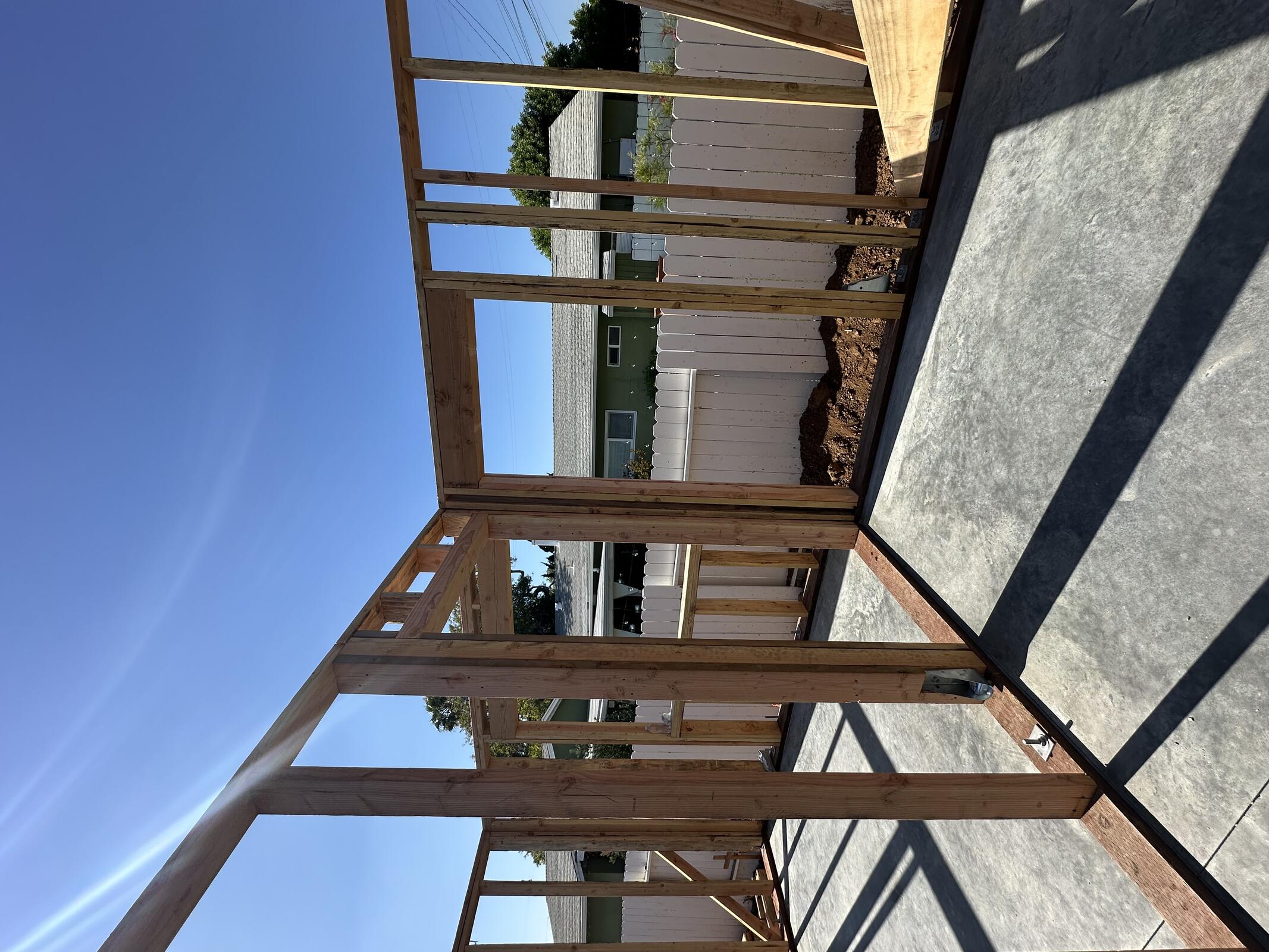

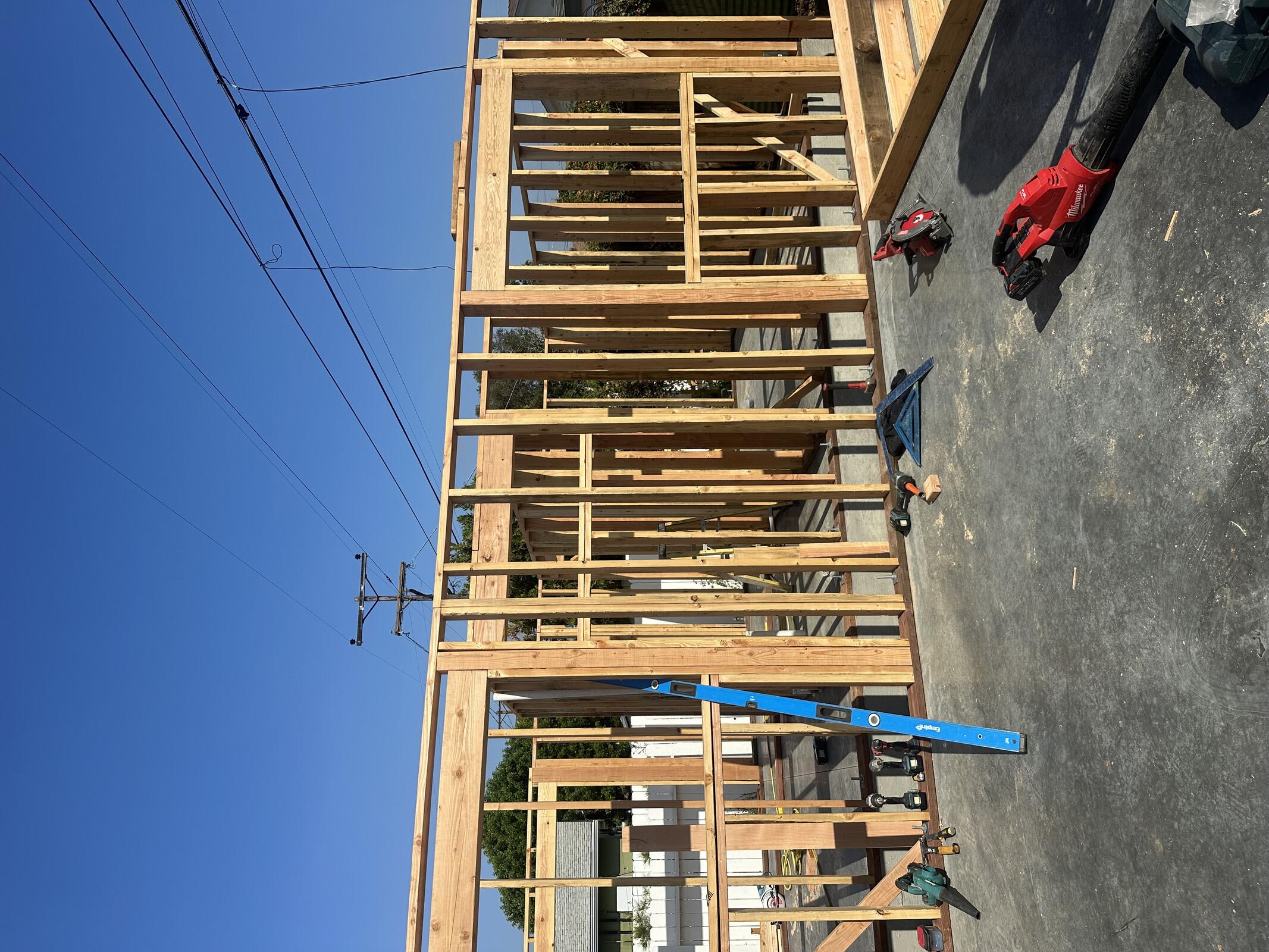

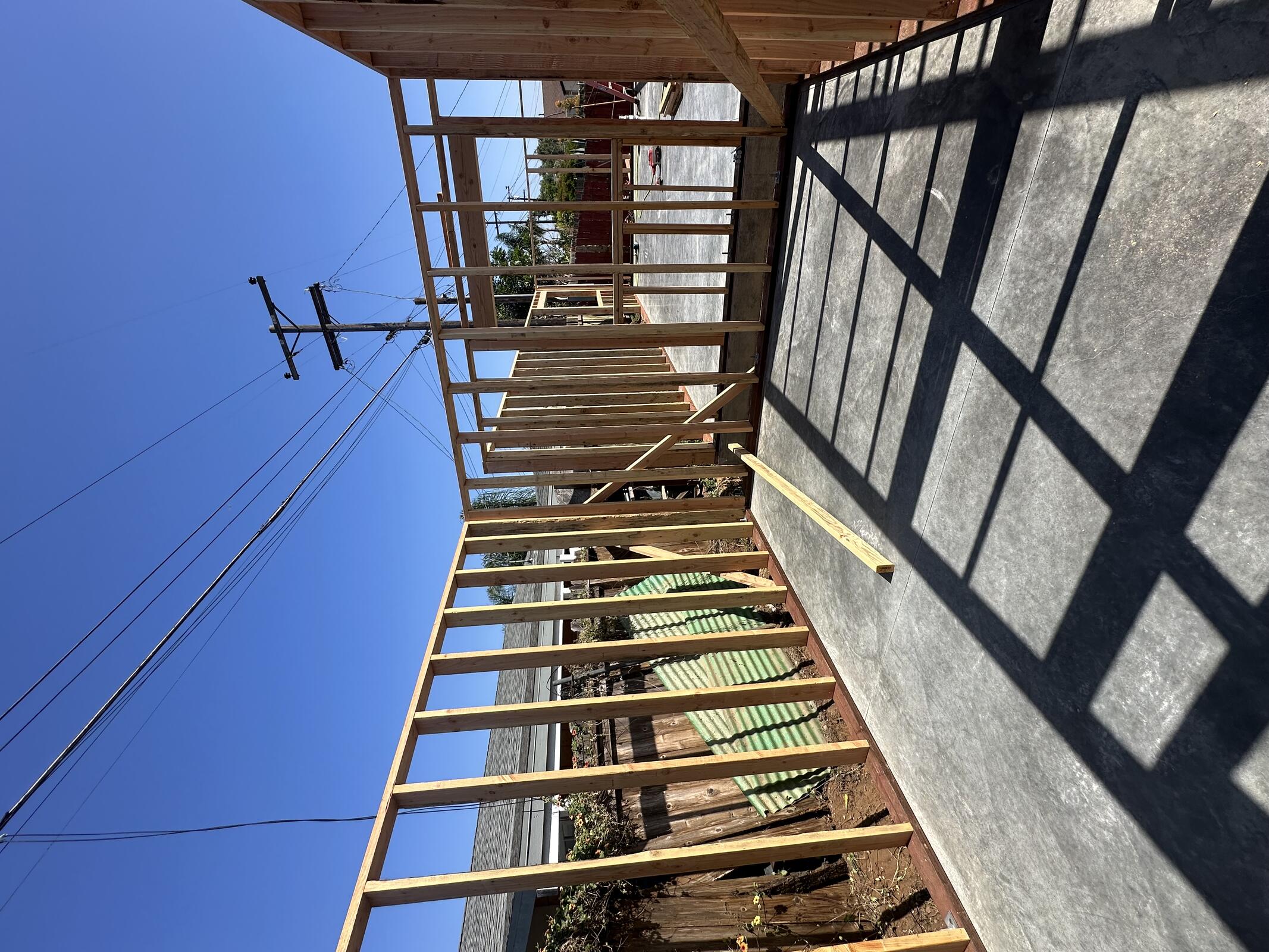

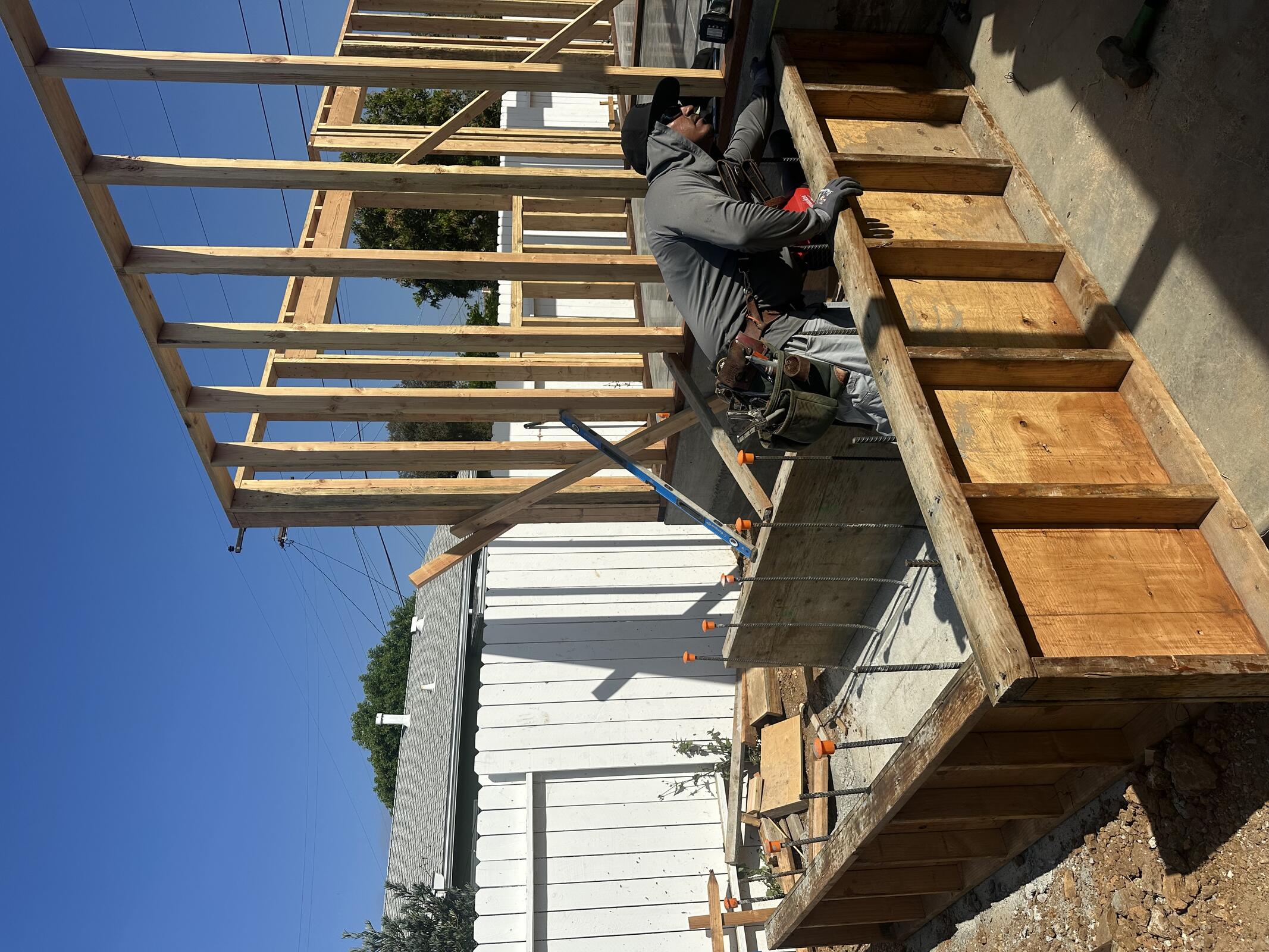

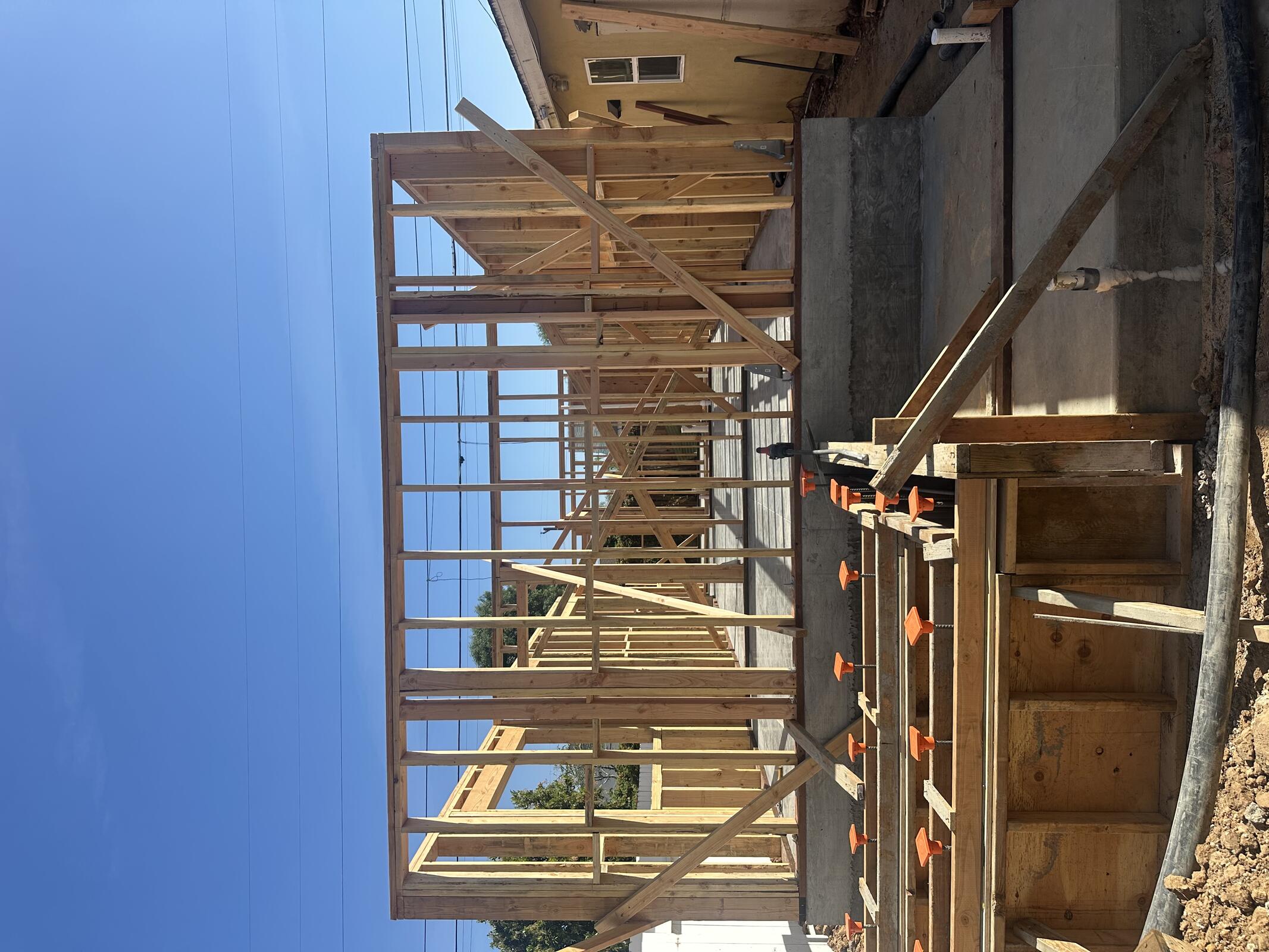

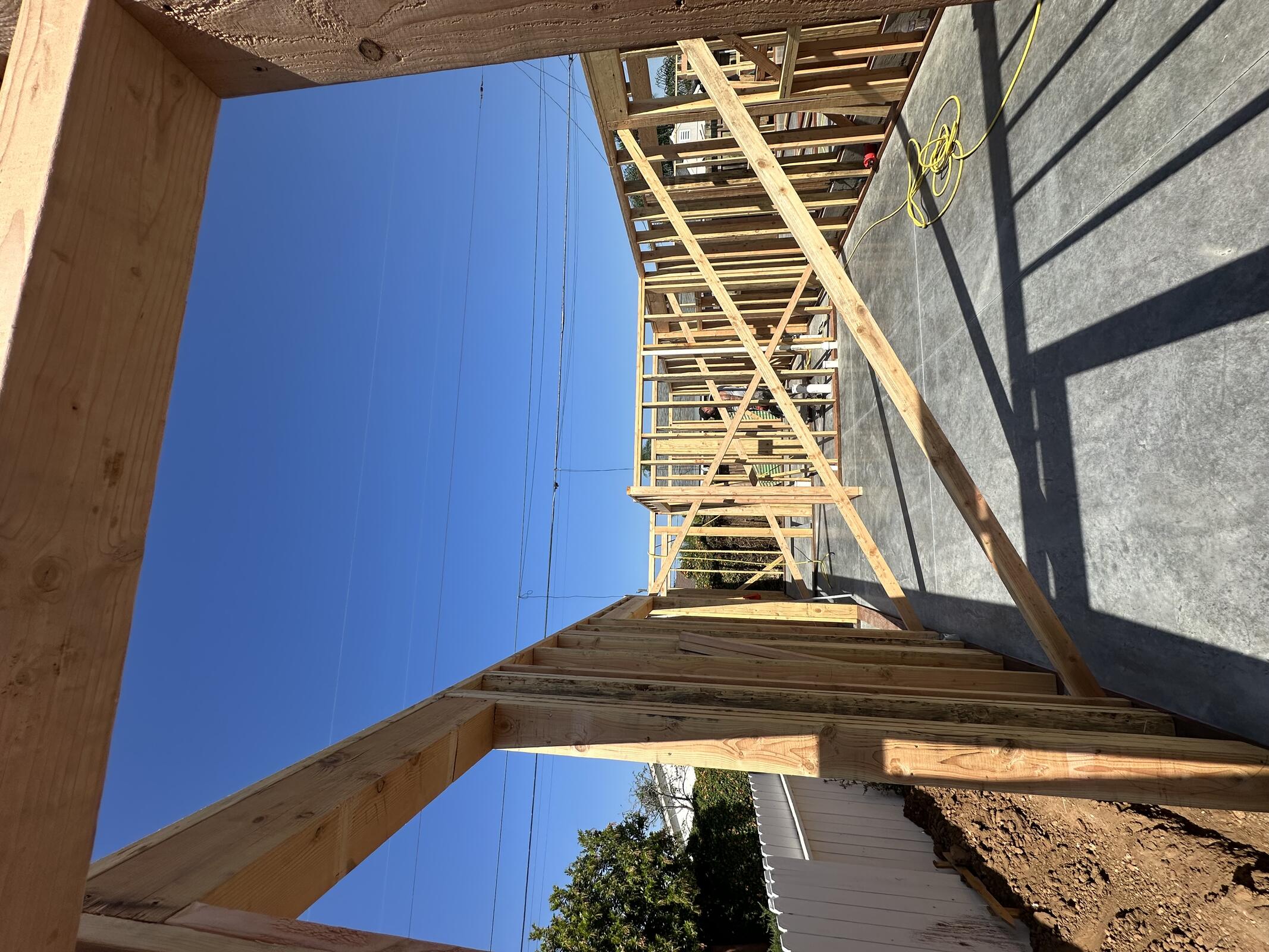

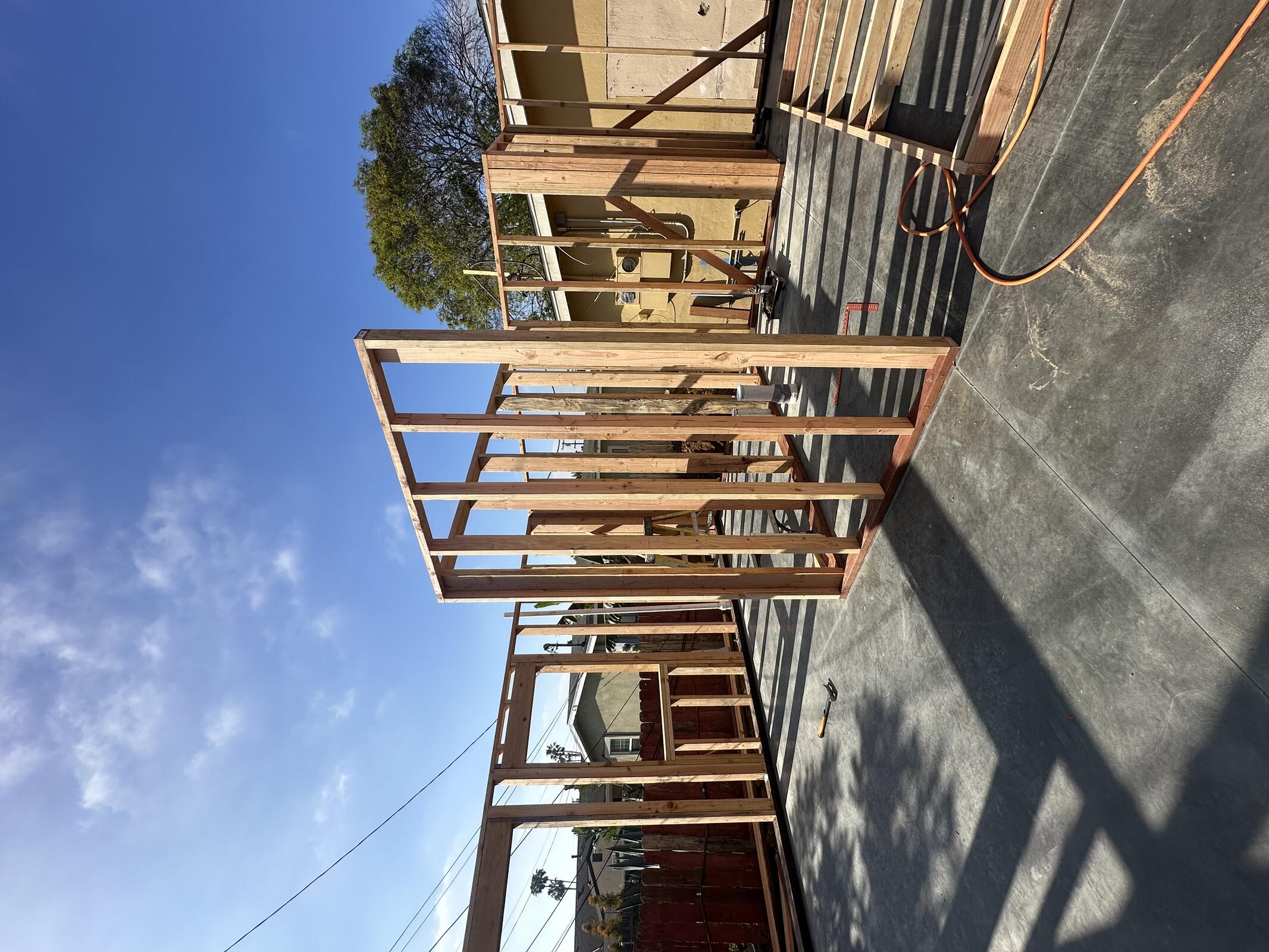

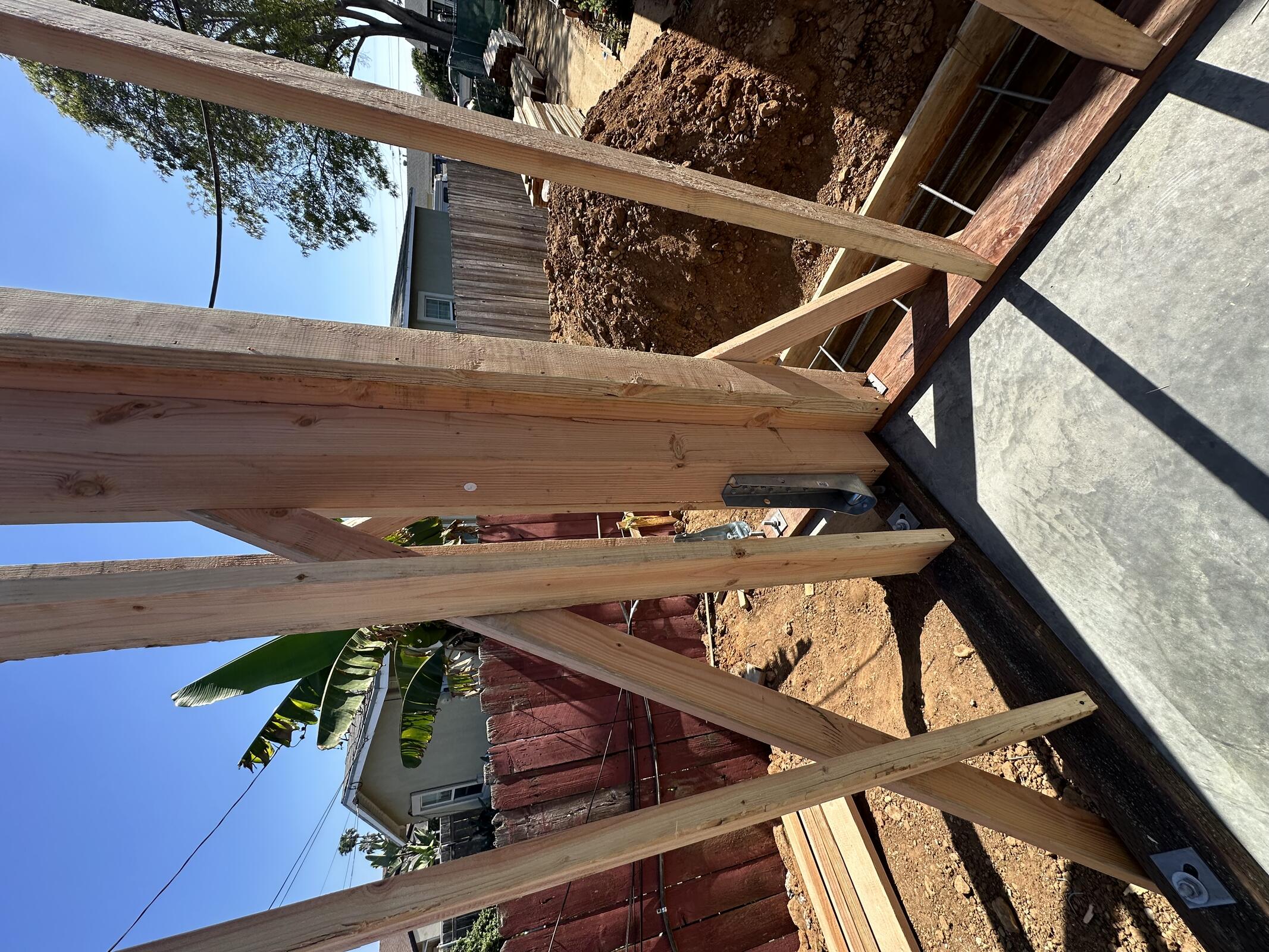

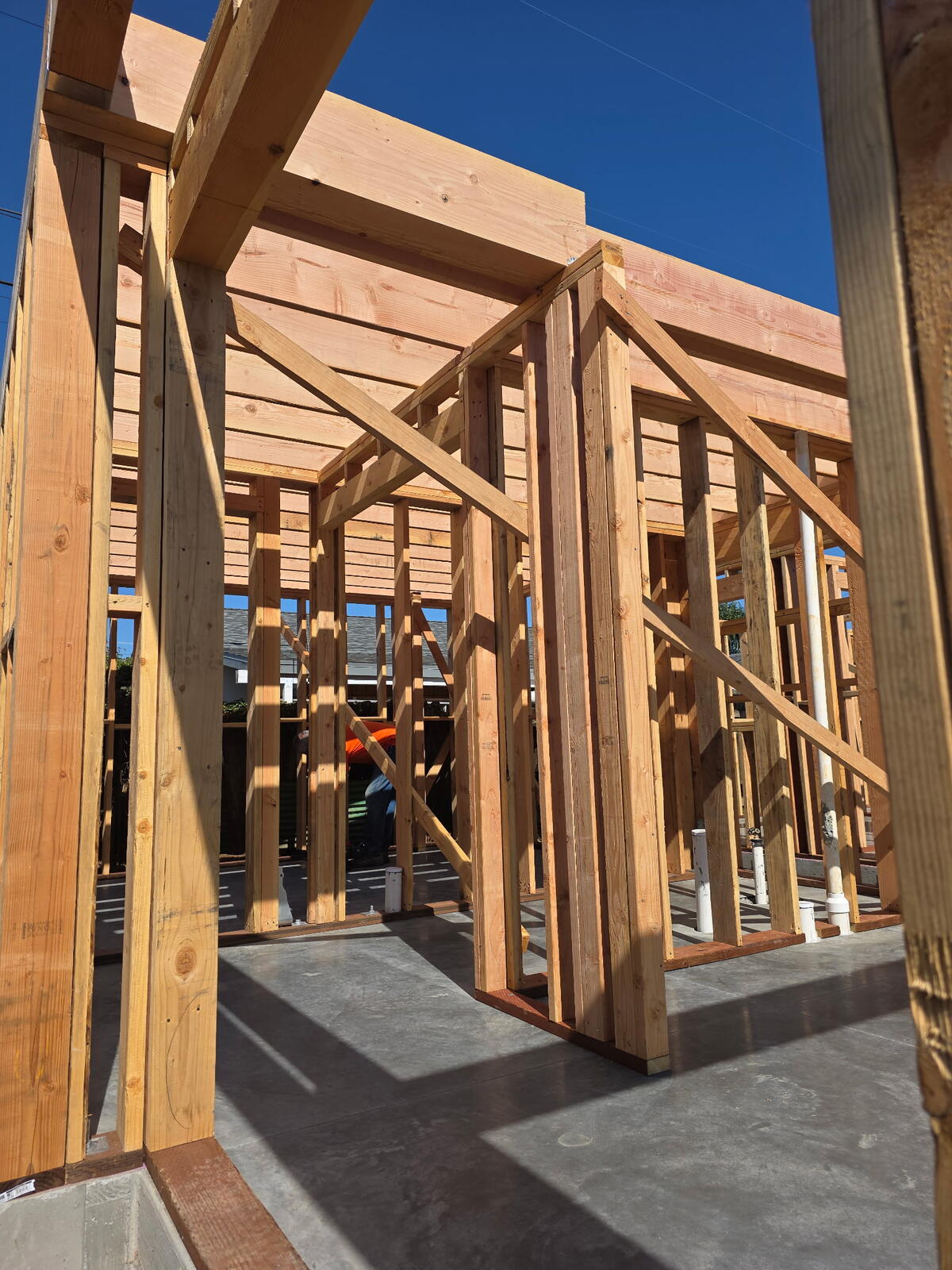

First floor framing still in progress. Layout for Structure B interior walls completed.

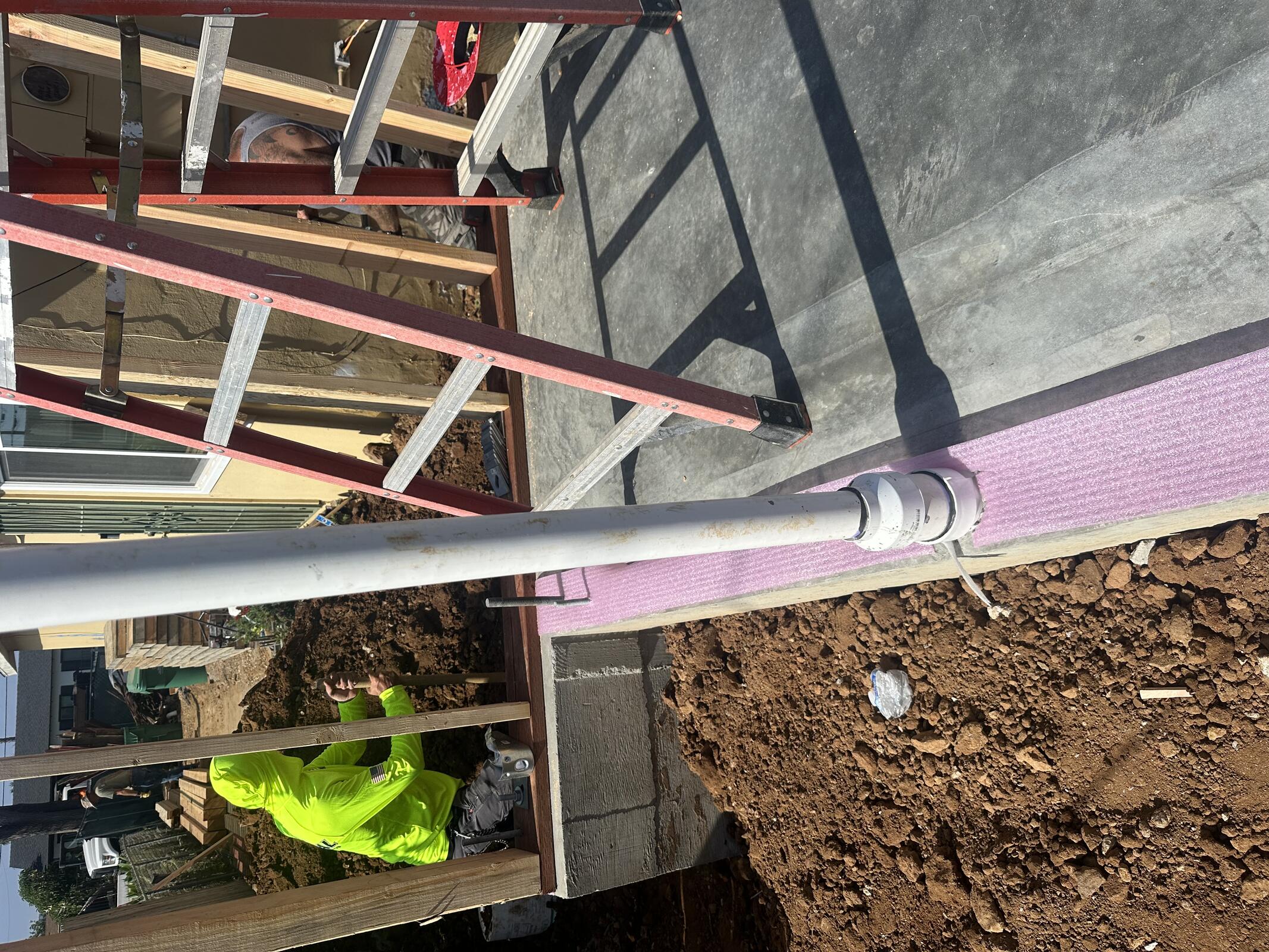

C3 connected new water meter on-site plumbing. Will return in 30 days to pave and replace sidewalk panel.
Dennis Hartley (Window Solutions) on site to measure and verify first floor window openings.
KTC pending detail from 1070 for pocket doors. Pricing for 8'-0" bi-pass doors received. Closet slider will change to full height to create more storage for tenants.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| C3 | 2 | 4 | 8 |
| JB General | 8 | 8 | 64 |
Inspection: N/A

Wednesday, March 25, 2026
Clear, 75°F

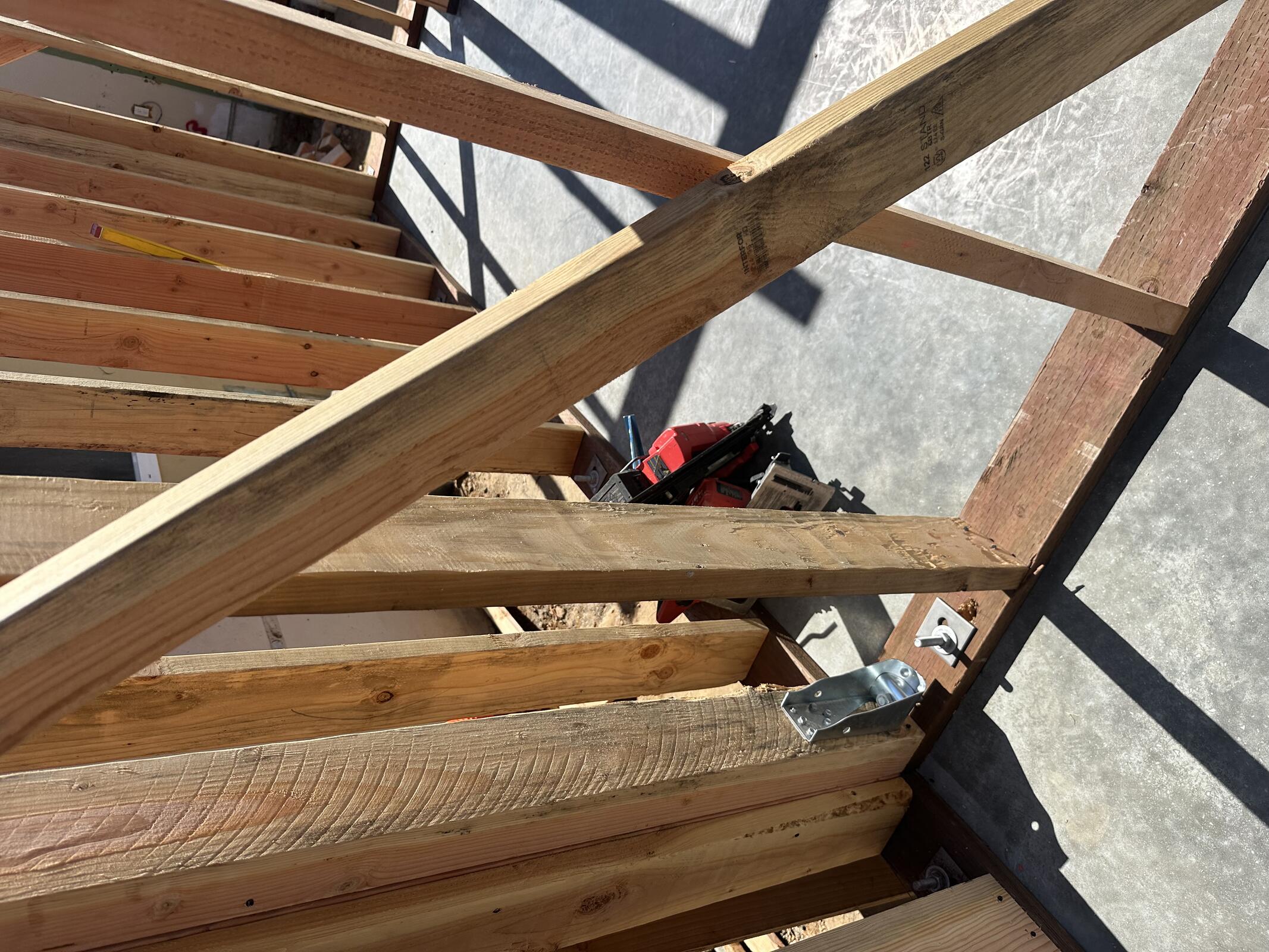

JB General on site, framing first floor walls. Starting fire blocking.
Taylor Trim stopped by to take progress pictures.
Concrete scheduled for 10 AM tomorrow for stair footings.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| JB General | 4 | 8 | 32 |
| JB General | 1 | 4 | 4 |
Inspection: Dave Finney passed stair footings. On site from 11:55 AM to 12:05 AM.

Thursday, March 26, 2026
Clear, 64°F

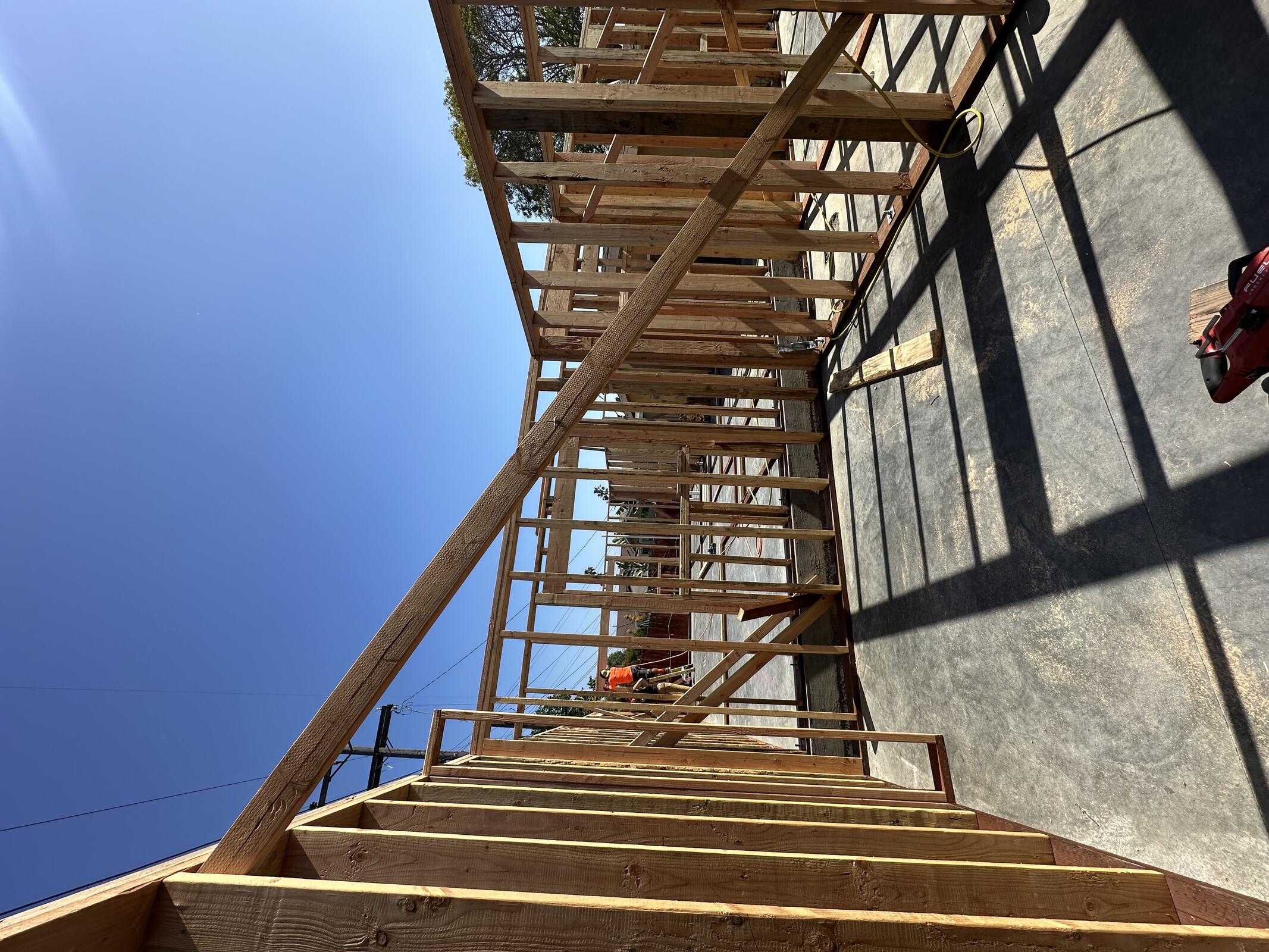

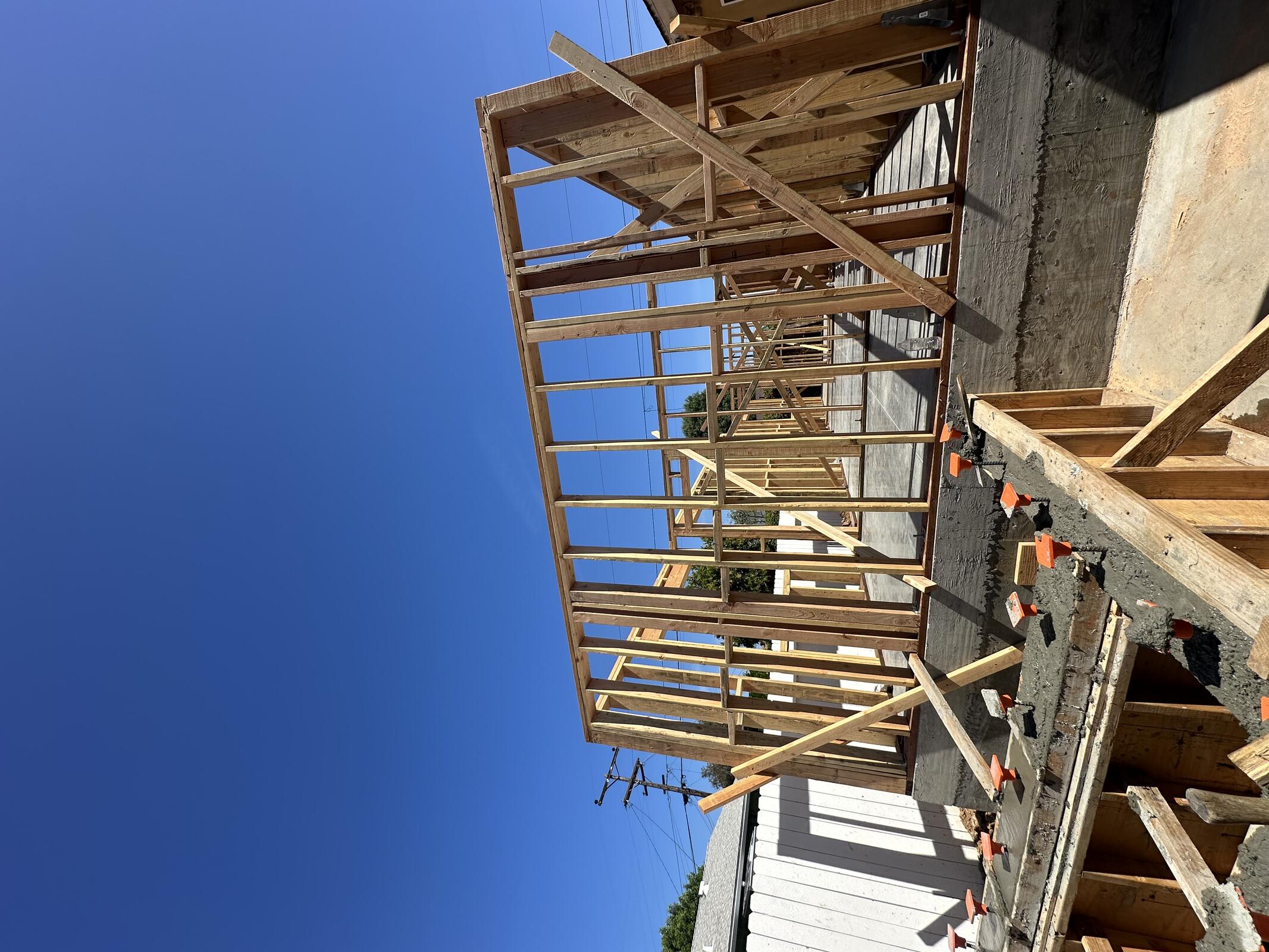

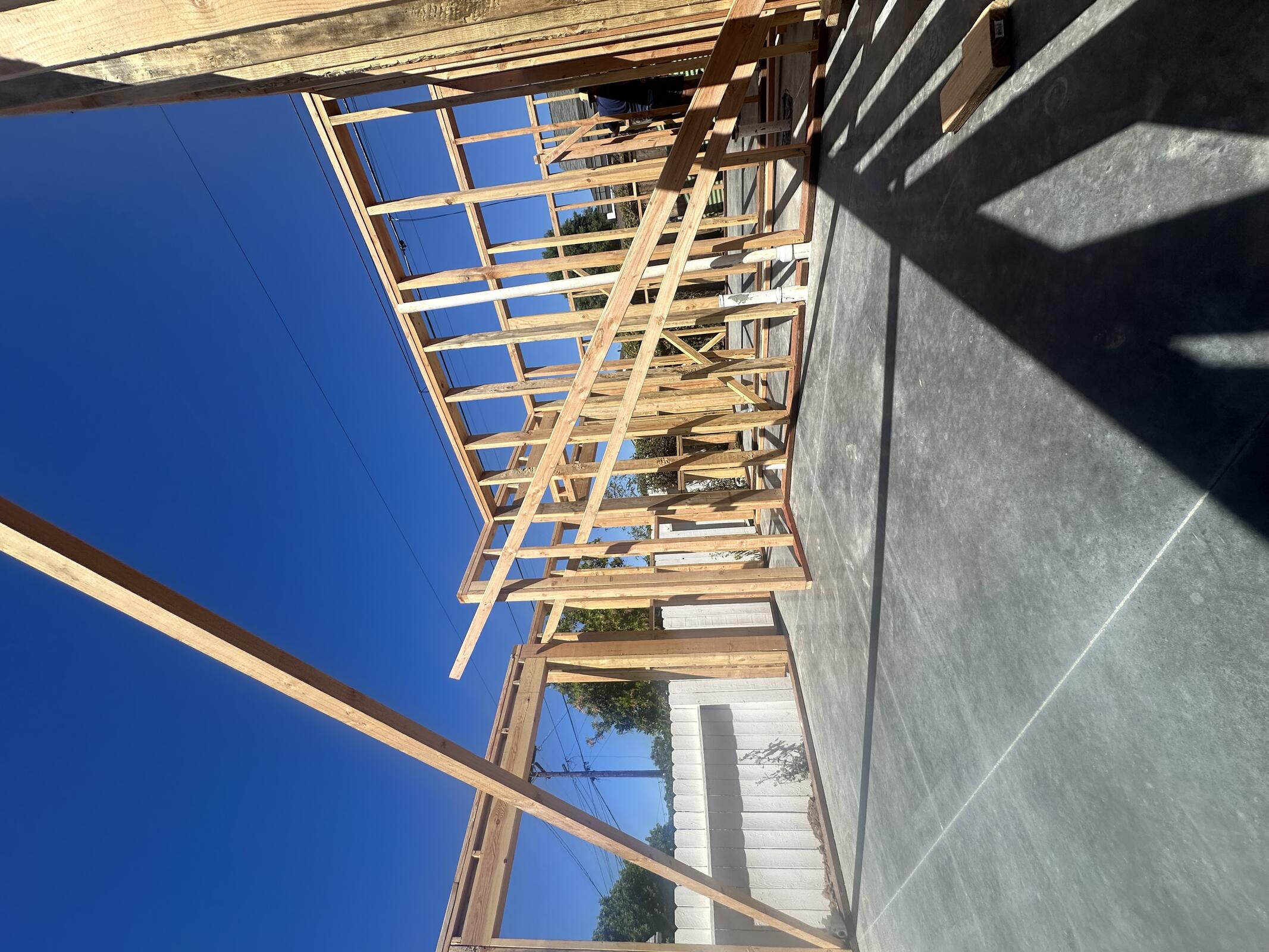

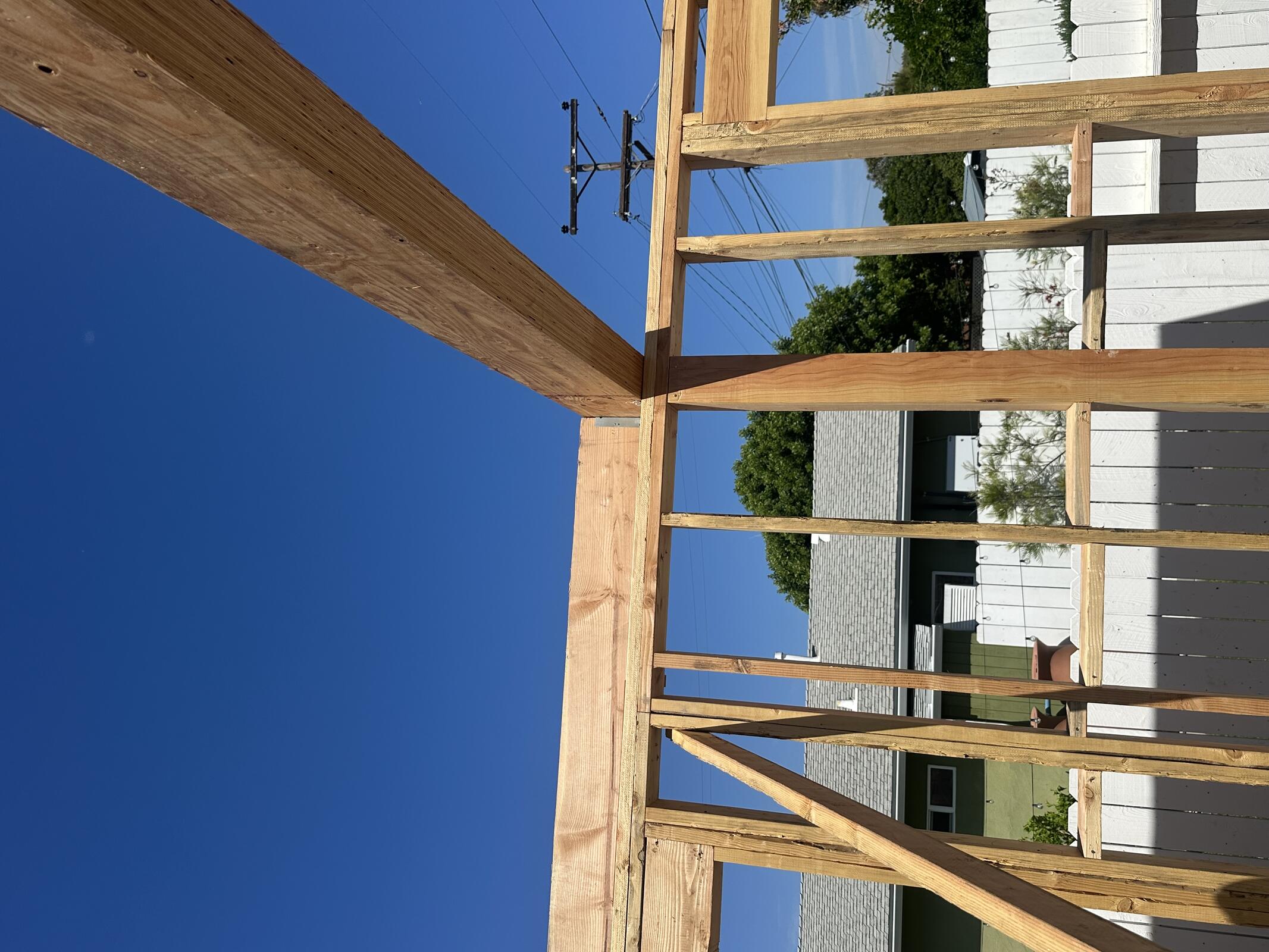

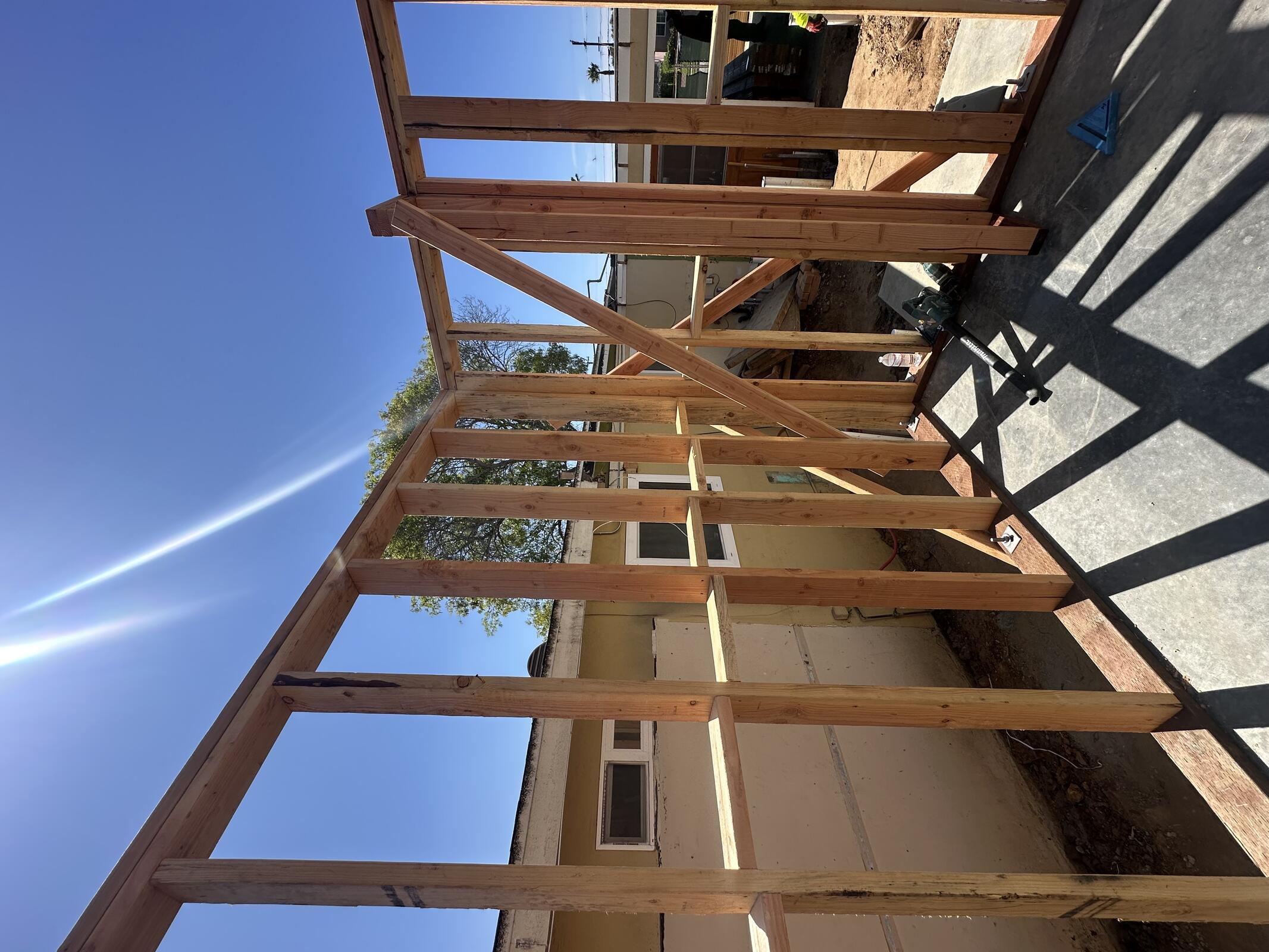

JB General continuing first floor framing. Top plates on Building B completed. Blocking in progress. Will start setting joists tomorrow.

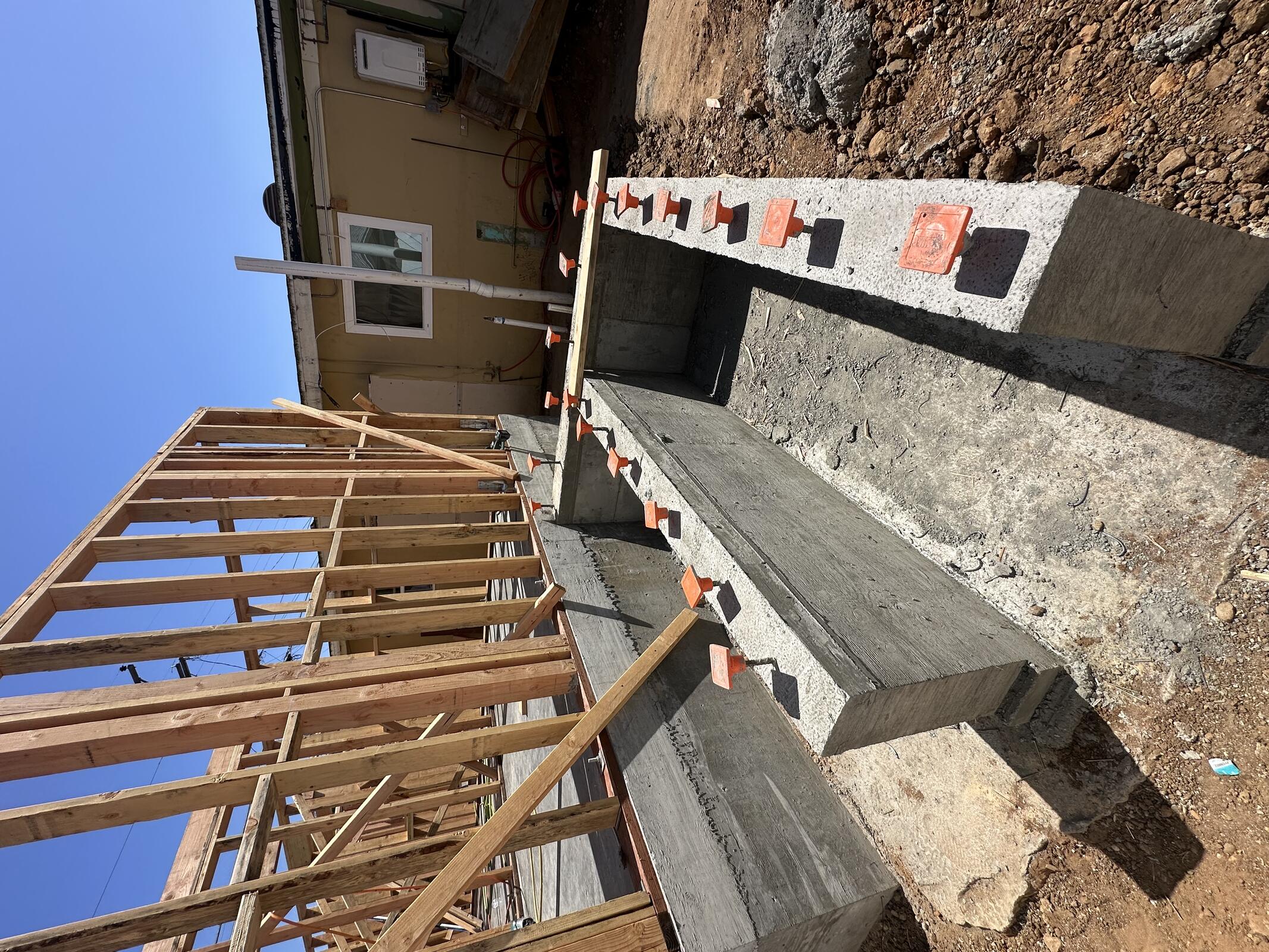

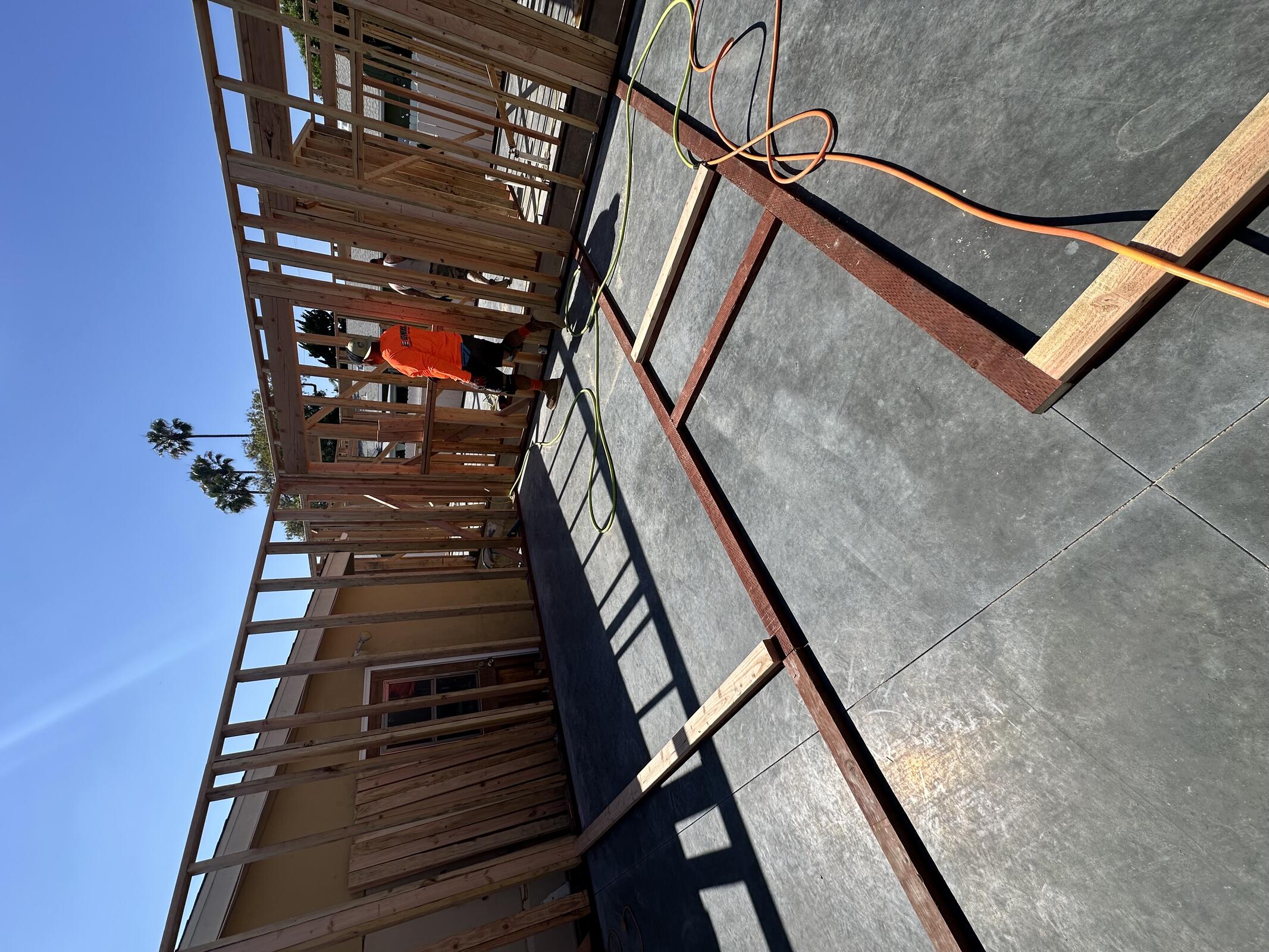

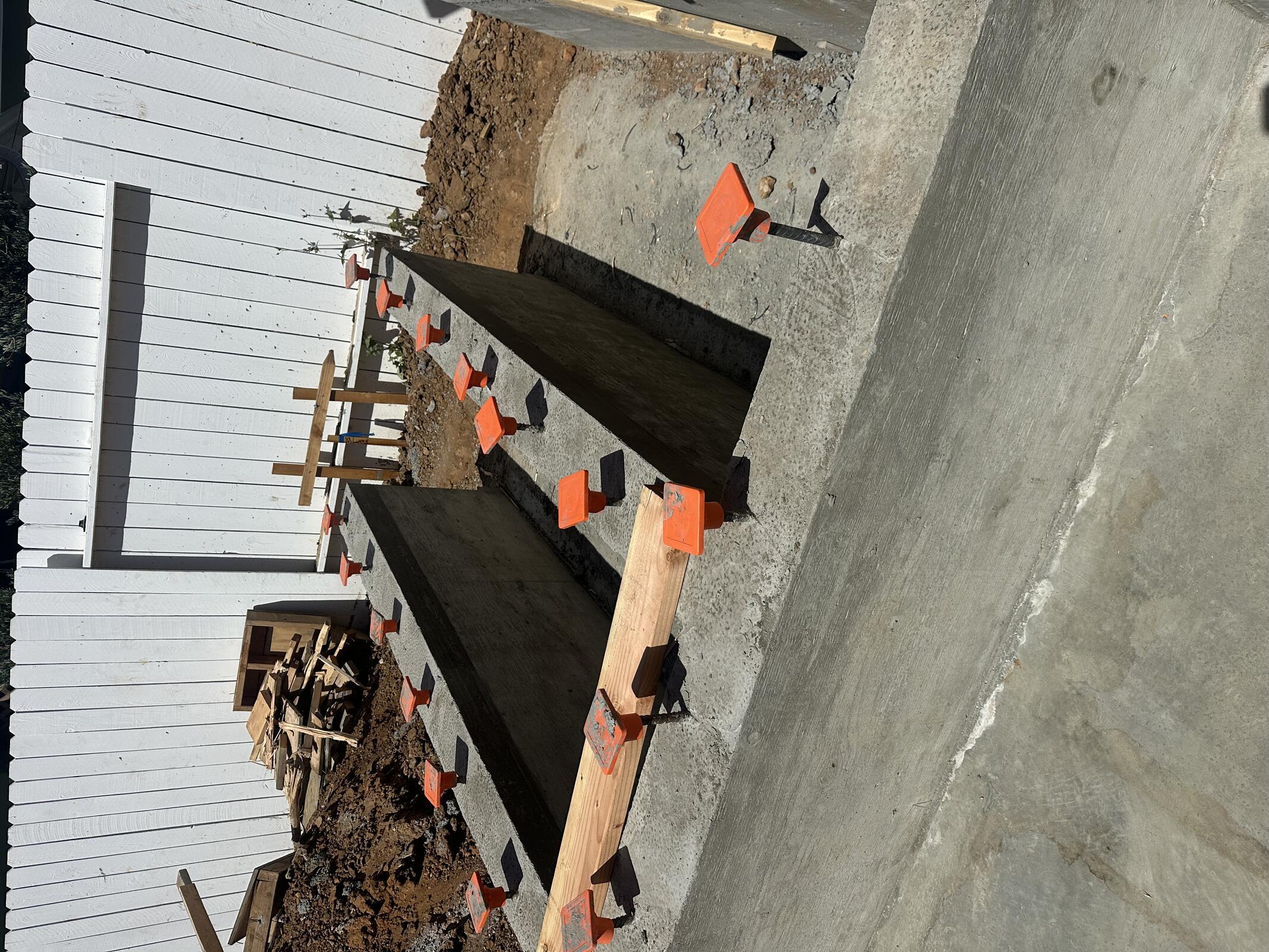

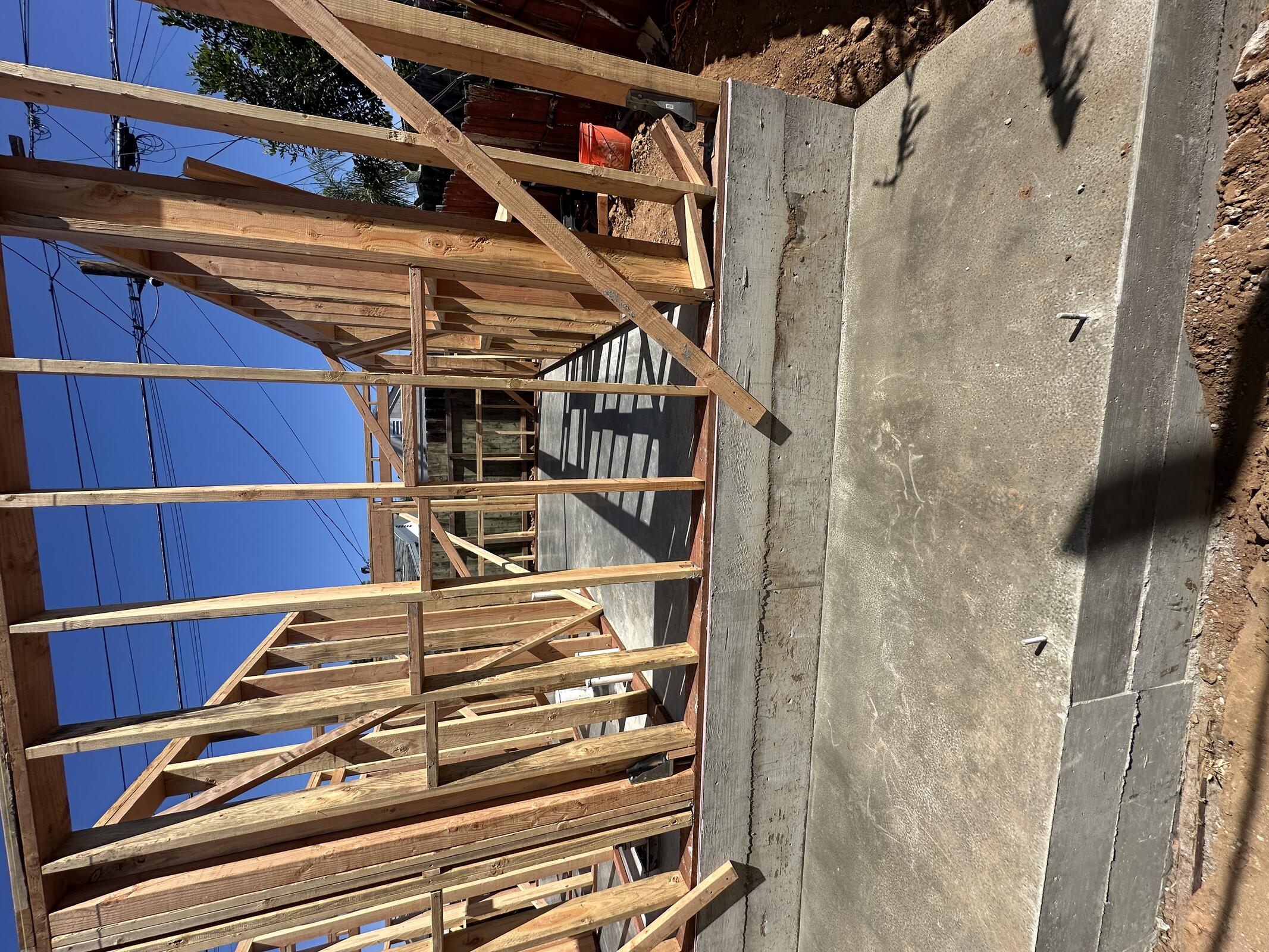

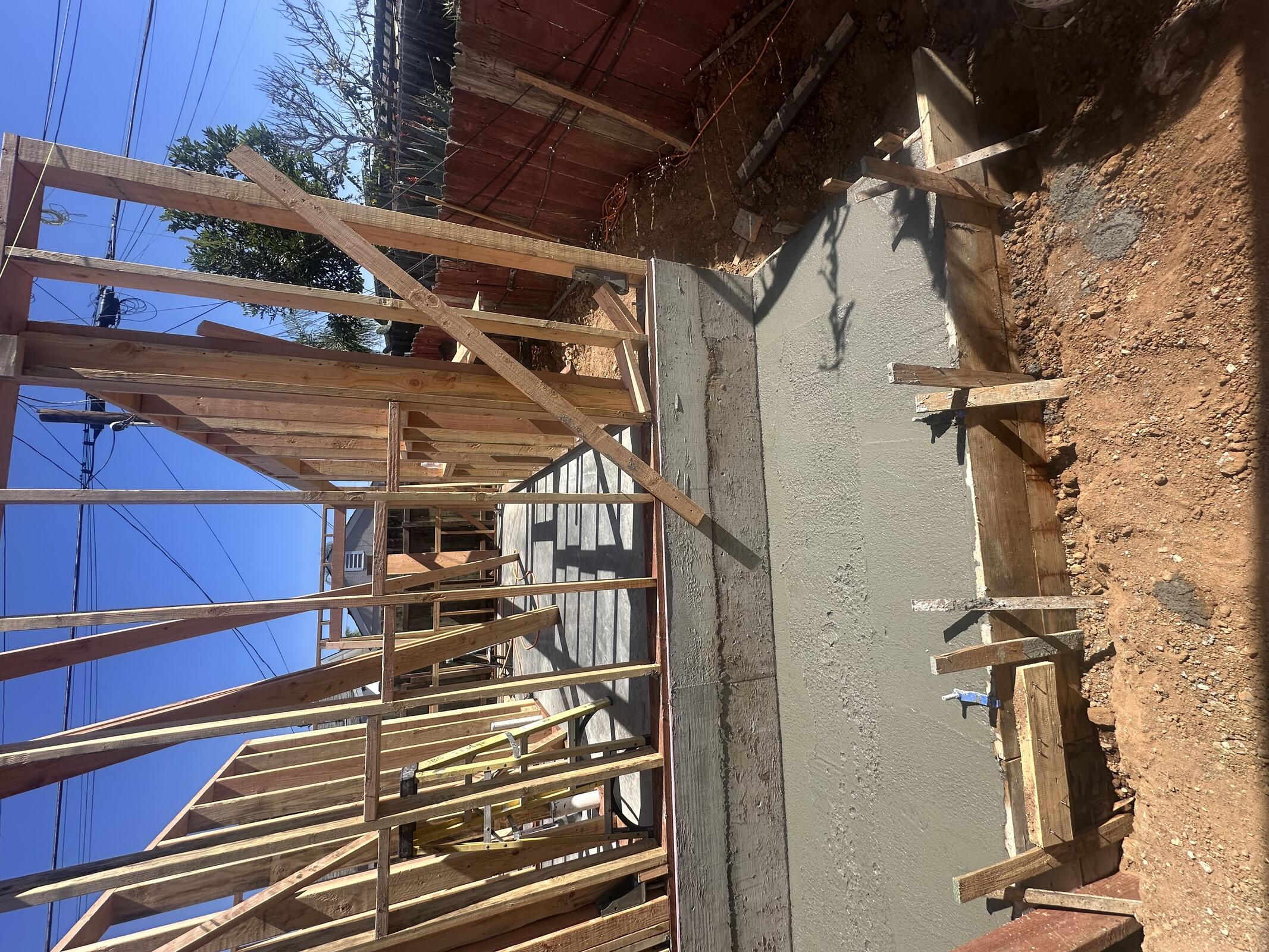

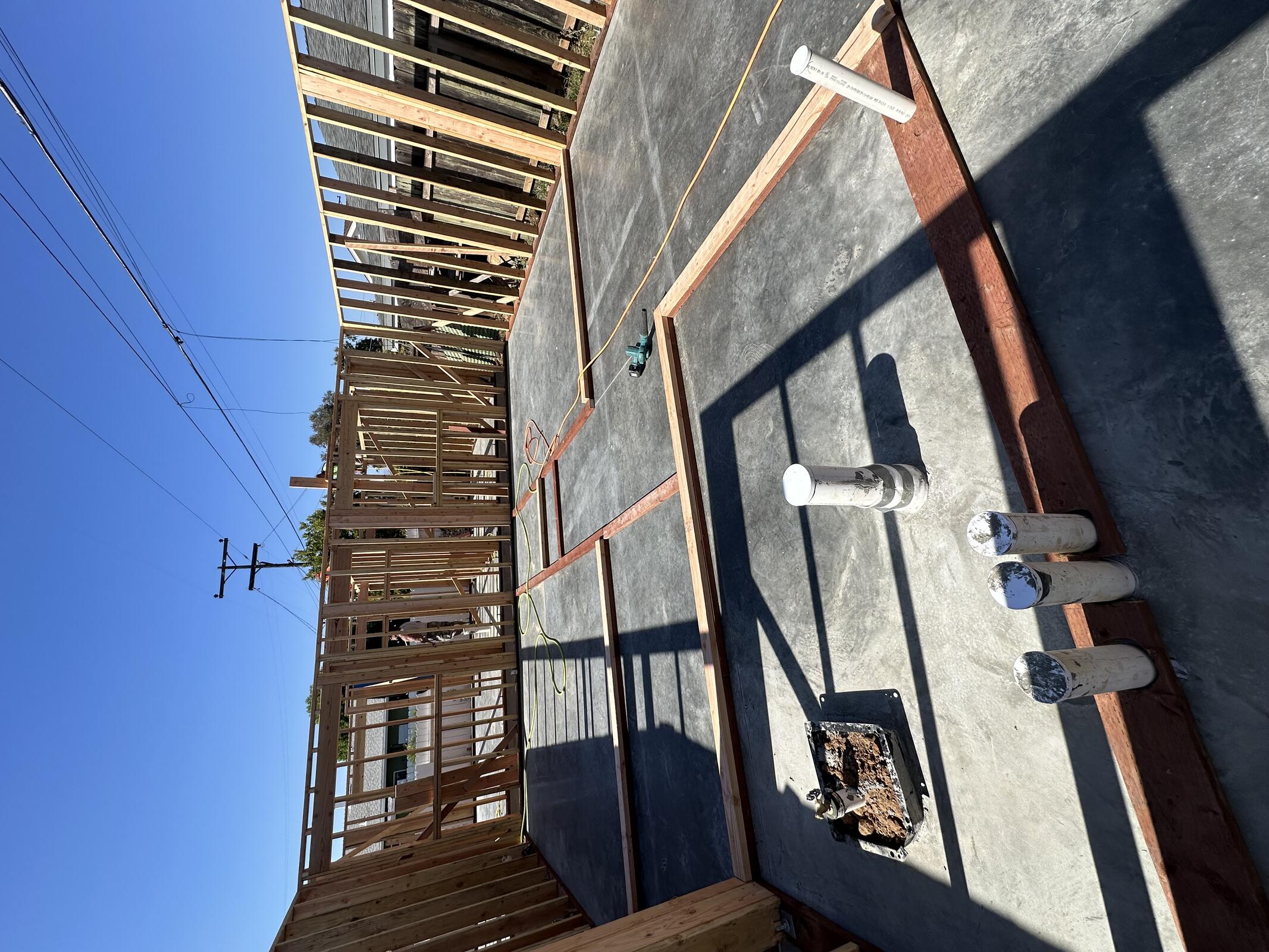

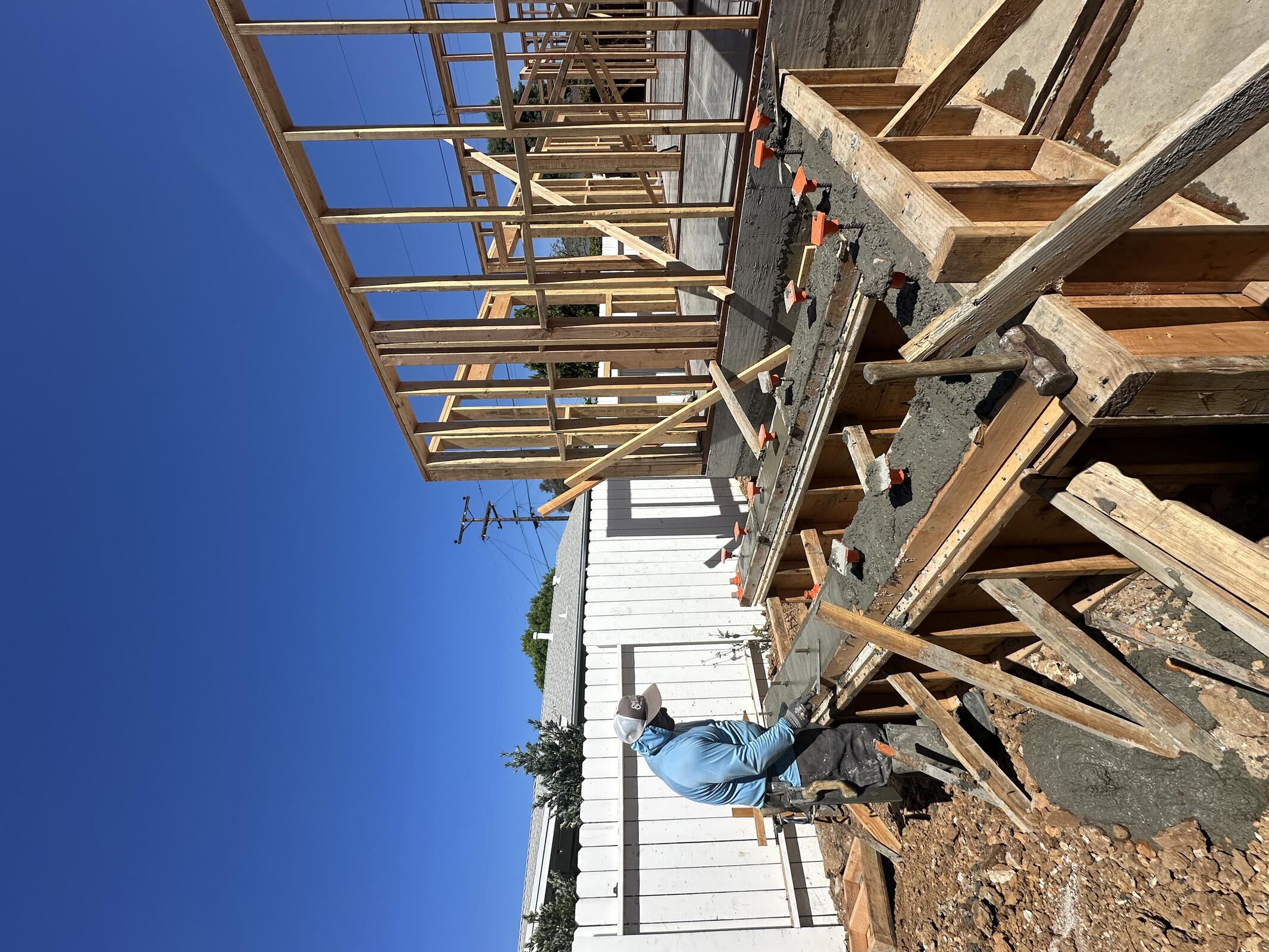

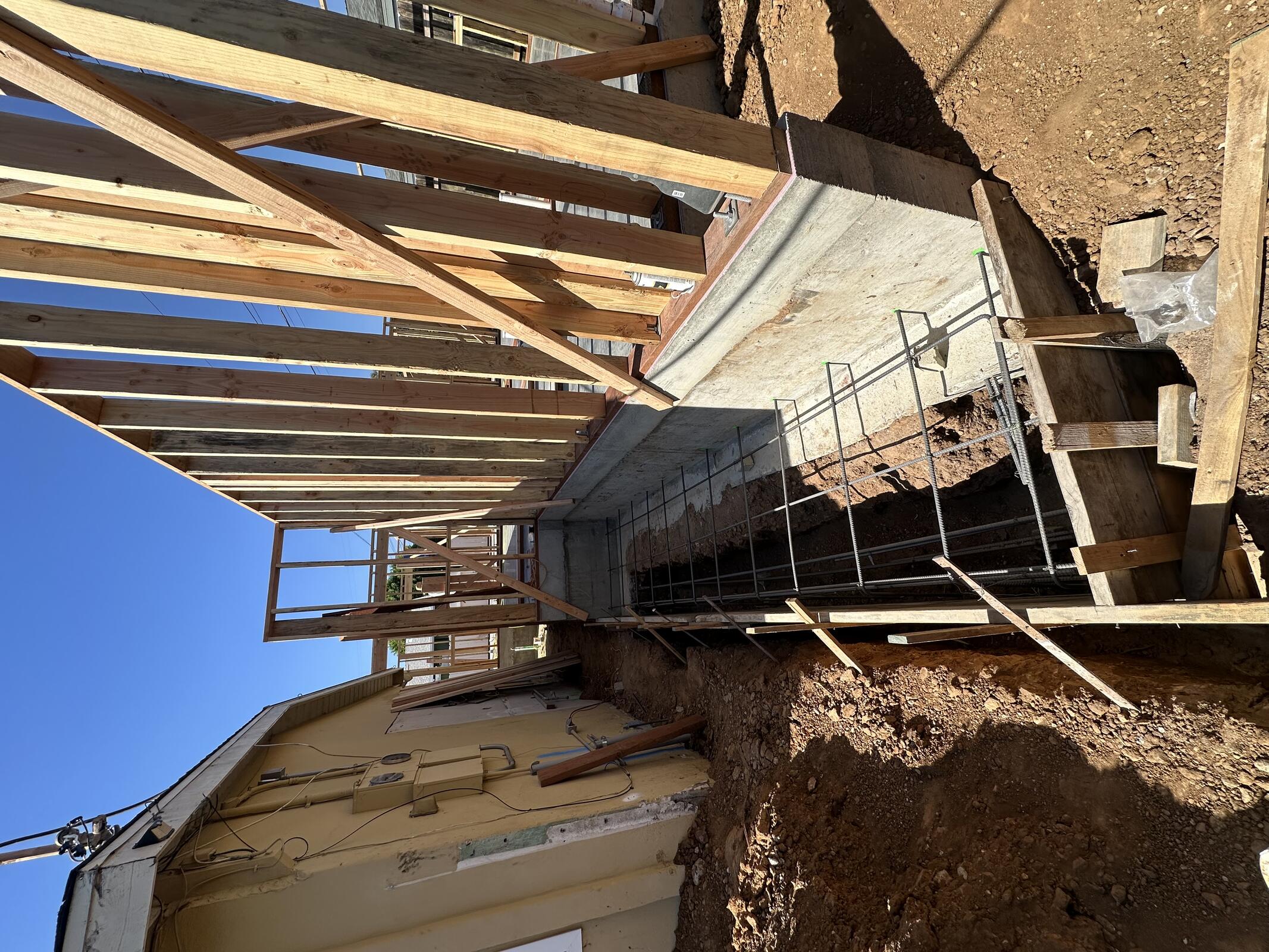

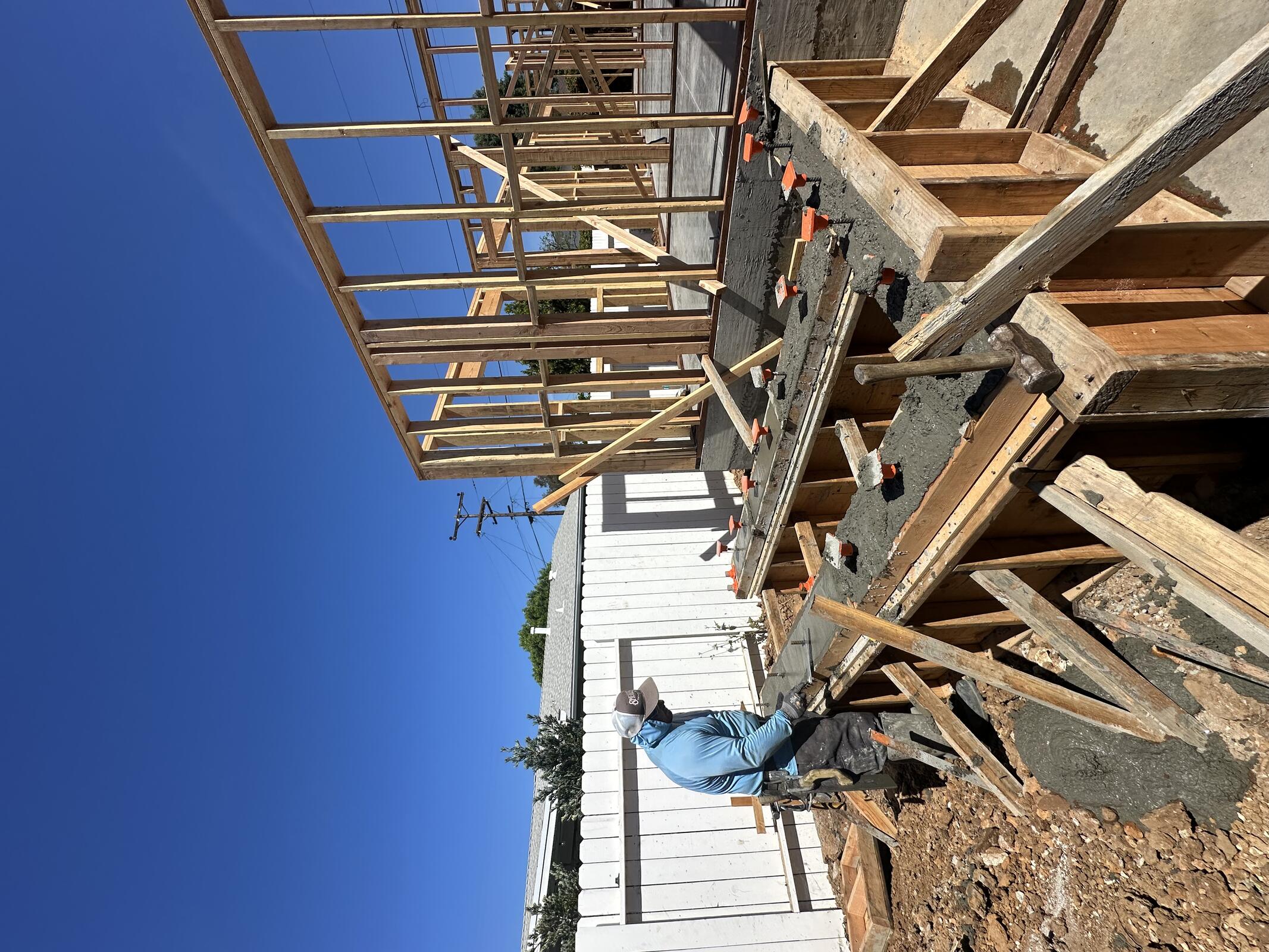

Stair footing at Building B and walls at Building C poured at 10:30 AM.
Zack Smith on site to check on progress.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| JB General | 4 | 8 | 32 |
| JB General | 2 | 2 | 4 |
Inspection: N/A

Friday, March 27, 2026
Clear, 76°F

Concrete from yesterday's pour stripped.

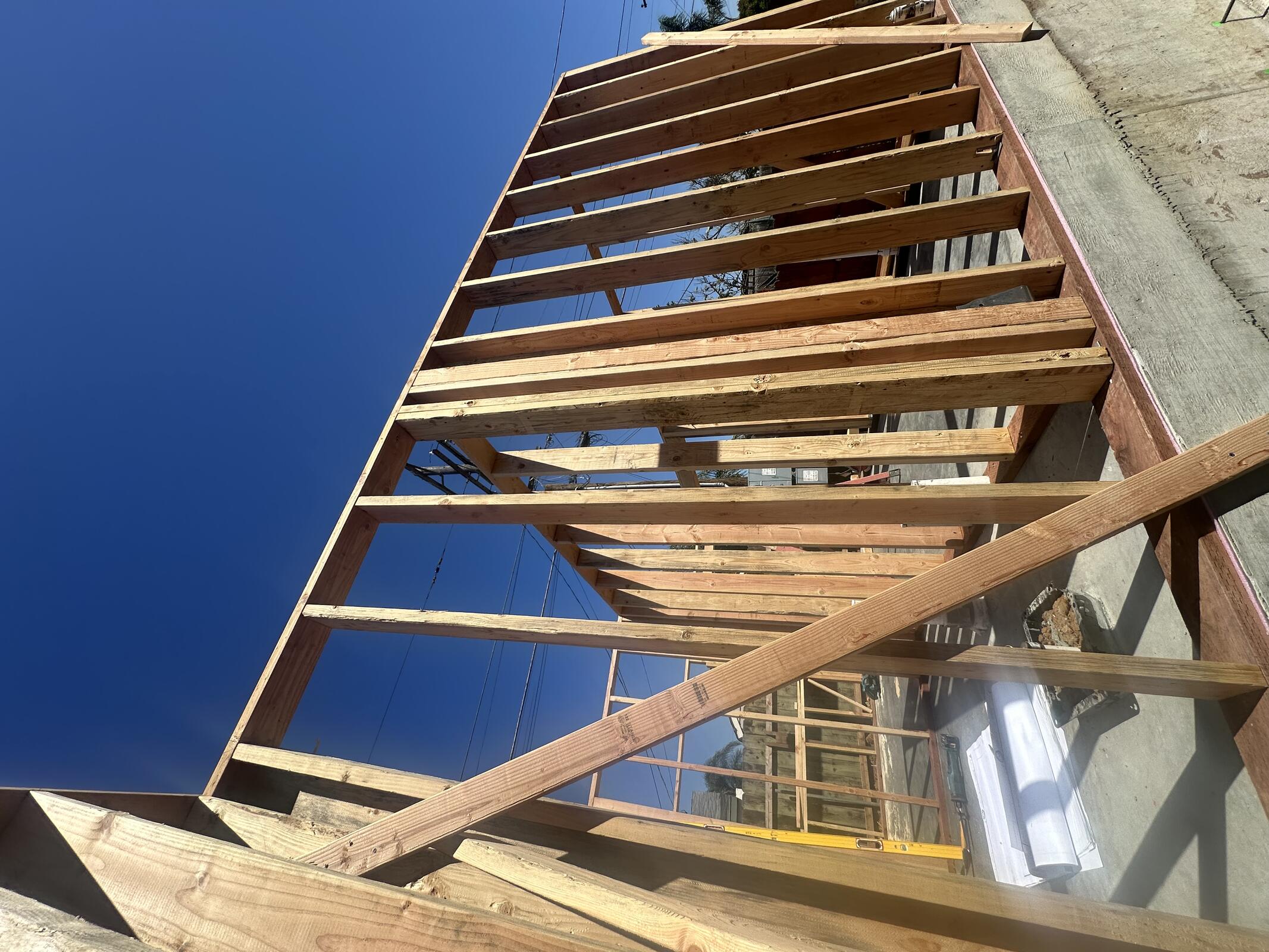

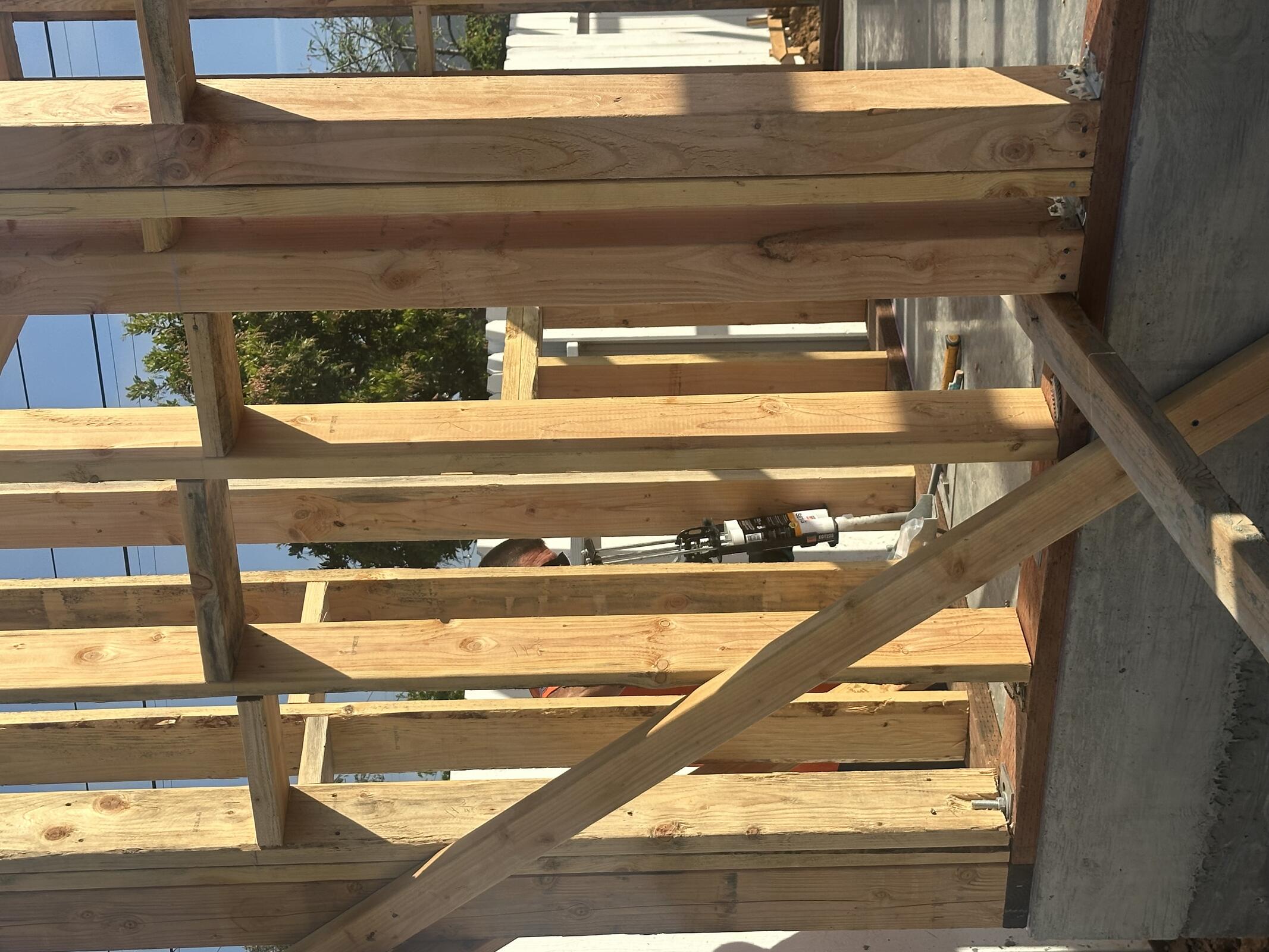

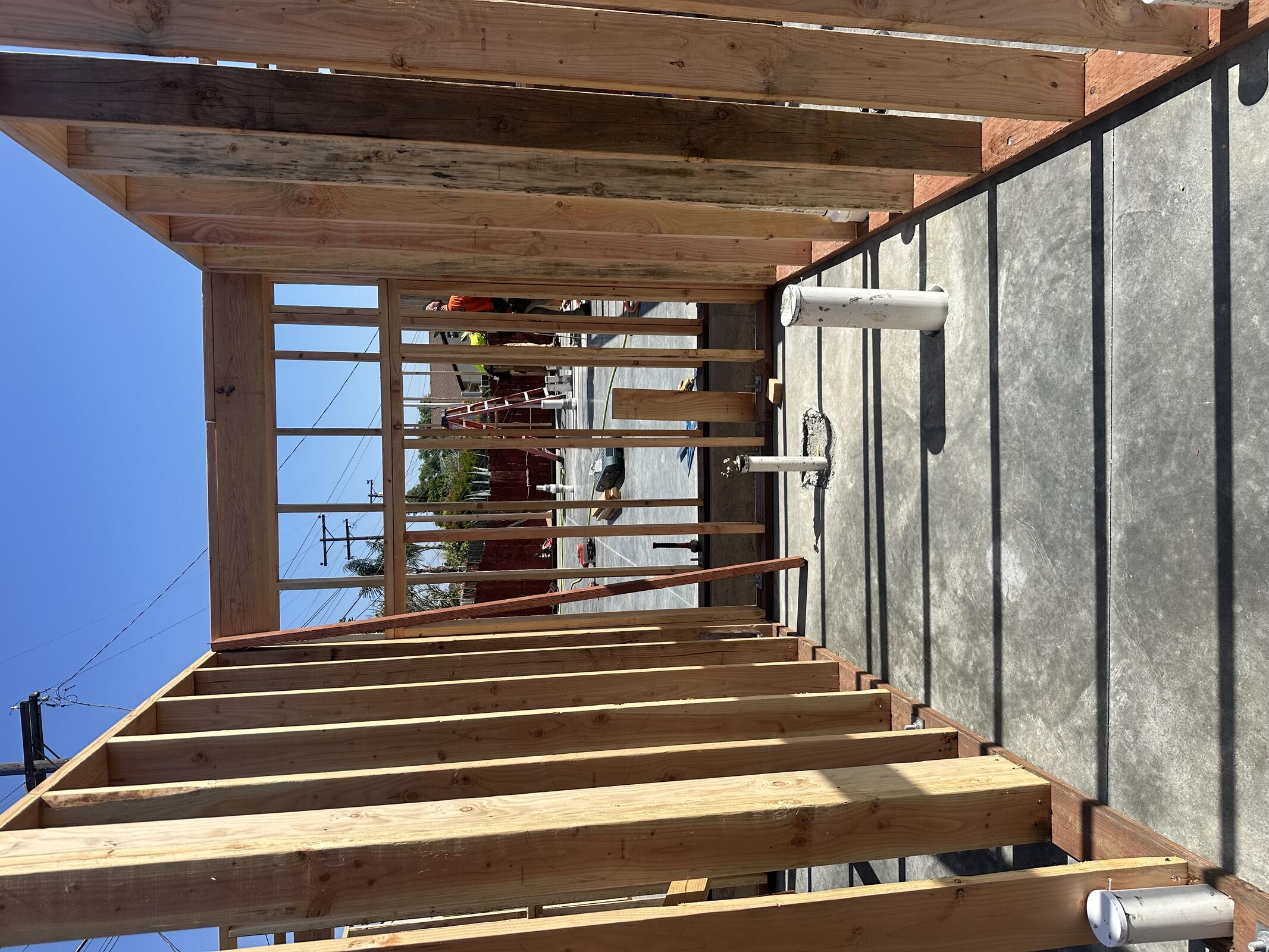

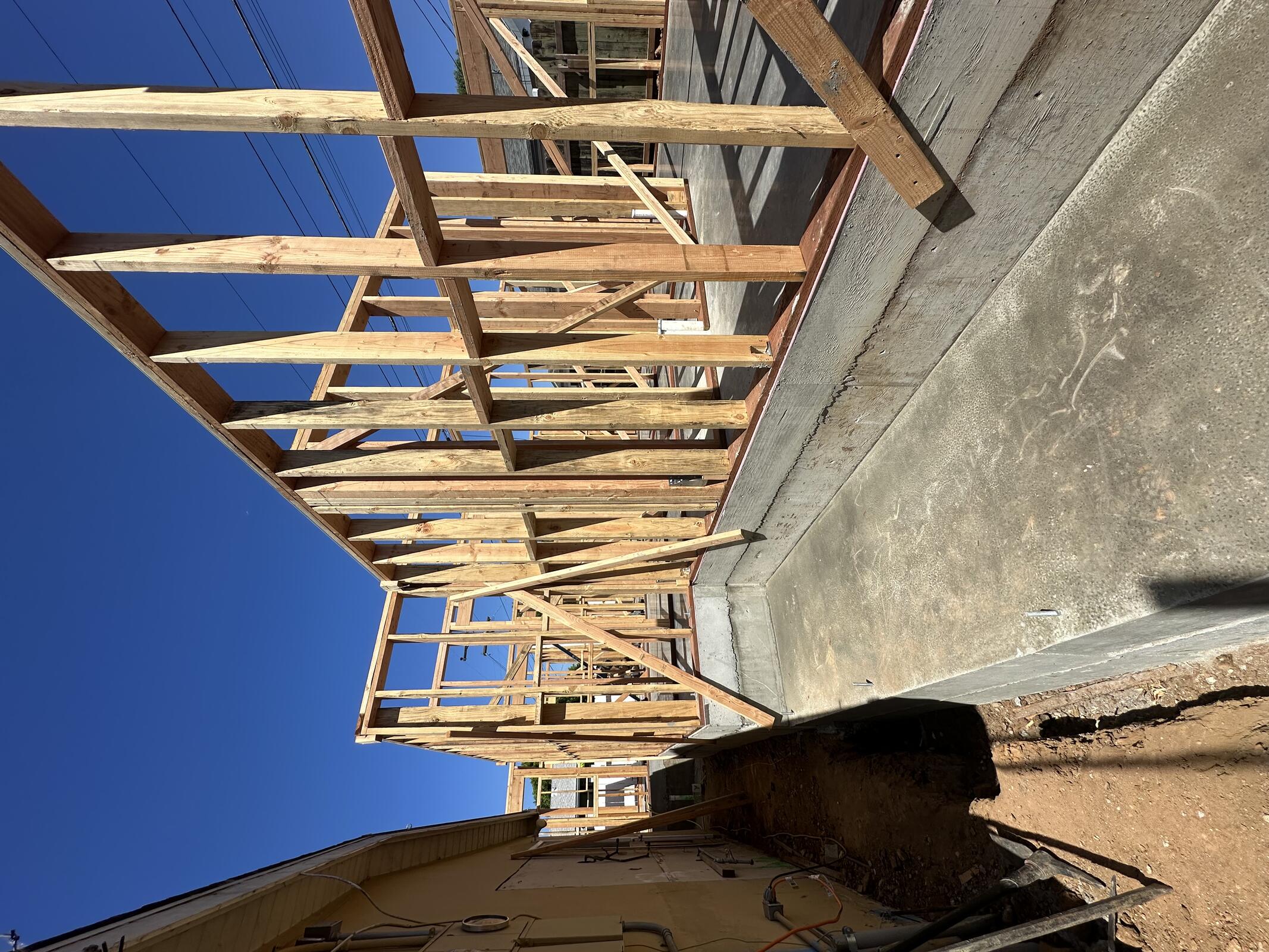

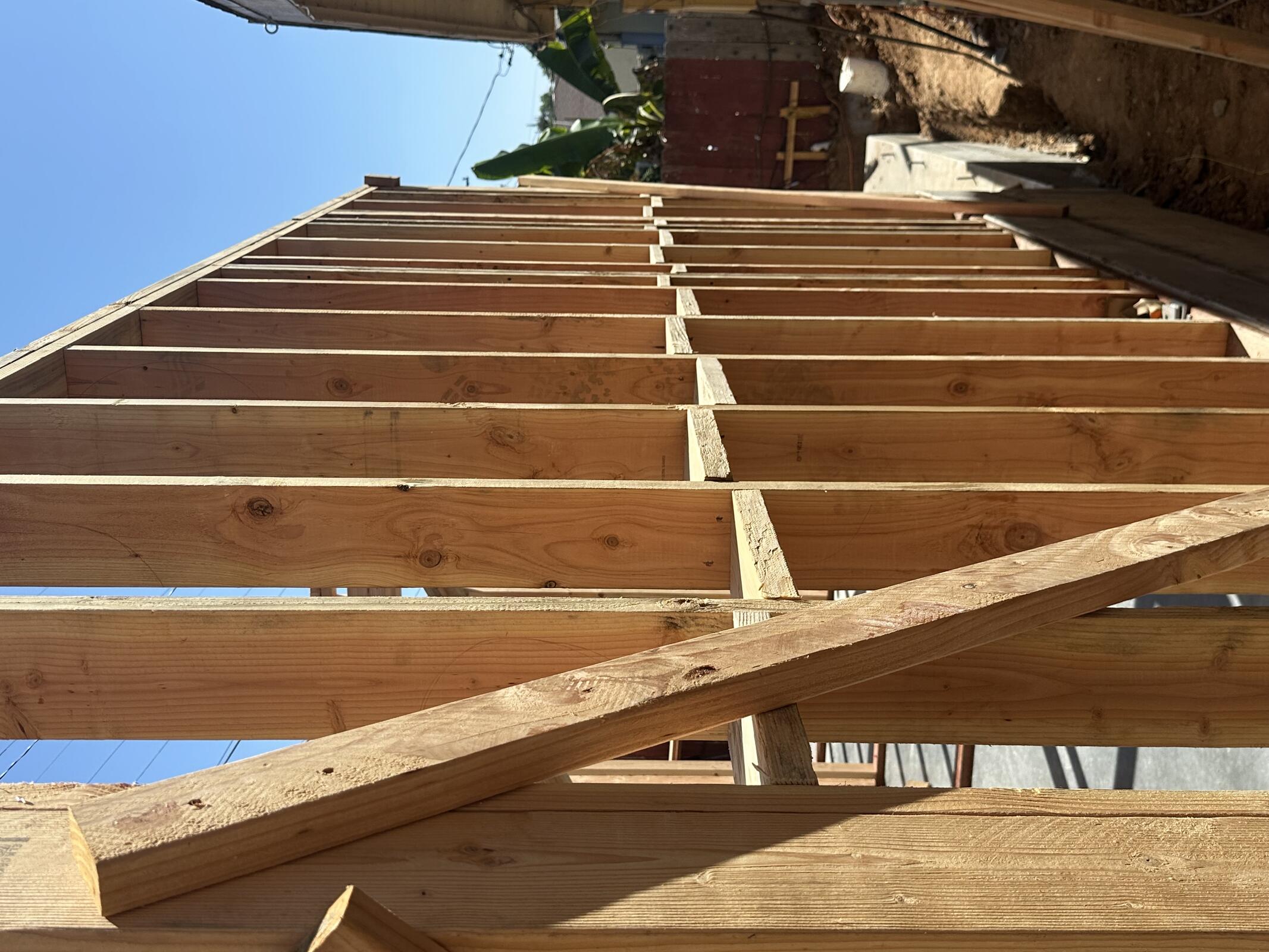

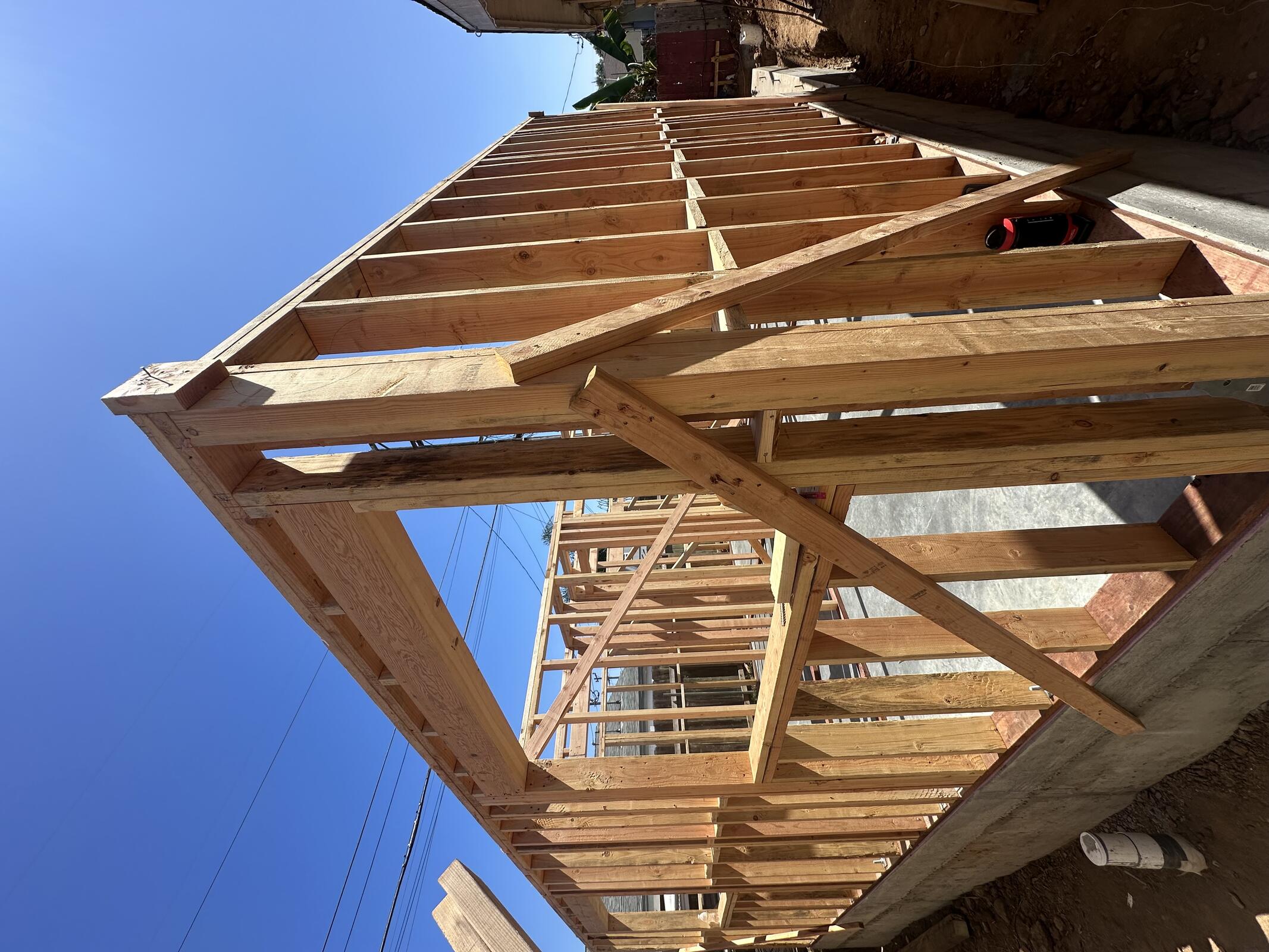

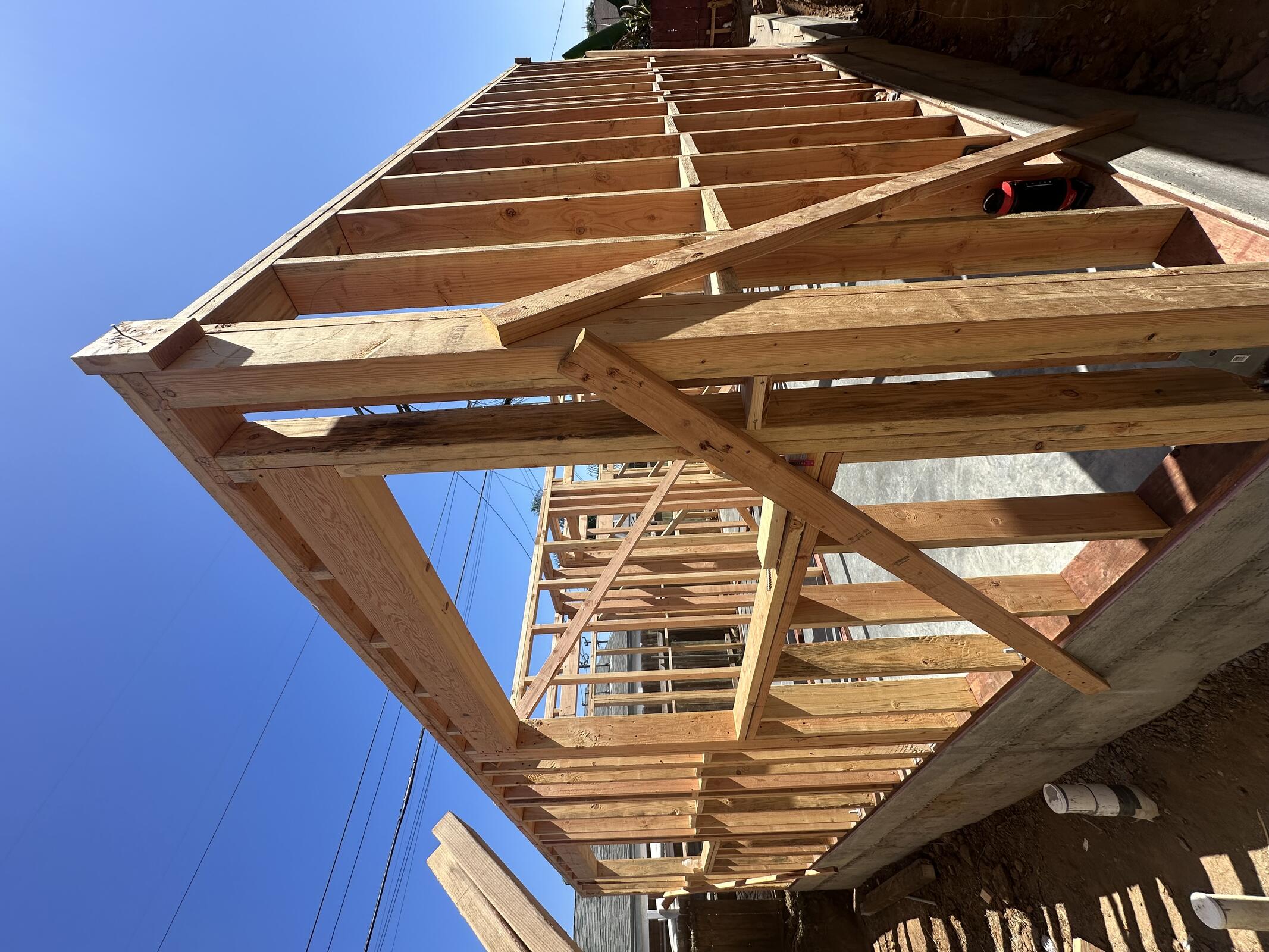

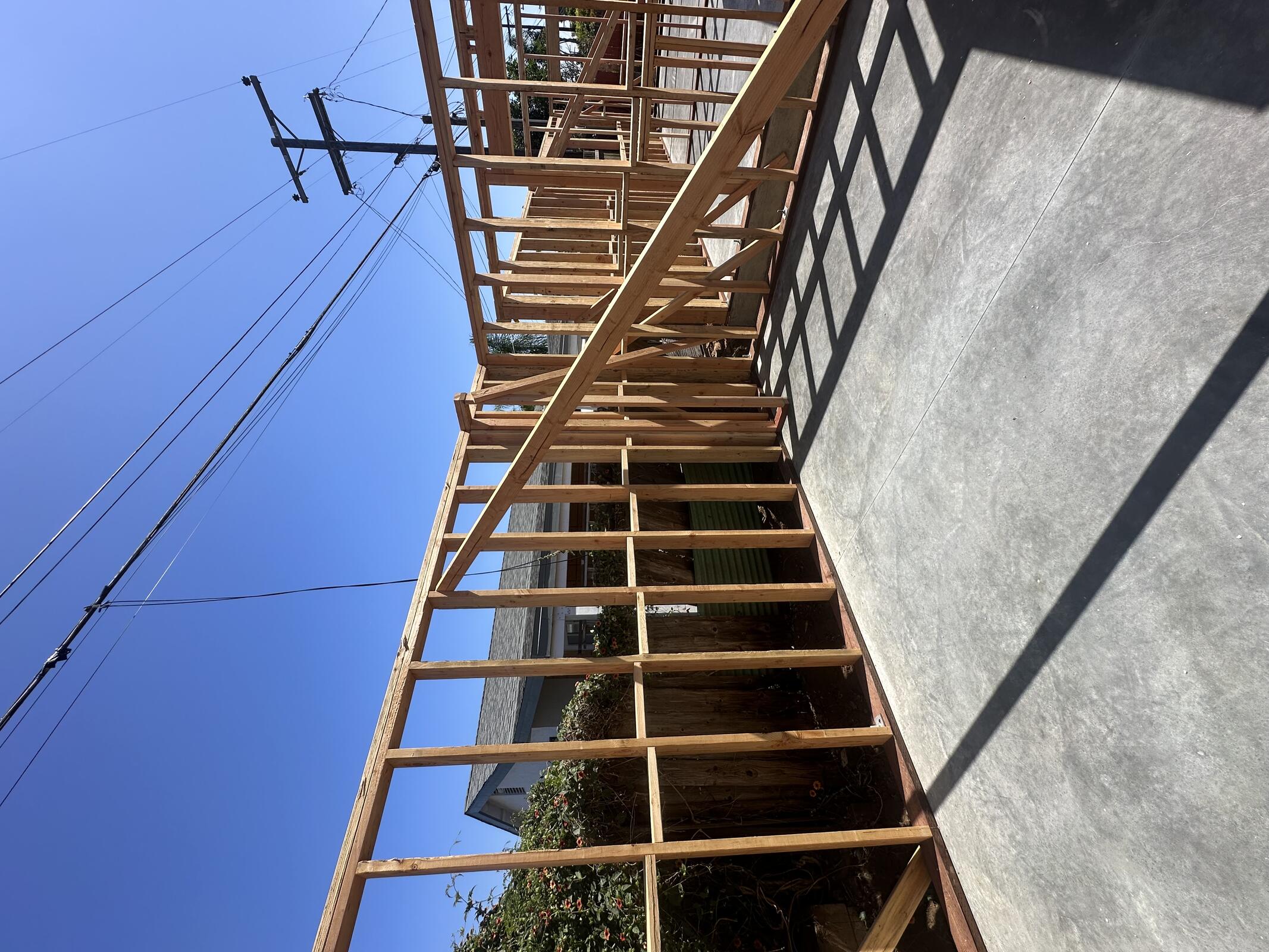

All blocking installed on exterior walls. Installation of joists on Building C in progress.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| JB General | 5 | 8 | 40 |
Inspection: N/A
