Week 8 of 34

Week of February 10 — February 11, 2026

2 days on site. 11 photos. Foundations.

February 10, 2026February 11, 20262 days11 photos
Foundations

Tuesday, February 10, 2026

Overcast, 63°F

Brent and Rick (JB General) on site, laying out wet set hardware for Structure C.

Concrete ordered for 1 pm.

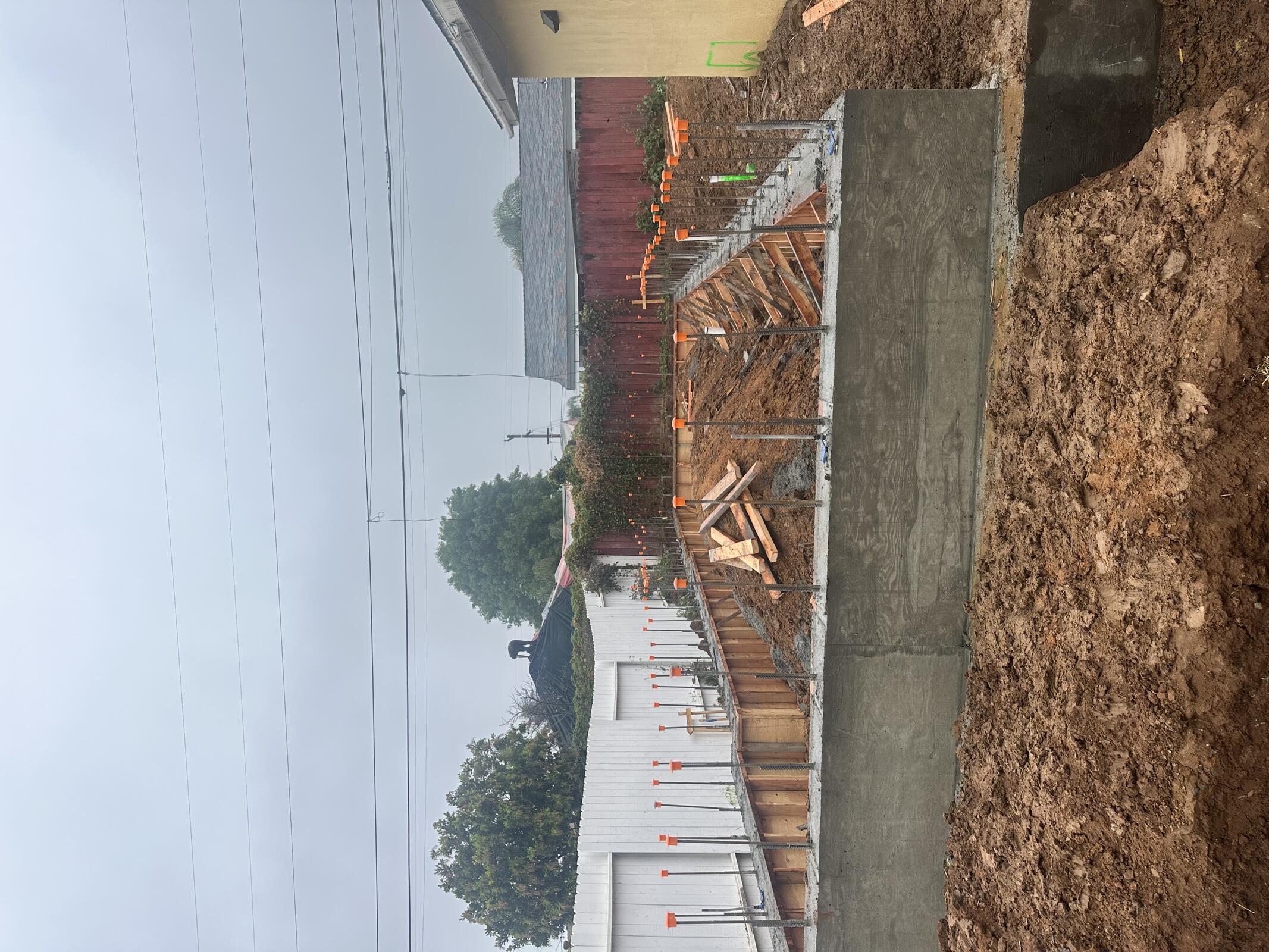

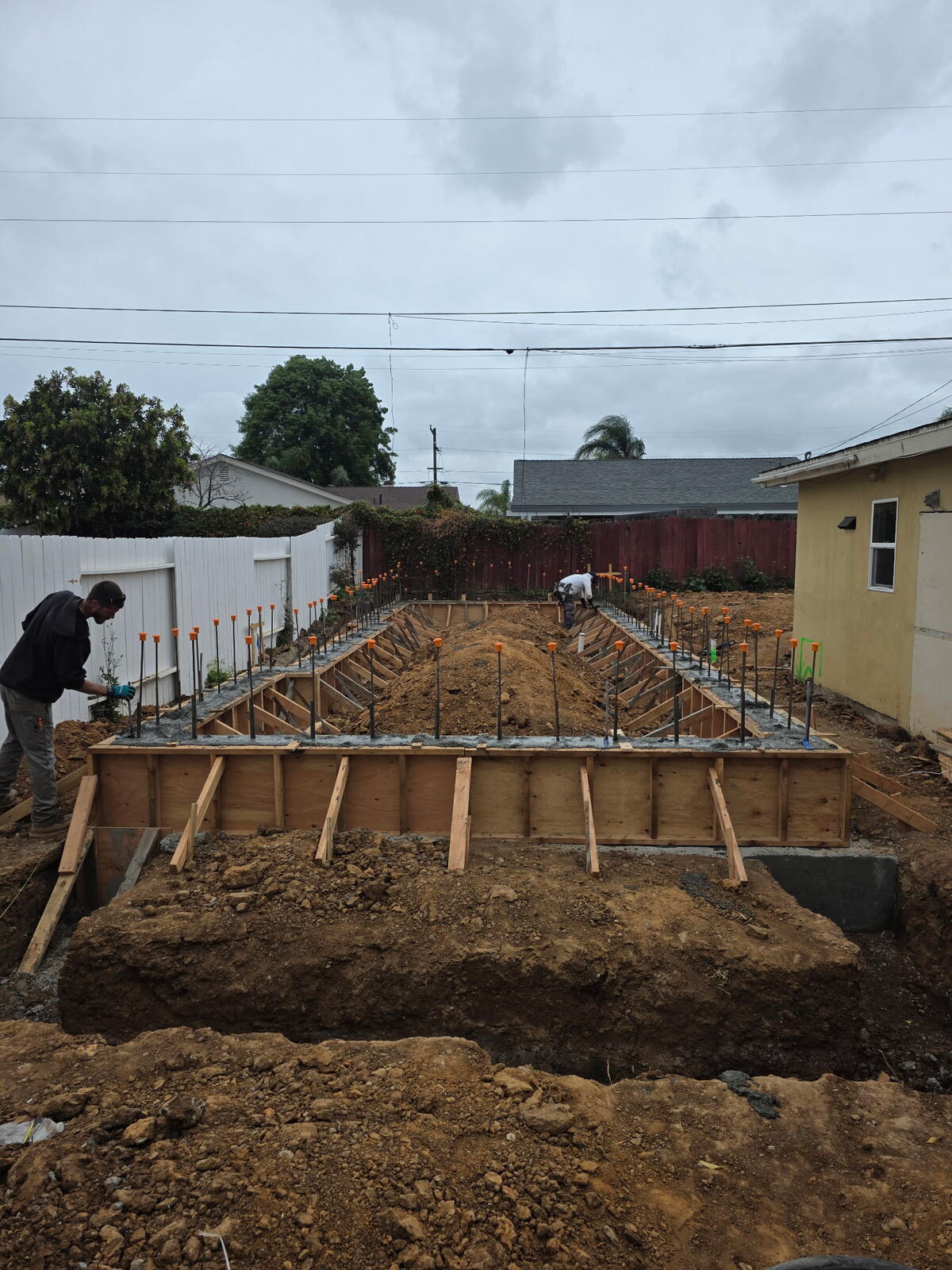

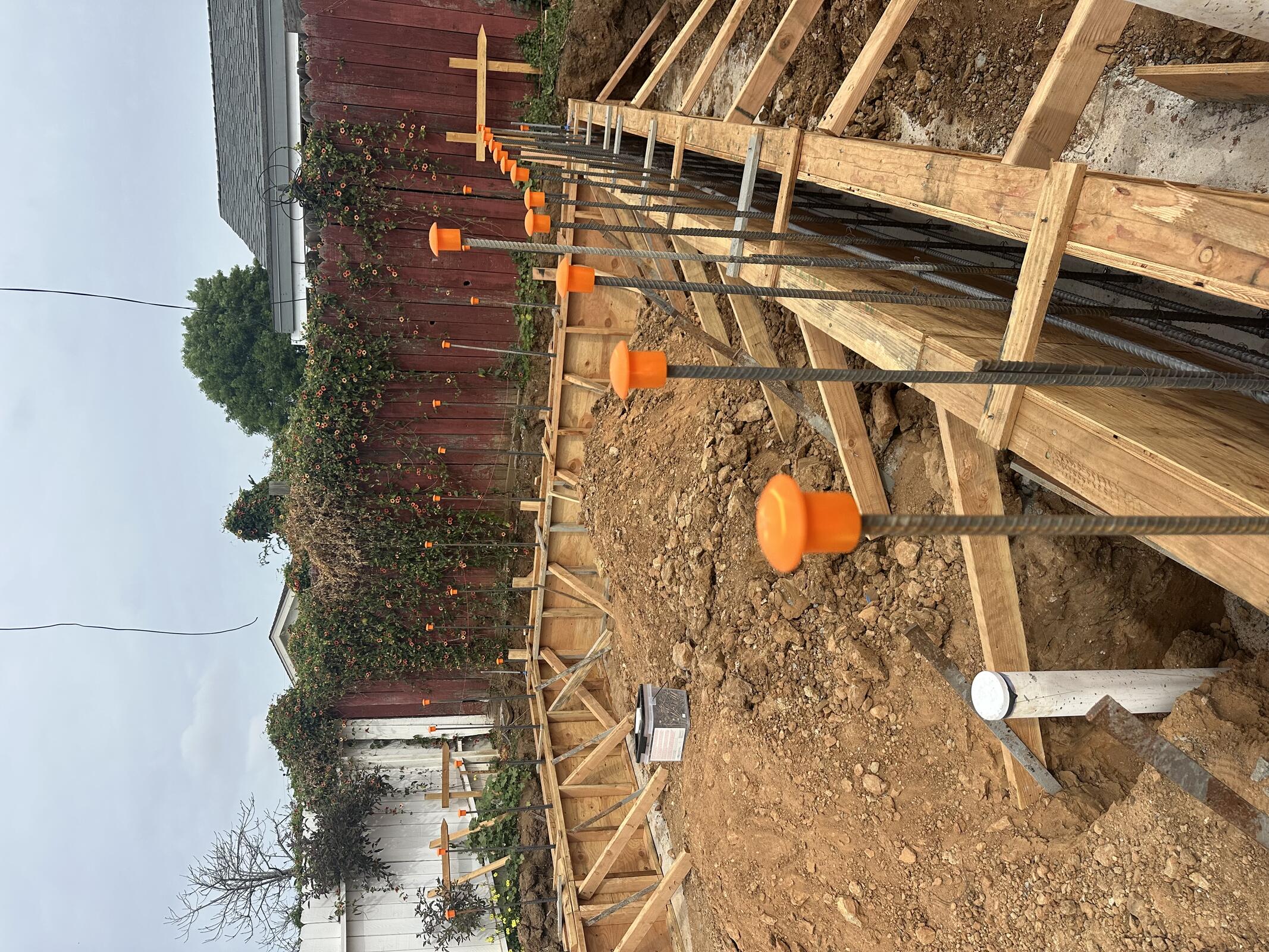

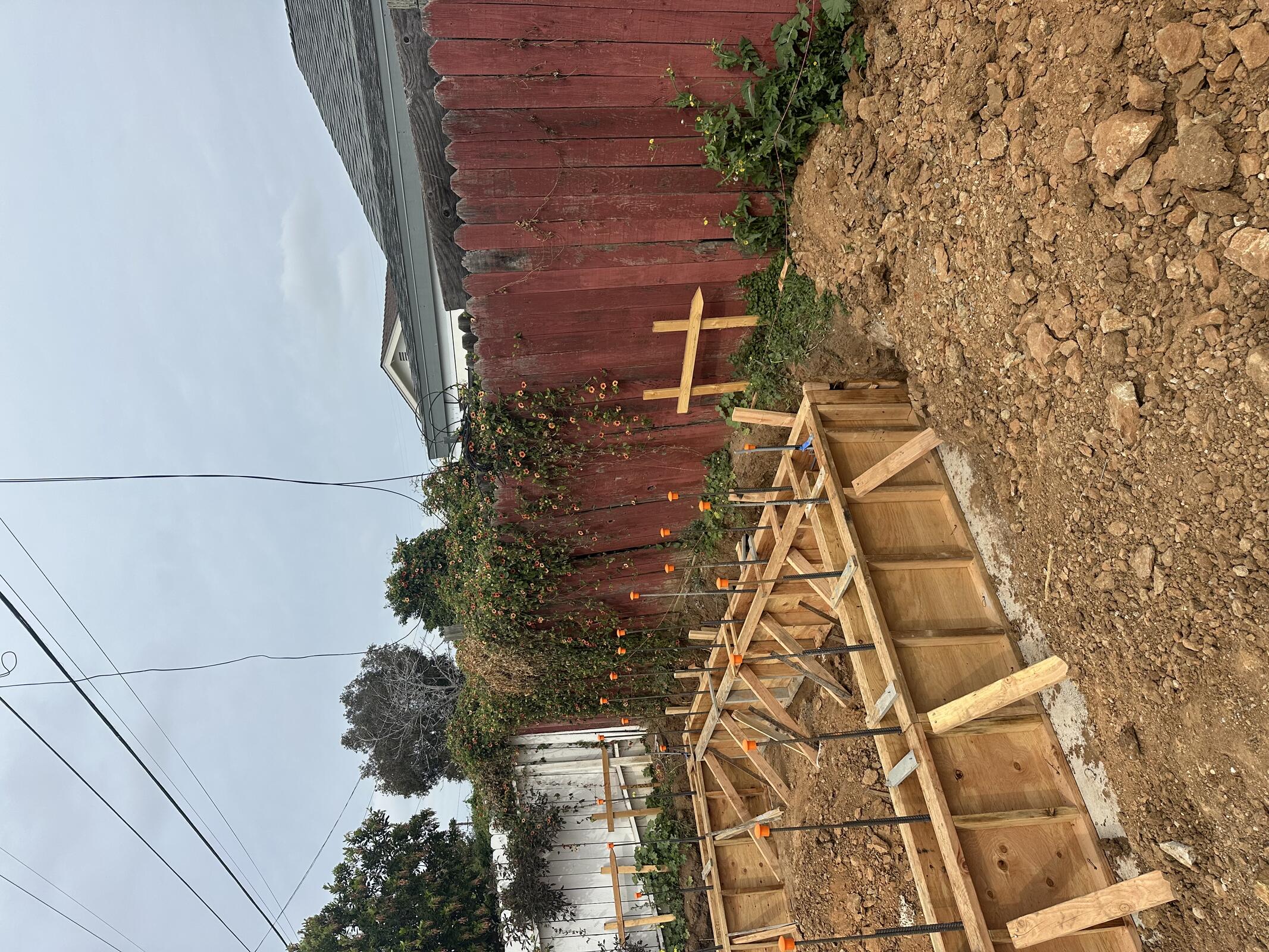

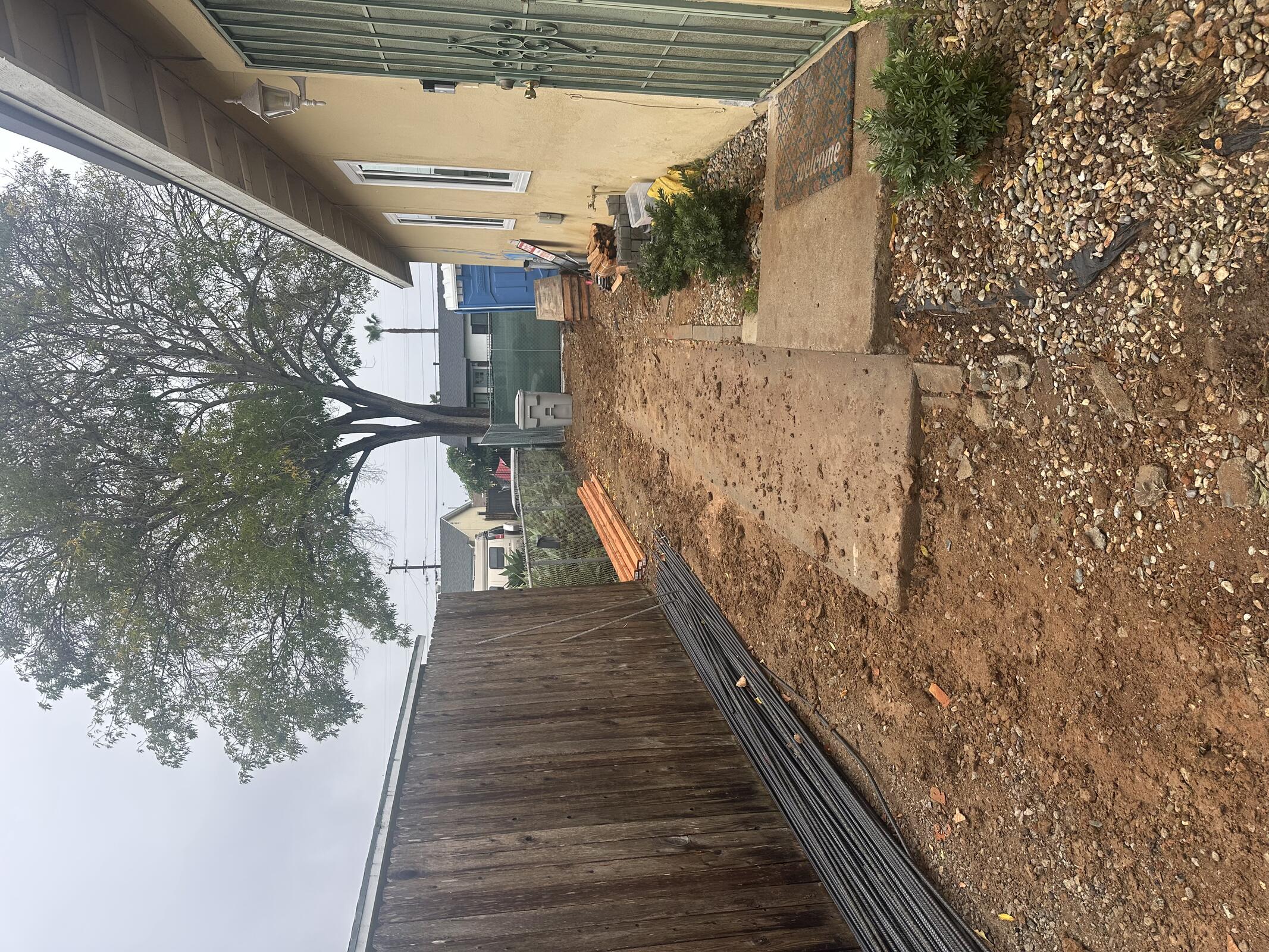

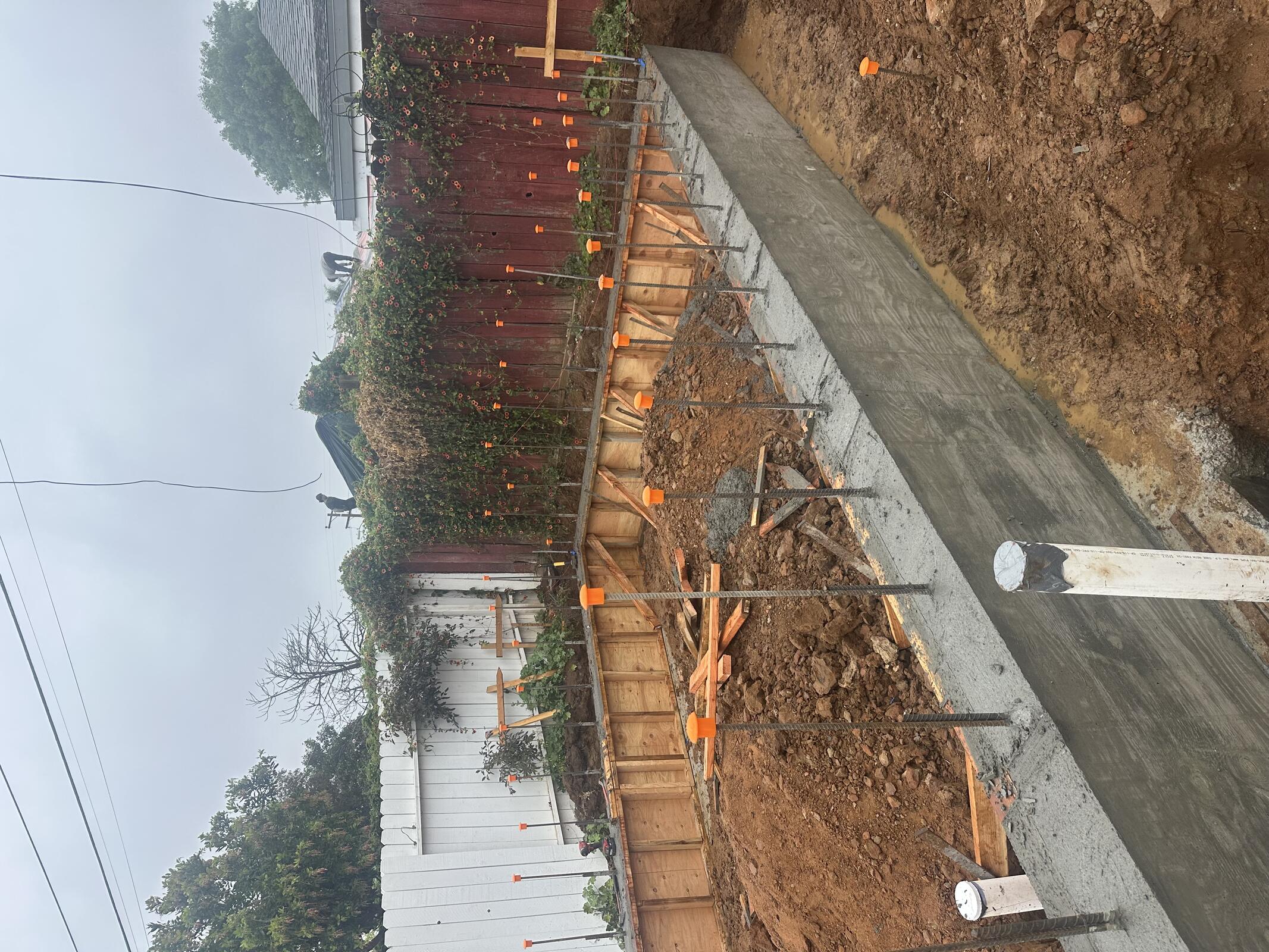

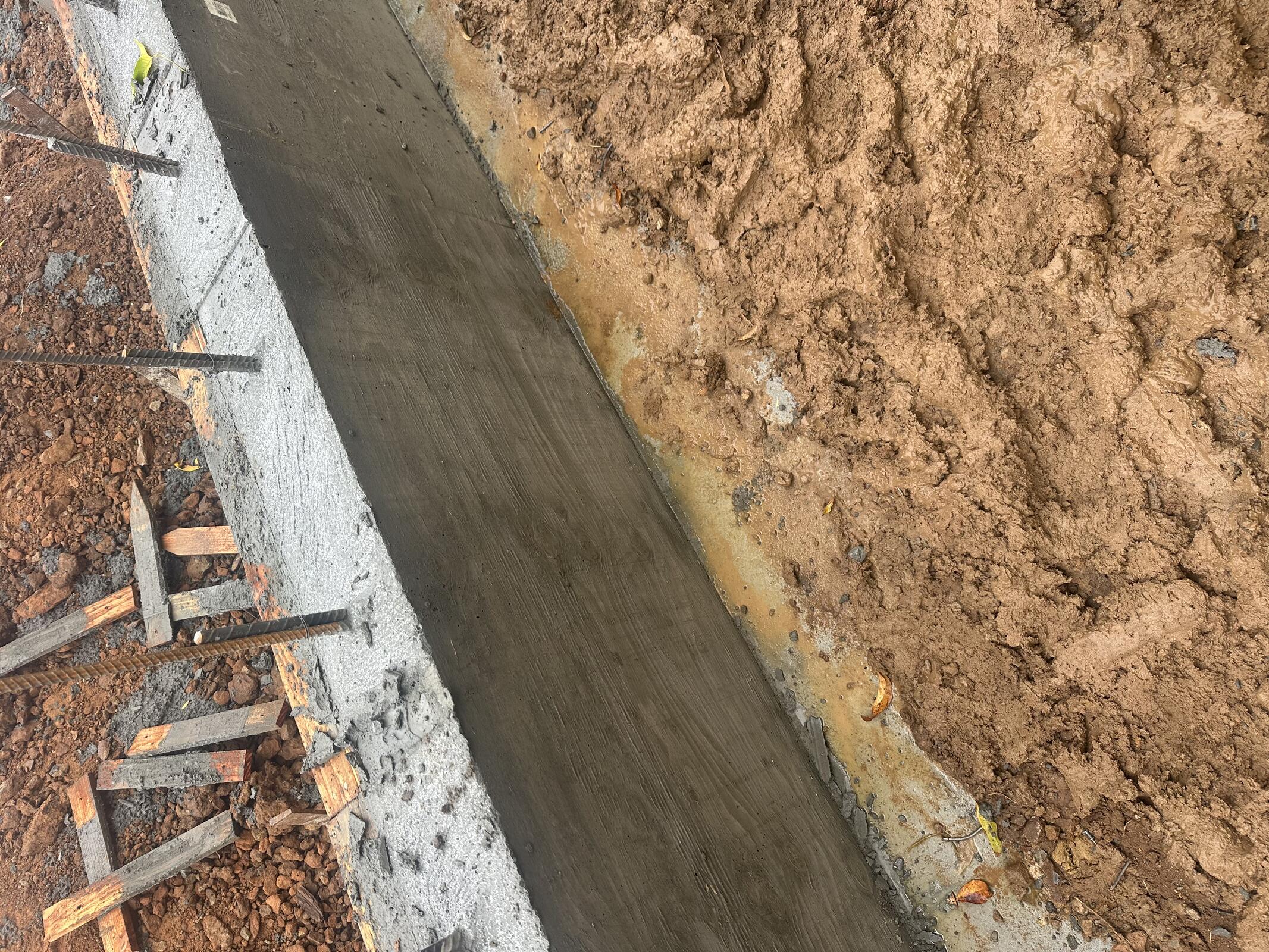

Stem walls poured.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
JB General2816

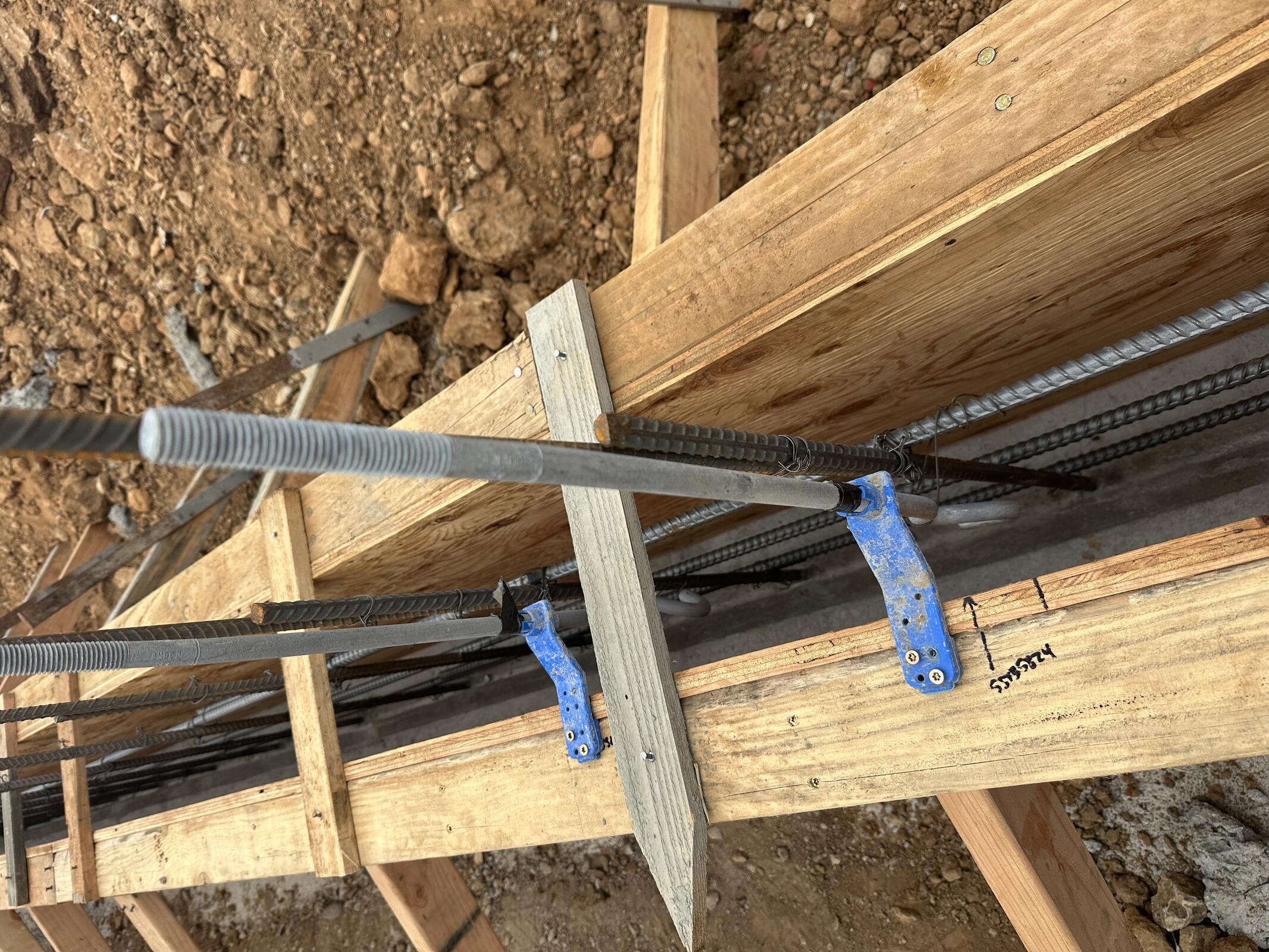

Inspection: Inspector came at 11:30 AM and signed off on Building C wall rebar and holddowns. Noted that mushroom caps are no longer allowed, and we will need to use square rebar caps on Buliding B.

Inspector also noted that PAs not required on existing structure. RFI submitted to clarify if needed on Buildings B and C.

Wednesday, February 11, 2026

Overcast, 60°F

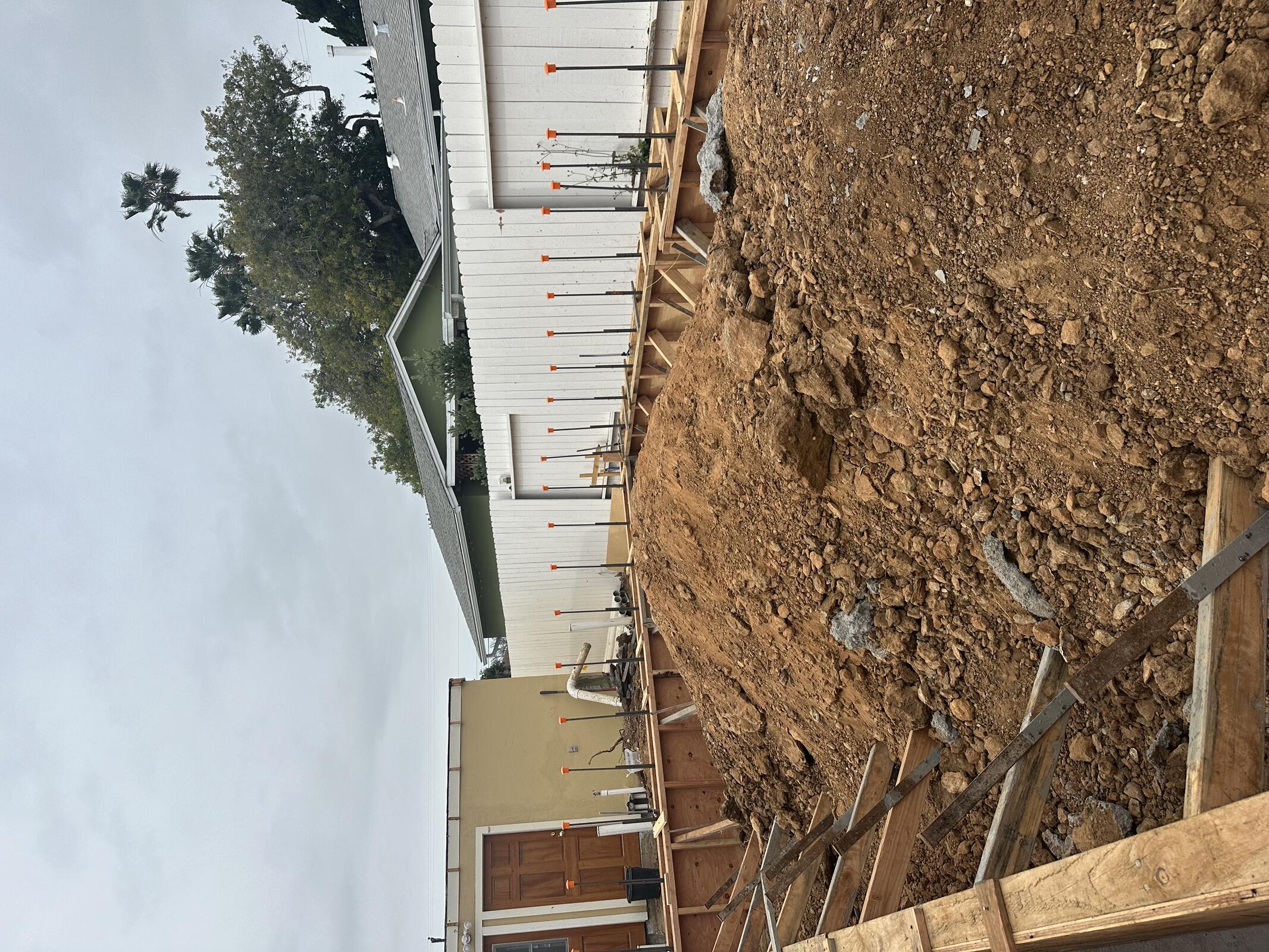

JB General on site stripping wall forms. Panels are being stacked to the site for use on Building B.

Area by the laundry room is wet and muddy, but stockpile on Building B pad seems okay, as well as area within building C stem walls.

Manpower:

SUBCONTRACTORWORKERSHOURS WORKEDTOTAL HOURS
JB General248

Inspection: N/A

Delay: 1/2 day rain delay. Need to wait for site to dry out to start backfill.
