Week of August 17 — August 21, 2026
5 days on site. 38 photos. Drywall, Electric, HVAC, Landscape, Plumbing, ROW.
Monday, August 17, 2026
Clear, 80°F

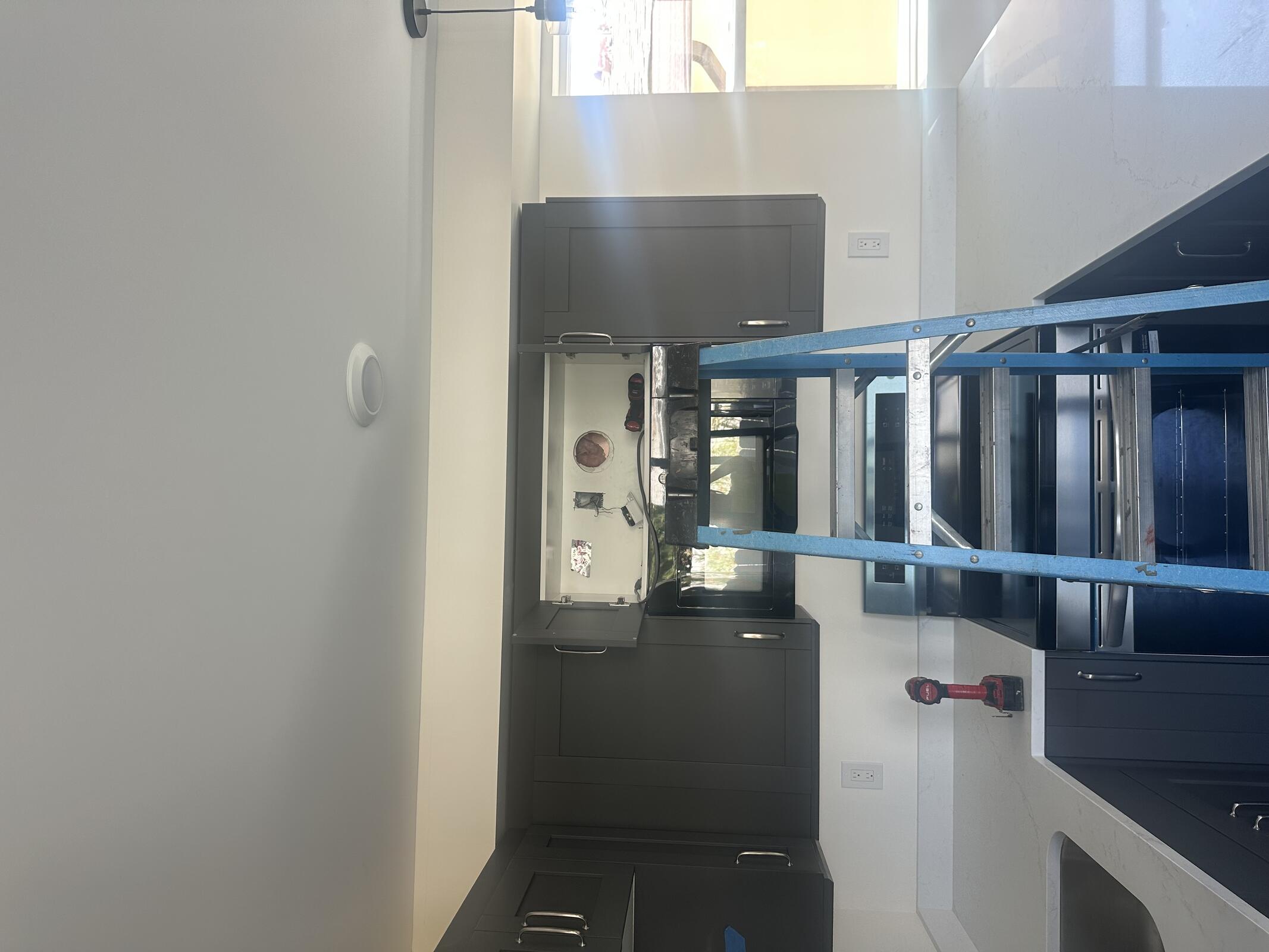

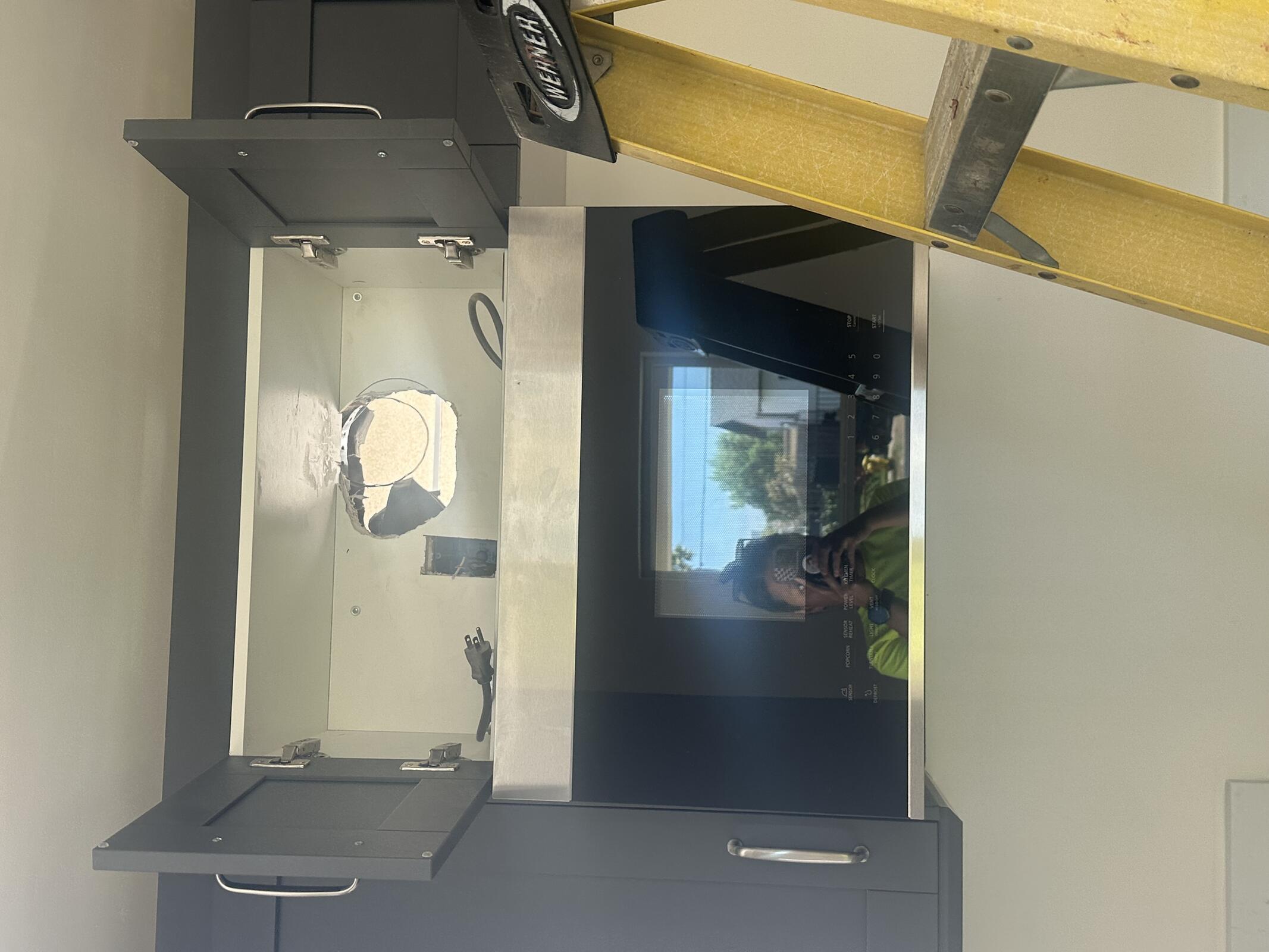

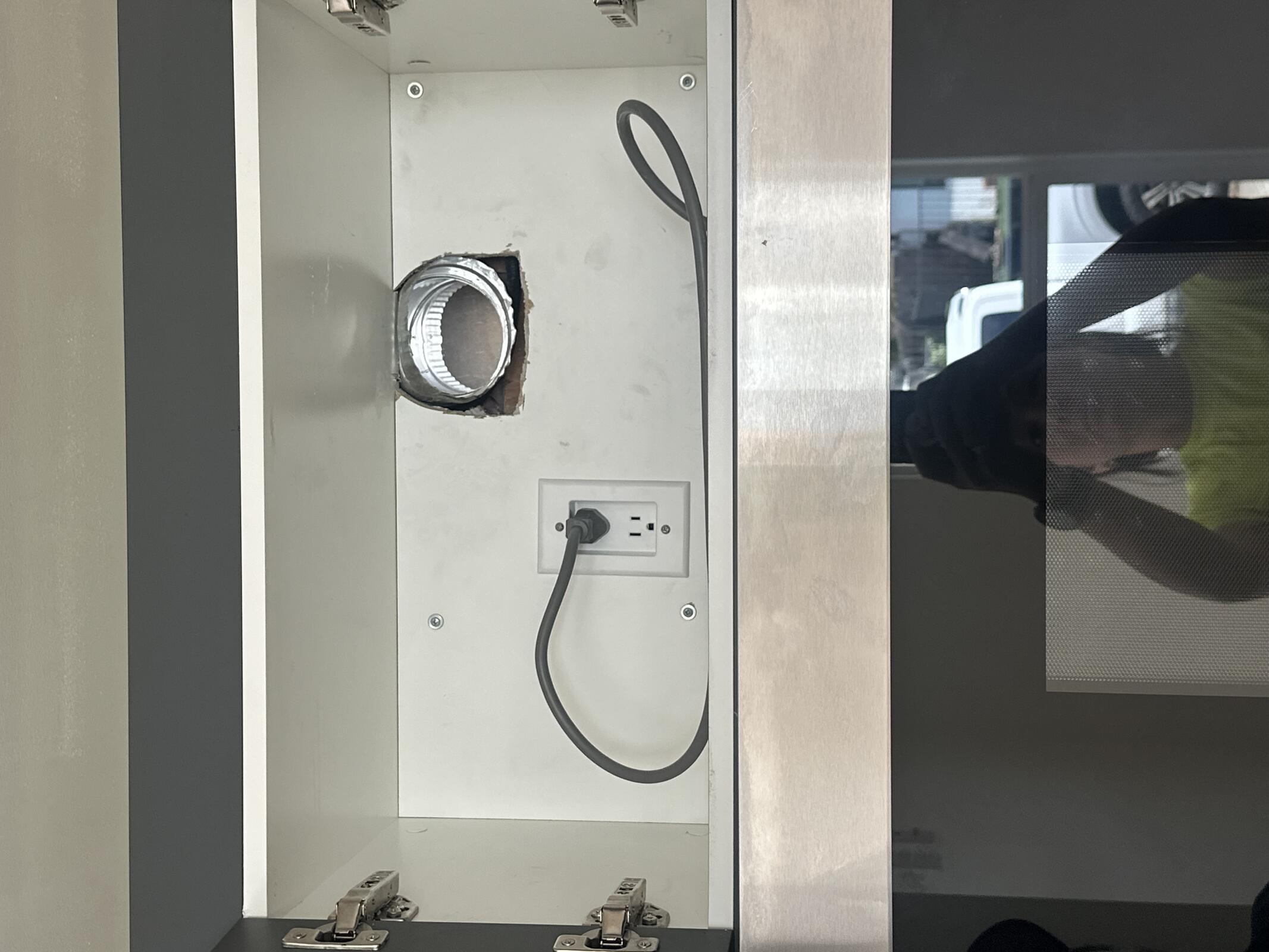

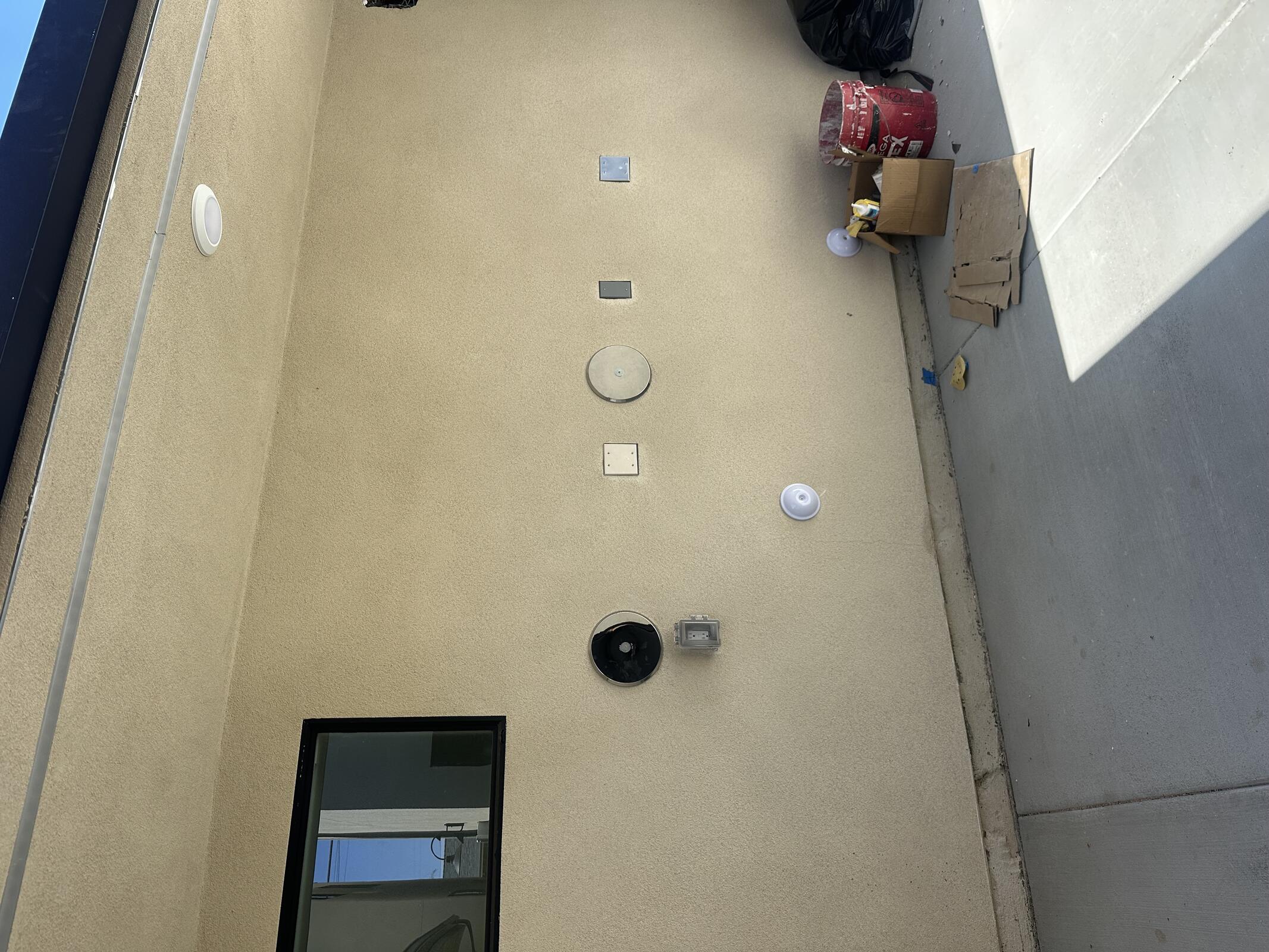

Clear on site, removing 4” ducts and preparing for install of 6” rigid ducts at micros.

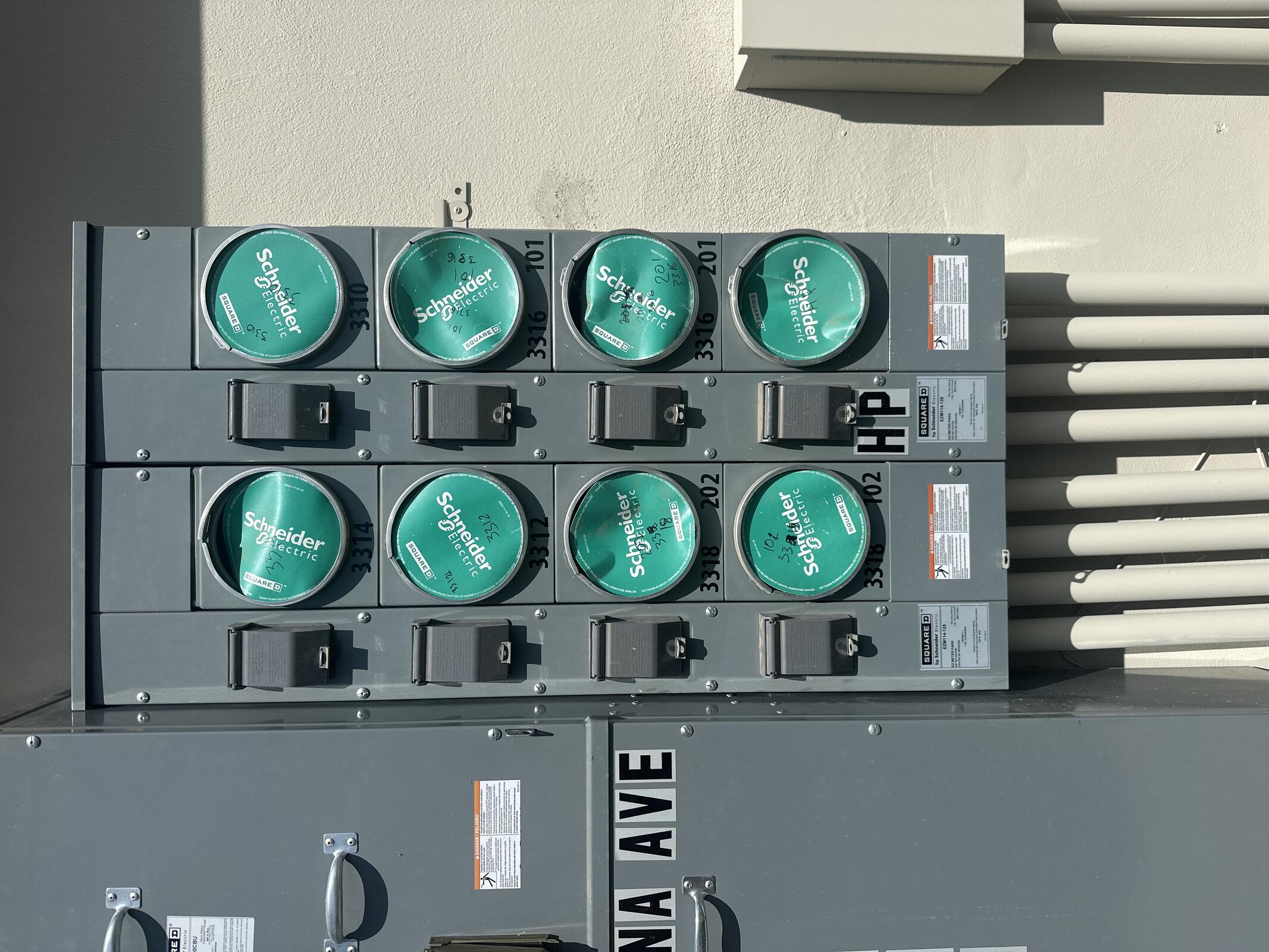

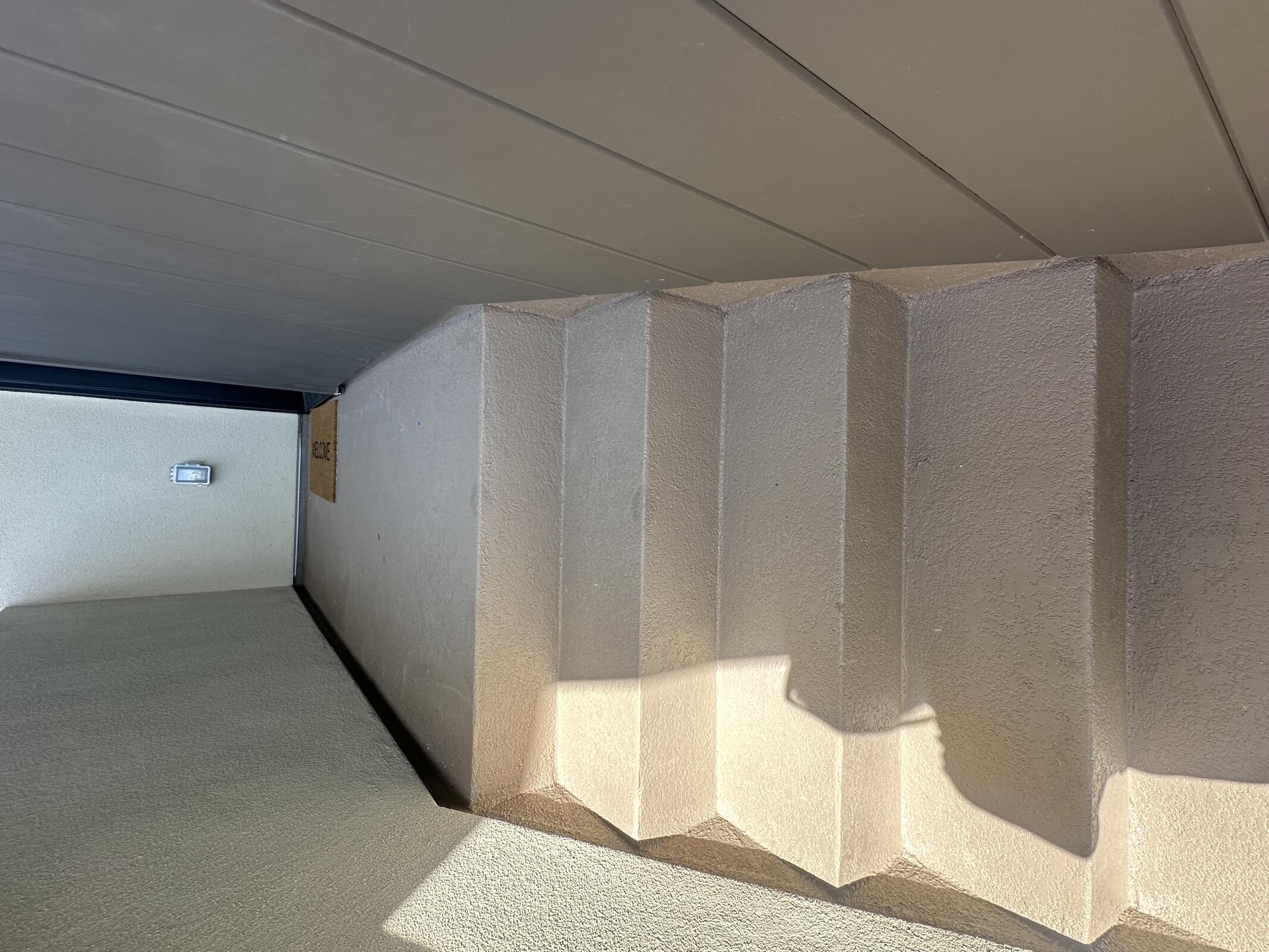

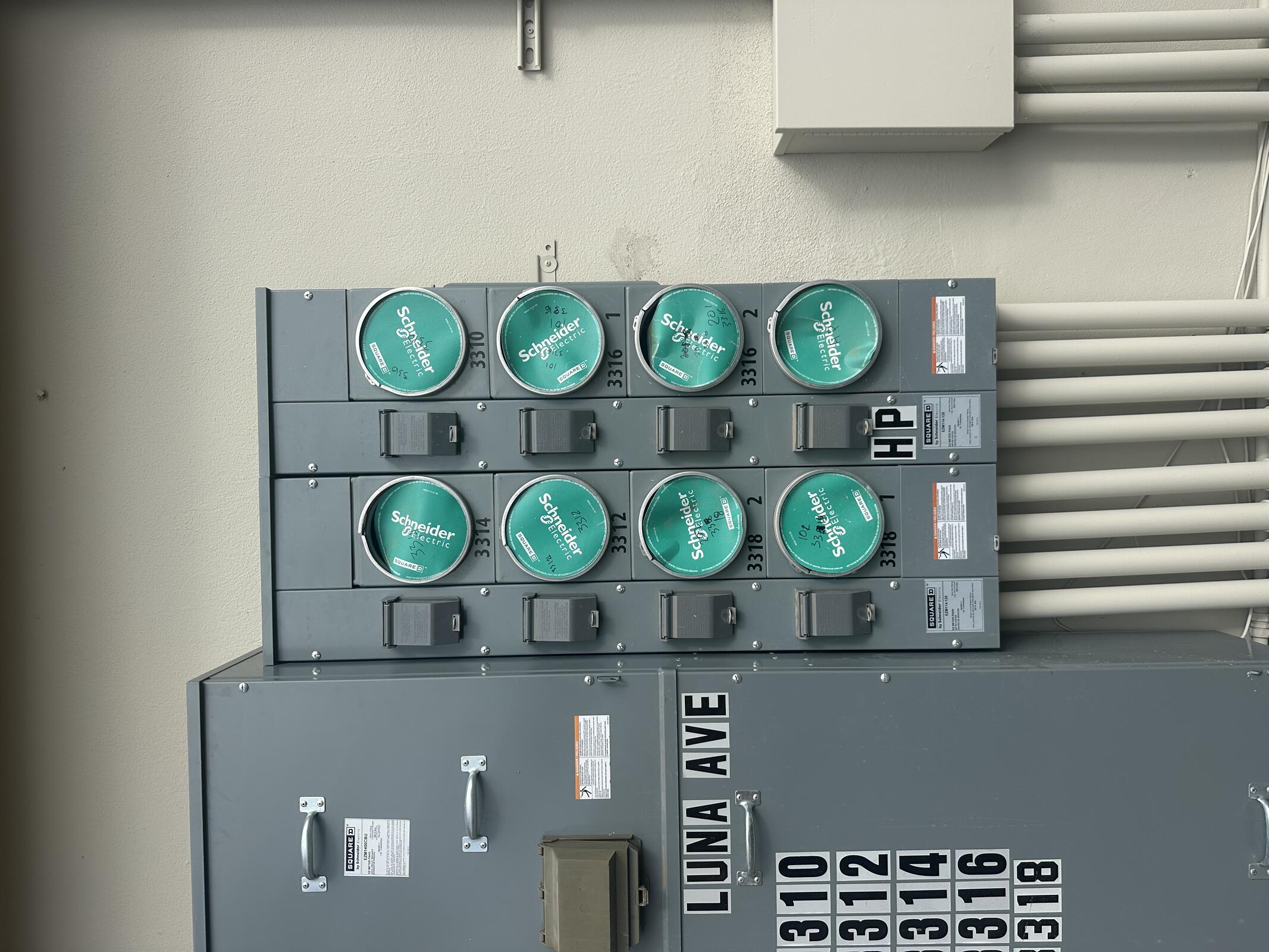

AC Electric on site to update switchgear labeling.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| Clear | 1 | 6 | 6 |
Inspection: N/A

Tuesday, August 18, 2026
Clear, 72°F

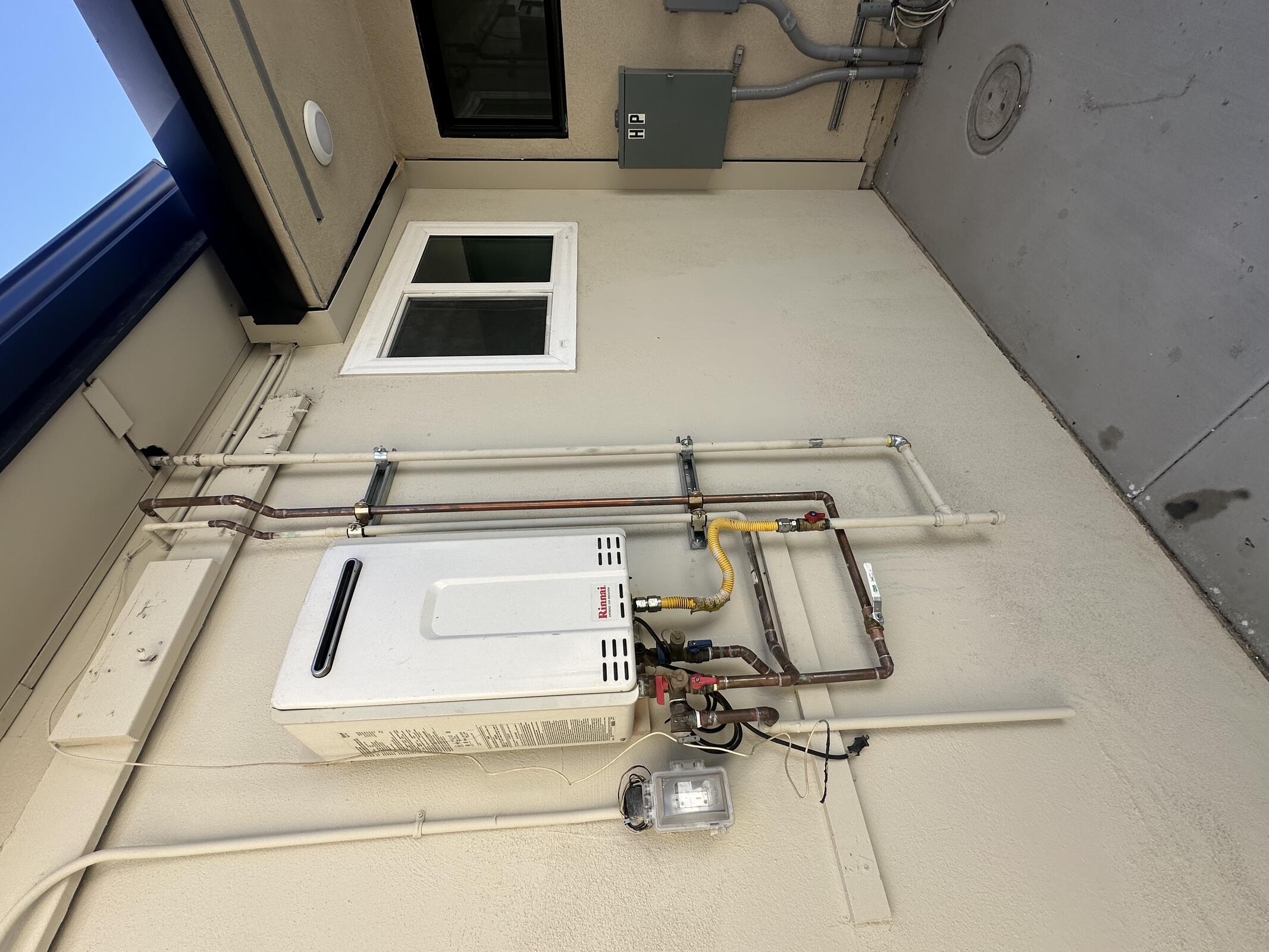

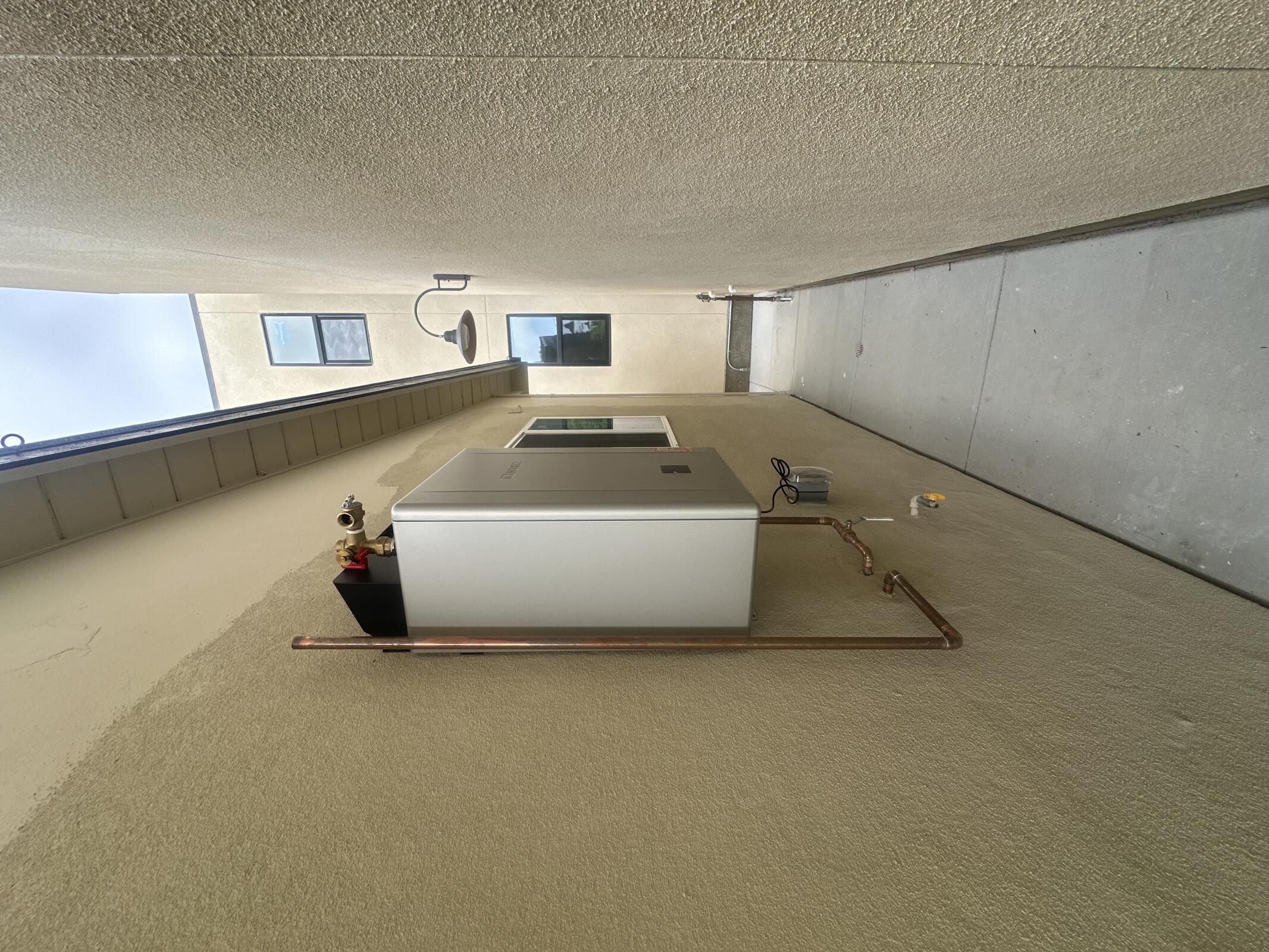

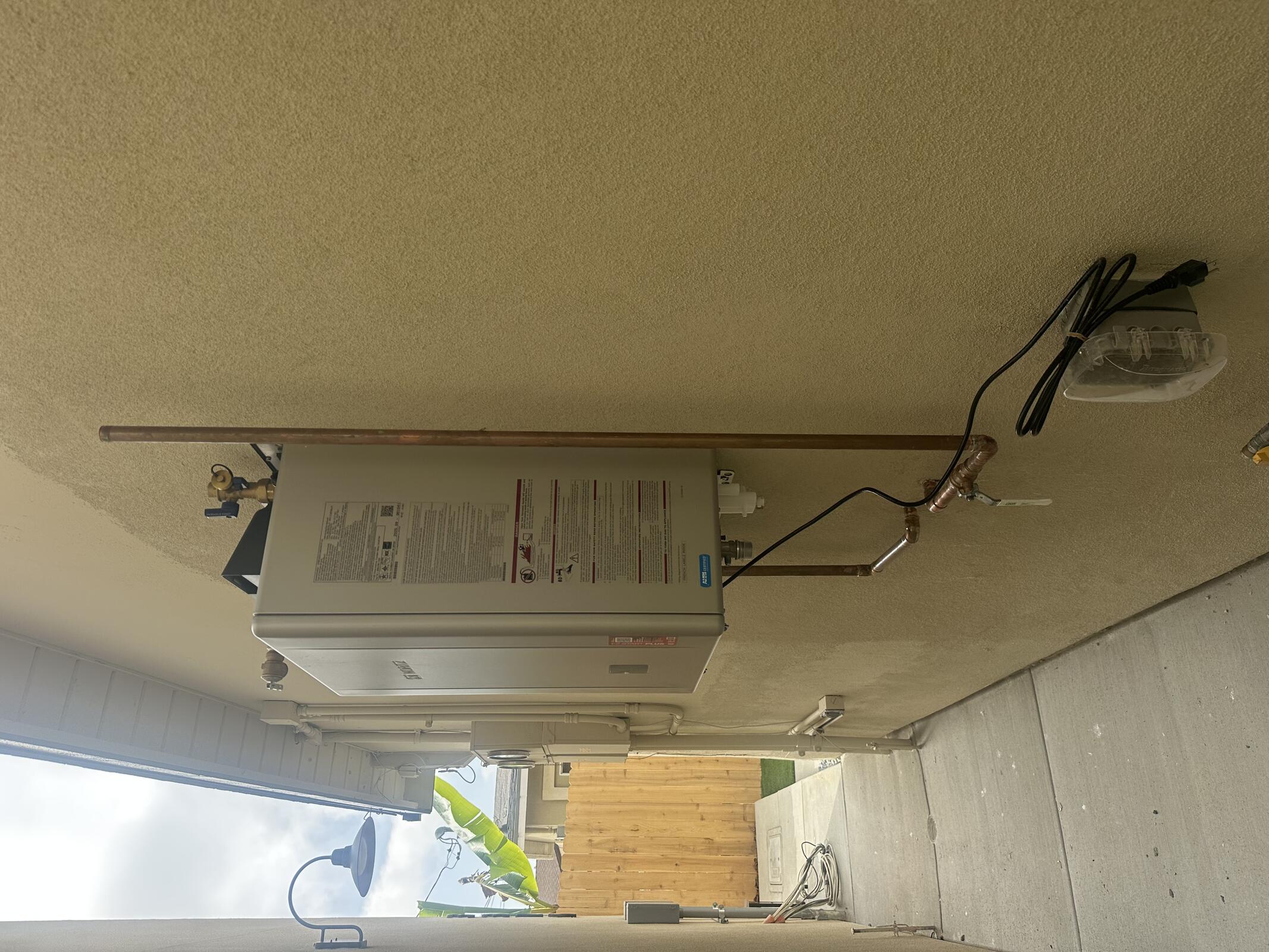

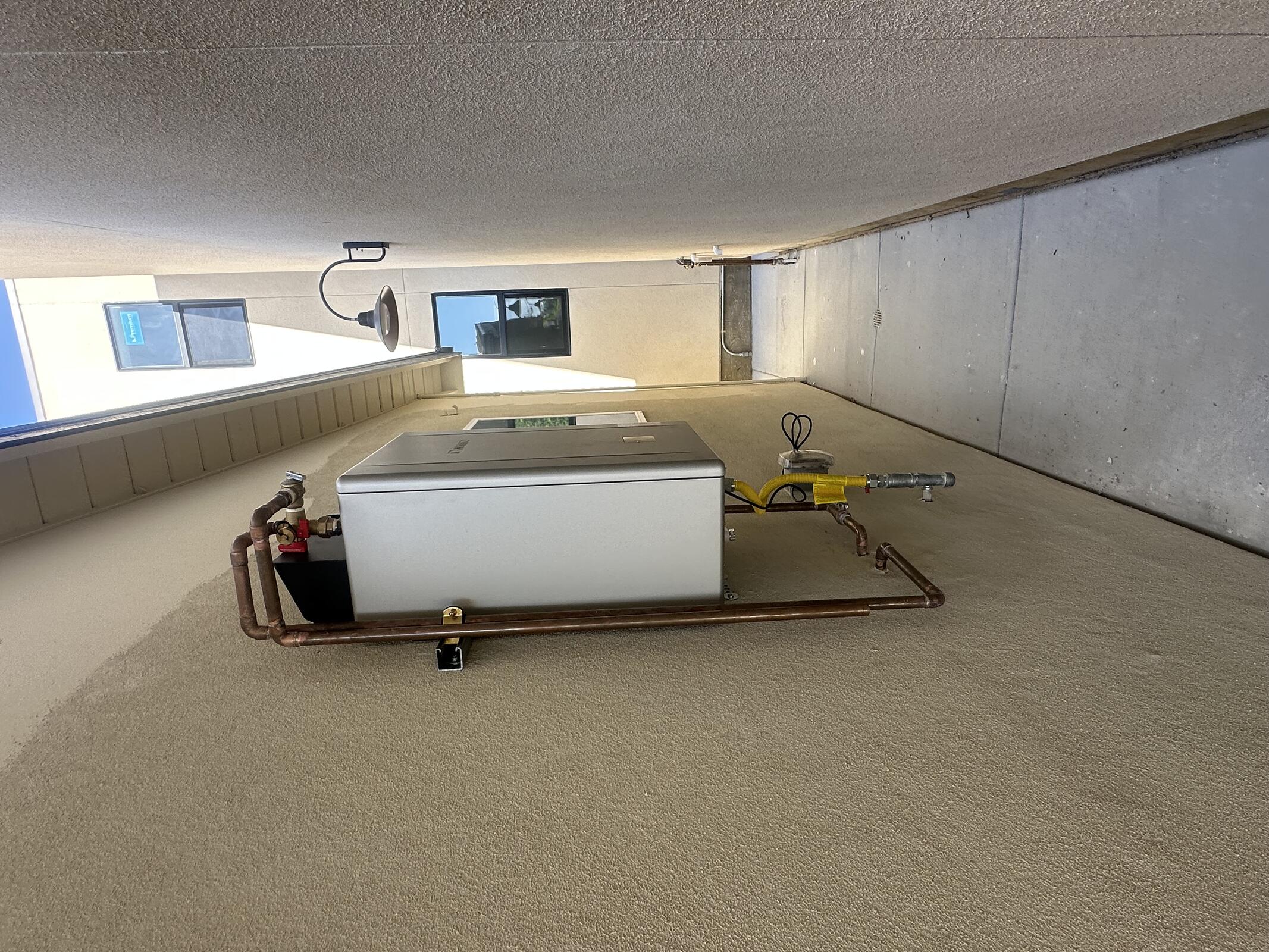

ZSP on site for half day to start install of tankless water heater at back existing unit. Luis walked with ML to discuss small pick up items.

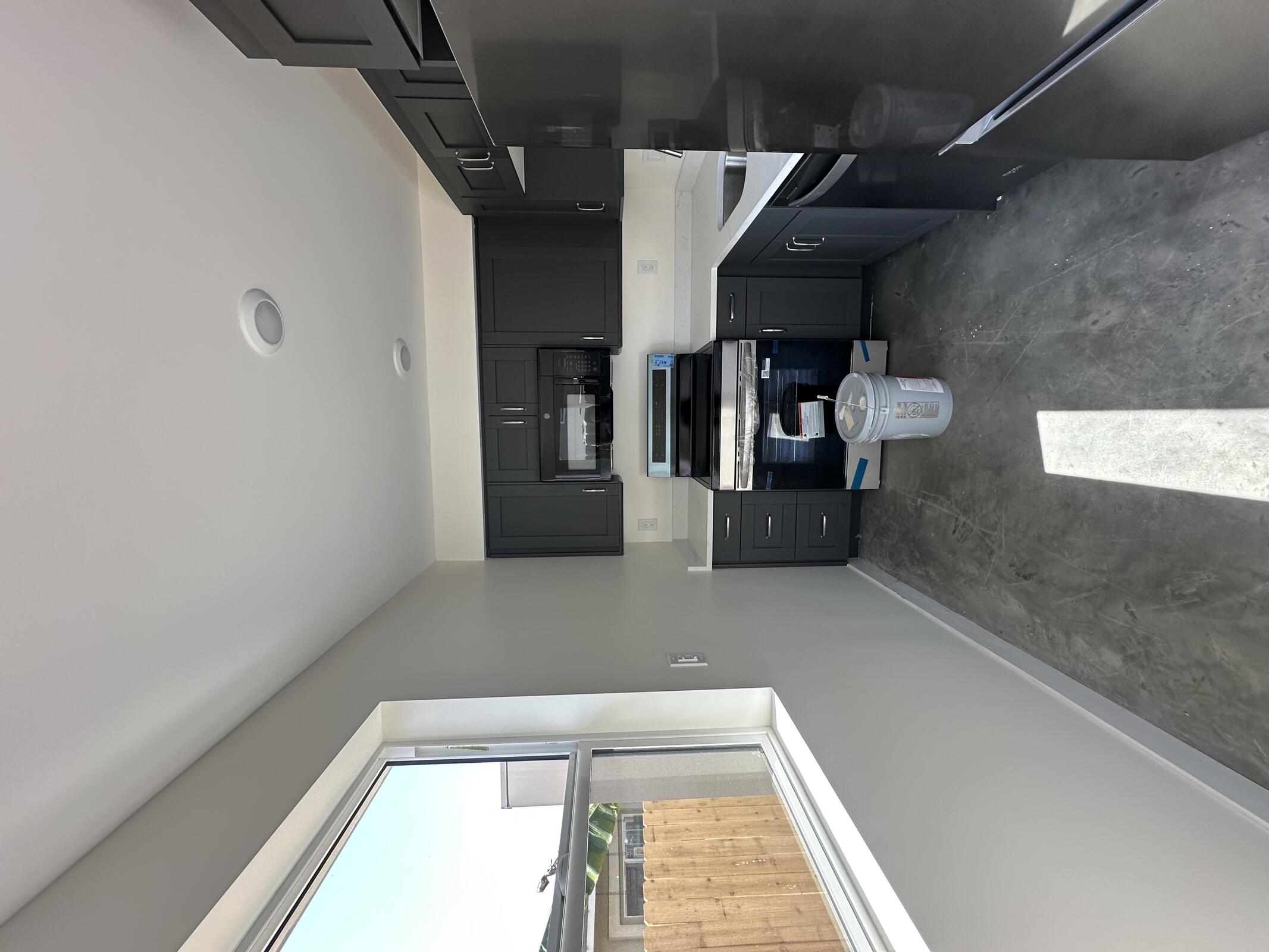

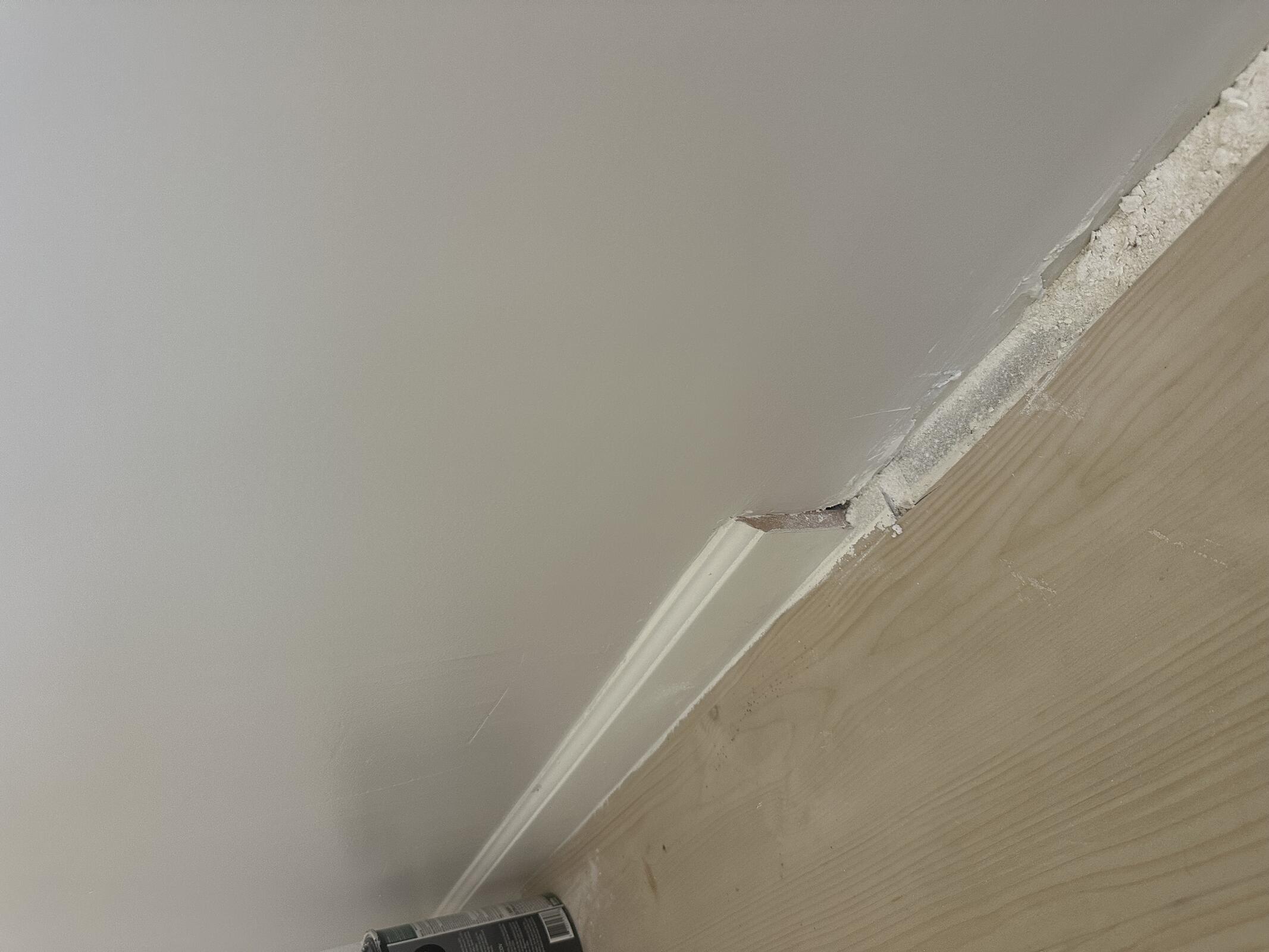

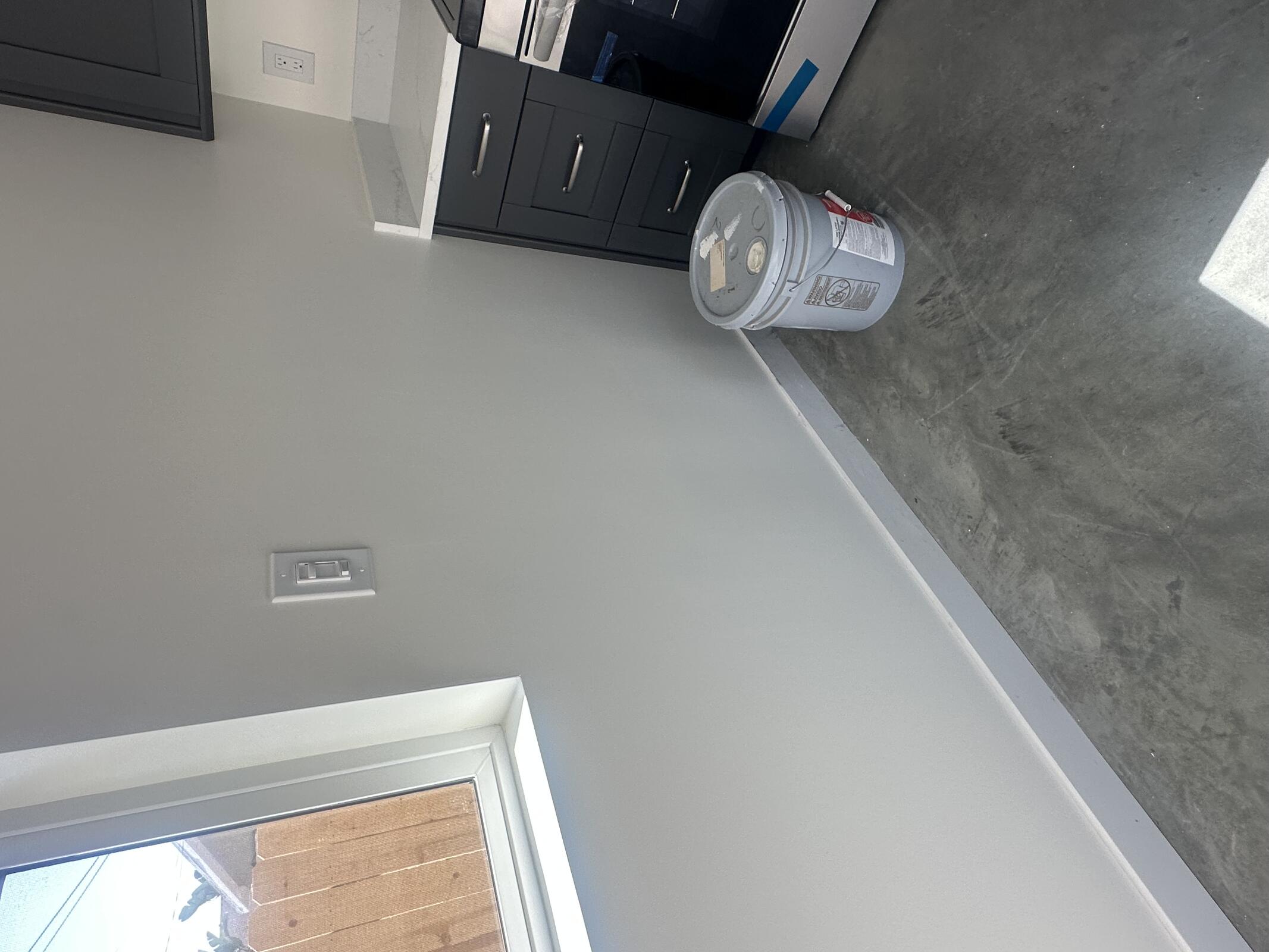

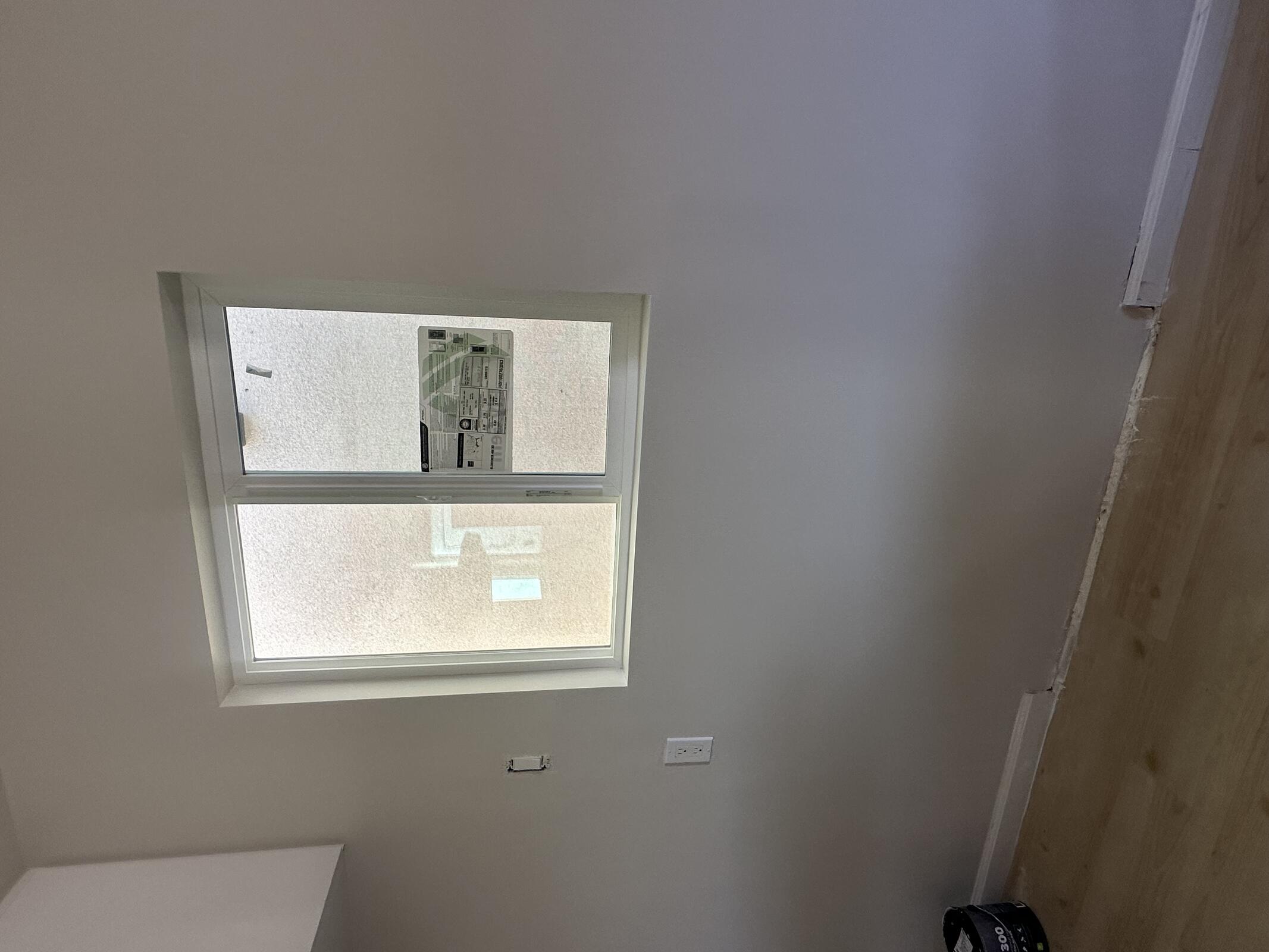

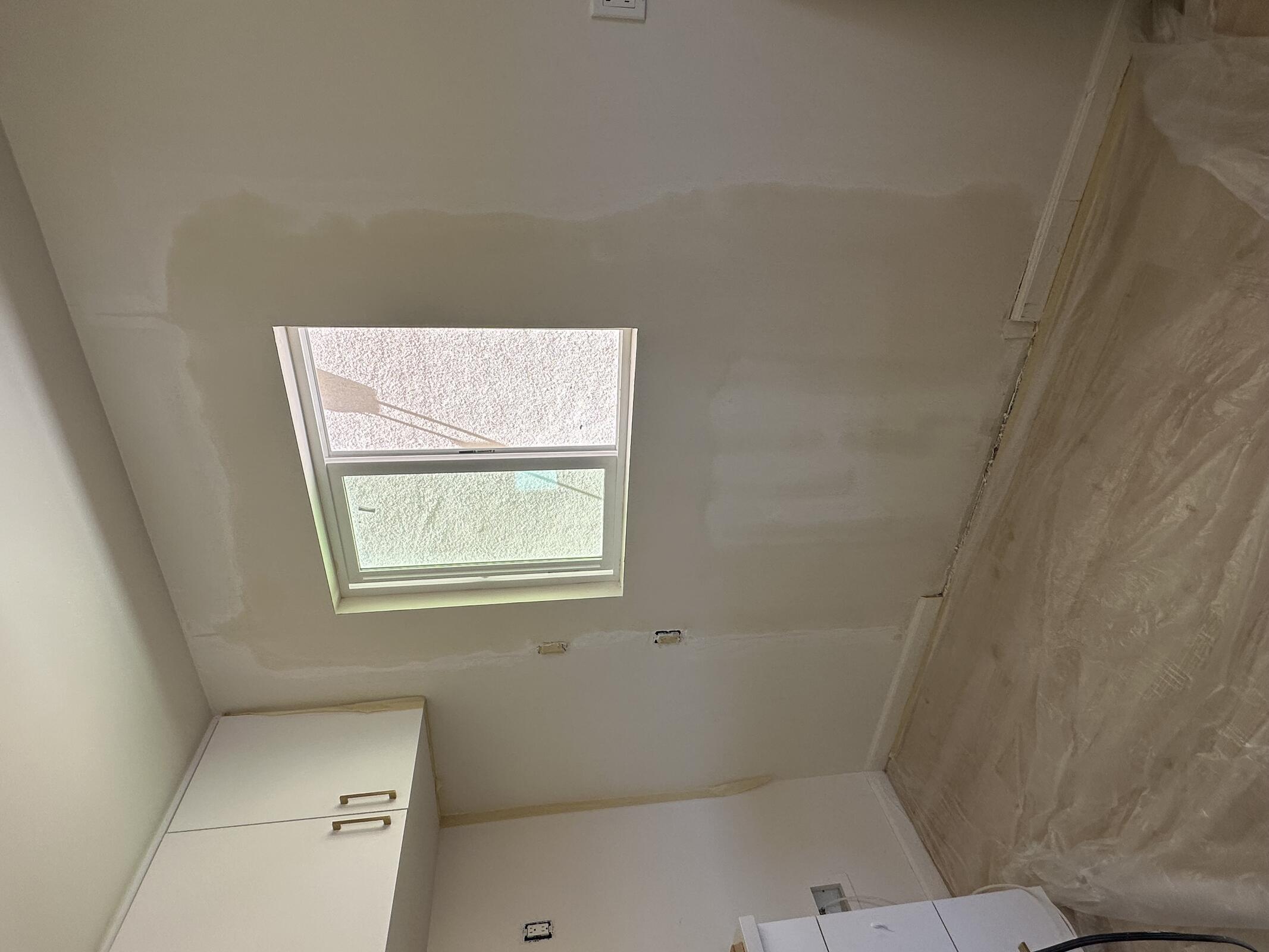

ZSP drywaller on site to patch HVAC and plumbing openings as well as door to window conversion at "office".

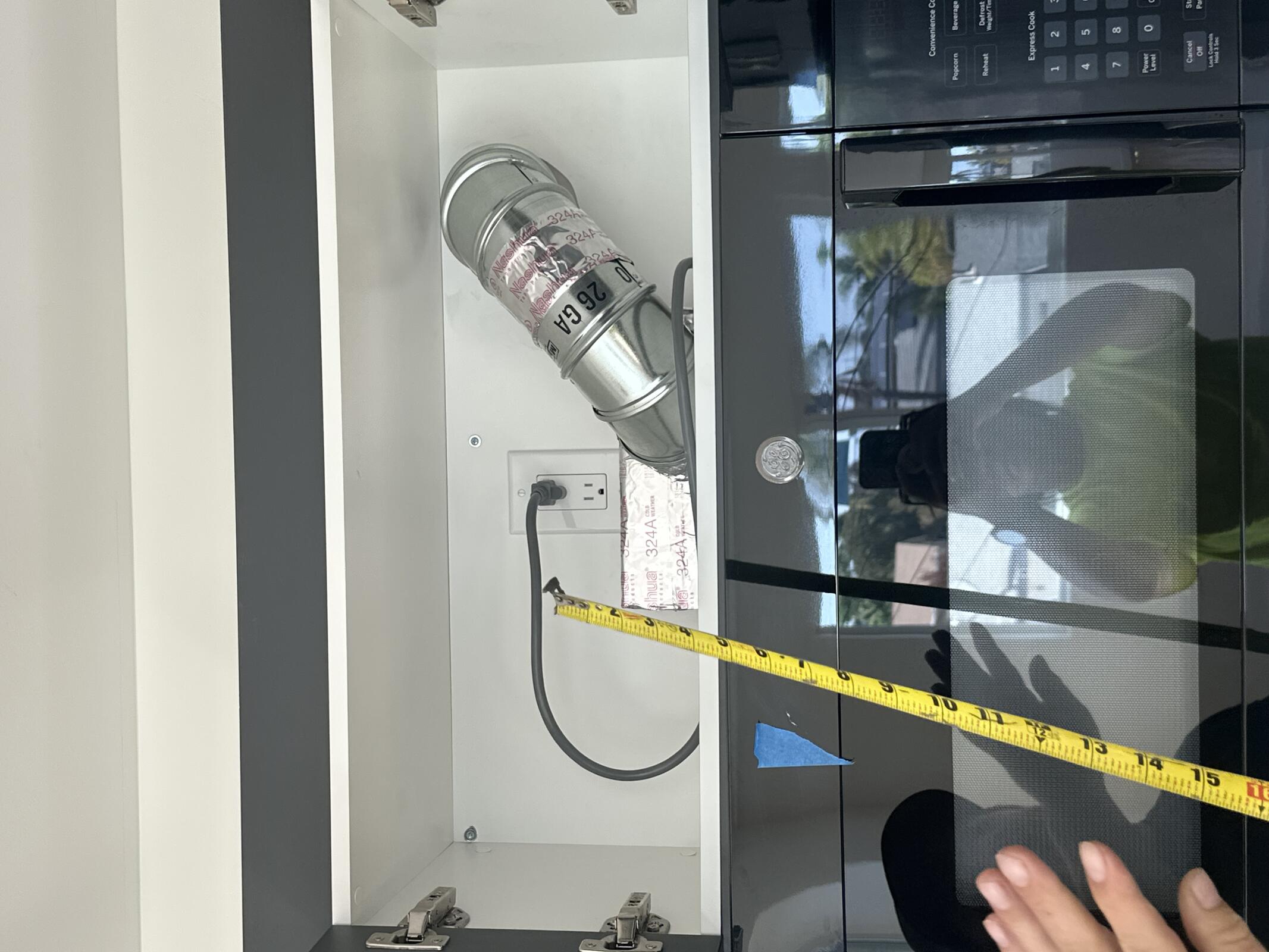

AC Electric moving microwave outlets to work with upsized range hood ducts.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| ZSP | 1 | 4 | 4 |
| AC Electric | 2 | 6 | 12 |
| ZSP - Drywaller | 1 | 4 | 4 |
Inspection: N/A
Delay: Pending call from SDGE.

Wednesday, August 19, 2026
Clear, 86°F

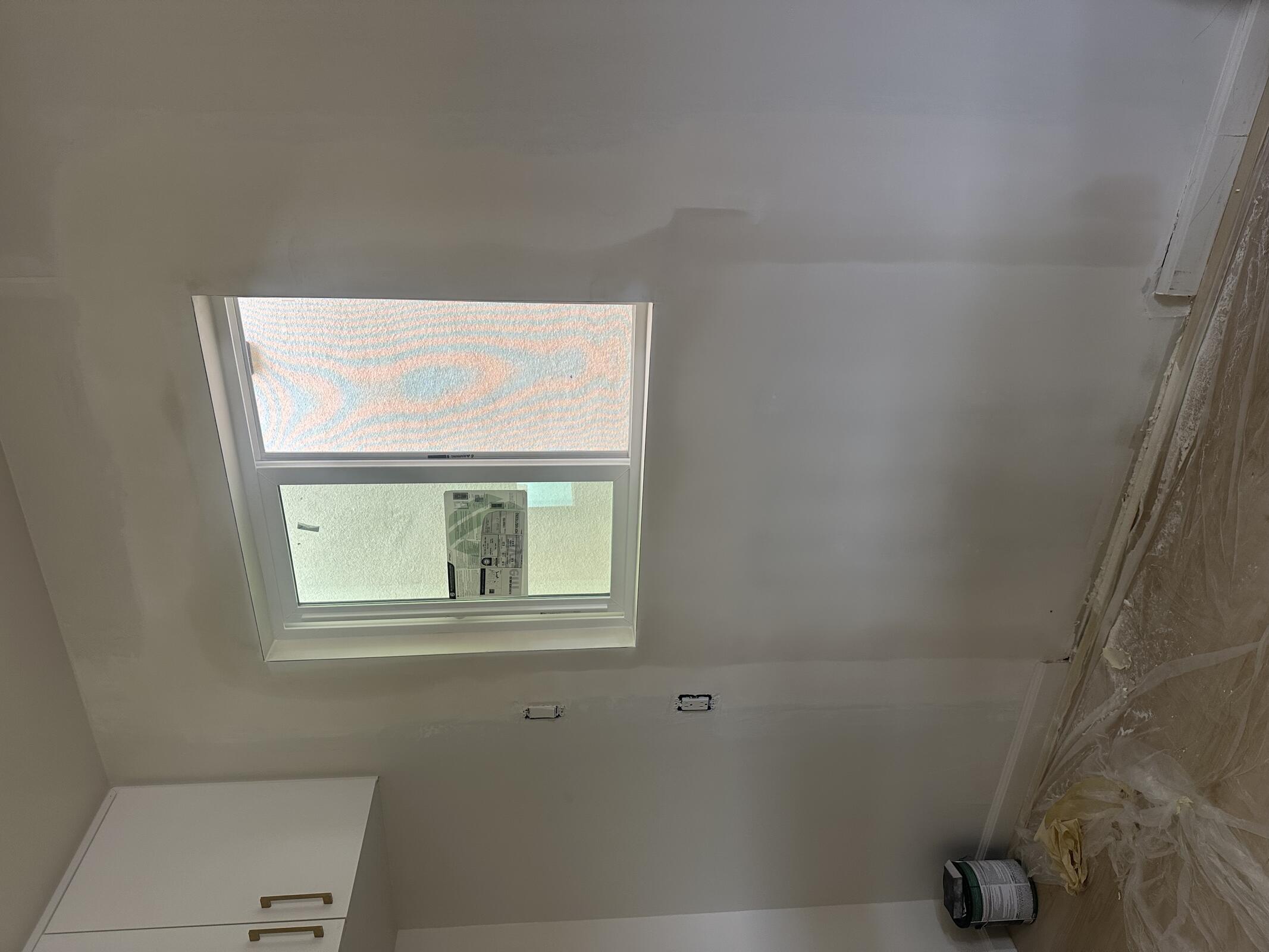

Drywaller briefly on site to sand patches.
ML walked site with Ismael (Painters Unlimited) to talk through final touch up expectations.
ML fixed reolink camera. Stream is back up.

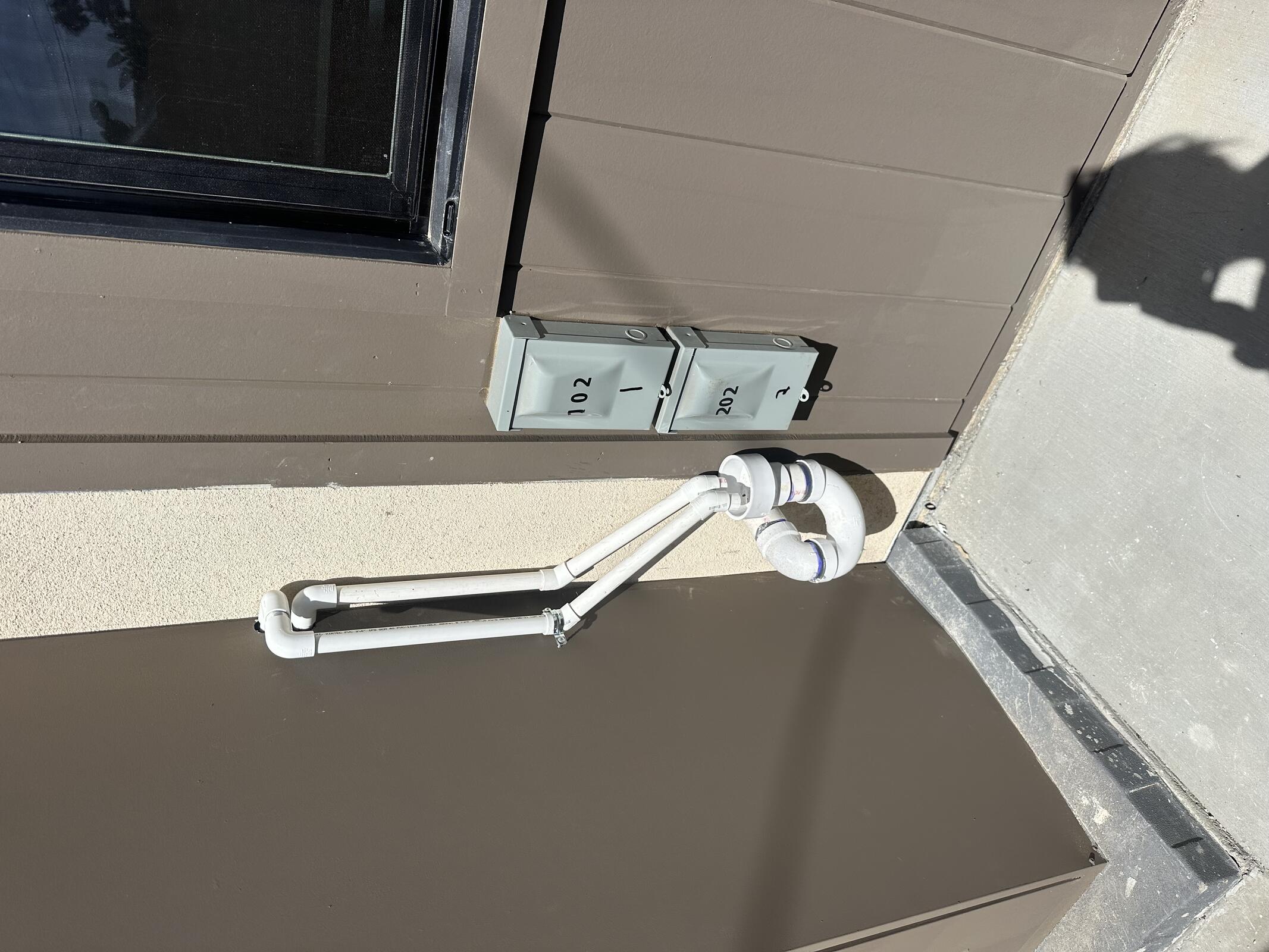

ML received mailbox keys from Postal Systems.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
Inspection: N/A

Delay: Email and VM sent to Dan Rodriquez (SDGE). Still waiting on electrification date.

Thursday, August 20, 2026
Partially cloudy, 81°F

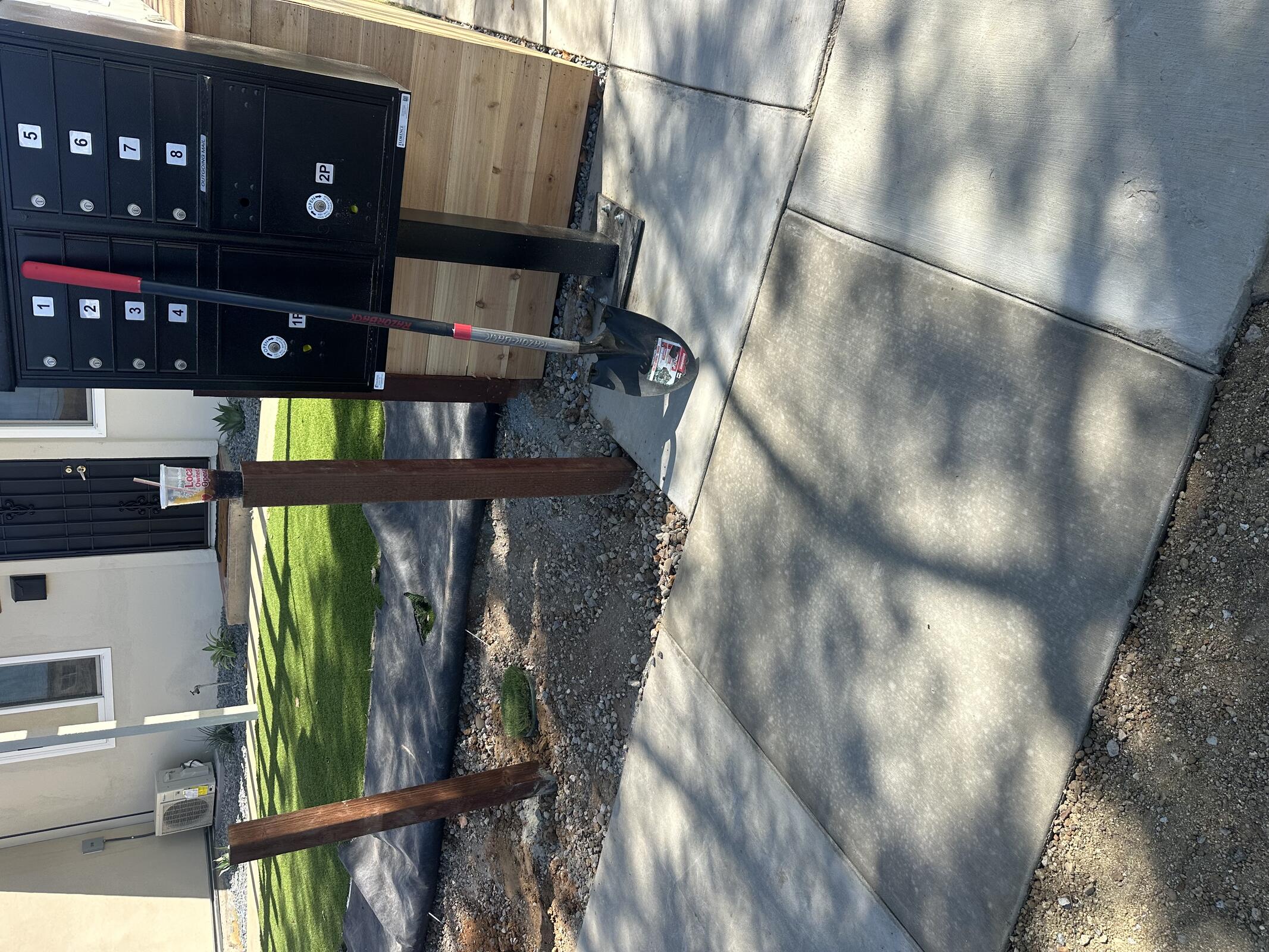

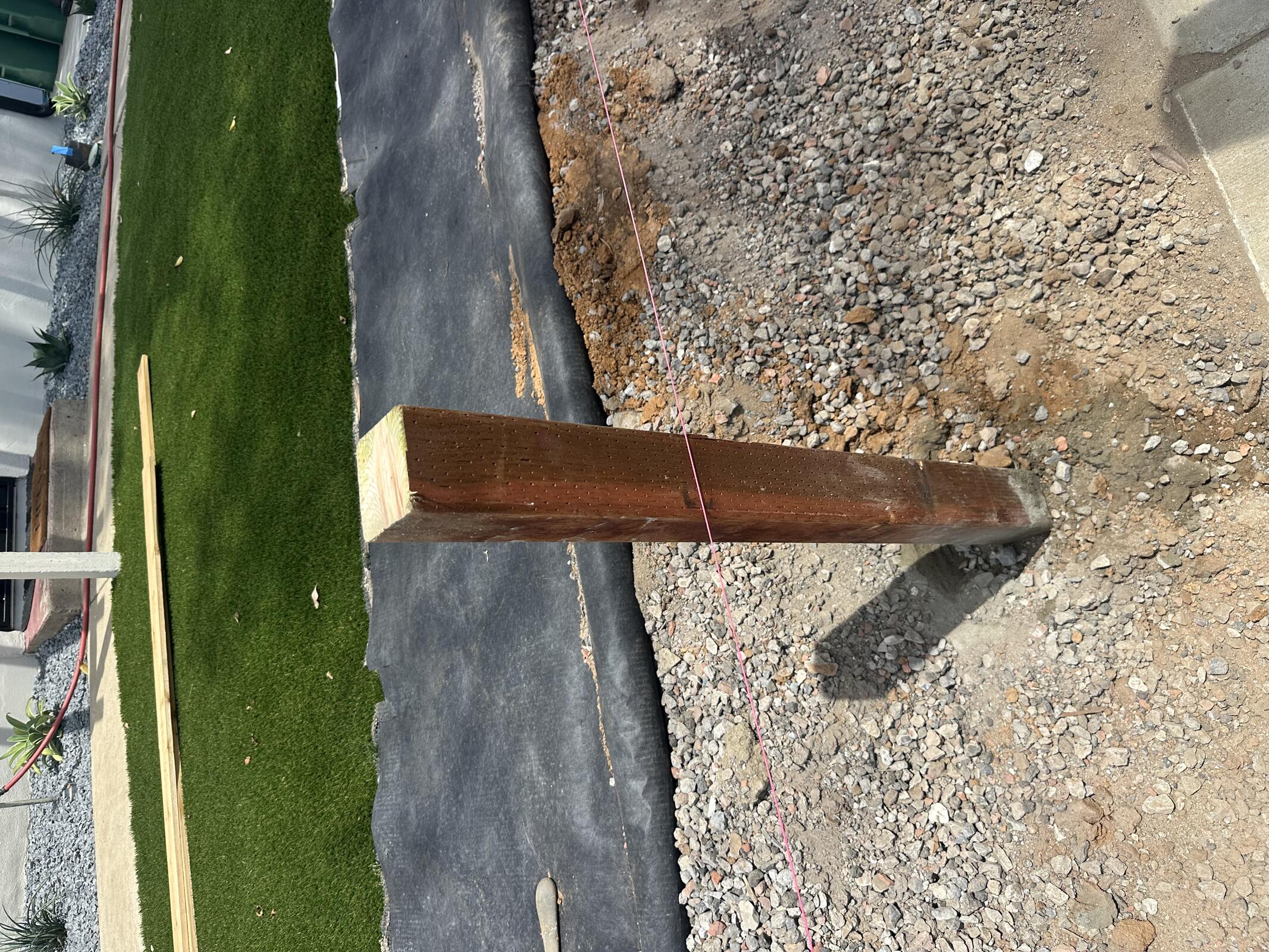

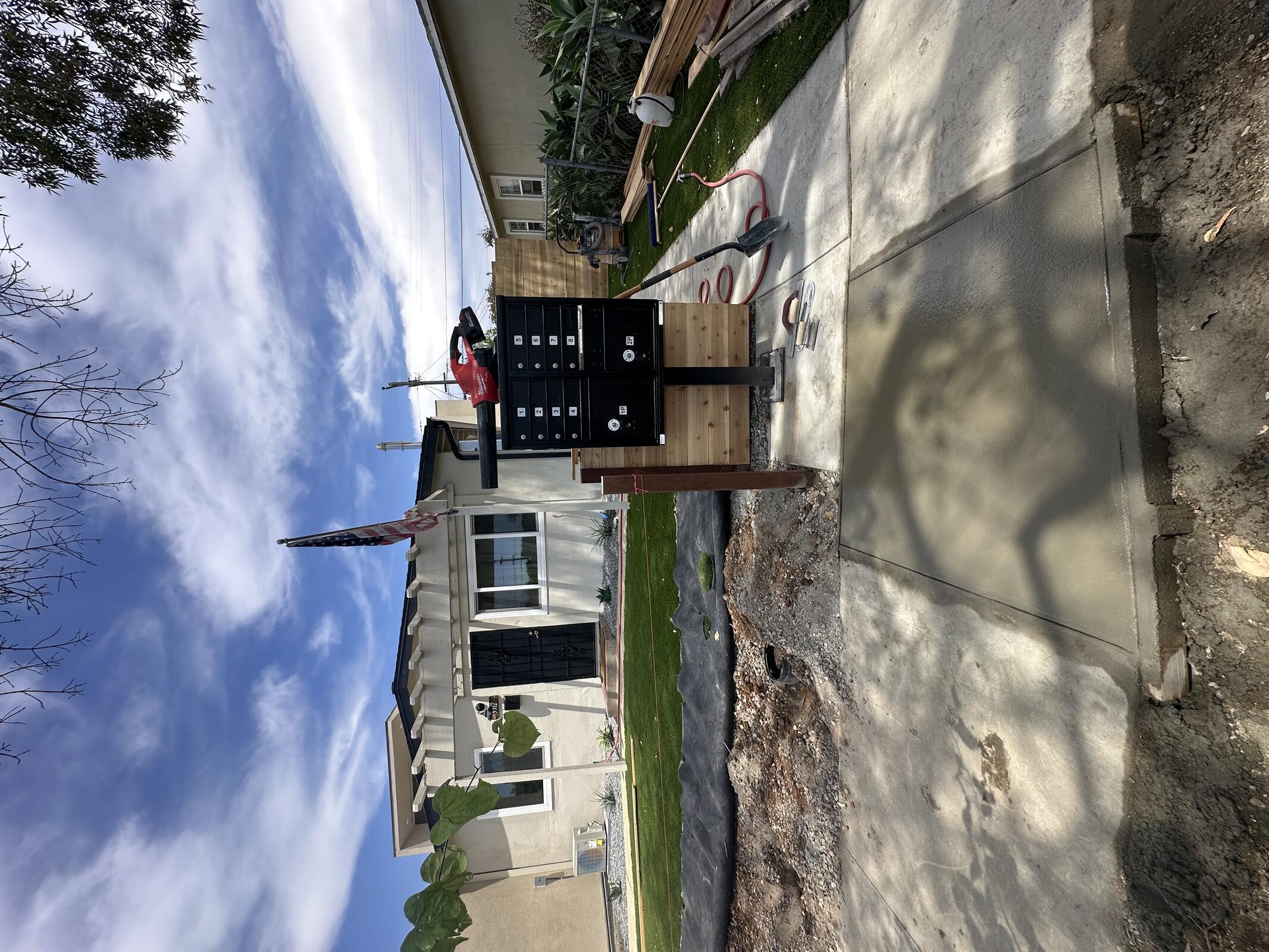

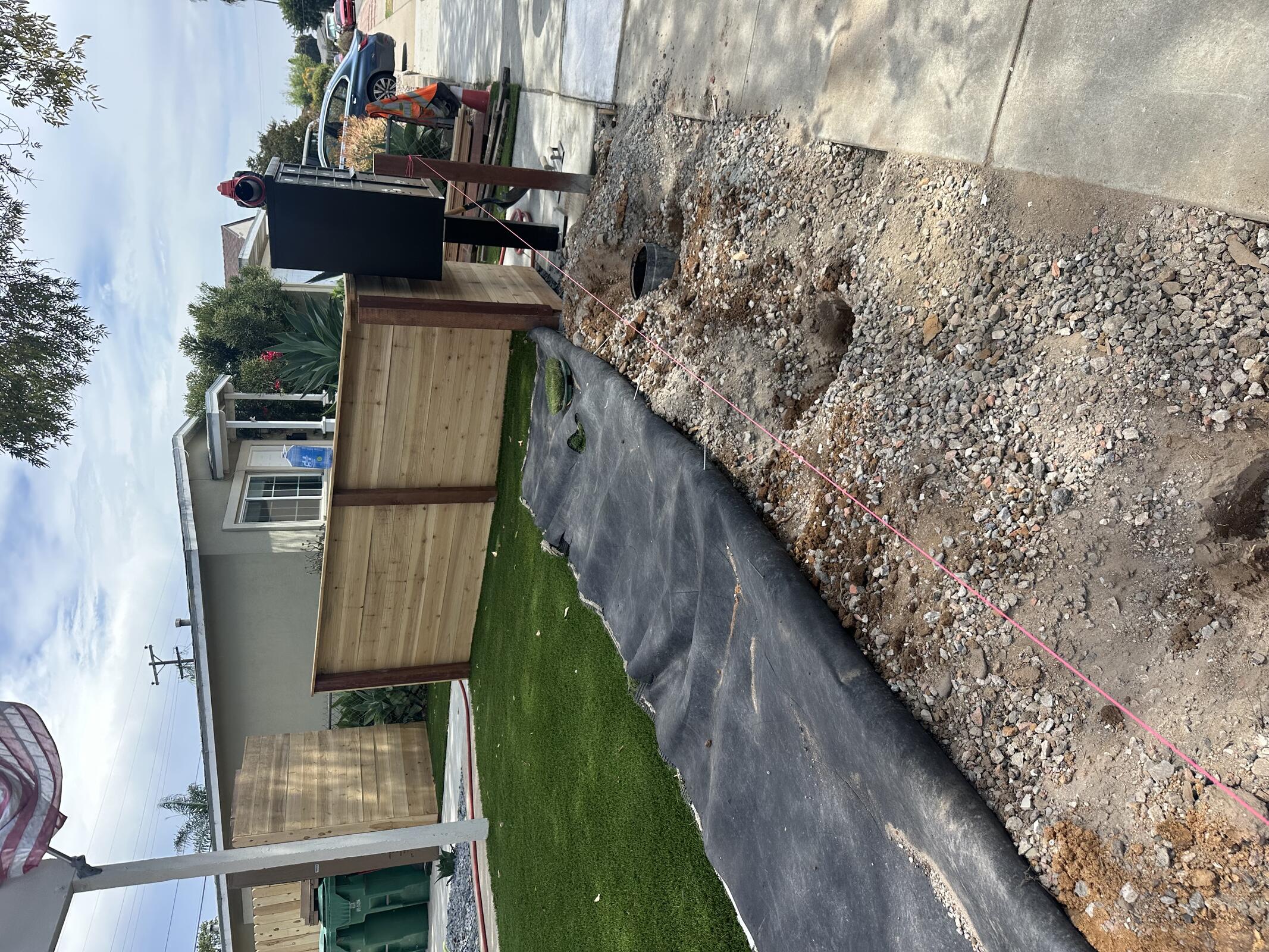

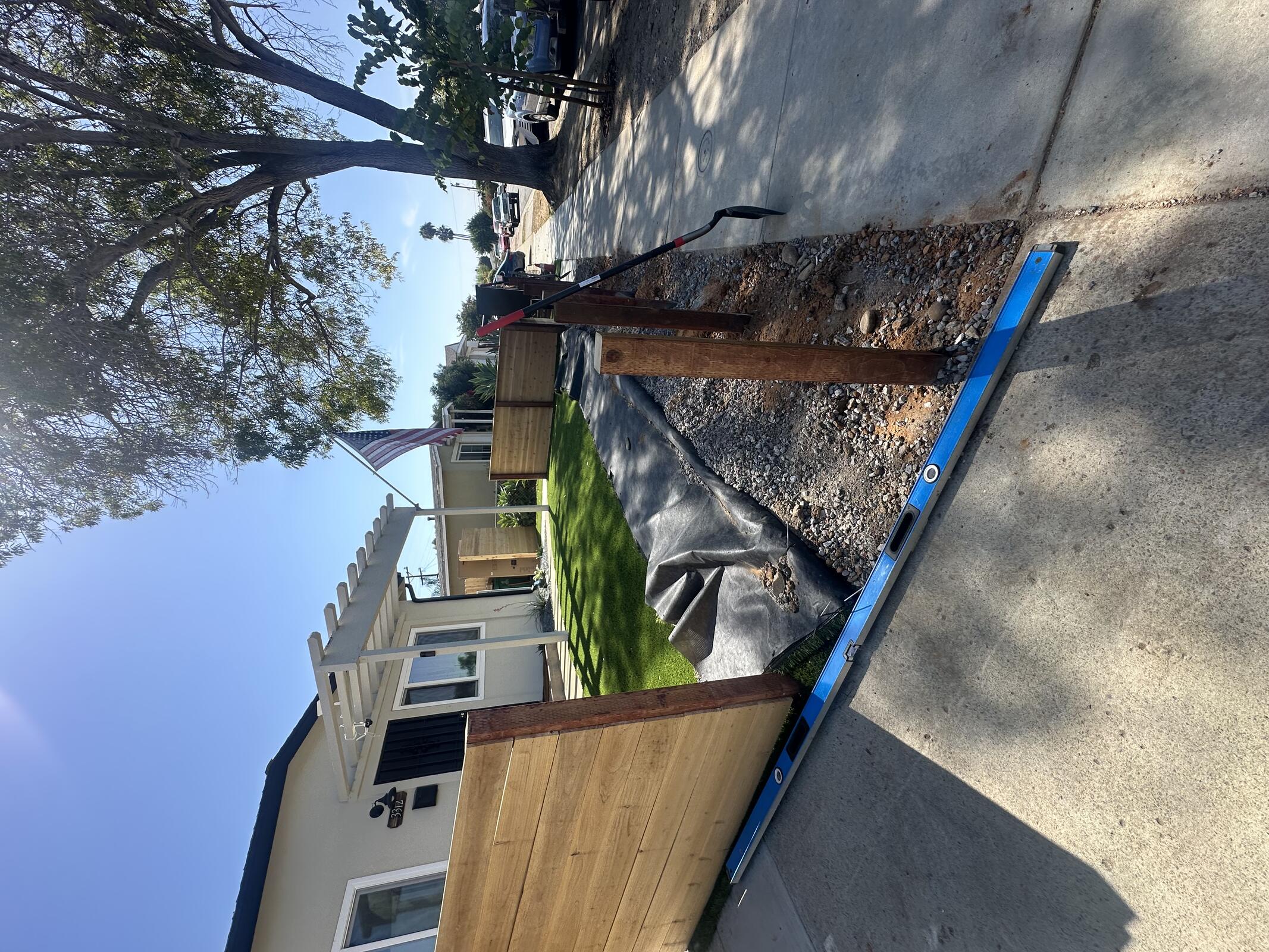

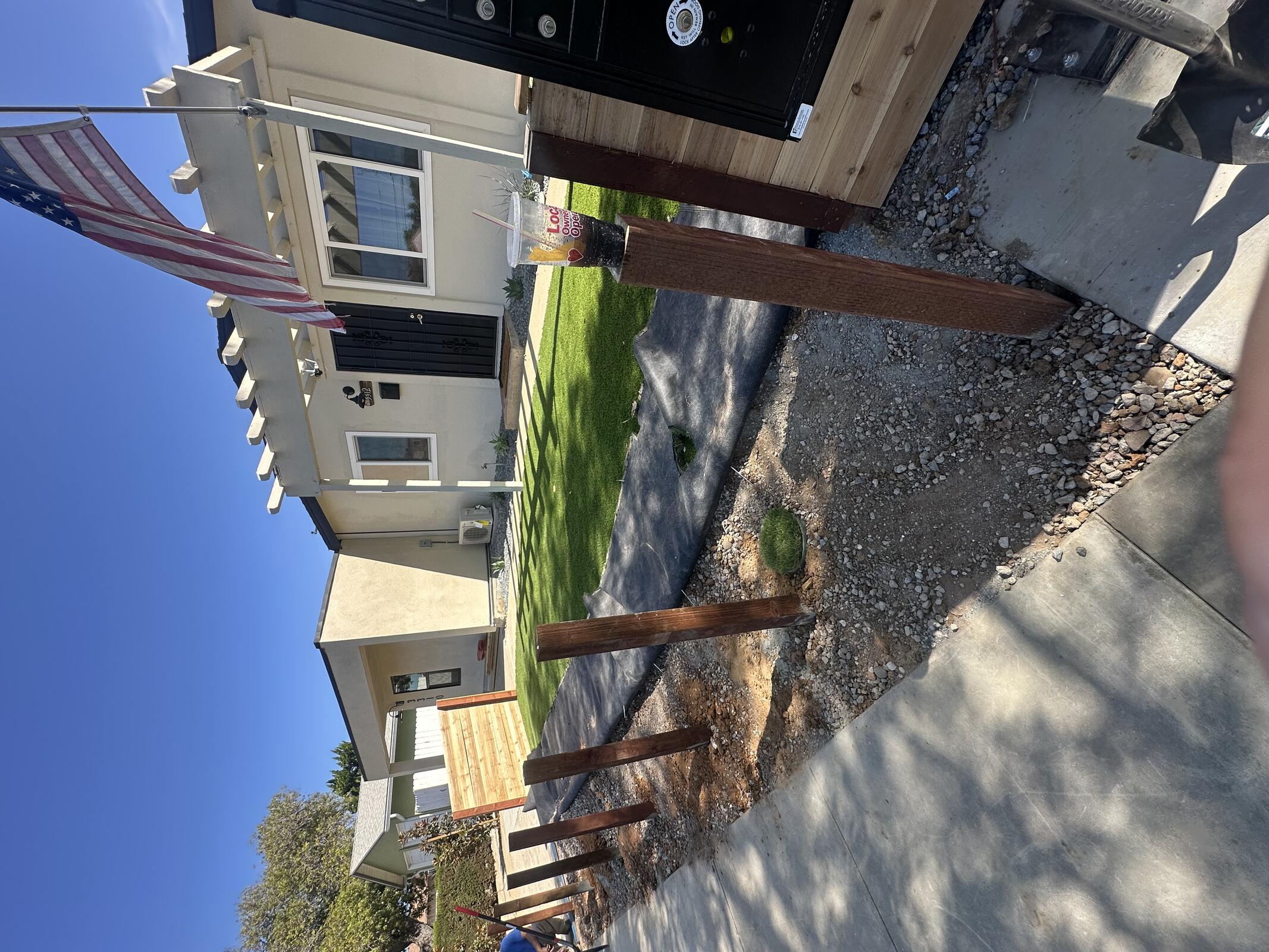

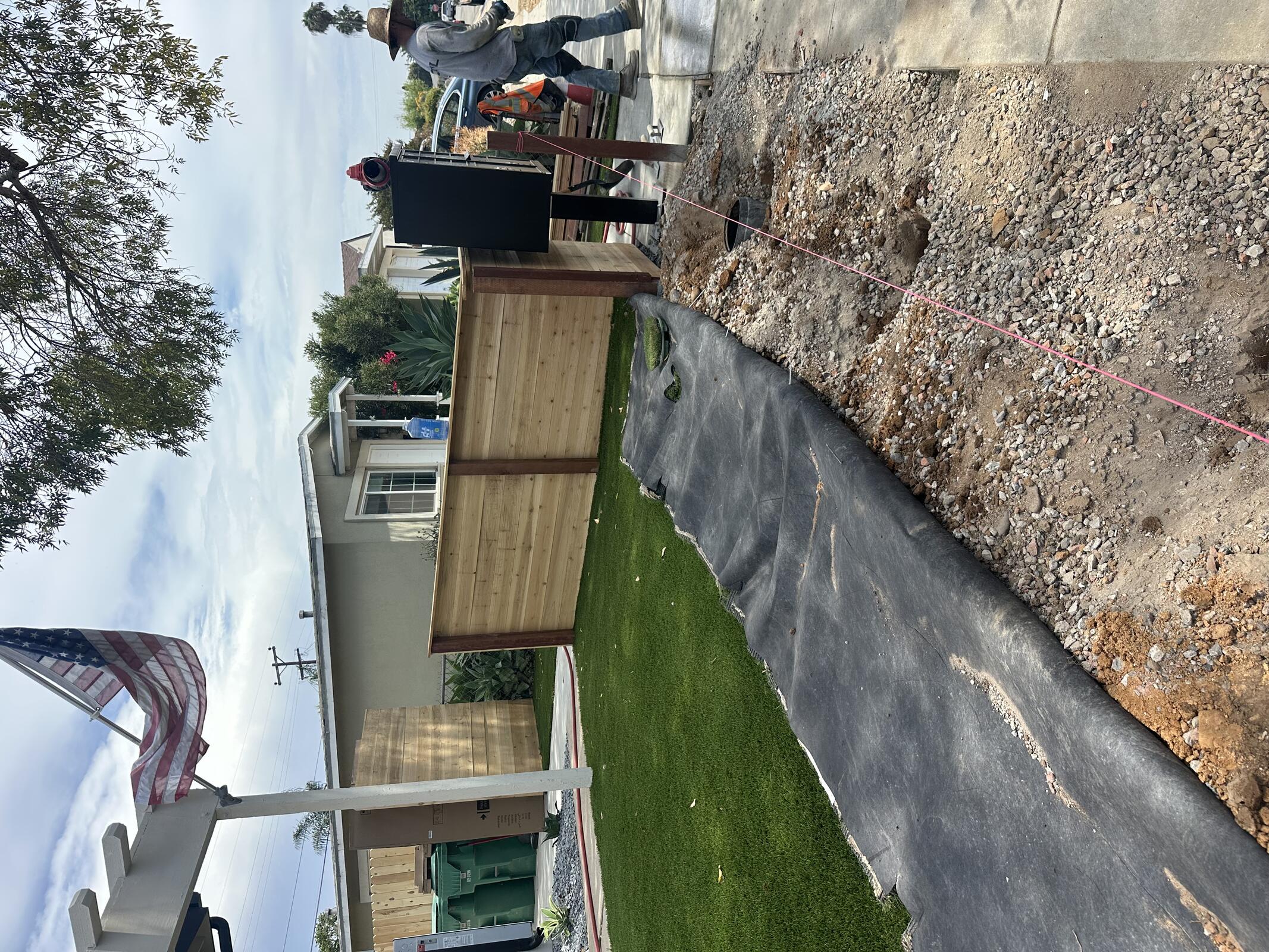

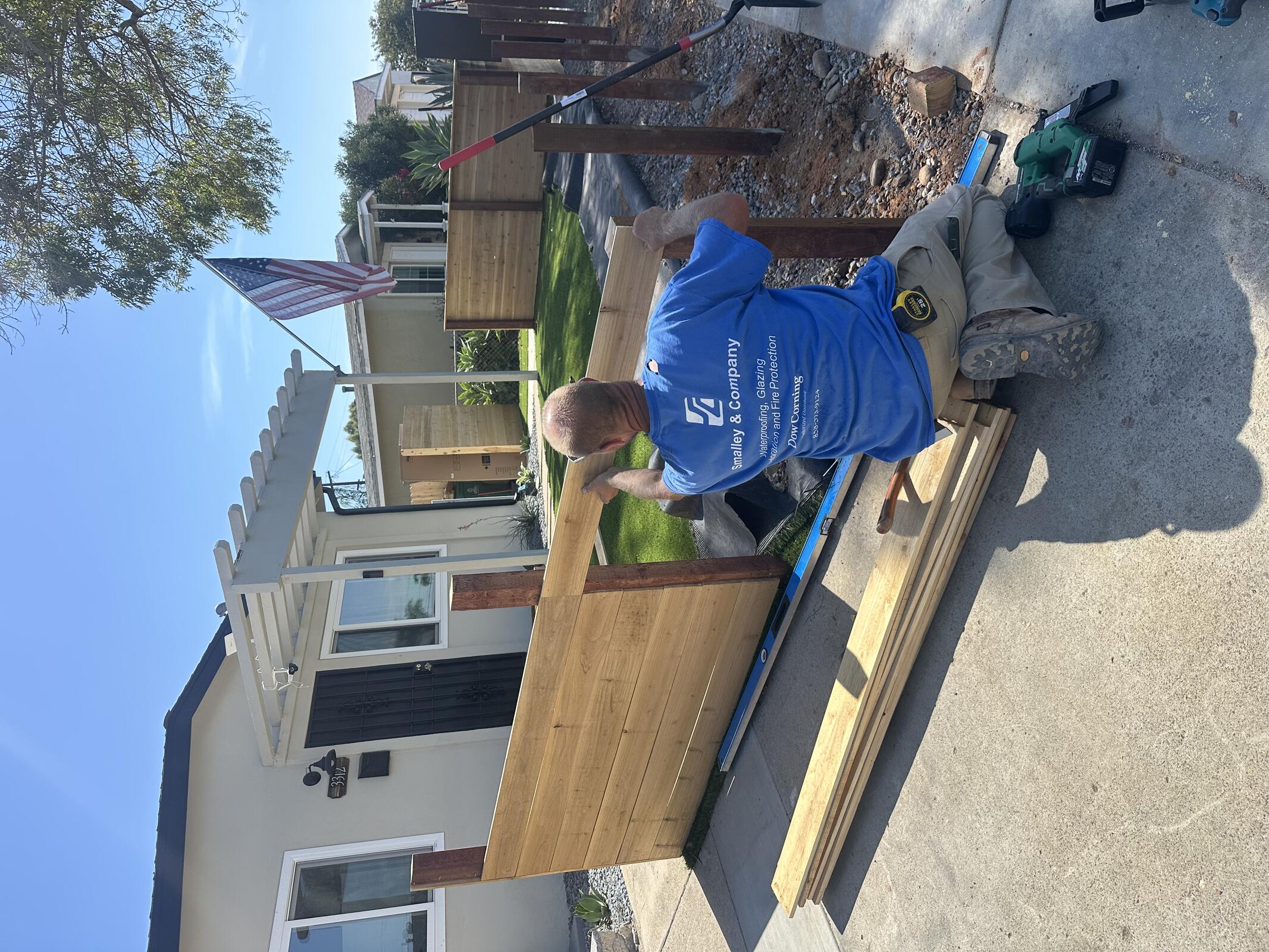

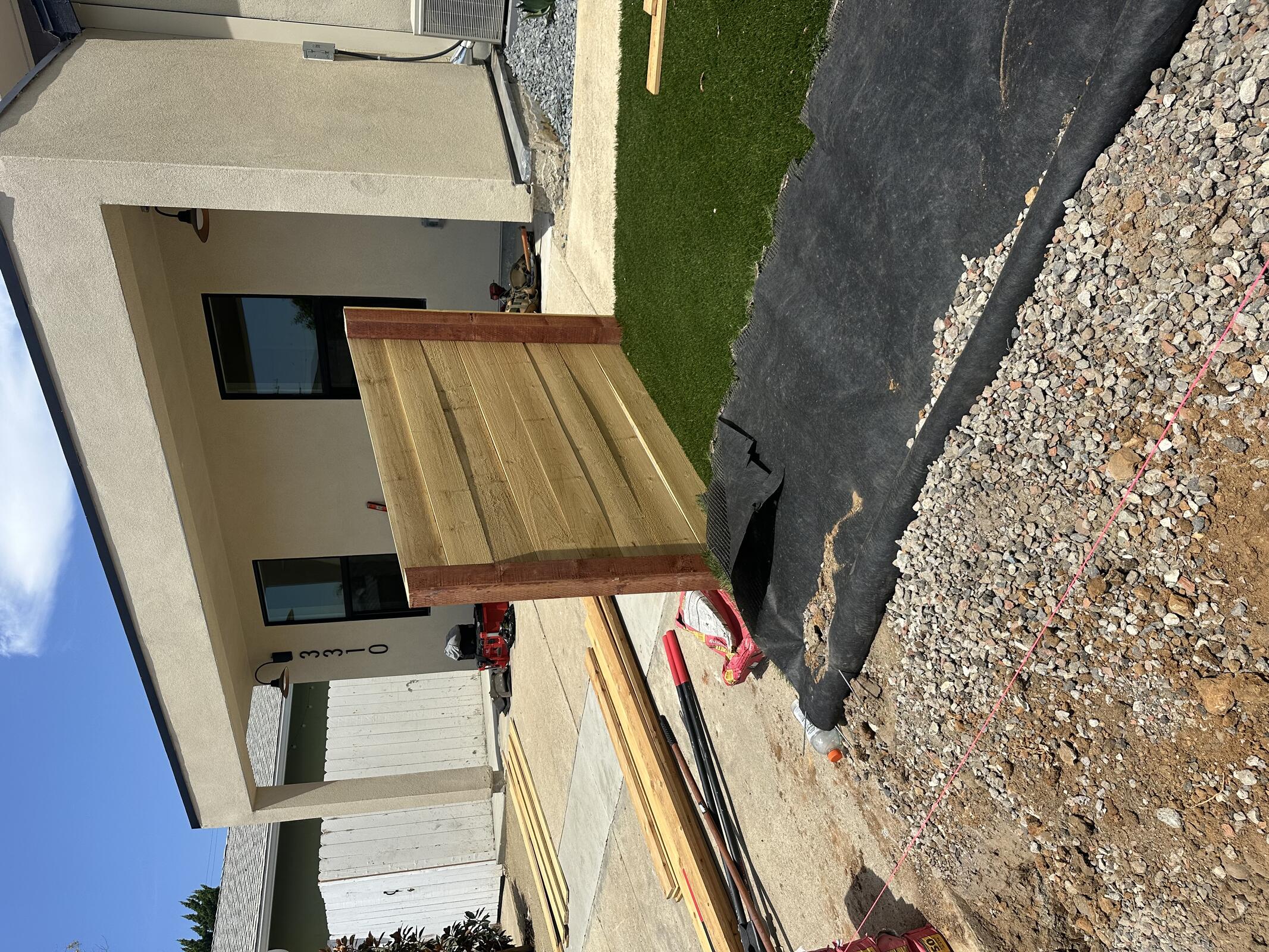

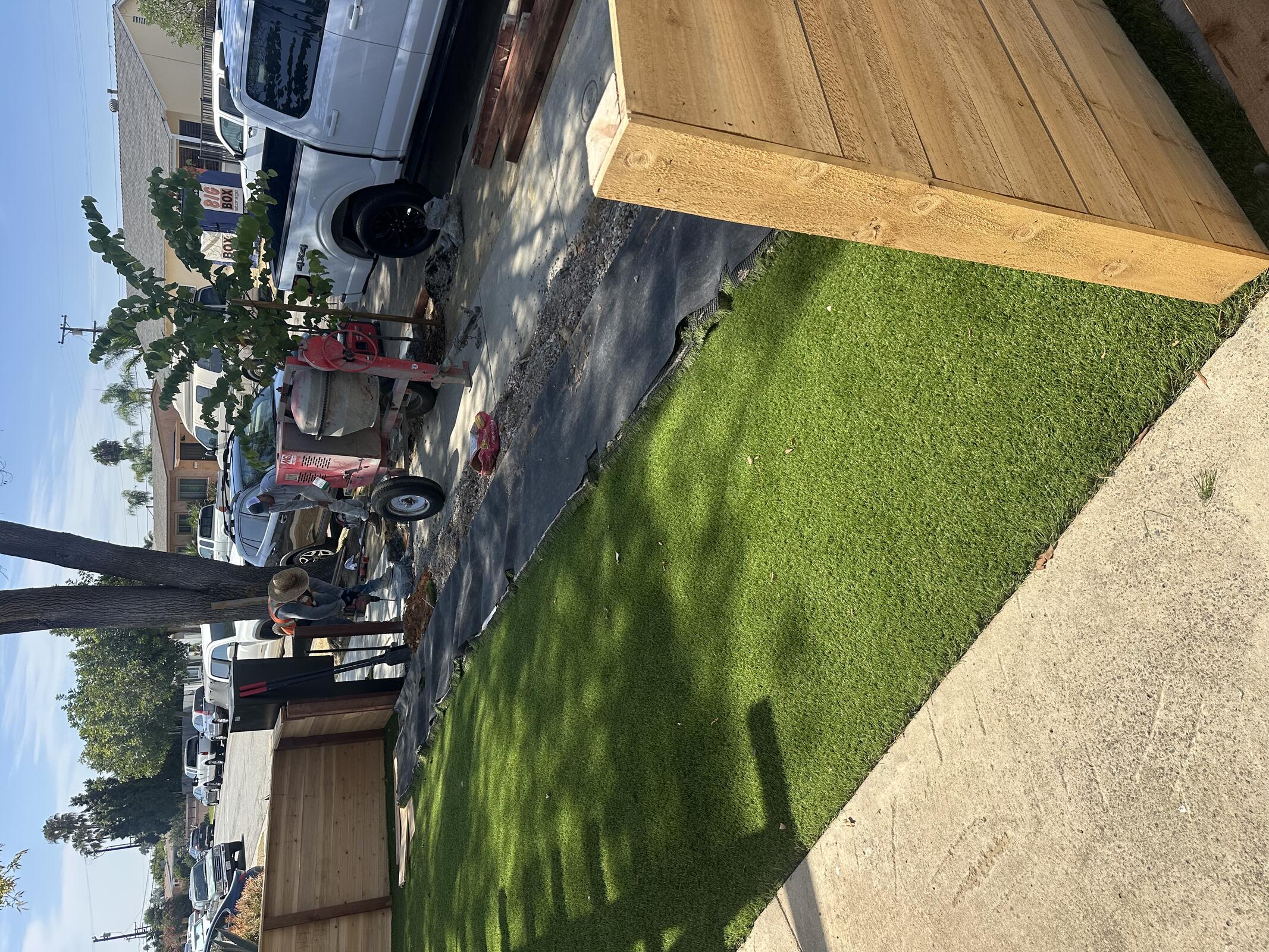

JBG on site demoing front fence and setting new posts.

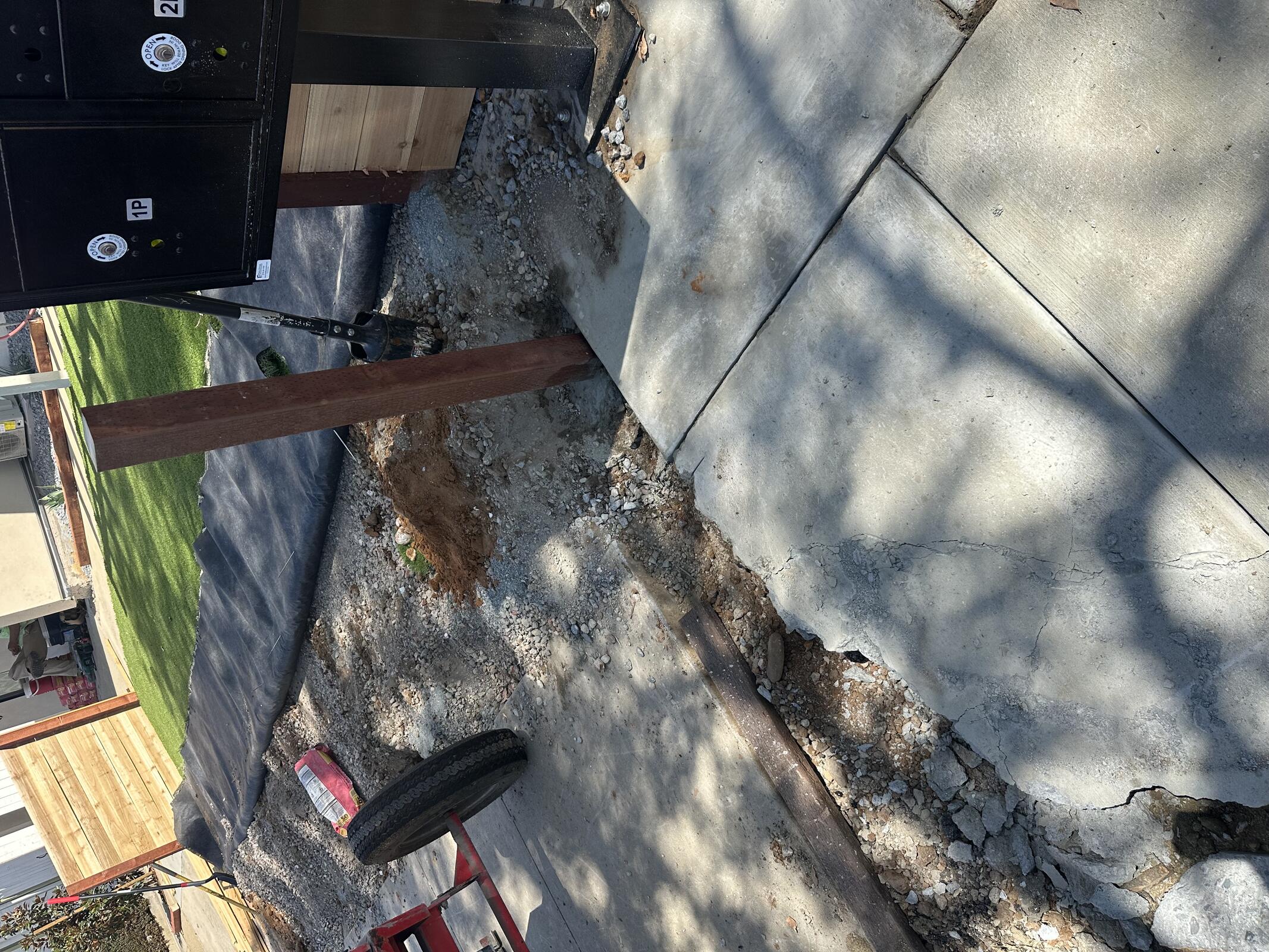

C3 on site to demo out asphalt patch and replace sidewalk panel.

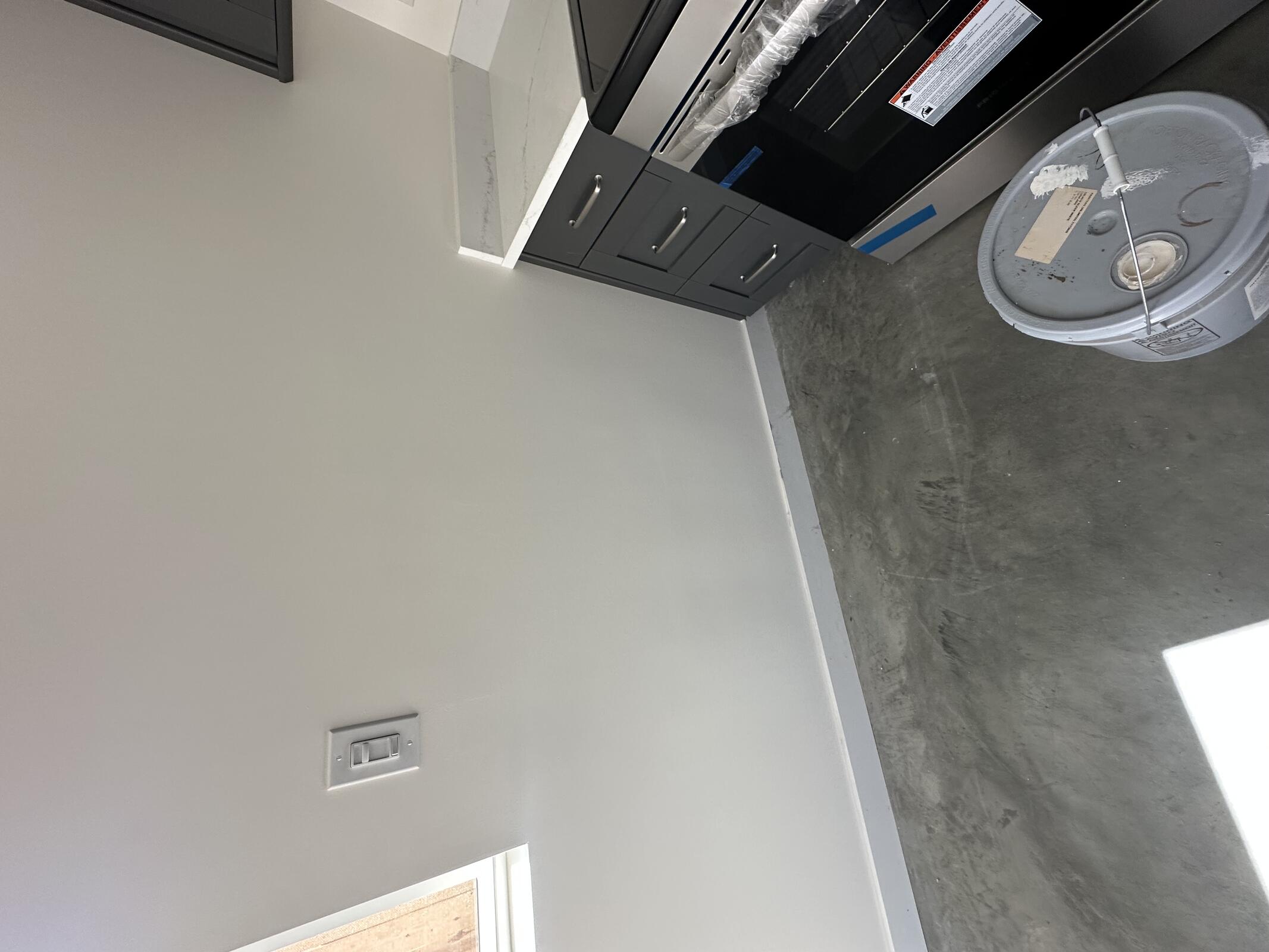

Drywall patches painted.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| C3 | 1 | 6 | 6 |
| JBG | 2 | 8 | 16 |
Inspection: N/A
Delay: Still pending callback from Dan Rodriguez (SDGE). ML left voicemail and sent email yesterday, 8/19.

Friday, August 21, 2026
Clear, 83°F
JBG working on fence.
Rete’s patched waterproofing damage from appliance delivery on stairs.
Manpower:
| SUBCONTRACTOR | WORKERS | HOURS WORKED | TOTAL HOURS |
|---|---|---|---|
| JBG | 1 | 6 | 6 |
| Rete’s | 1 | 2 | 2 |
Inspection: N/A
